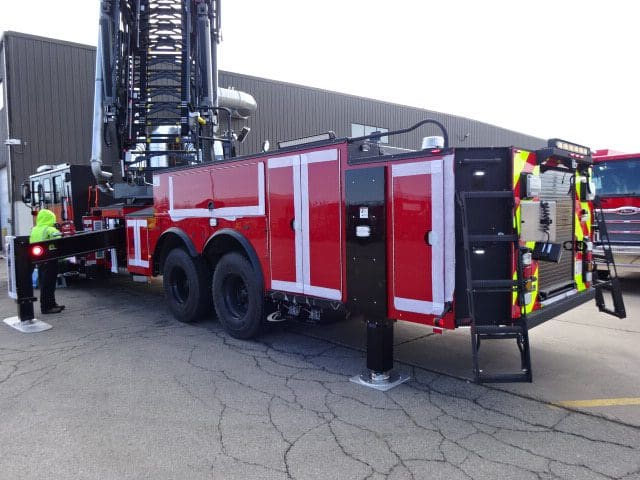

03-31-23

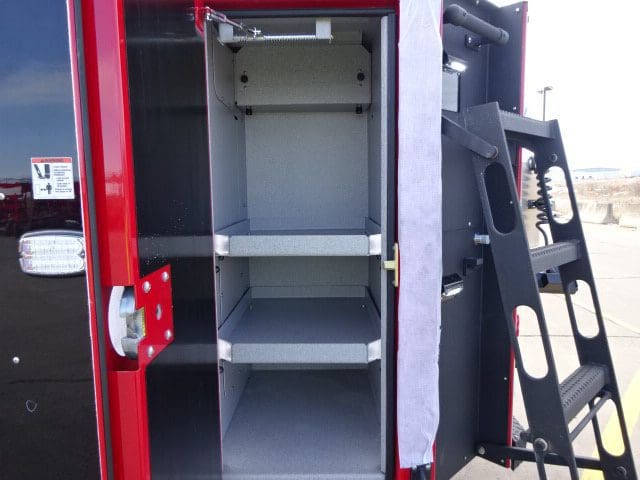

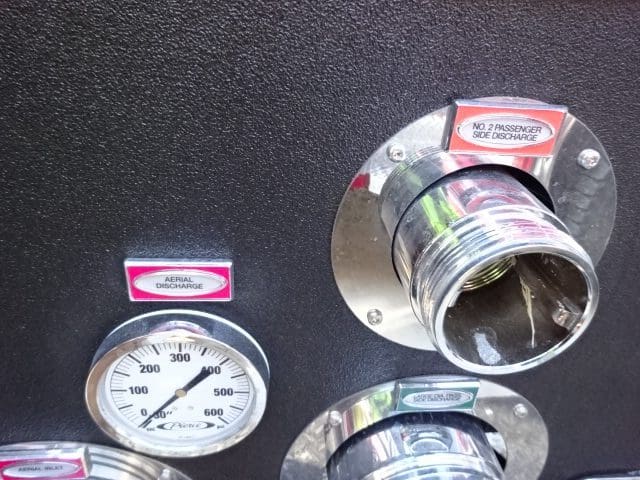

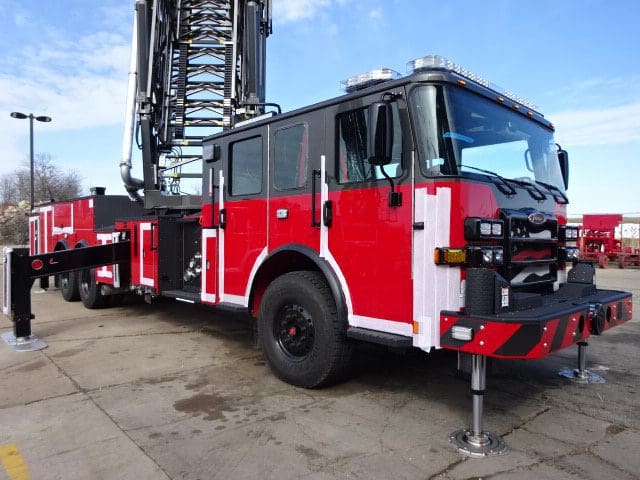

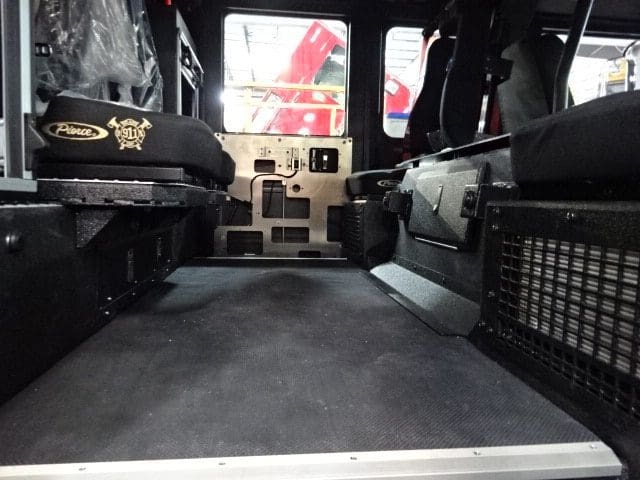

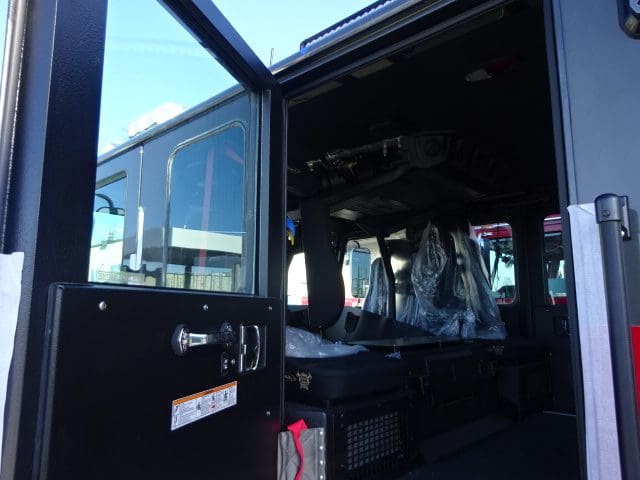

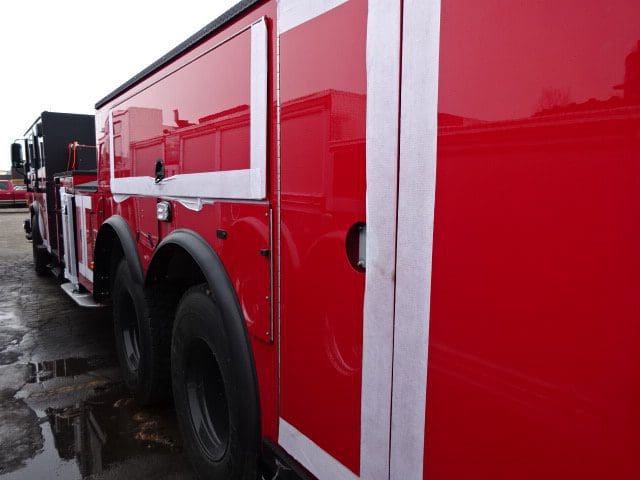

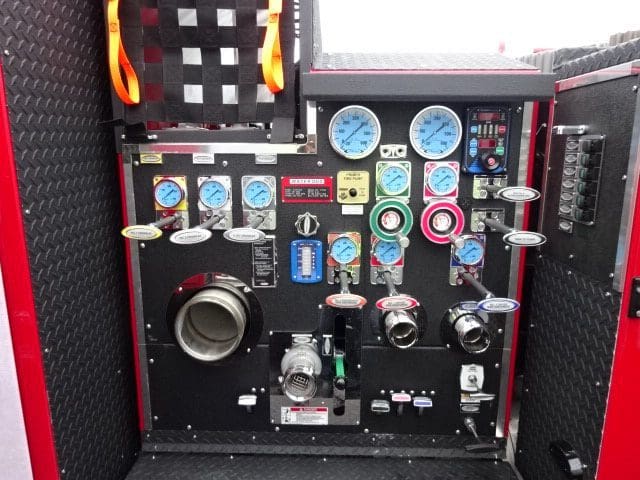

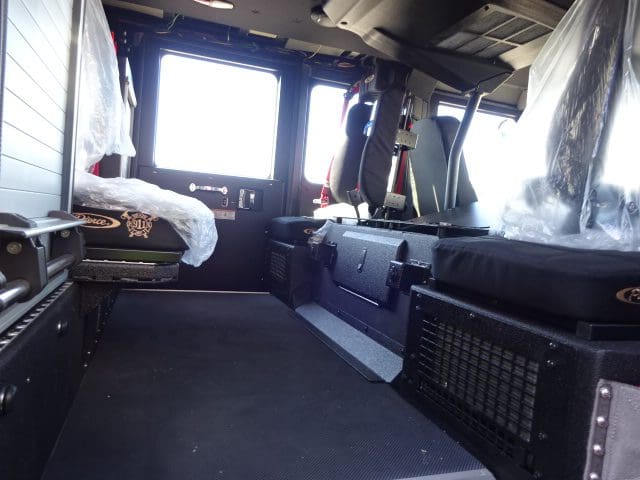

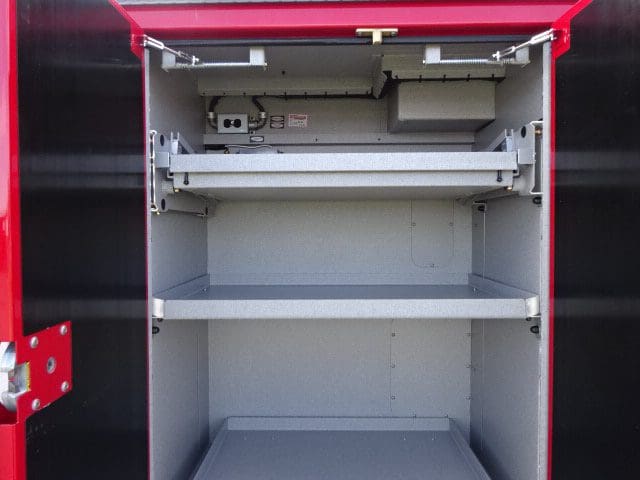

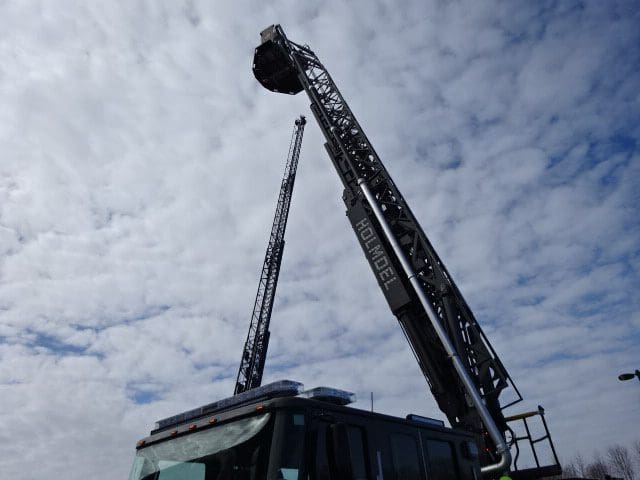

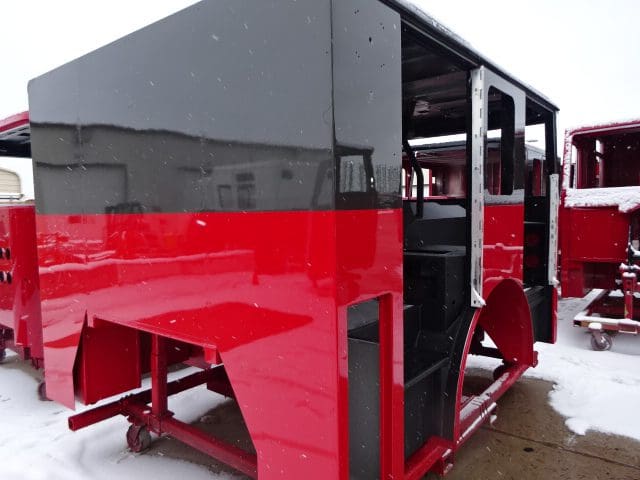

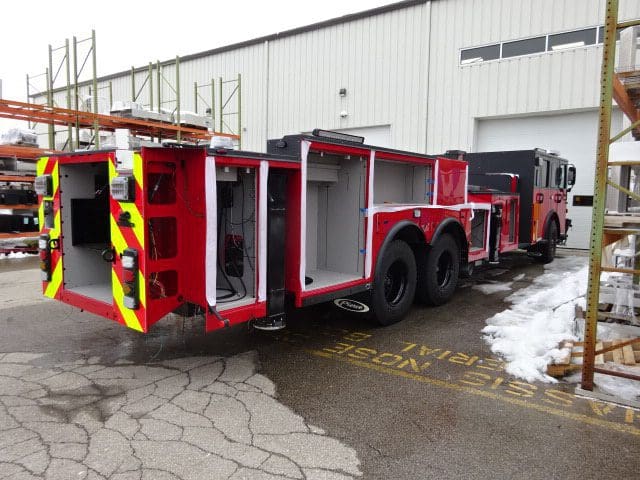

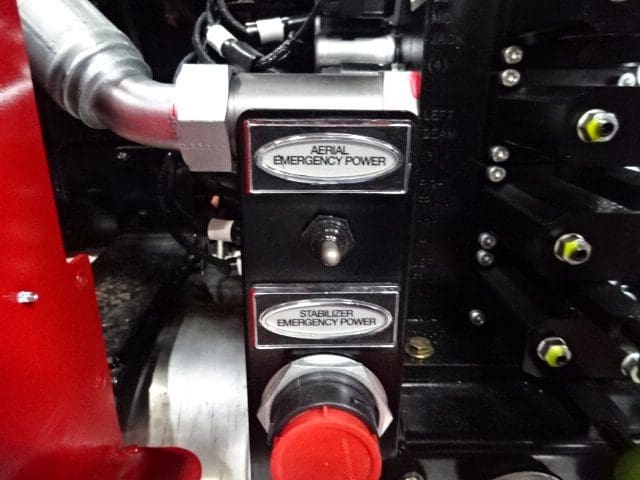

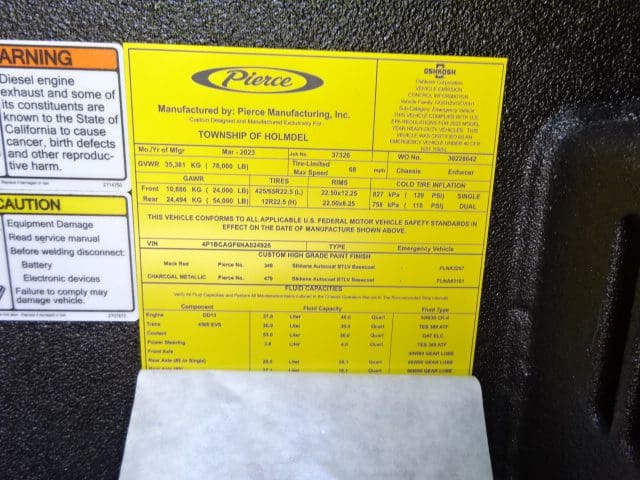

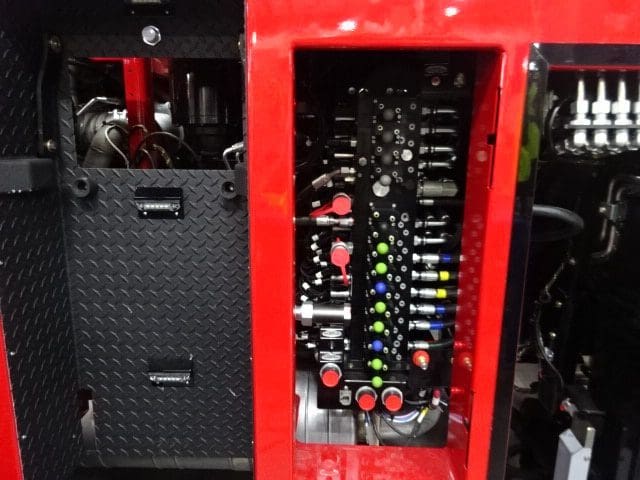

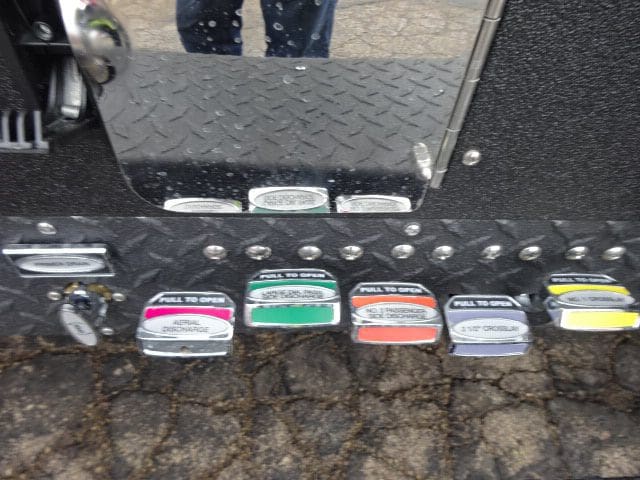

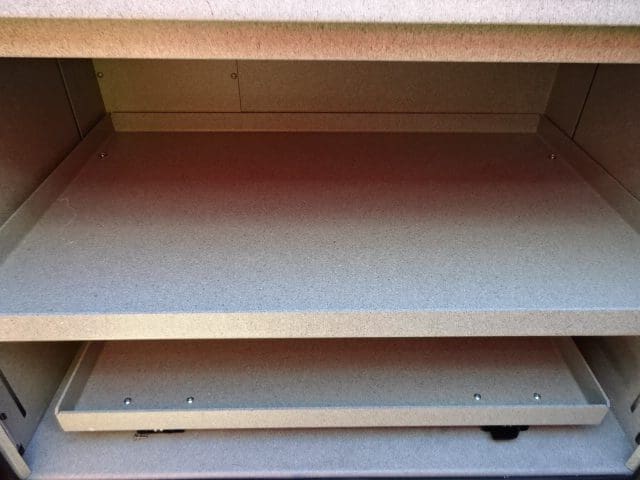

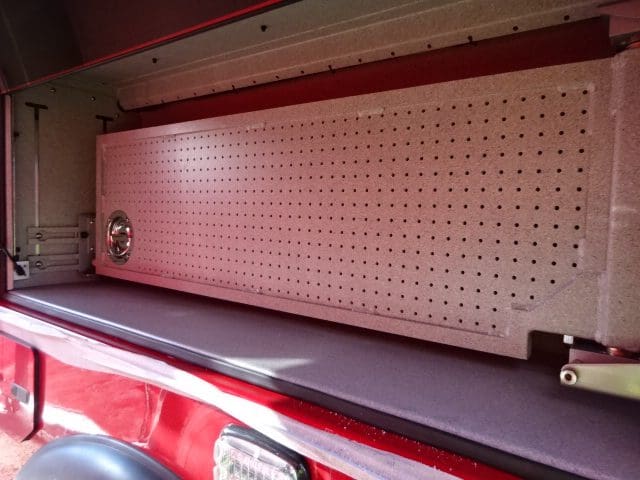

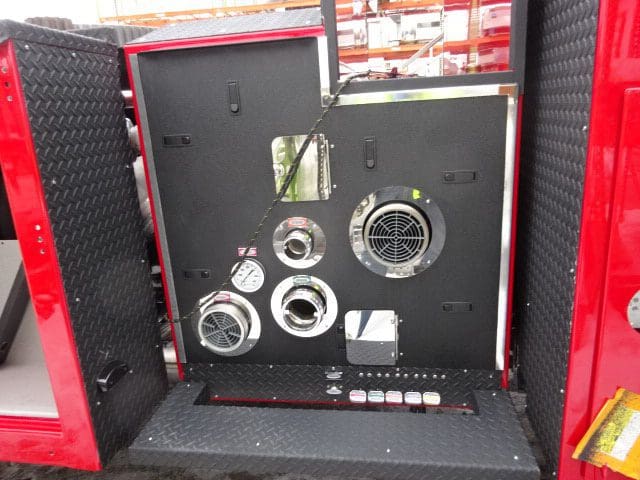

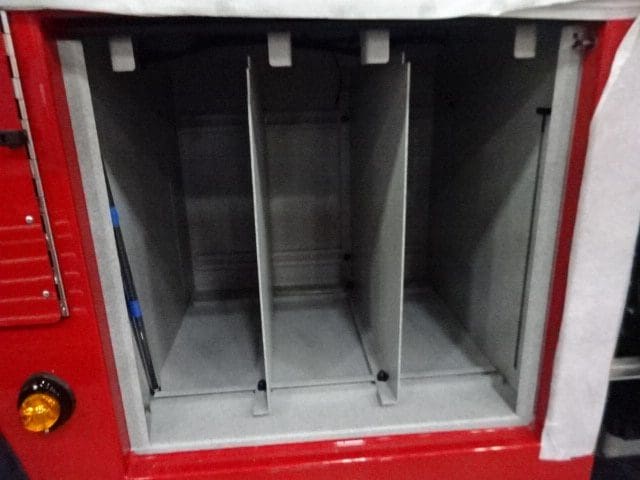

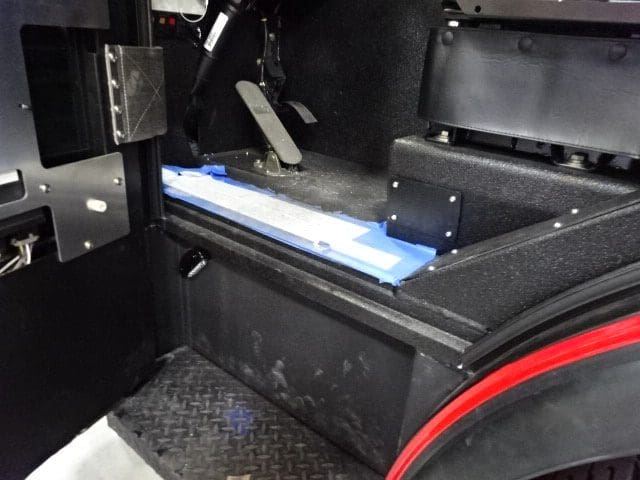

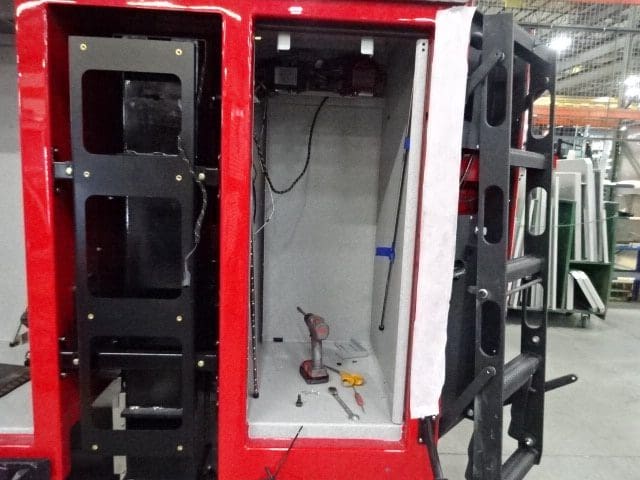

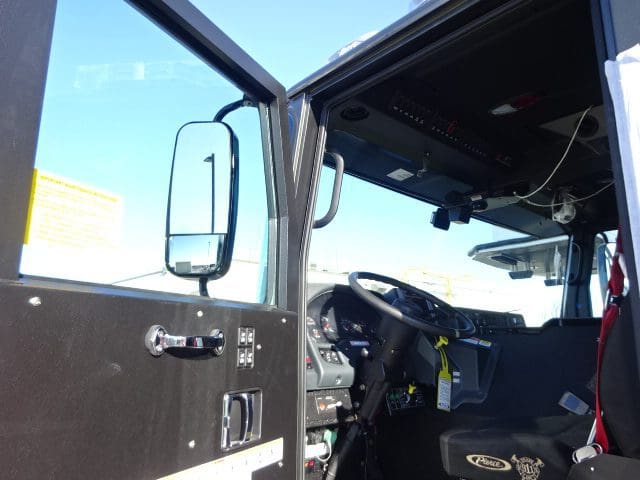

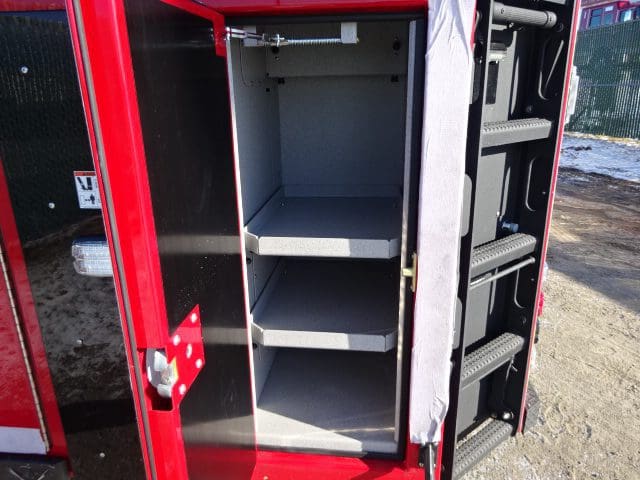

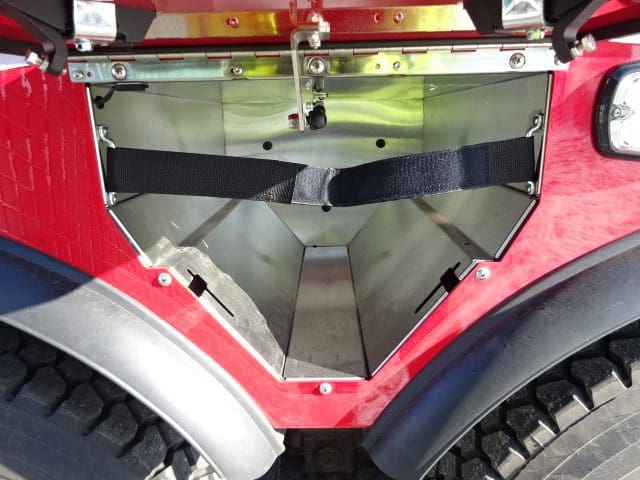

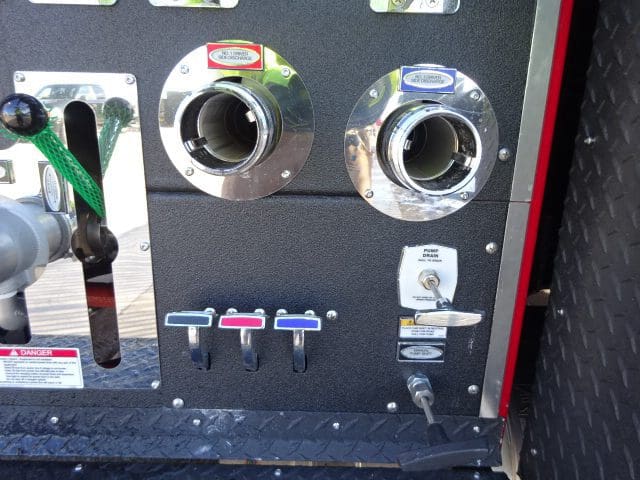

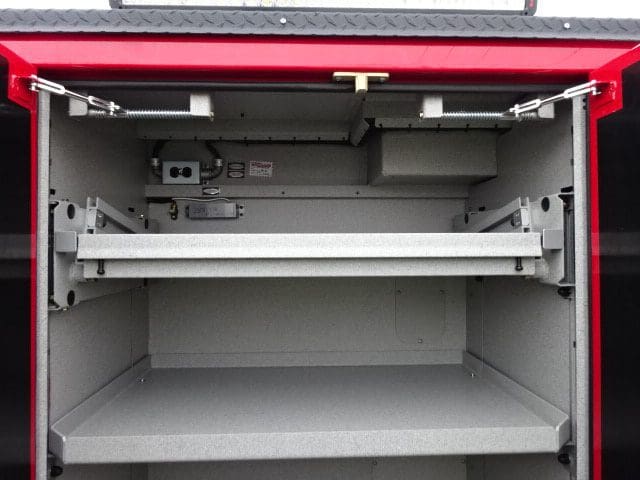

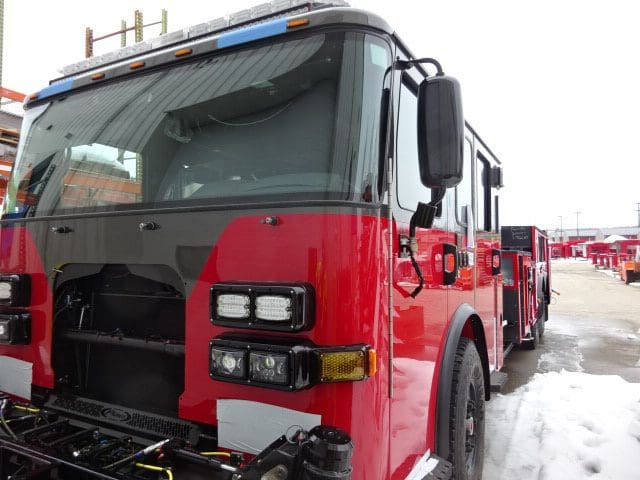

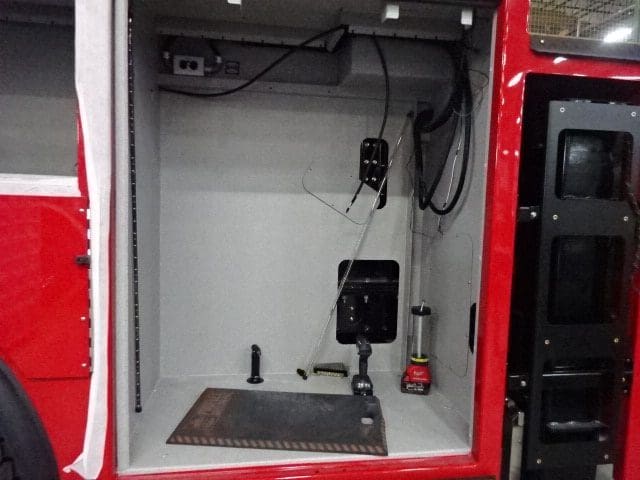

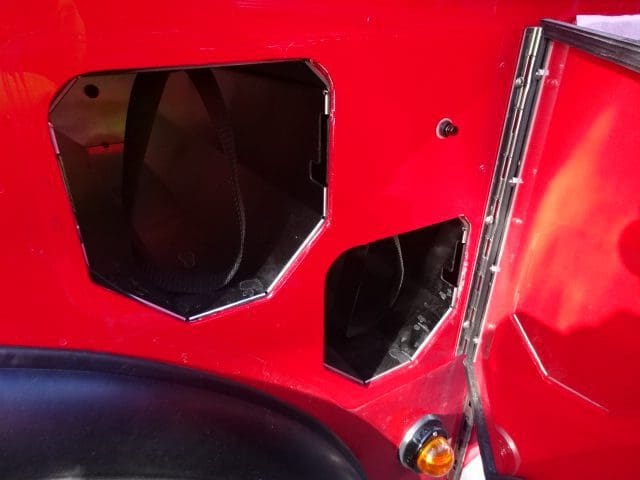

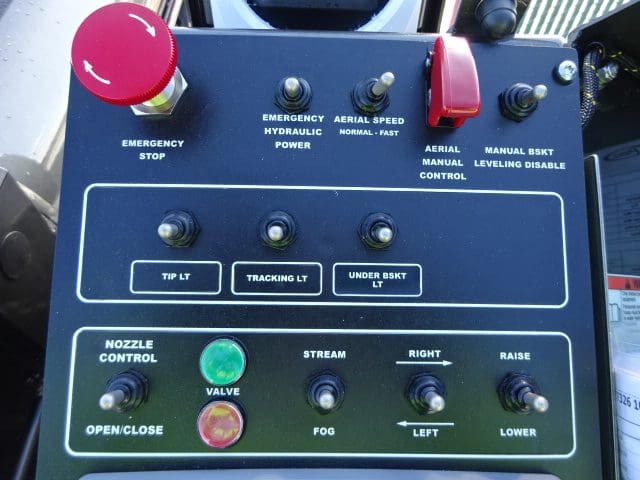

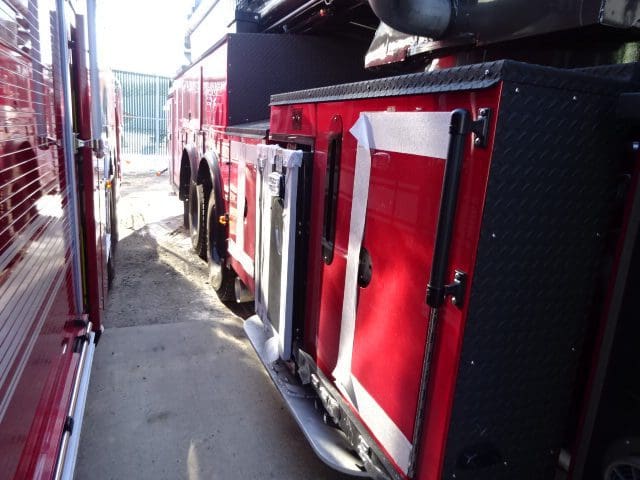

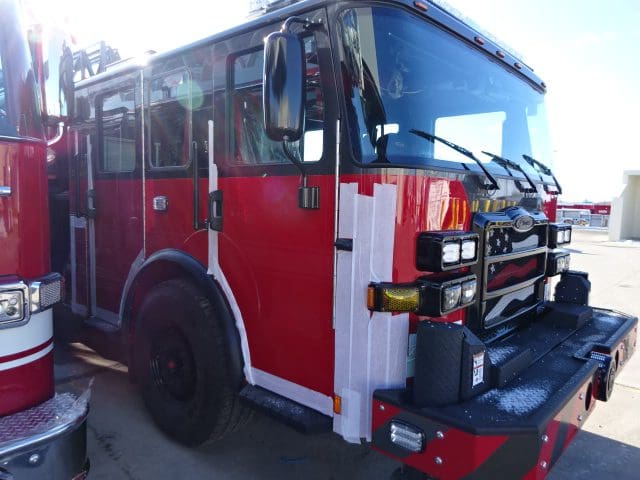

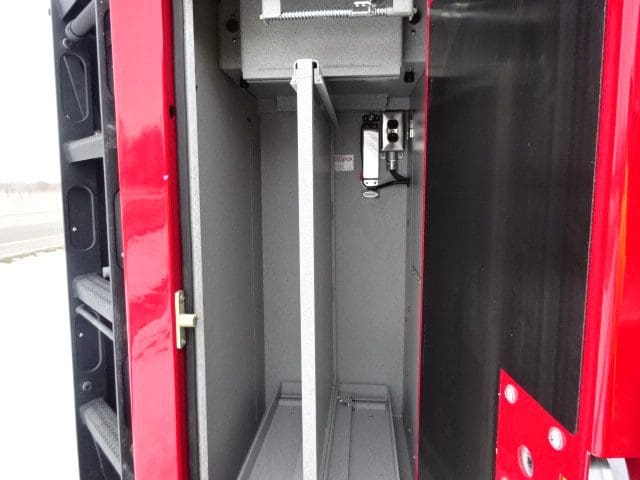

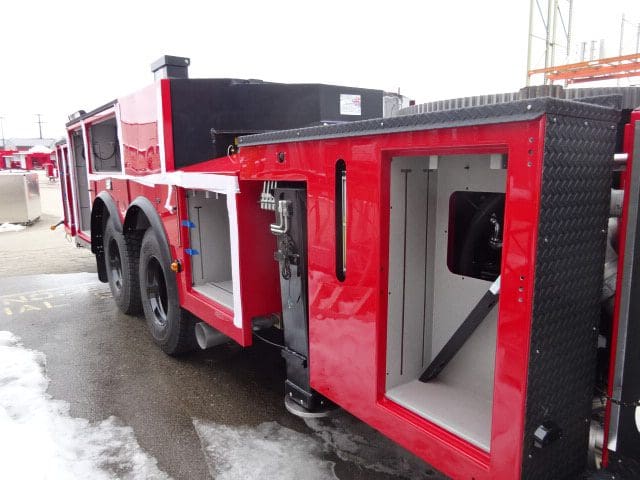

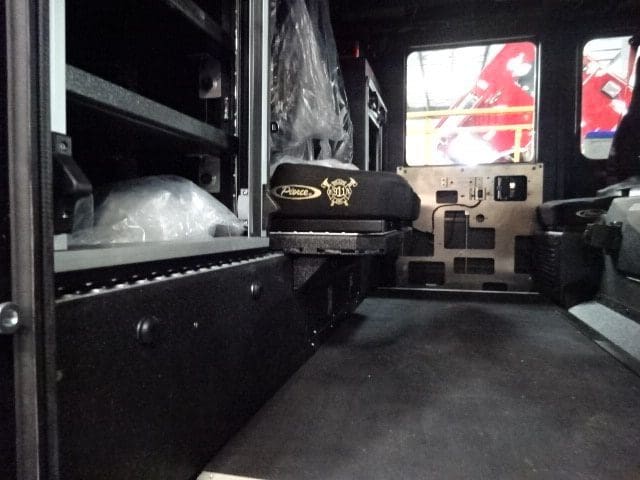

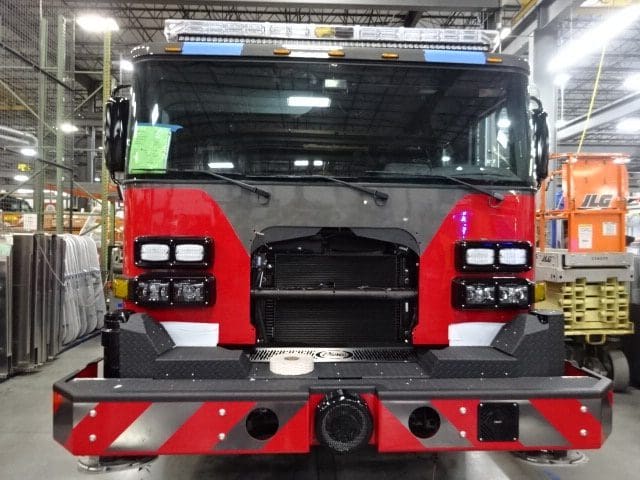

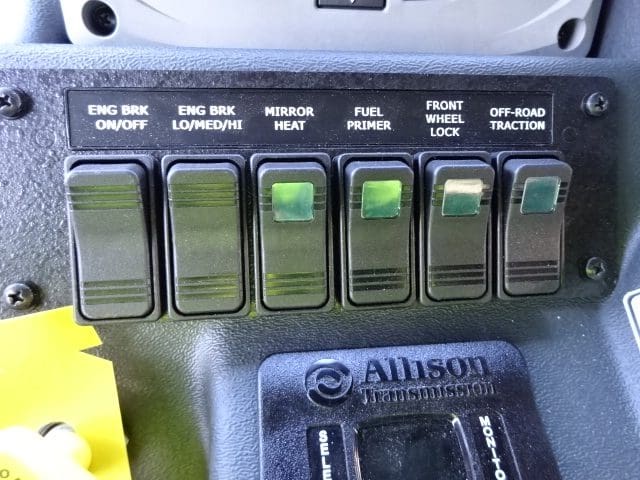

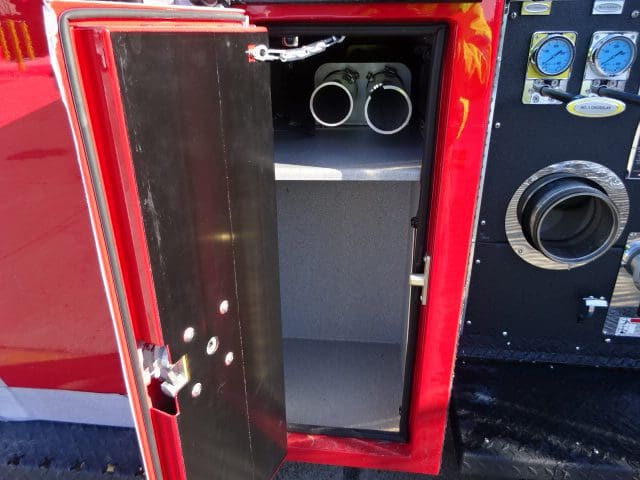

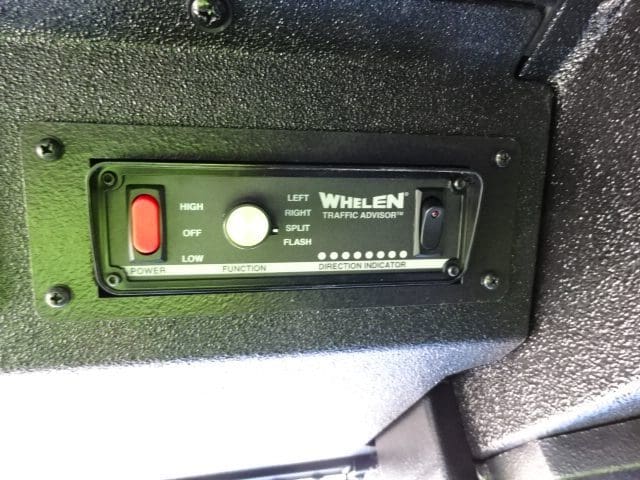

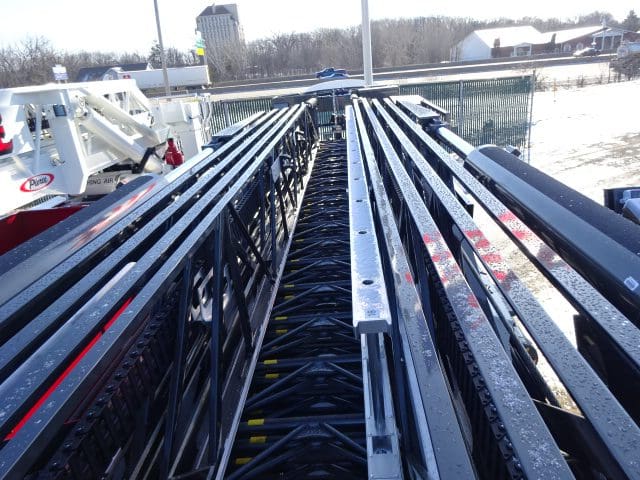

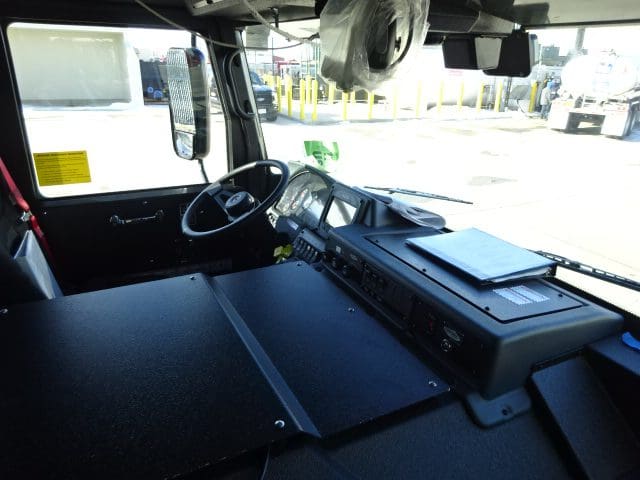

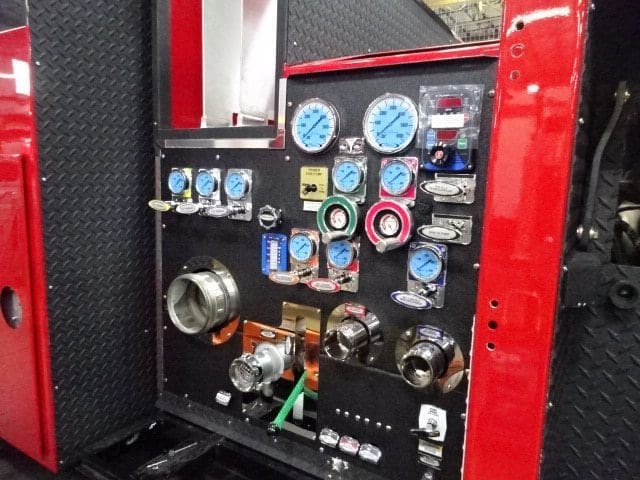

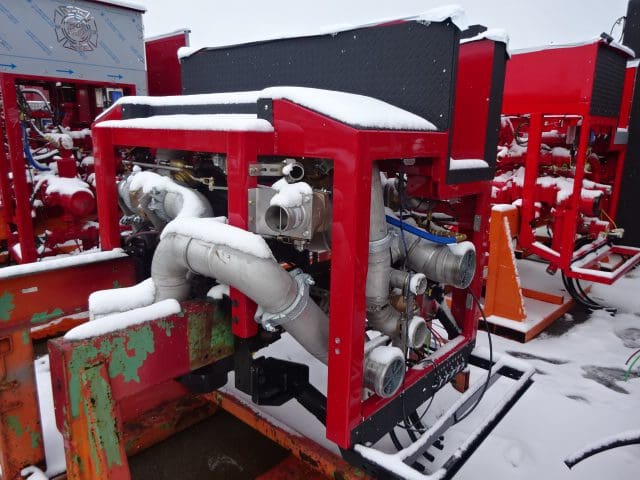

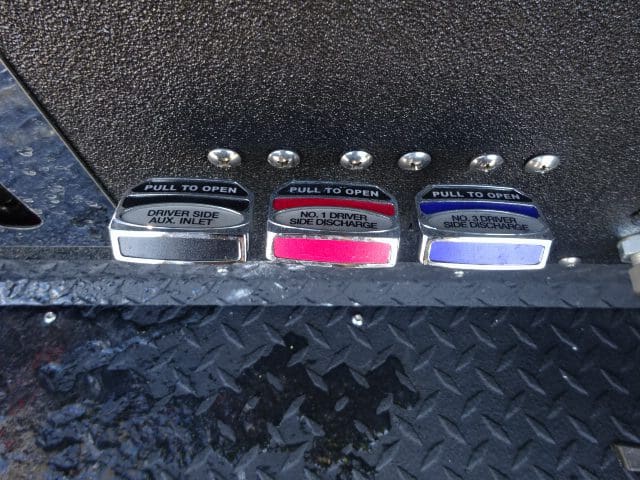

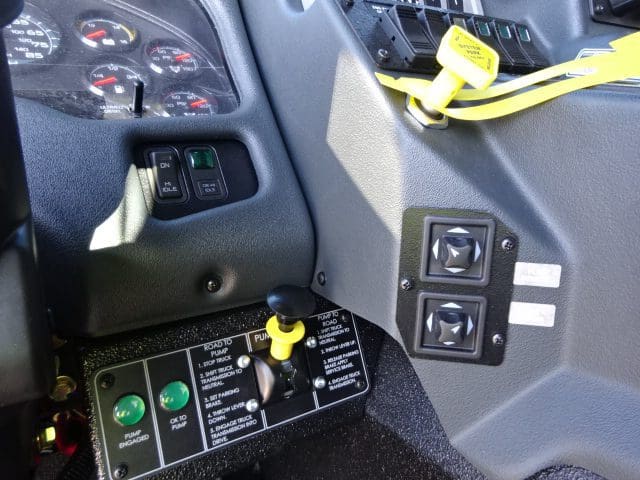

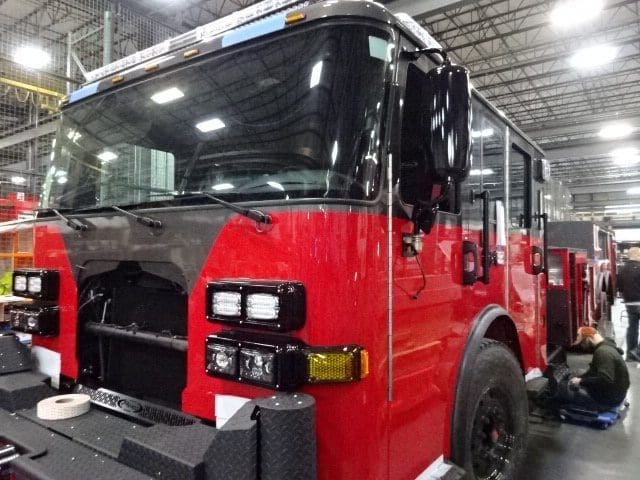

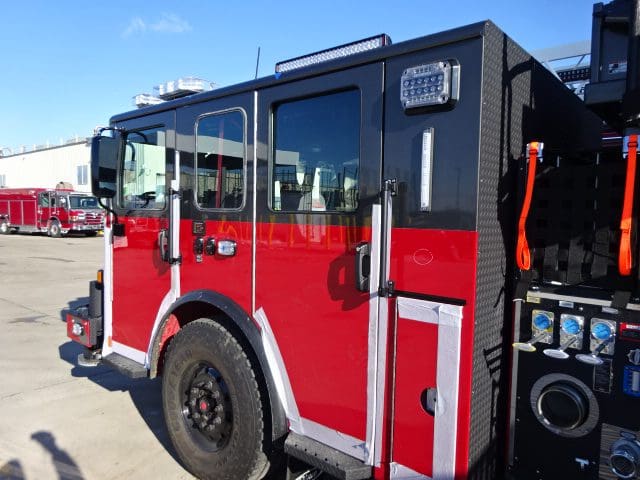

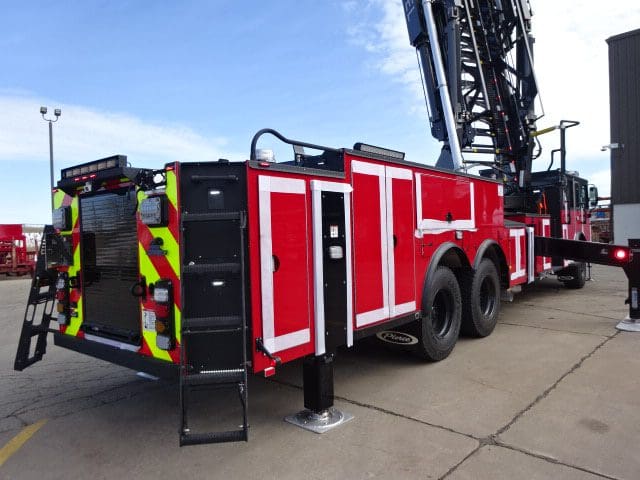

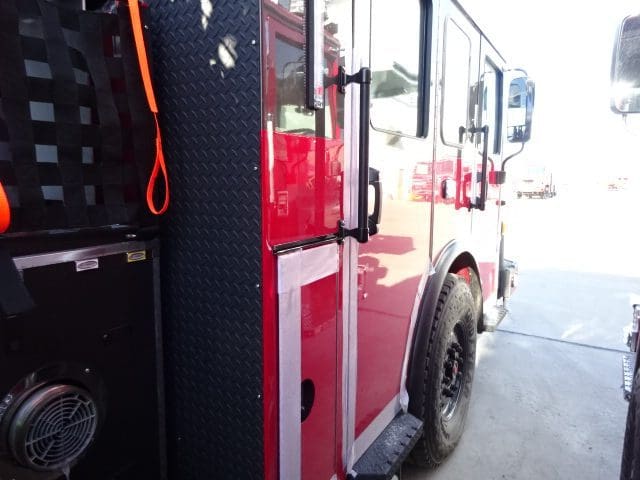

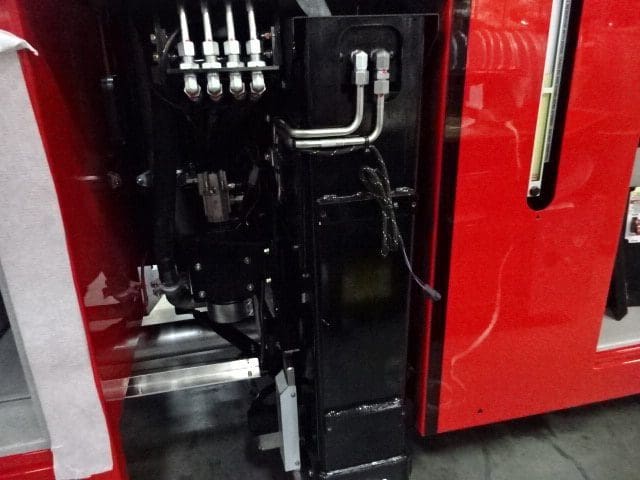

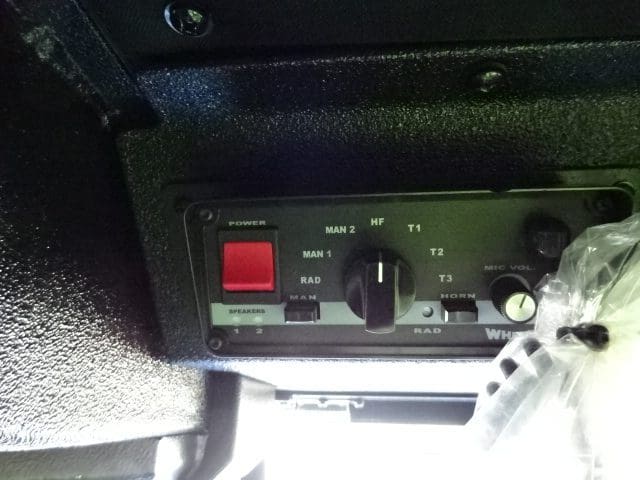

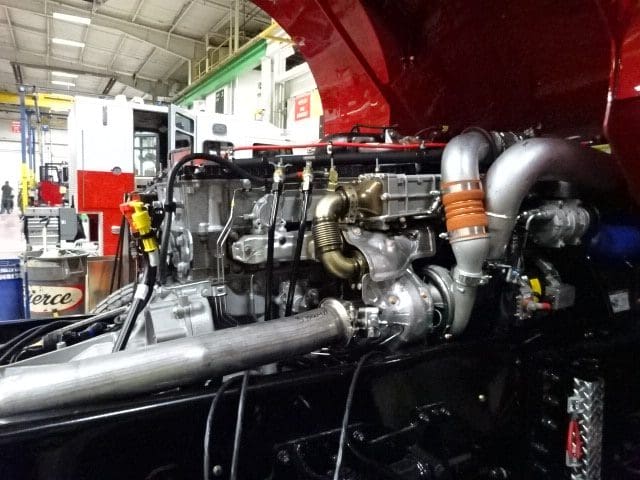

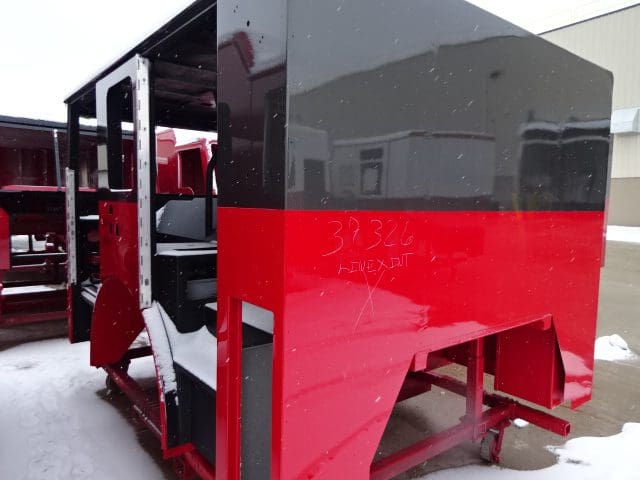

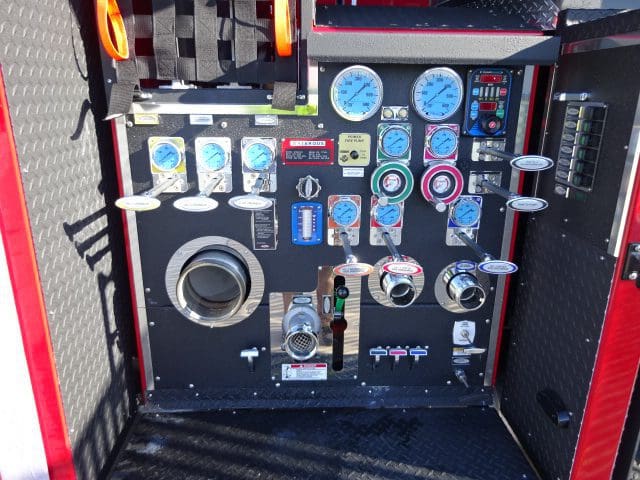

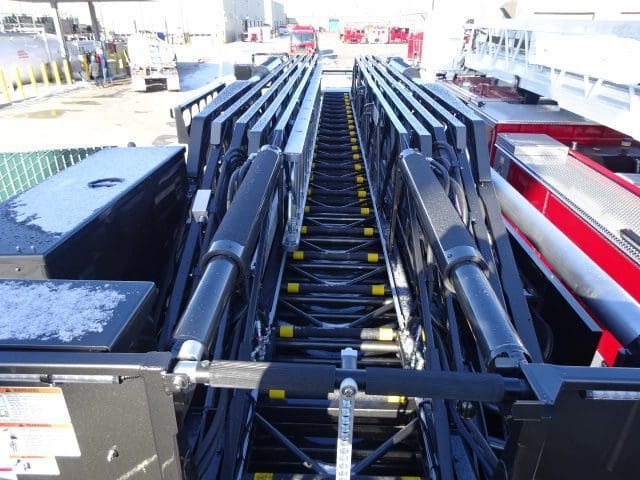

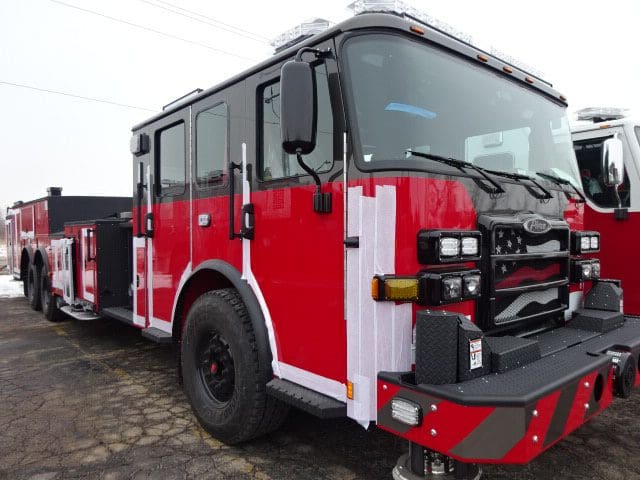

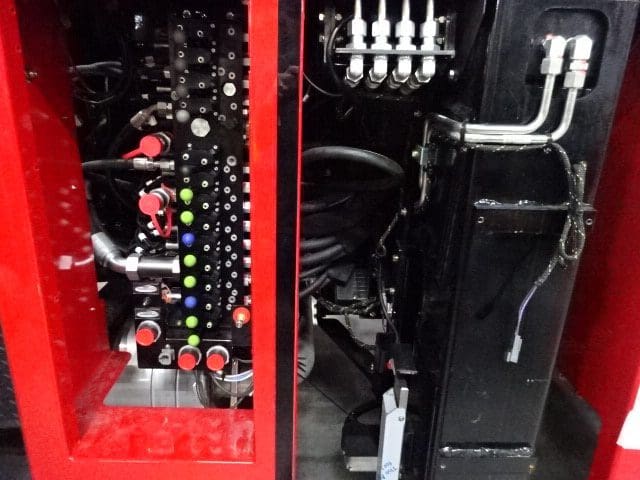

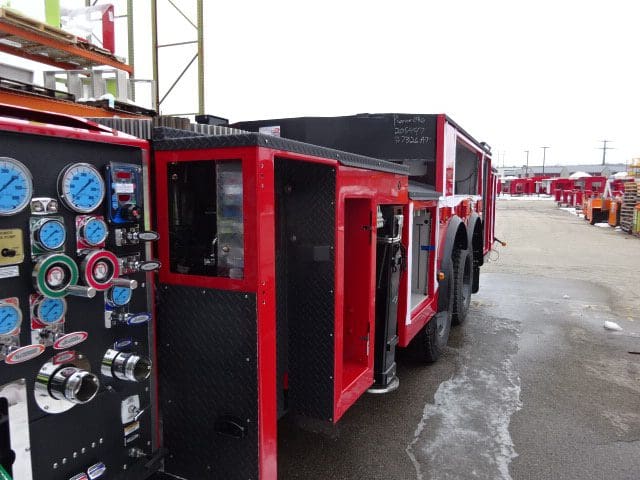

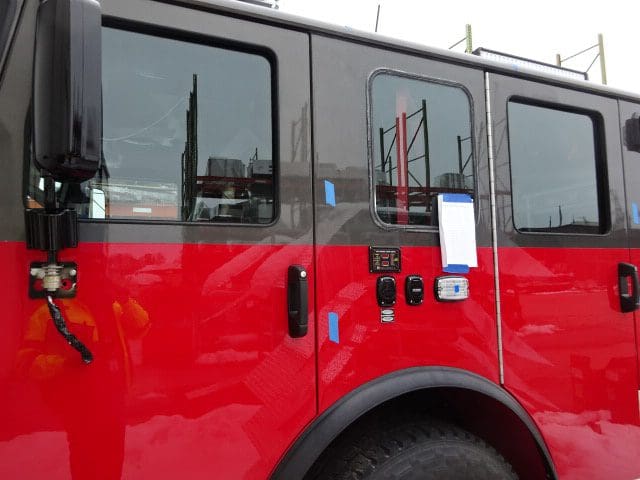

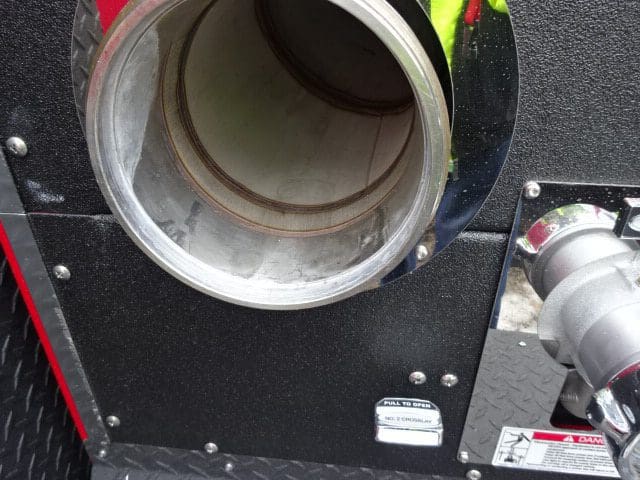

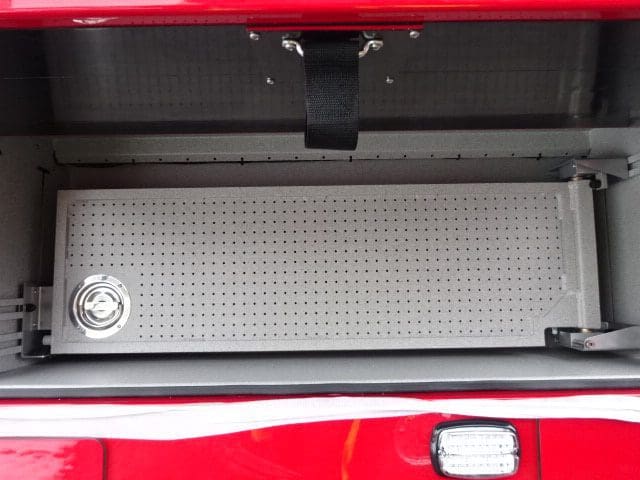

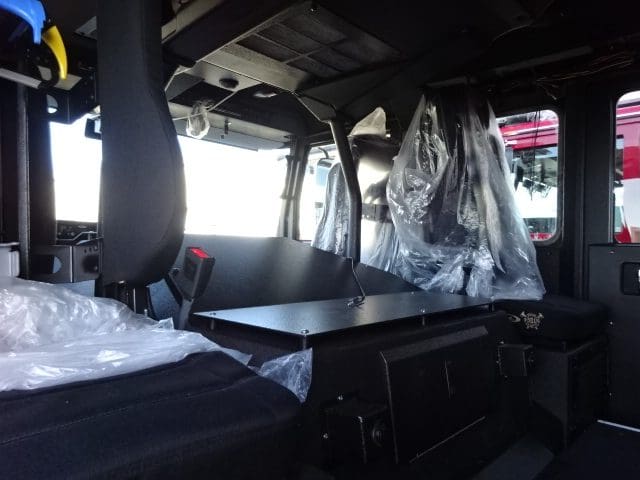

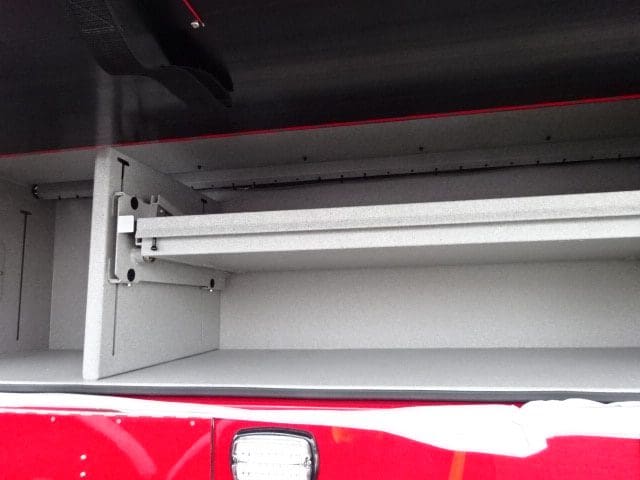

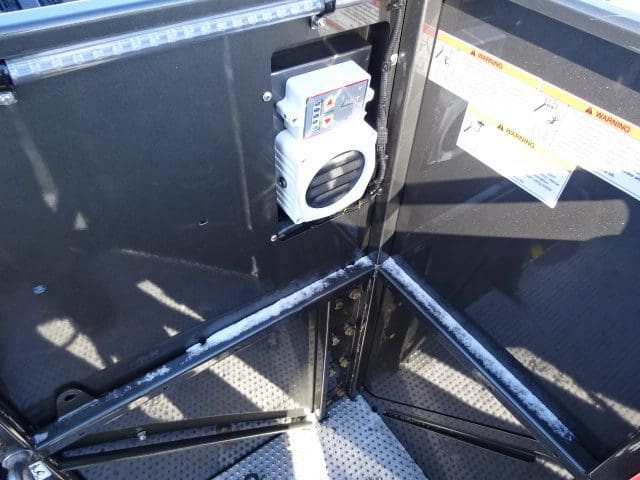

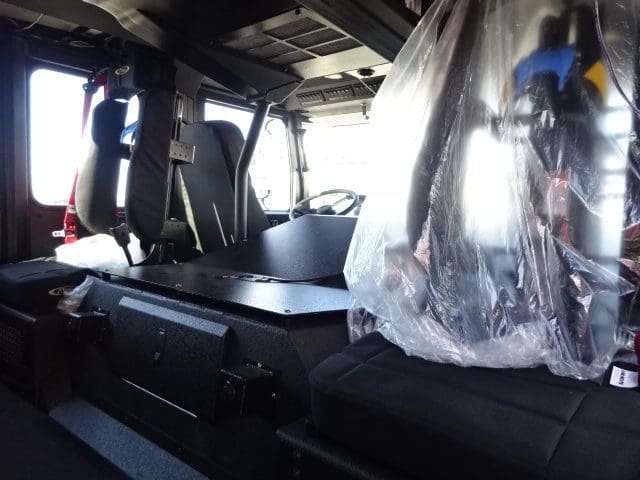

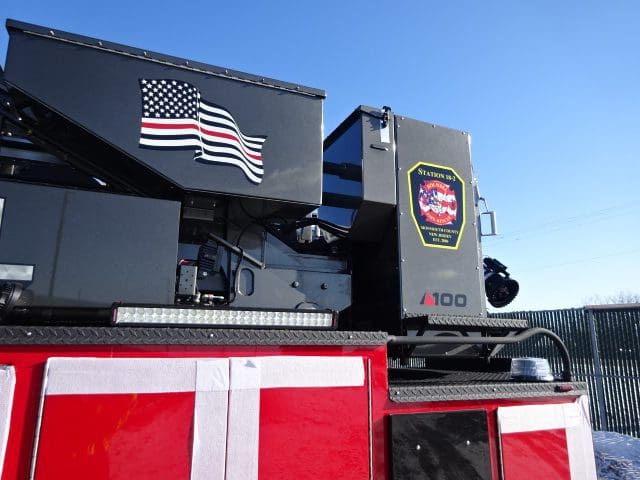

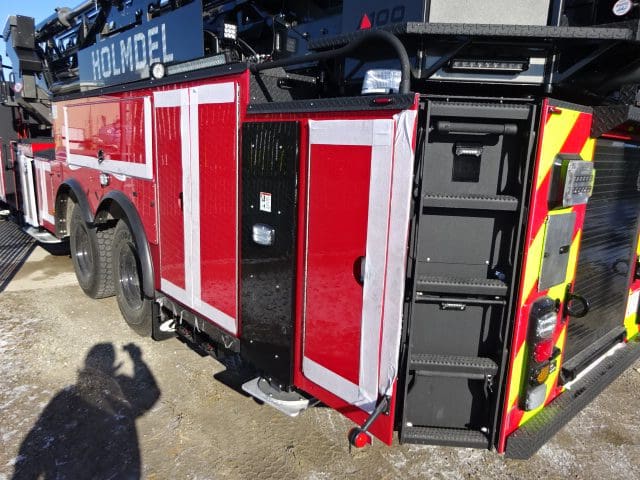

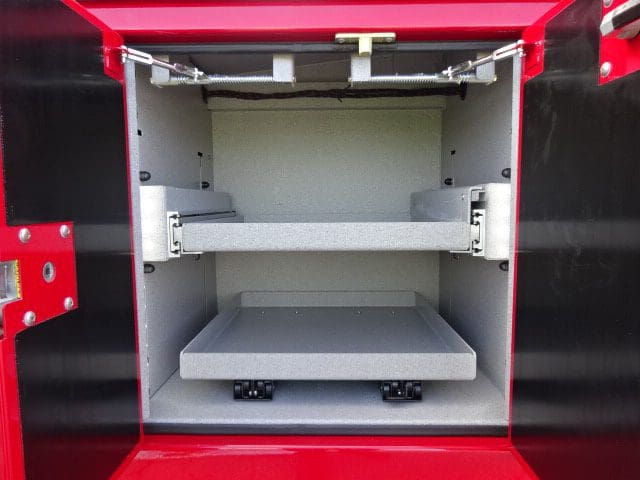

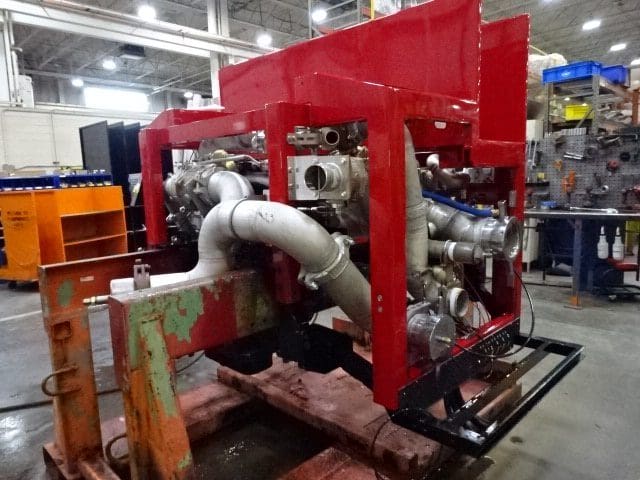

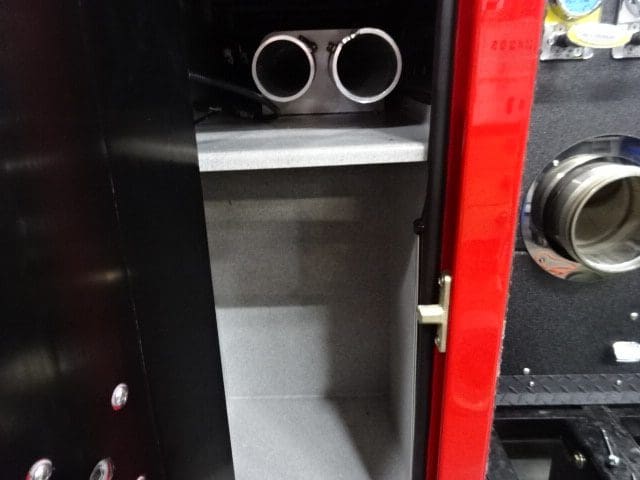

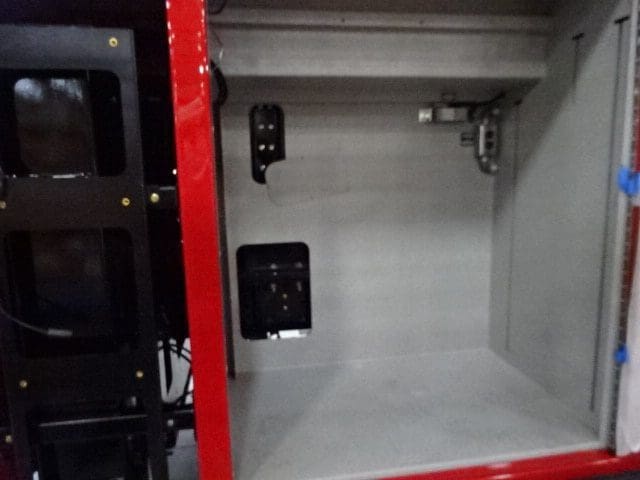

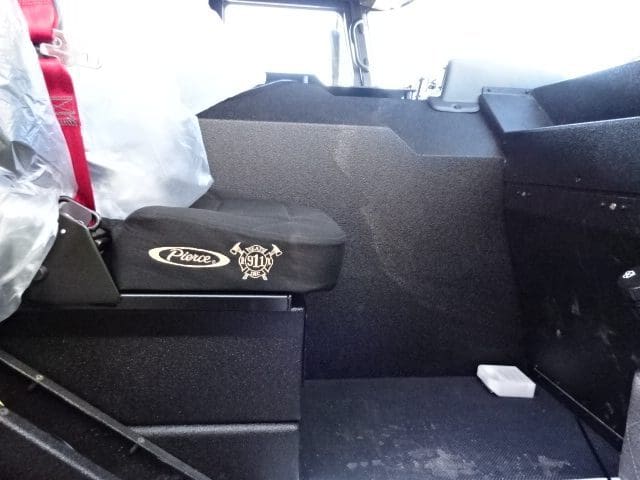

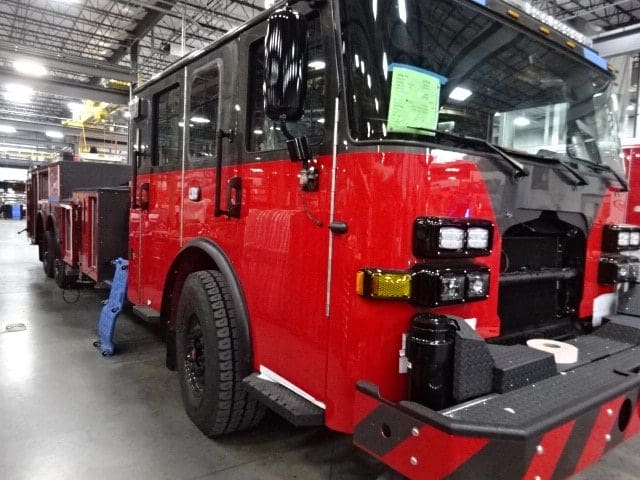

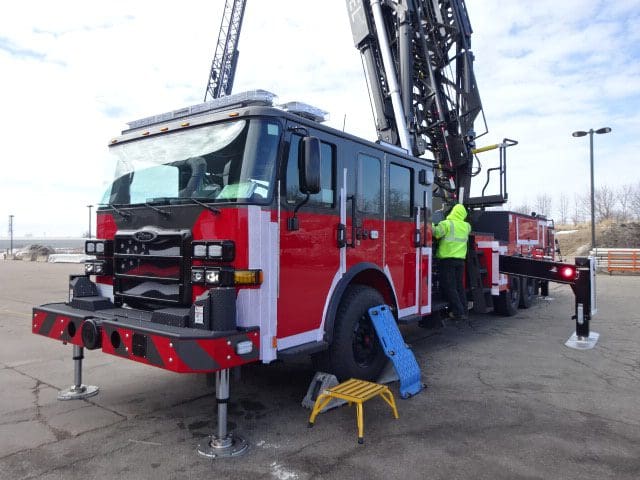

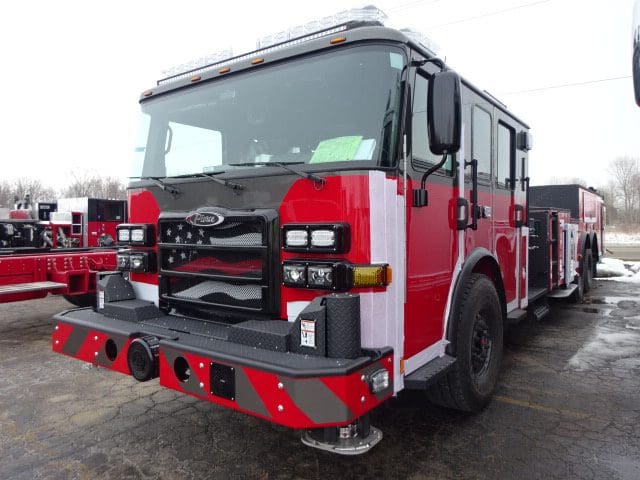

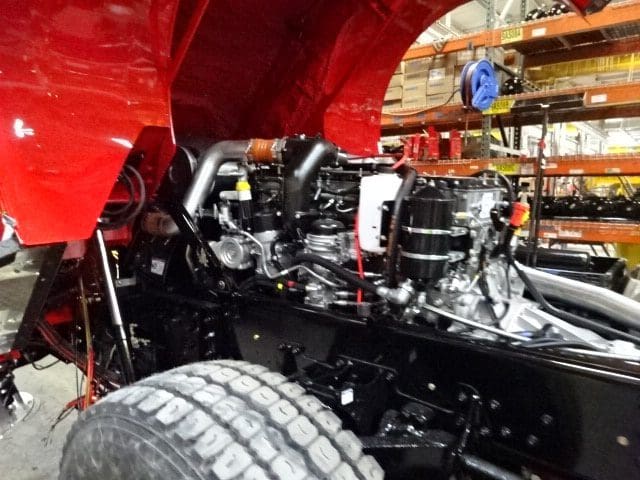

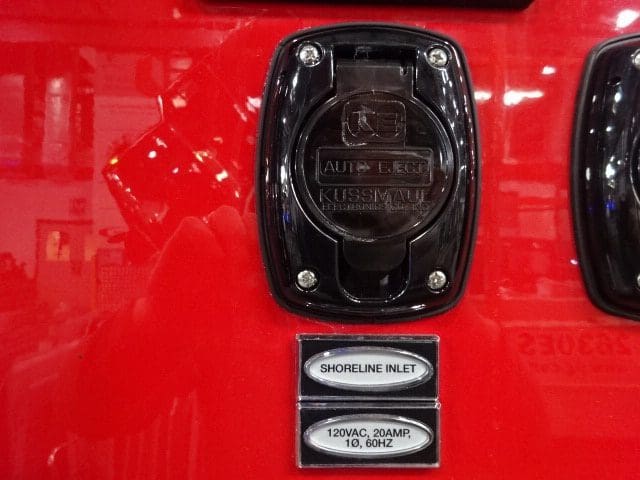

In this report, the apparatus completed aerial testing and released to quality. Once complete it will release to graphics where any remaining content will be applied. It will then be made ready for final inspection. This is the last scheduled report.
03-17-23

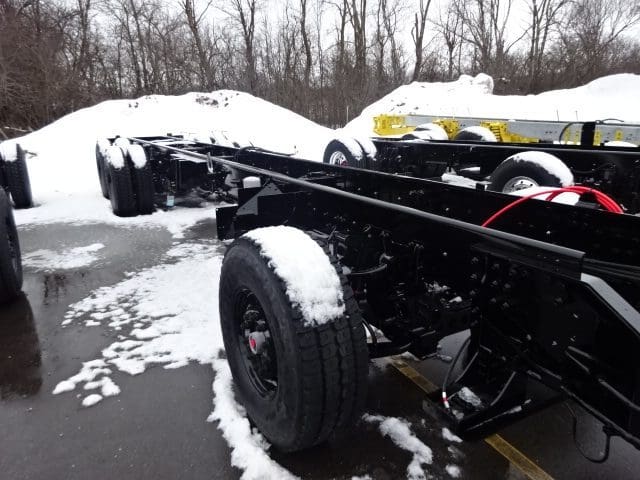

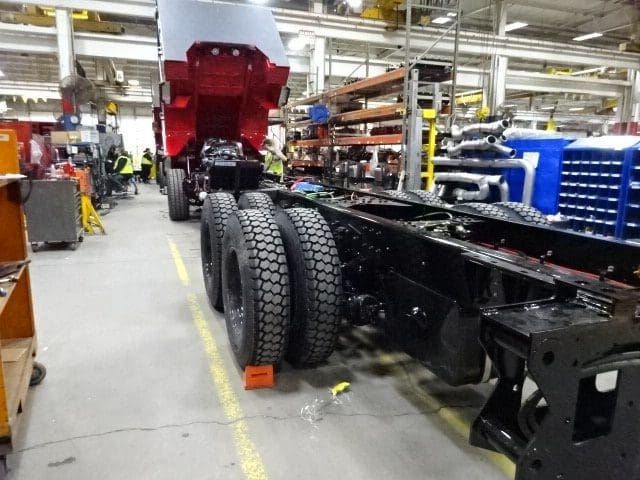

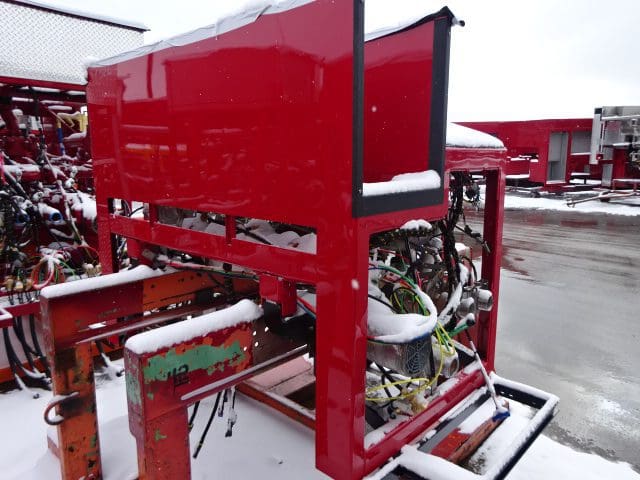

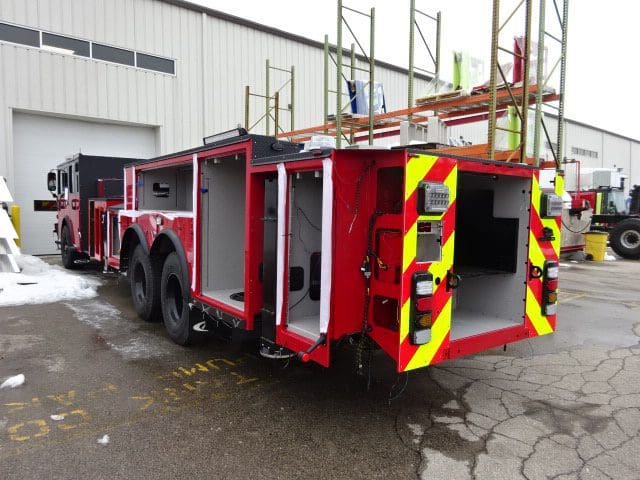

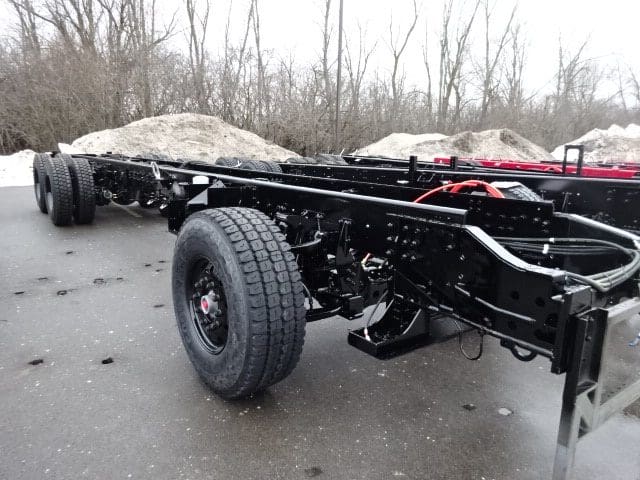

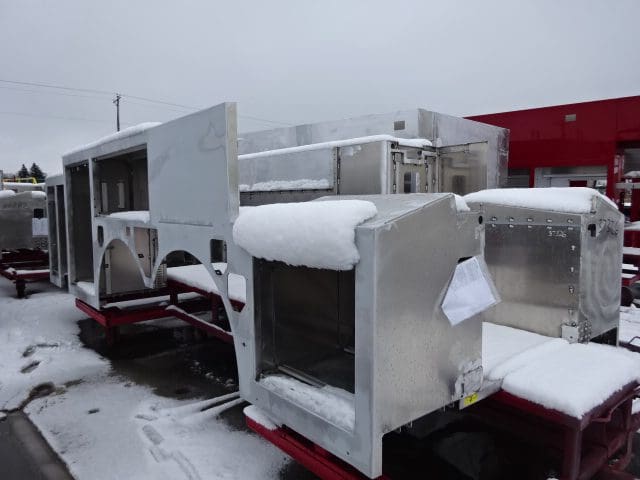

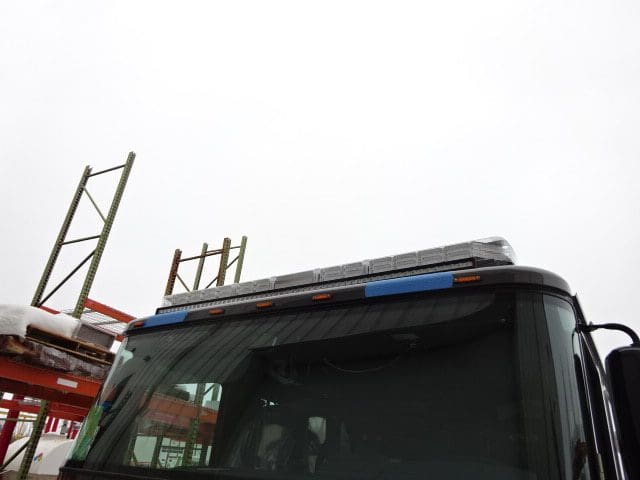

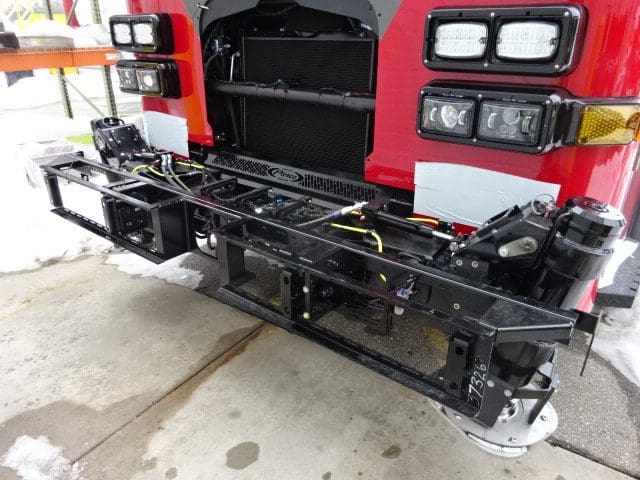

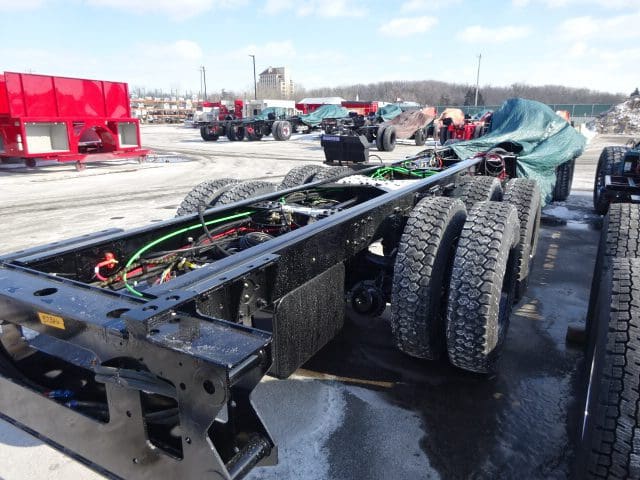

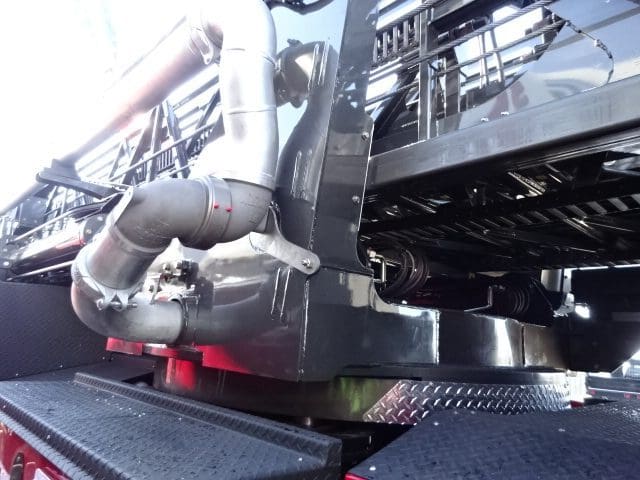

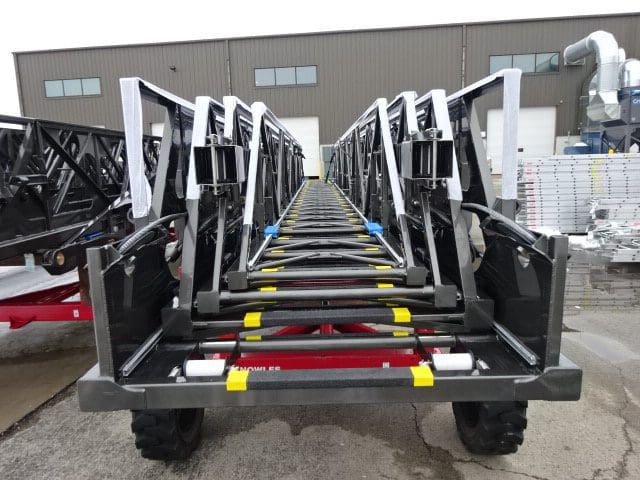

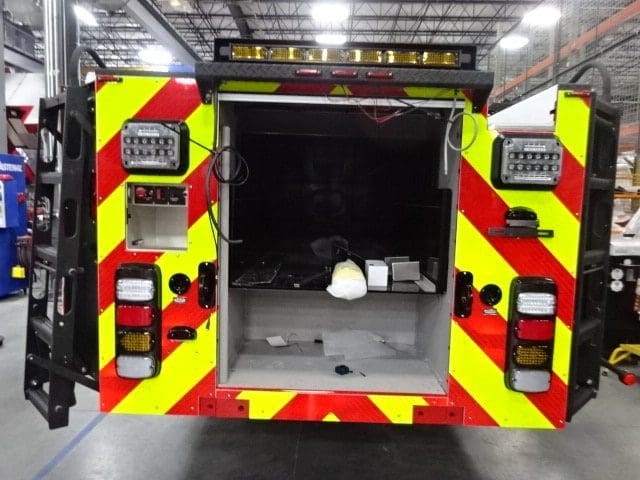

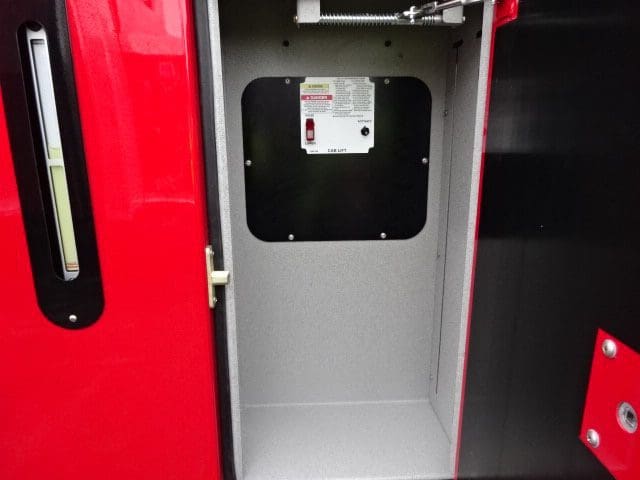

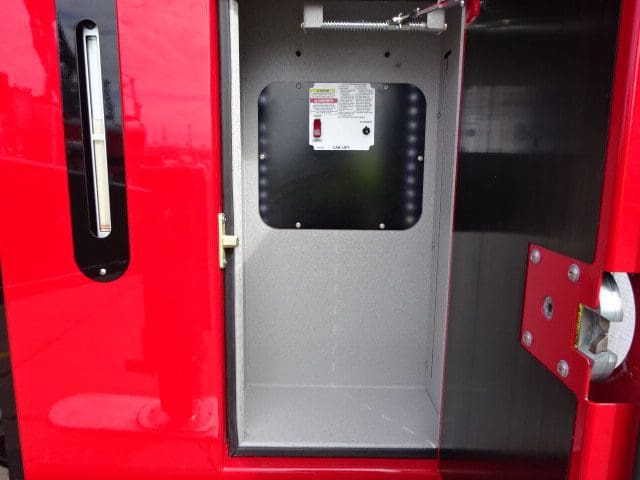

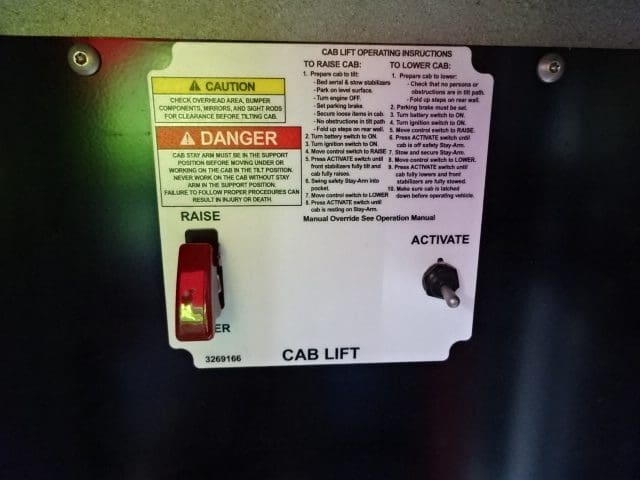

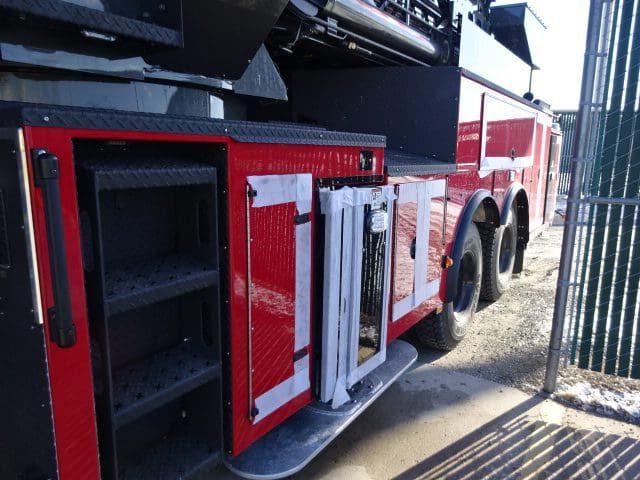

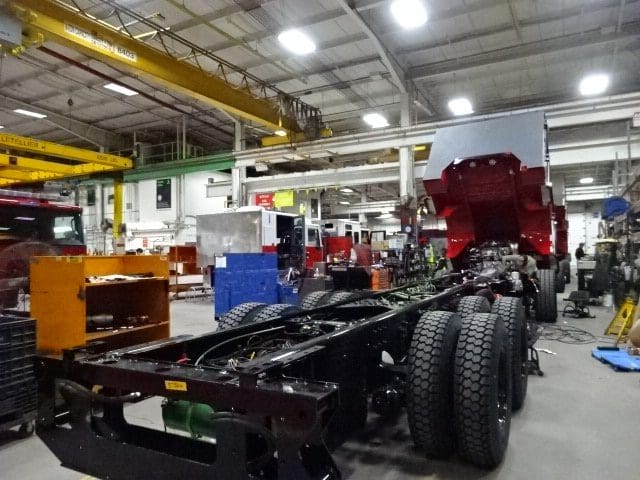

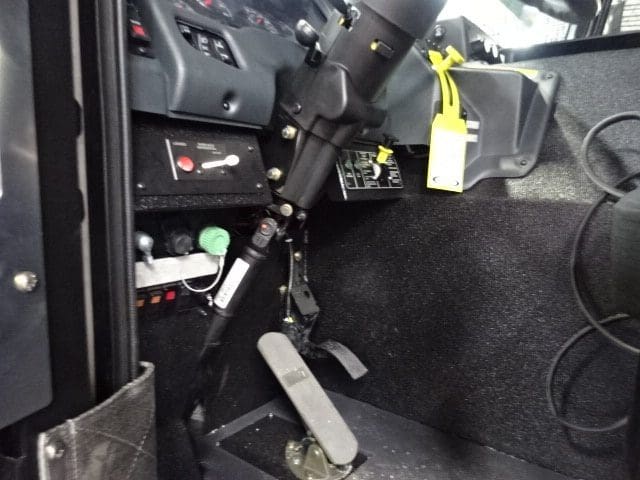

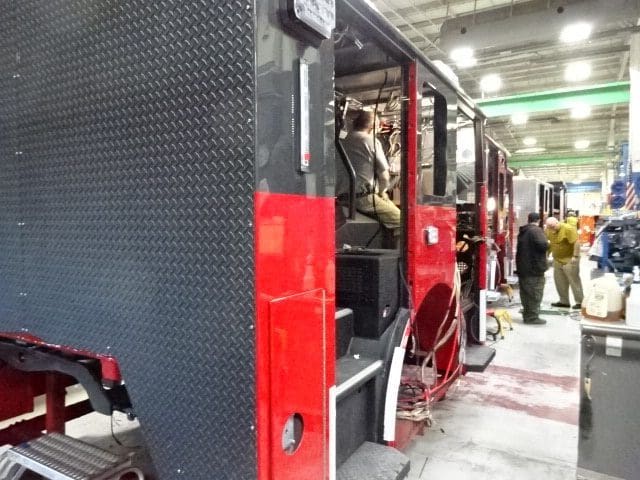

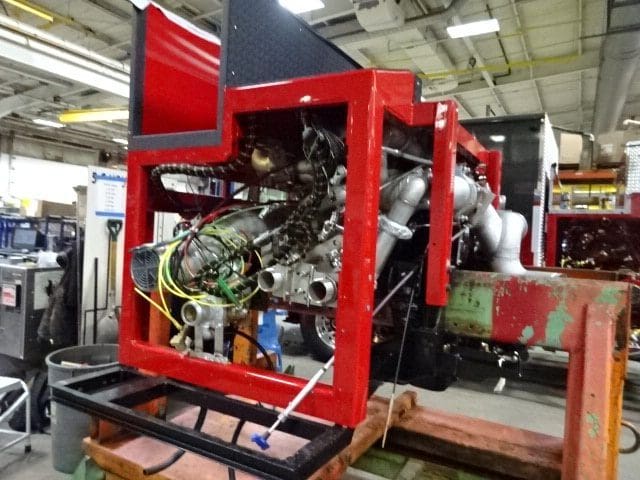

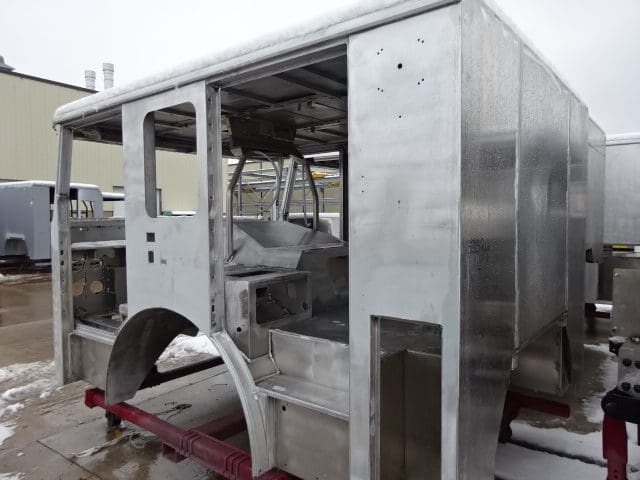

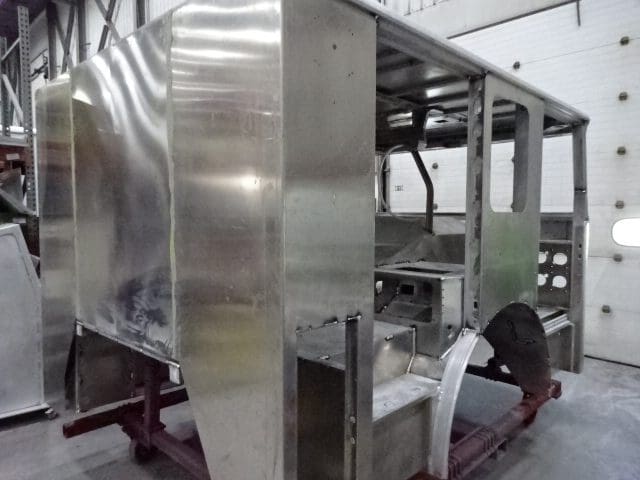

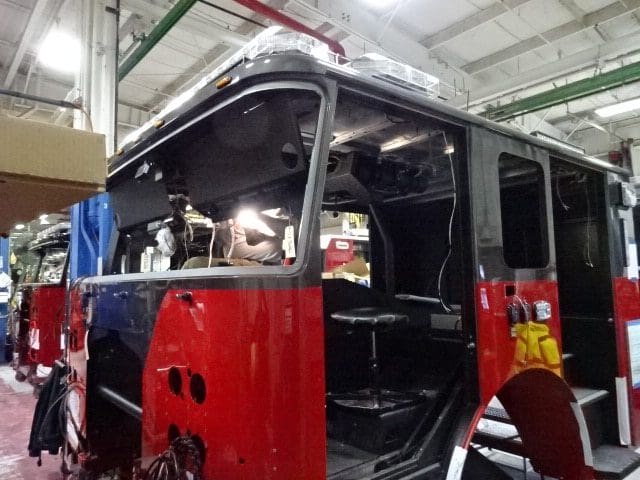

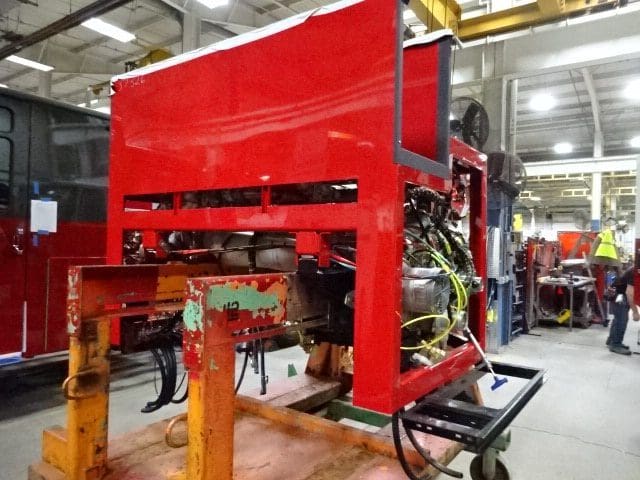

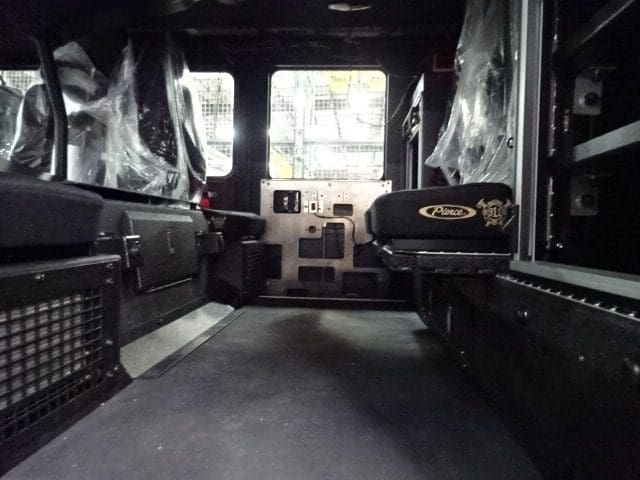

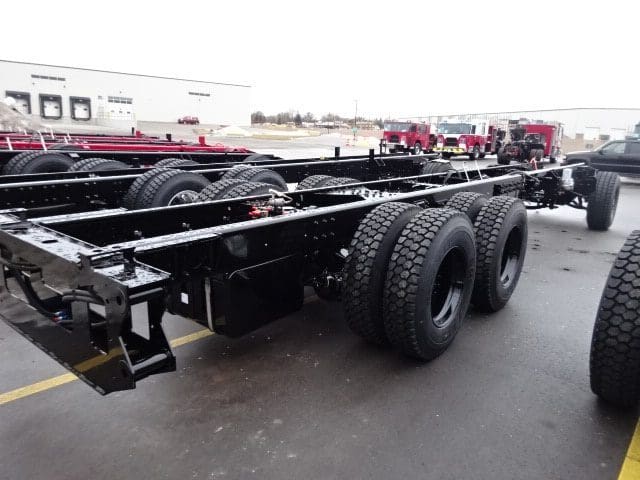

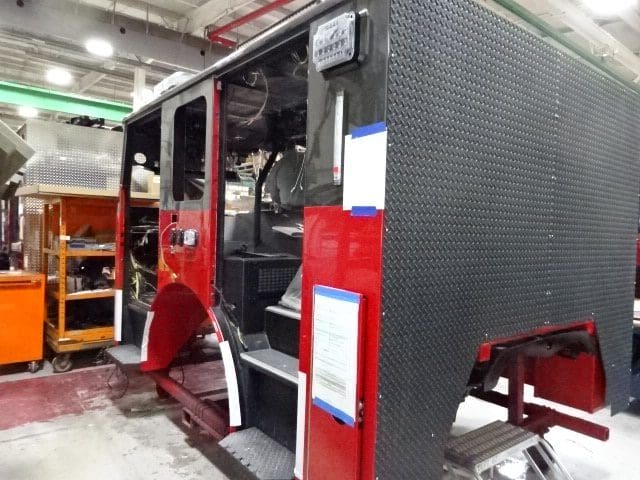

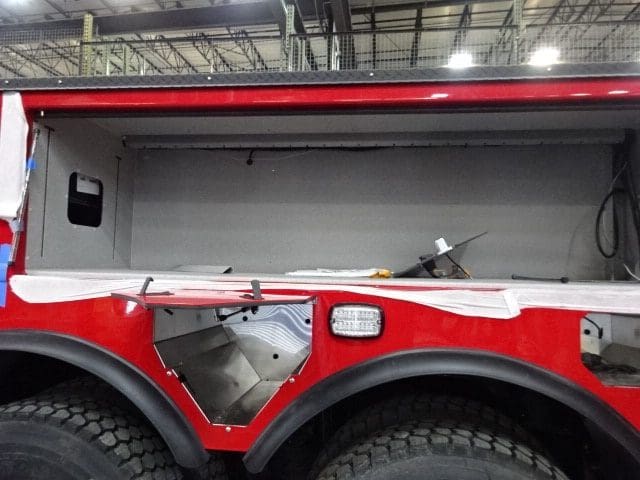

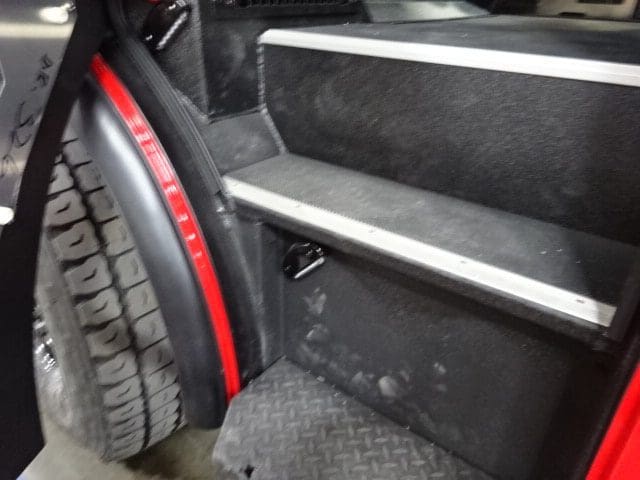

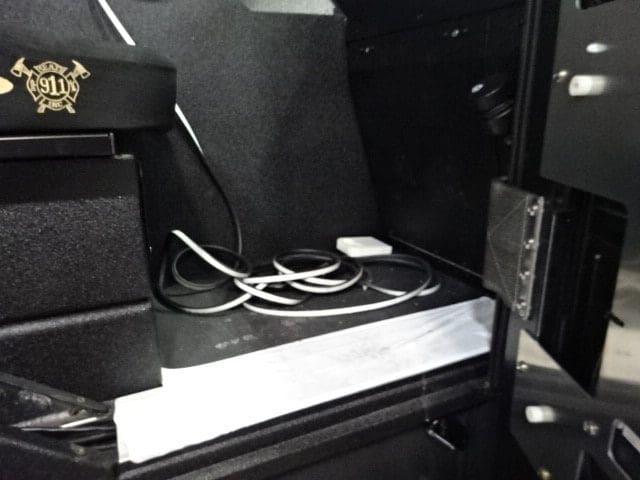

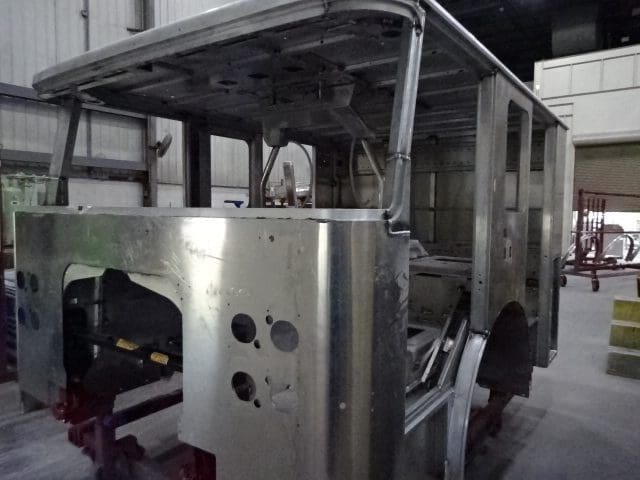

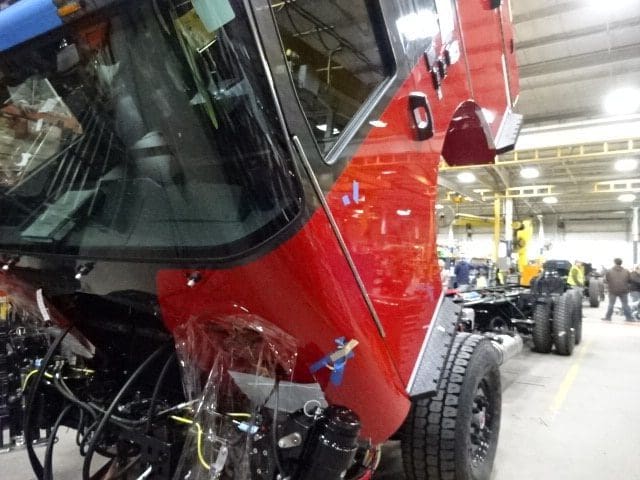

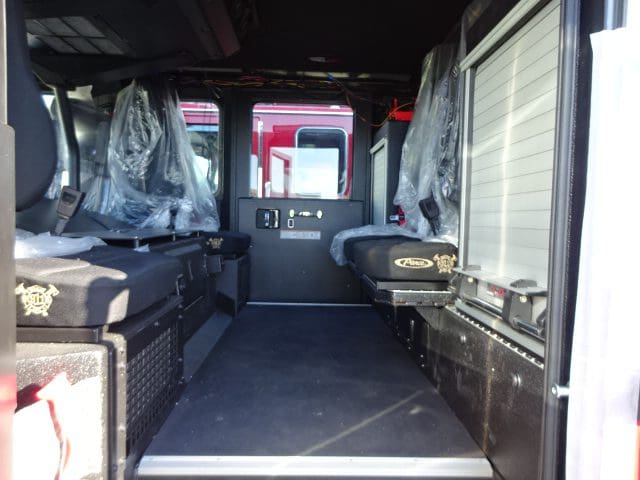

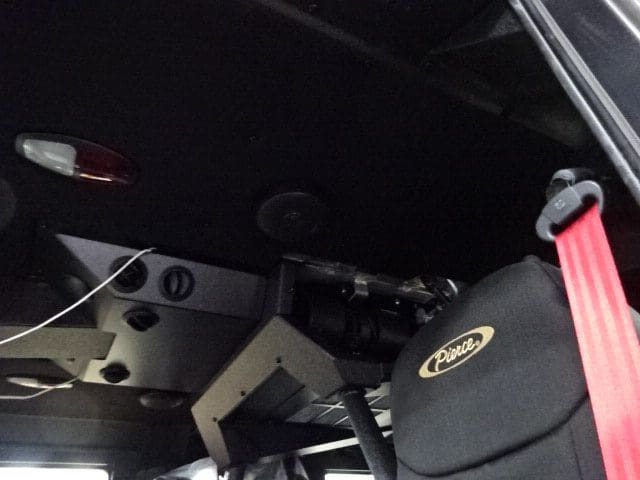

The apparatus completed final assembly and is staged while the aerial device started assembly.

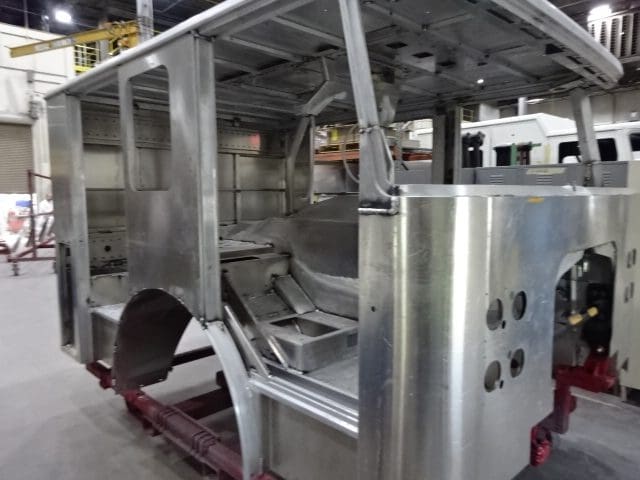

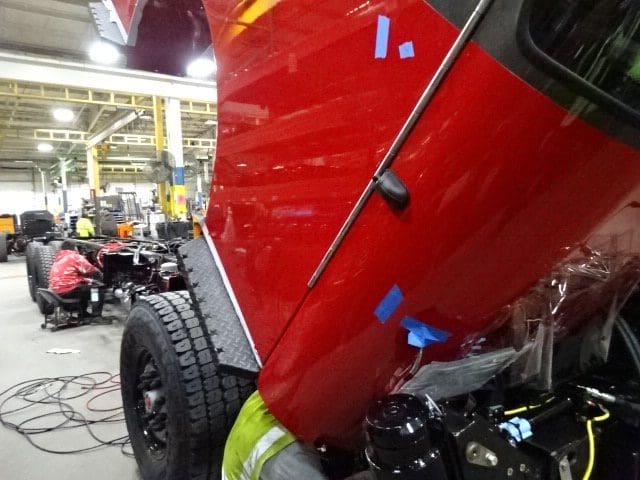

02-10-23

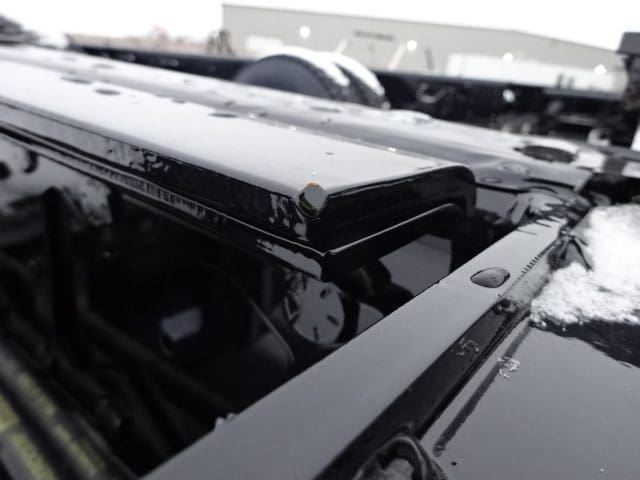

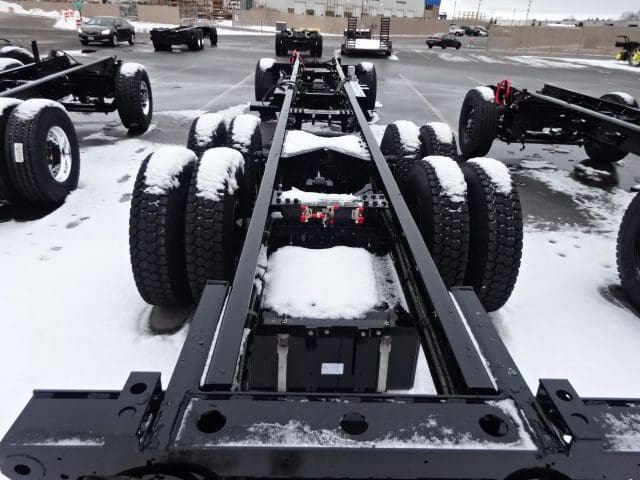

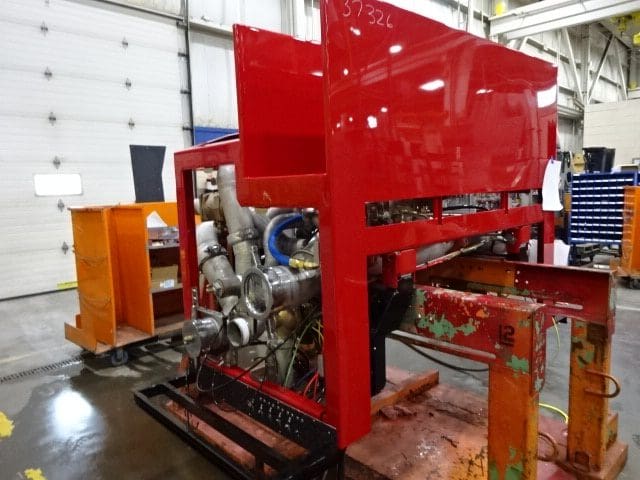

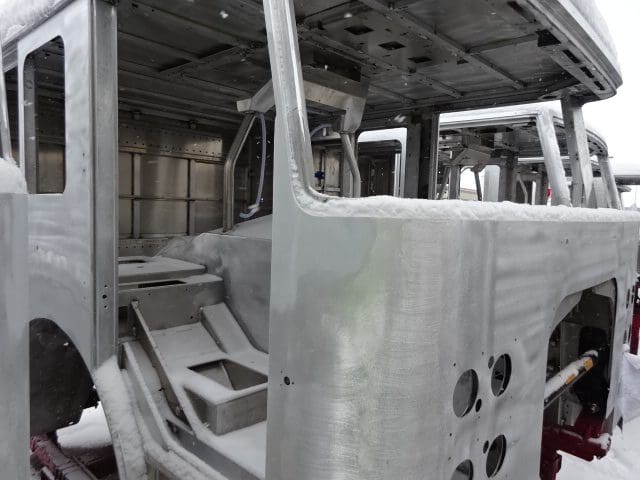

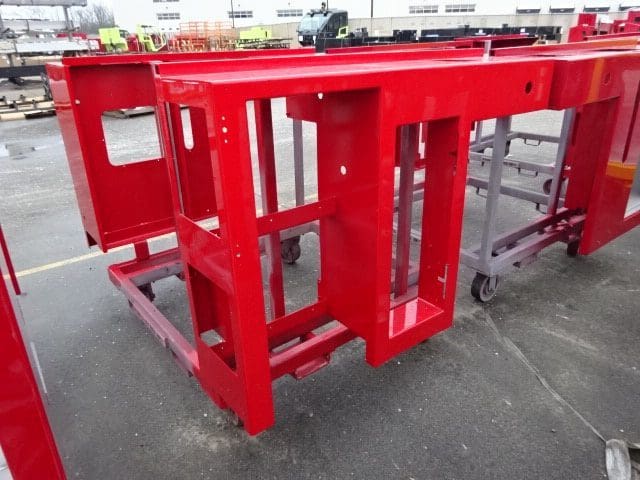

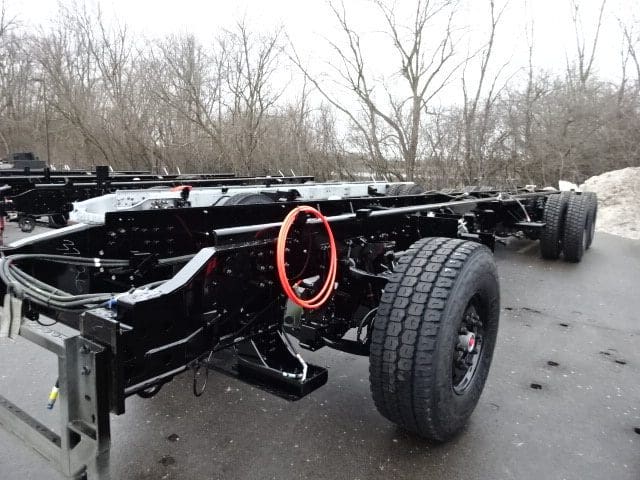

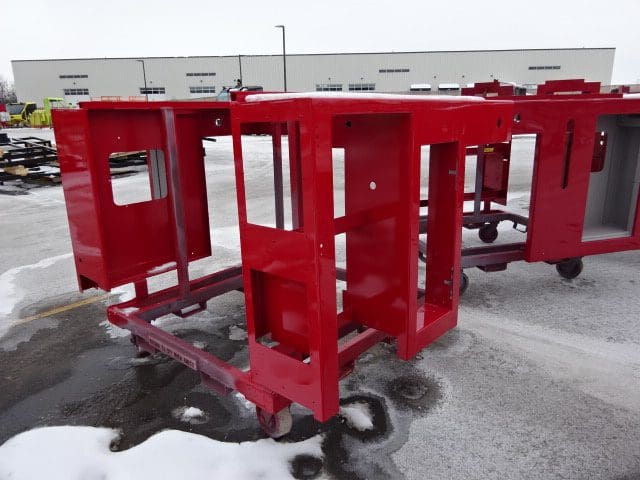

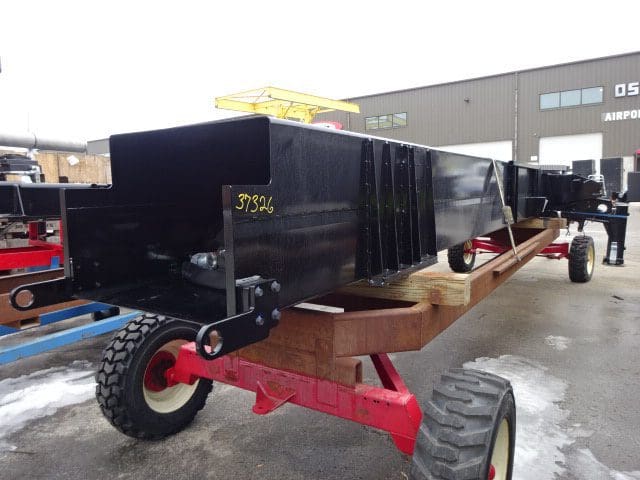

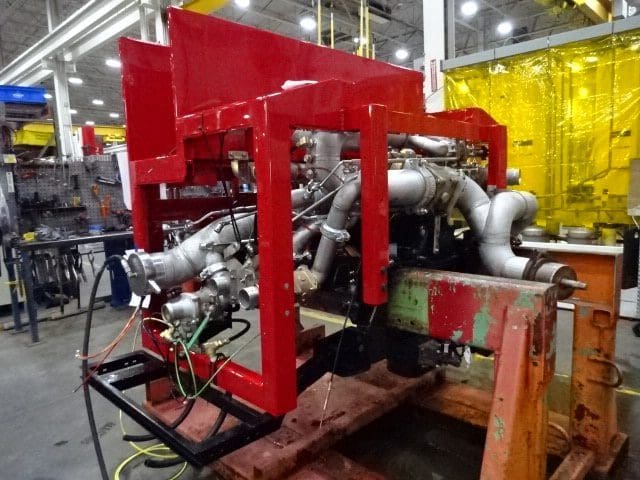

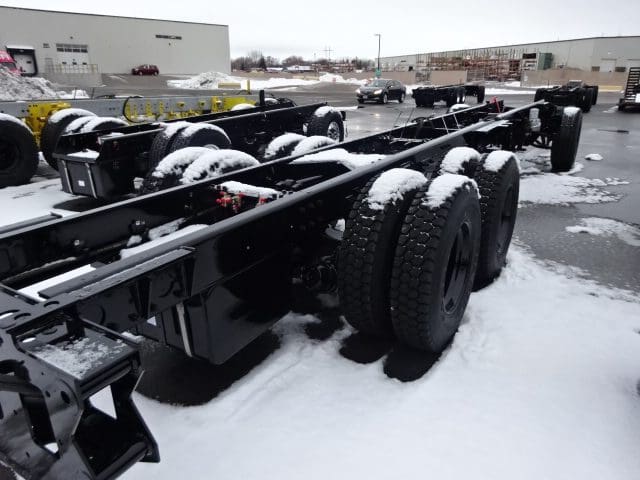

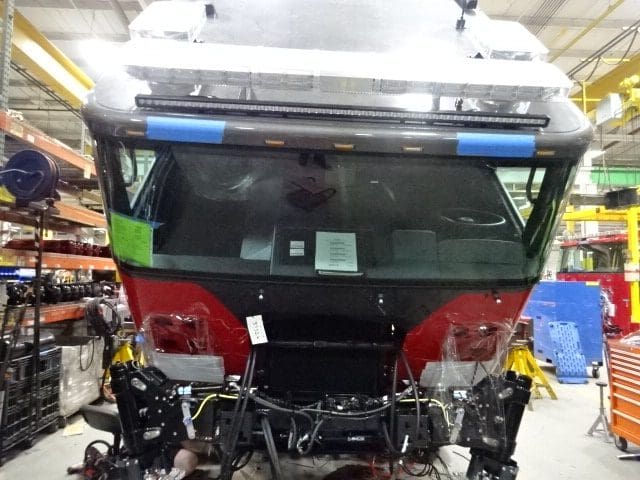

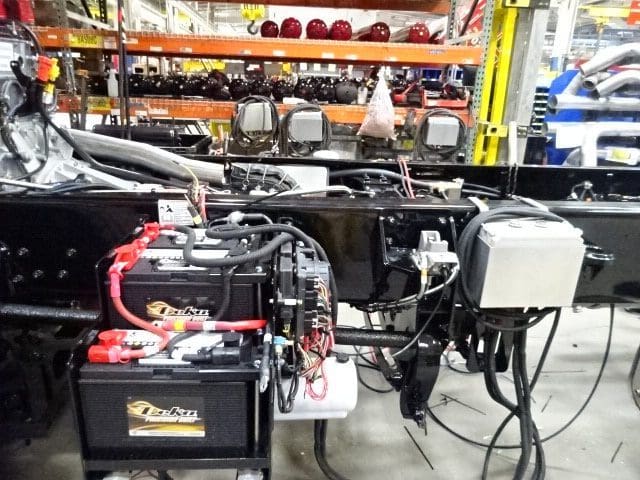

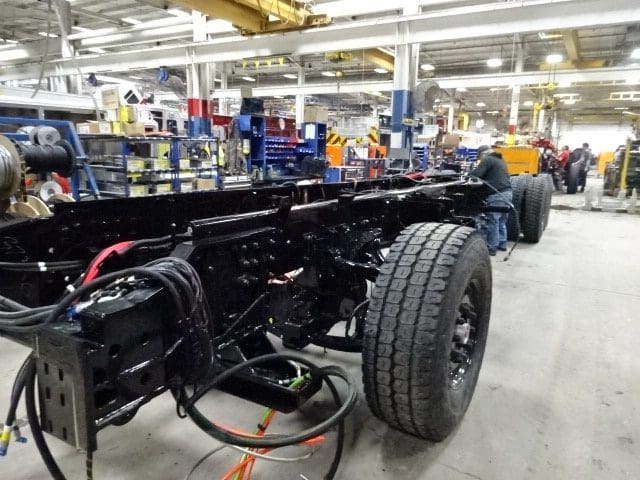

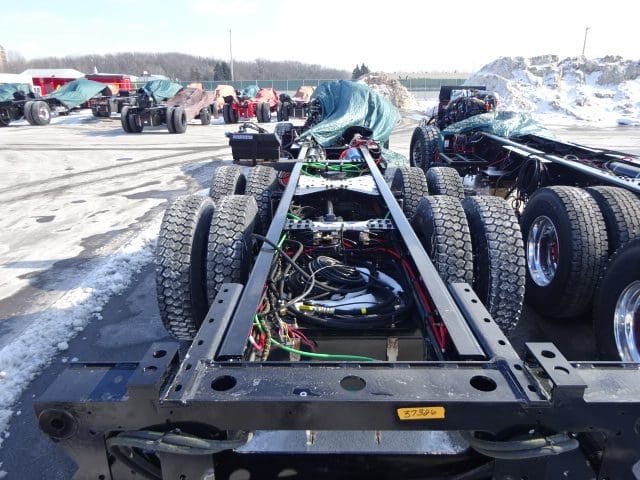

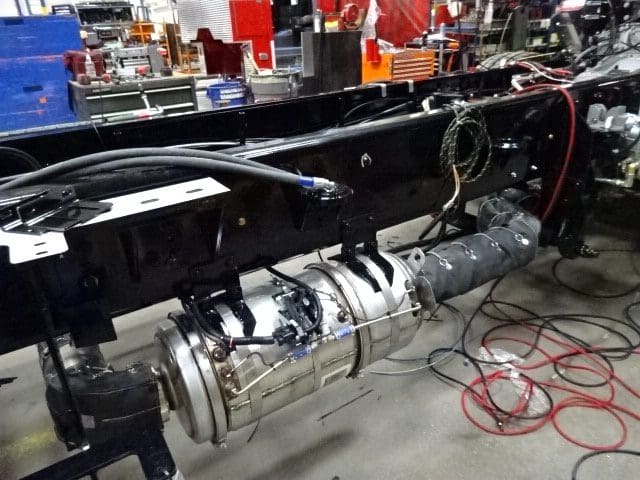

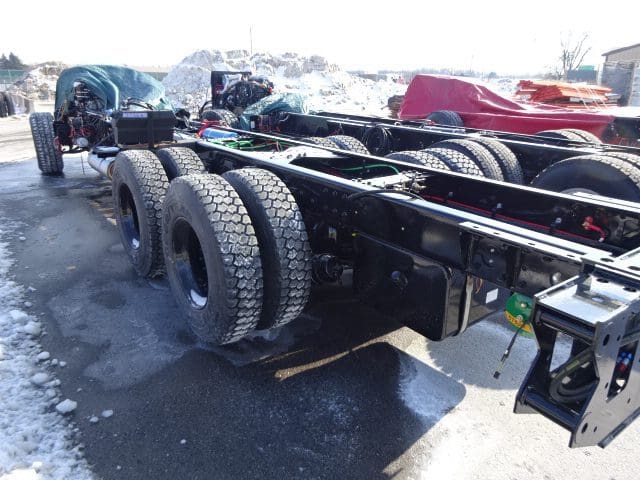

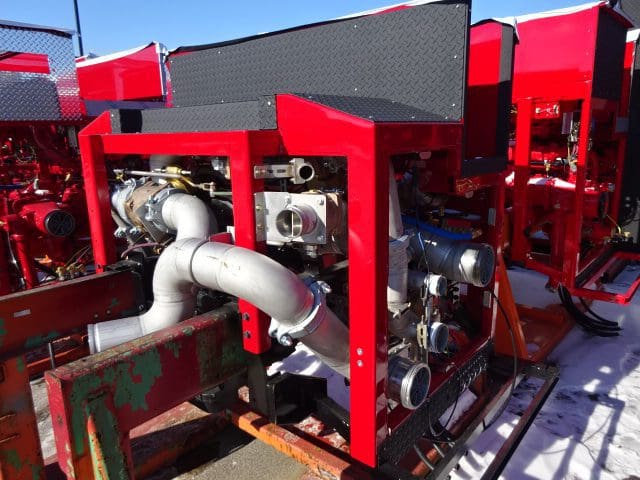

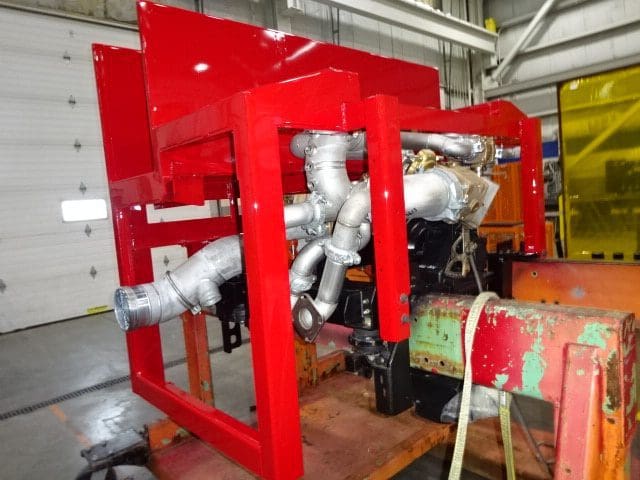

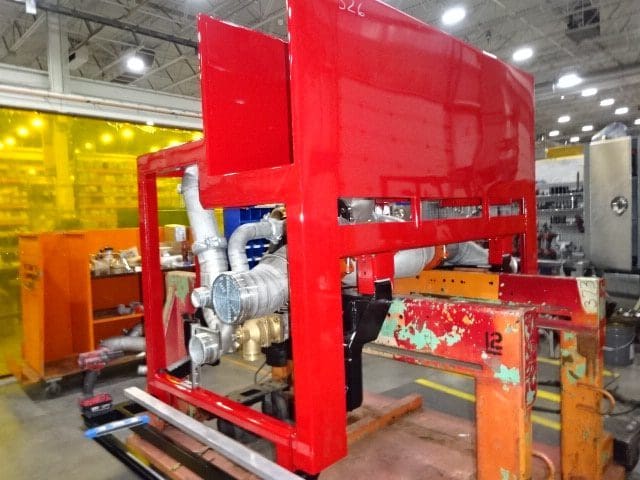

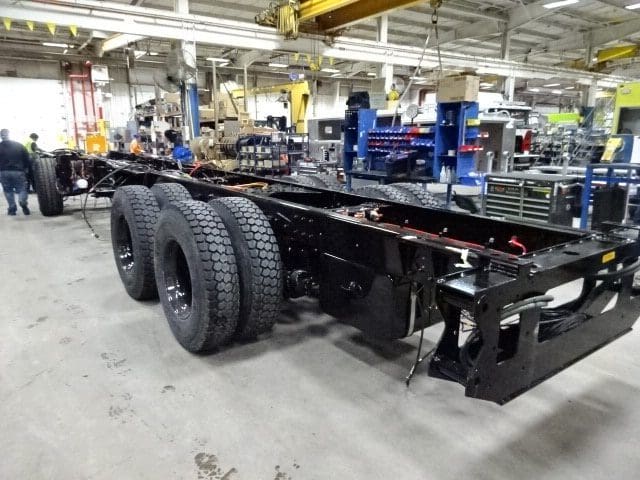

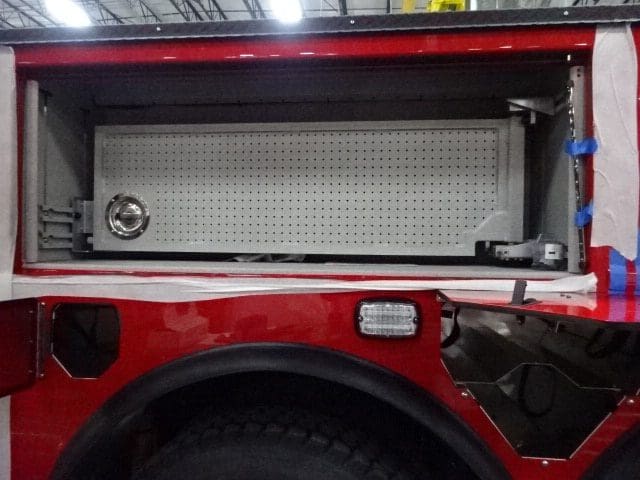

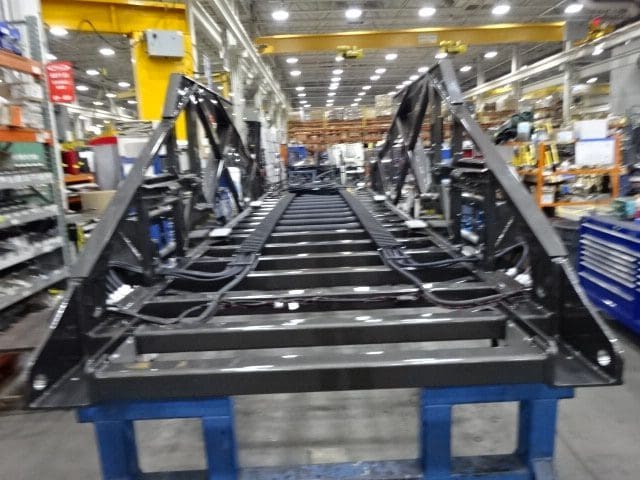

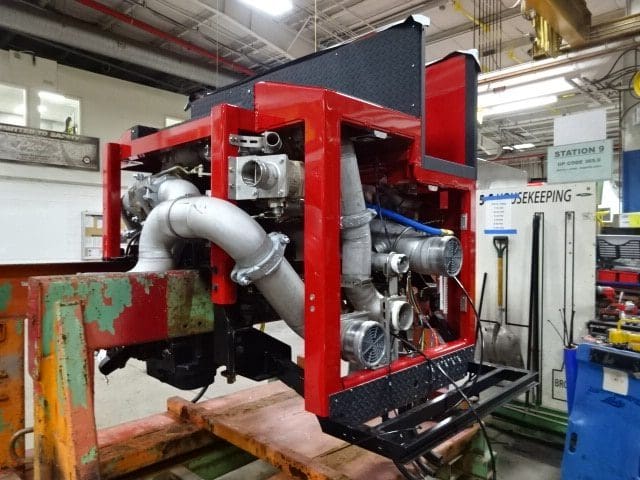

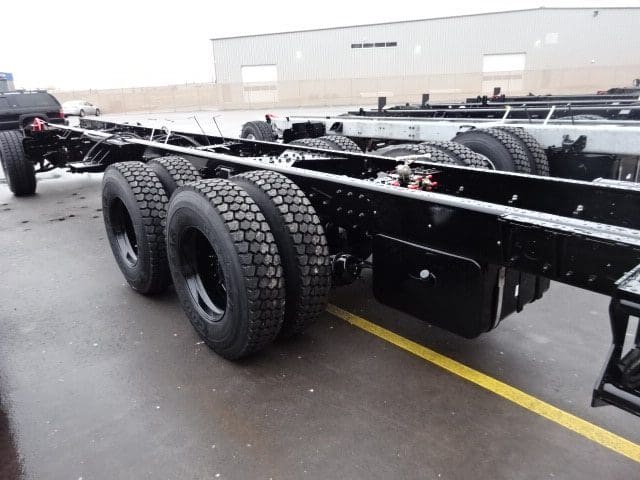

The cab was installed on the frame, while the pump house and both body modules remain staged, and the torque box started initial assembly.

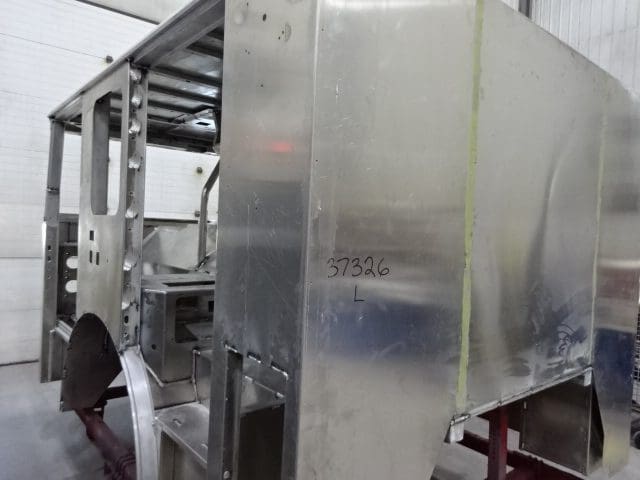

02-03-23

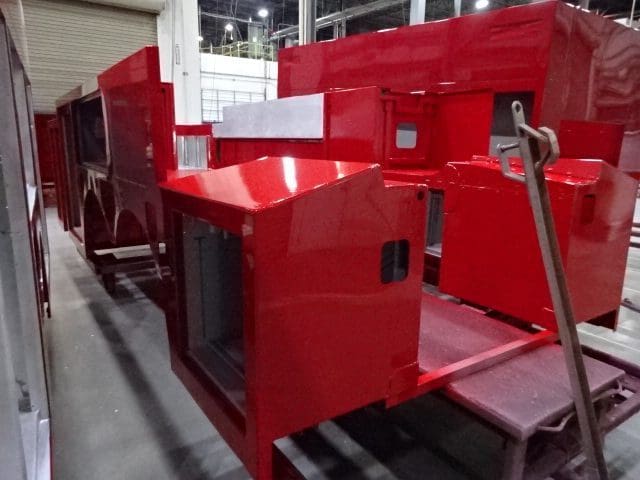

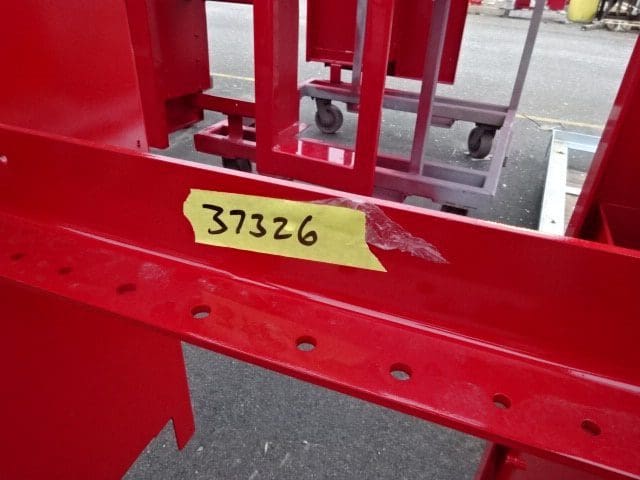

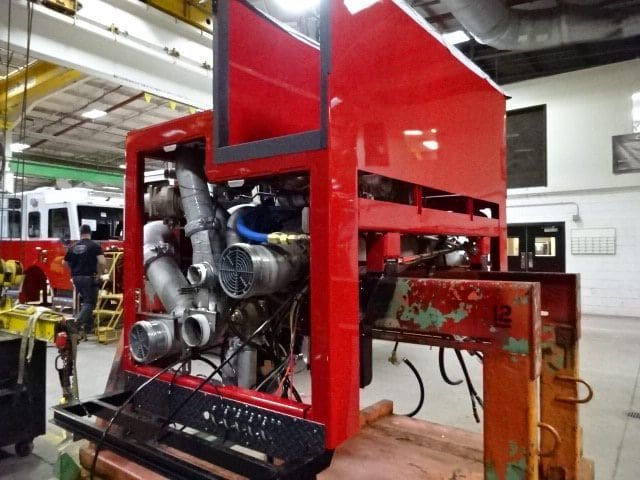

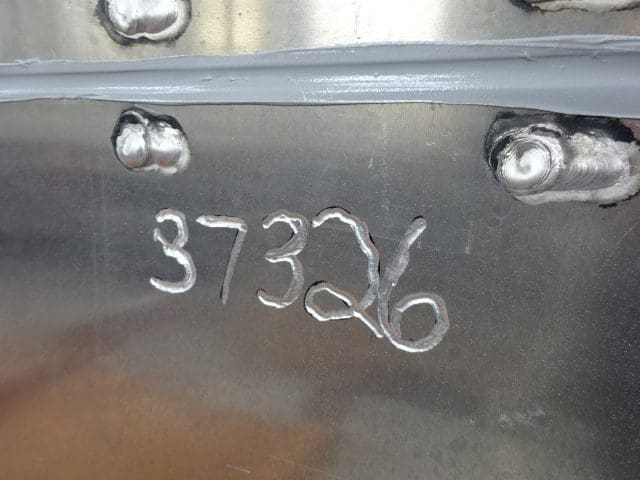

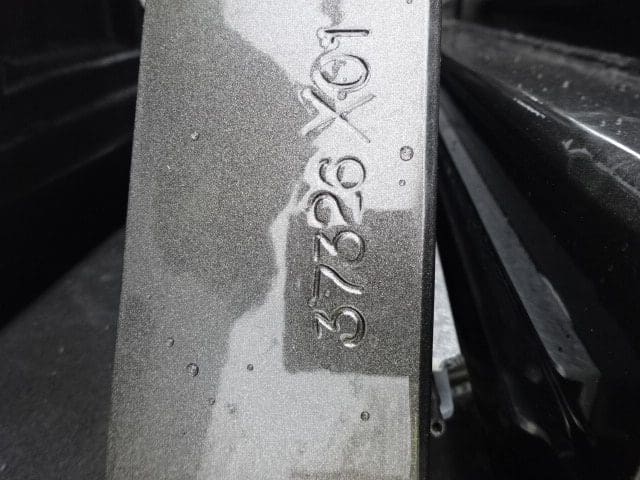

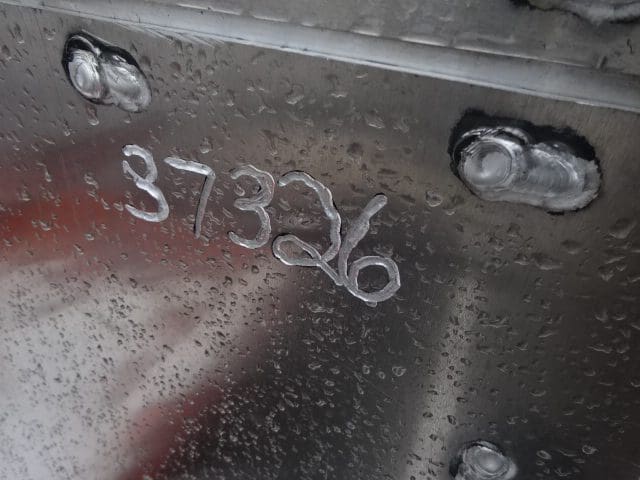

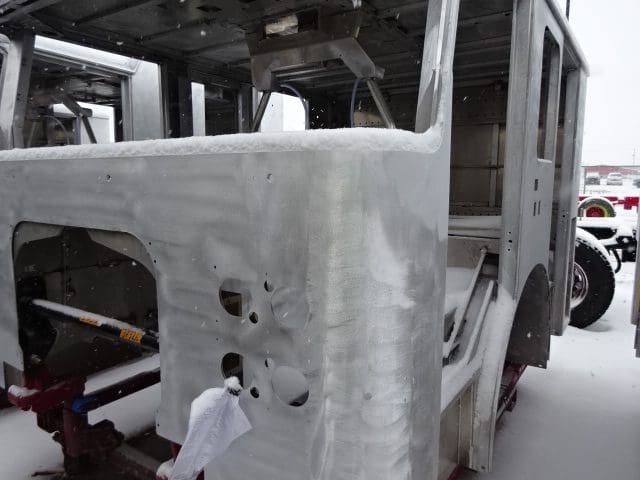

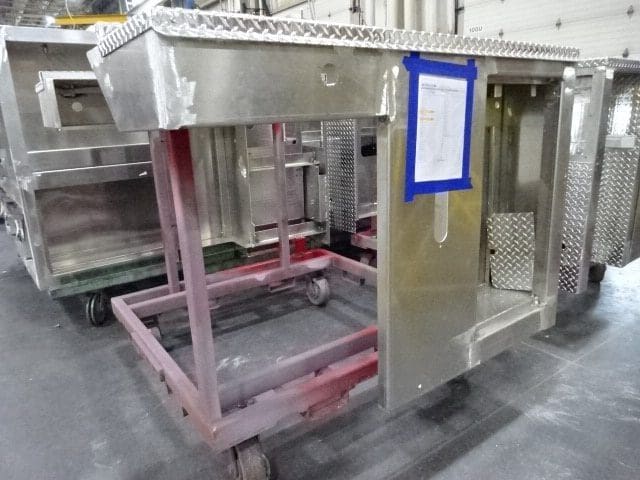

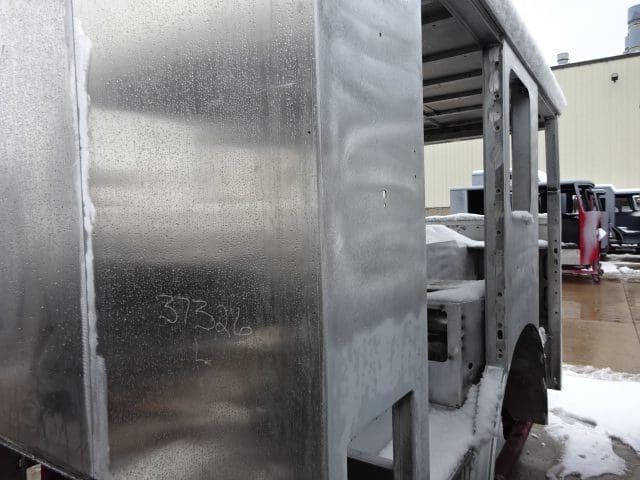

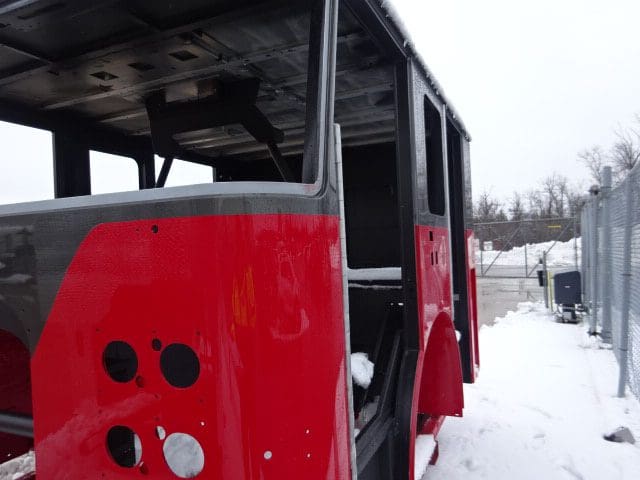

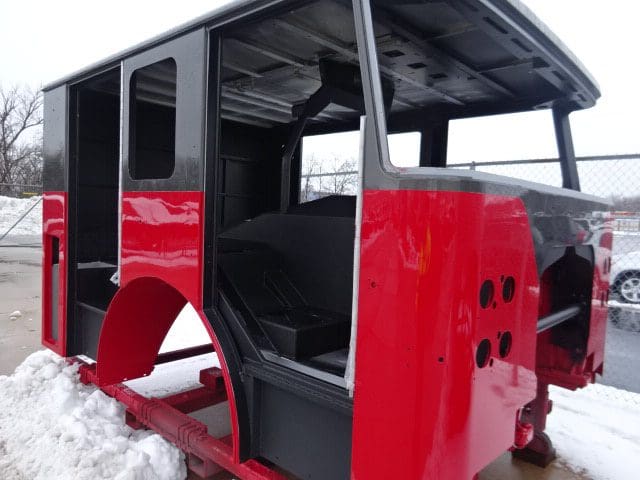

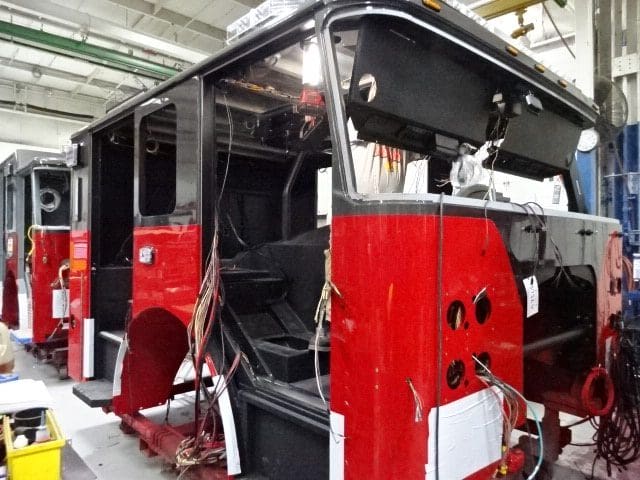

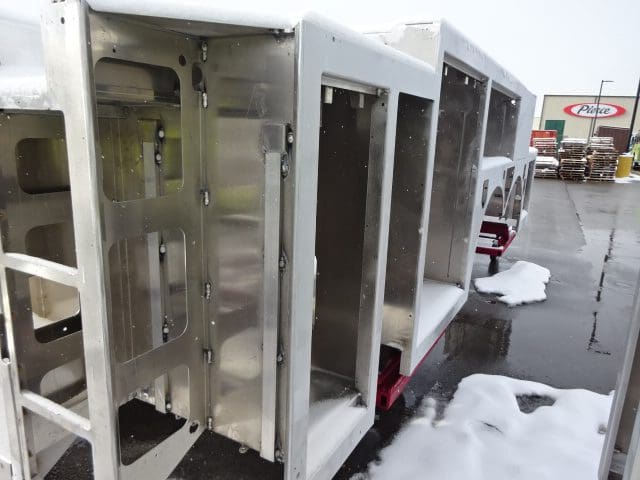

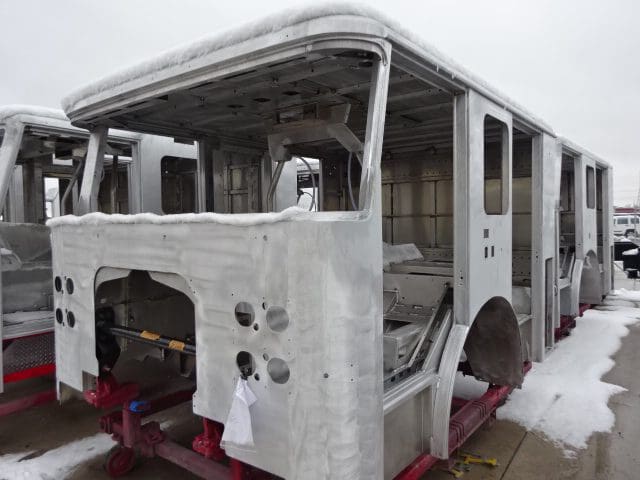

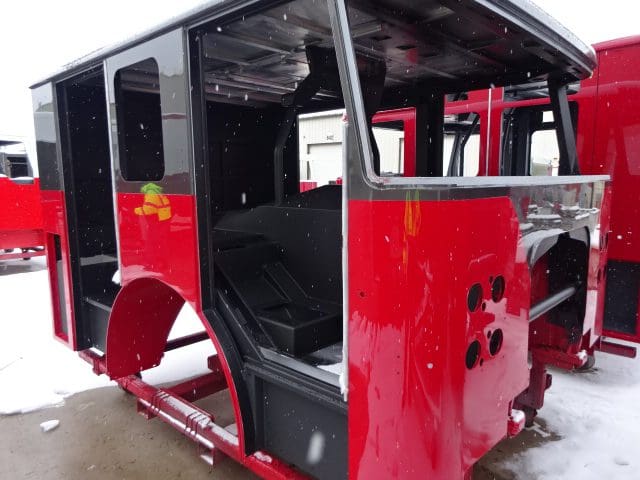

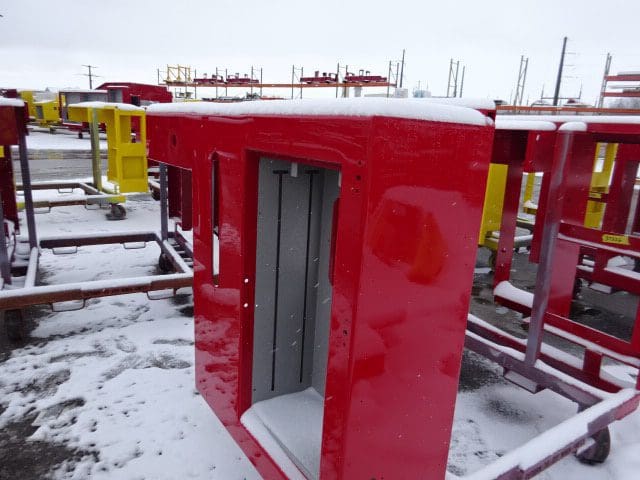

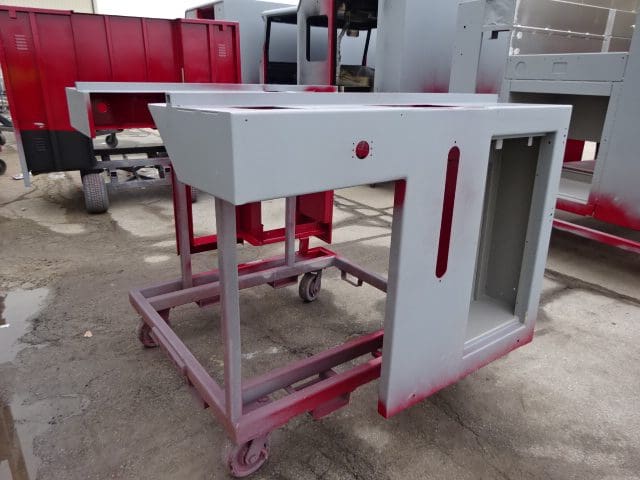

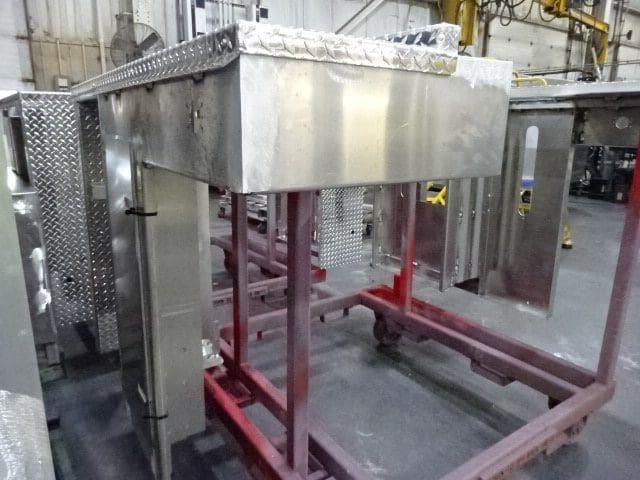

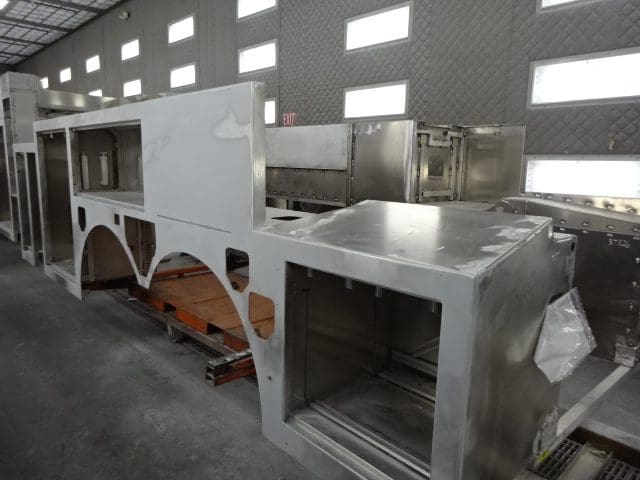

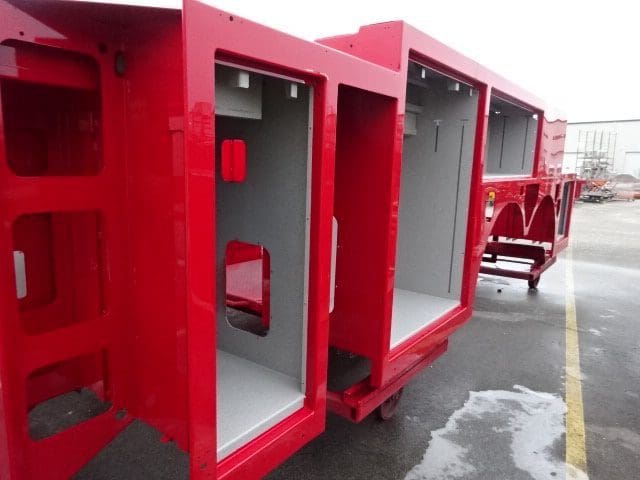

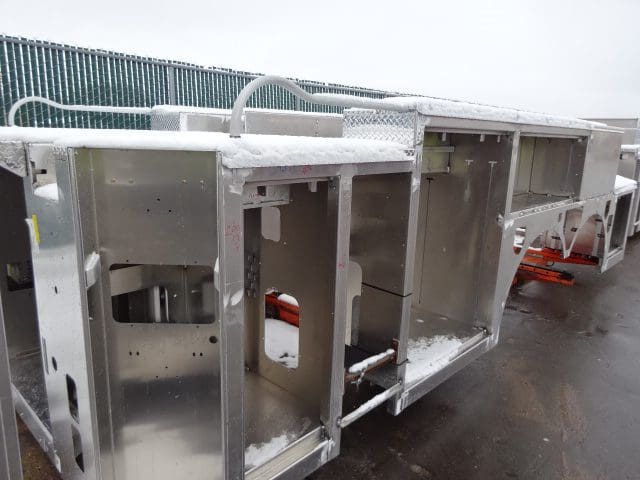

The cab started initial assembly, the frame build continued, the pump house and forward body modules remain staged, and the rear body module completed the paint process.

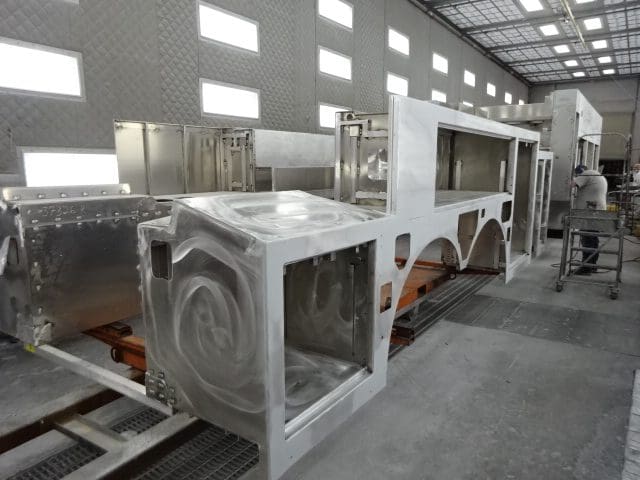

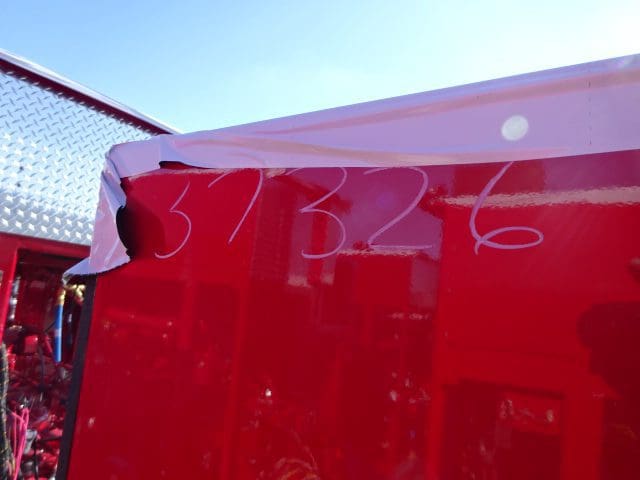

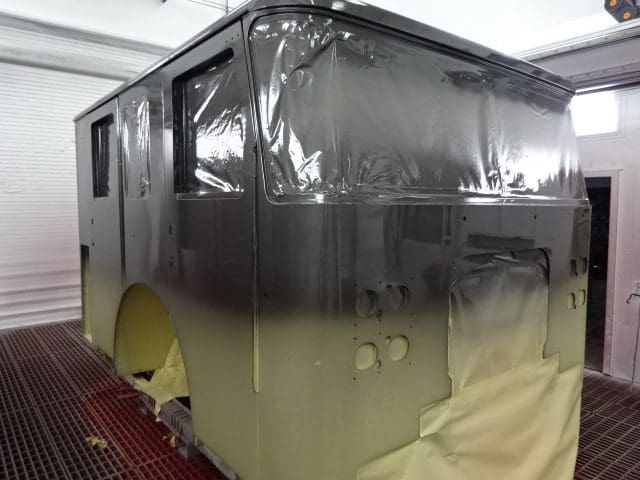

01-27-23

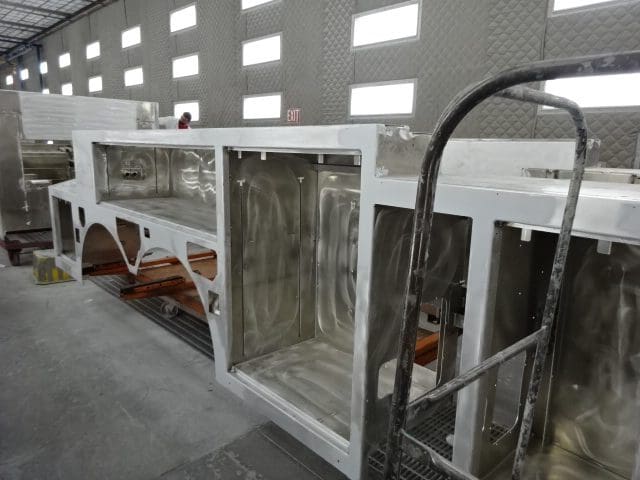

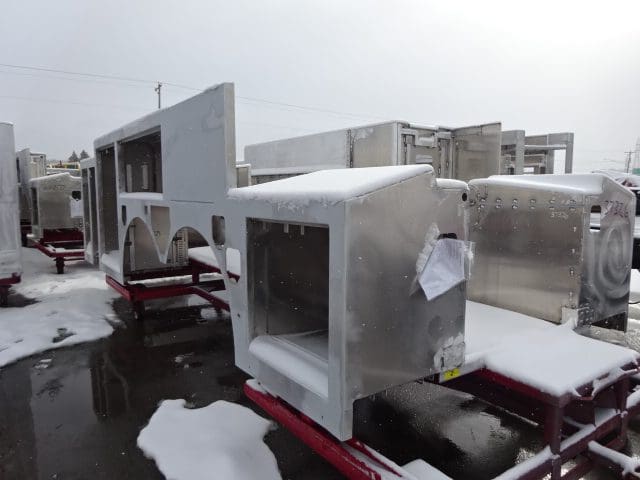

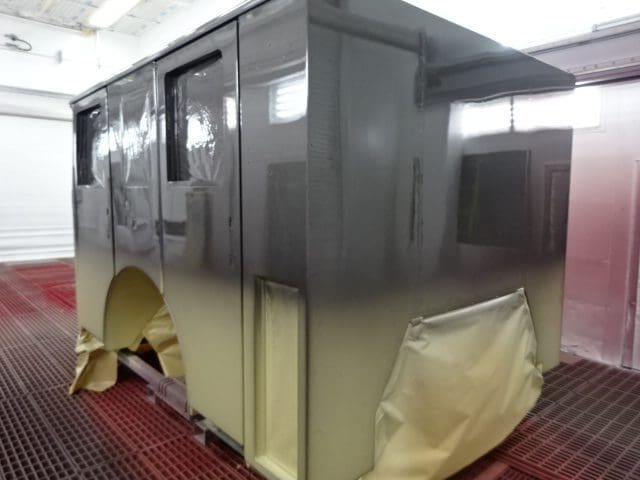

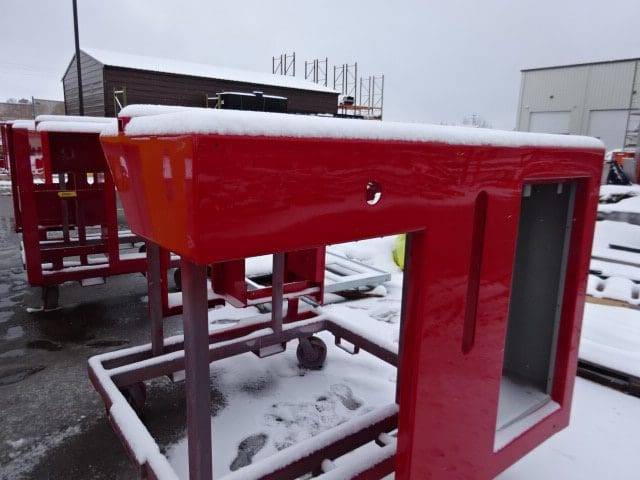

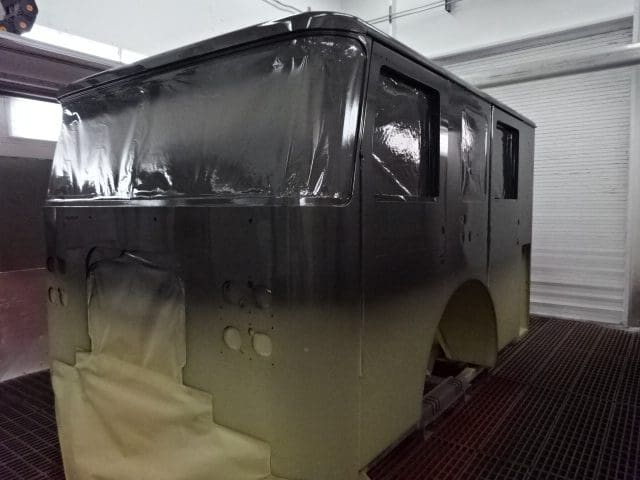

The cab remained staged, the frame build continued, the pump house is staged, the forward body module completed paint, and the rear body module continued the paint process.
01-20-23

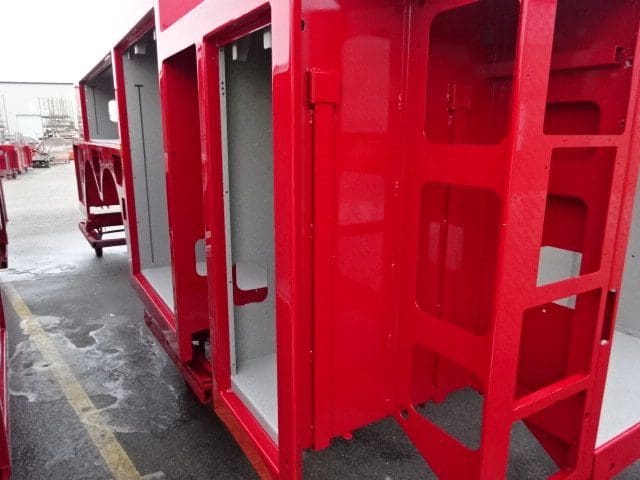

The cab completed paint and is staged for initial assembly, the frame build continued, the pump house completed initial assembly and is staged, the forward body module was unavailable for photos and the rear body module continued the paint process.

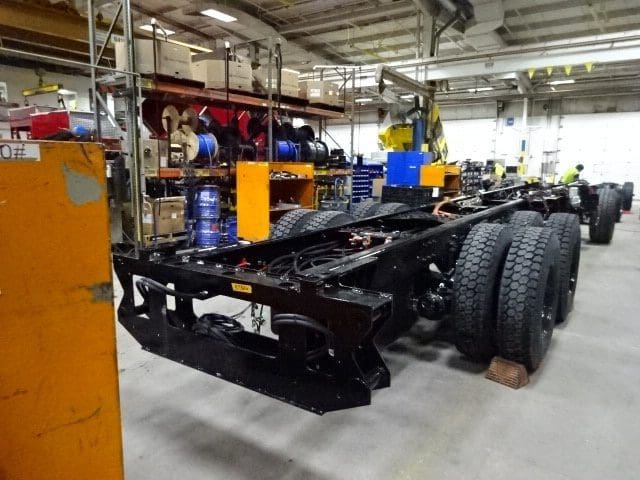

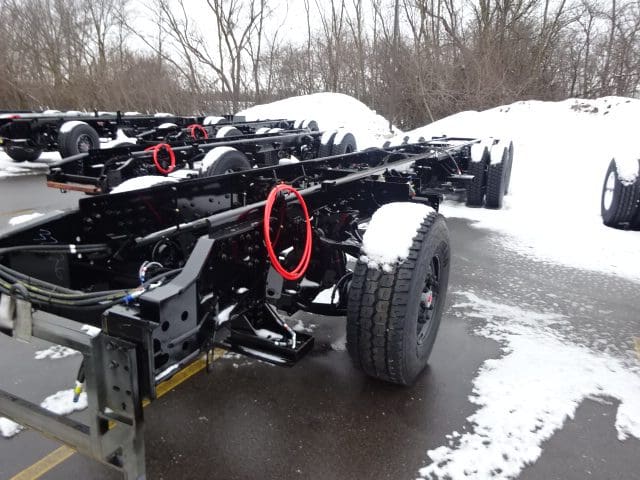

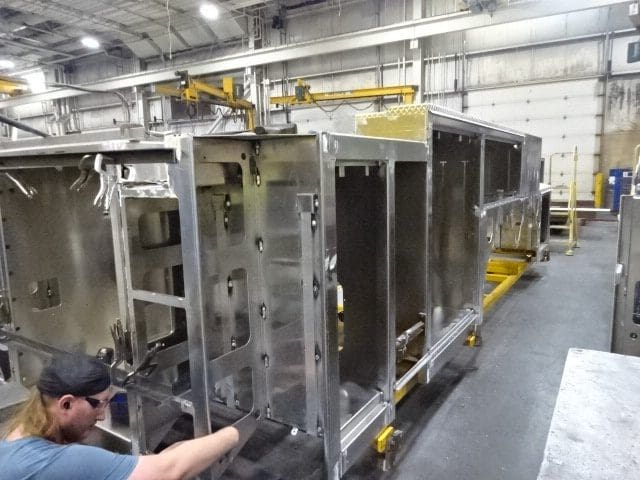

01-13-23

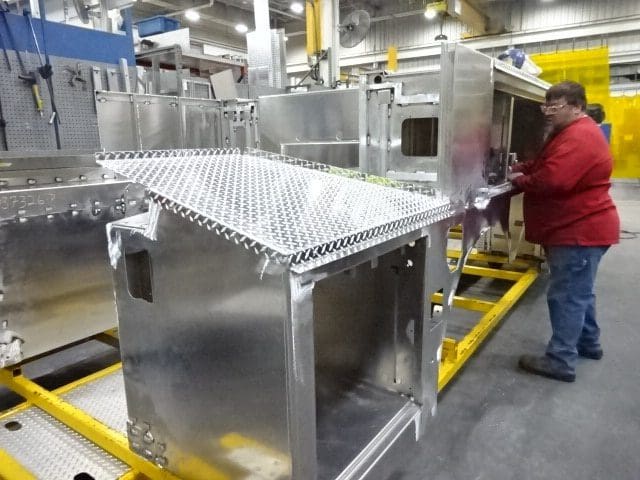

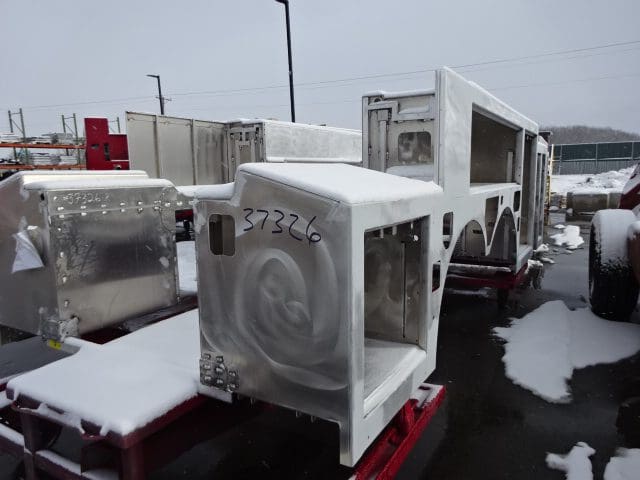

The cab was unavailable for photos, the frame build began, the pump house continued initial assembly, and the forward and rear body modules started the paint process.

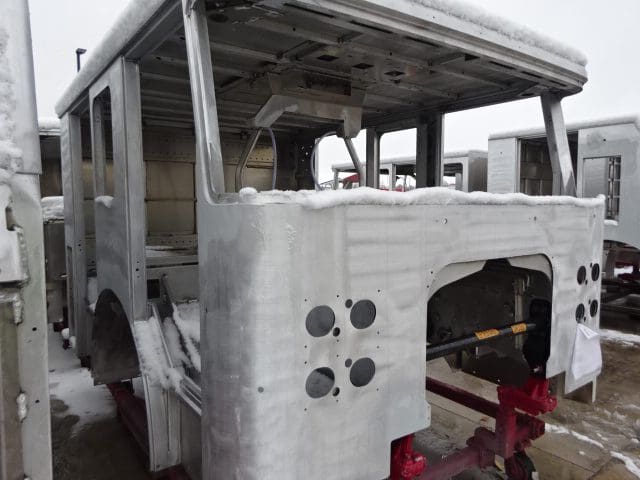

01-06-23

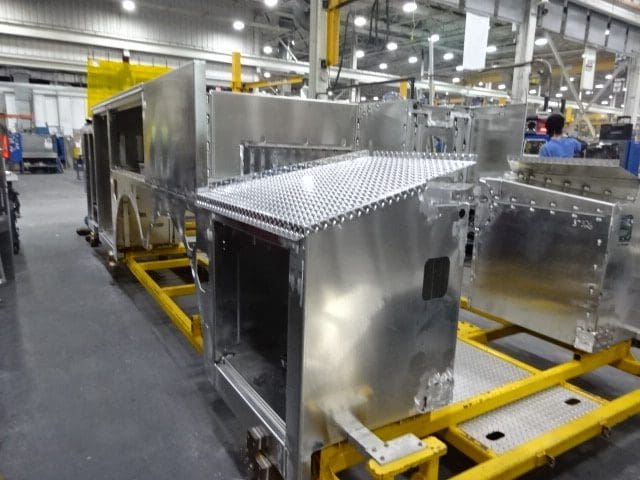

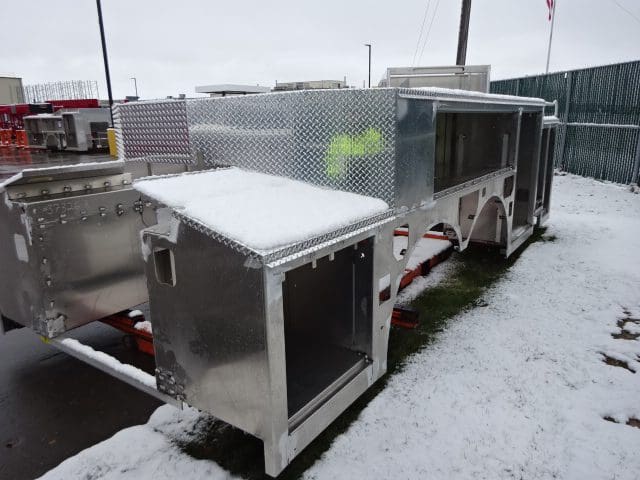

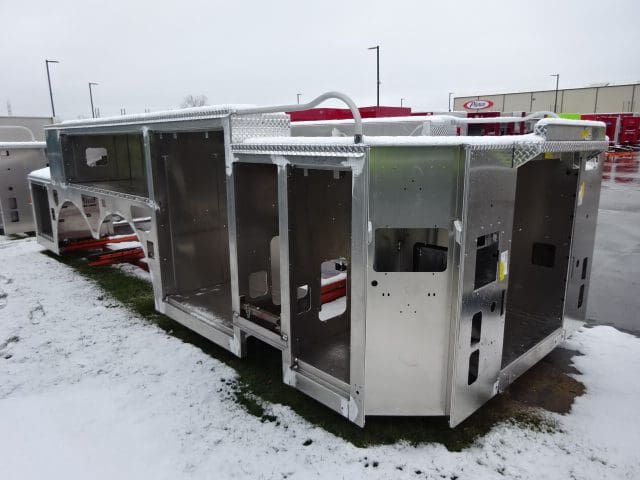

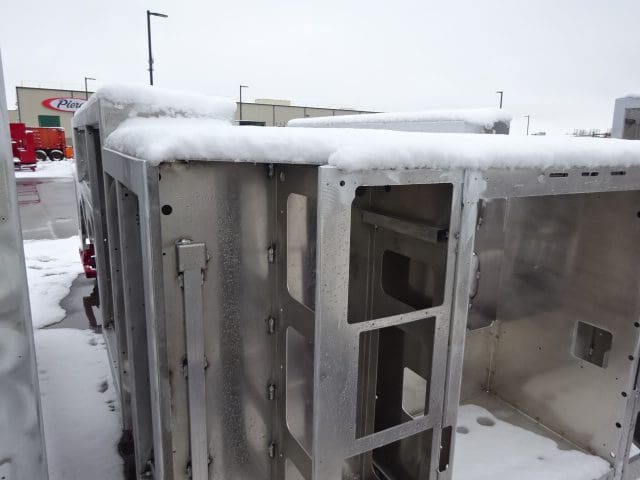

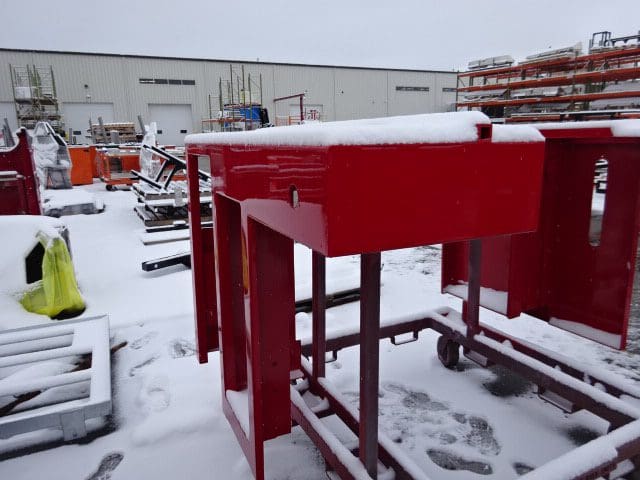

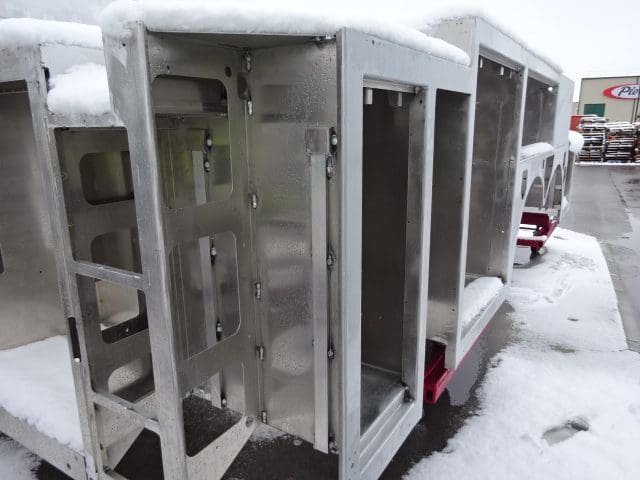

The cab continued the paint process, the pump house began initial assembly, the forward body module began fabrication, and the rear body module completed fabrication and was staged.
12-23-22

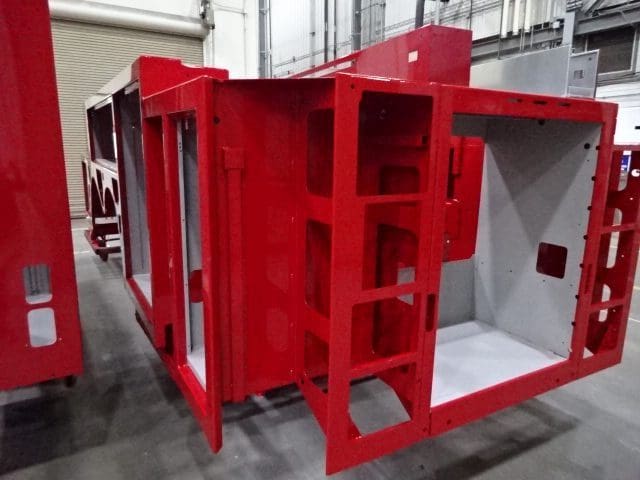

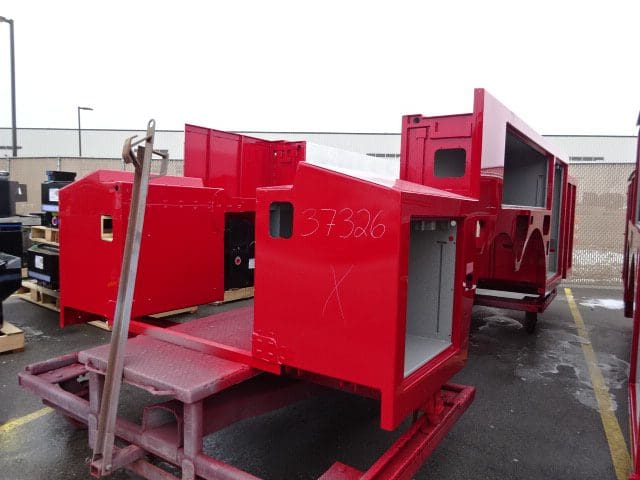

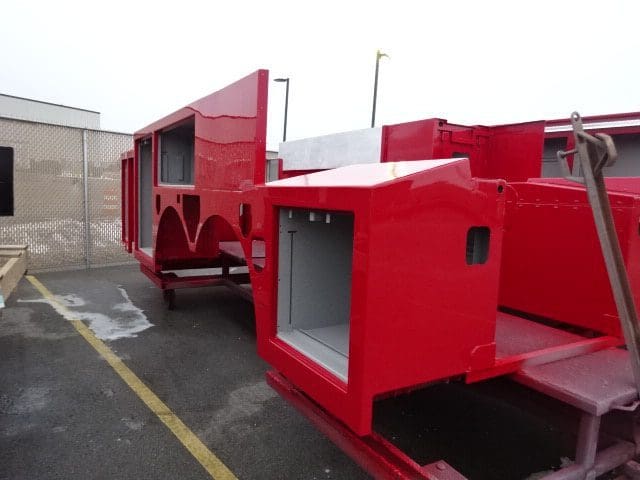

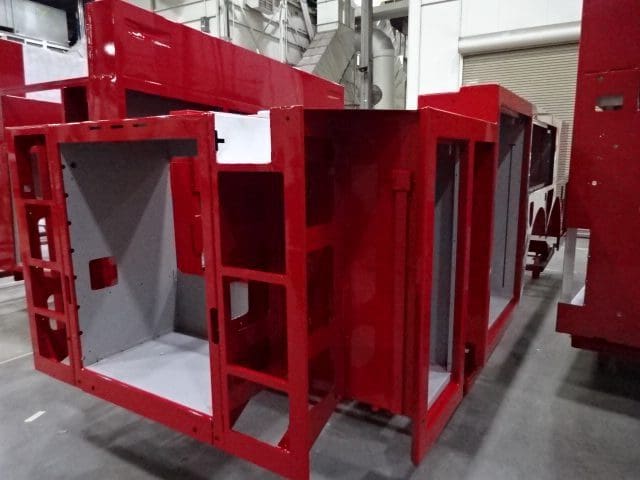

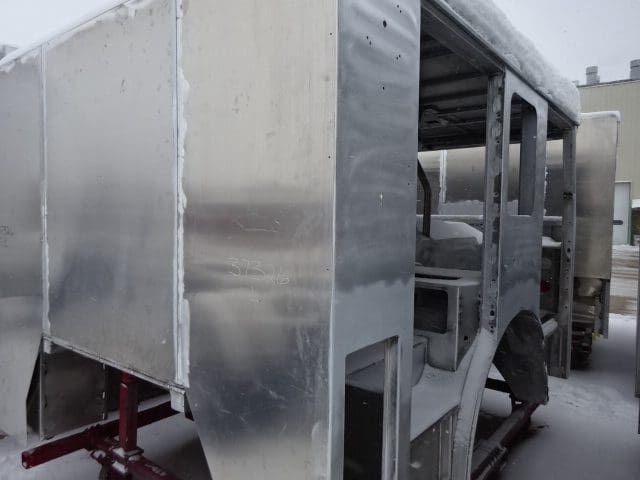

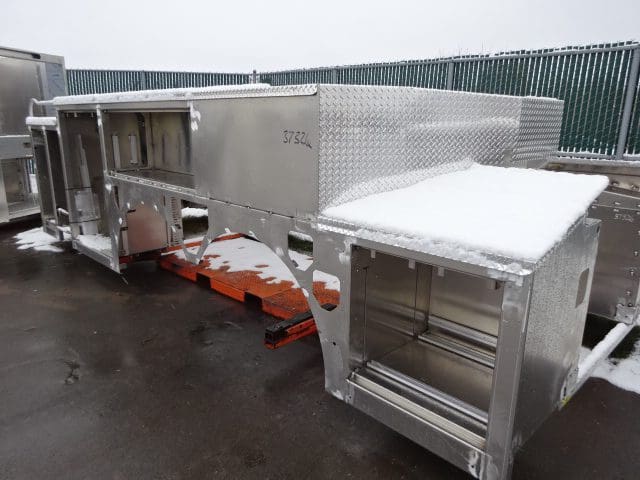

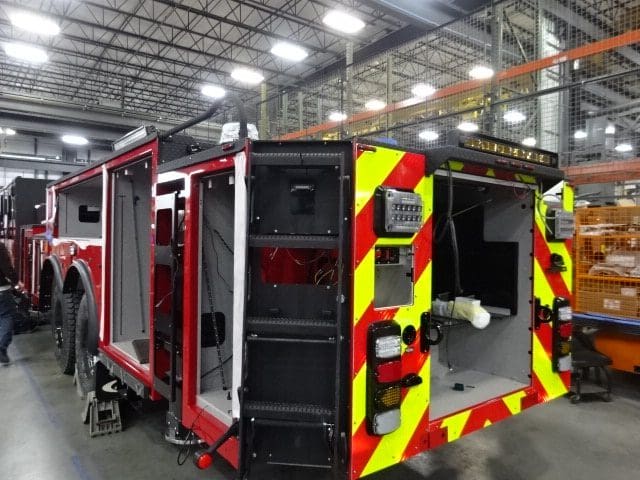

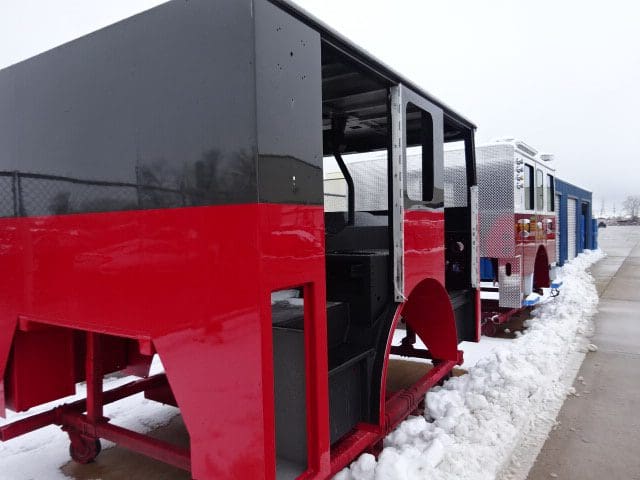

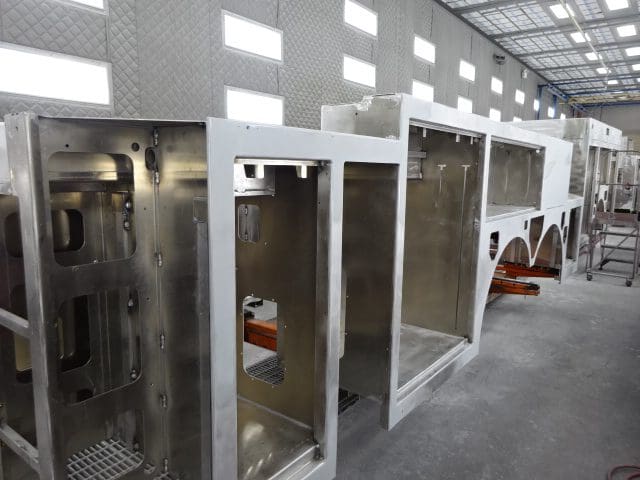

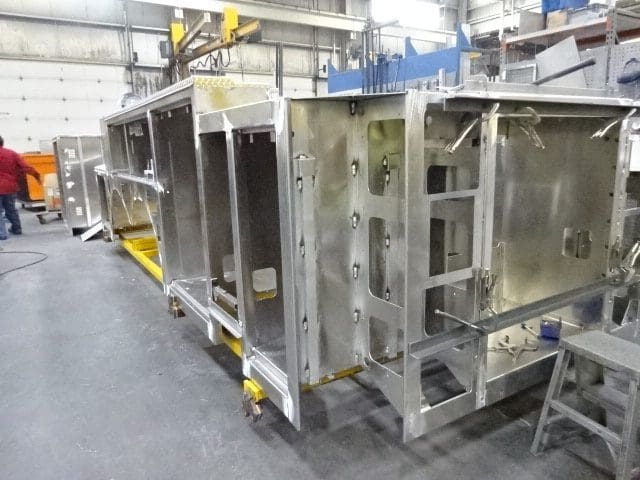

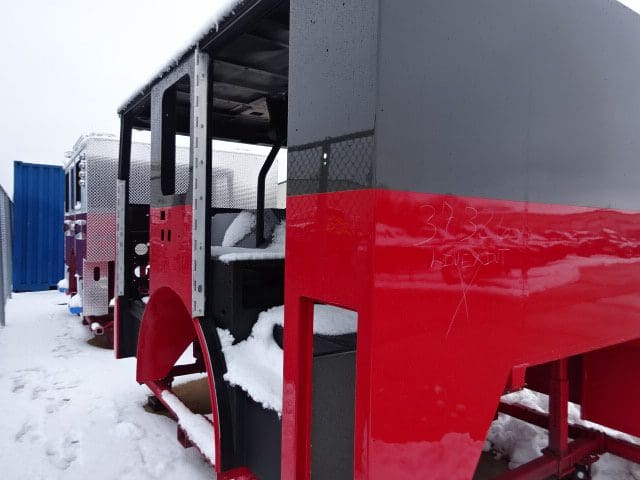

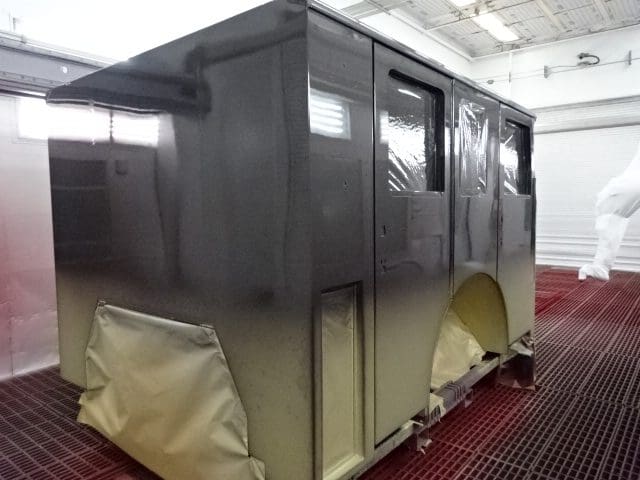

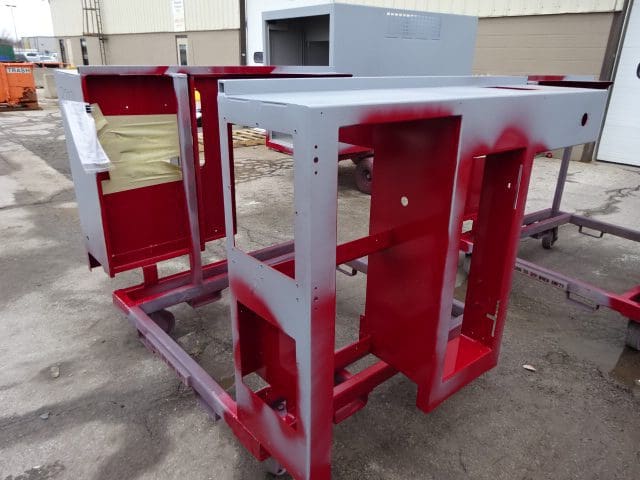

The cab made progress through paint and was staged, the frame build continued, the pump house was painted and continued initial assembly, and the body completed fabrication and was staged.
12-09-22

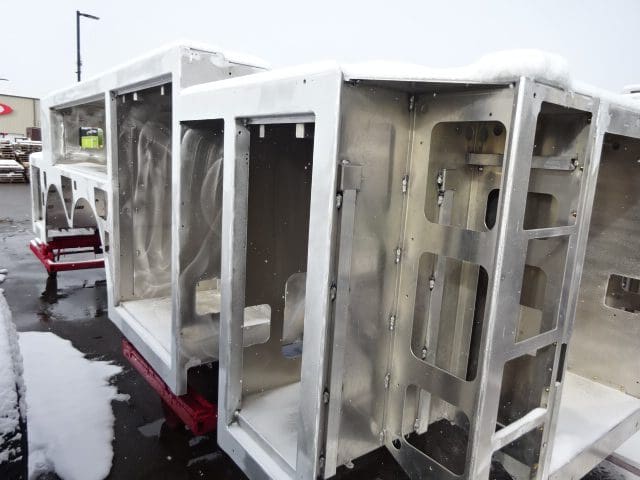

This unit is now in production. In this report, the cab was fabricated and began the paint process.
