06-16-23

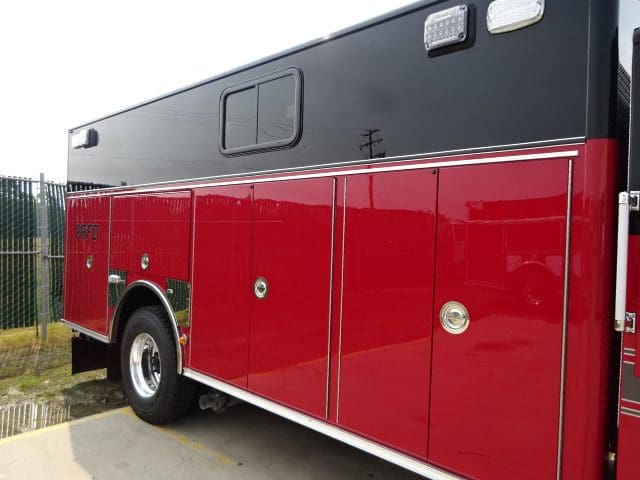

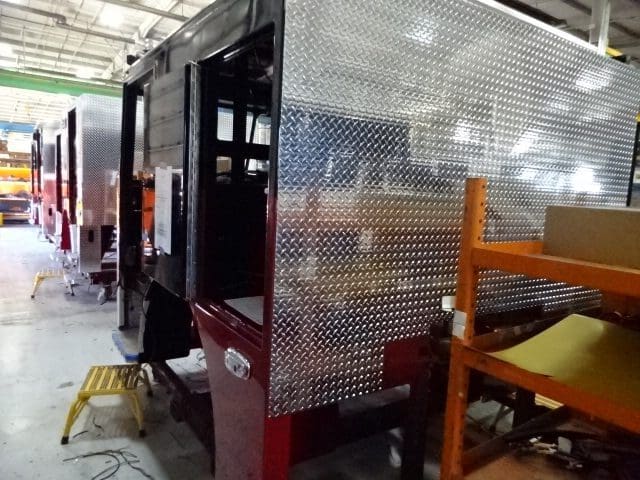

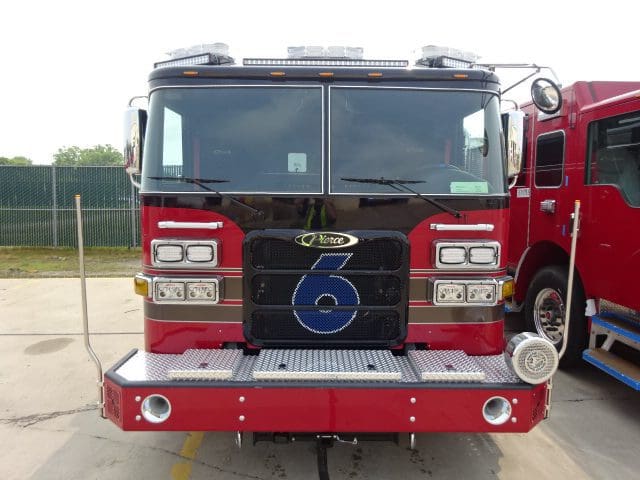

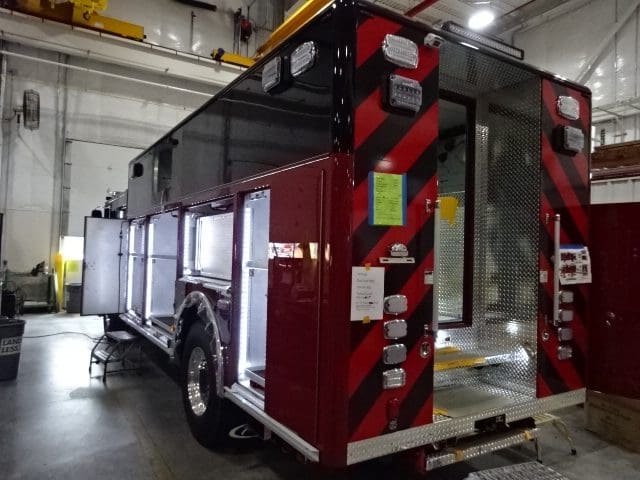

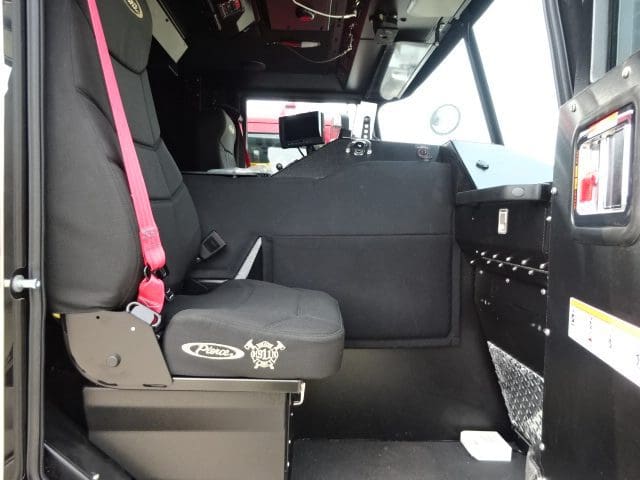

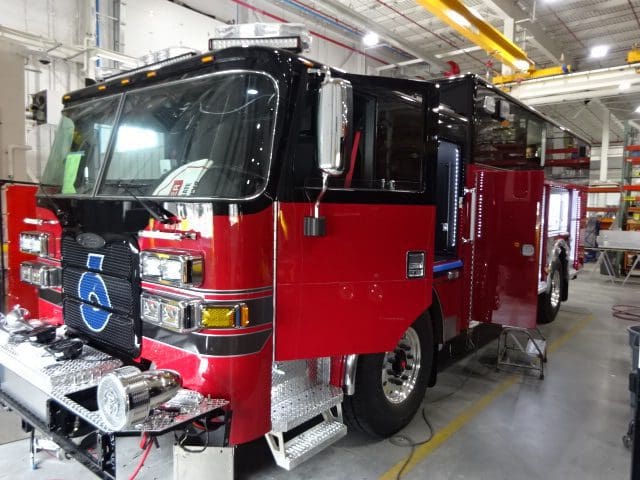

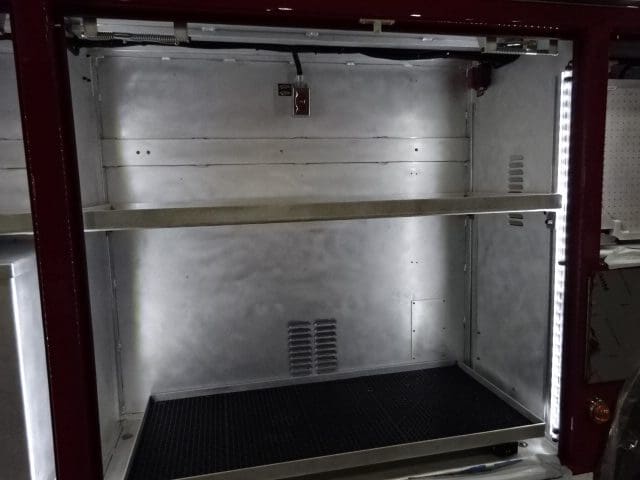

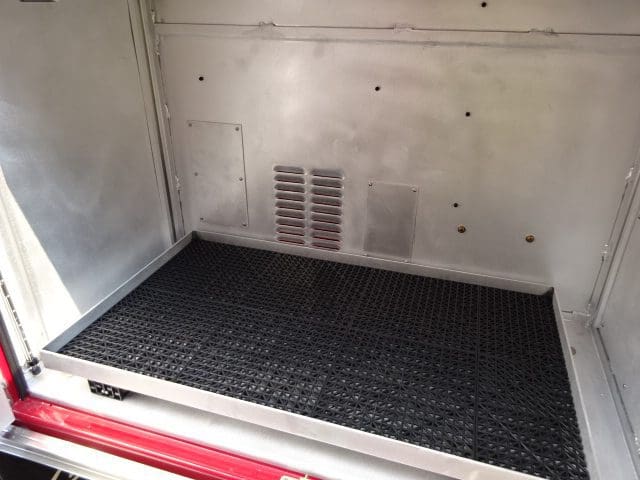

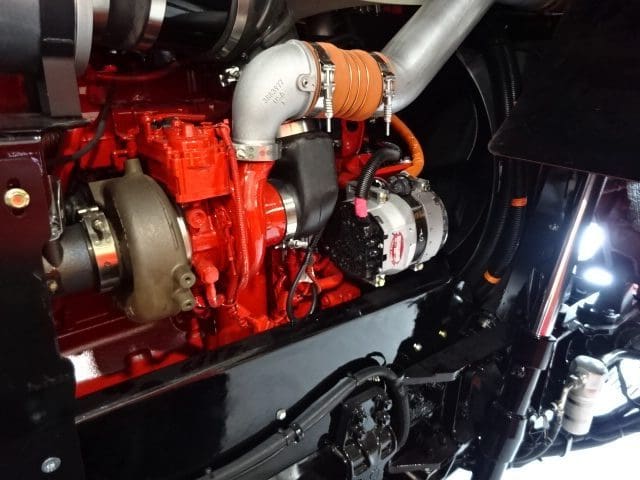

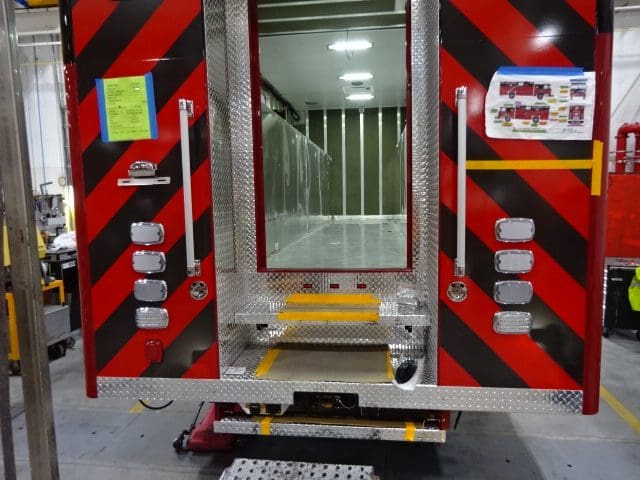

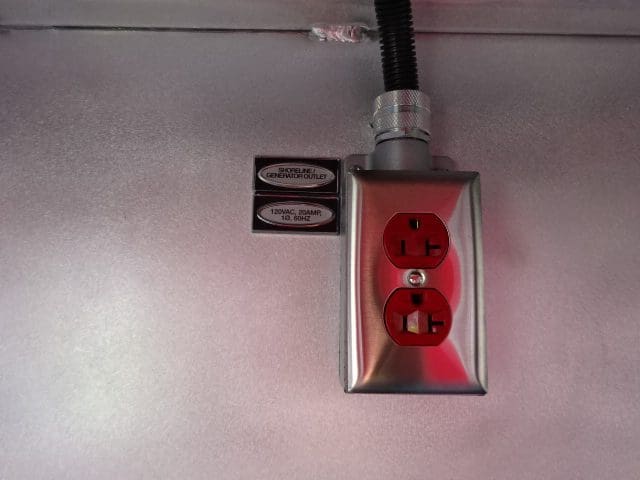

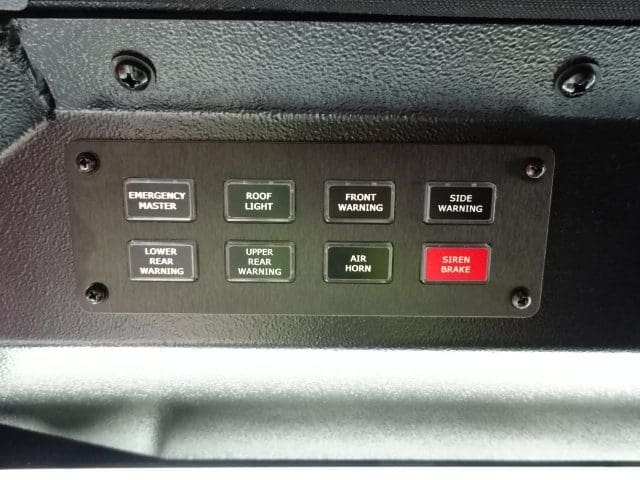

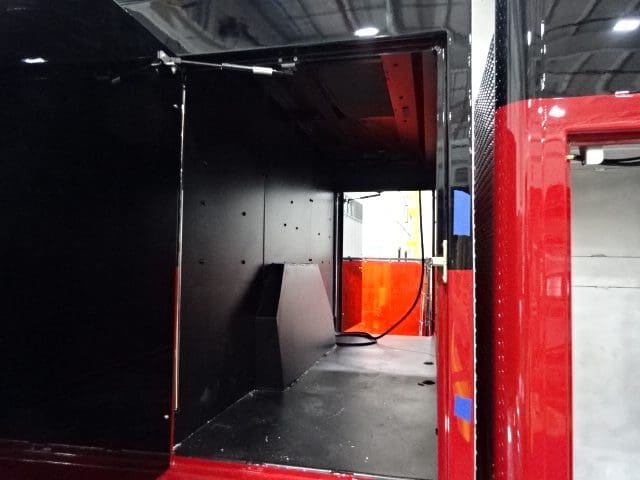

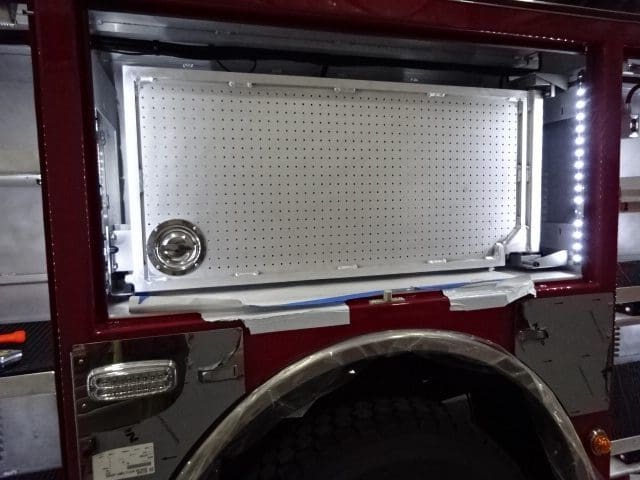

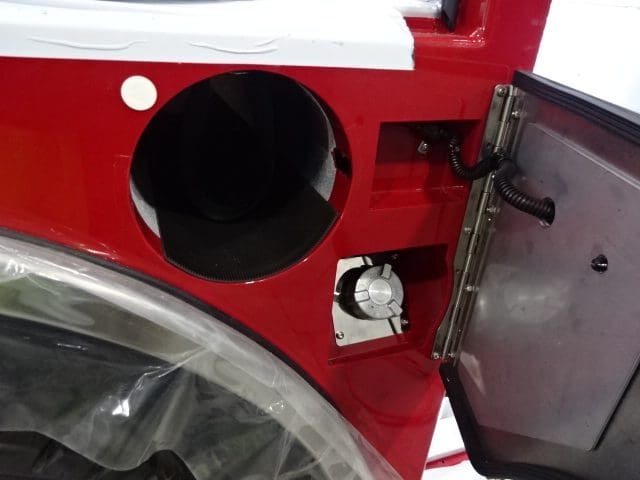

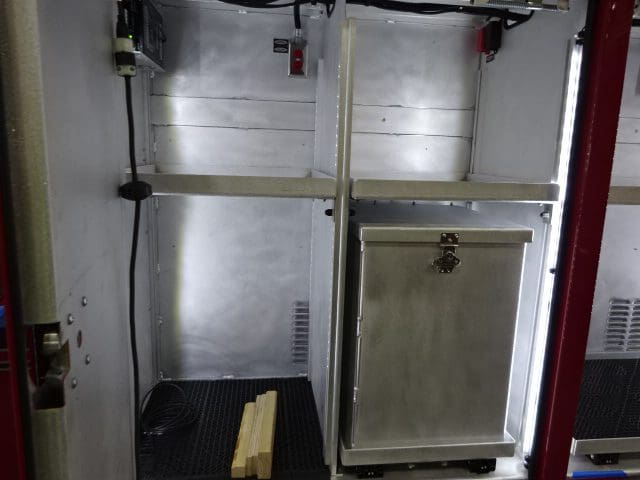

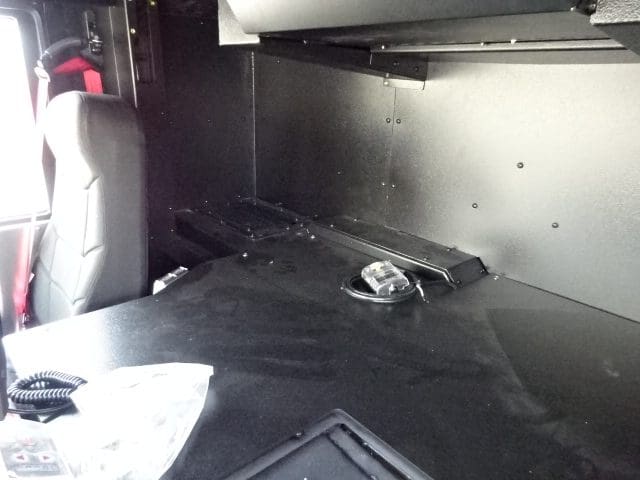

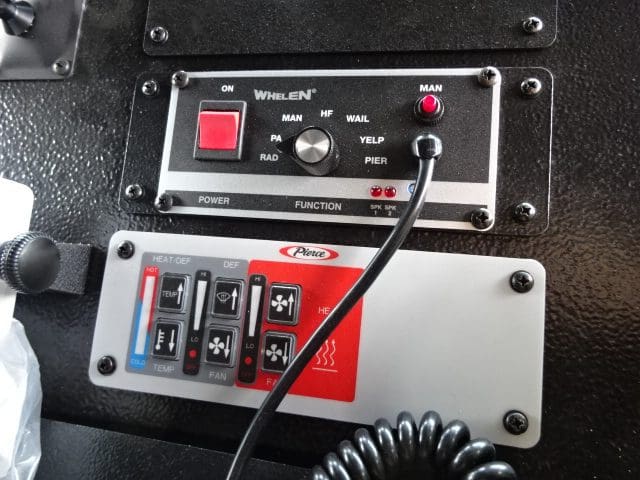

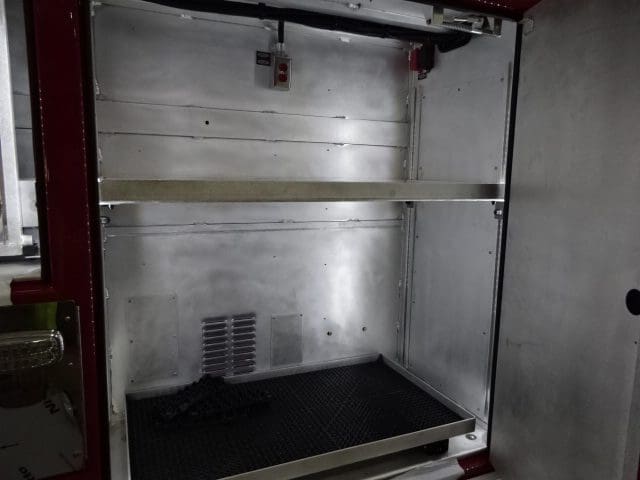

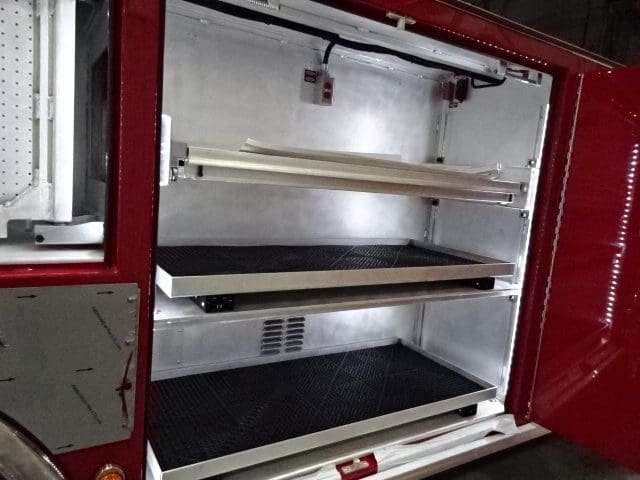

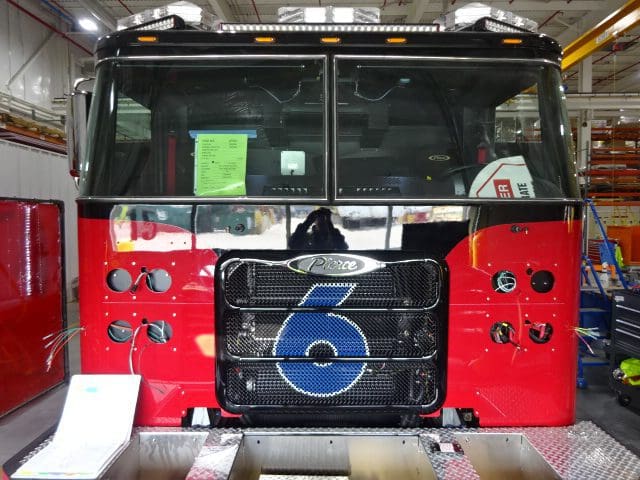

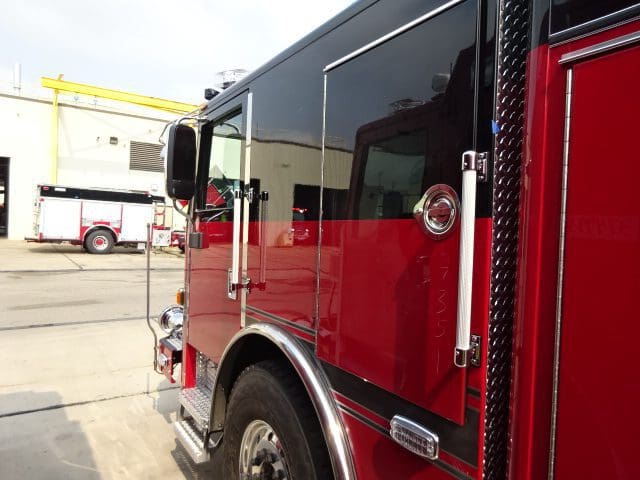

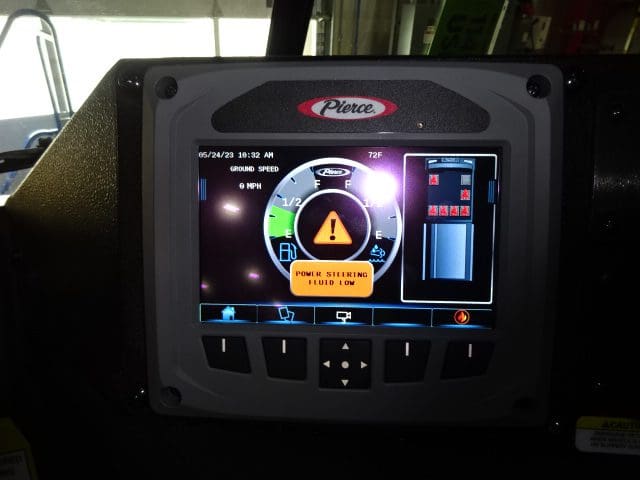

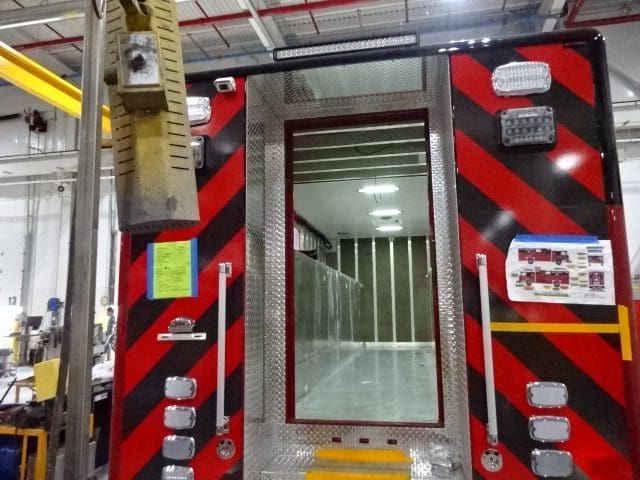

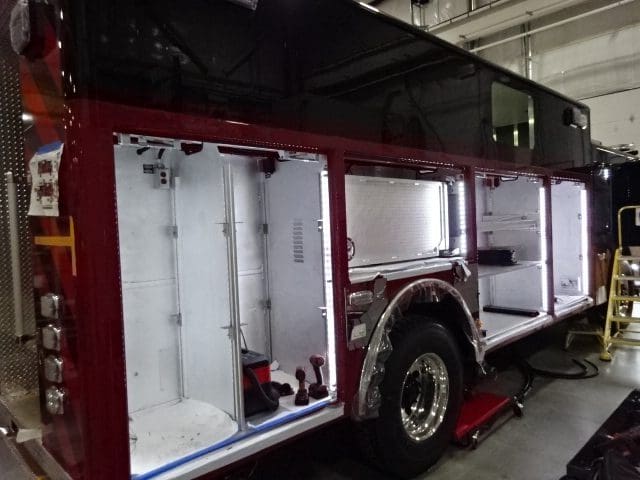

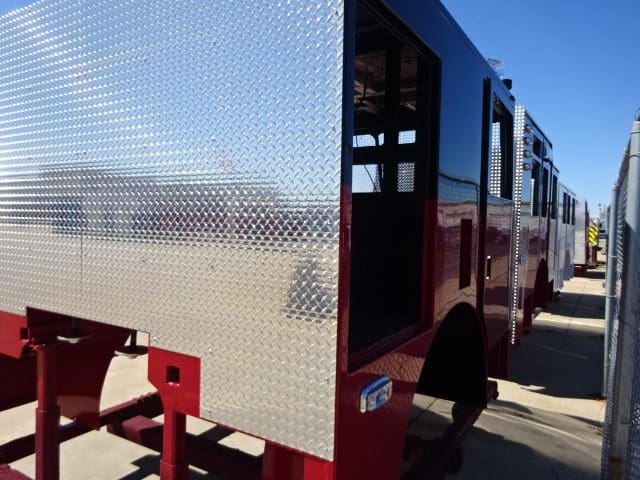

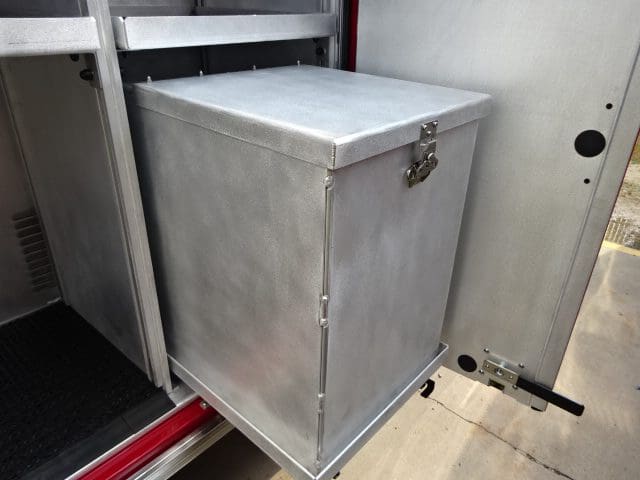

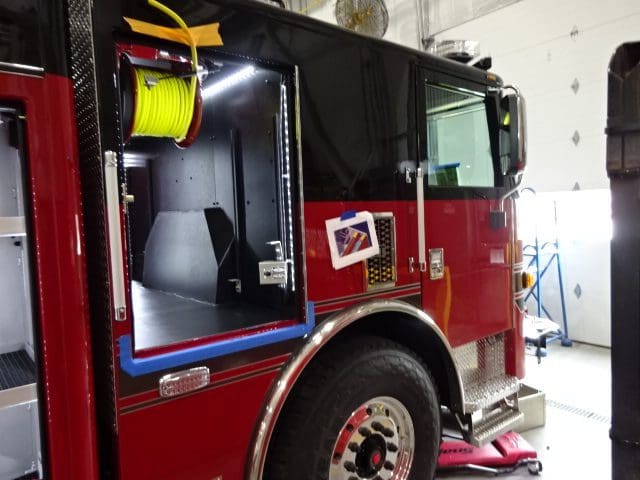

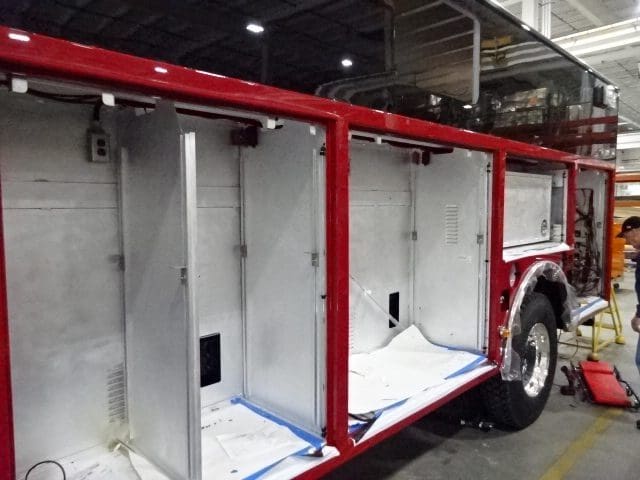

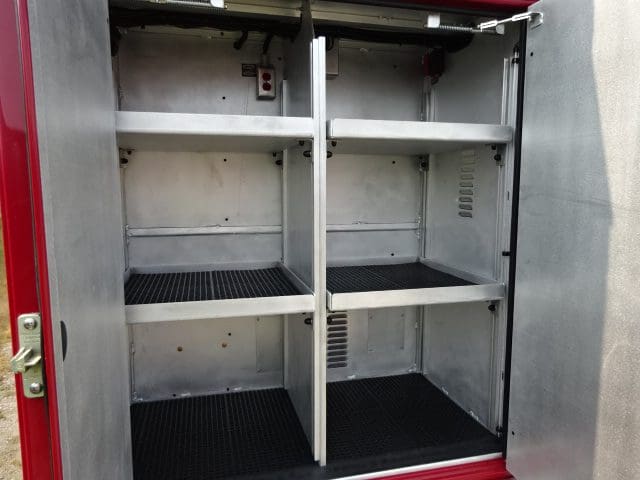

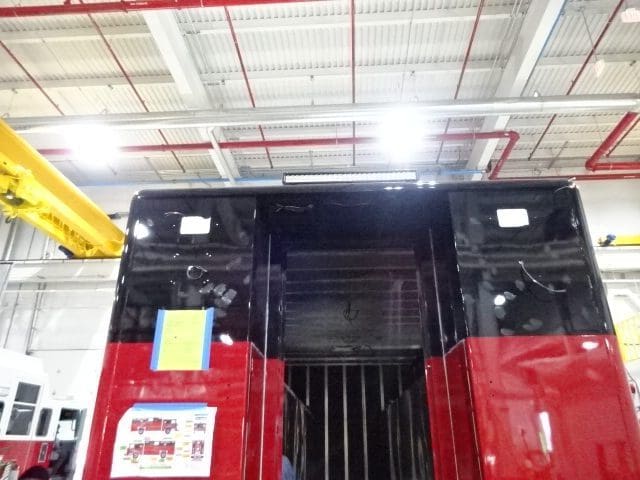

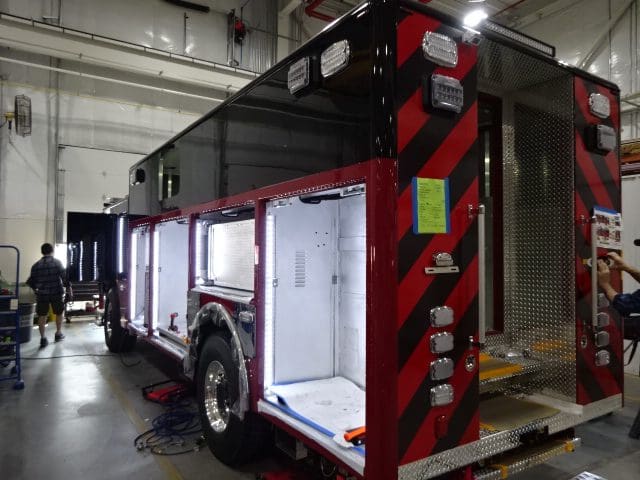

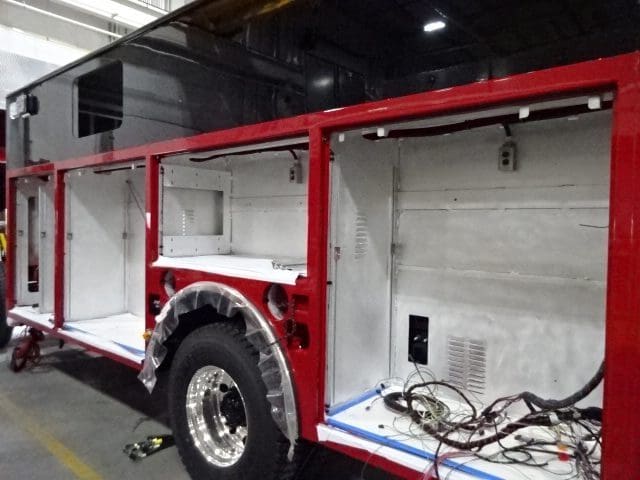

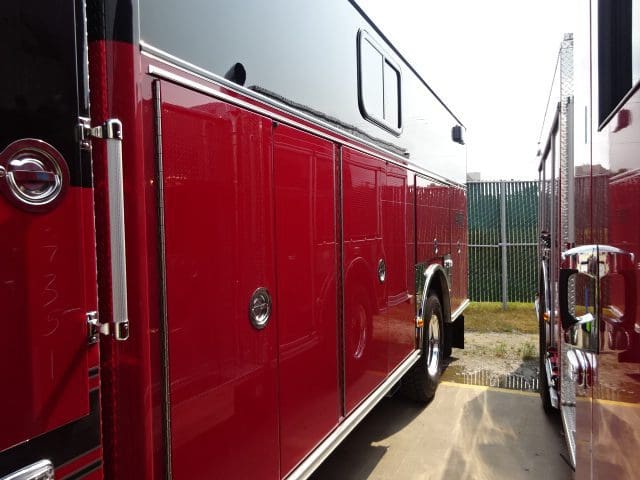

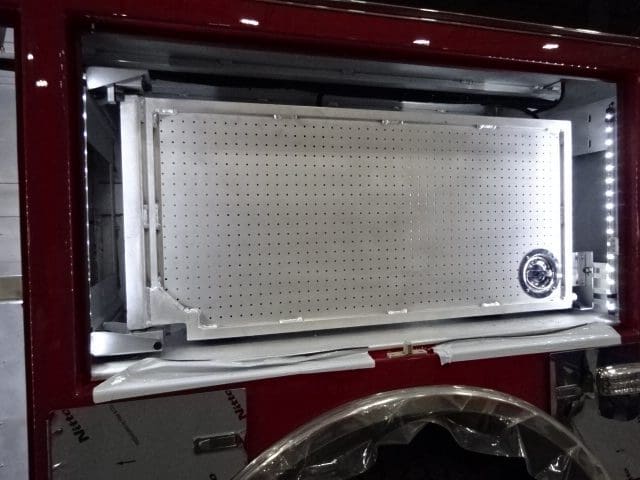

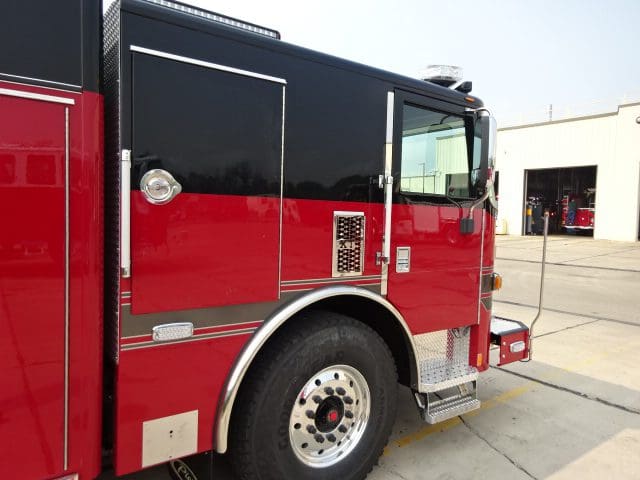

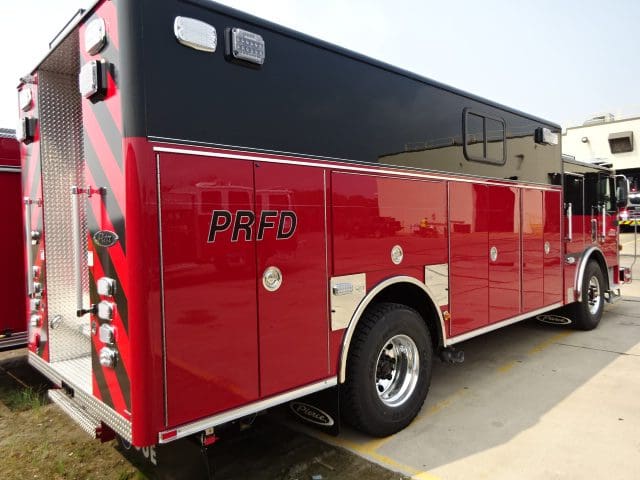

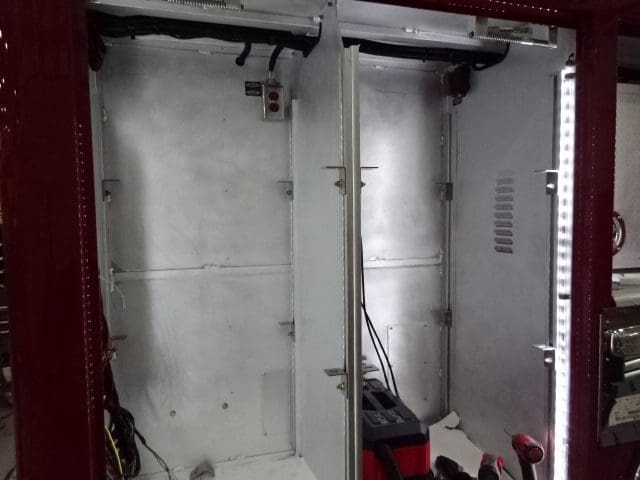

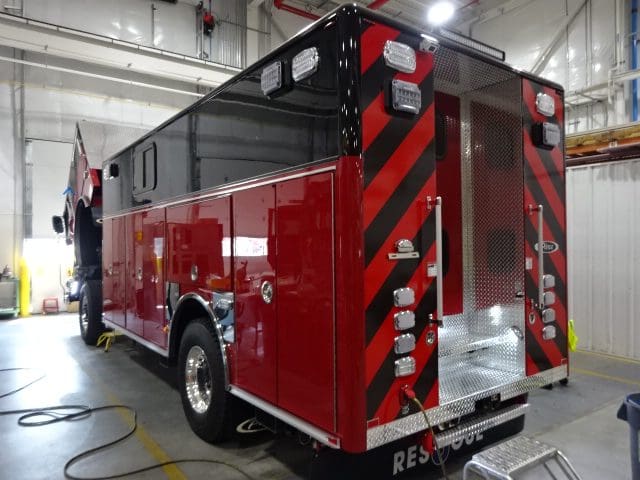

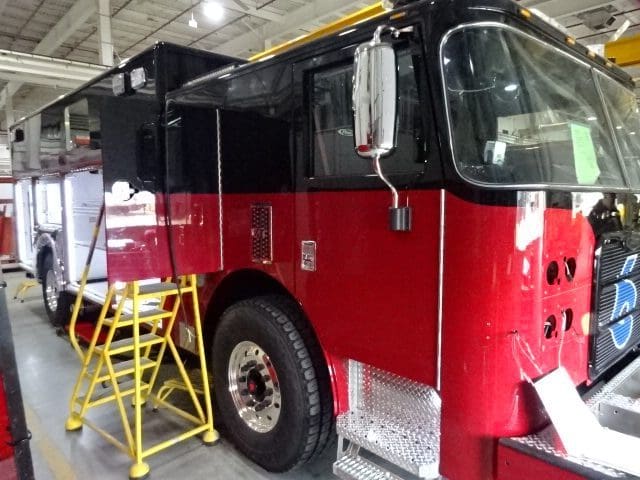

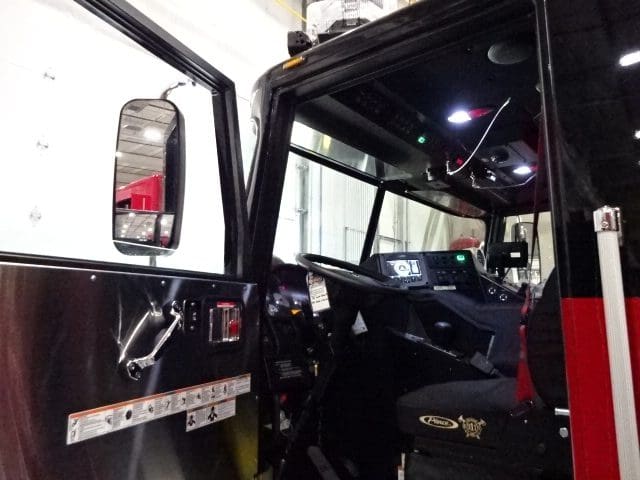

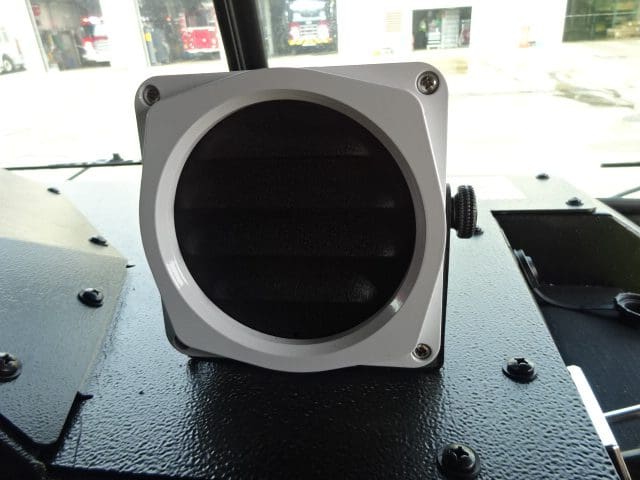

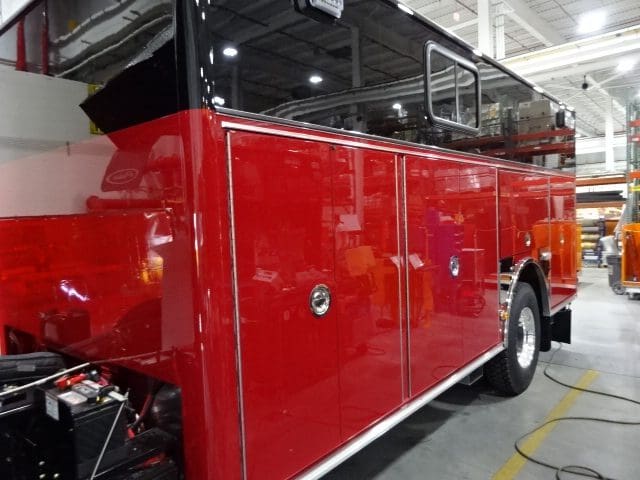

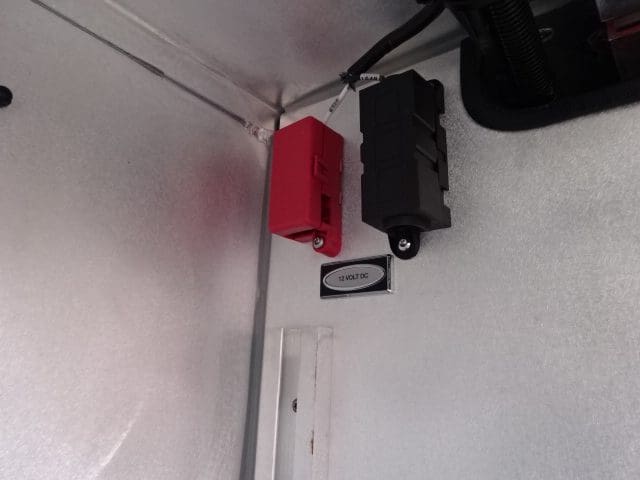

This unit completed final assembly and was released to test. Once complete, it will release to quality and graphics where any remaining content will be applied. It will then be made ready for final inspection. This is the last scheduled report.
05-05-23

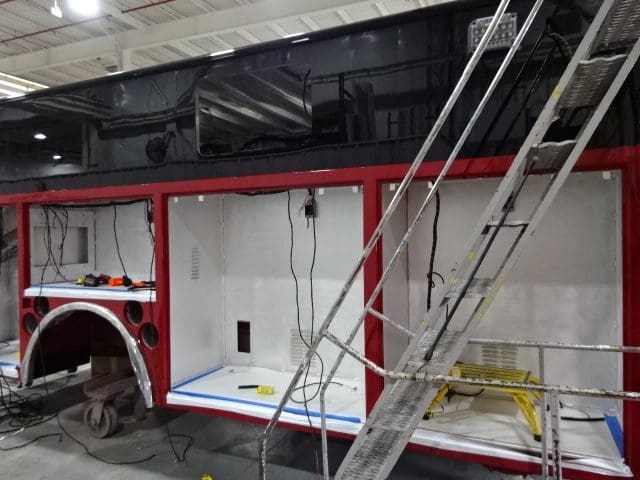

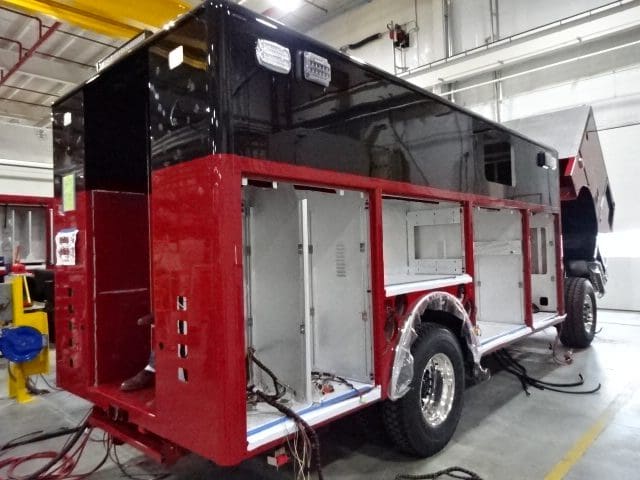

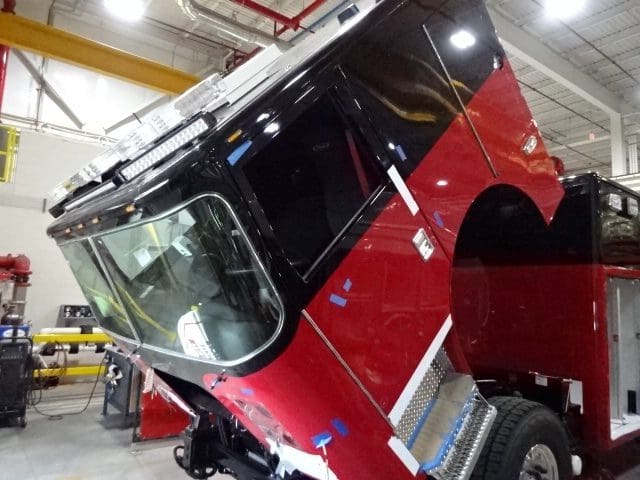

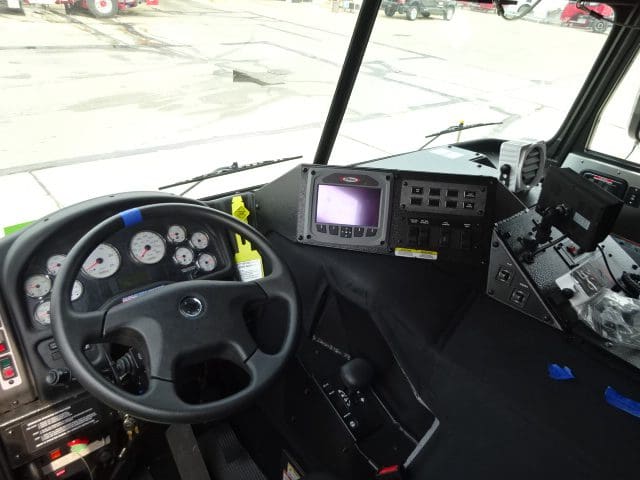

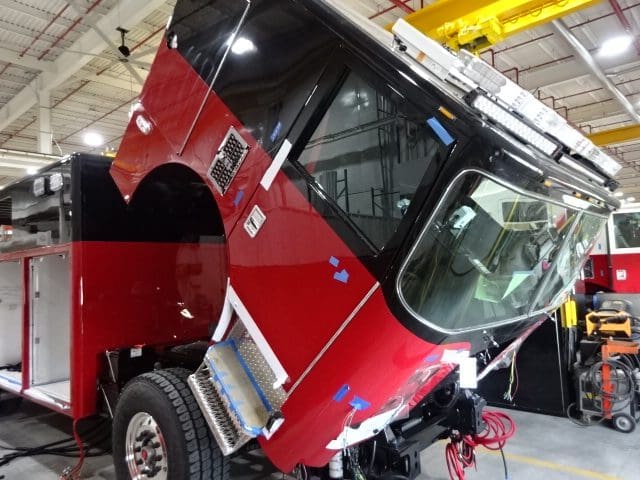

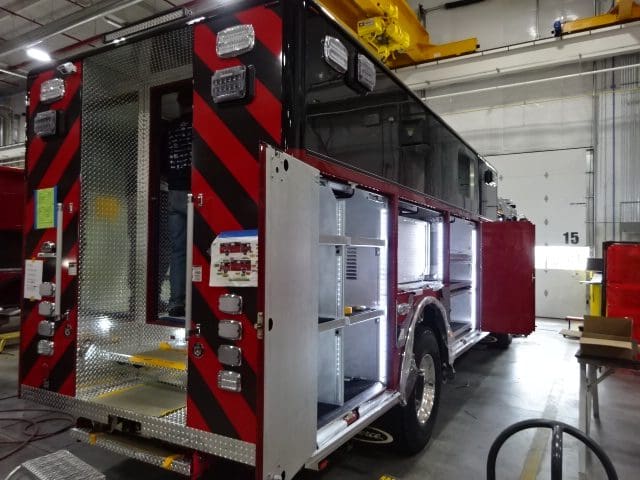

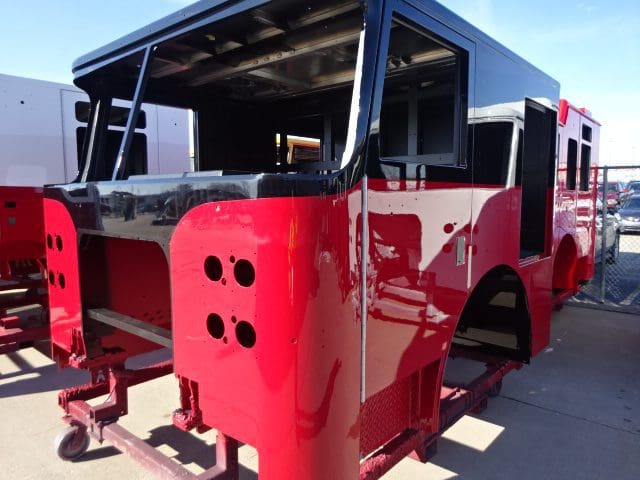

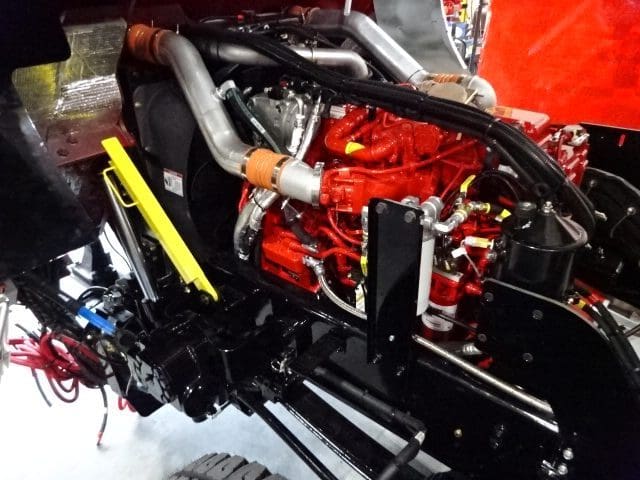

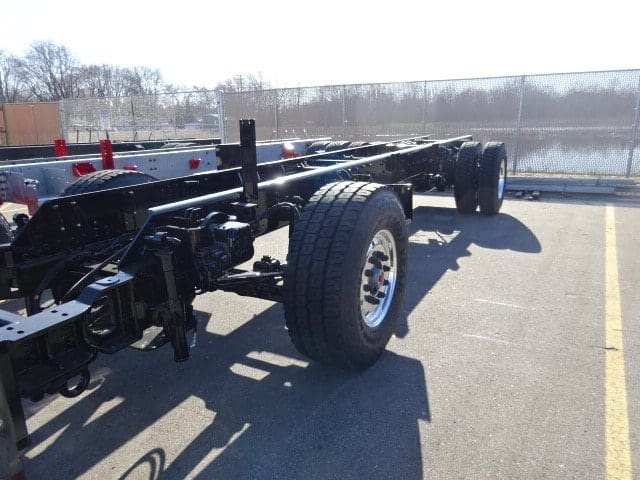

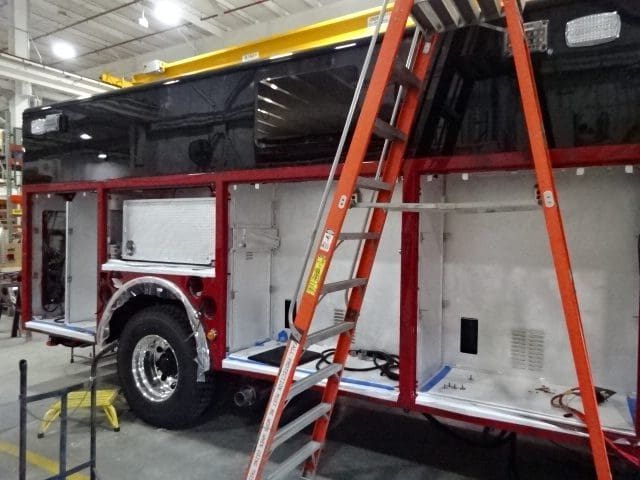

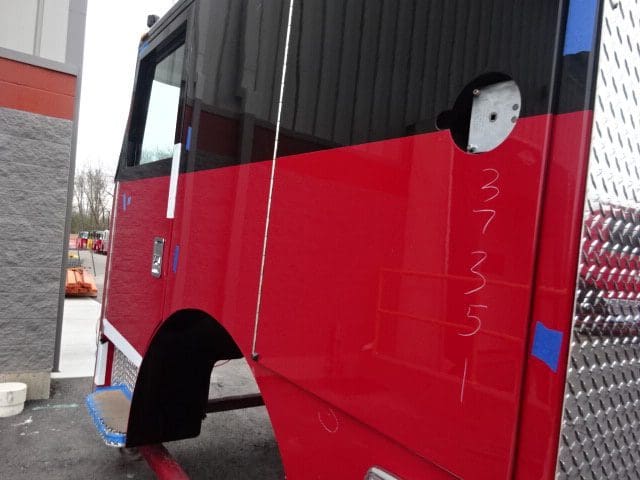

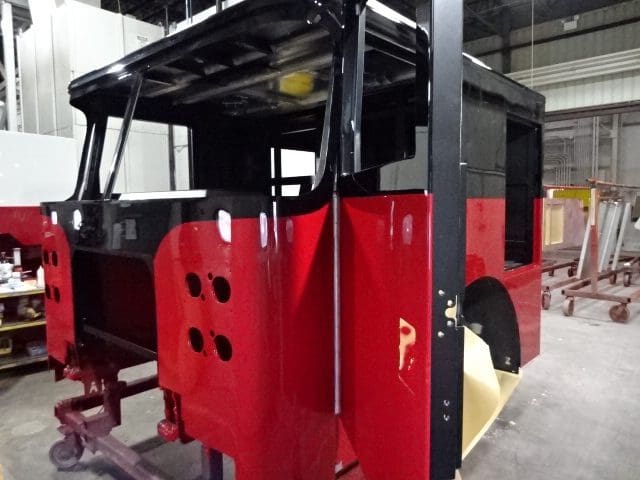

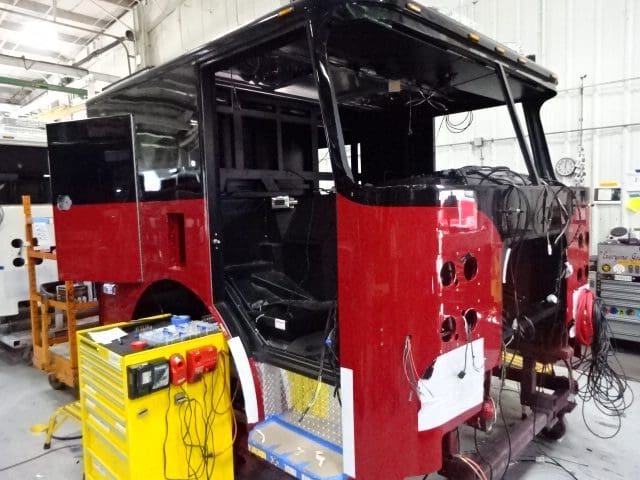

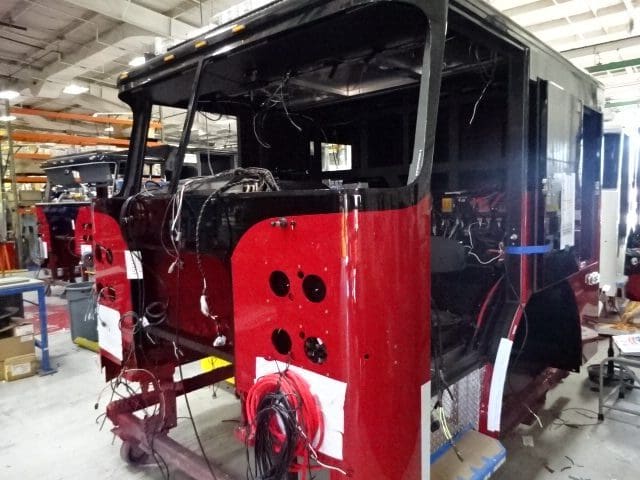

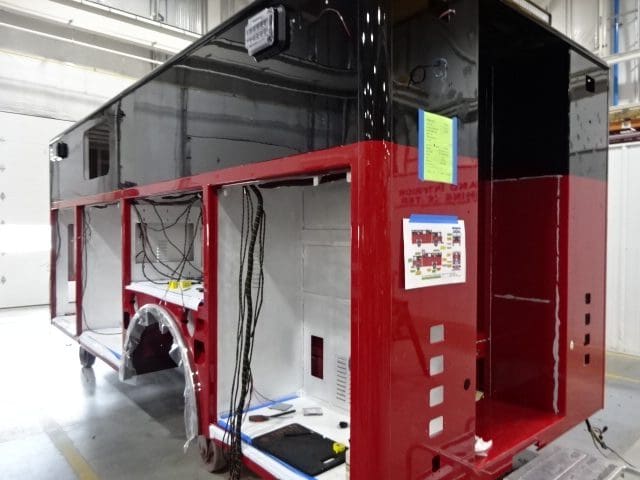

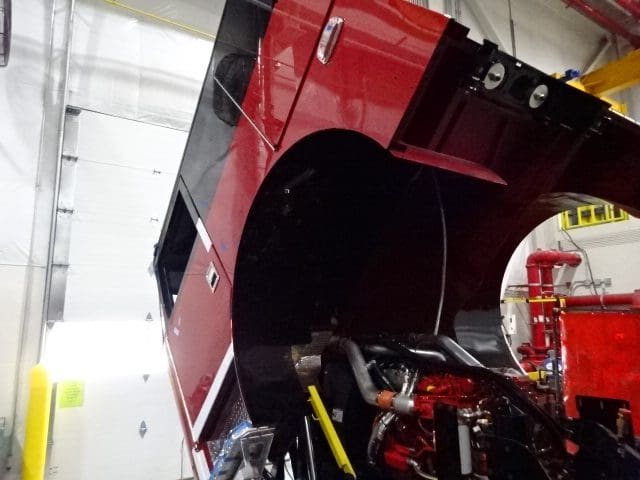

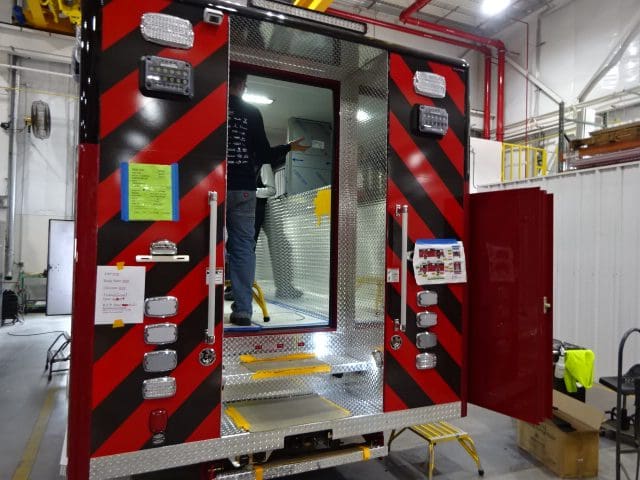

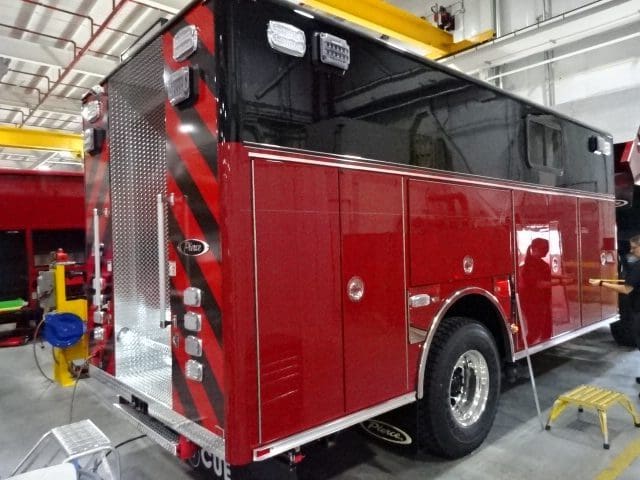

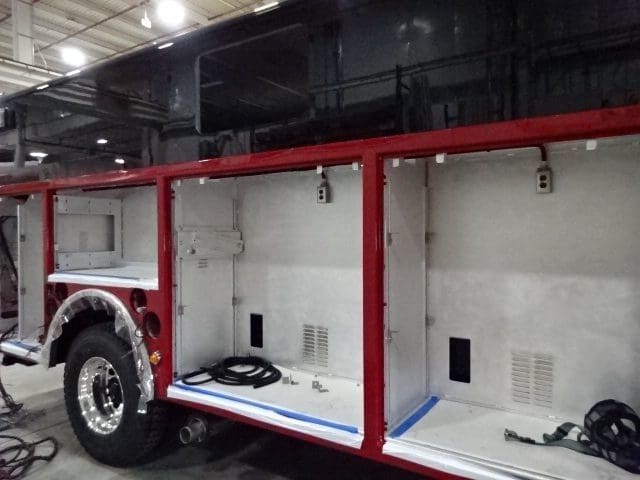

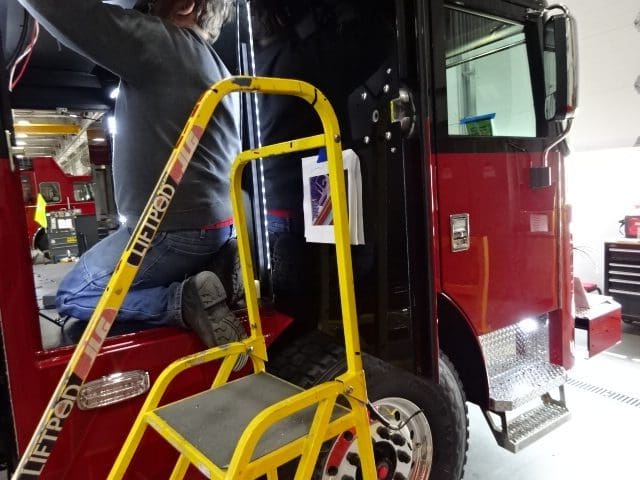

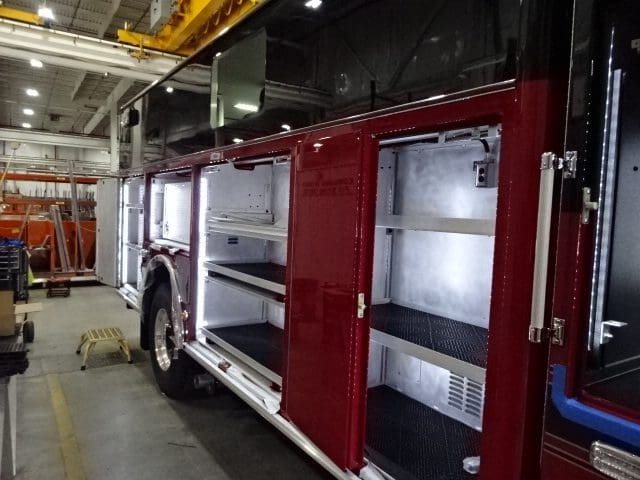

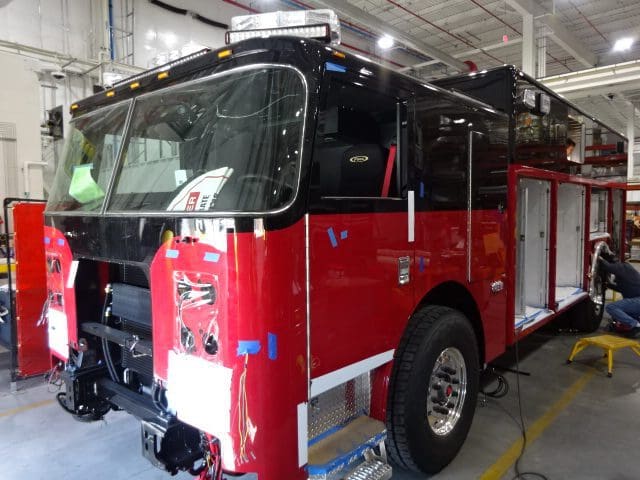

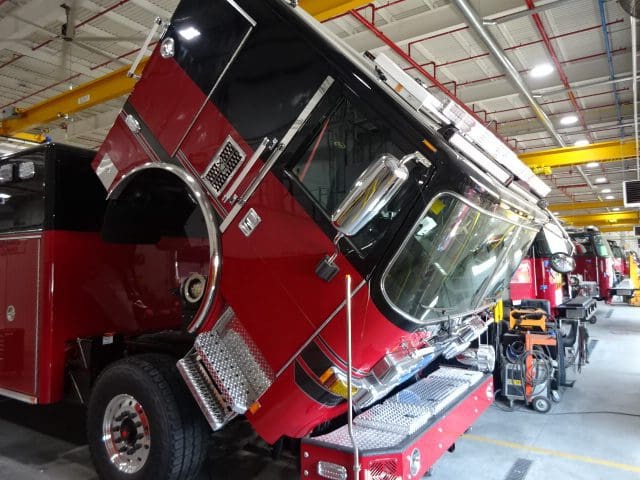

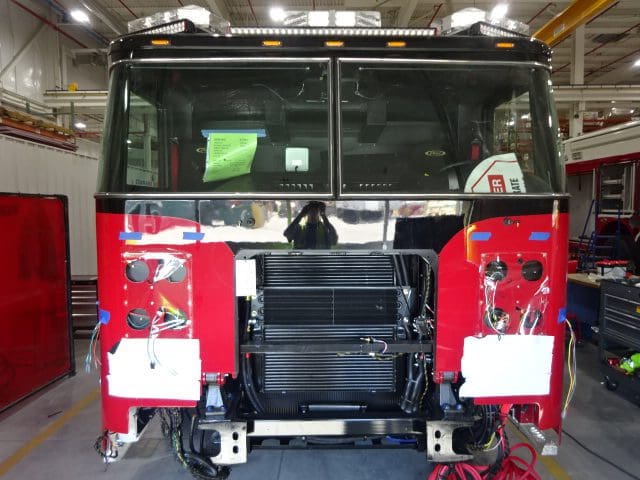

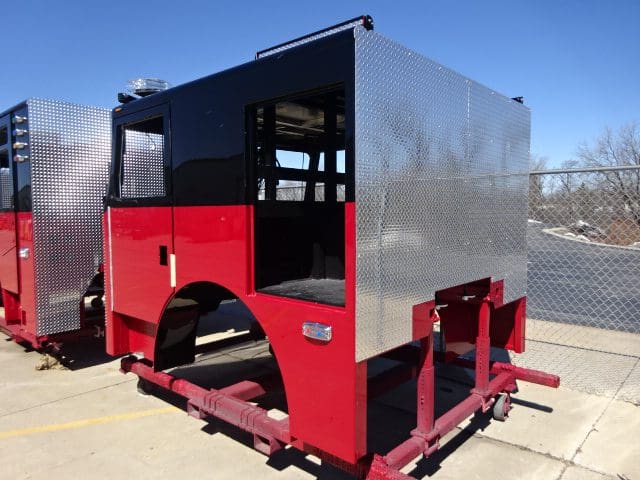

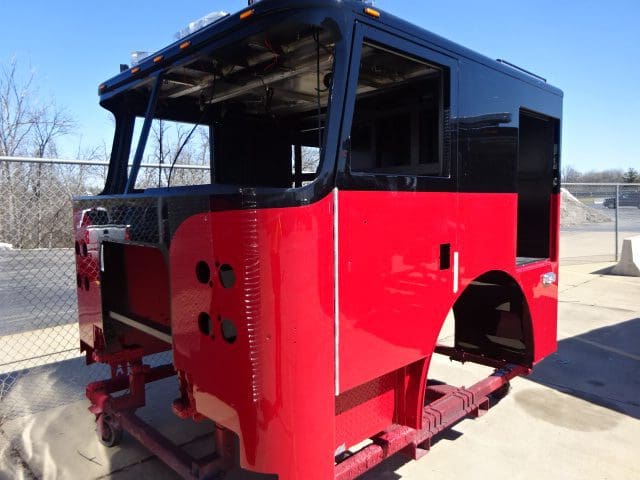

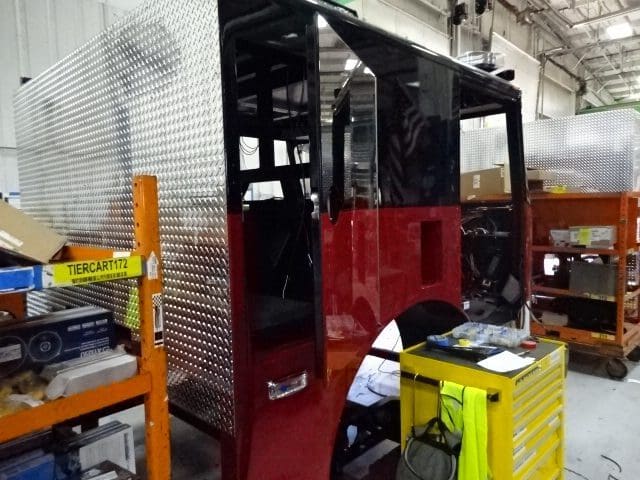

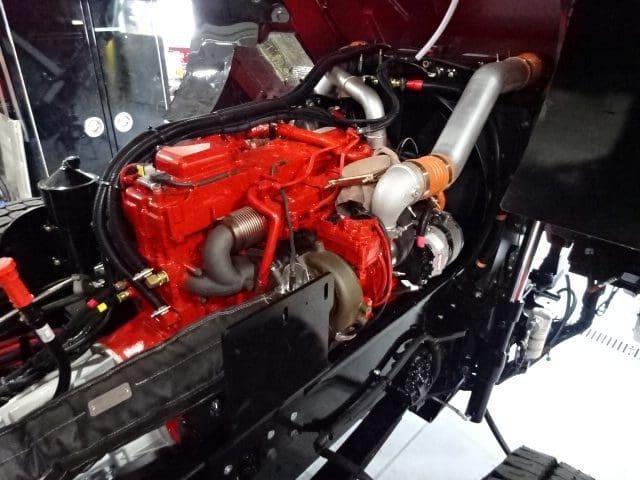

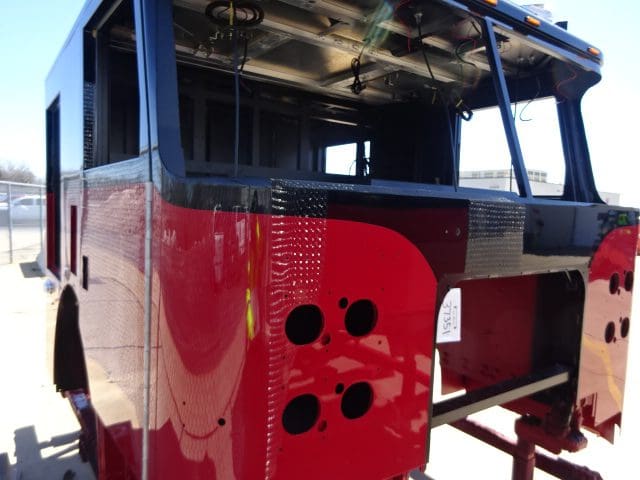

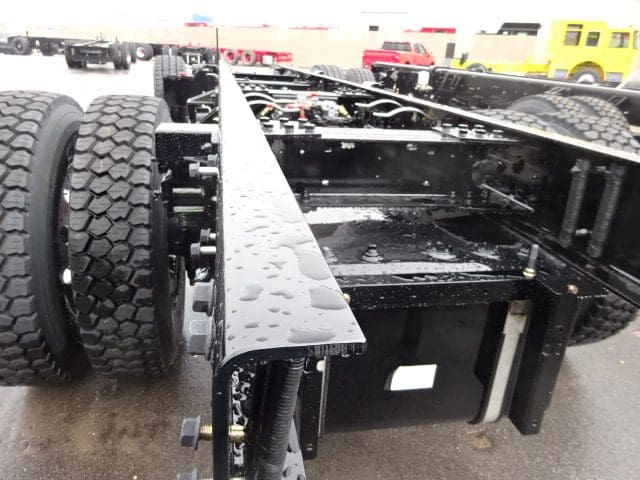

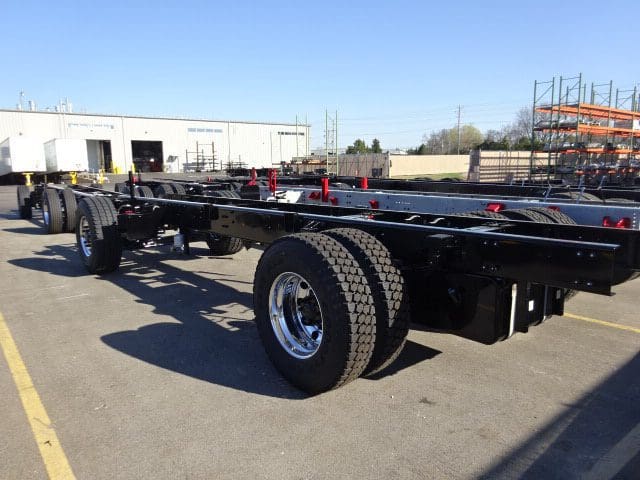

The cab and body were installed on the frame followed by the start of final assembly

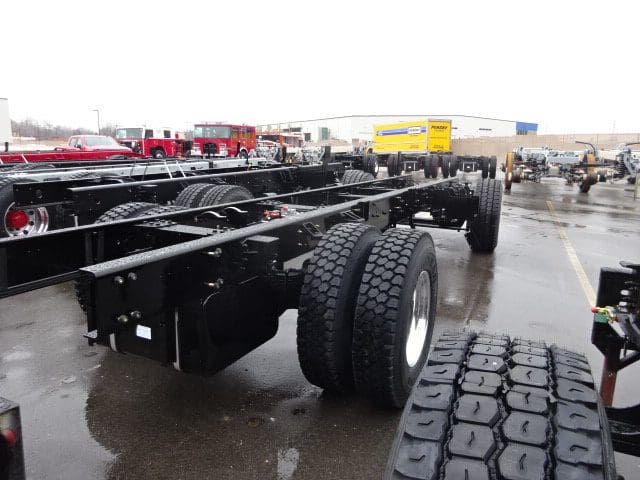

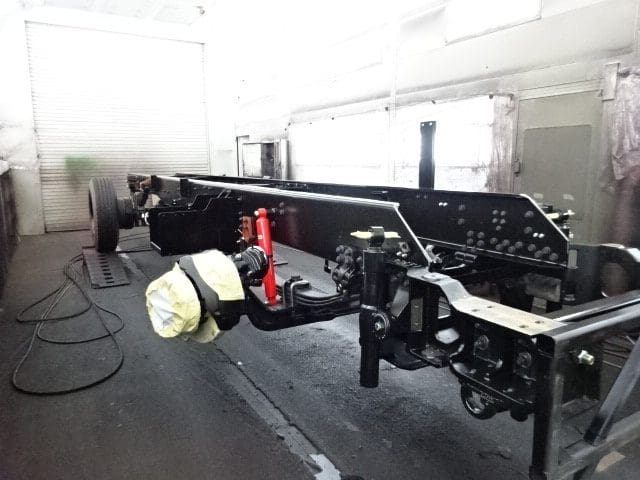

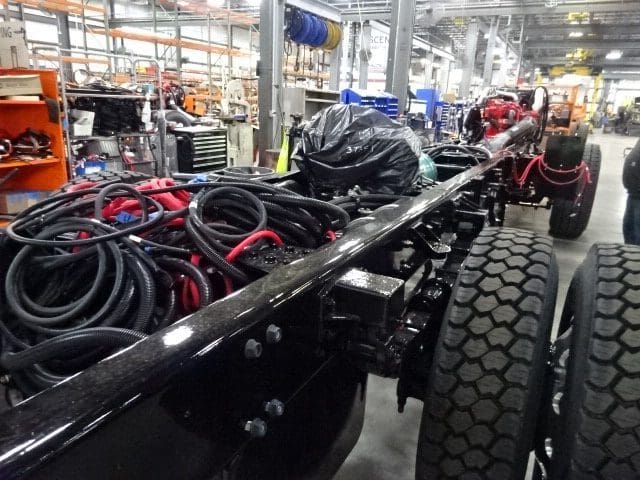

04-28-23

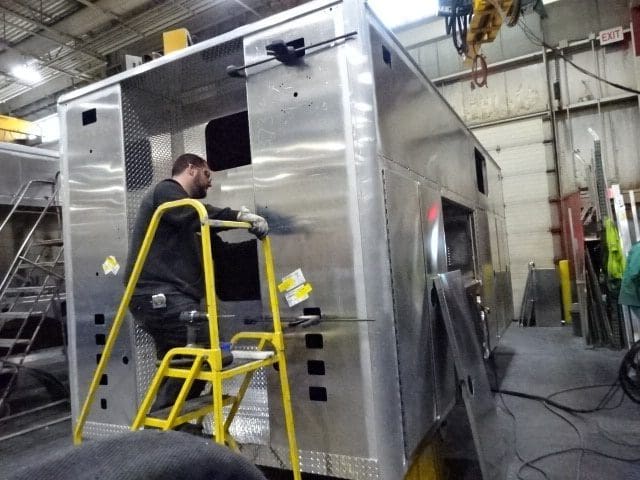

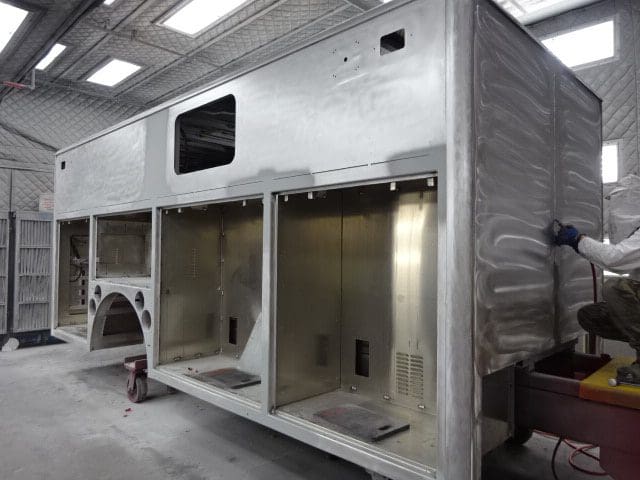

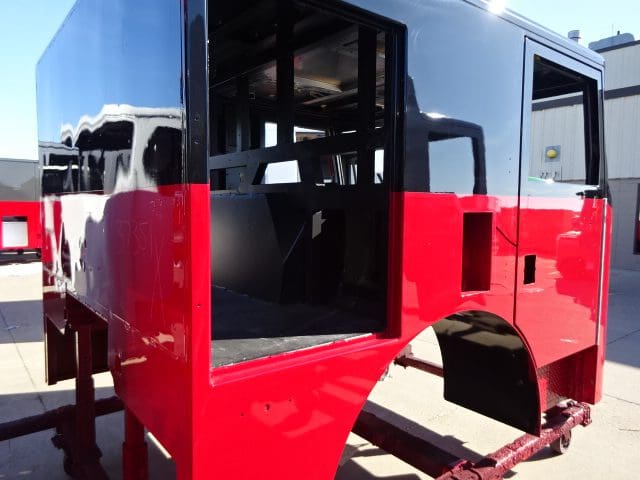

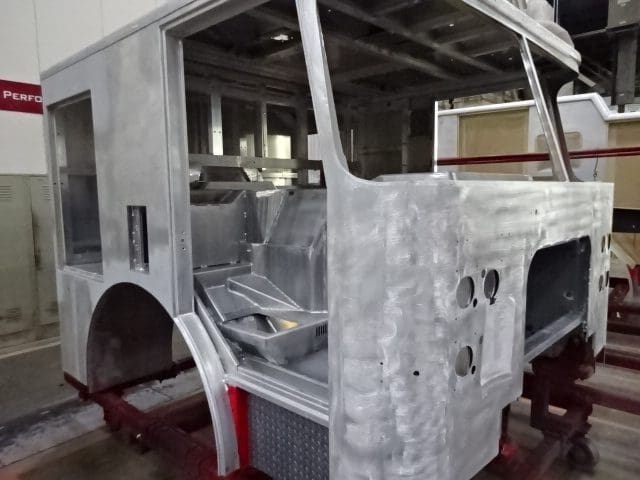

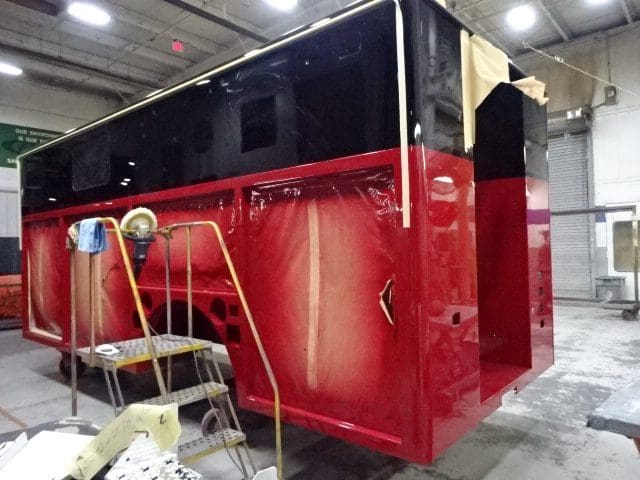

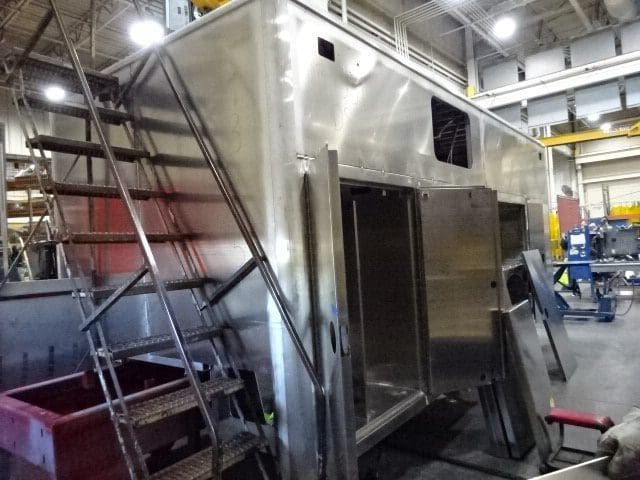

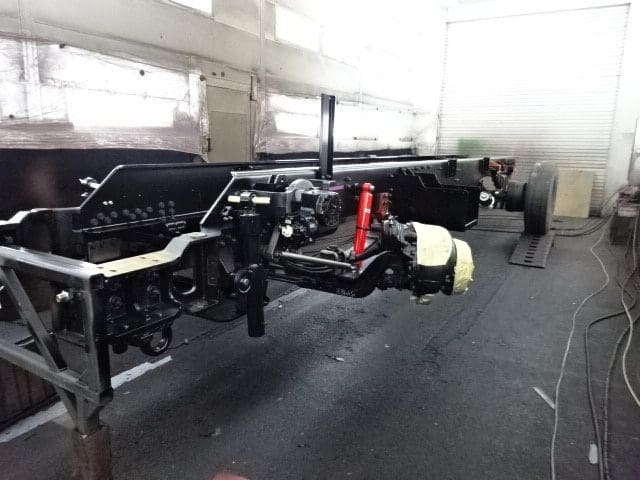

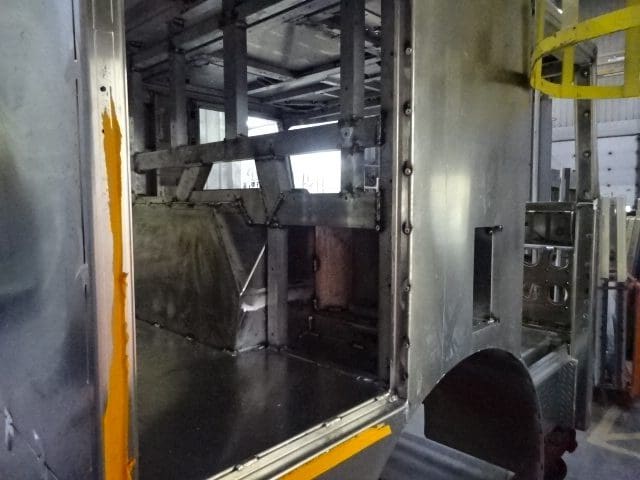

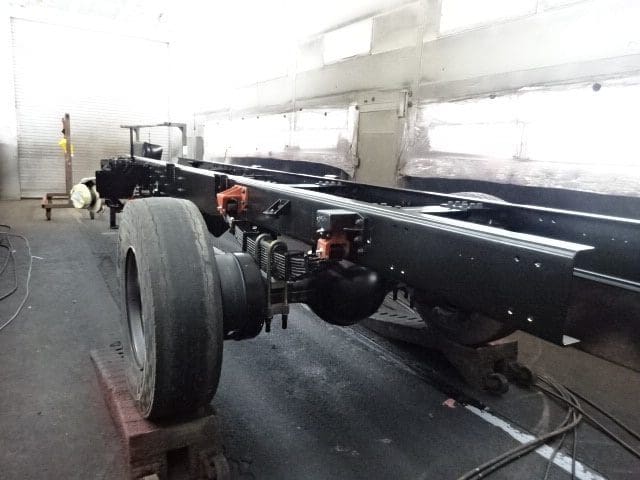

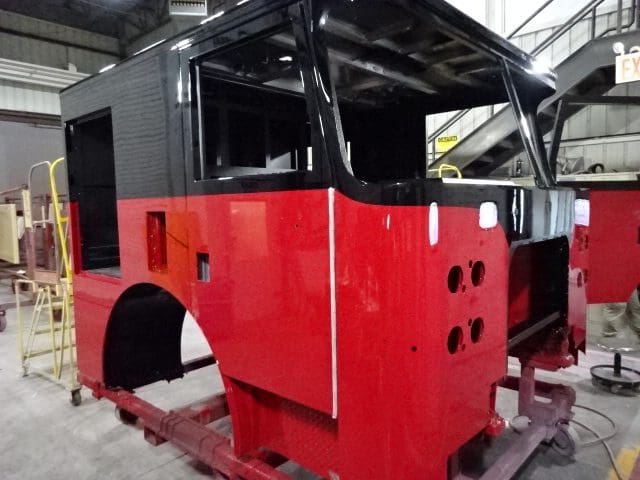

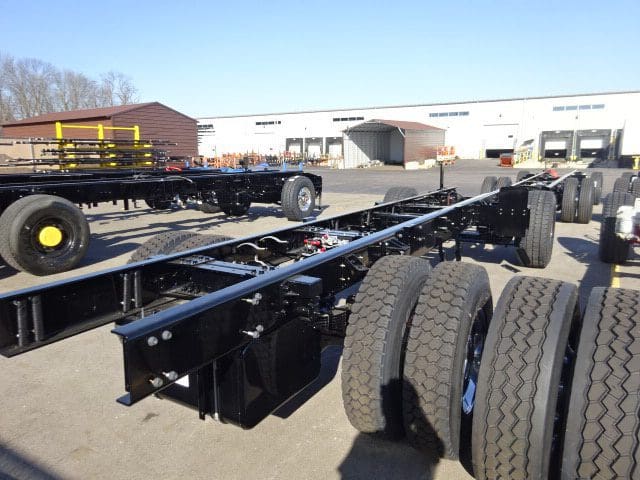

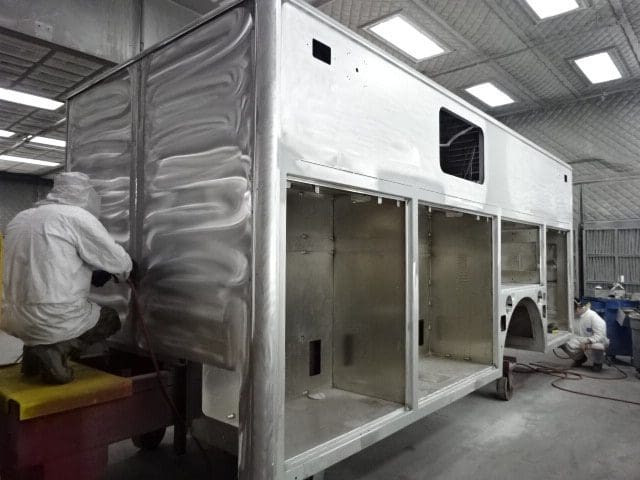

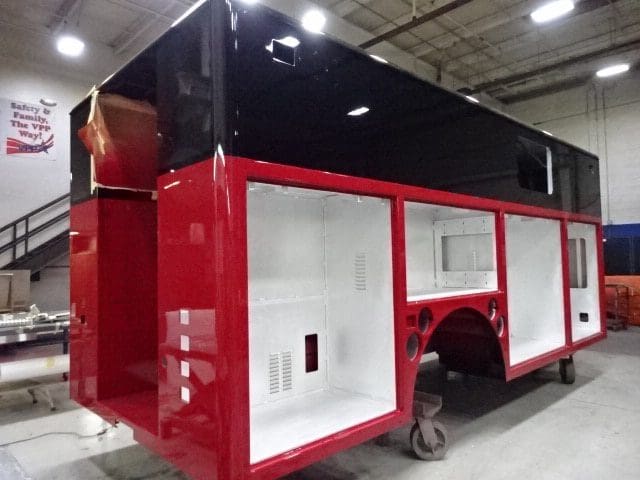

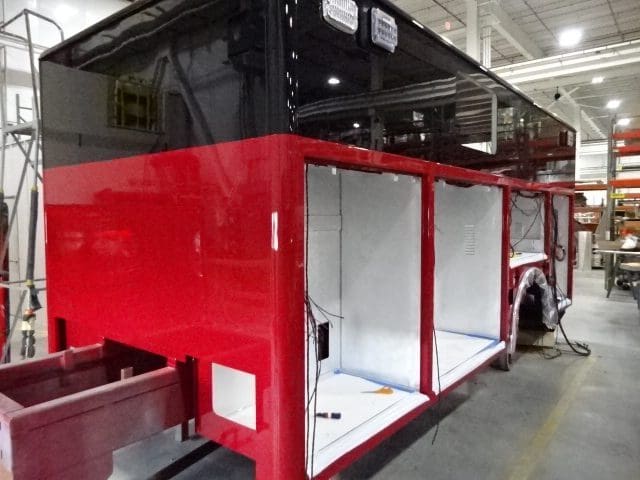

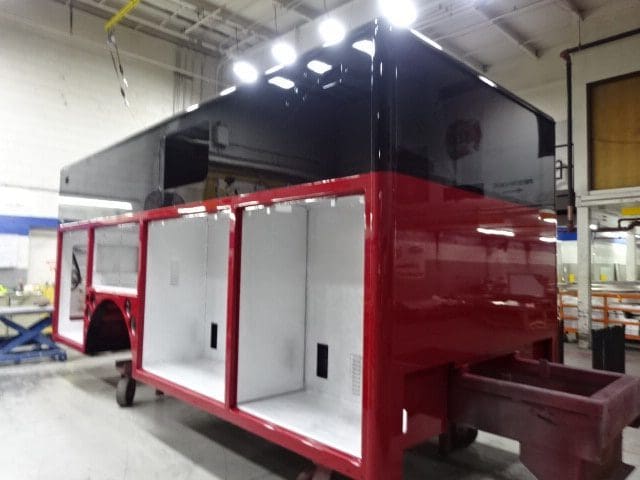

The cab continued through initial assembly and was staged, the frame build continued, and the body completed the paint process and began initial assembly.
04-21-23
The cab continued initial assembly, the frame build continued, and the body continued the paint process.
04-14-23
The cab continued initial assembly, the frame build continued, and your body continued through paint.
04-07-23

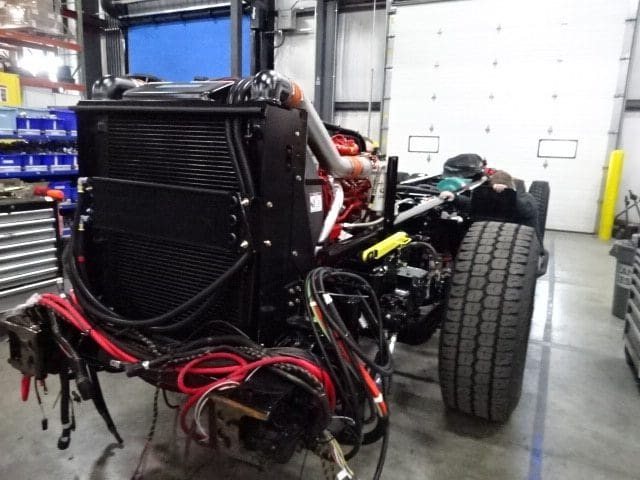

The cab began initial assembly, the frame build continued, and the body completed fabrication and began the paint process.

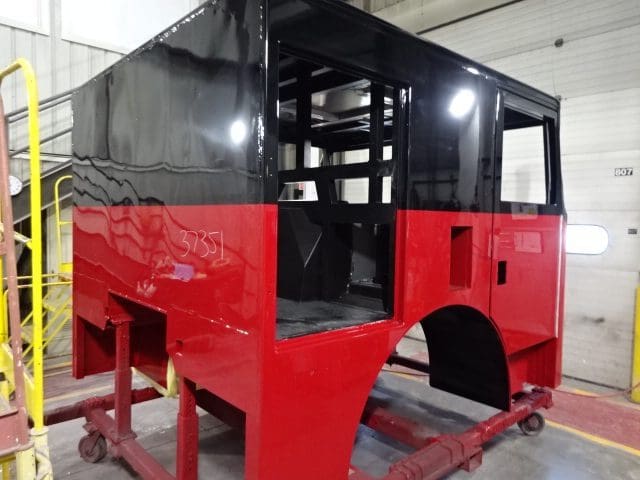

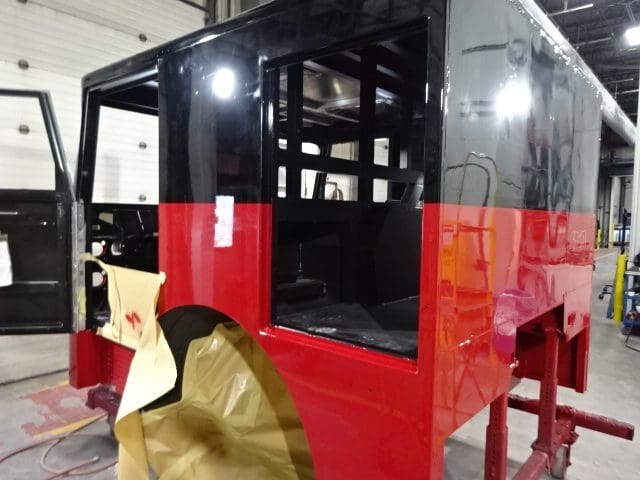

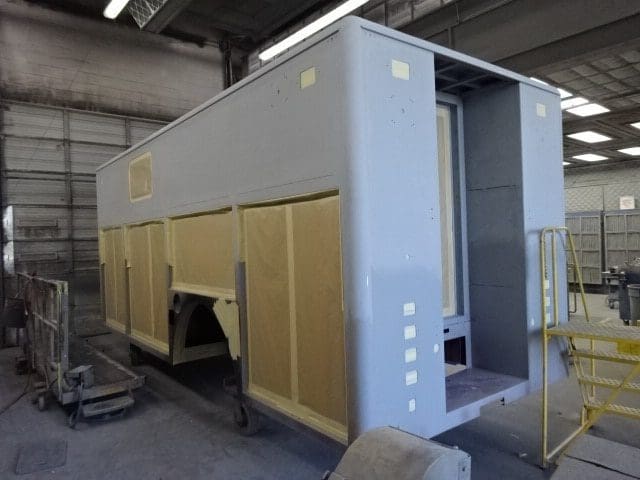

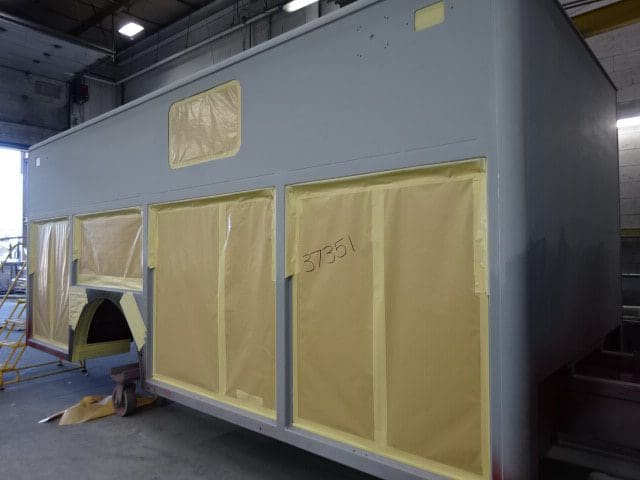

03-31-23

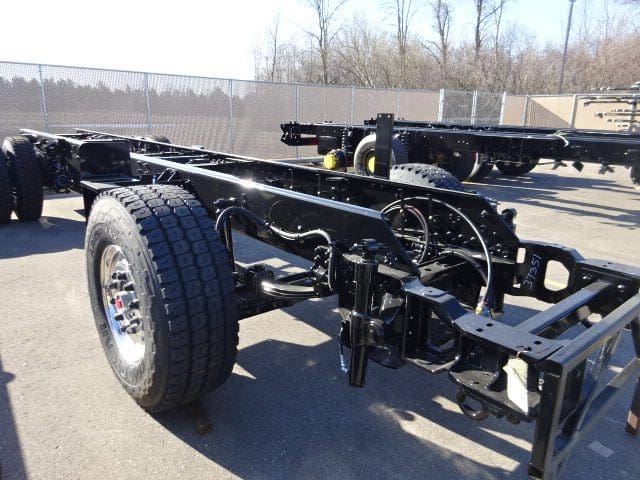

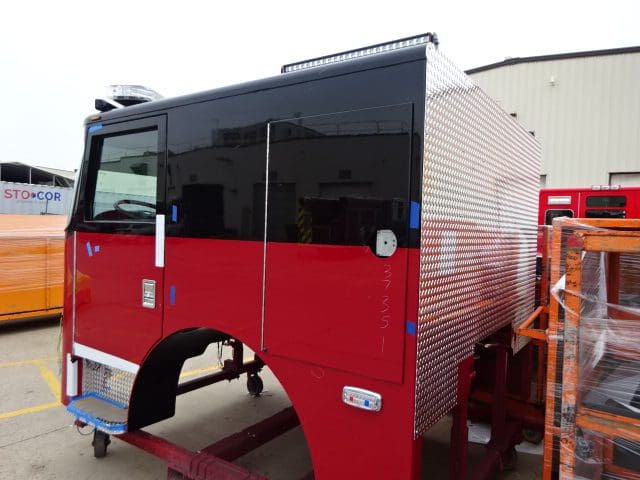

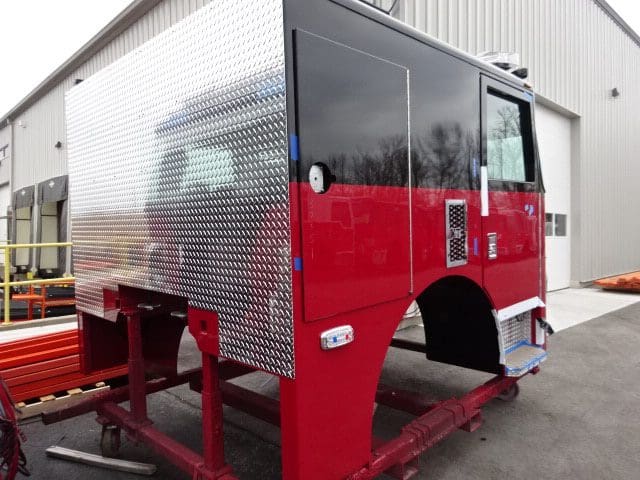

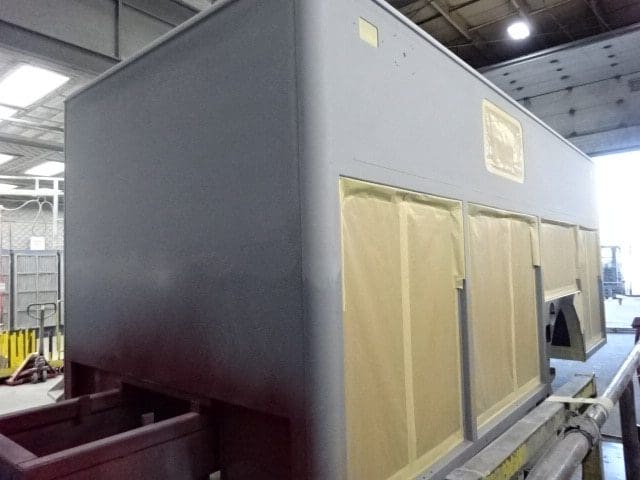

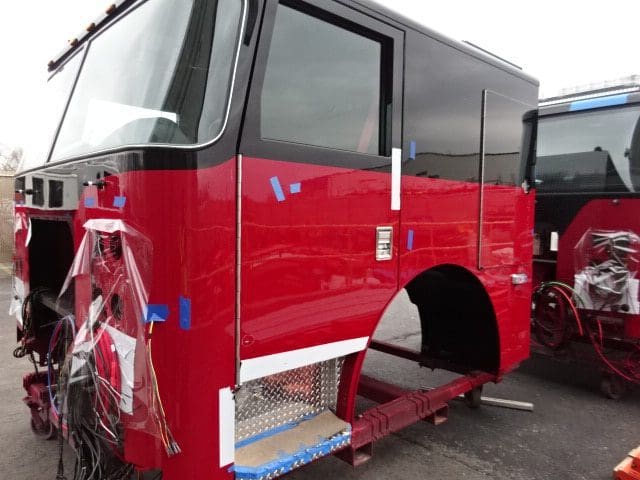

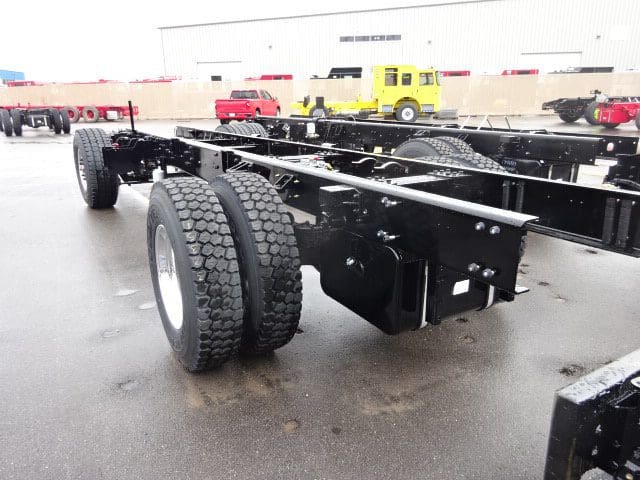

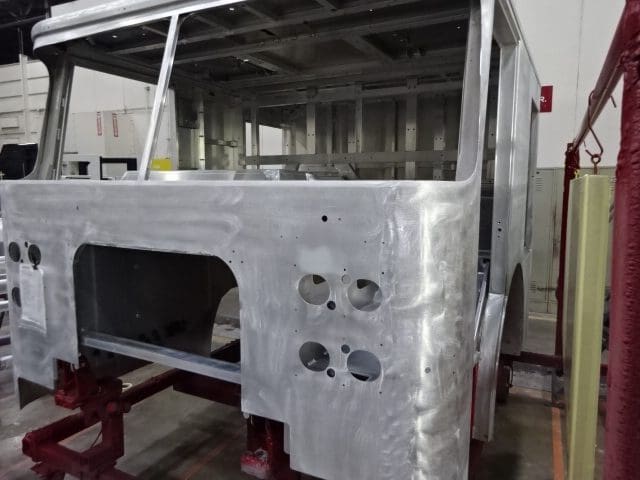

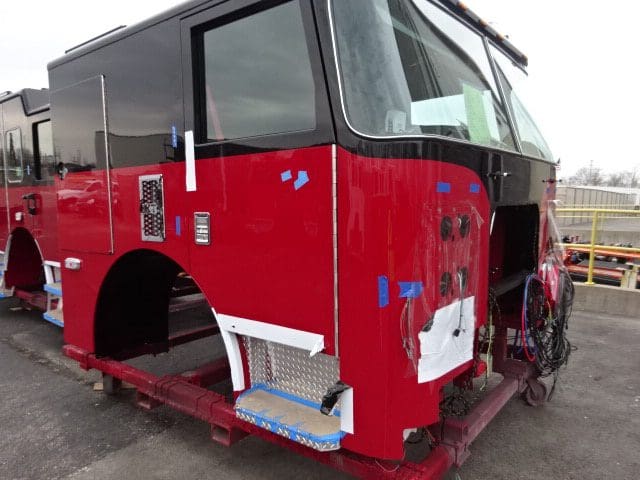

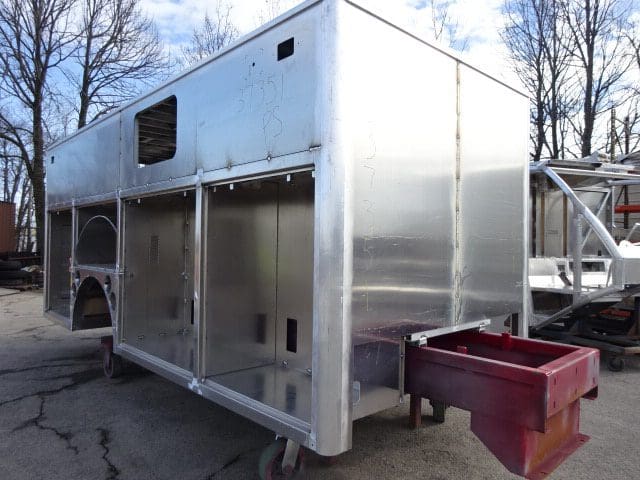

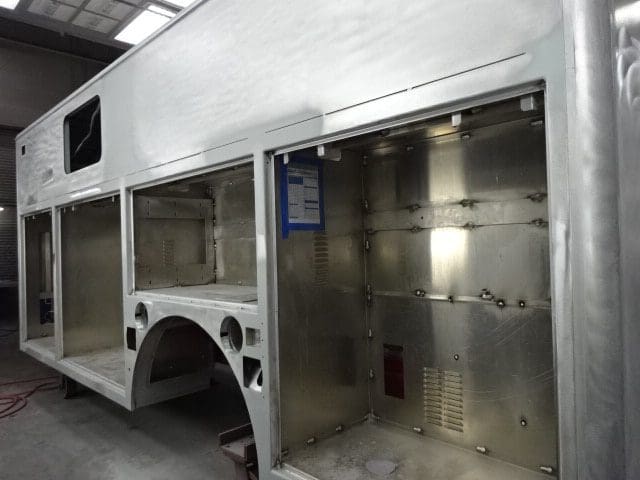

The cab completed paint and was staged, the frame build continued, and the body continued fabrication.
03-24-23

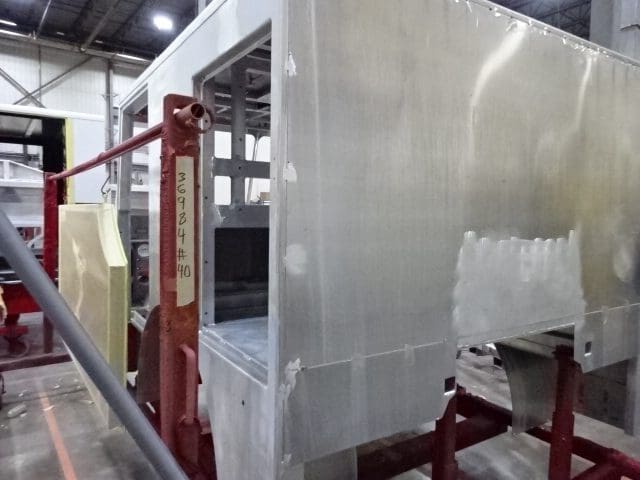

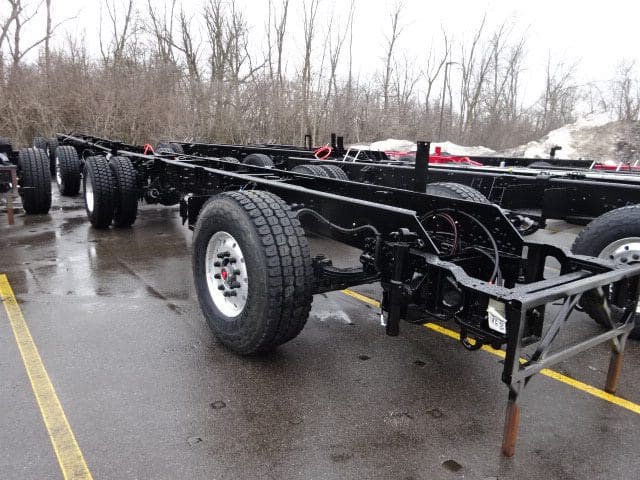

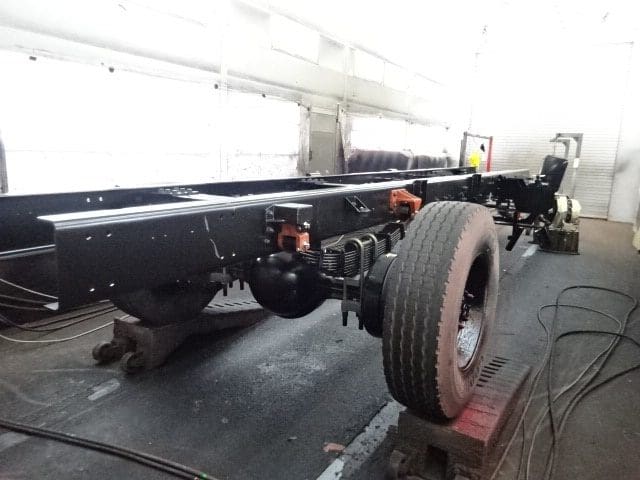

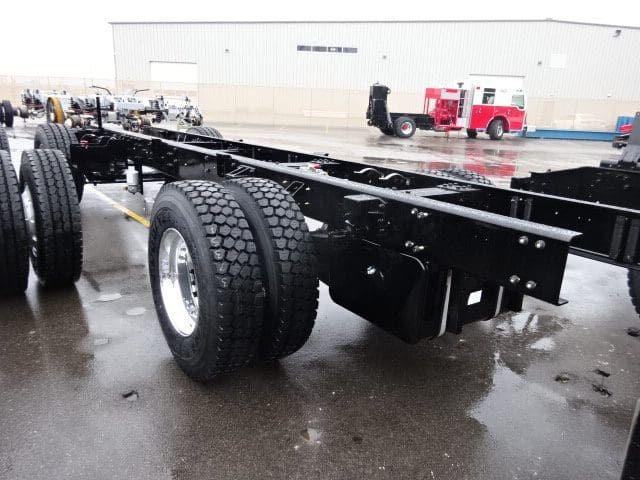

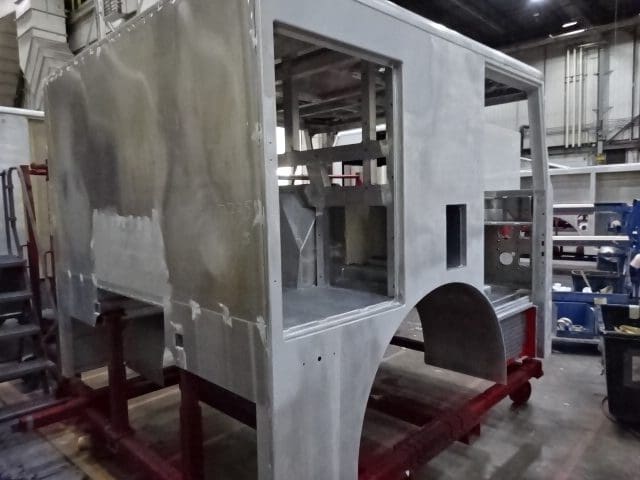

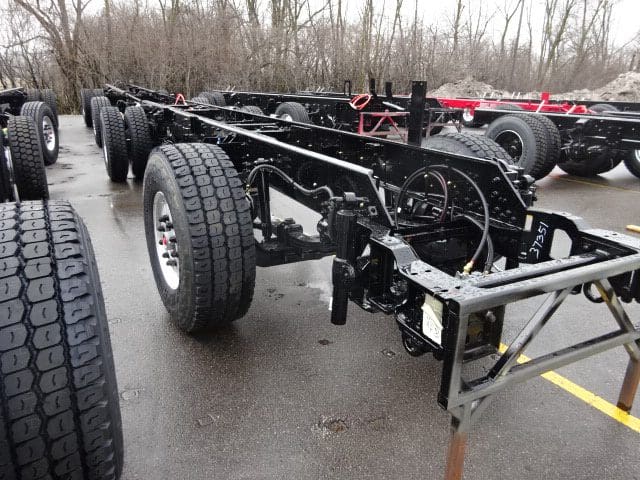

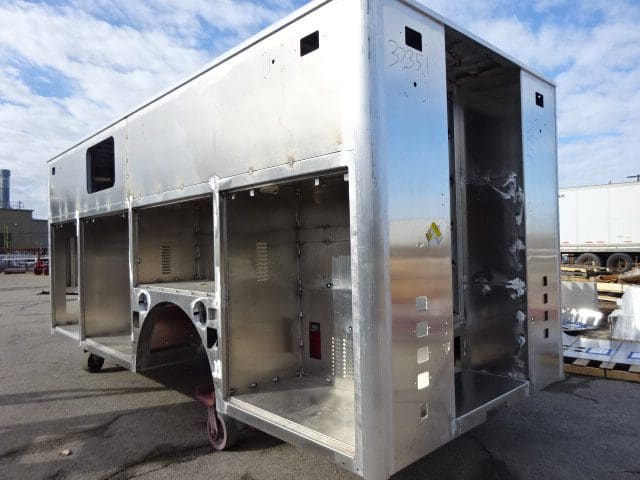

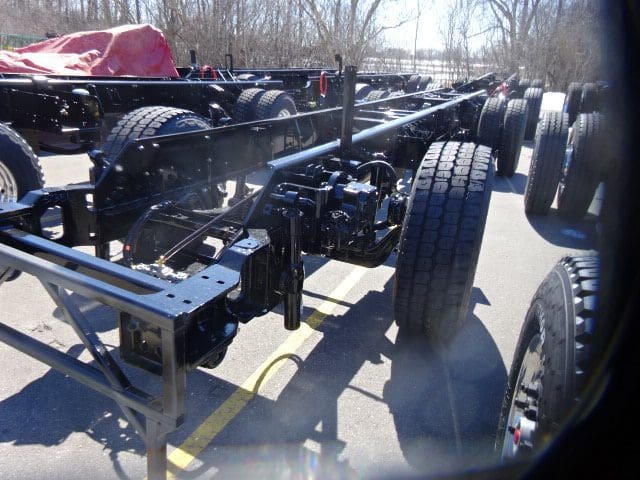

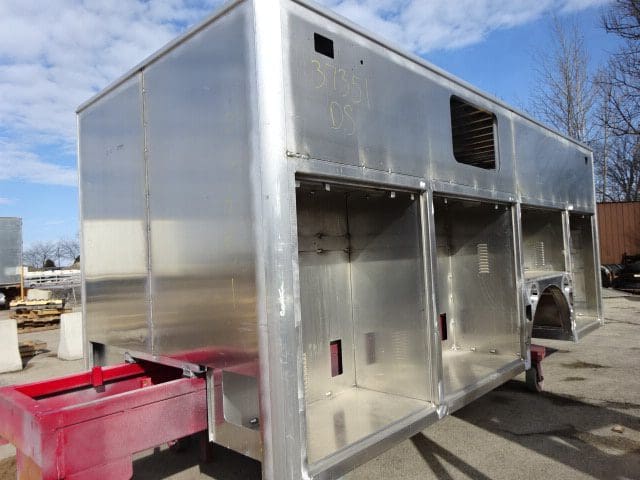

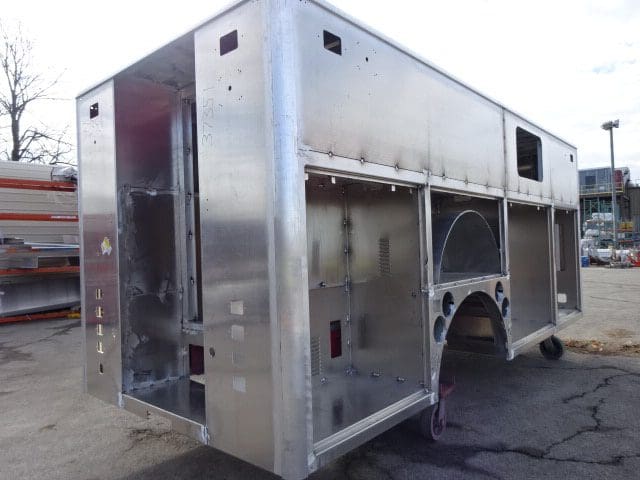

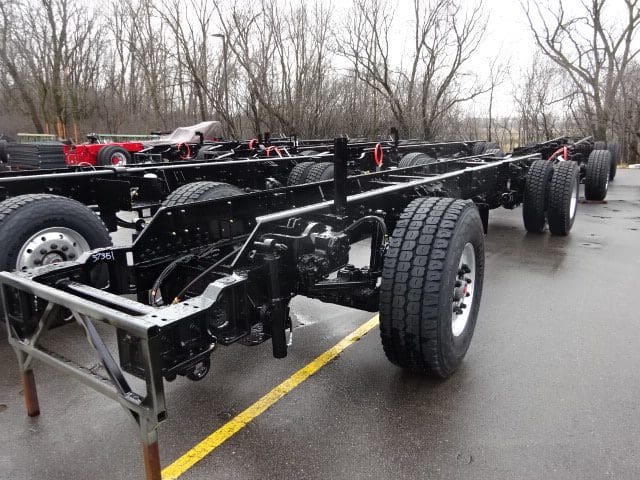

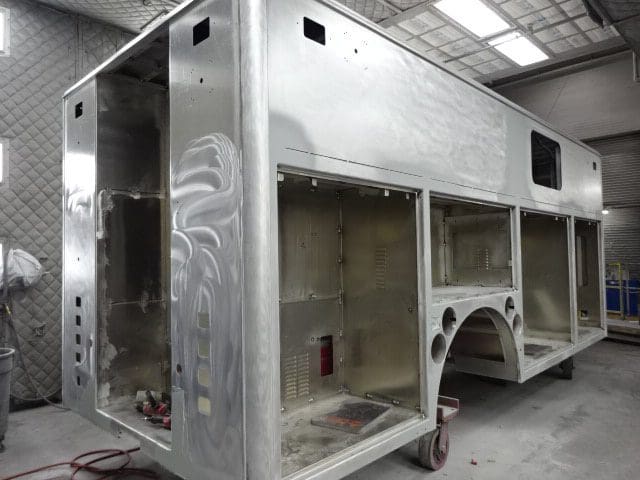

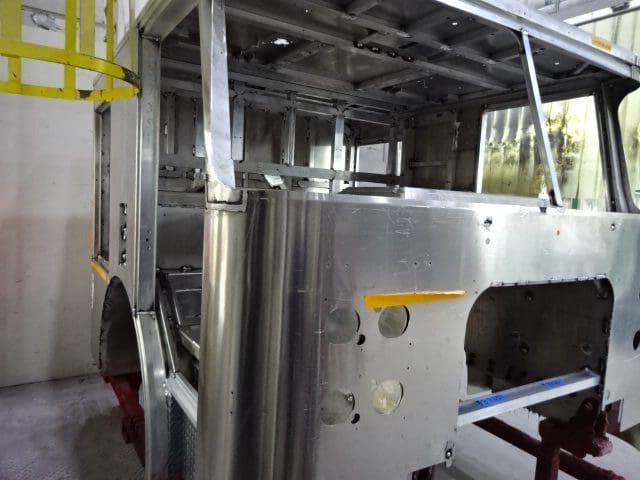

The cab continued the paint process, the frame build continued, and the body began fabrication.

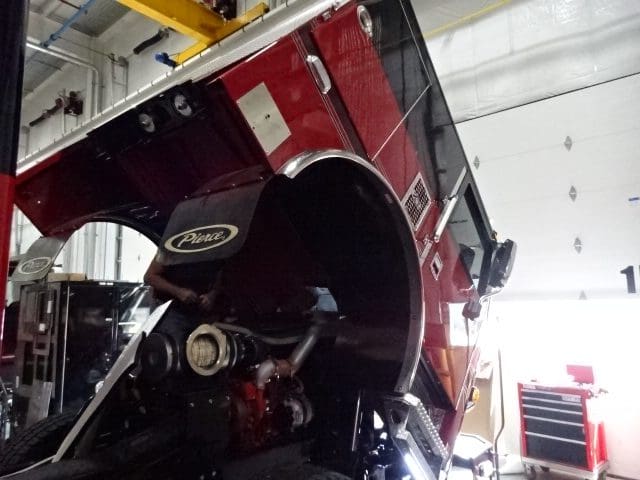

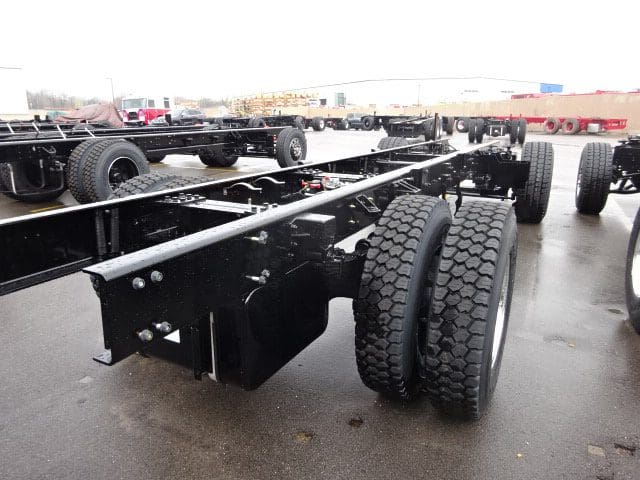

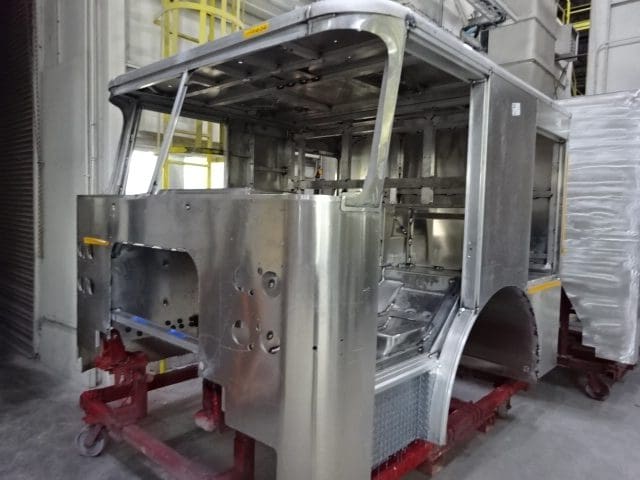

03-10-23

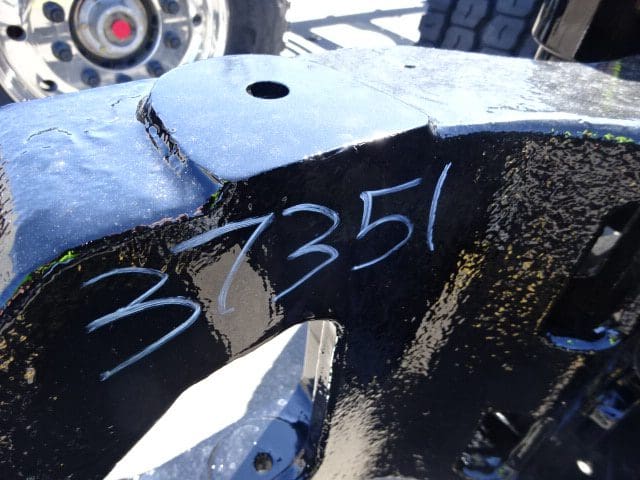

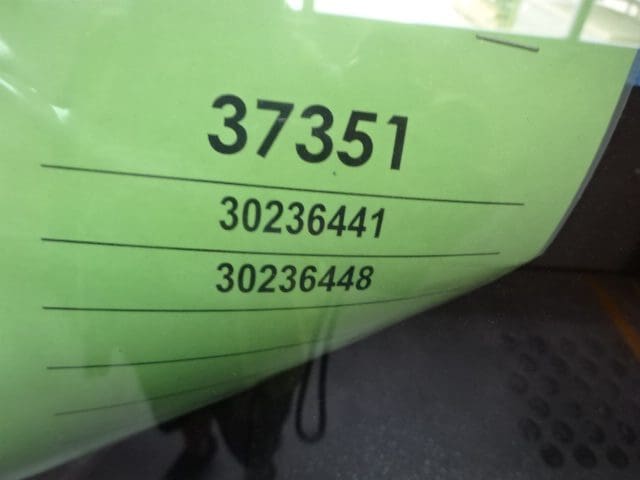

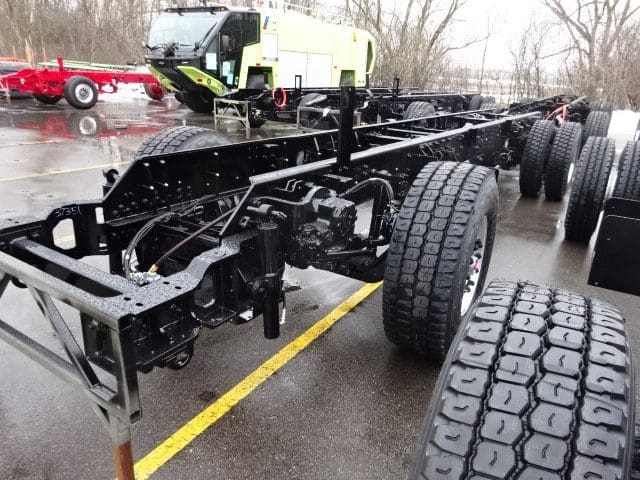

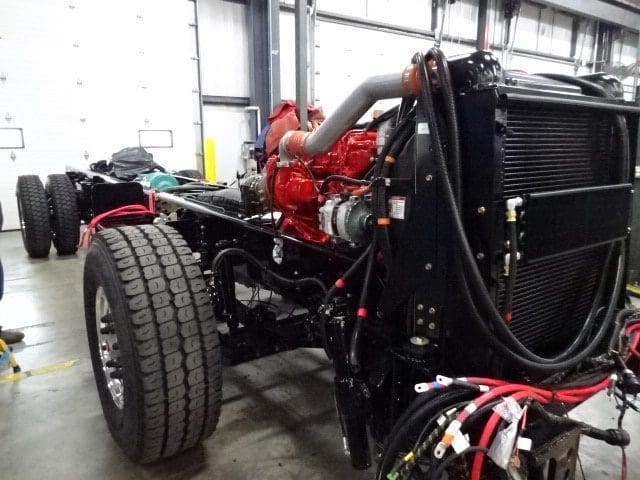

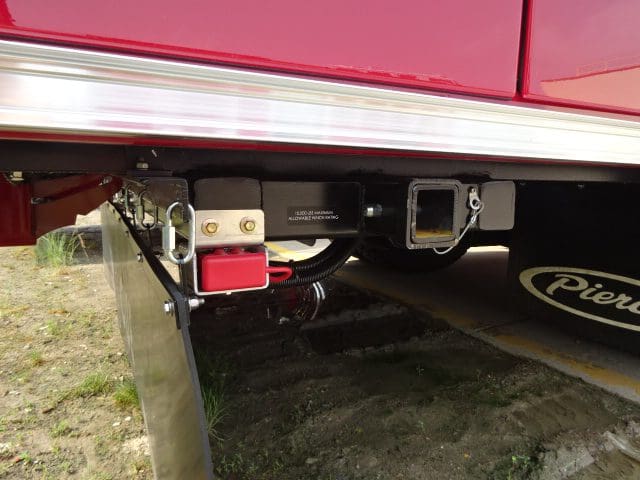

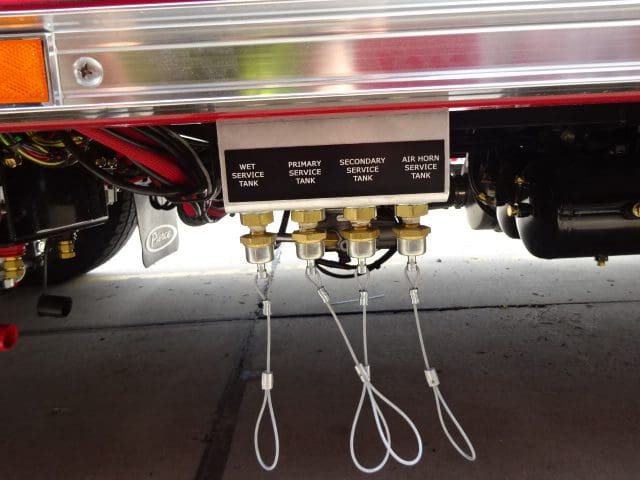

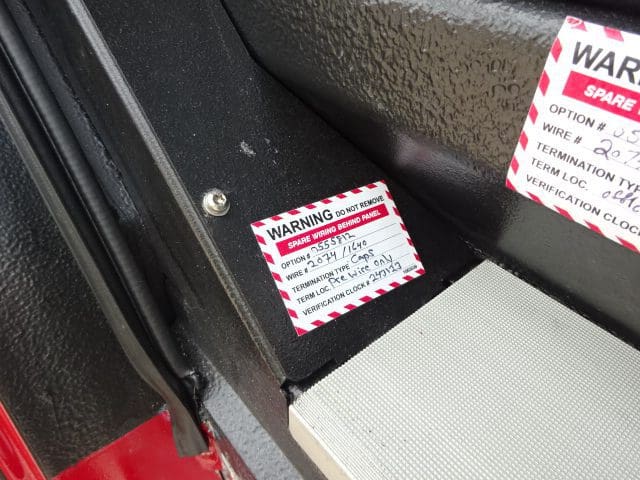

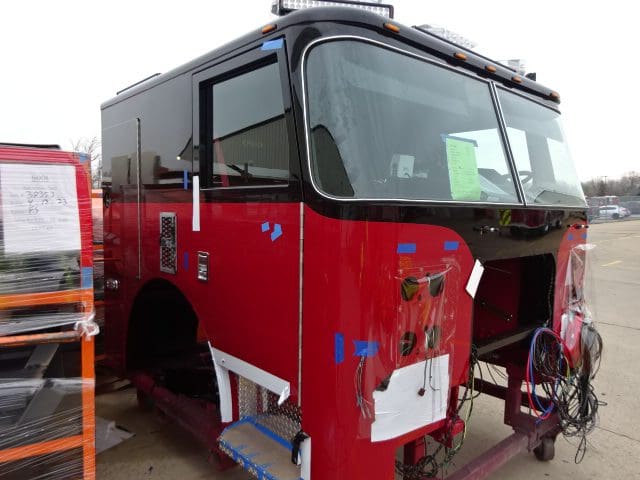

This Pierce apparatus is now in production. In this report, the cab was fabricated and began the paint process.
