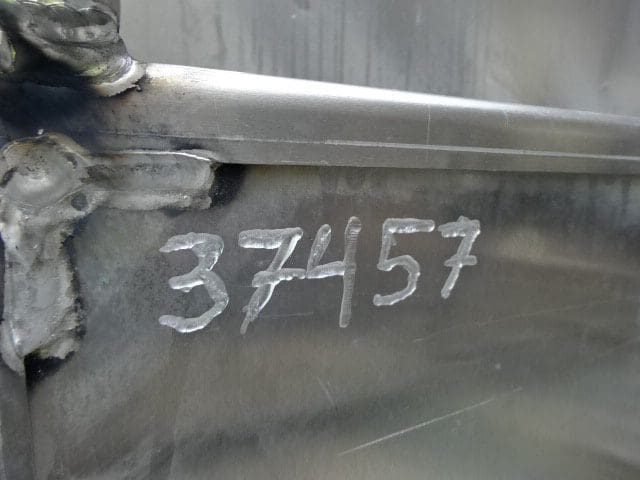

37457 – Howell – Enforcer 107′ Ascendant Aerial

Enforcer 107' Ascendant Aerial

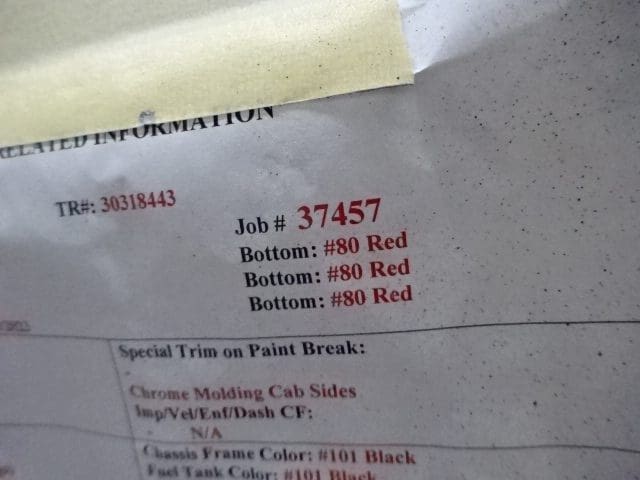

Job #: 37457

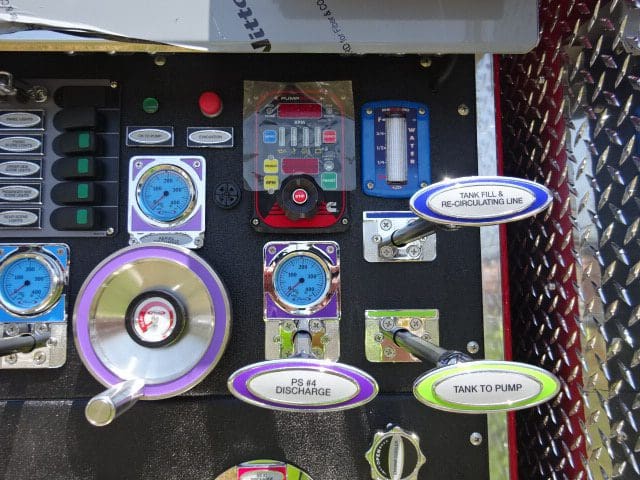

PROGRESS UPDATES

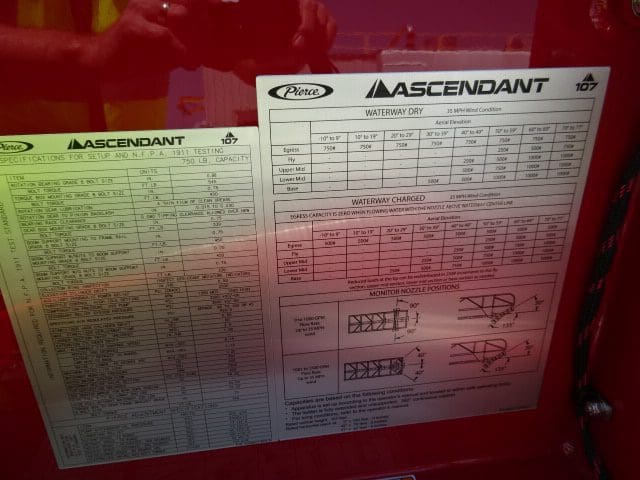

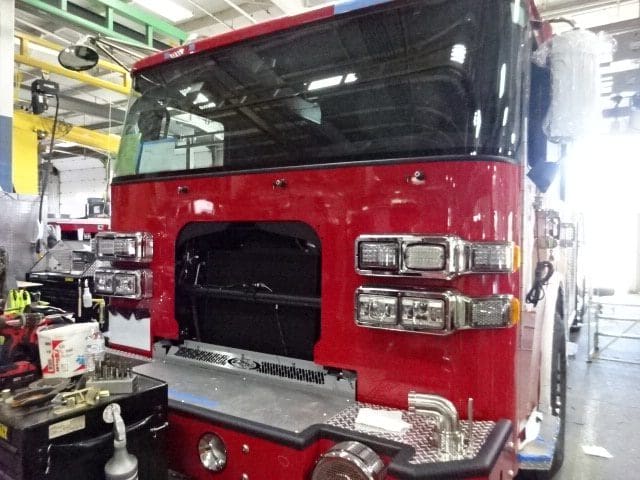

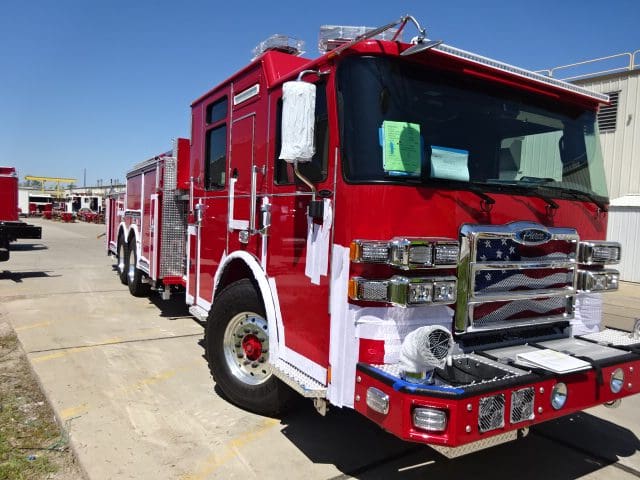

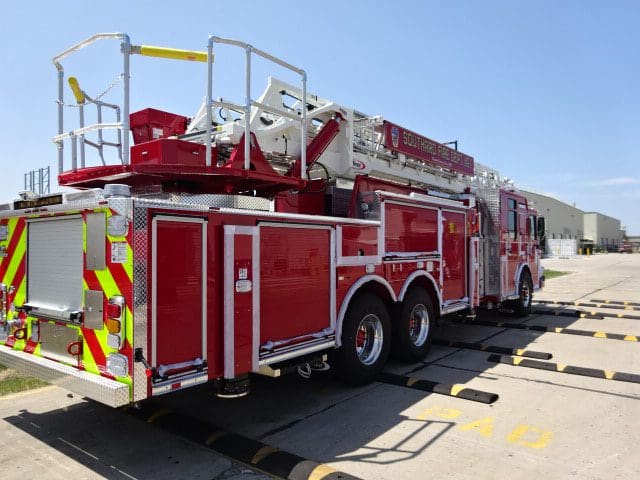

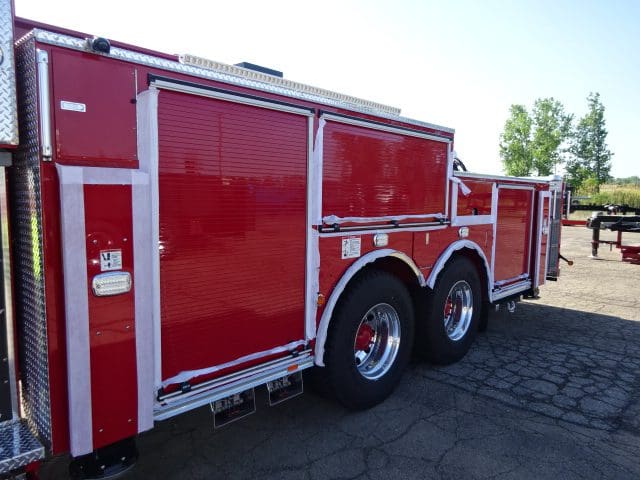

06-02-23

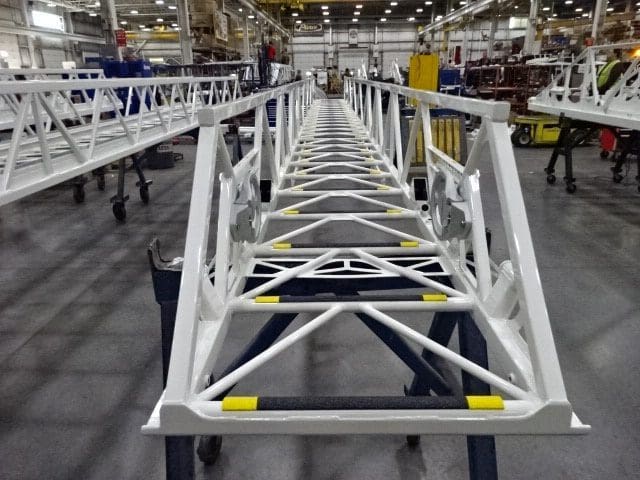

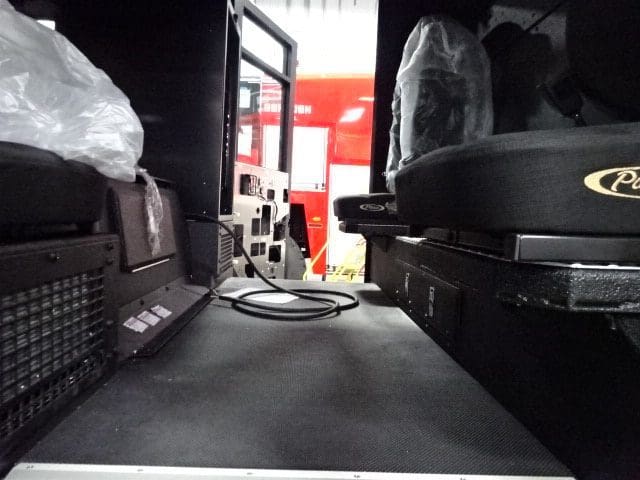

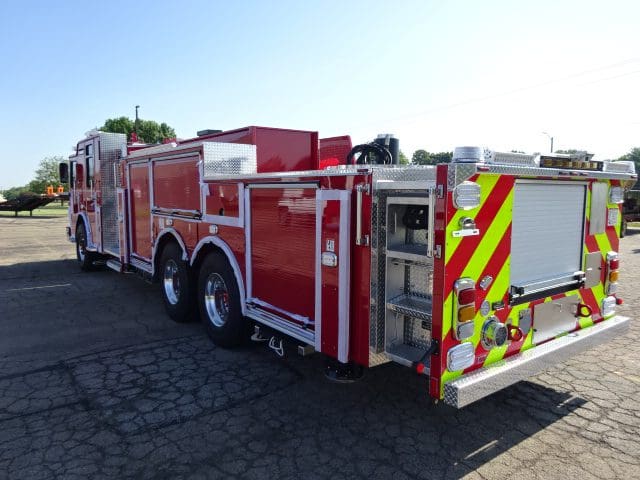

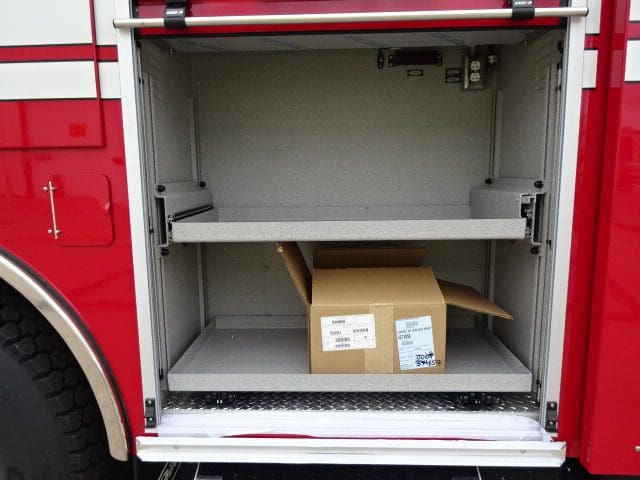

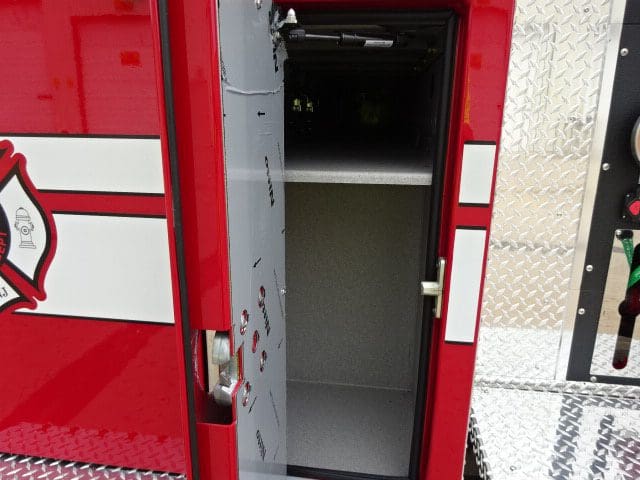

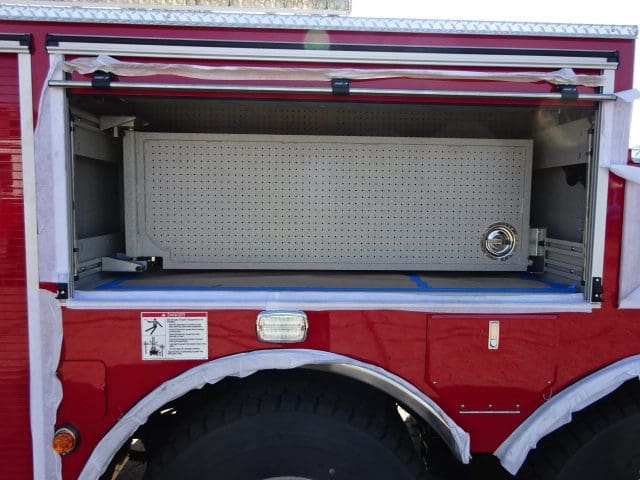

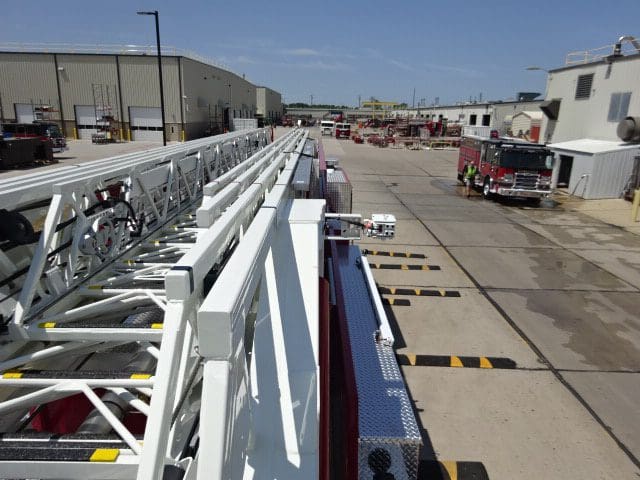

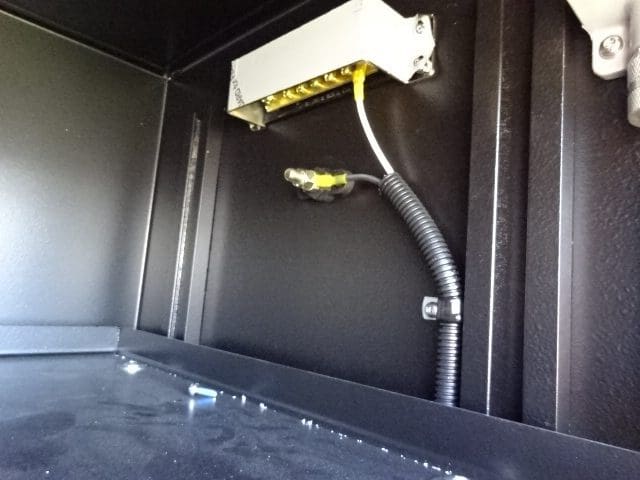

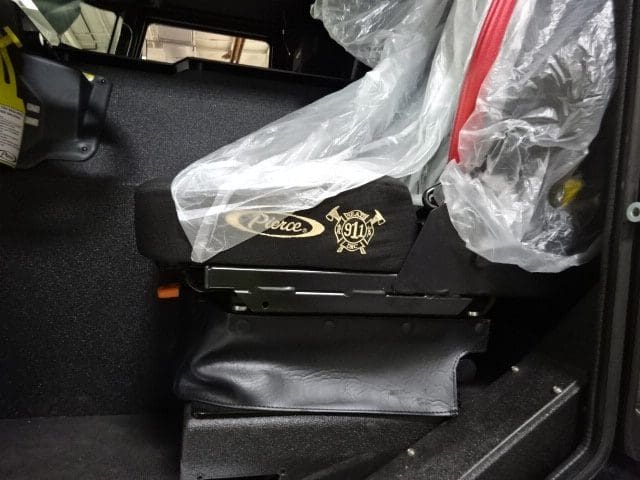

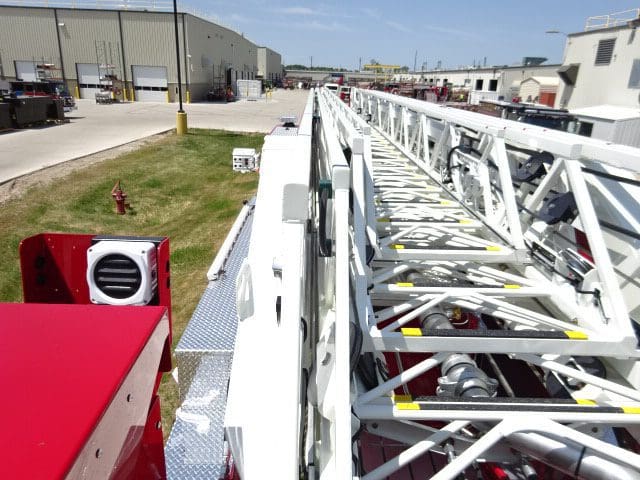

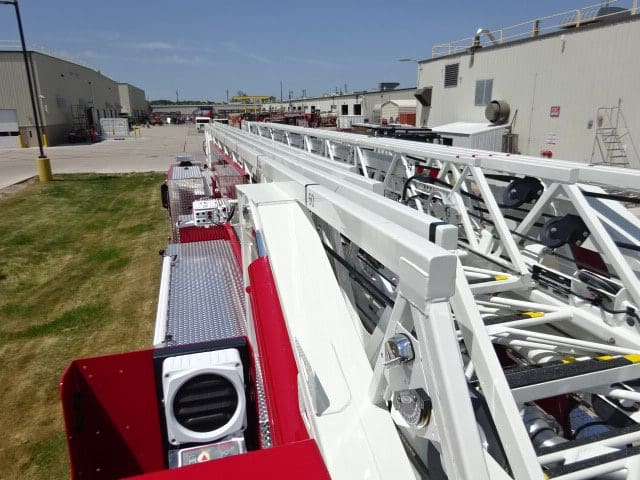

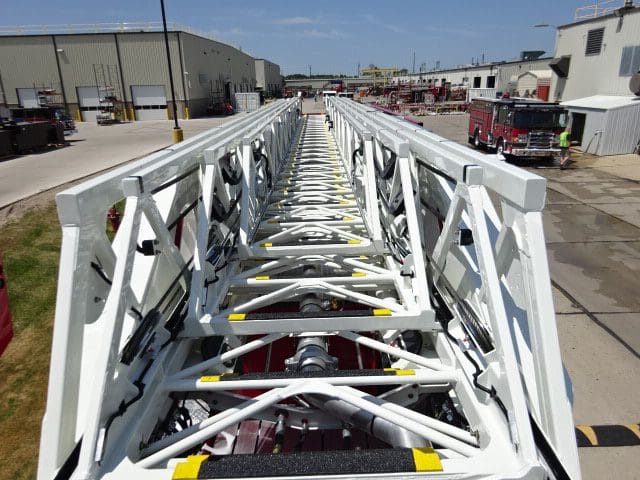

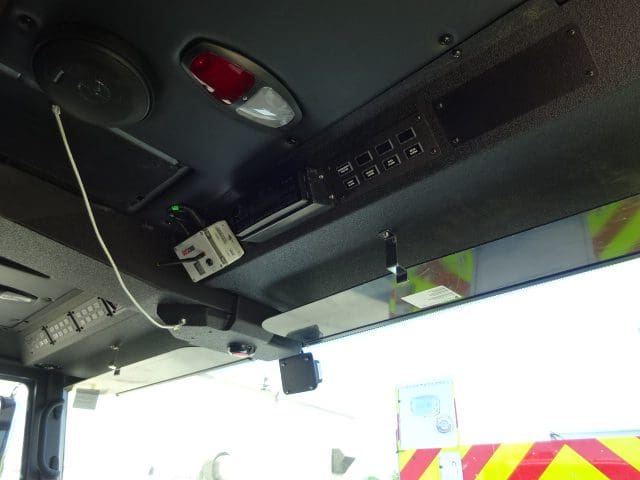

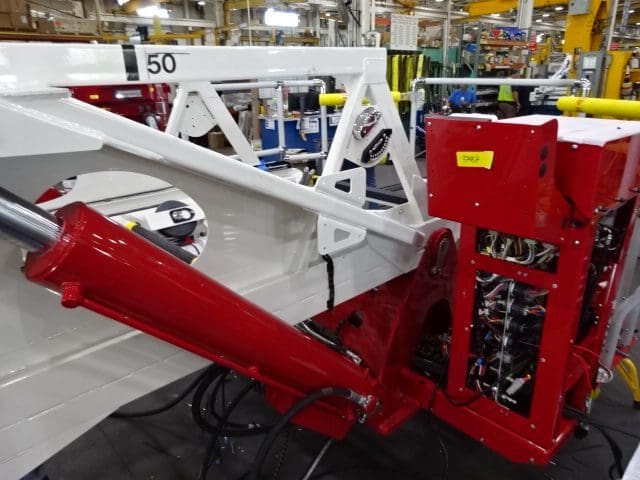

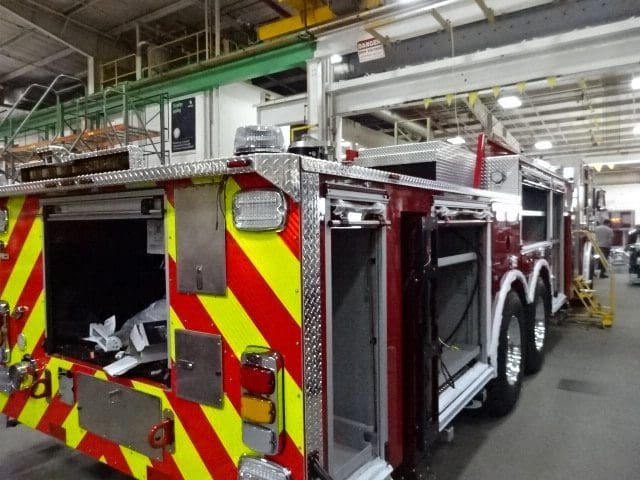

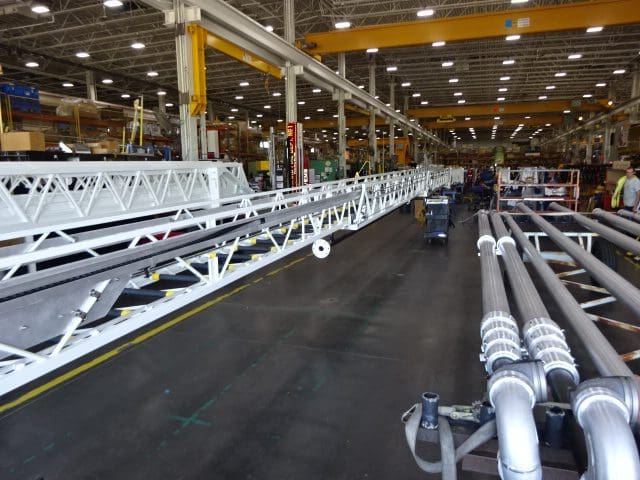

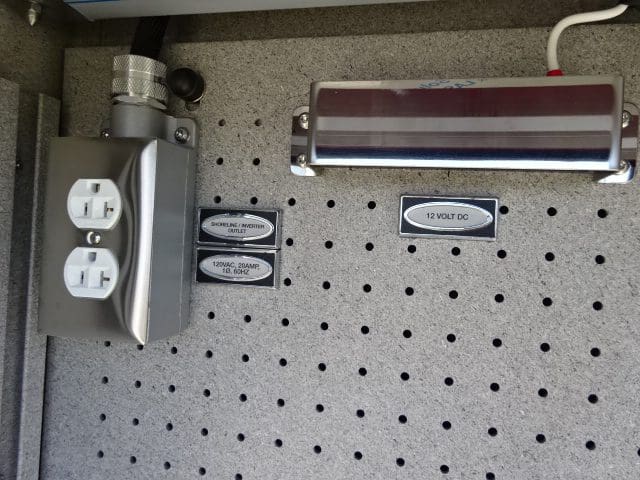

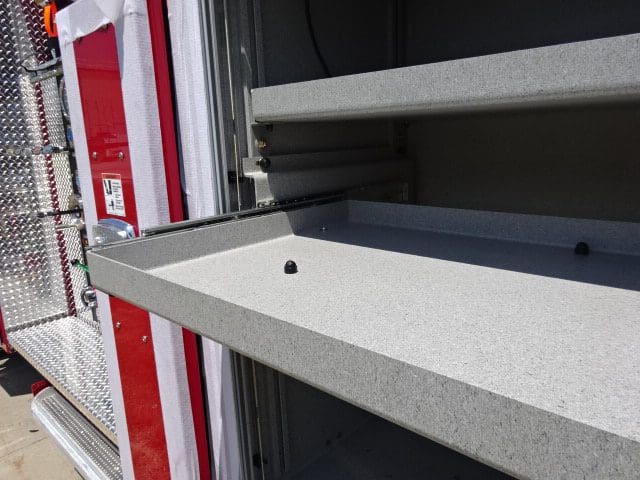

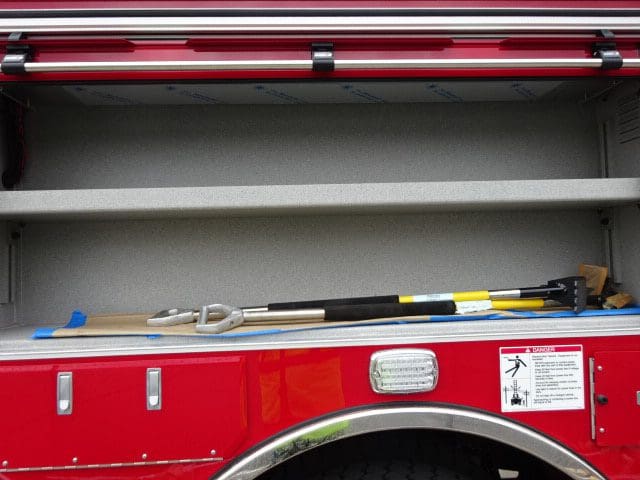

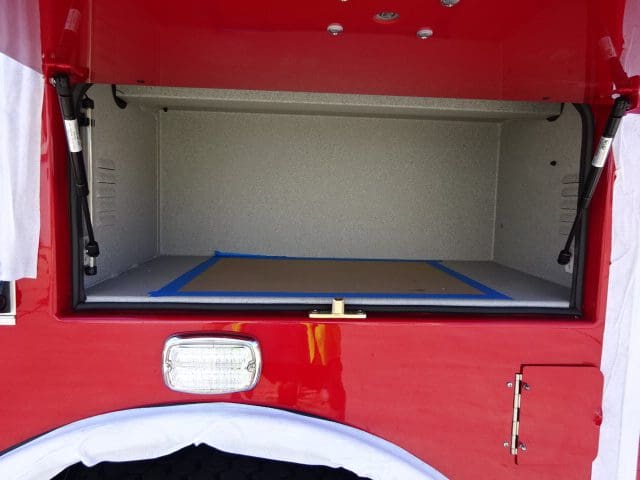

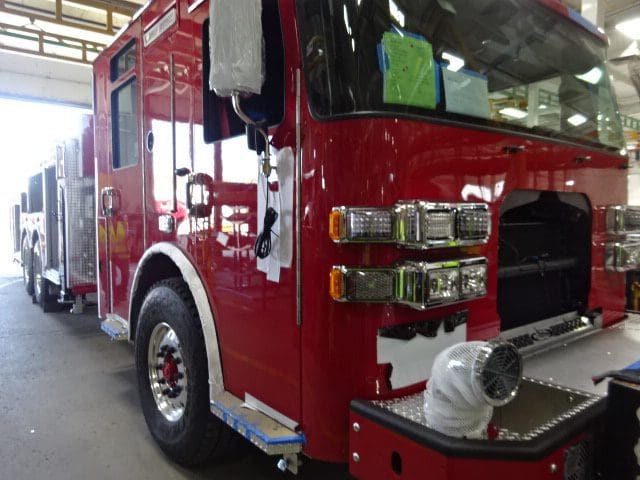

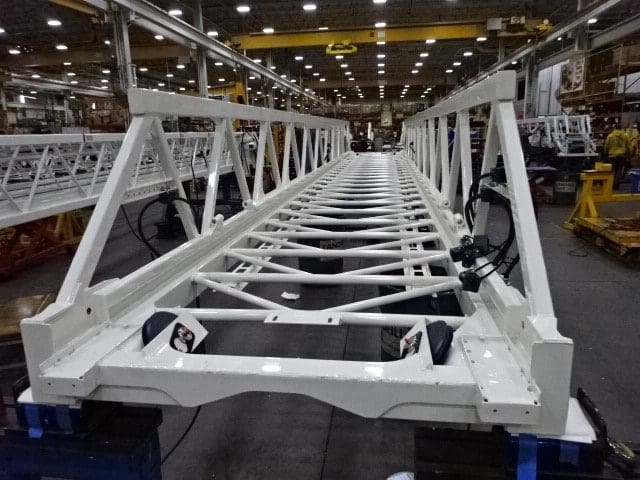

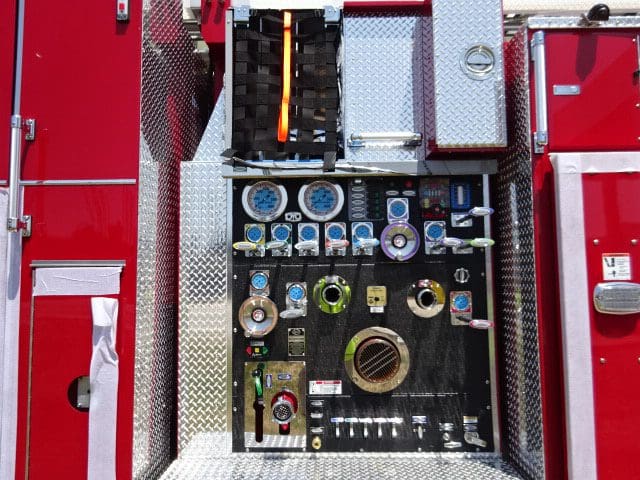

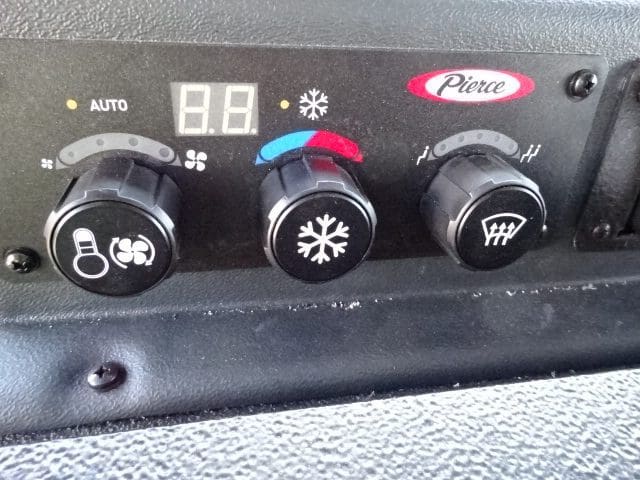

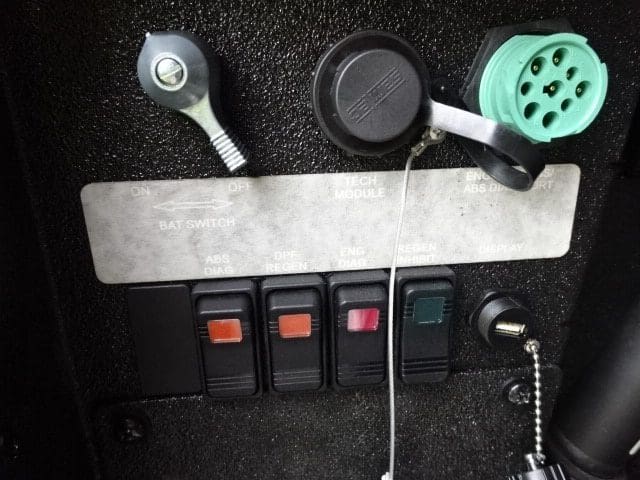

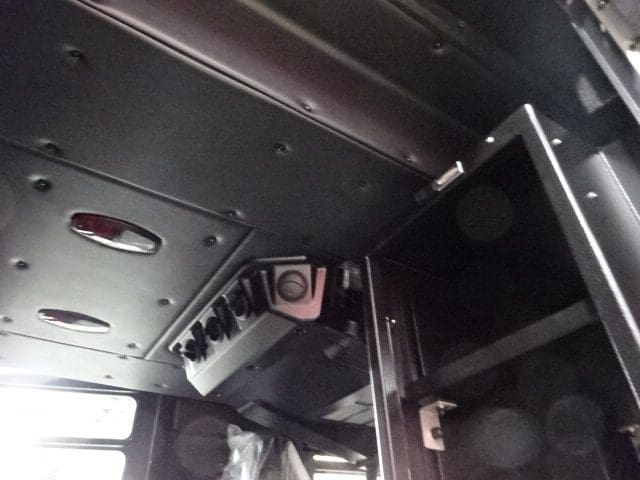

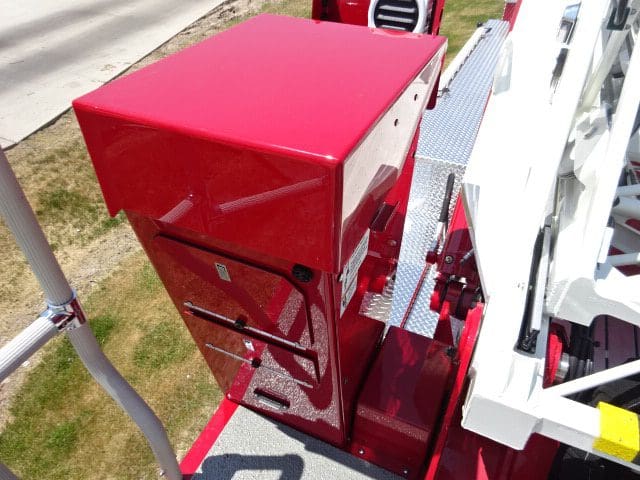

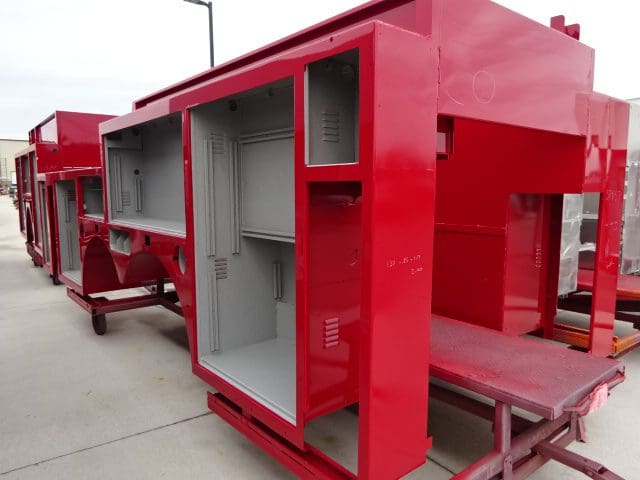

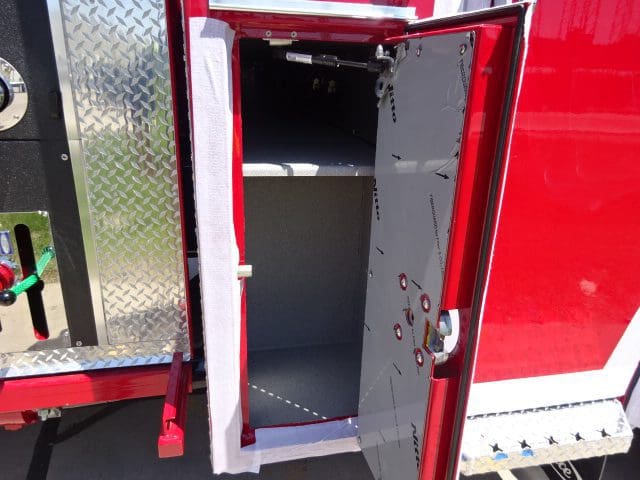

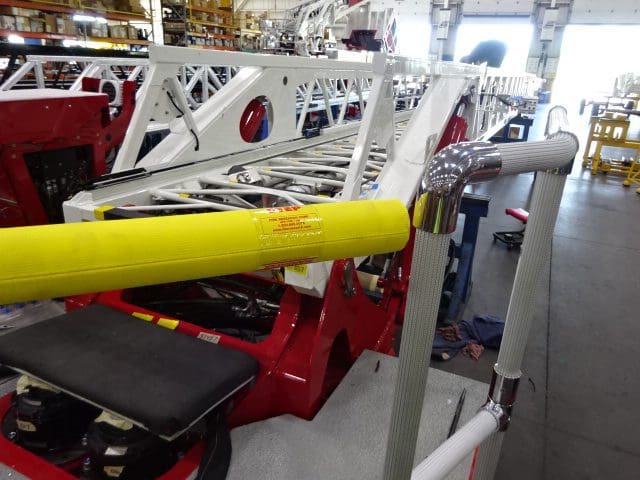

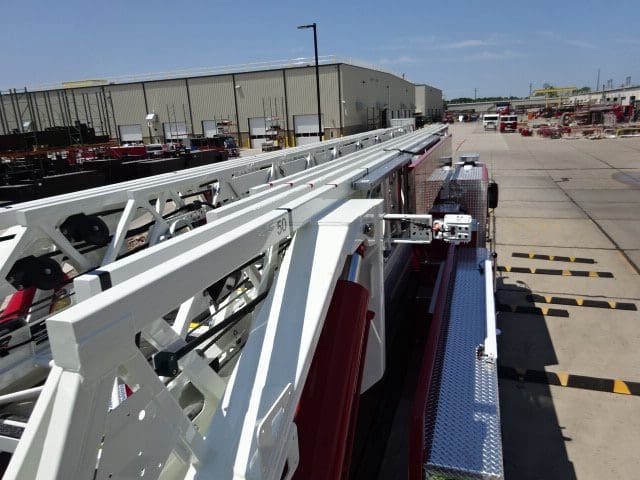

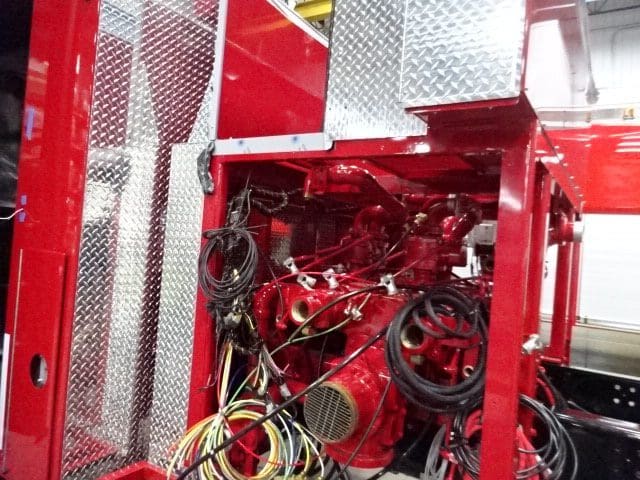

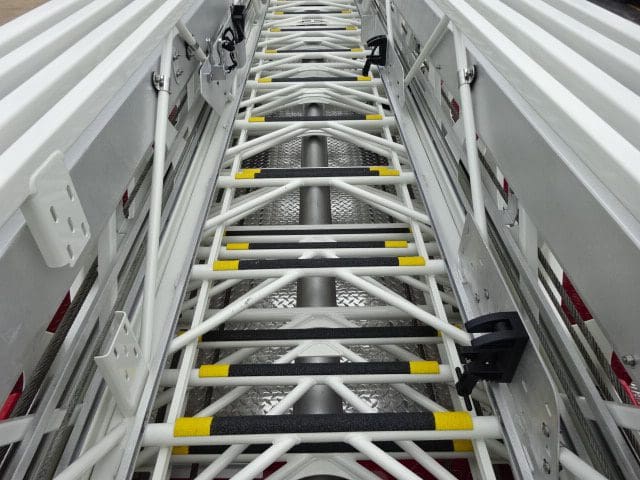

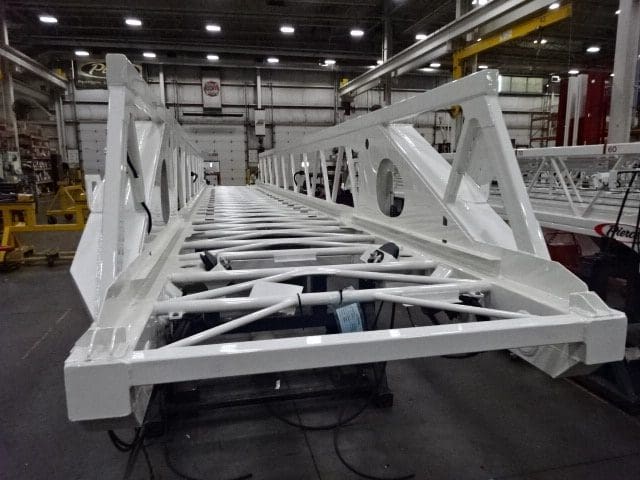

In this report, the apparatus remained staged while the aerial device continued assembly.

05-12-23

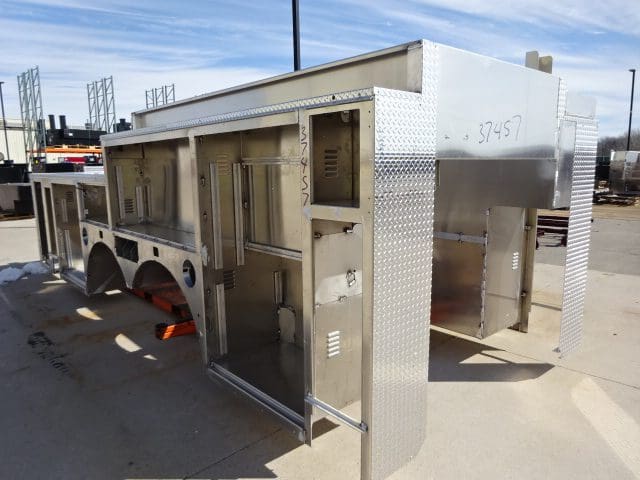

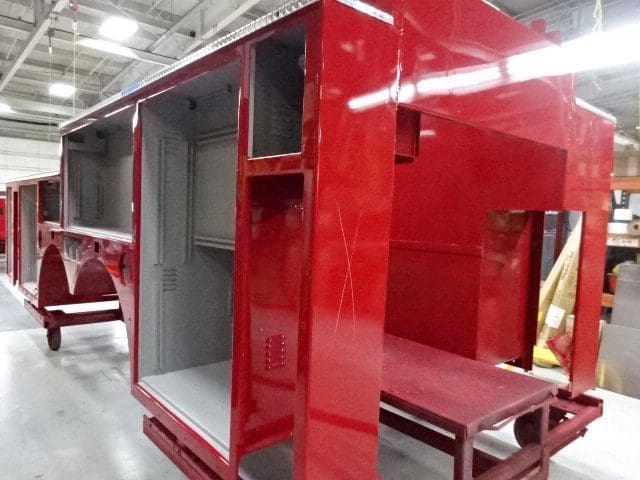

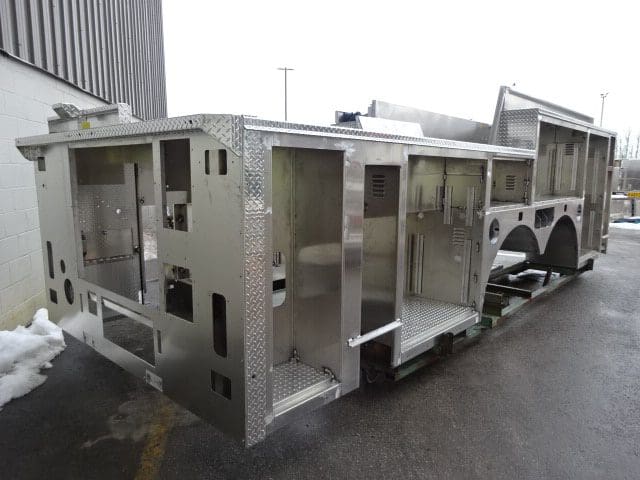

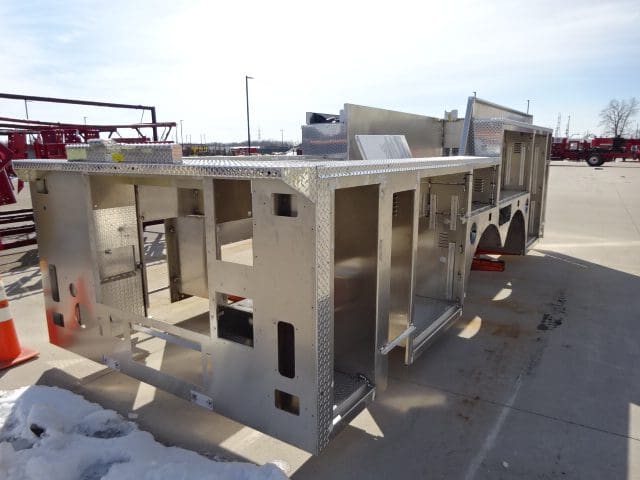

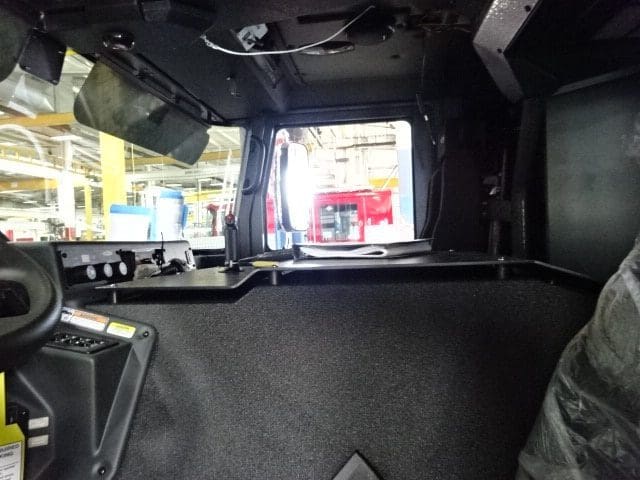

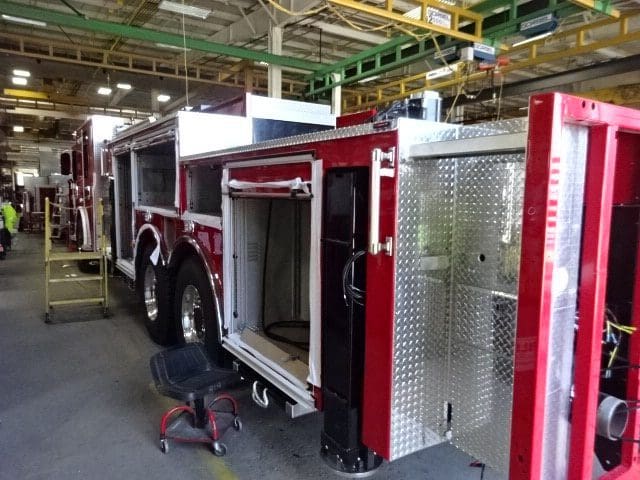

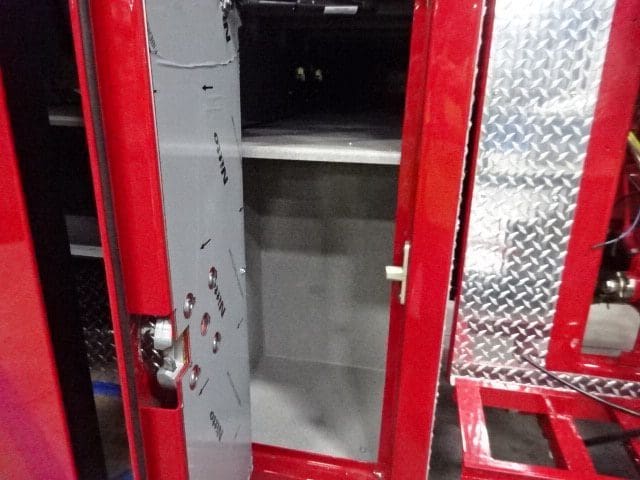

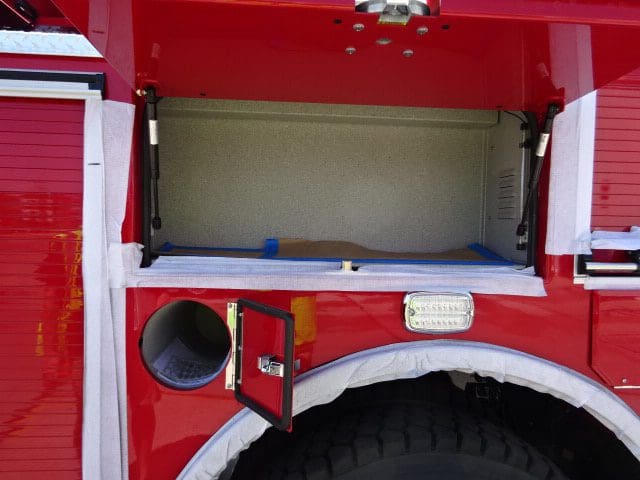

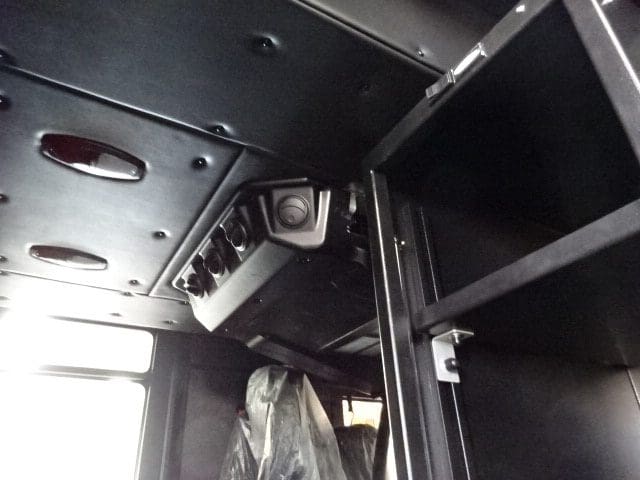

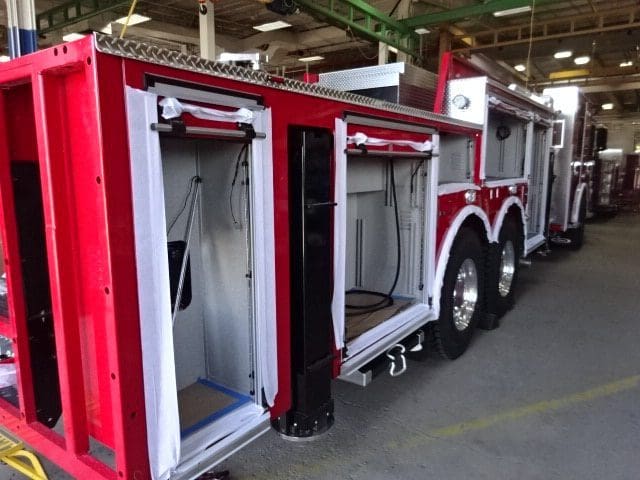

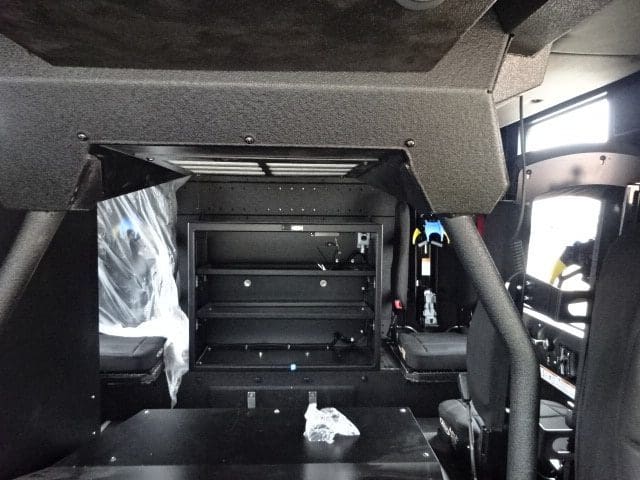

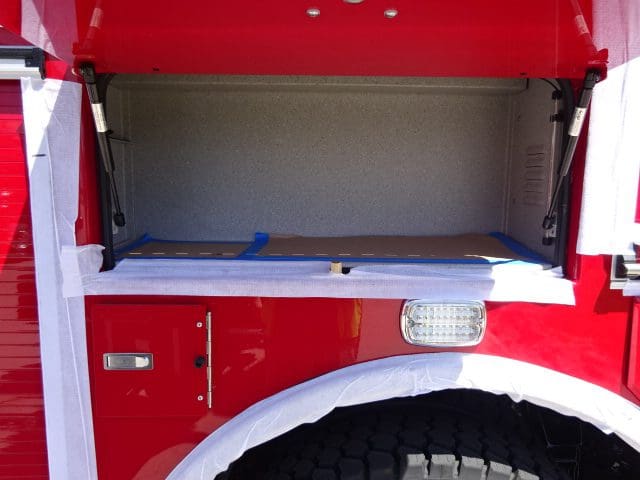

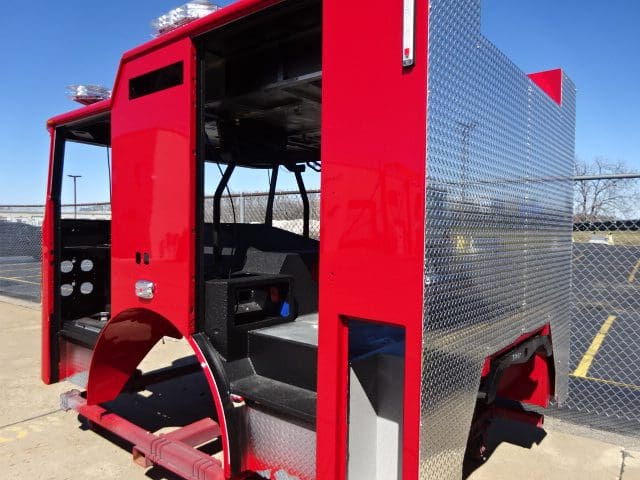

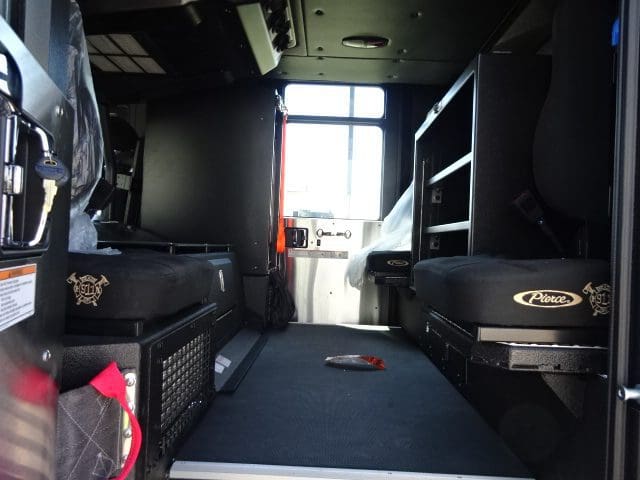

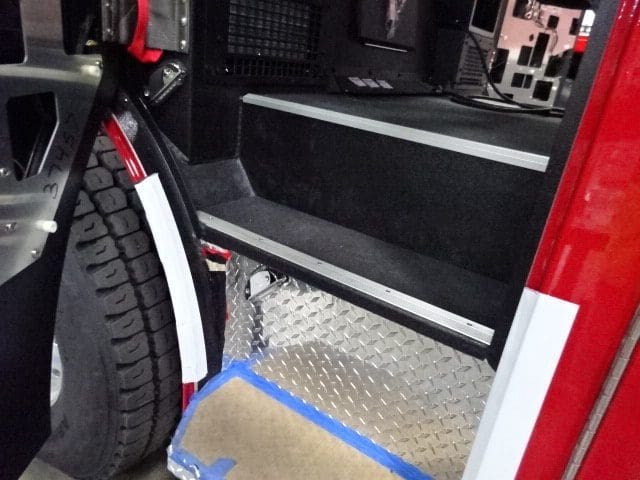

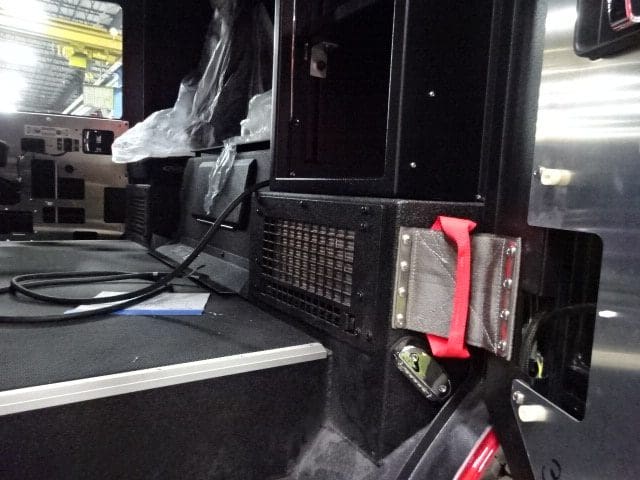

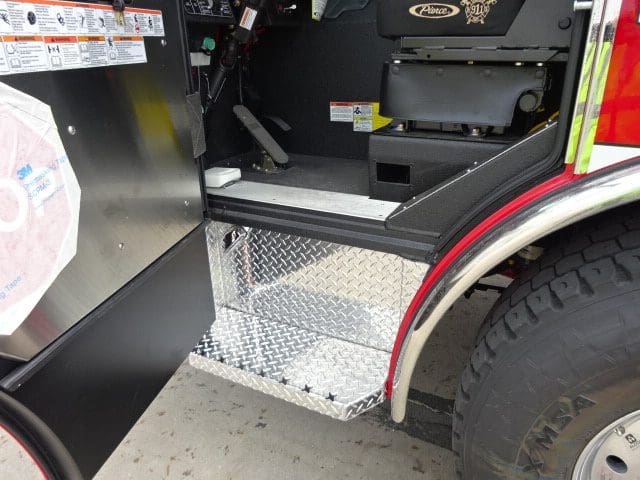

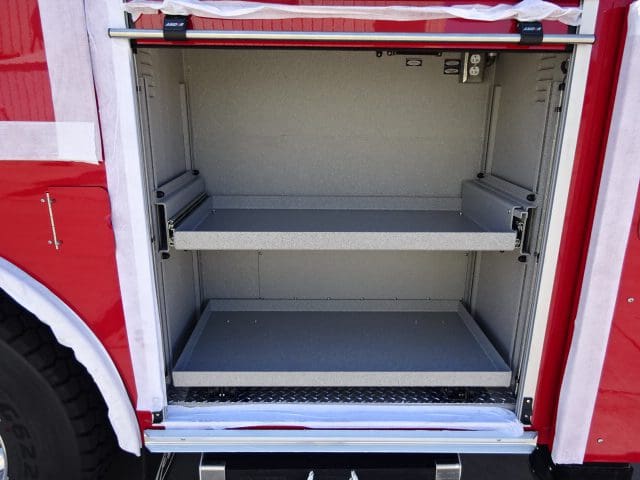

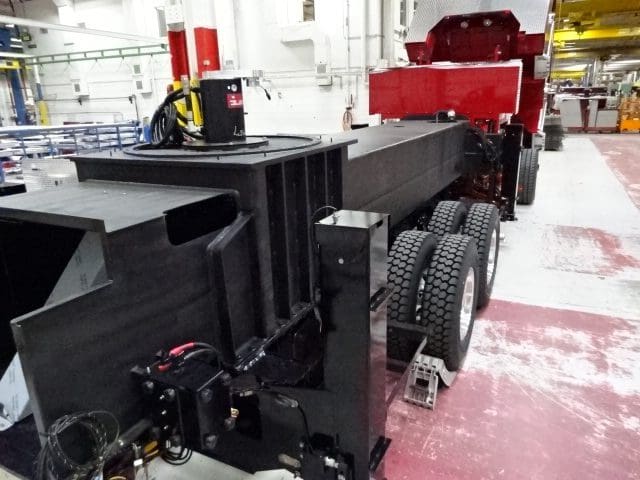

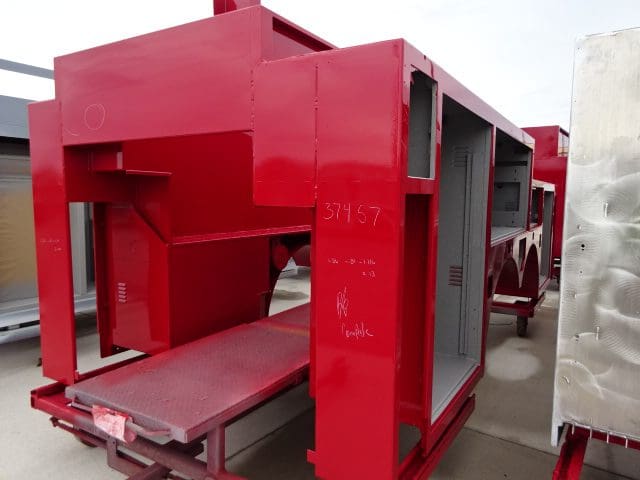

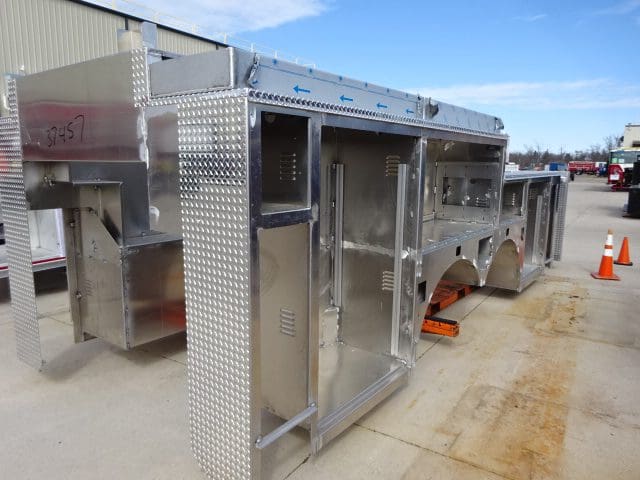

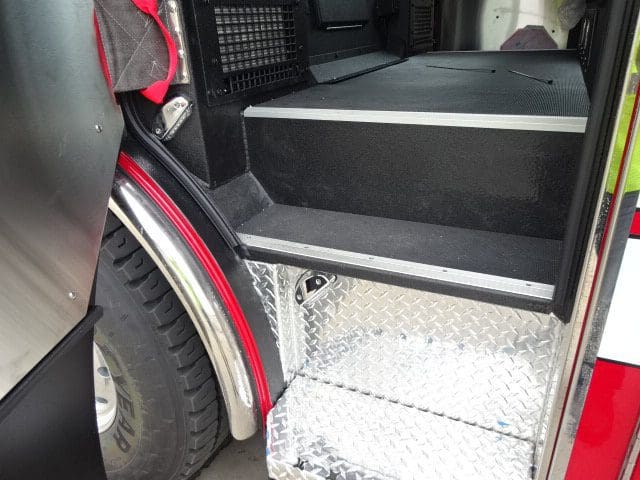

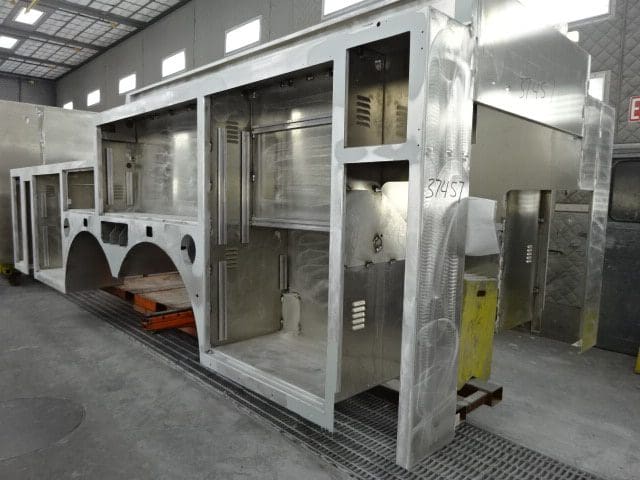

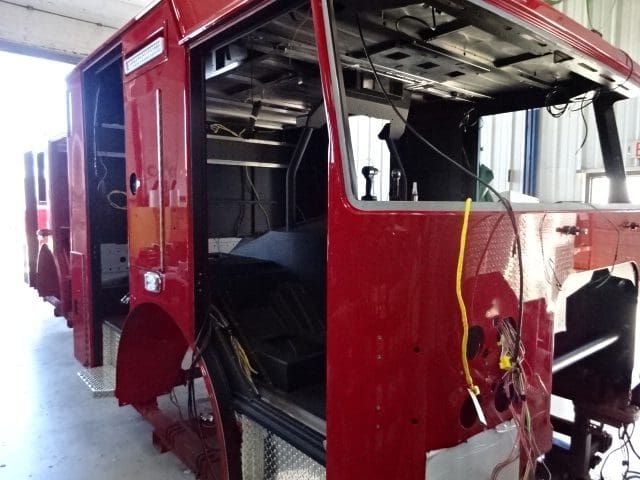

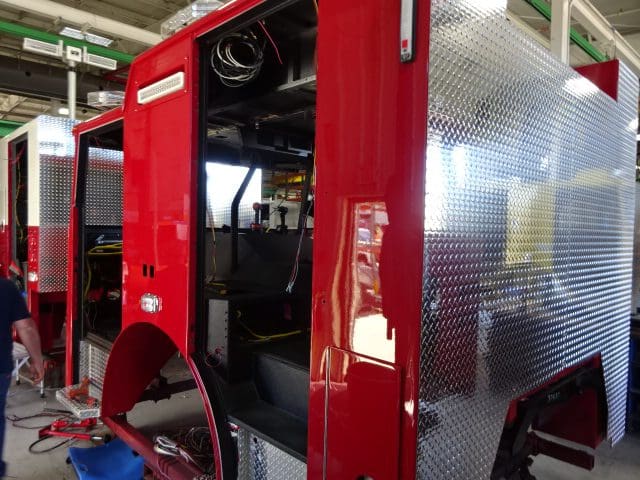

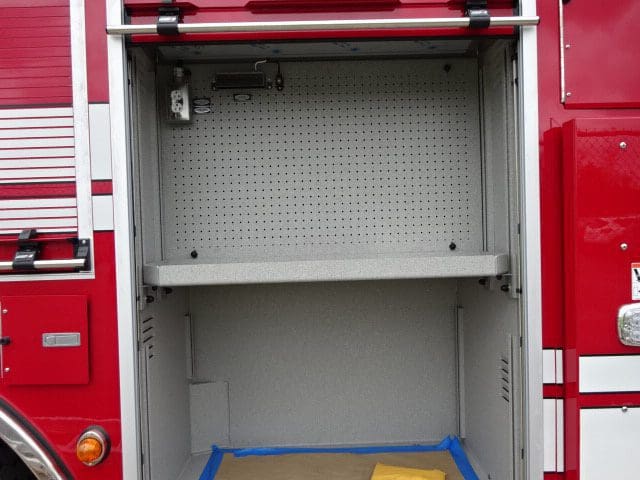

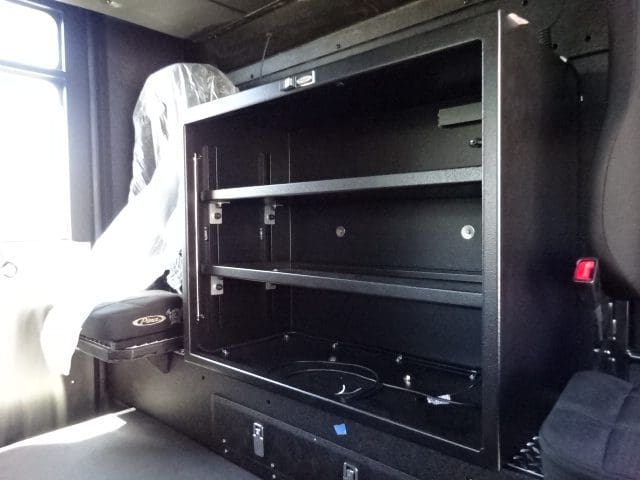

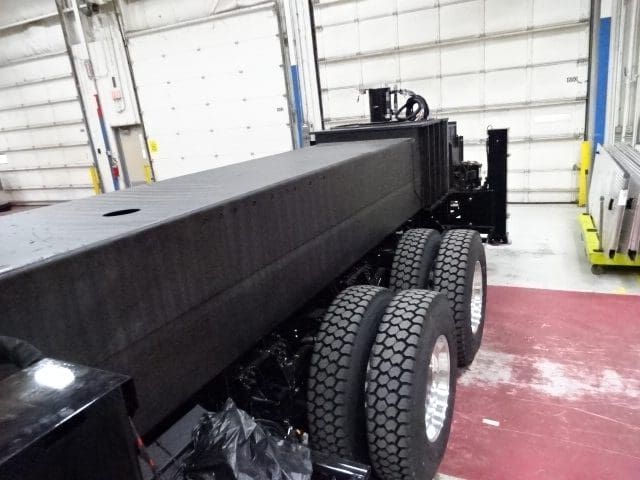

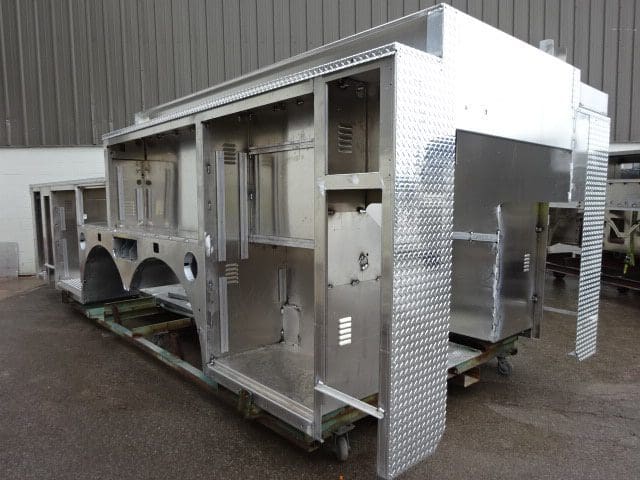

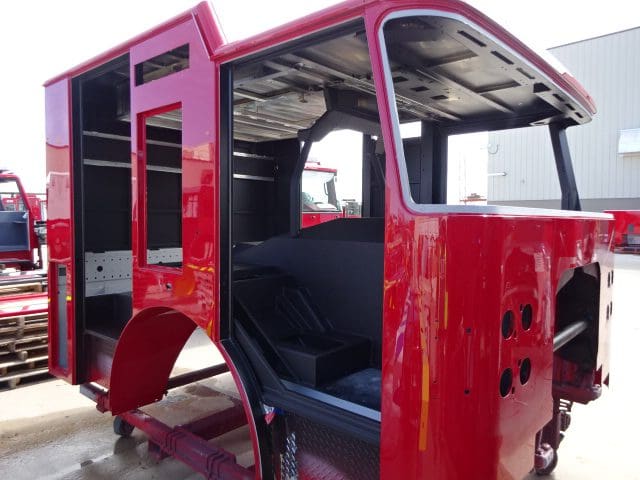

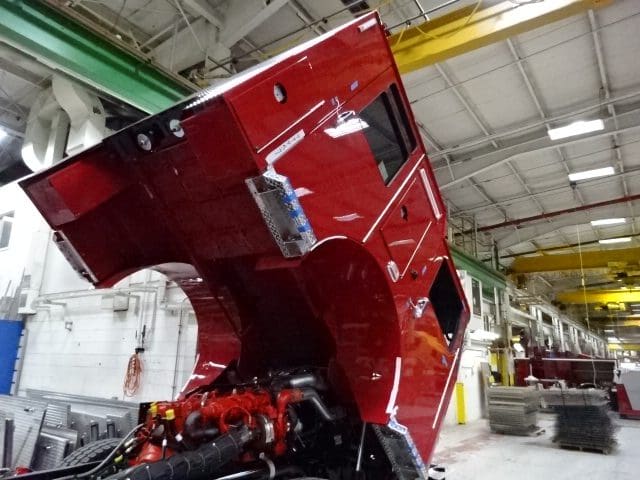

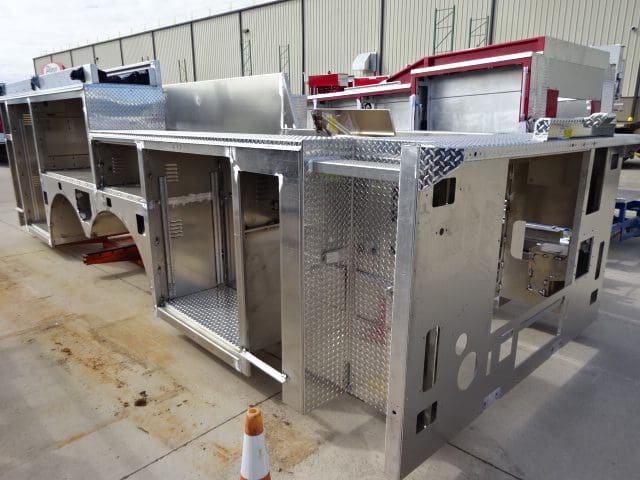

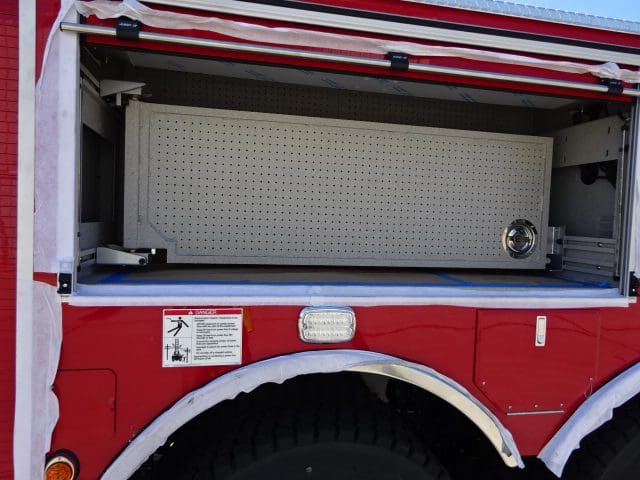

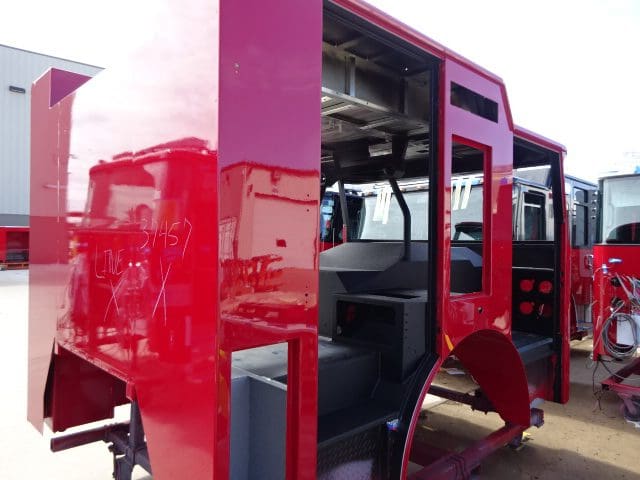

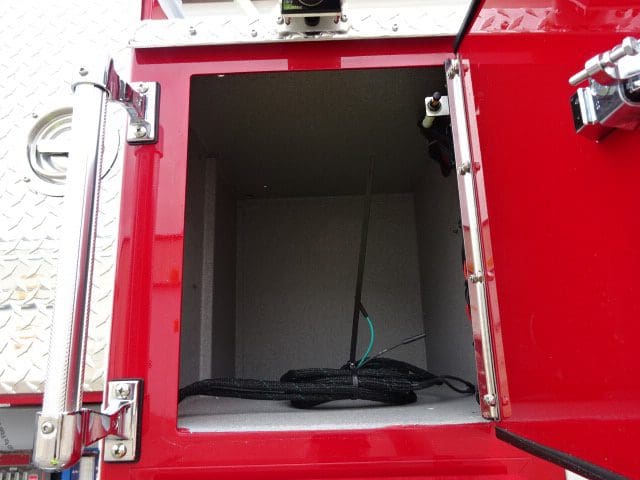

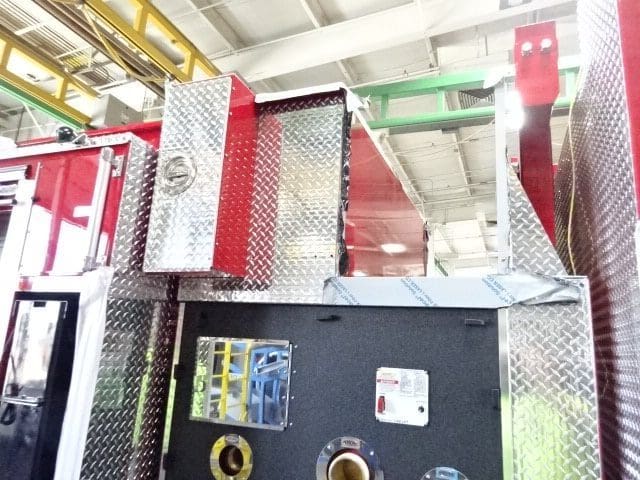

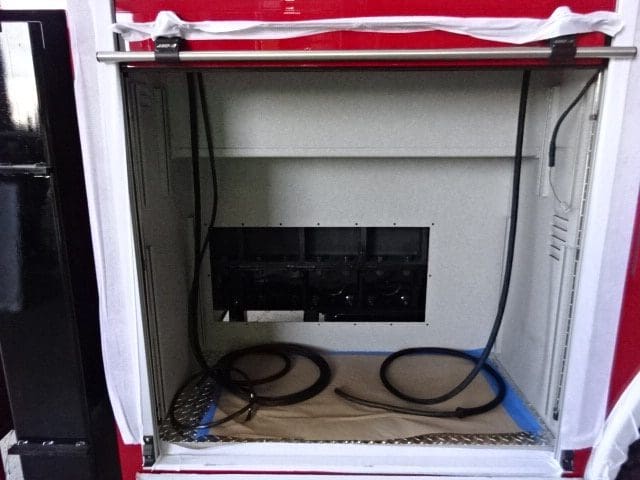

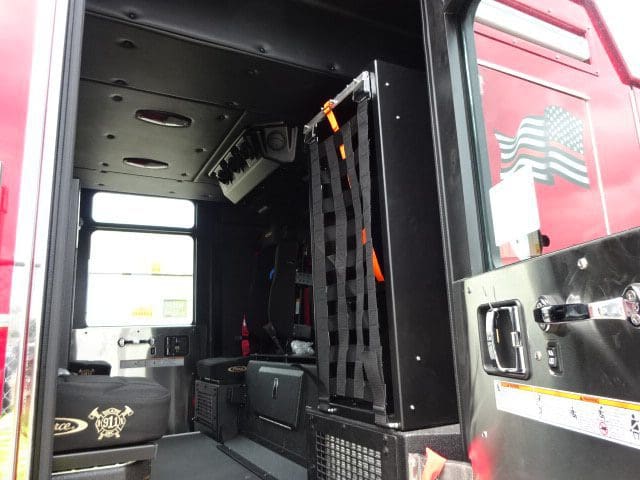

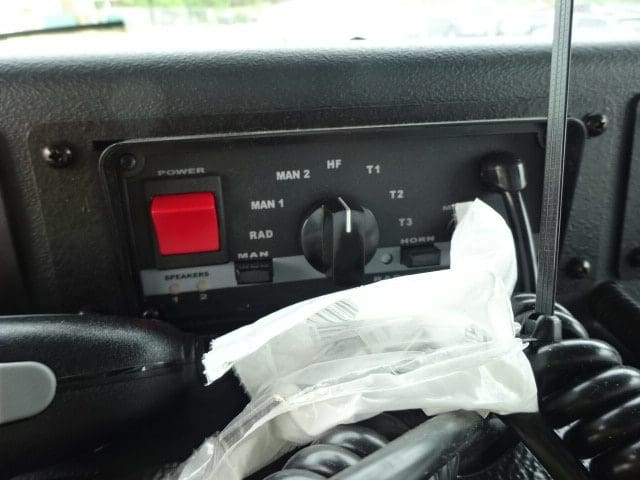

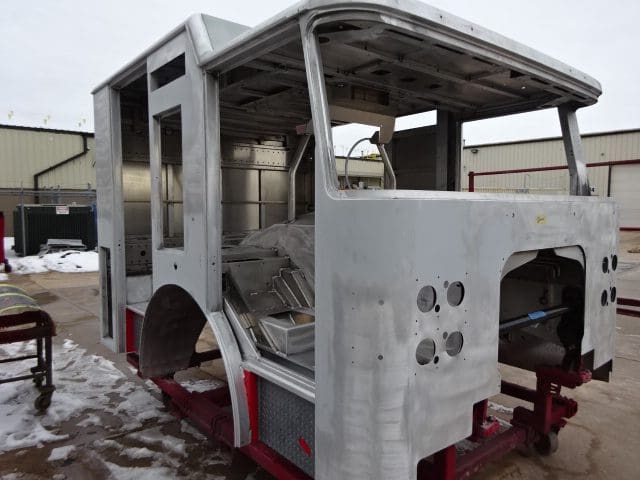

In this report the body completed initial assembly and was merged with the chassis, followed by the start of final assembly.

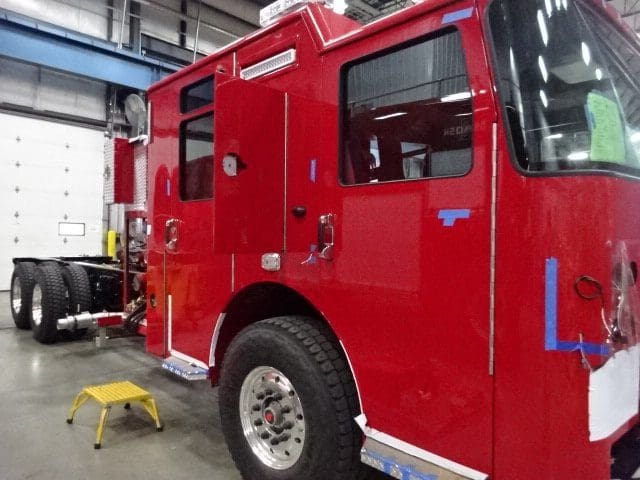

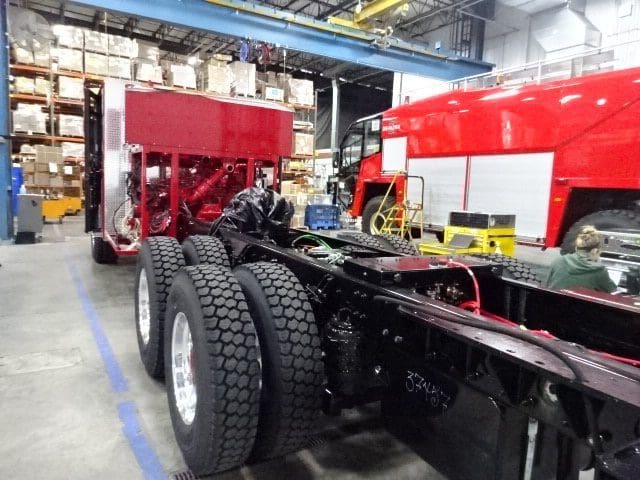

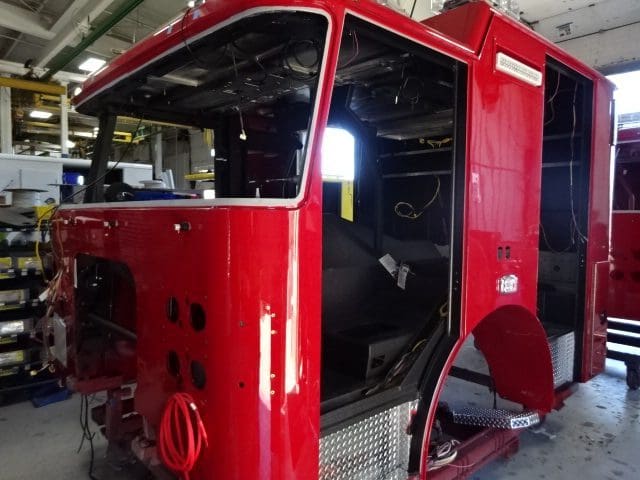

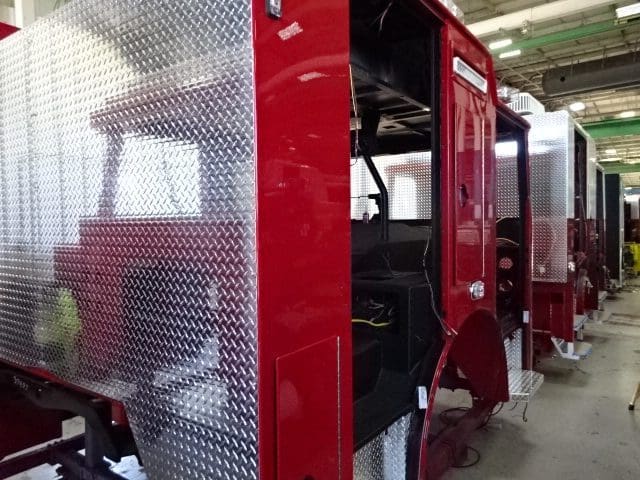

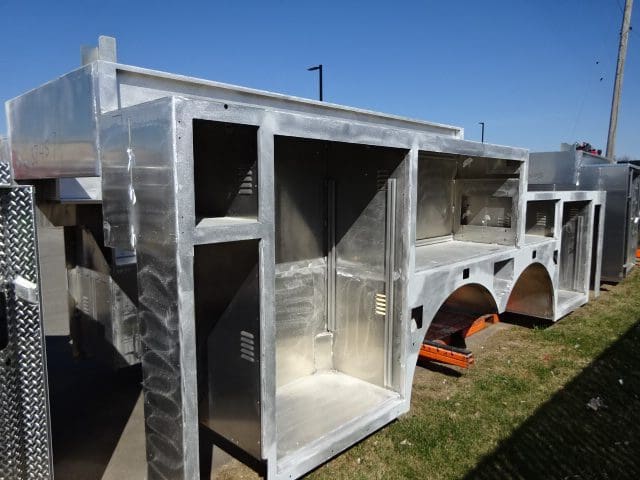

05-05-23

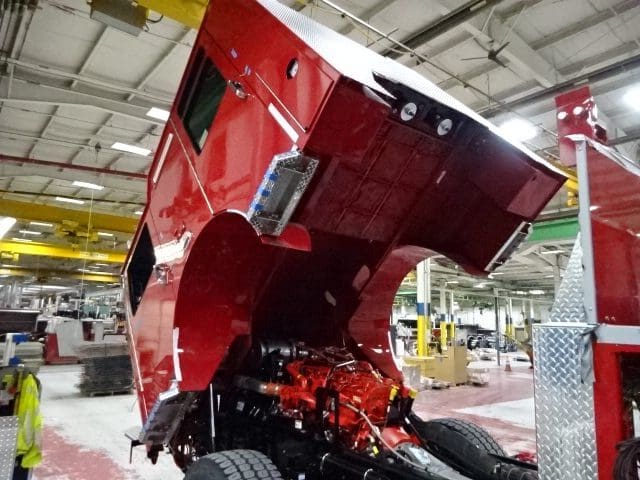

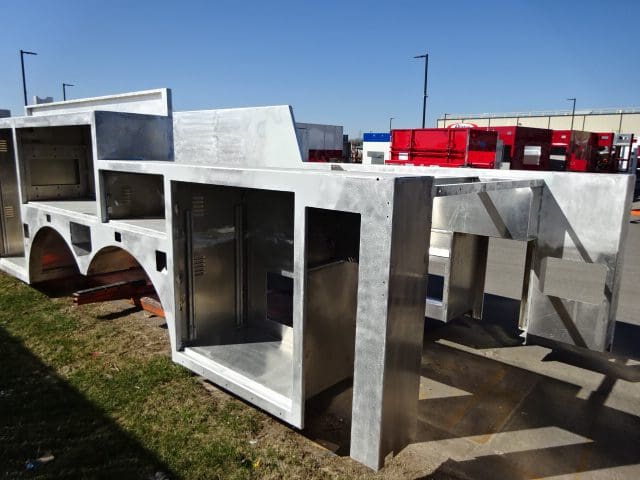

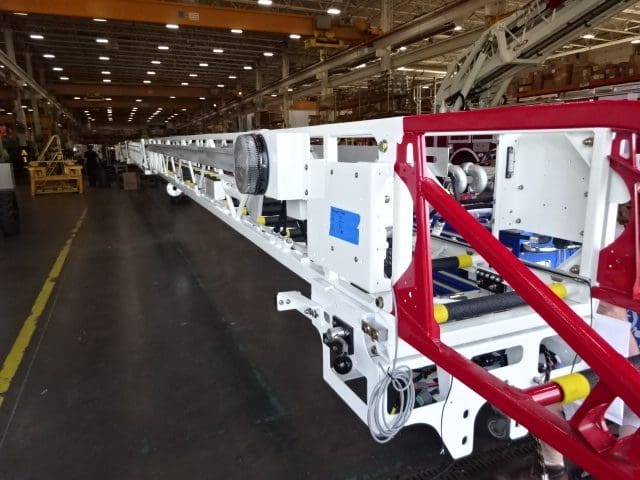

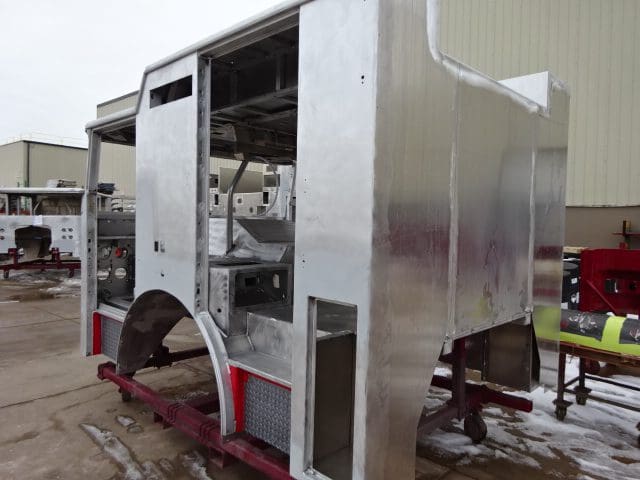

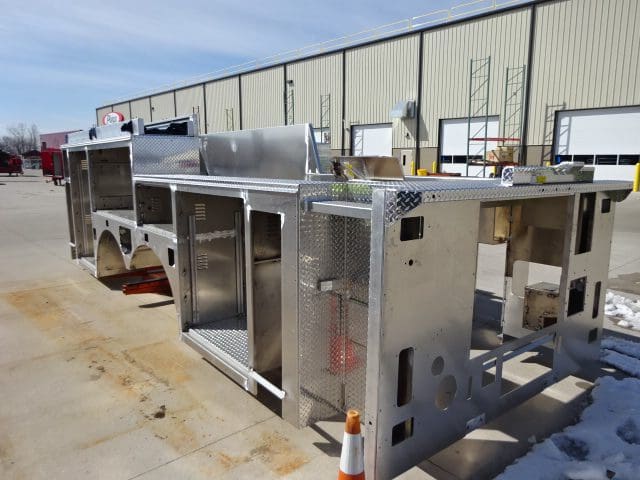

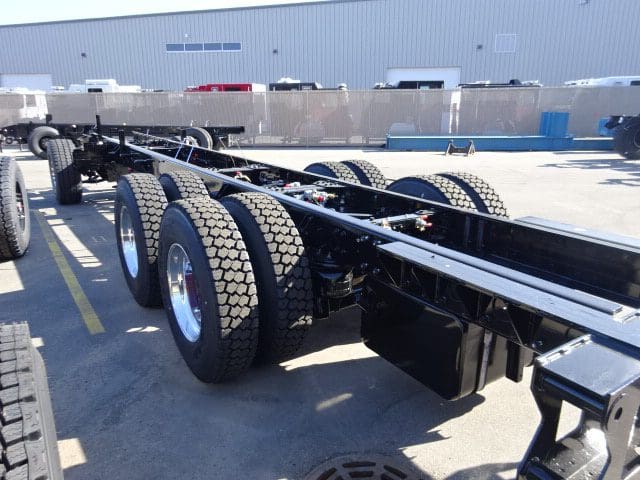

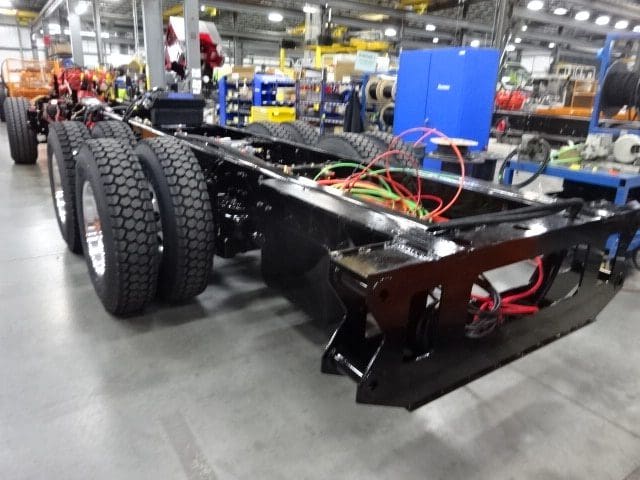

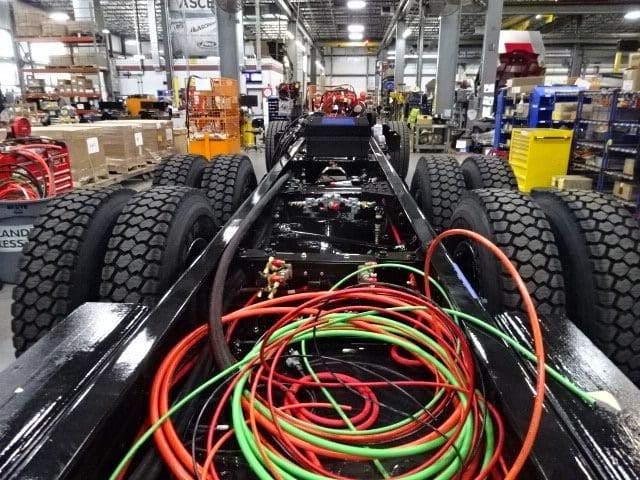

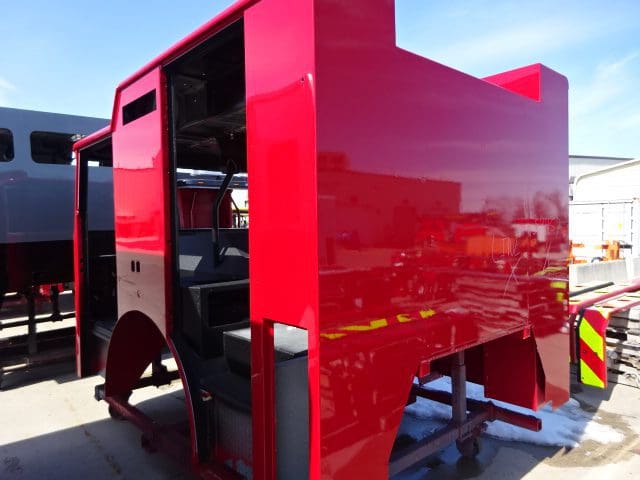

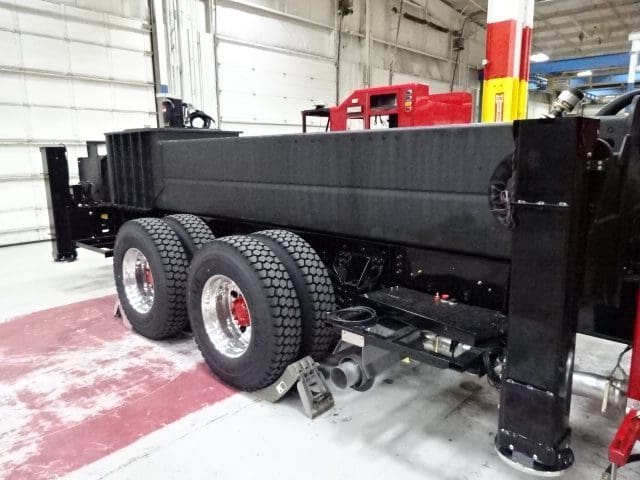

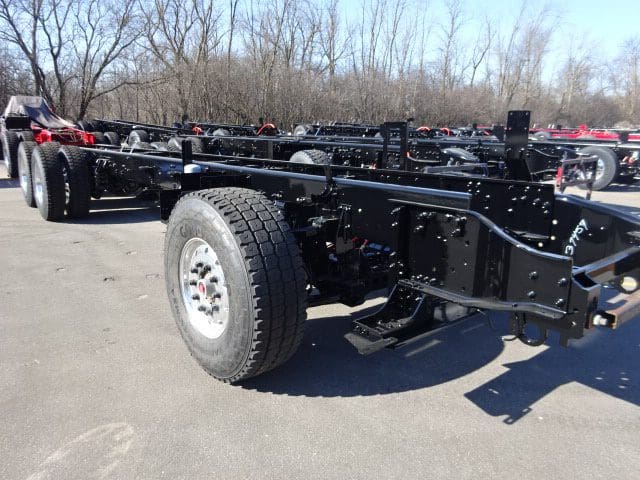

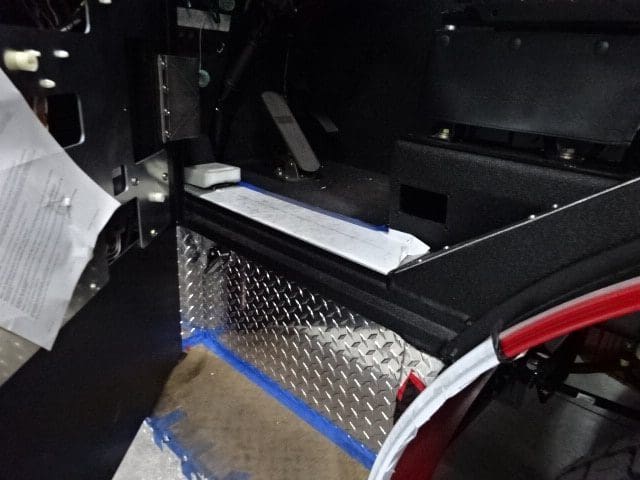

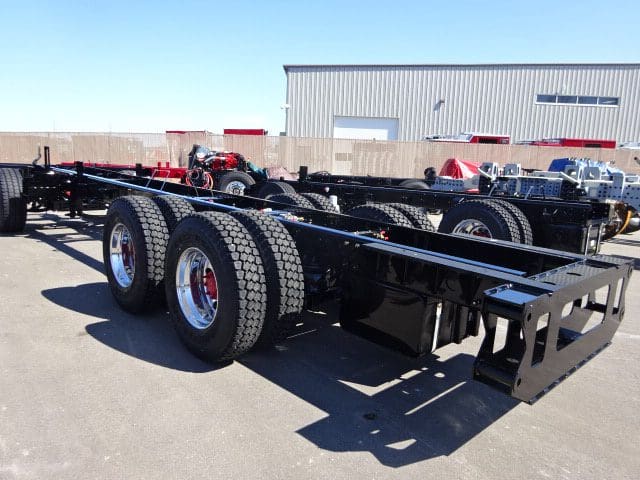

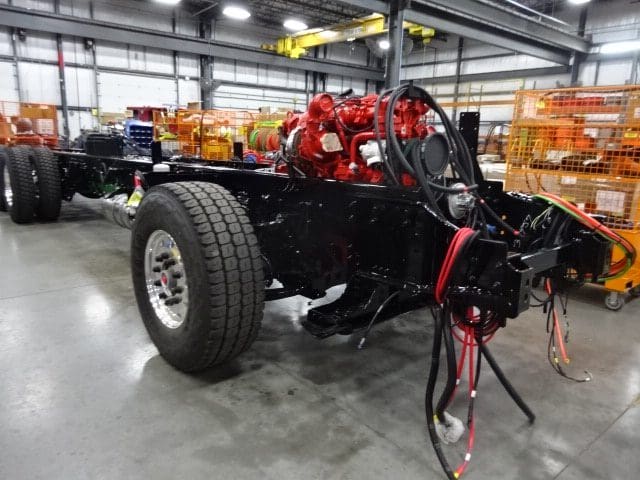

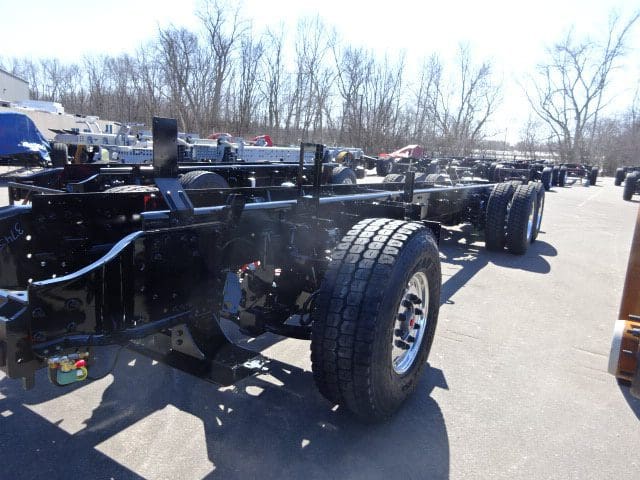

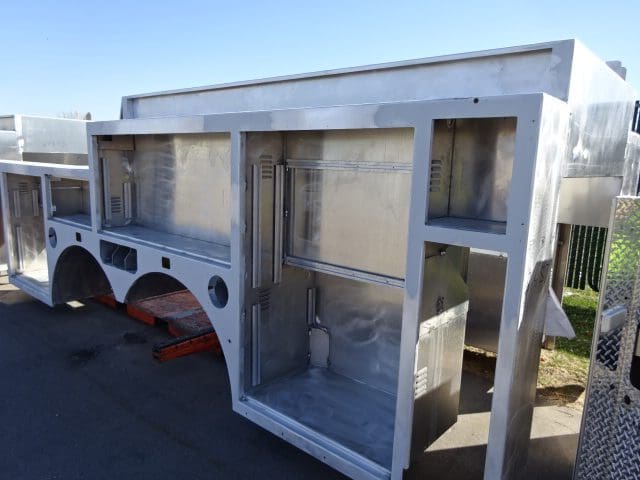

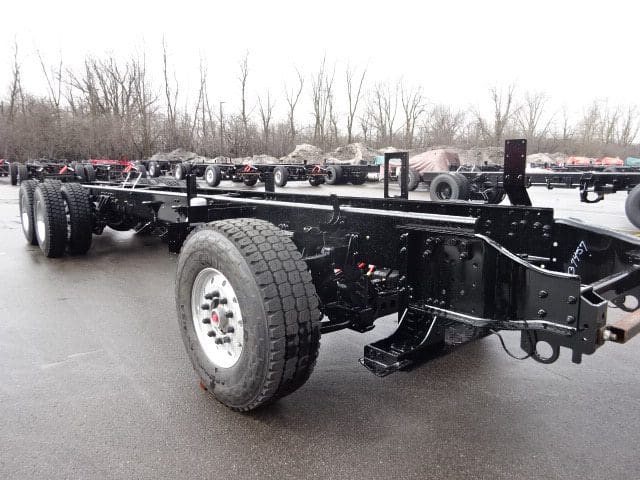

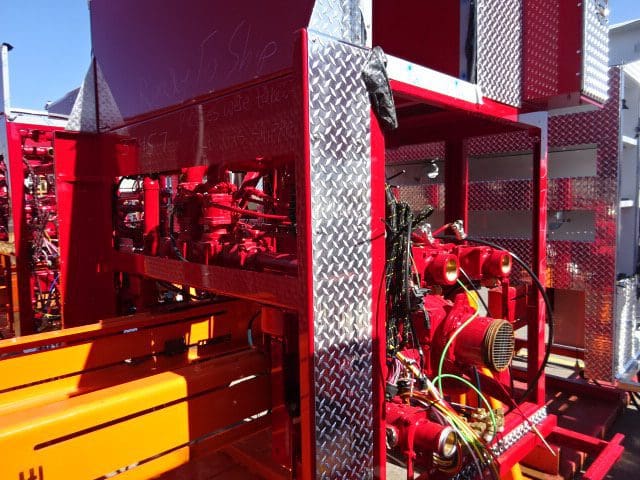

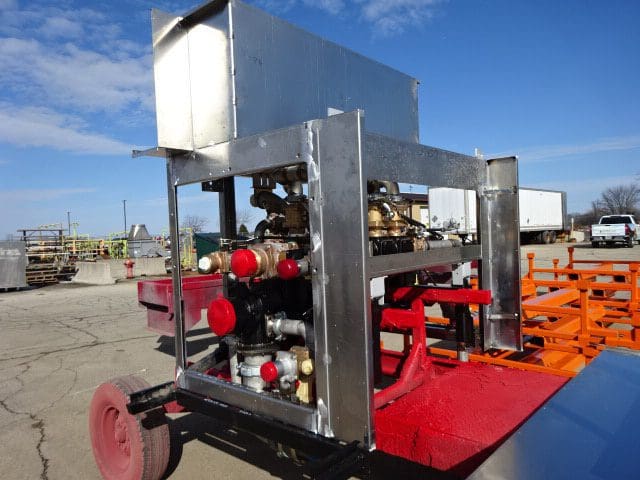

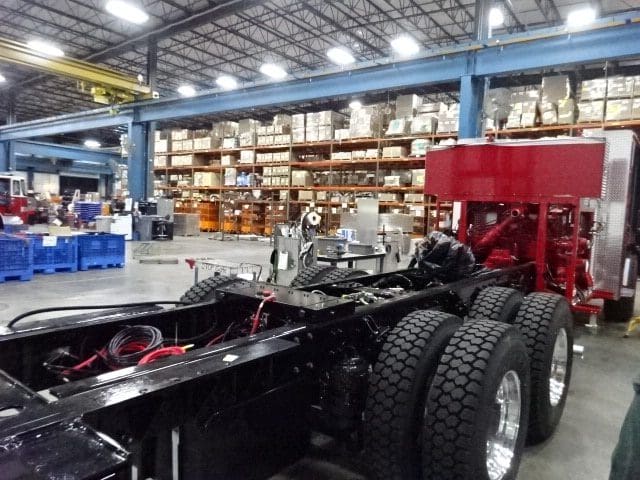

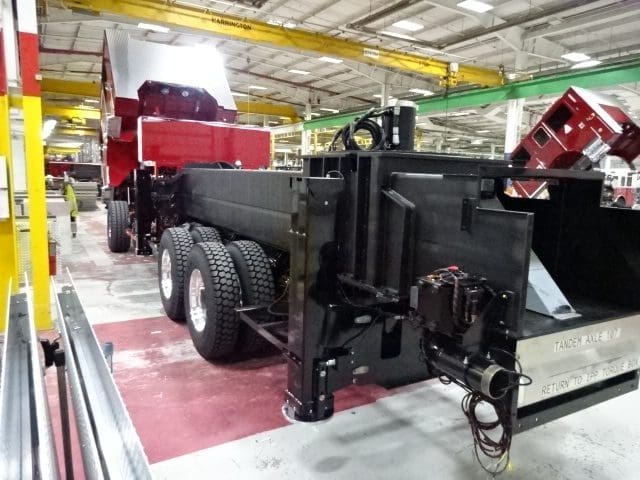

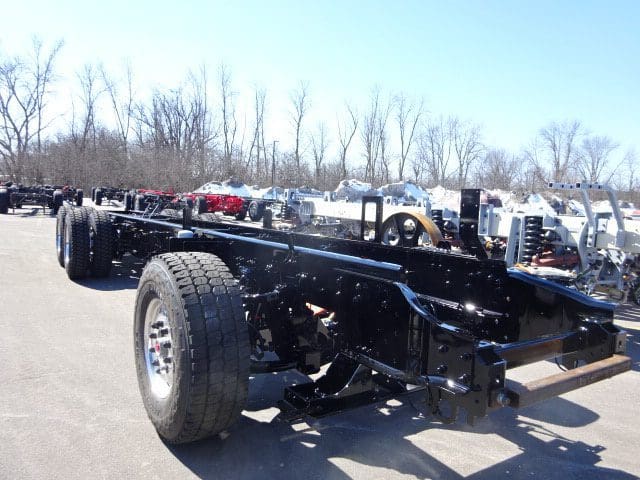

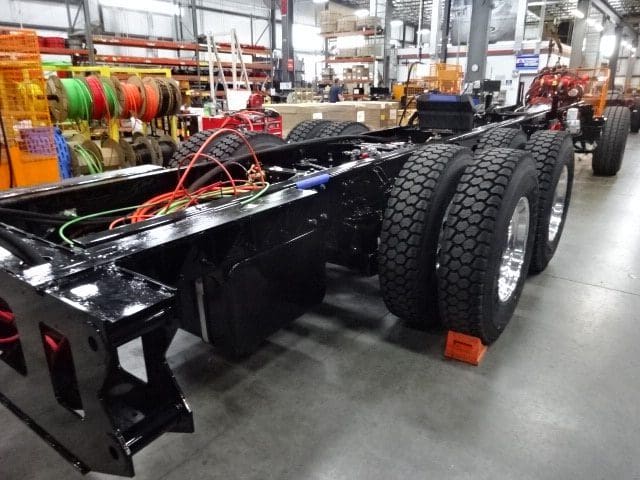

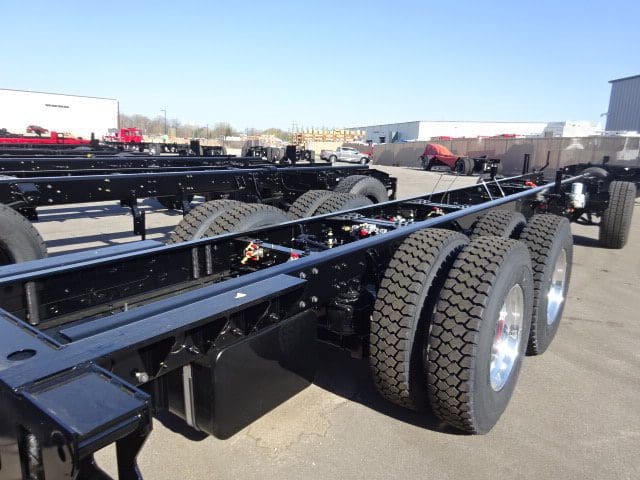

The chassis continued assembly while the body began initial assembly.

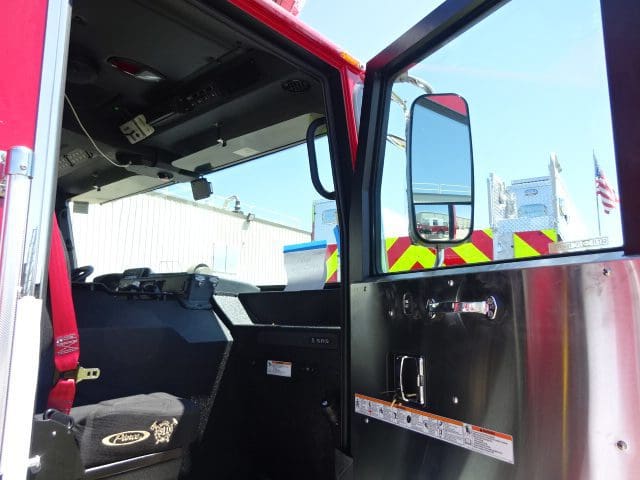

04-29-23

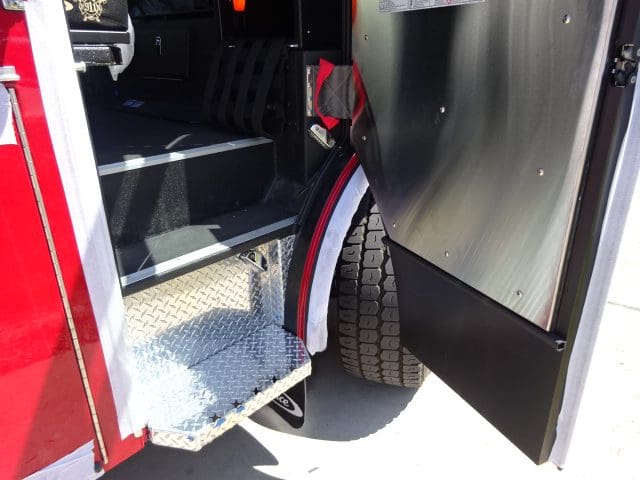

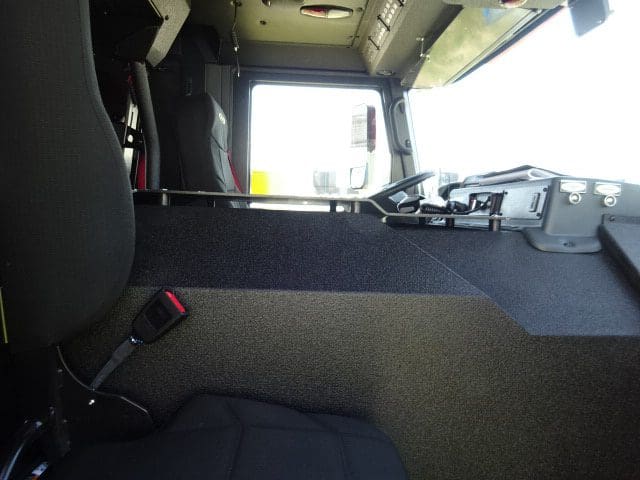

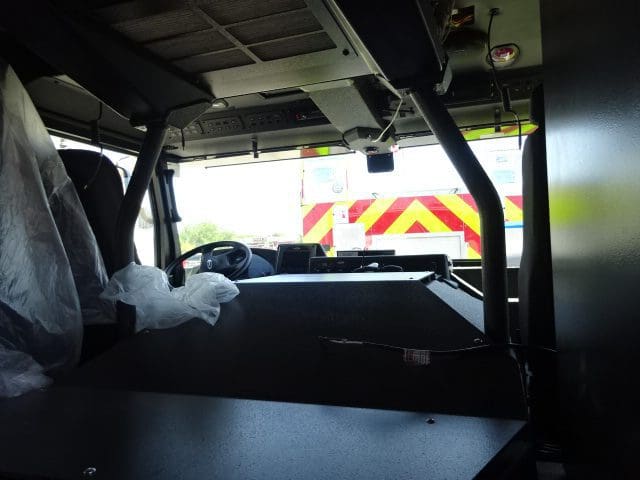

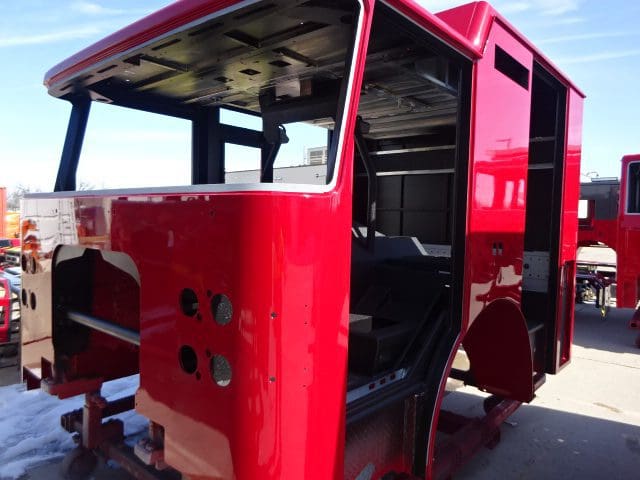

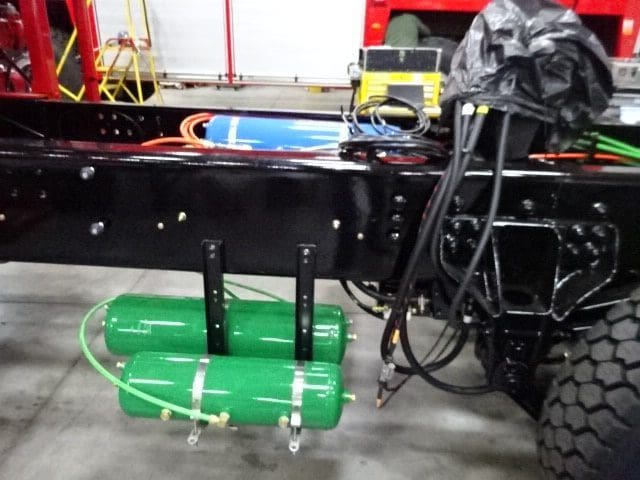

The cab and pump house were installed on the frame while assembly continued, and the body was unavailable for photos

04-21-23

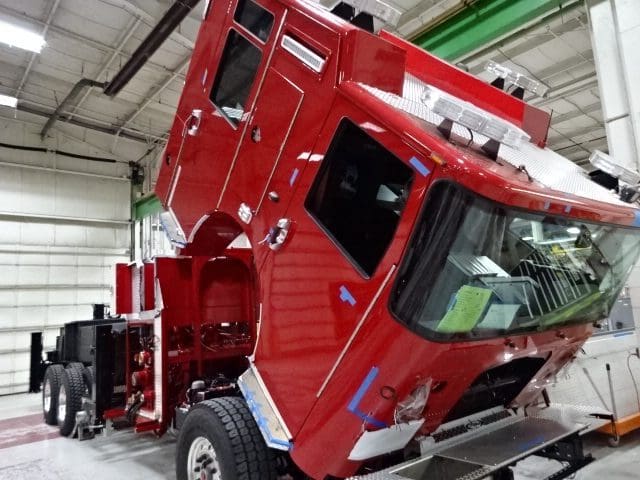

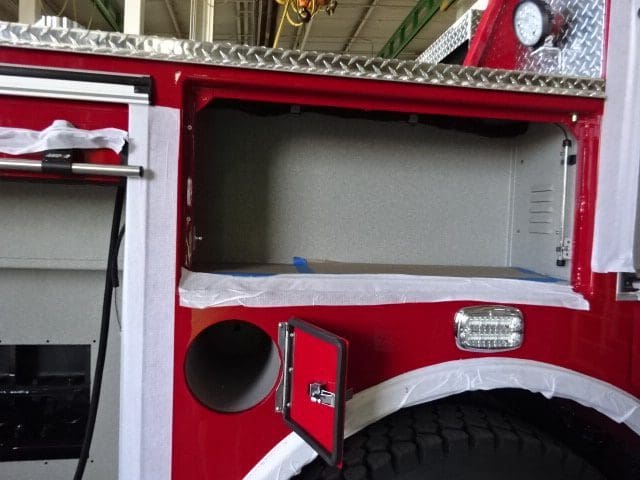

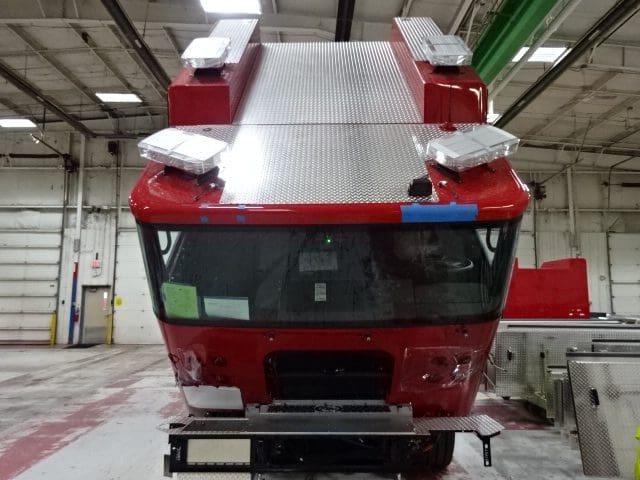

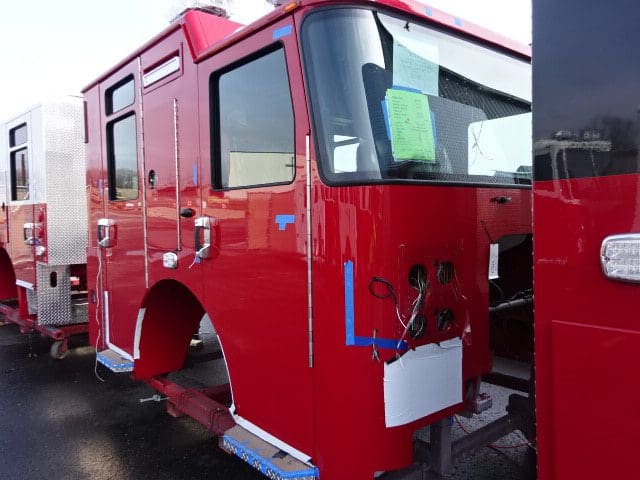

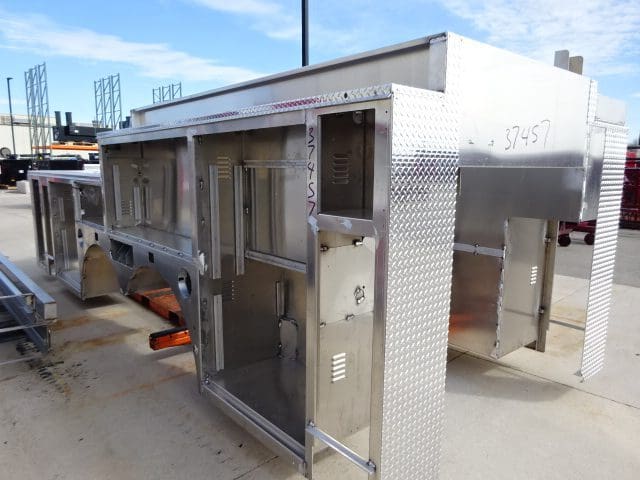

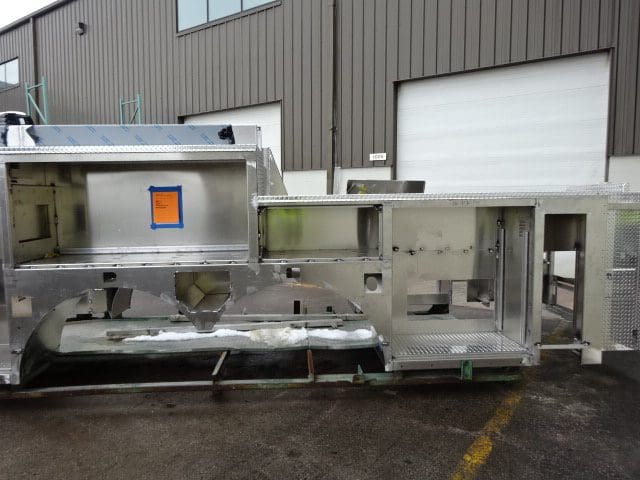

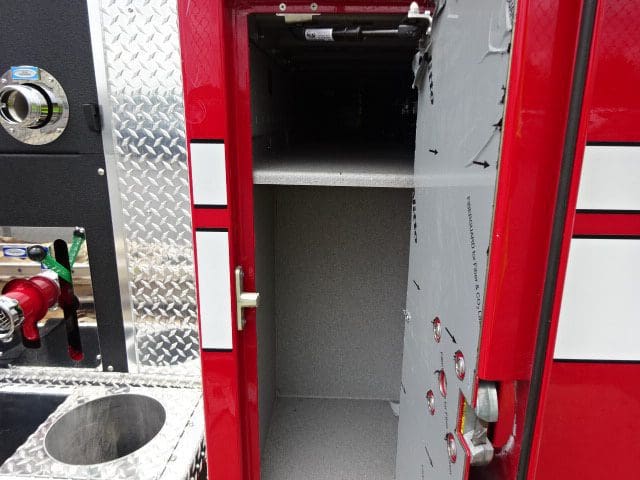

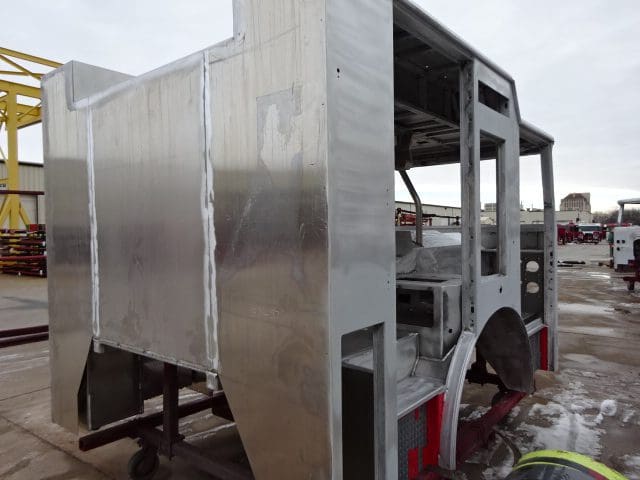

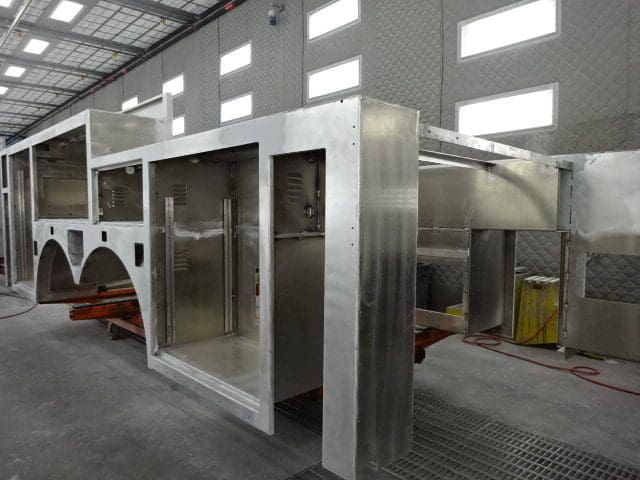

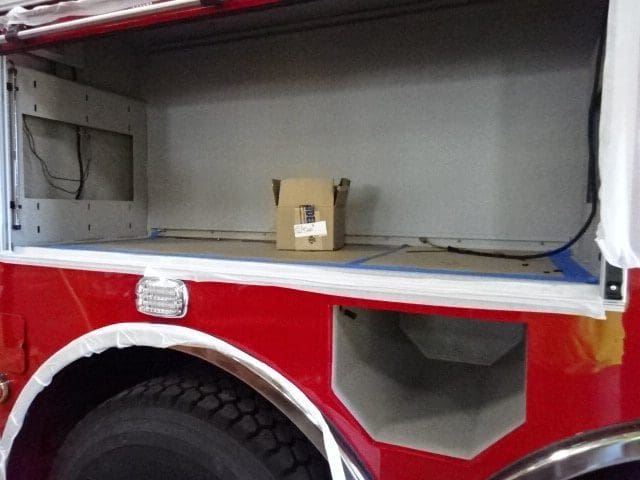

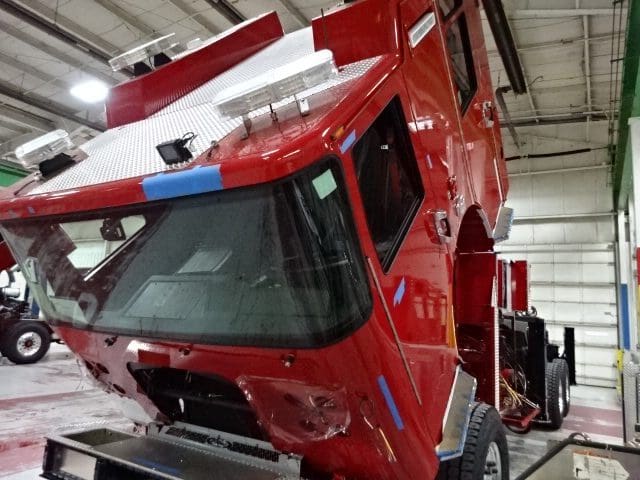

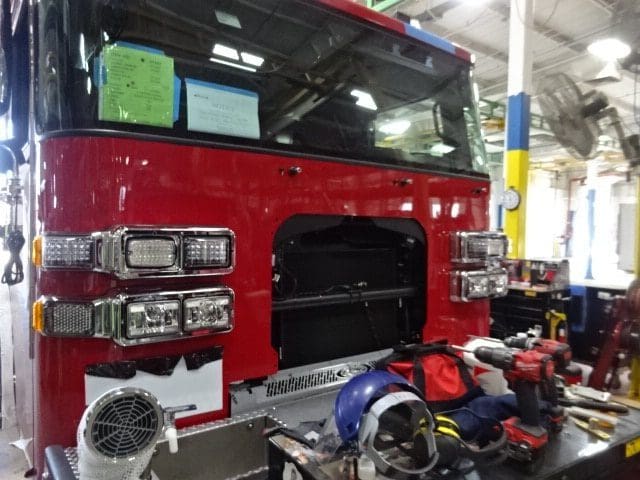

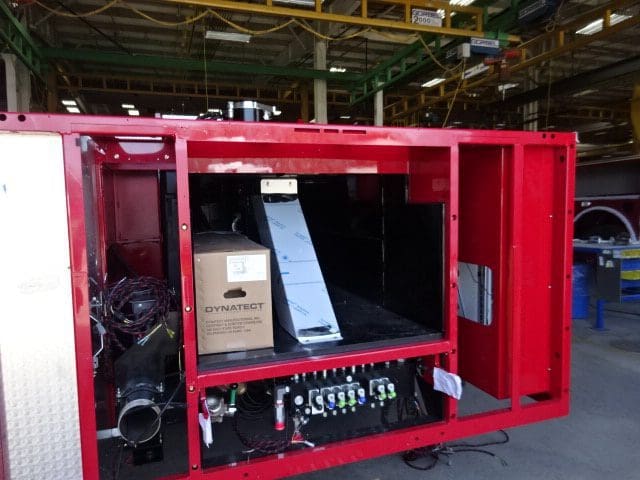

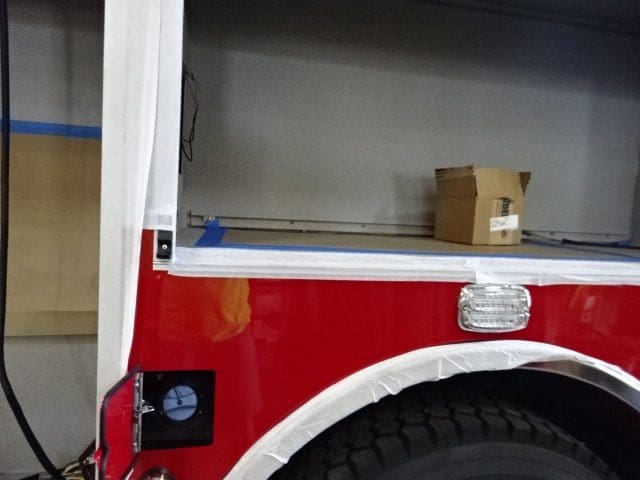

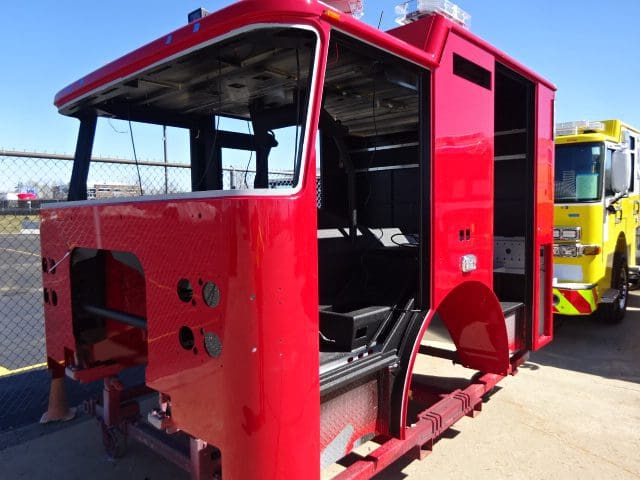

The cab completed initial assembly and was staged, the frame build continued, the pump house remained staged, and the body made progress through paint and was staged.

04-14-23

The cab continued initial assembly, the frame build continued, the pump house remained staged, and the body continued the paint process.

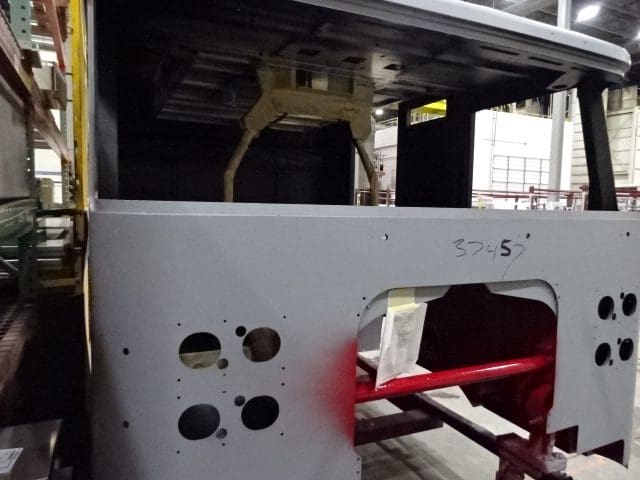

04-07-23

The cab started initial assembly, the frame build continued, the pump house completed initial assembly and is staged, and the body started the paint process.

03-31-23

The cab was staged, the frame build began, the pump house was painted, and the body remained staged.

03-24-23

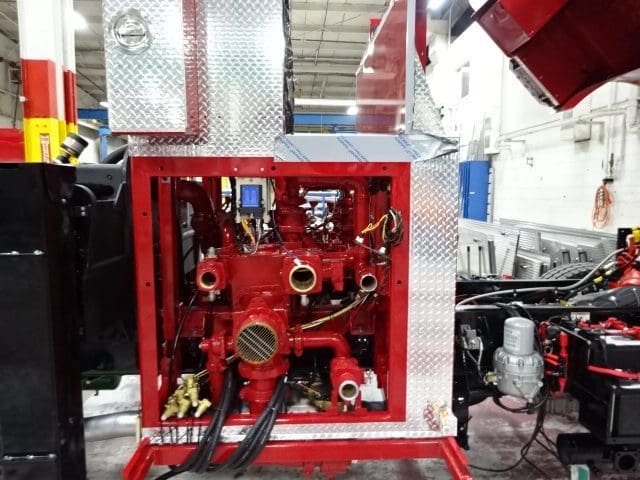

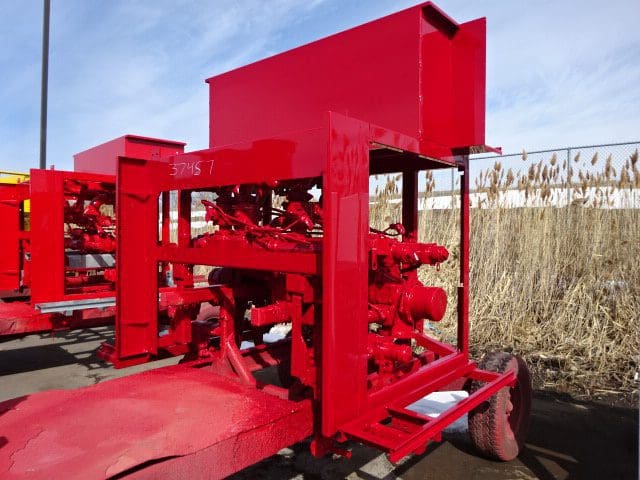

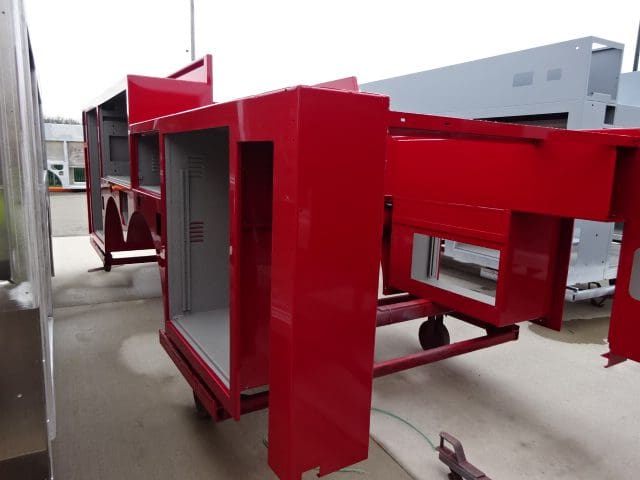

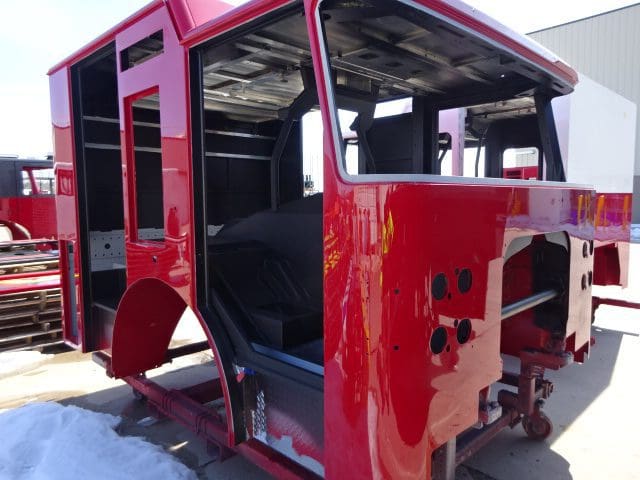

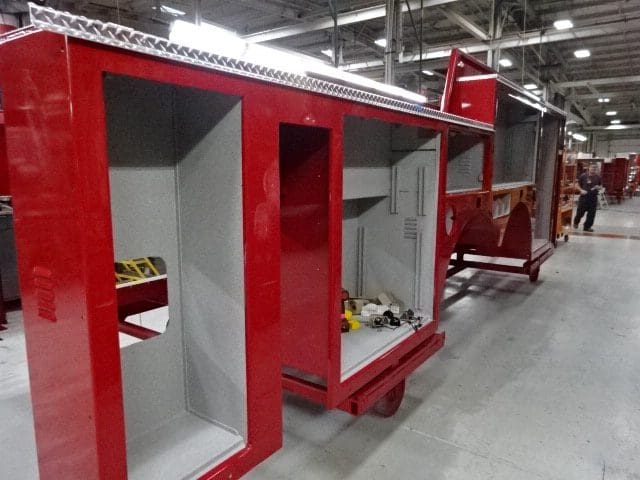

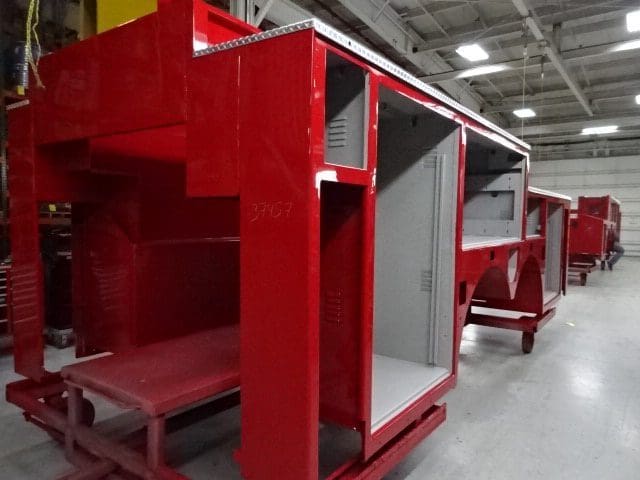

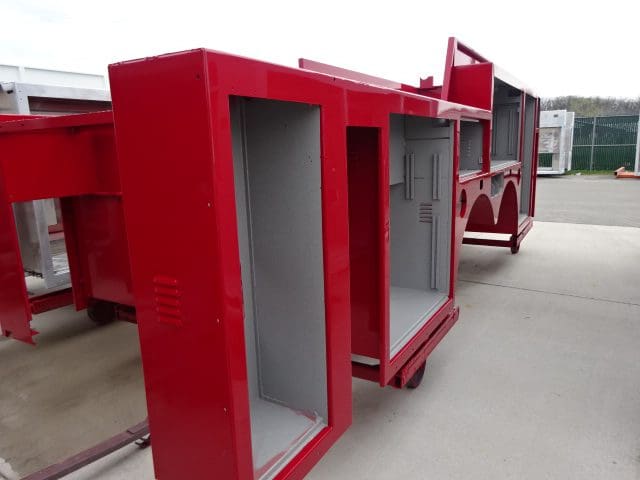

The cab completed paint and was staged, the pump house began initial assembly, and the body released to paint.

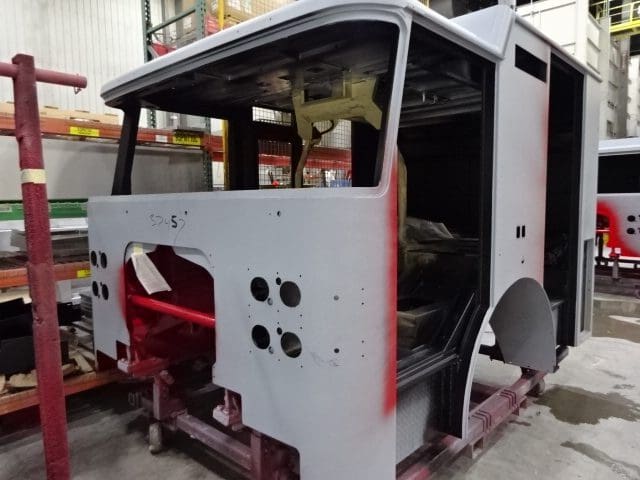

03-17-23

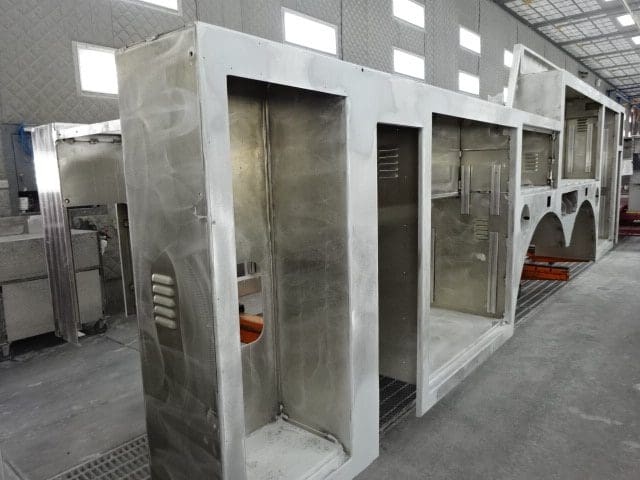

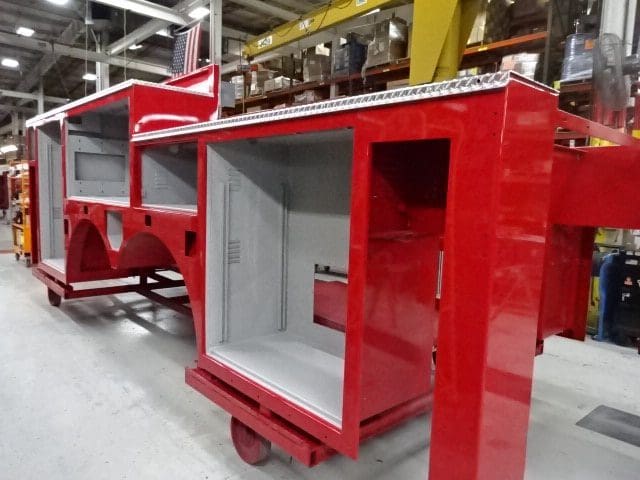

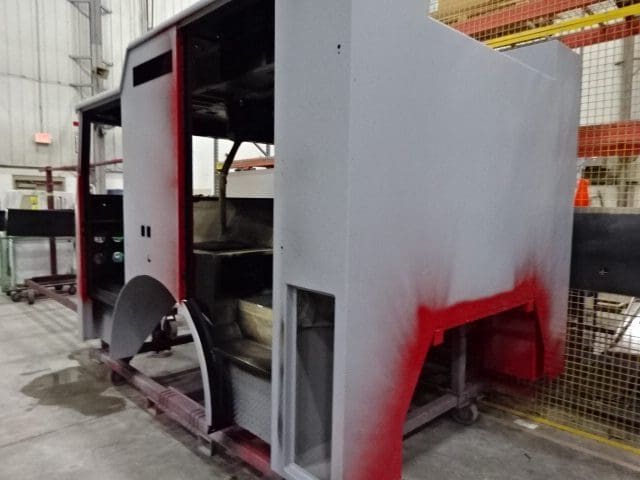

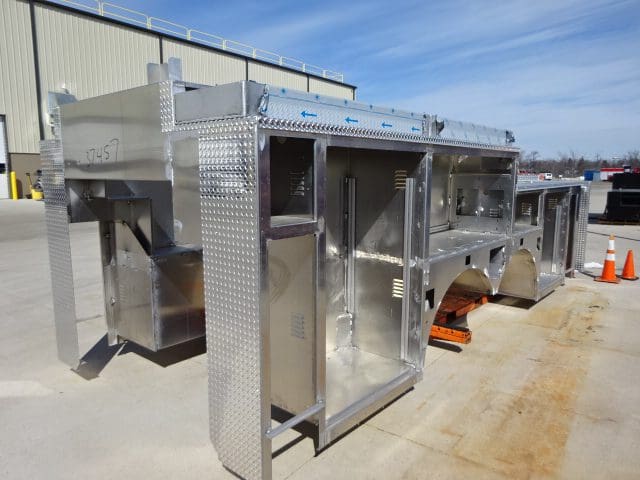

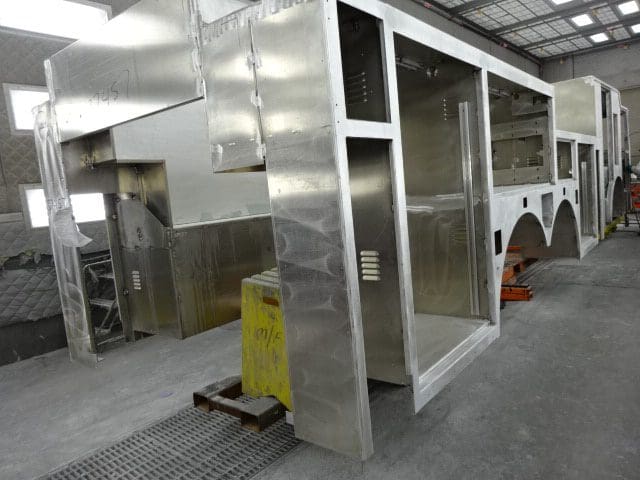

The cab continued through paint while the body was fabricated and staged.

03-10-23

The cab began the paint process.
