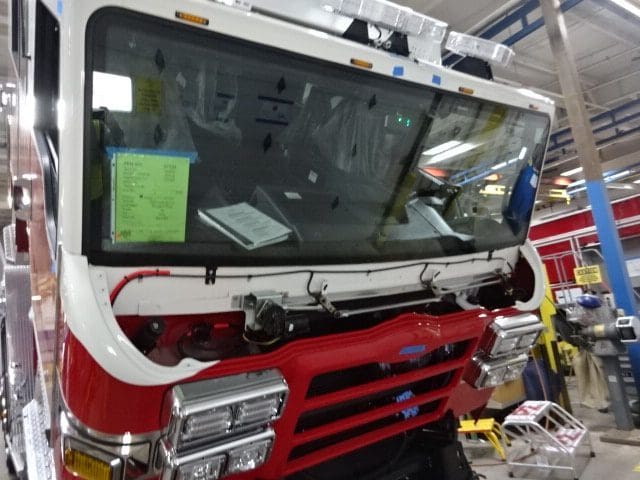

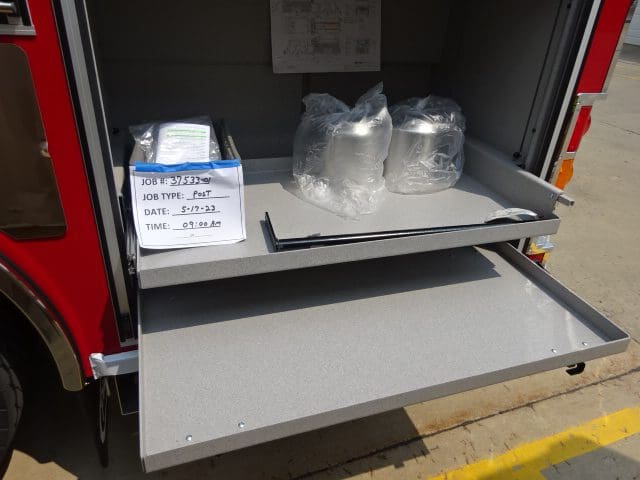

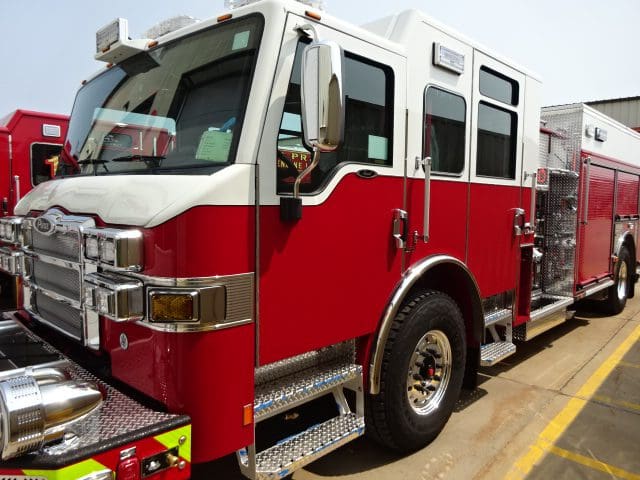

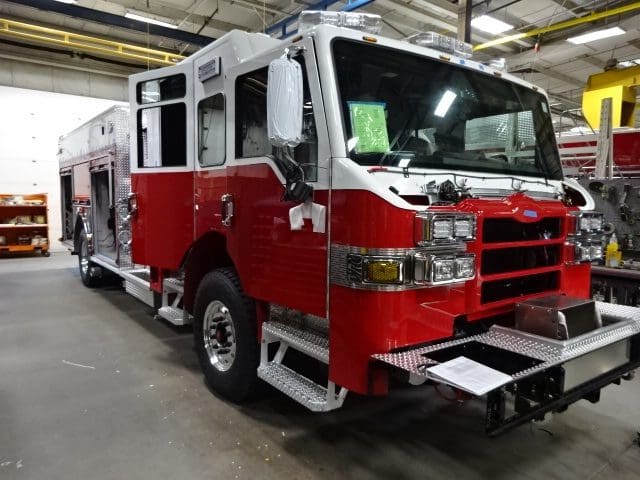

05-19-23

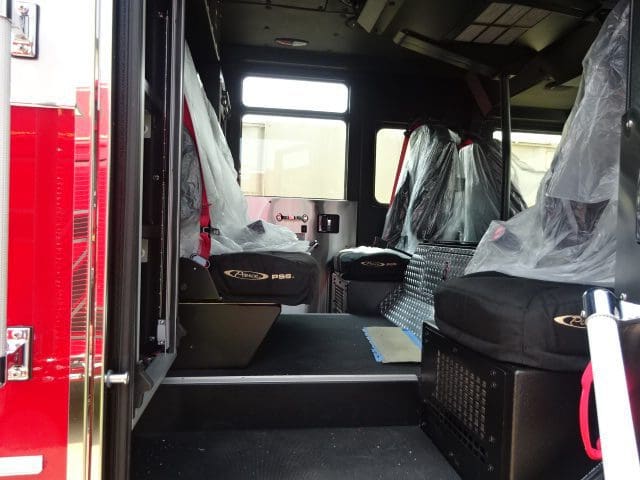

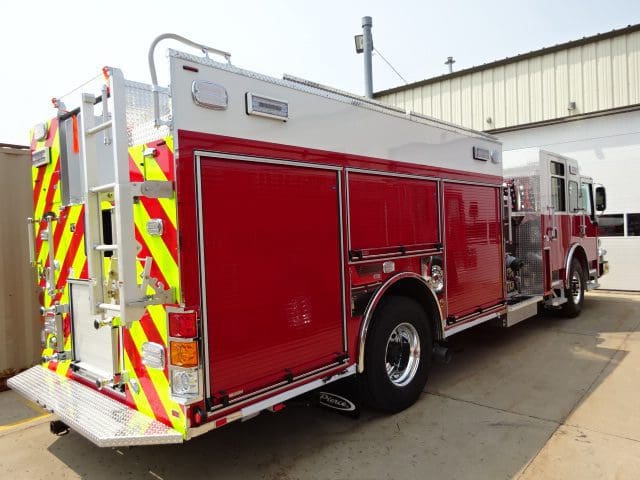

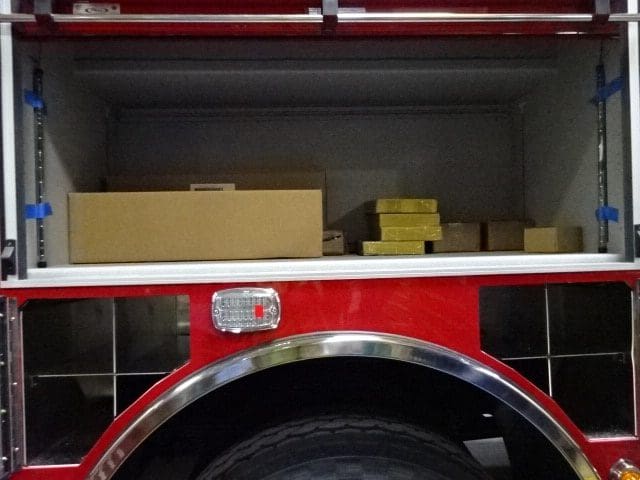

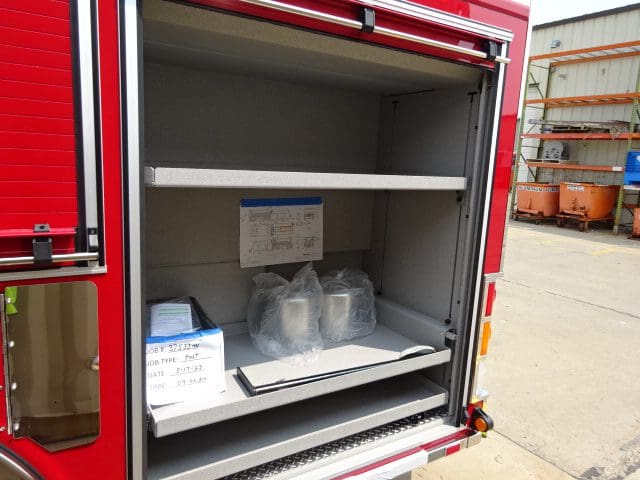

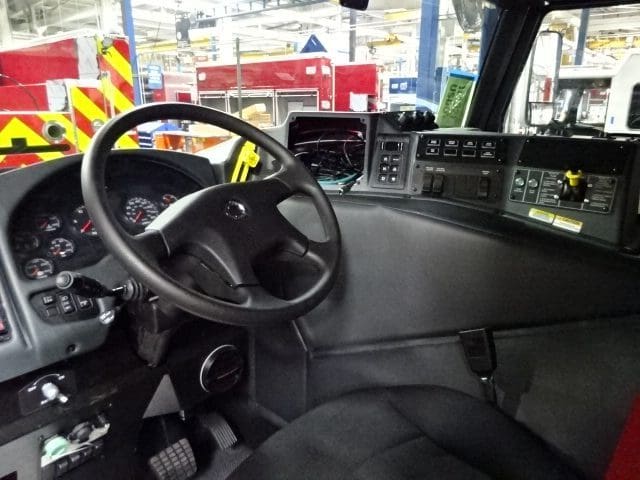

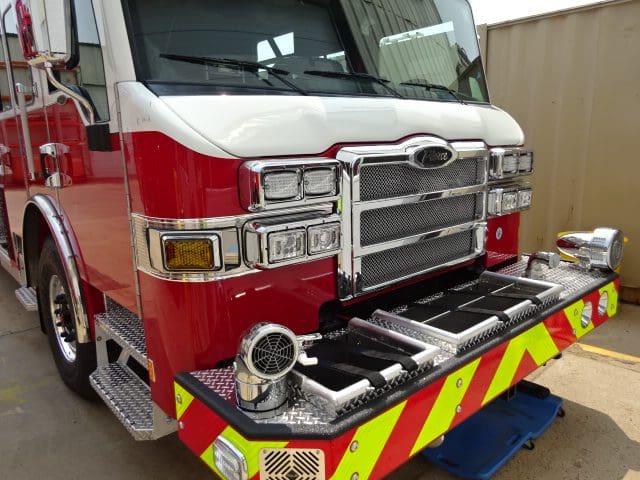

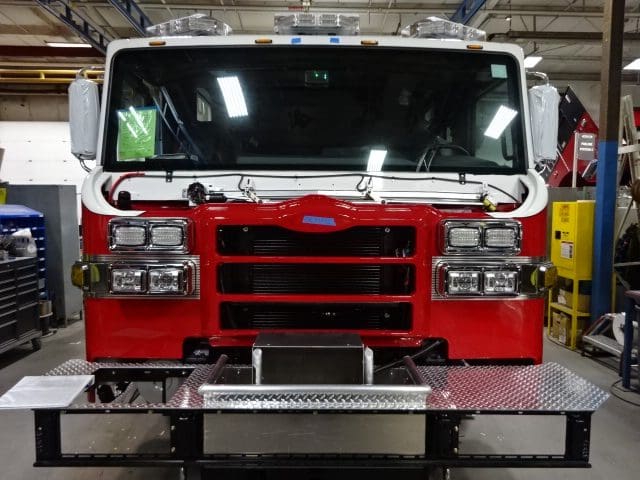

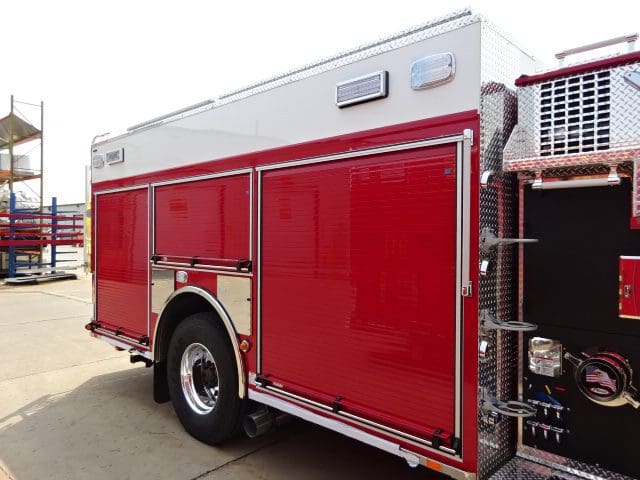

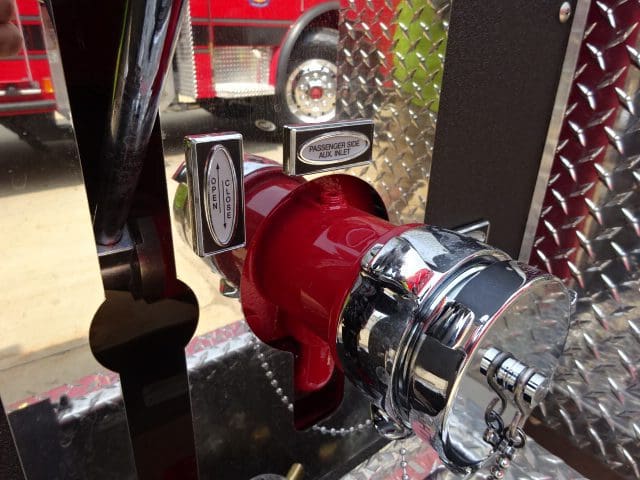

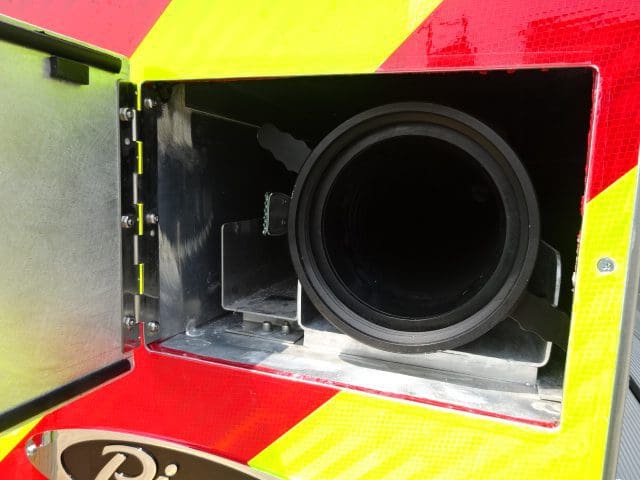

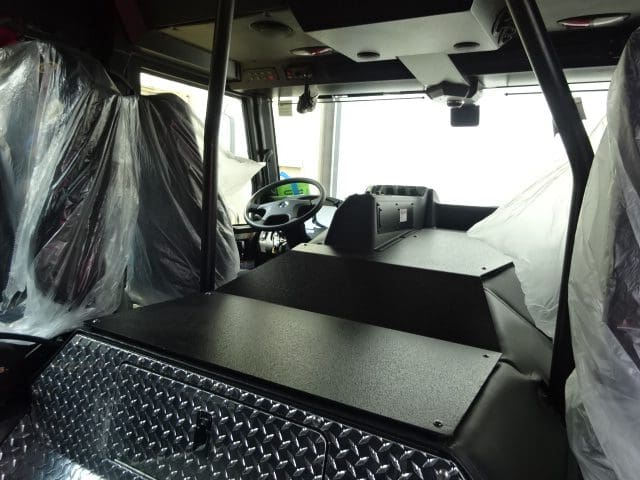

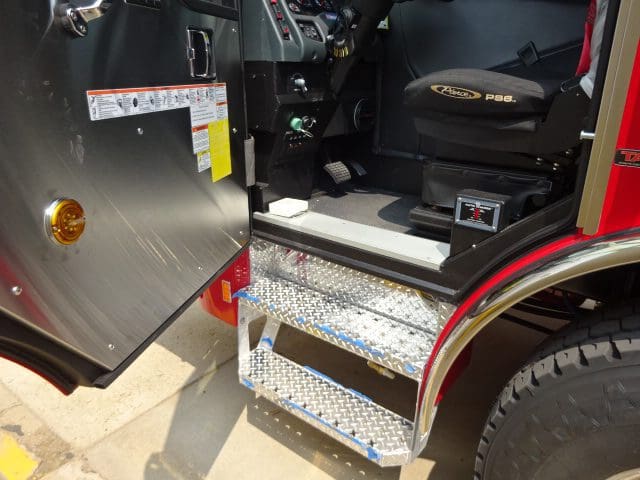

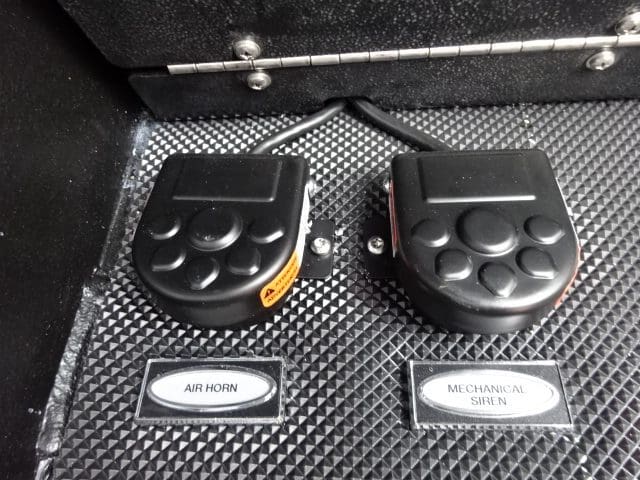

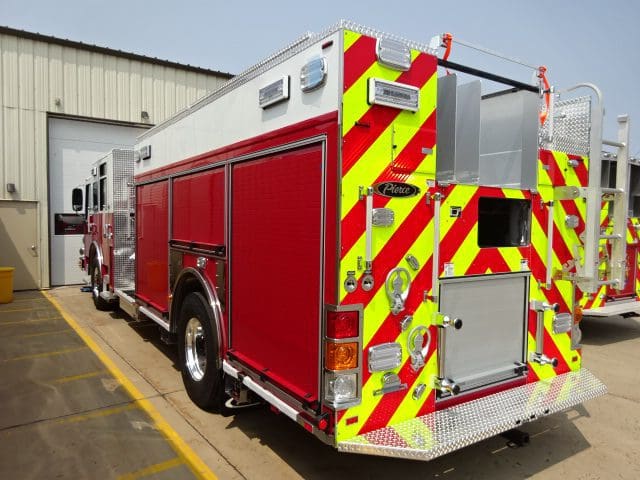

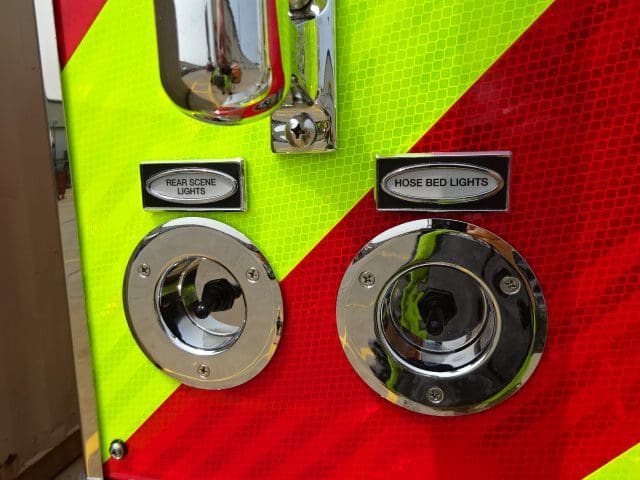

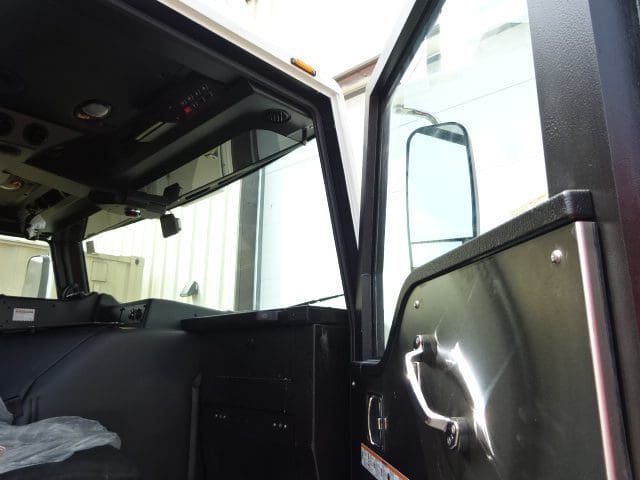

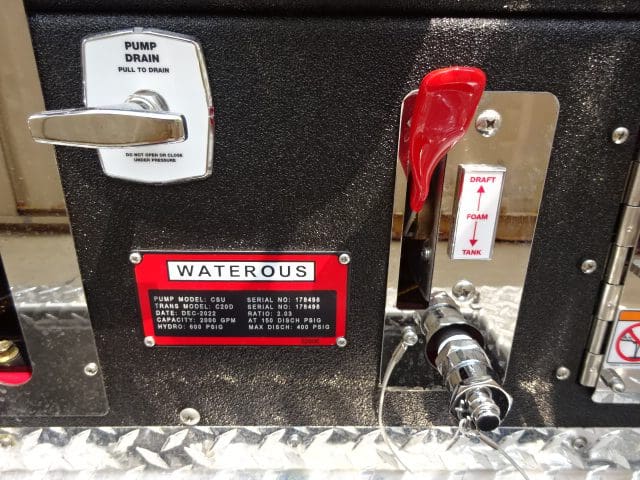

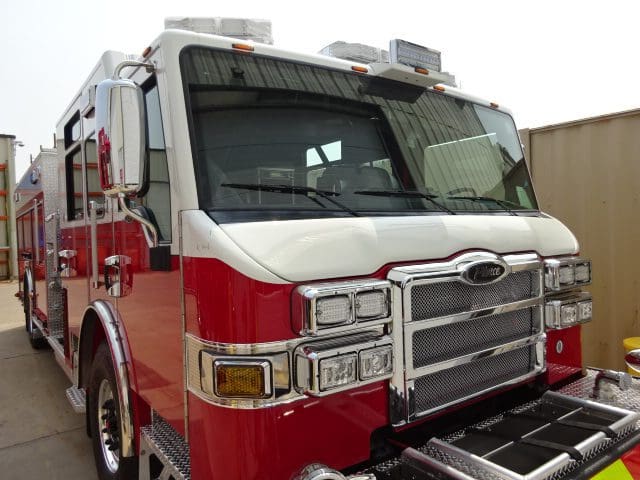

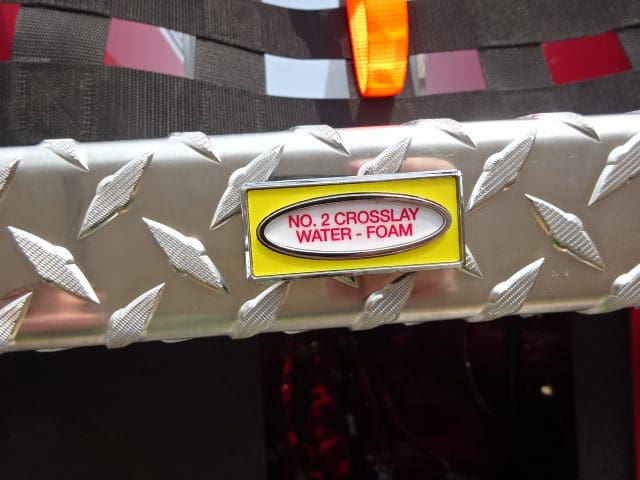

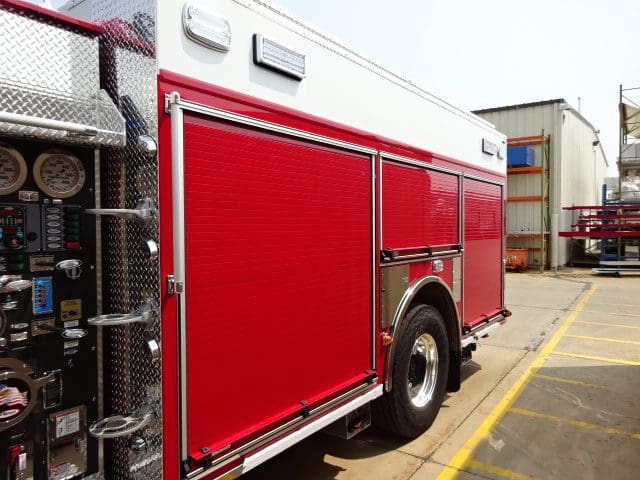

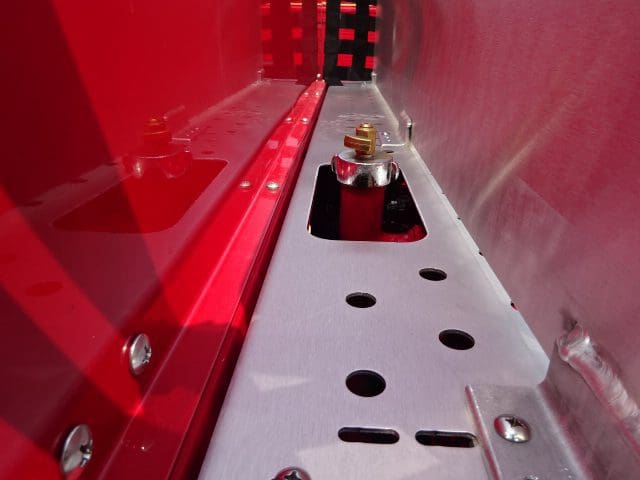

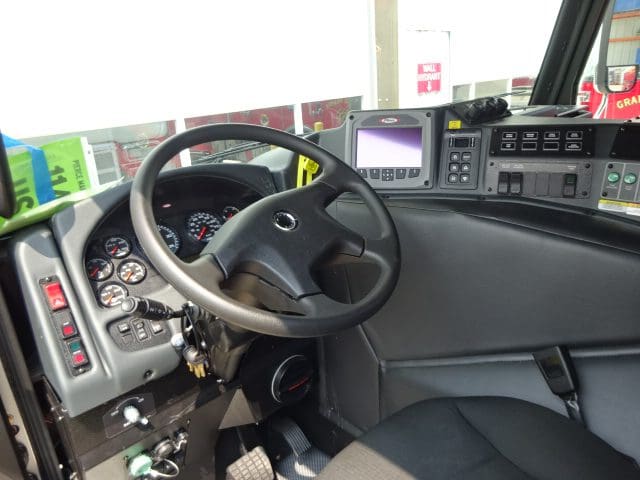

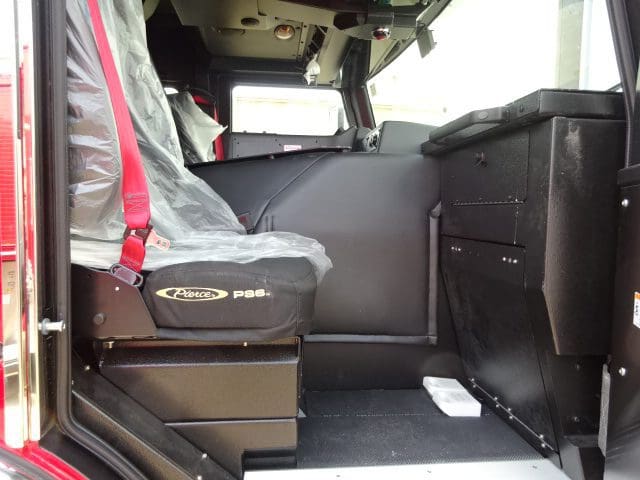

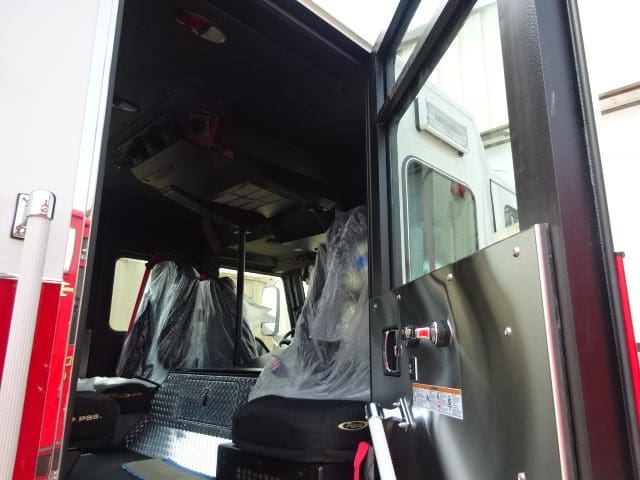

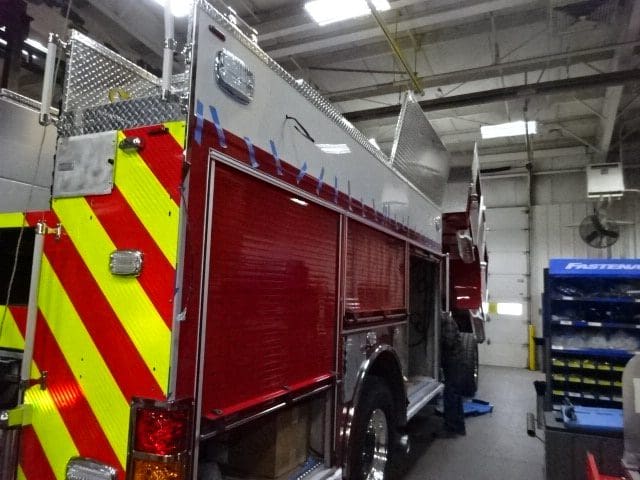

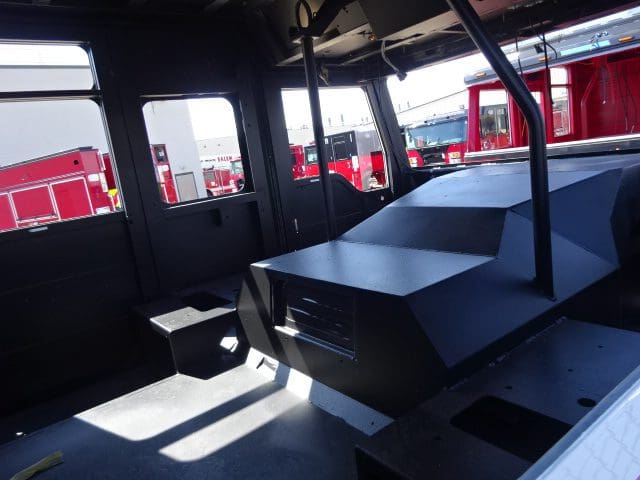

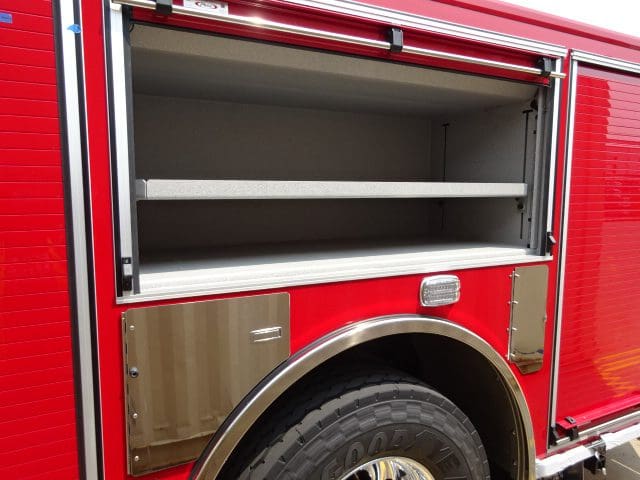

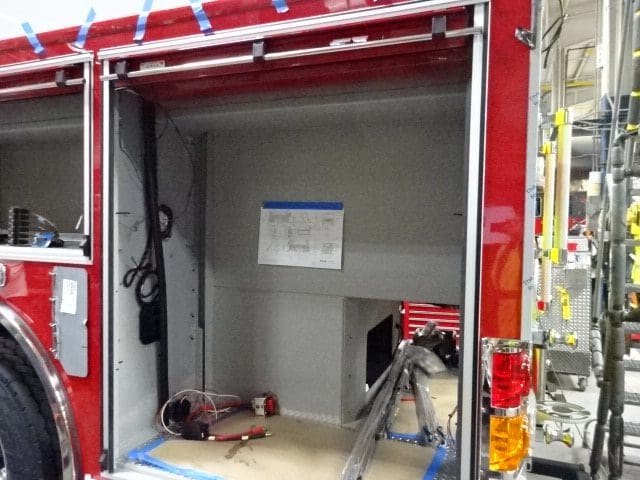

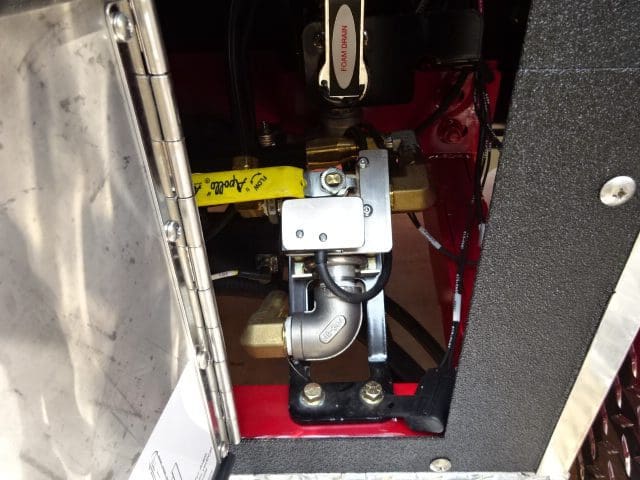

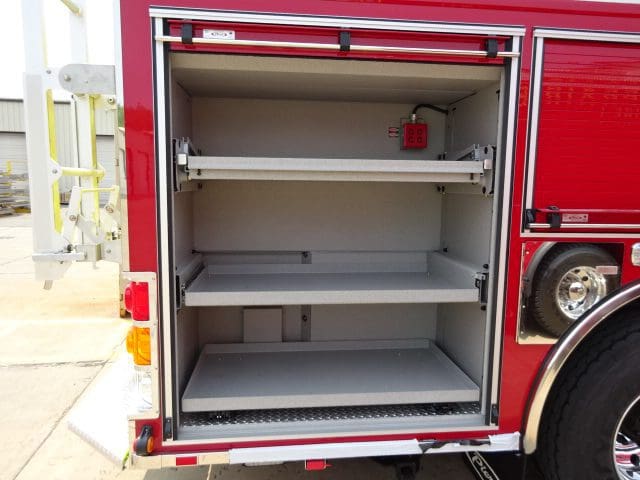

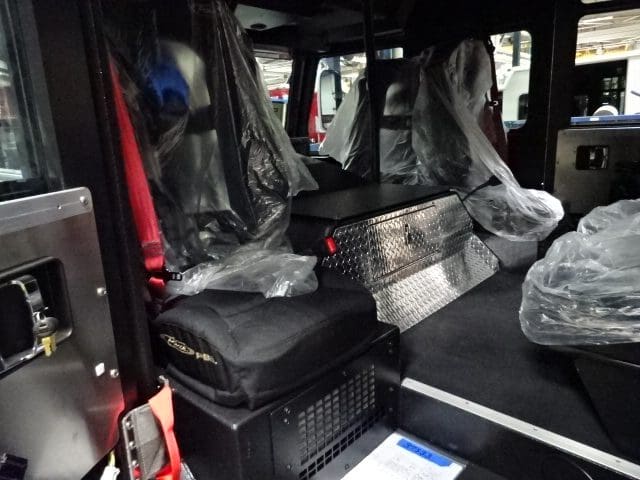

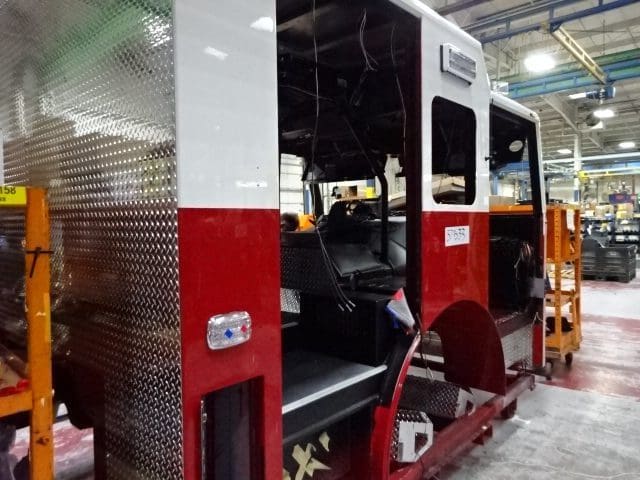

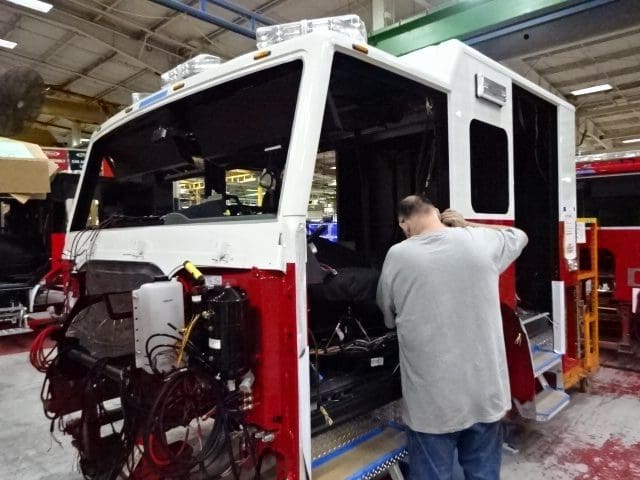

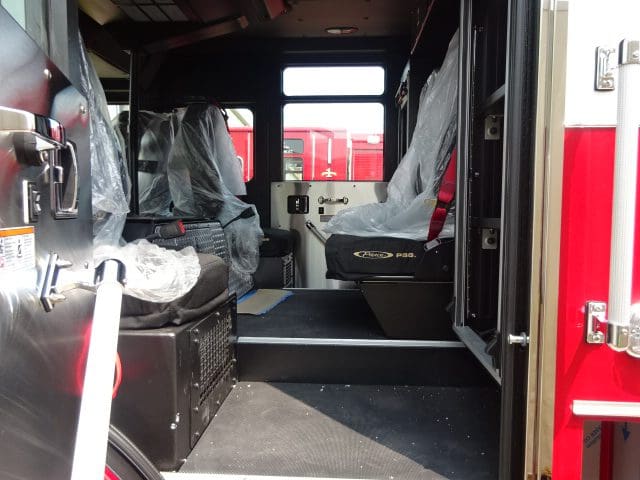

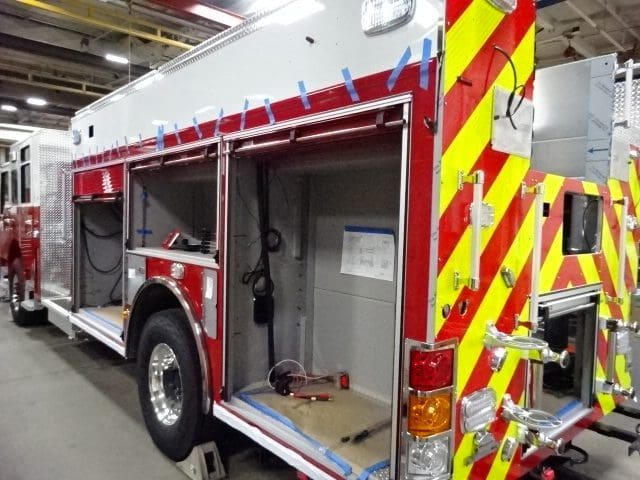

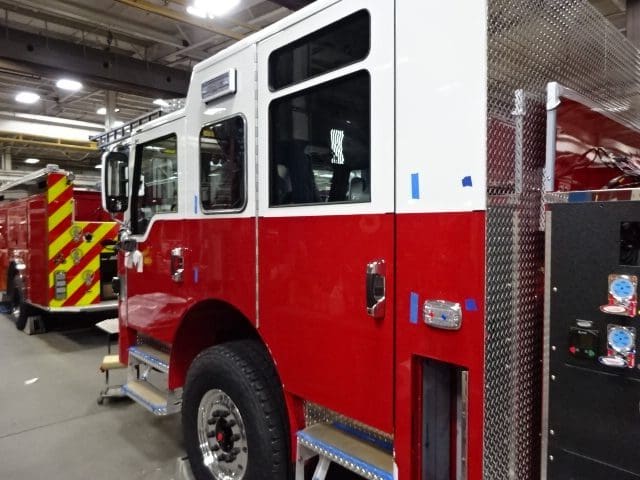

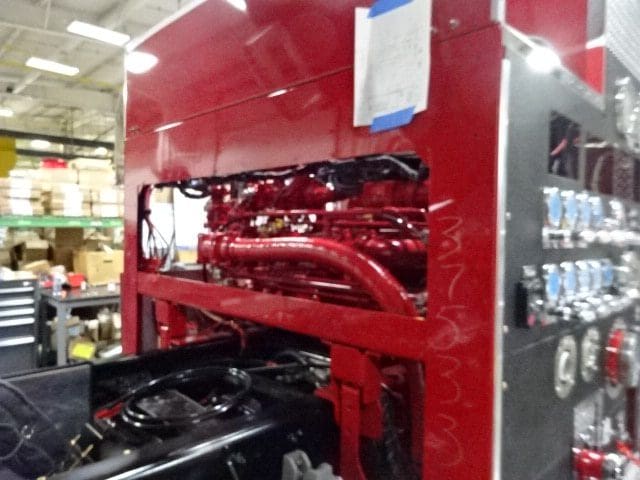

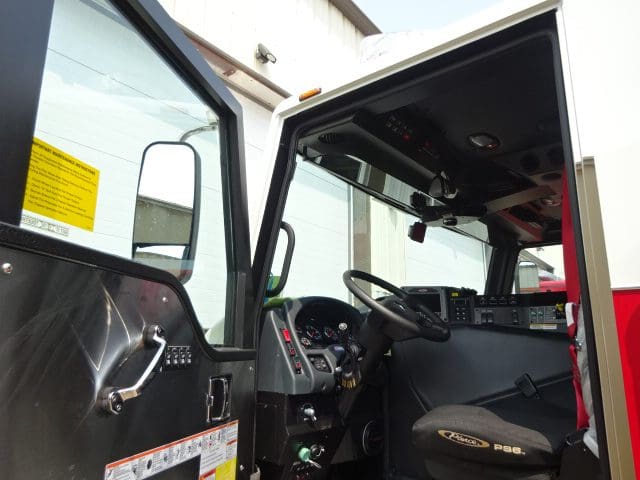

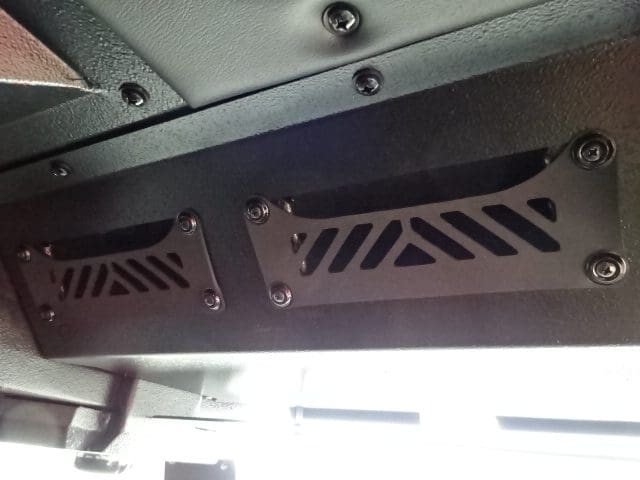

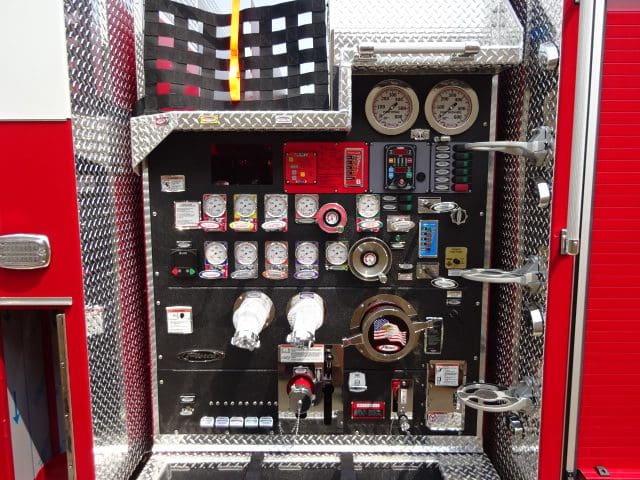

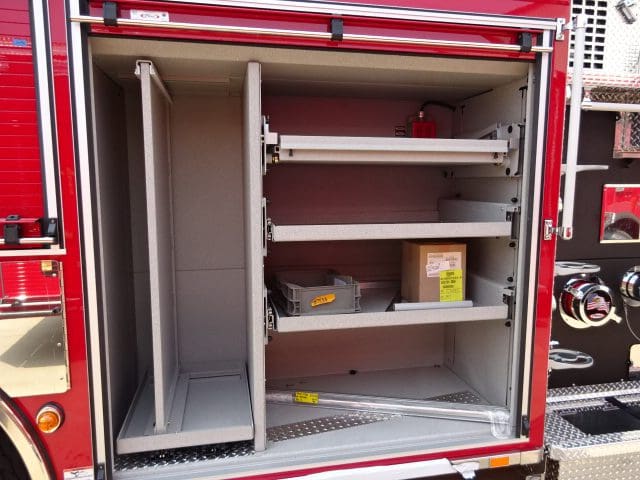

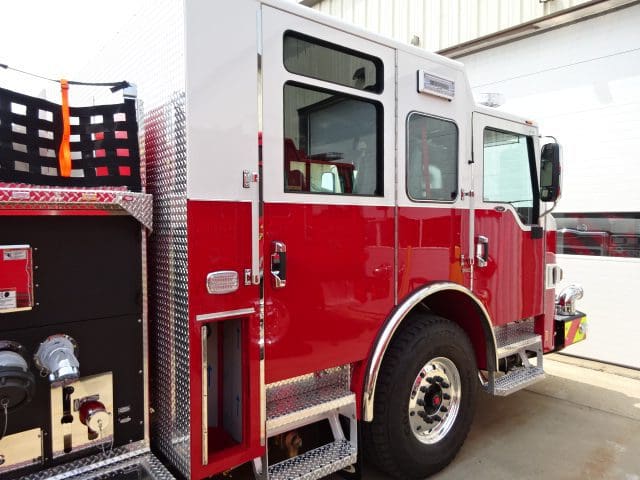

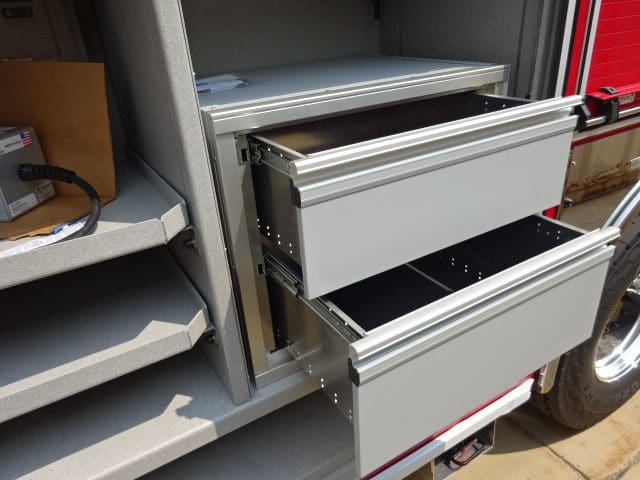

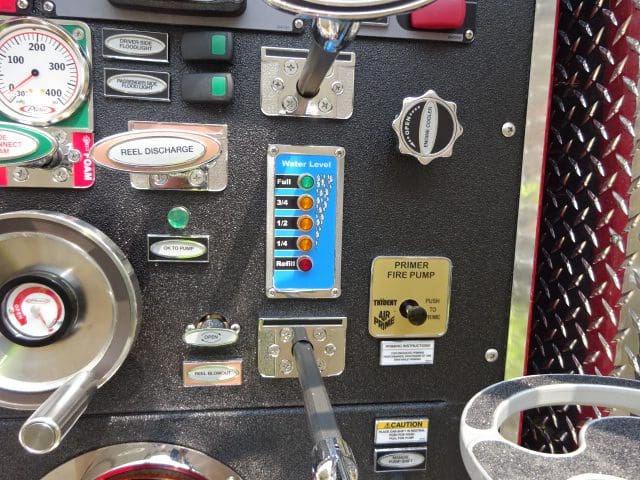

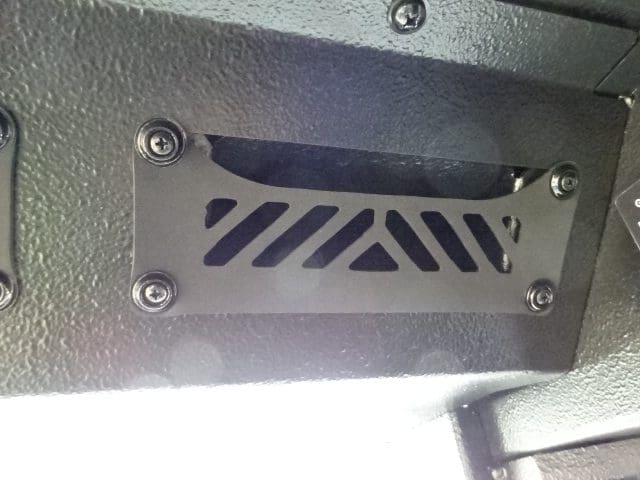

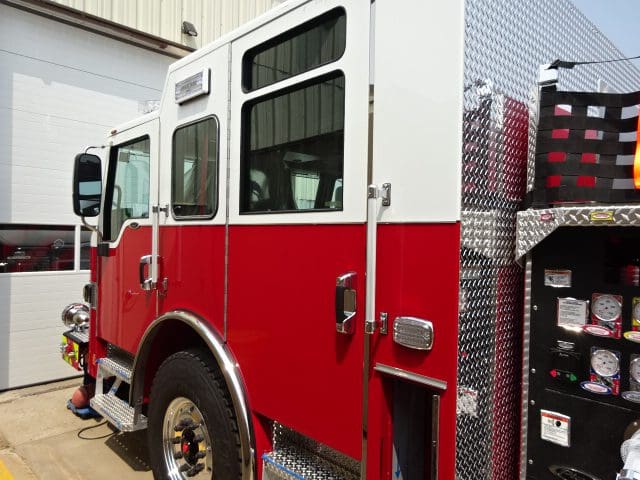

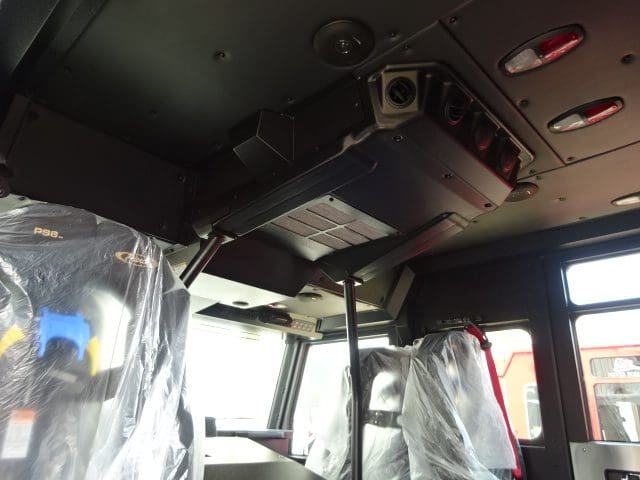

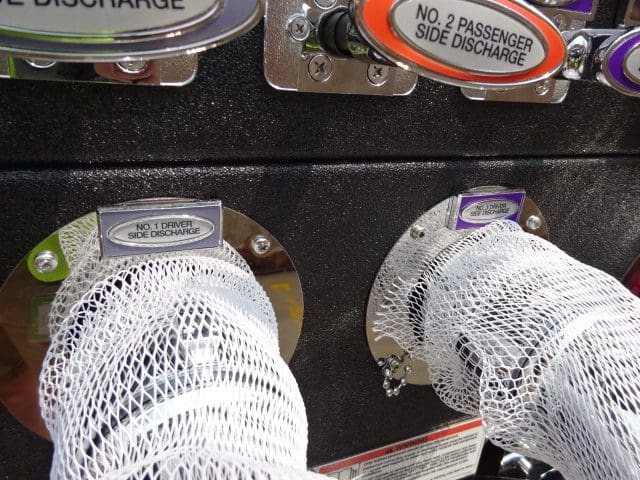

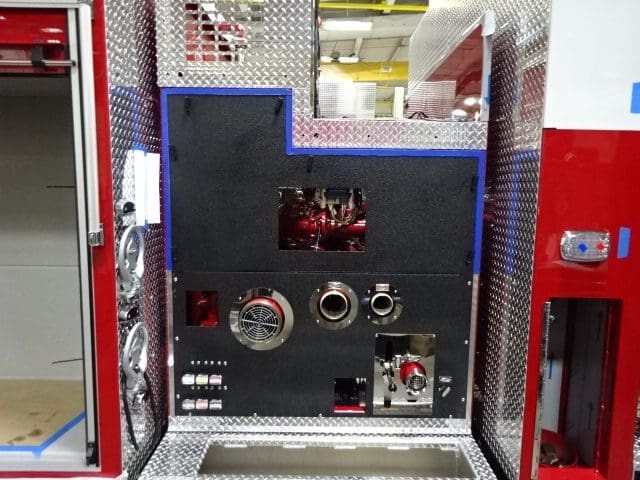

In this report, the apparatus completed final assembly and released to test. Once complete, it will be sent through quality and graphics where any remaining content will be applied. It will then be made ready for final inspection. This is the last scheduled report.

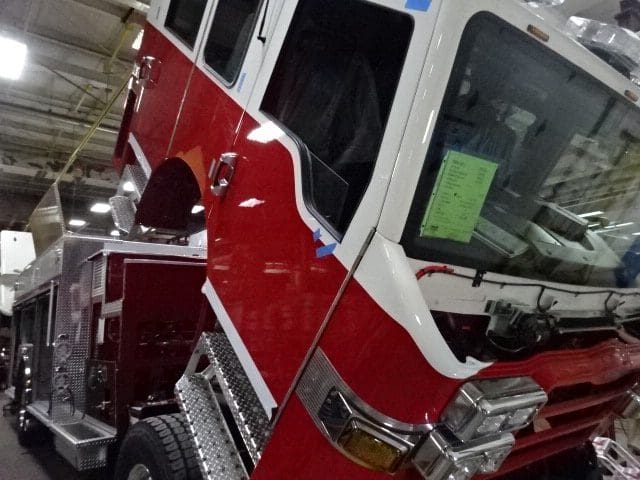

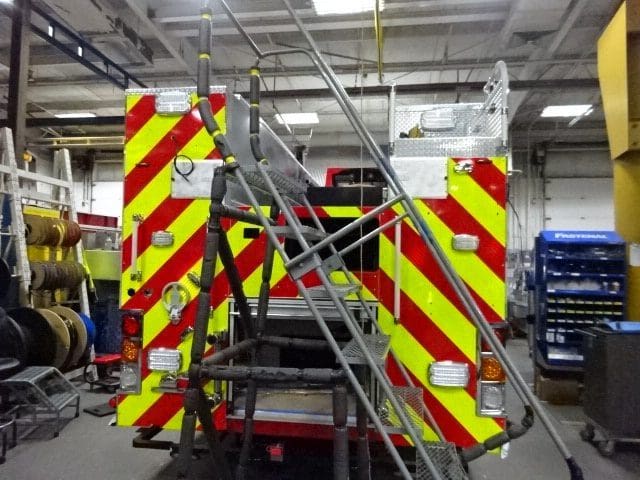

05-12-23

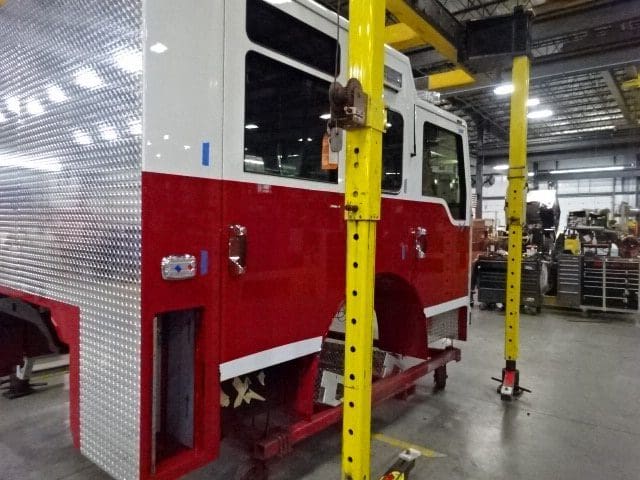

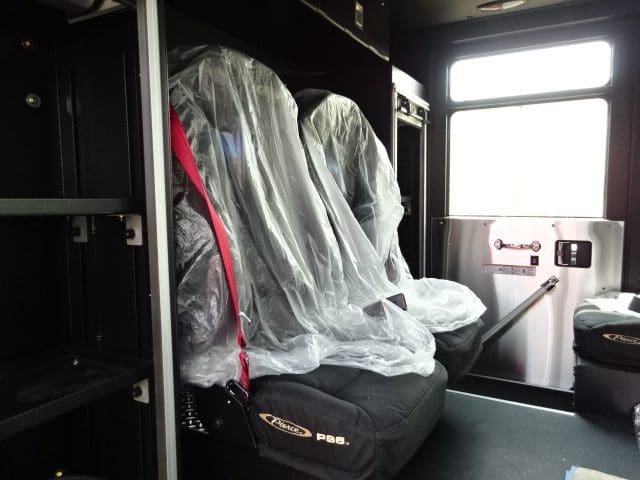

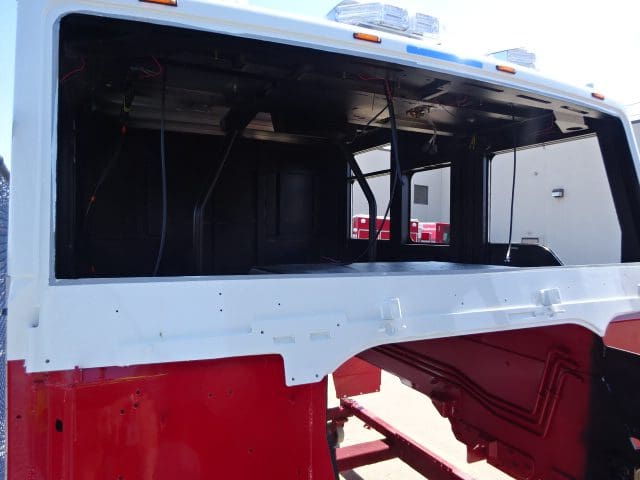

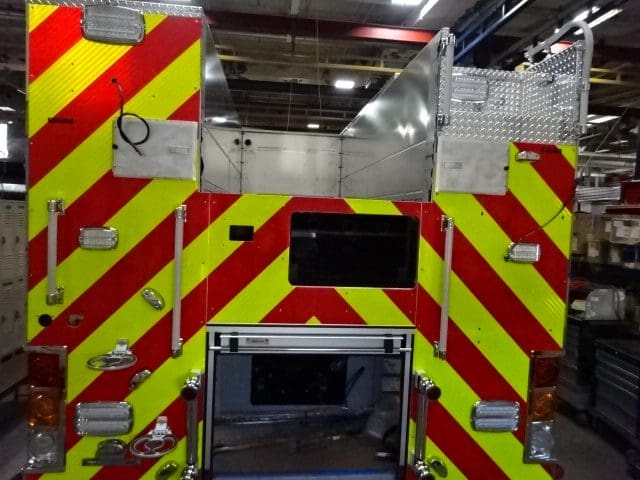

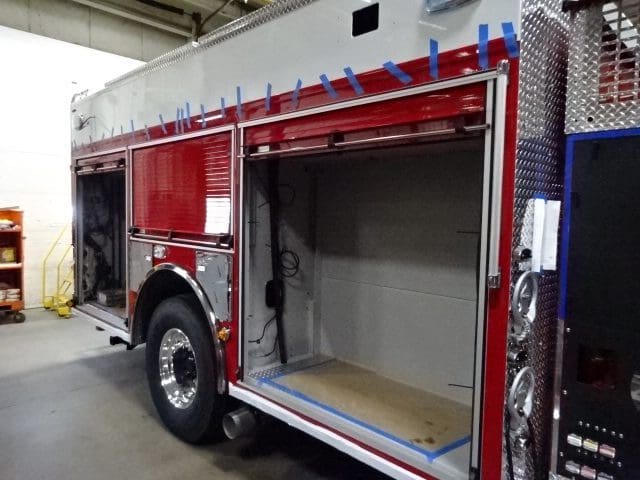

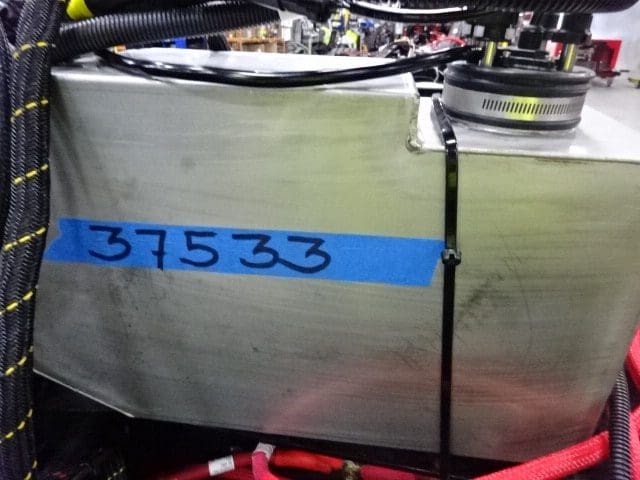

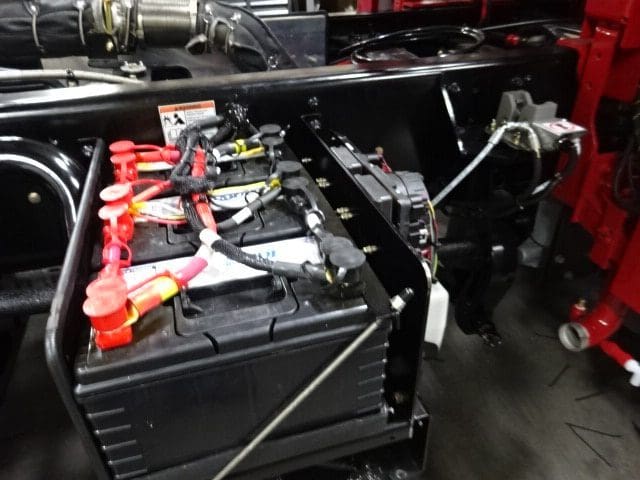

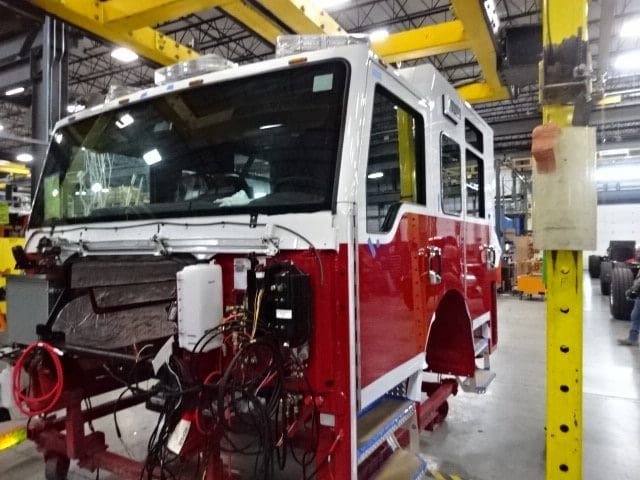

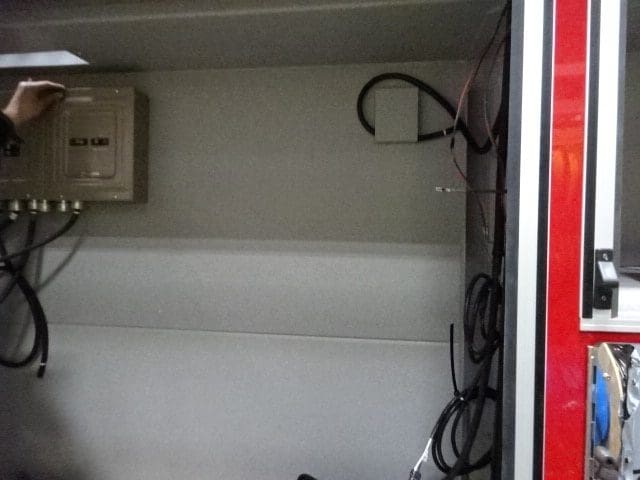

This unit was available for photography, we may be able to provide a report later this week.

04-28-23

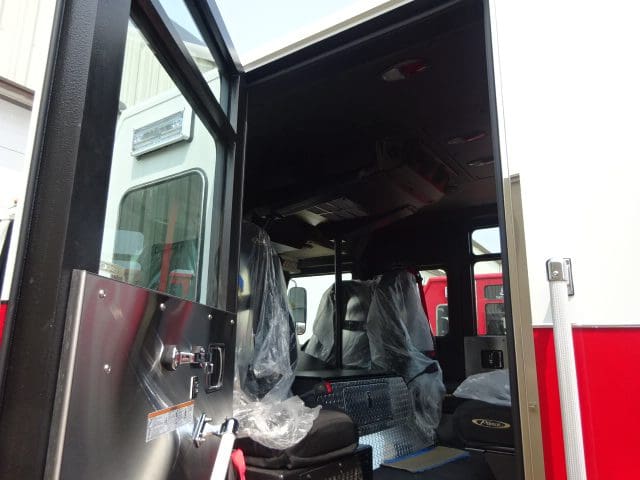

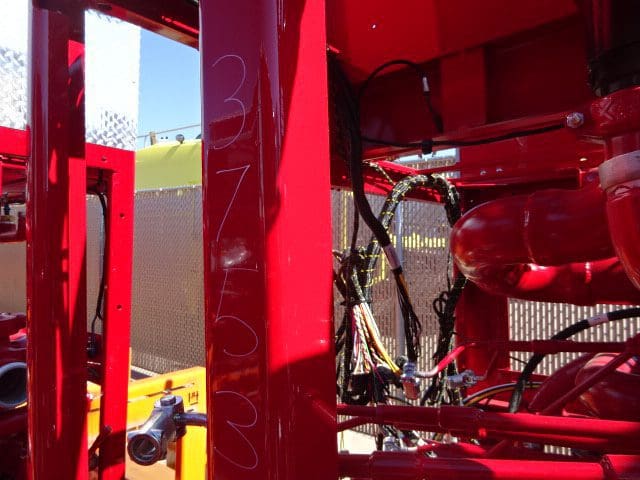

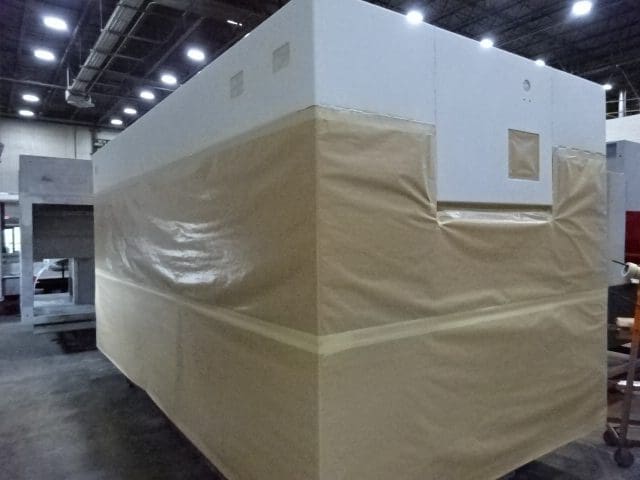

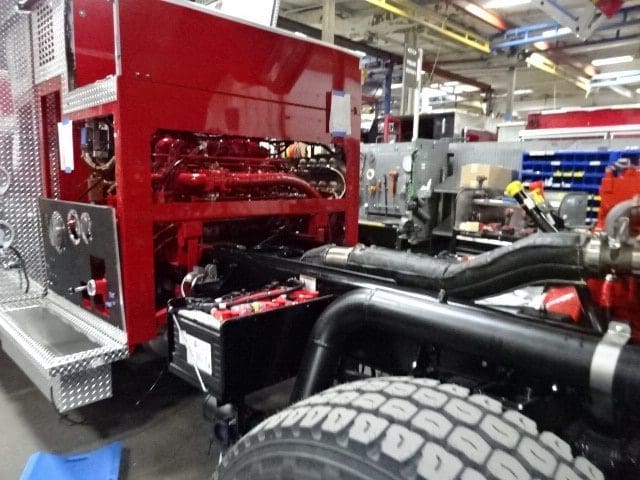

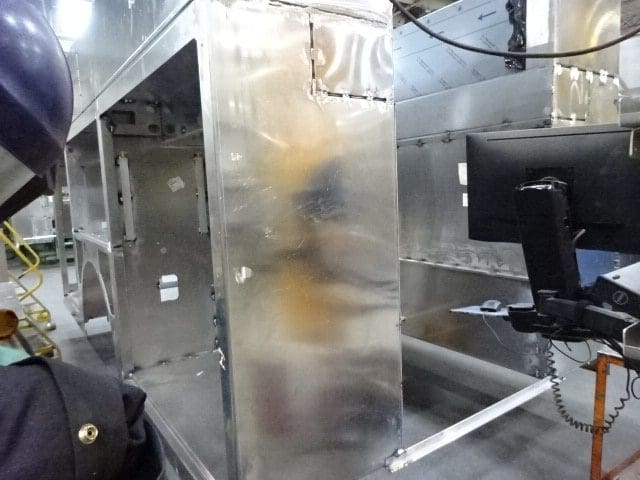

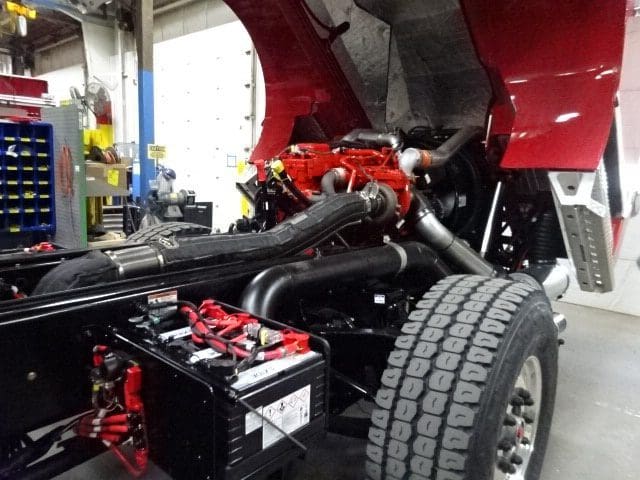

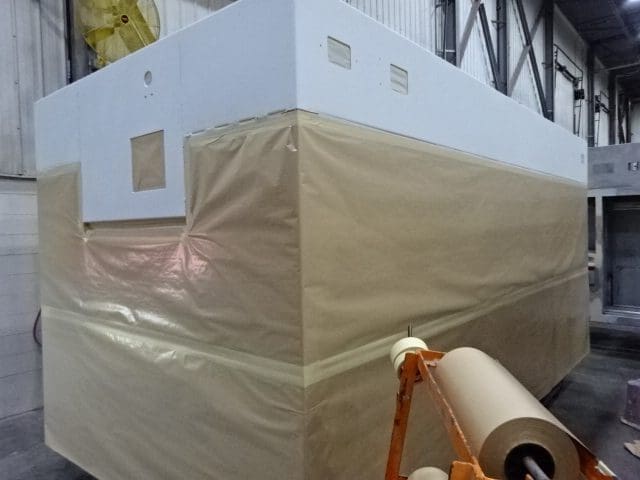

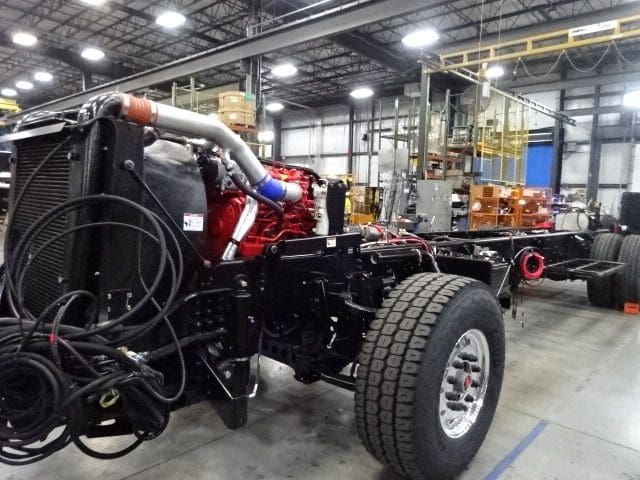

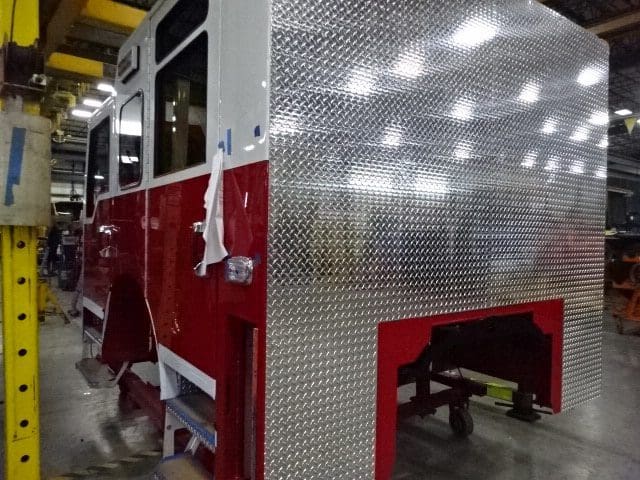

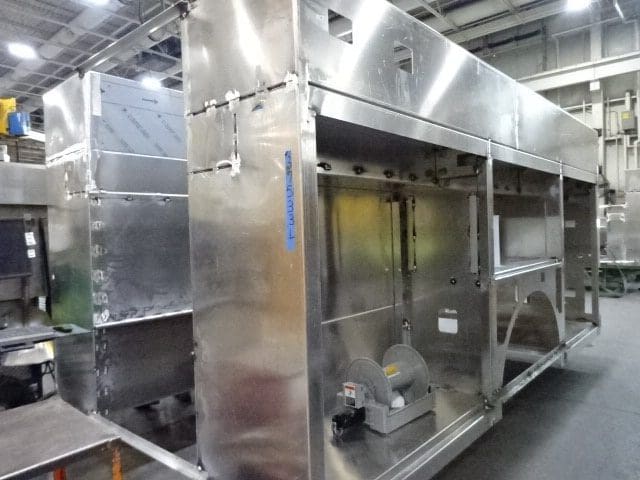

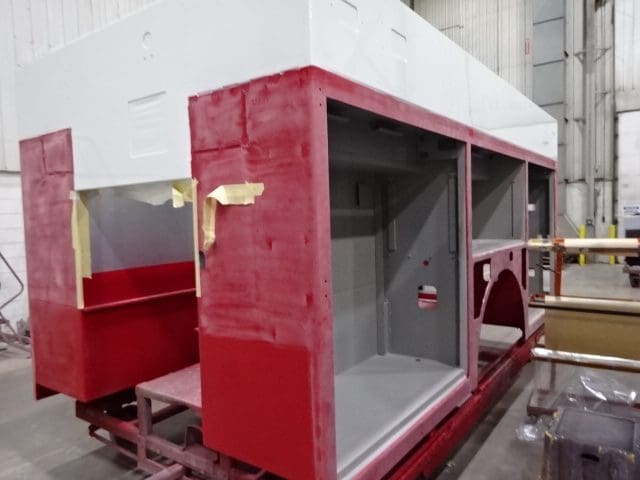

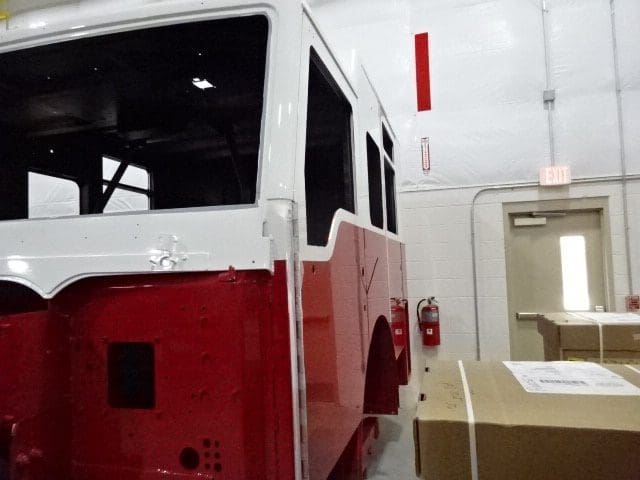

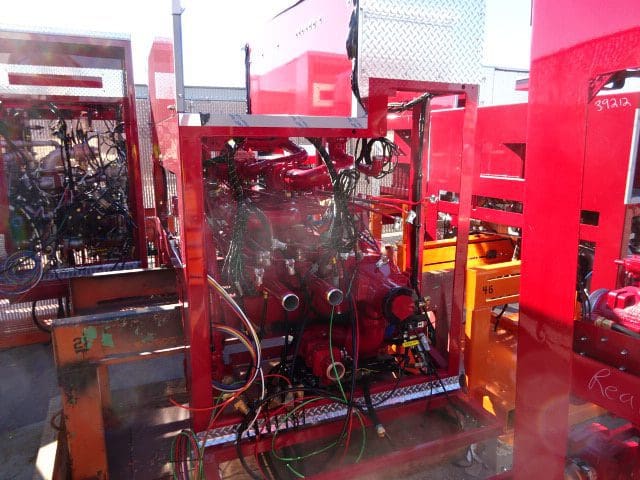

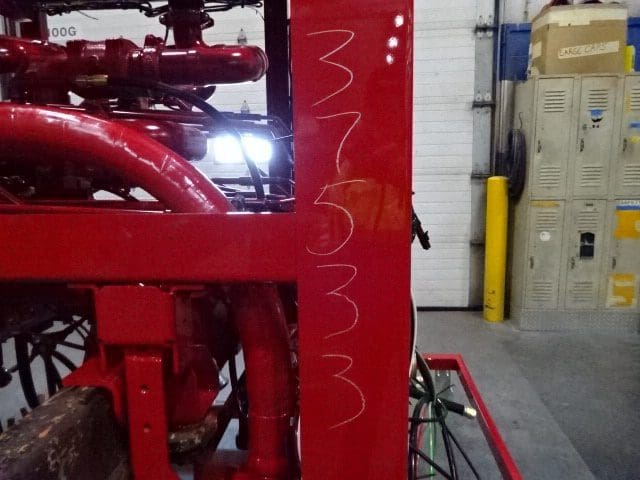

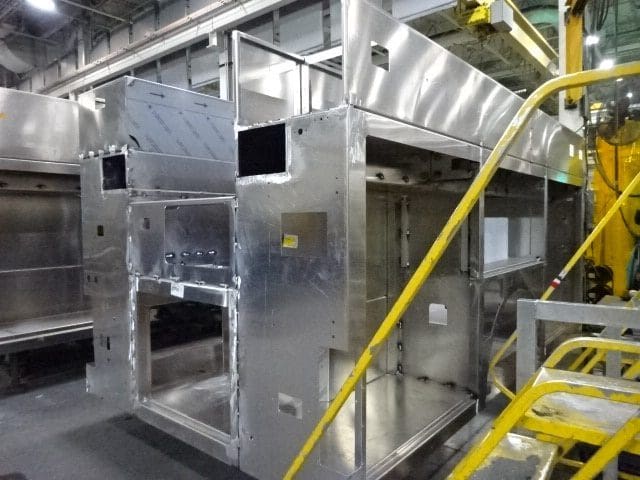

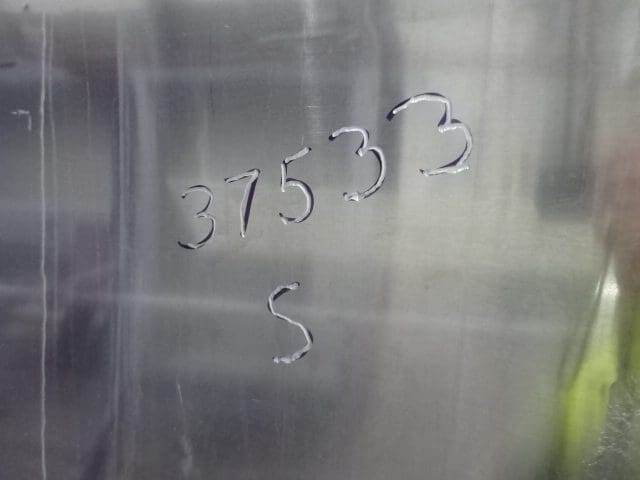

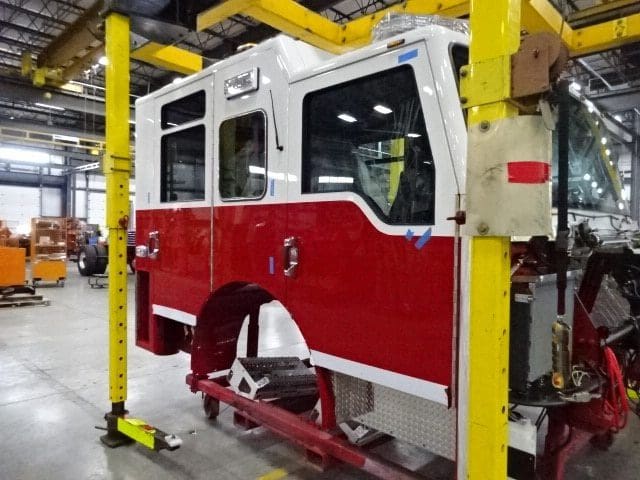

The cab and pump house were installed on the frame while the body completed paint and initial assembly and was also merged with the chassis while assembly continued.

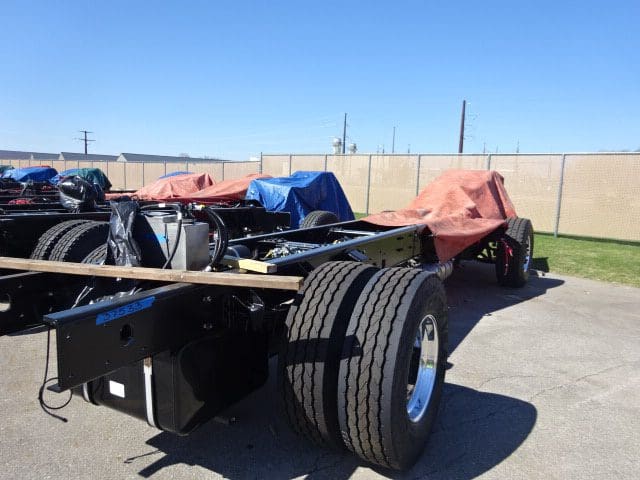

04-21-23

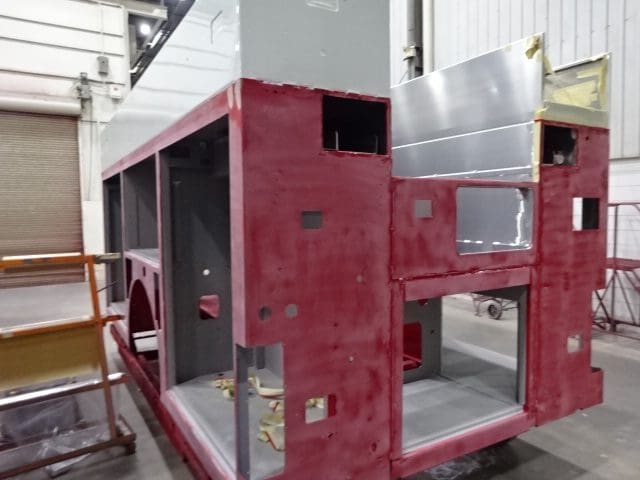

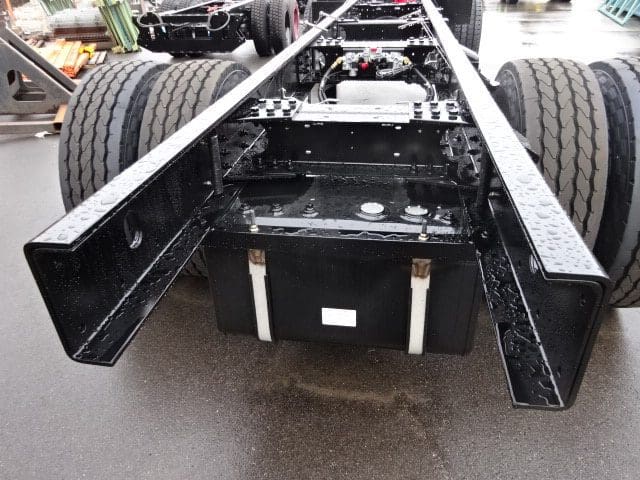

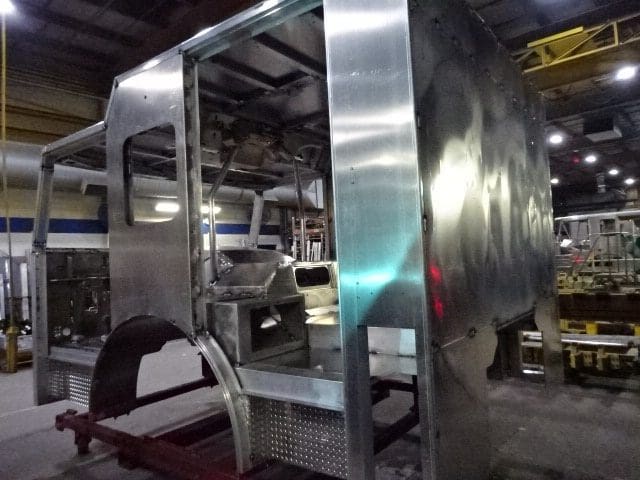

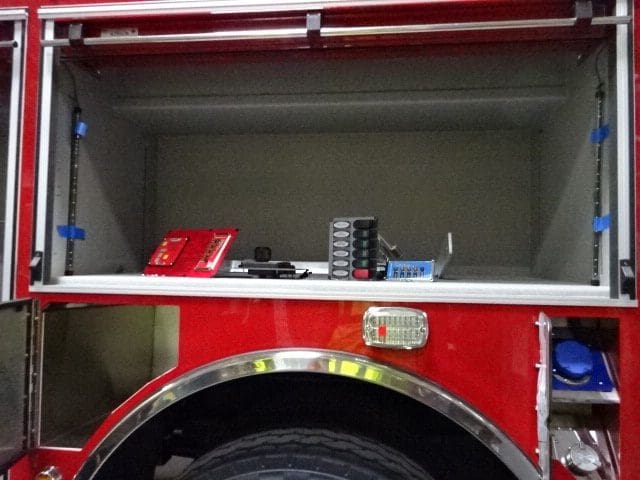

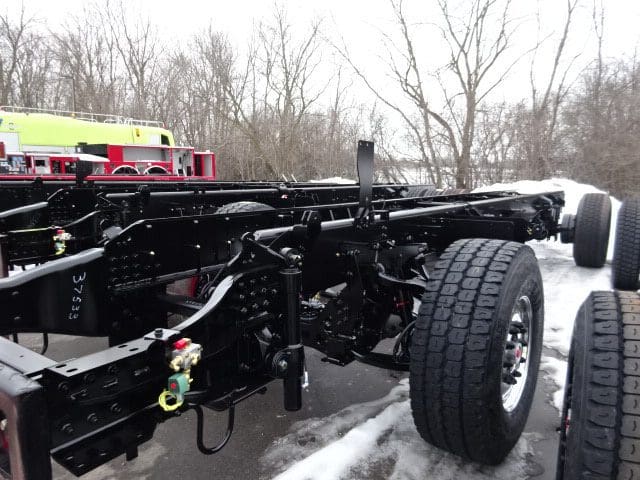

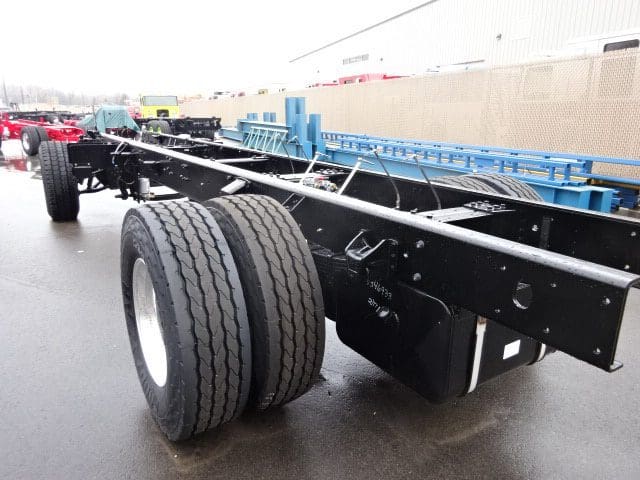

The cab was staged to be installed on the frame, the frame build continued, the pump house remained staged, and the body continued through paint.

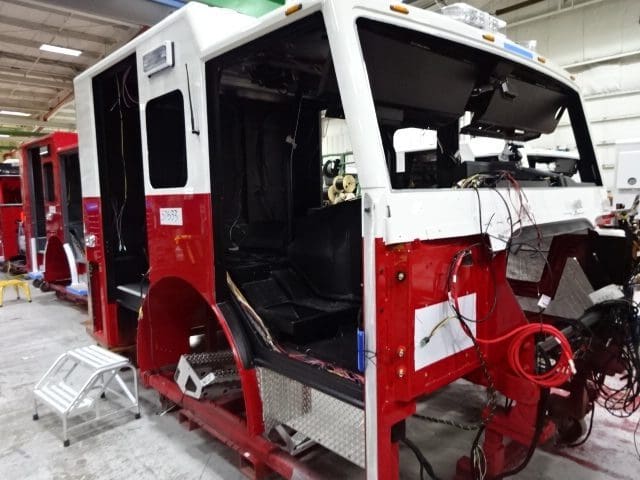

04-14-23

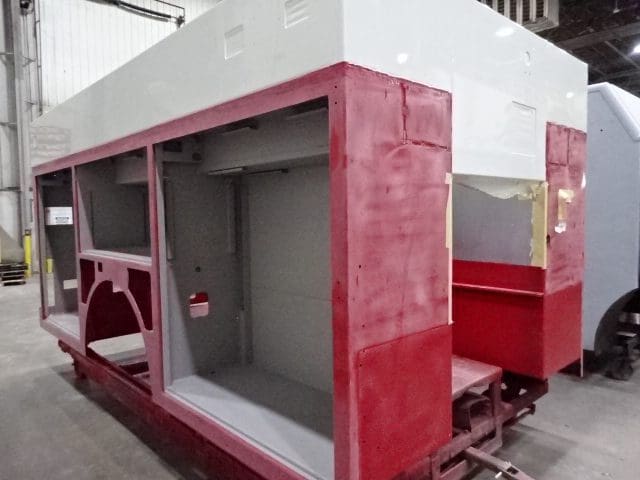

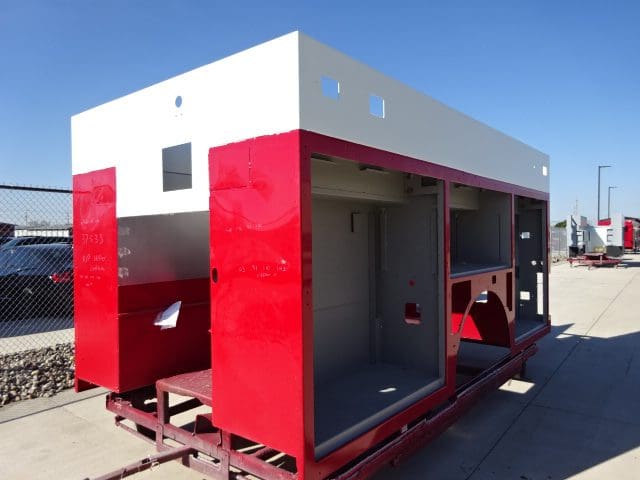

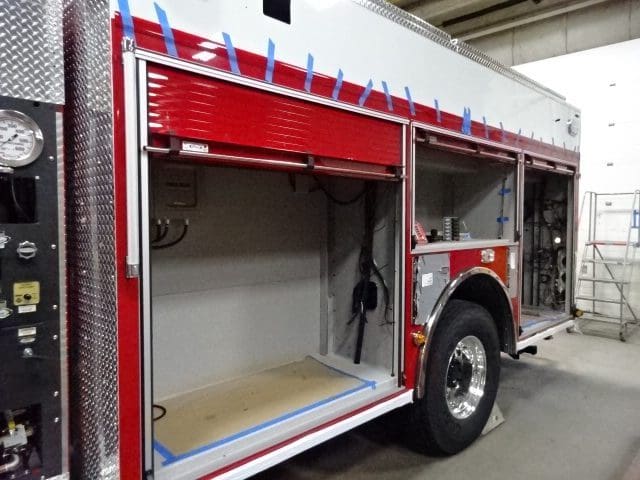

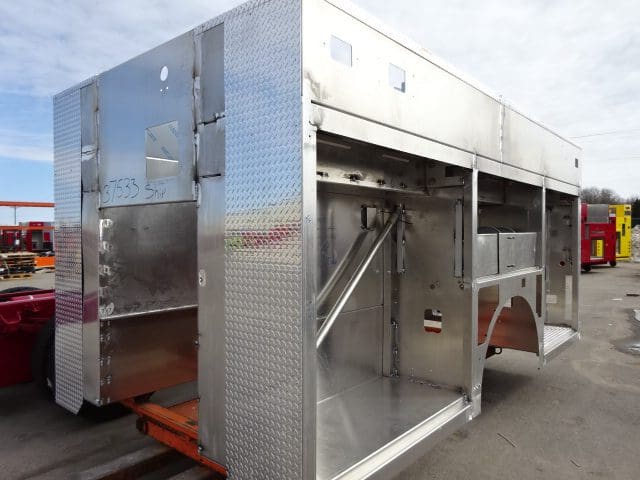

The cab completed initial assembly and was staged, the frame build continued, the pump house completed remained staged, and the body continued through paint.

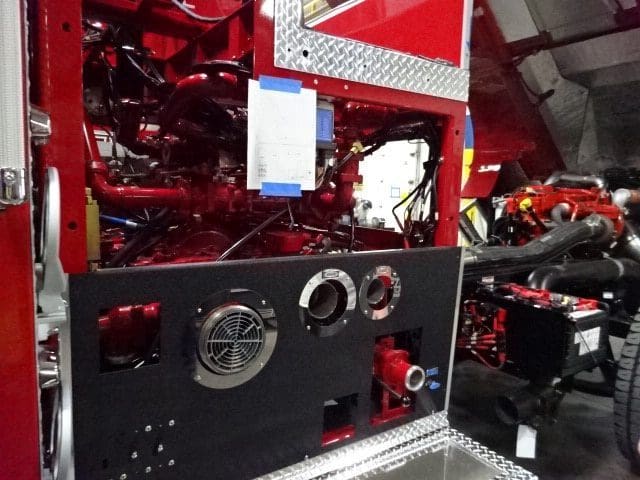

04-07-23

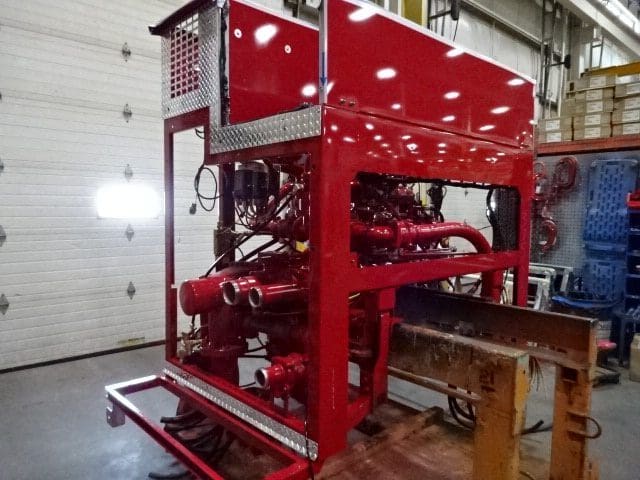

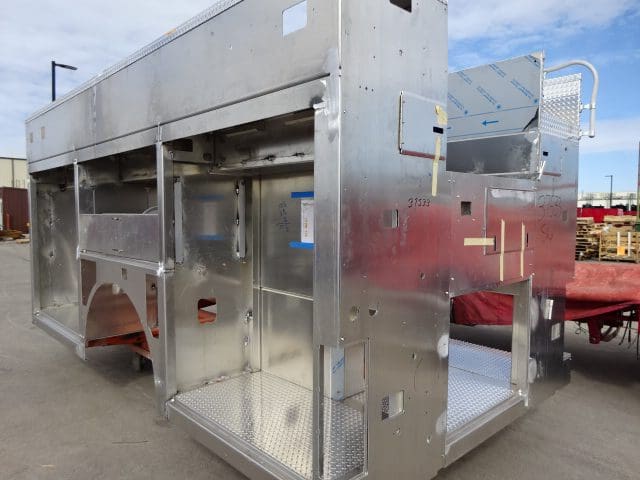

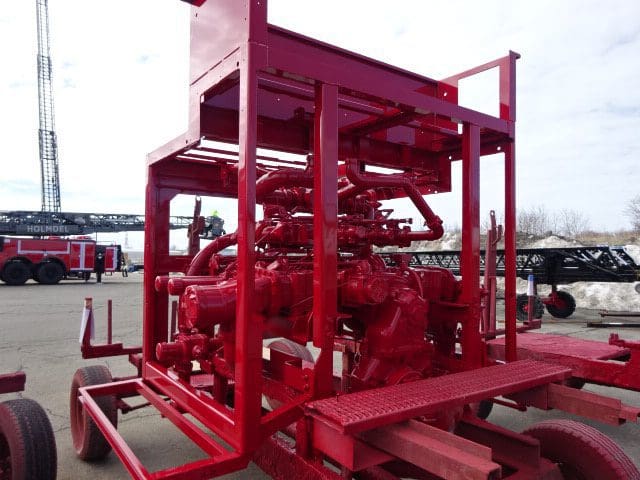

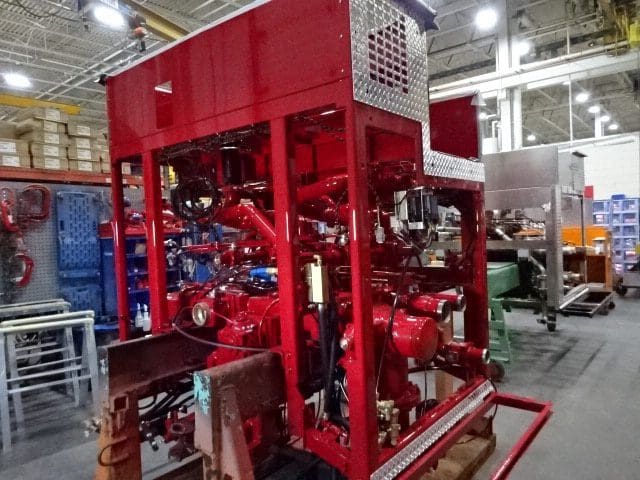

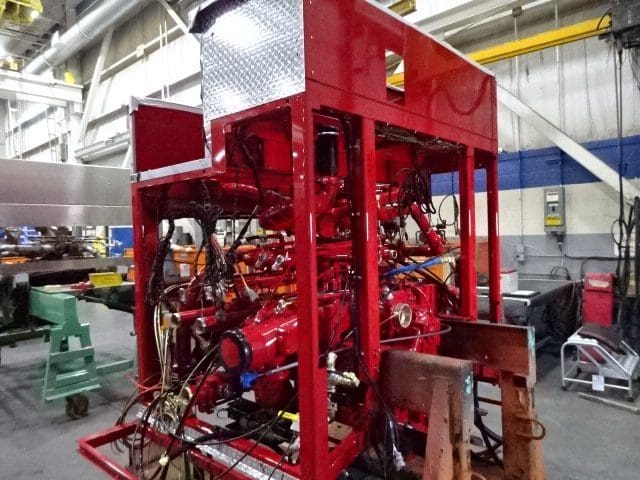

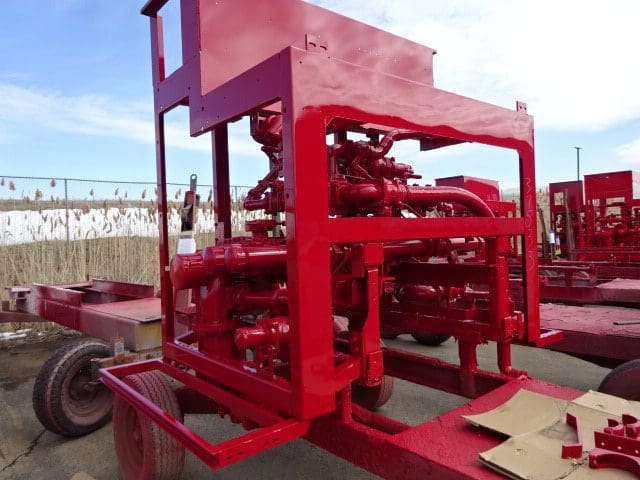

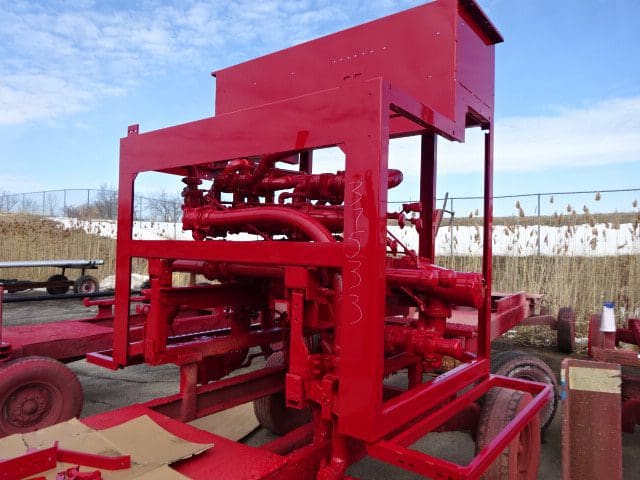

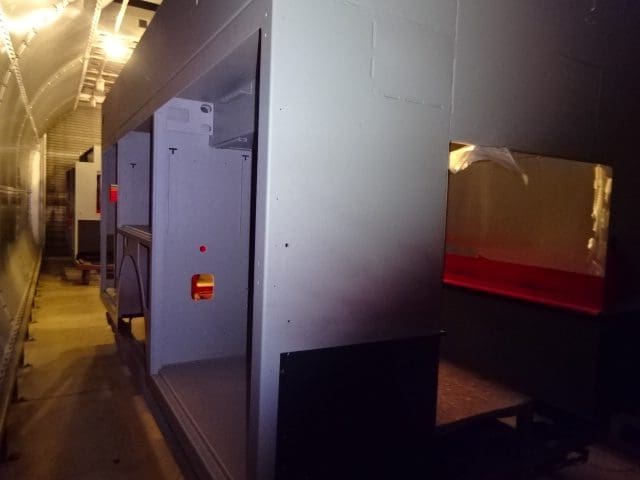

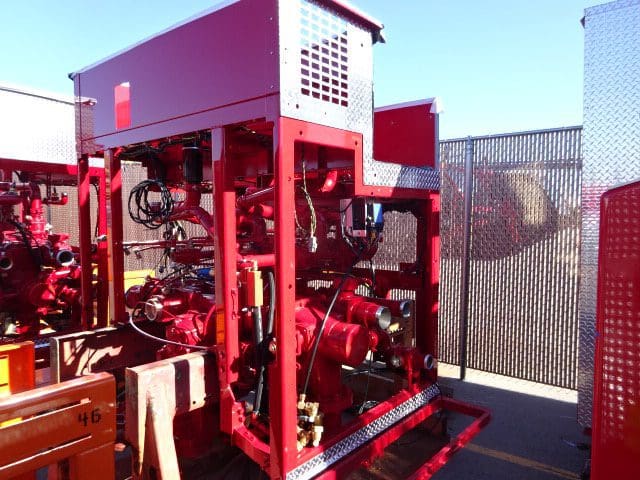

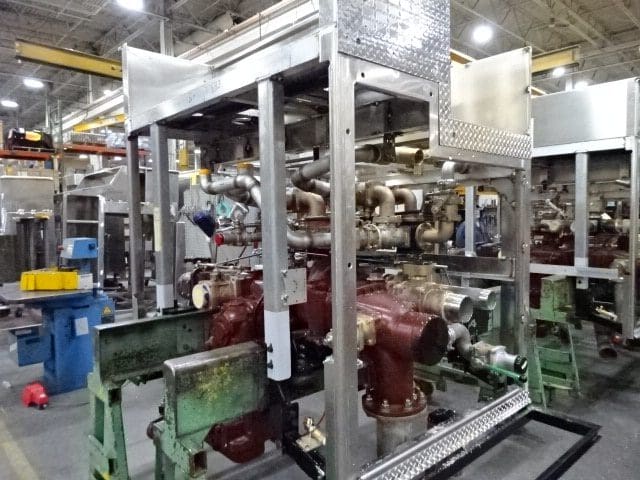

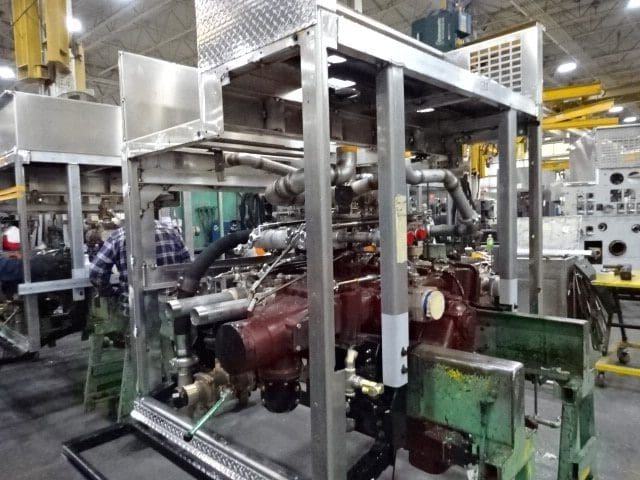

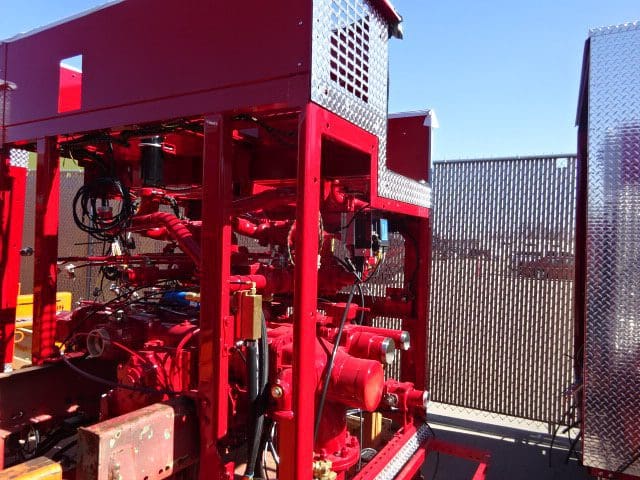

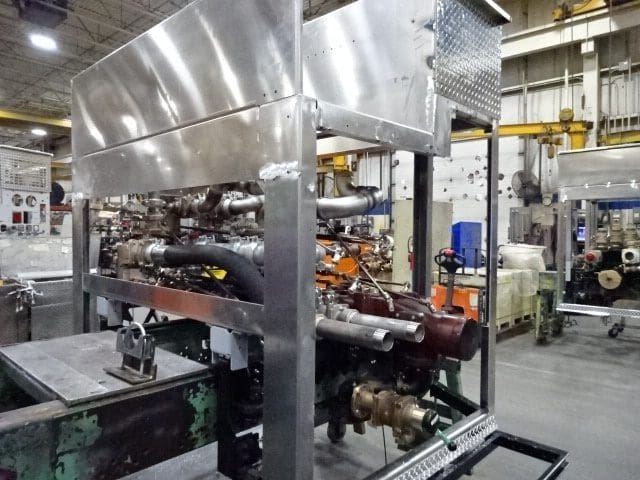

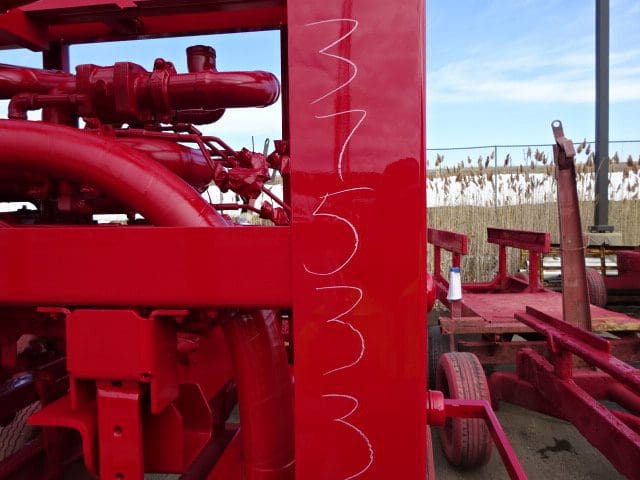

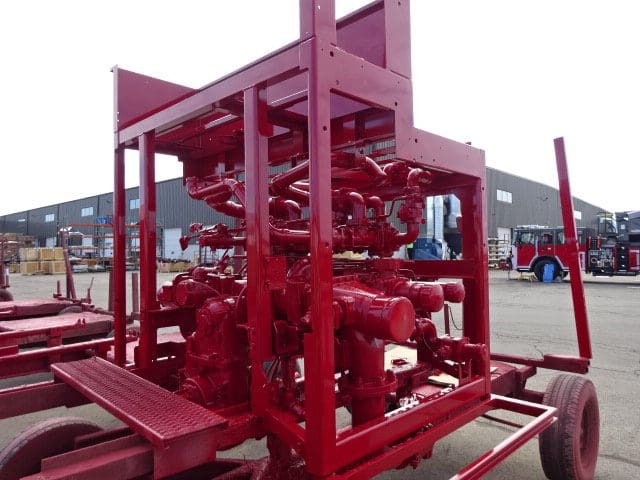

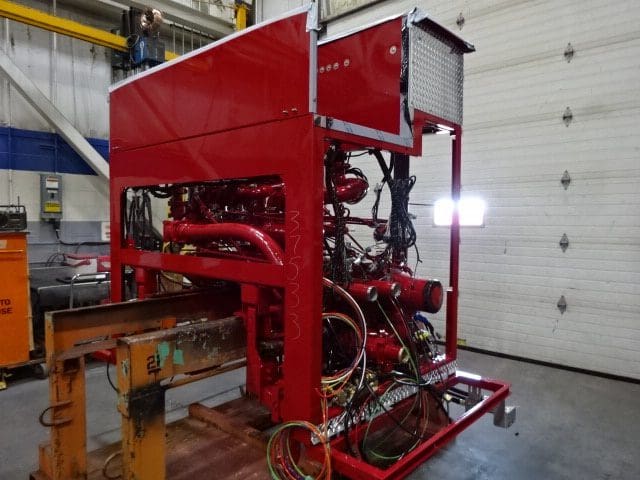

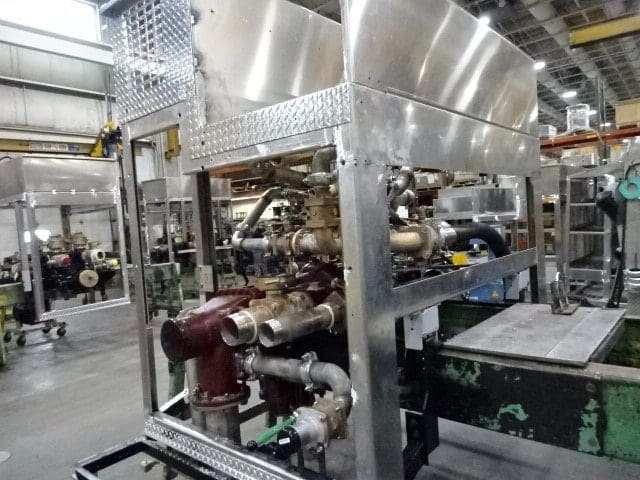

The cab continued initial assembly, the frame build continued, the pump house completed initial assembly, and the body continued through paint.

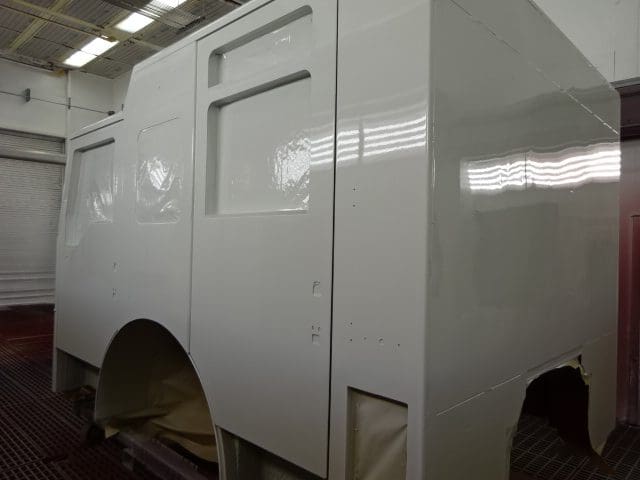

03-31-23

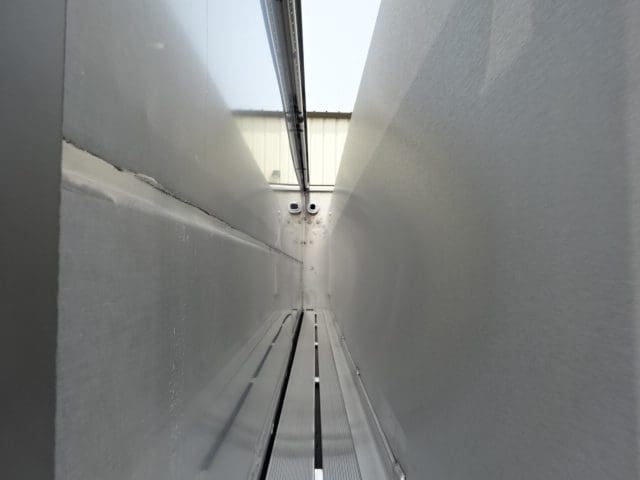

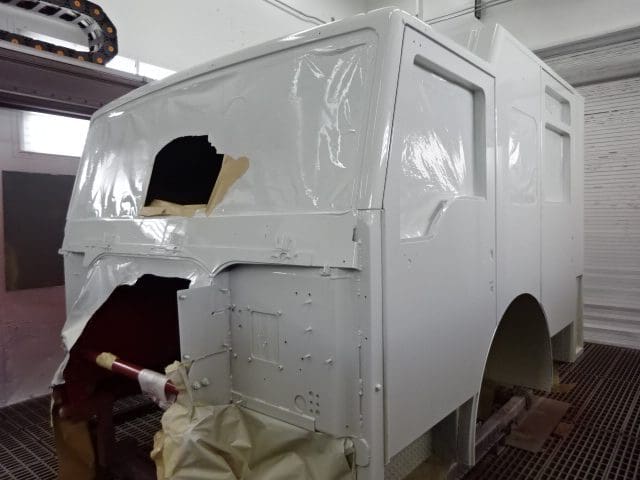

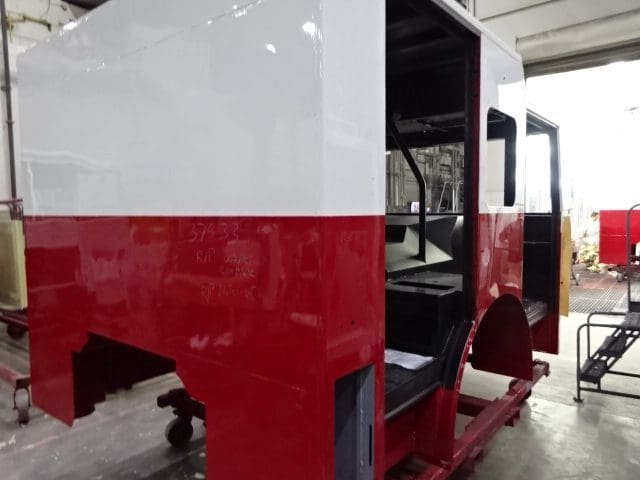

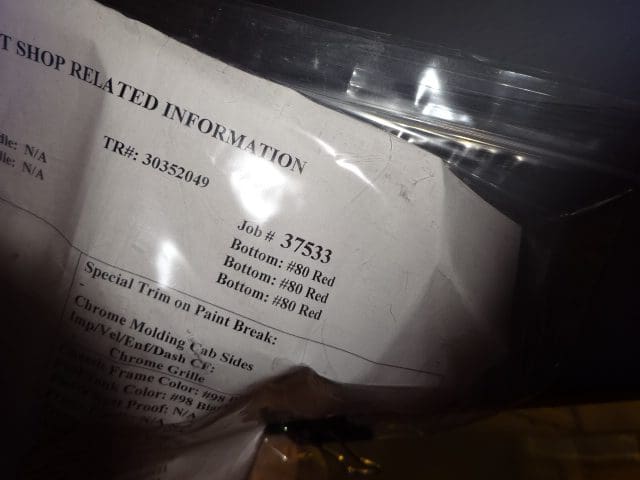

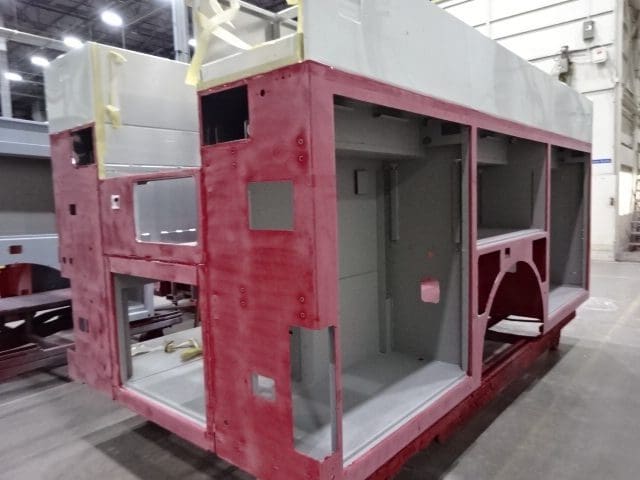

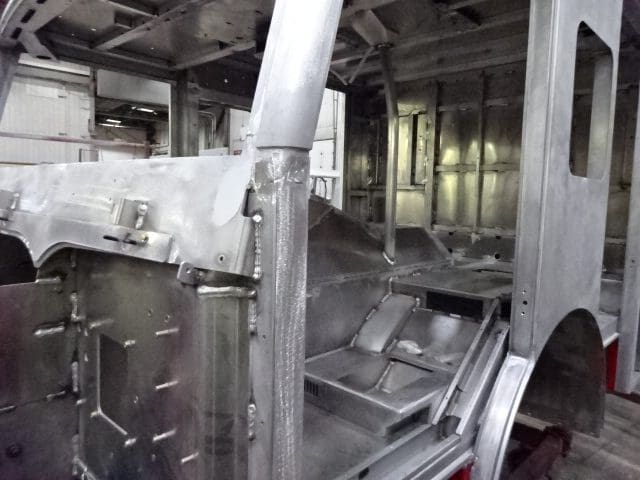

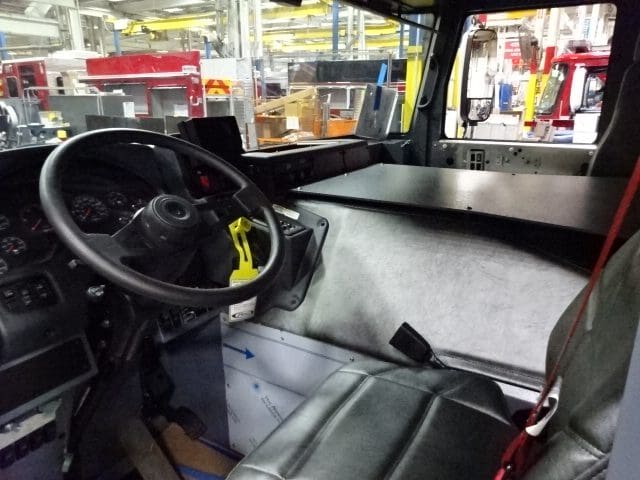

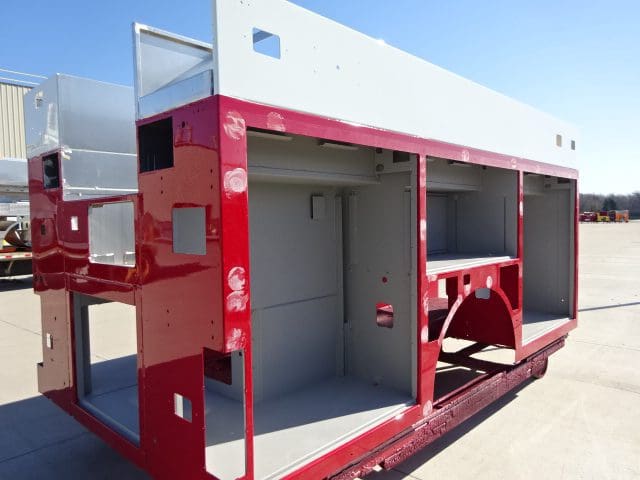

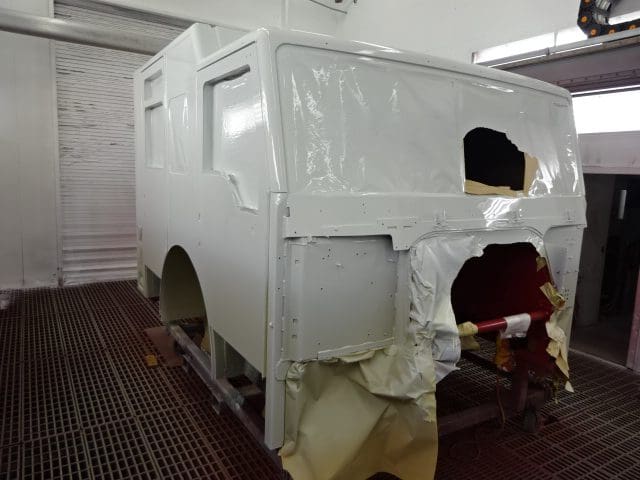

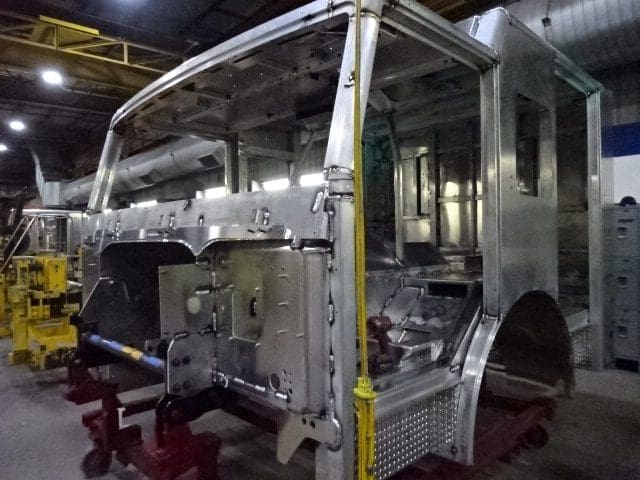

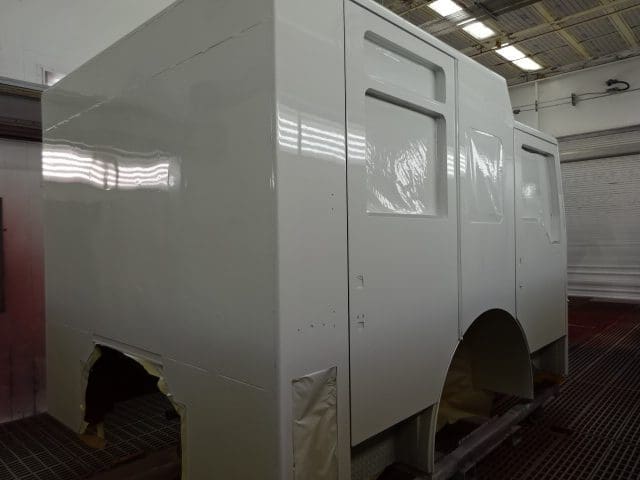

The cab began initial assembly, the frame build continued, the pump house continued initial assembly, and the body began the paint process.
03-24-23

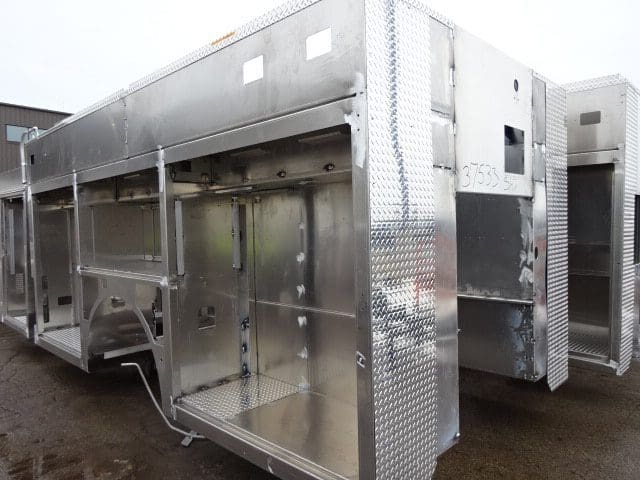

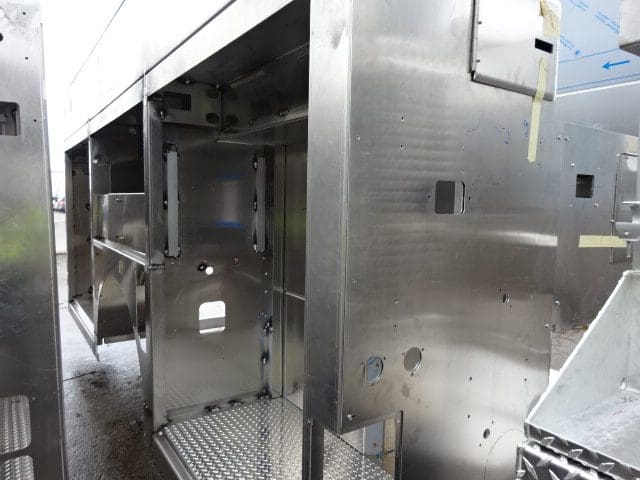

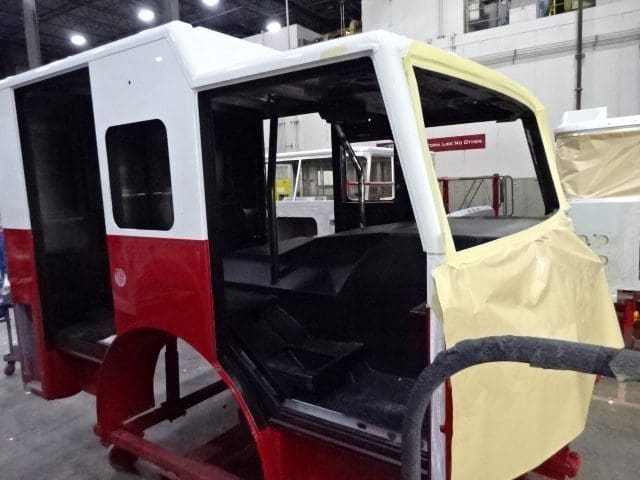

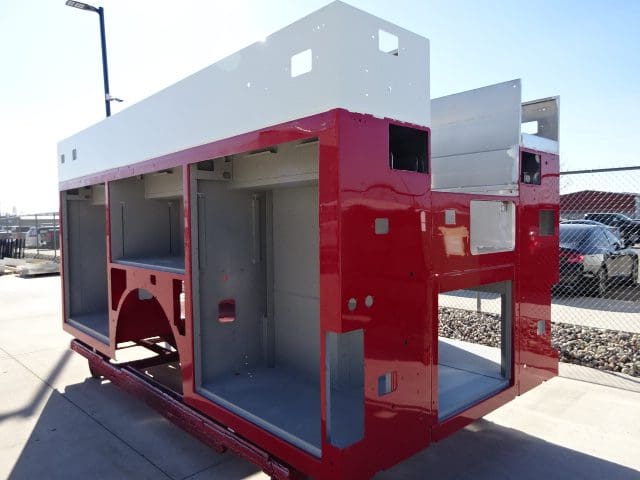

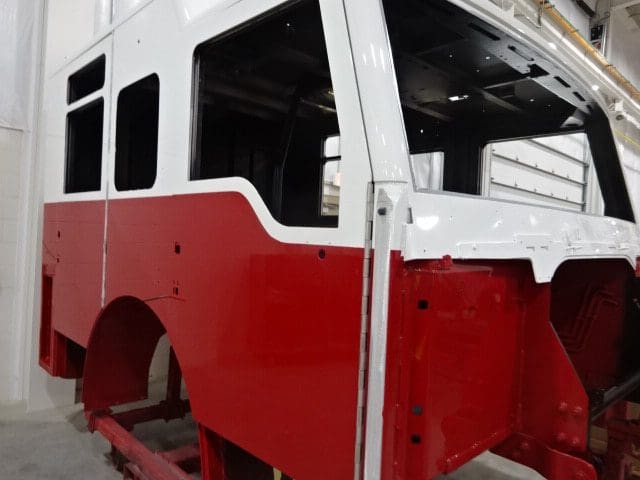

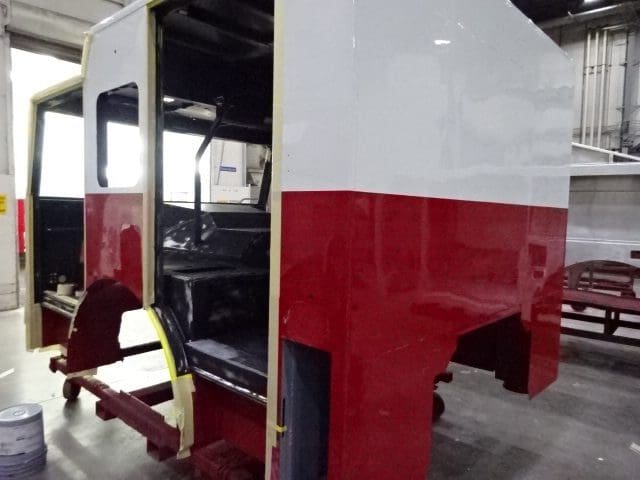

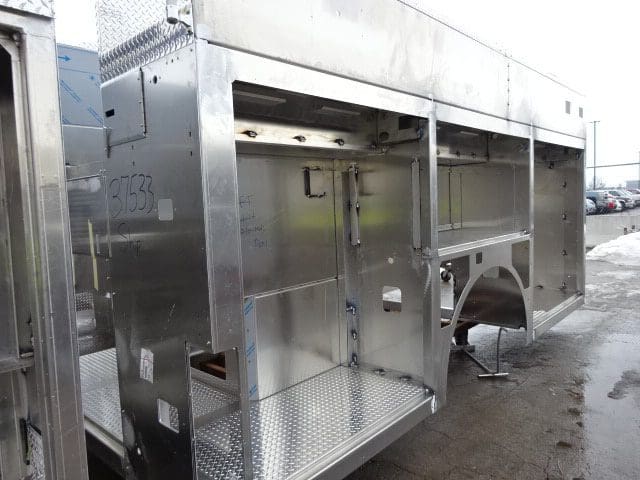

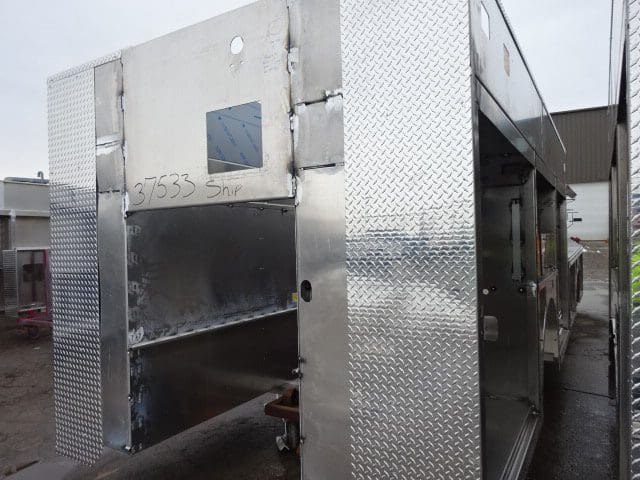

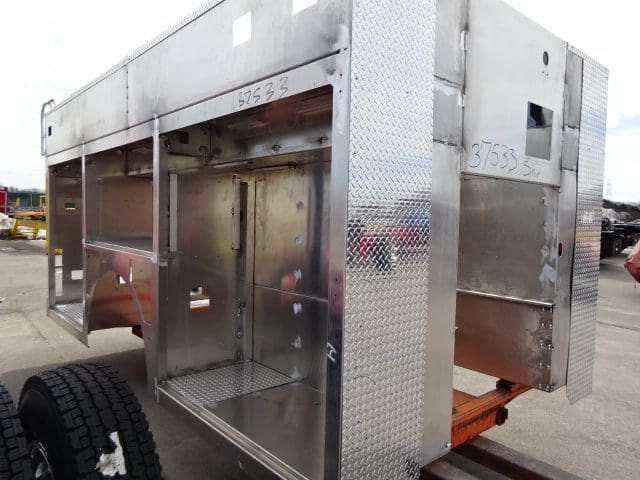

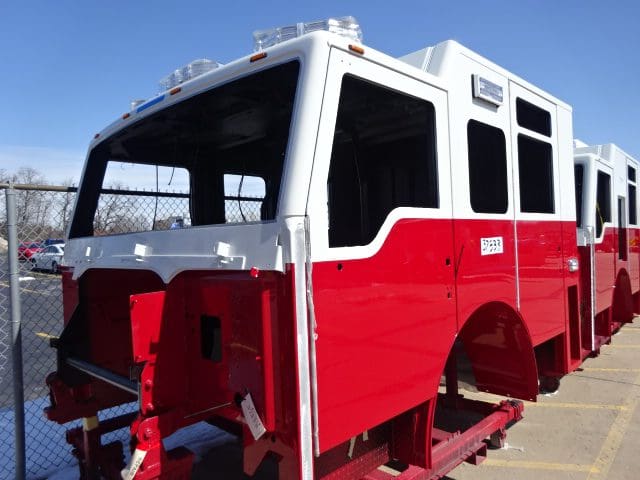

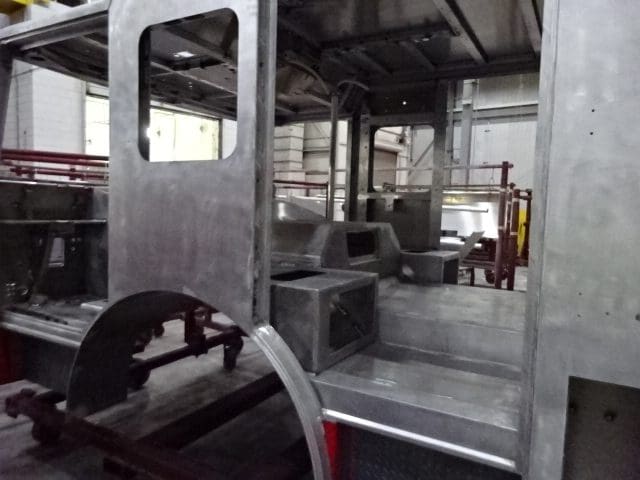

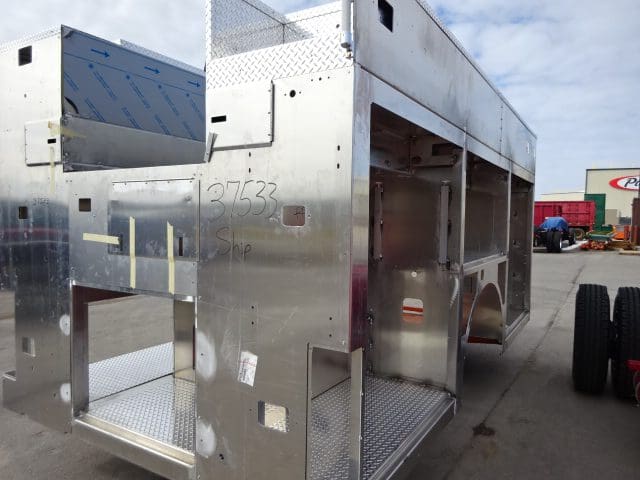

The cab made progress through paint and was staged, the frame build continued, the pump house was painted, and the body completed fabrication and was staged.

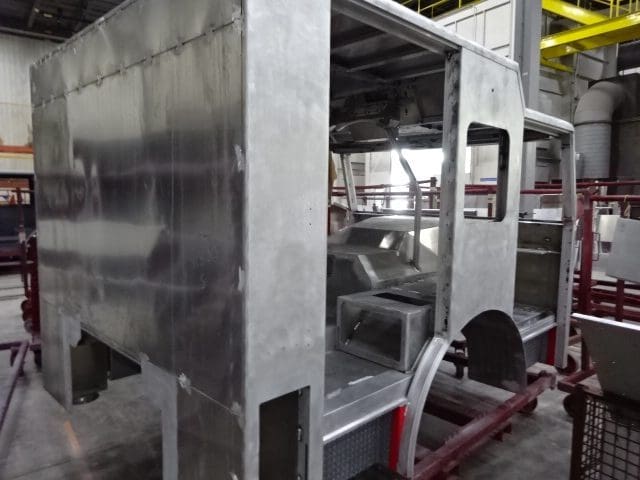

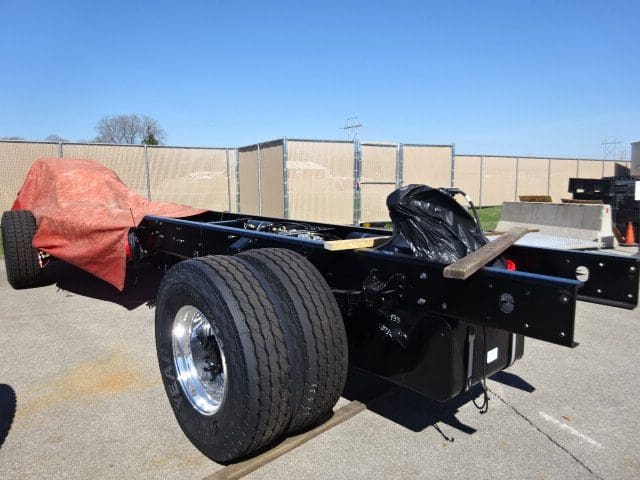

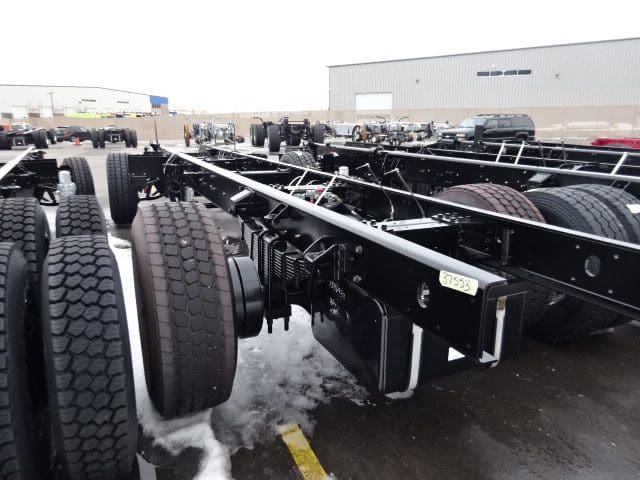

03-17-23

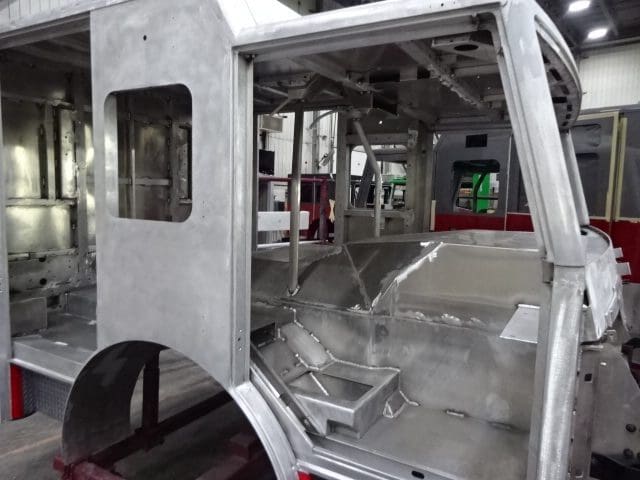

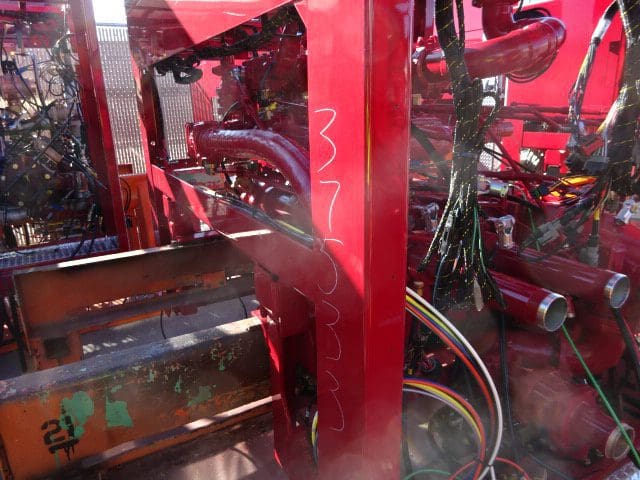

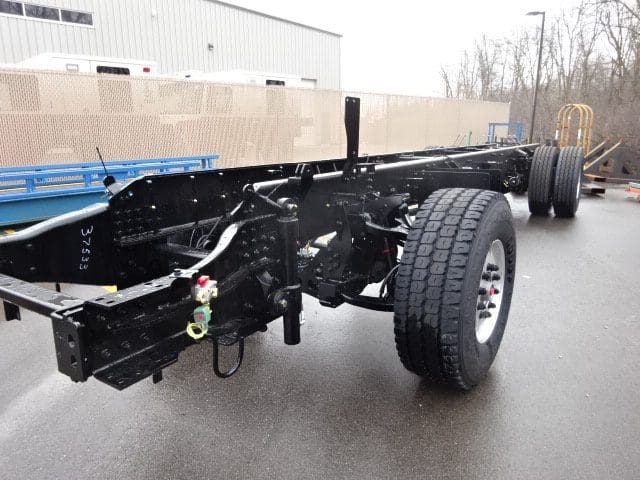

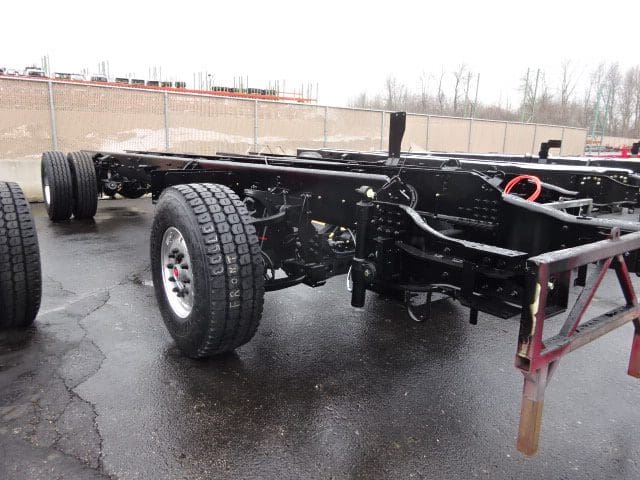

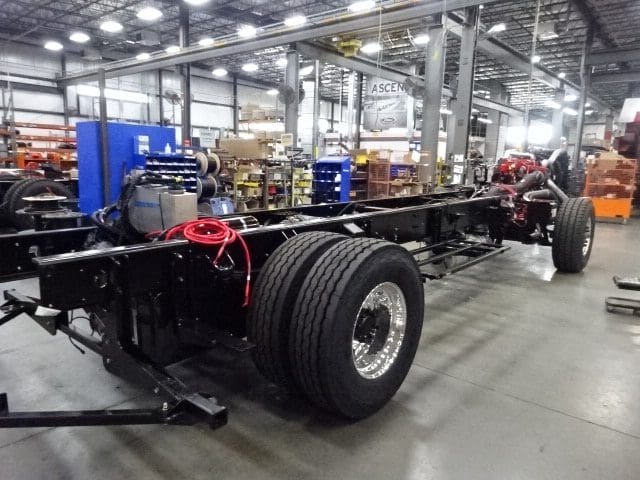

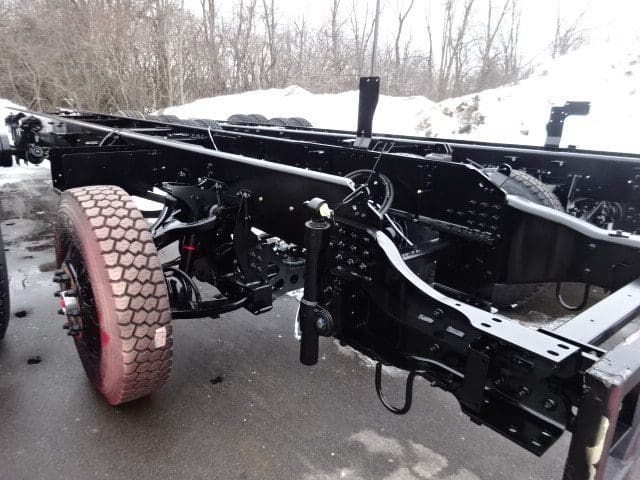

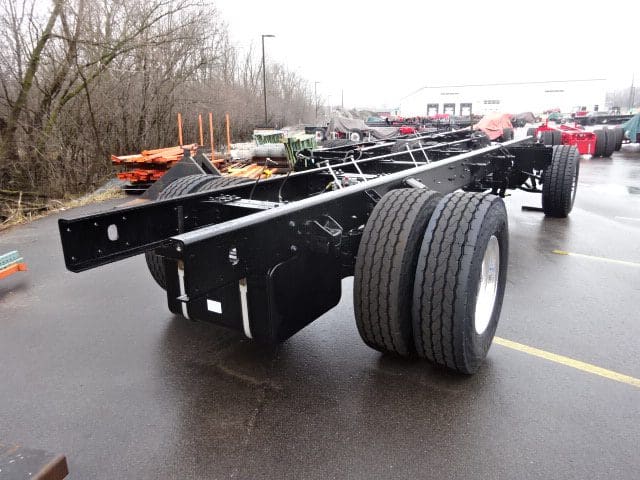

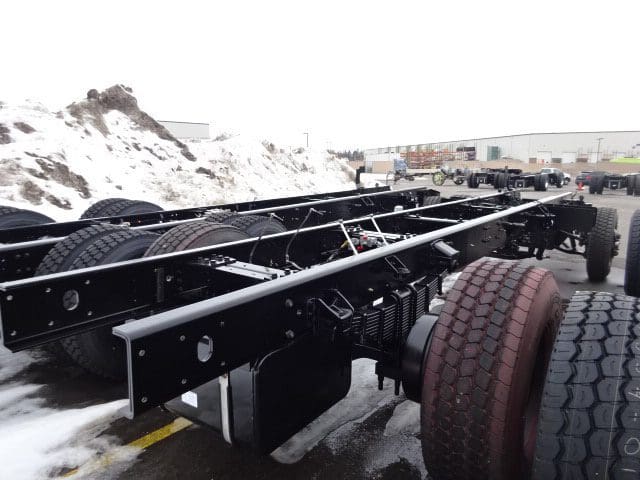

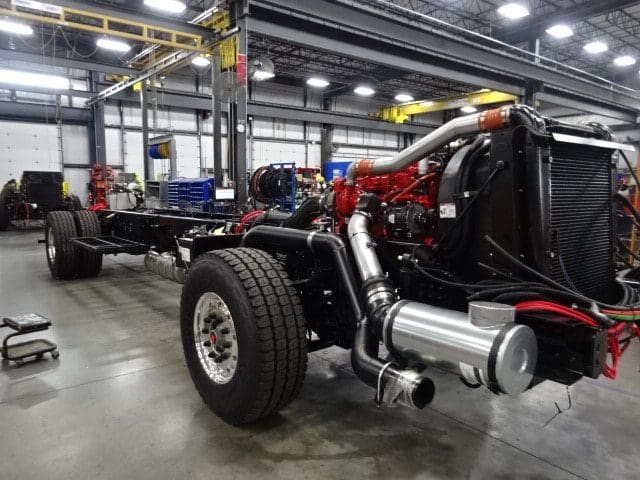

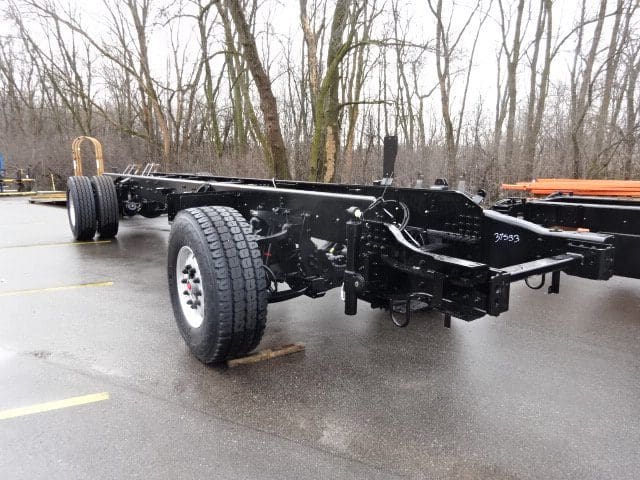

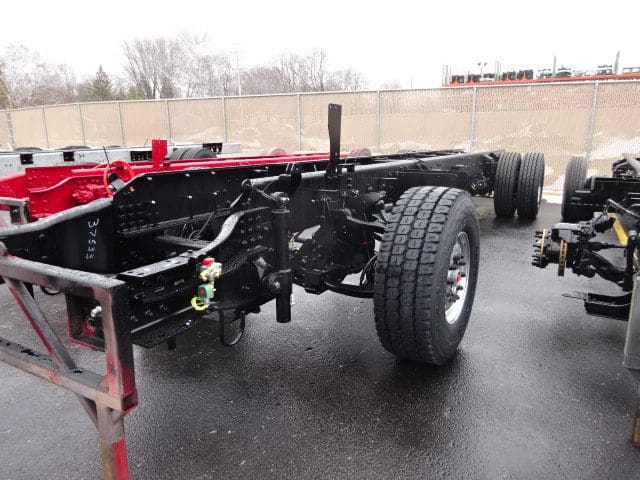

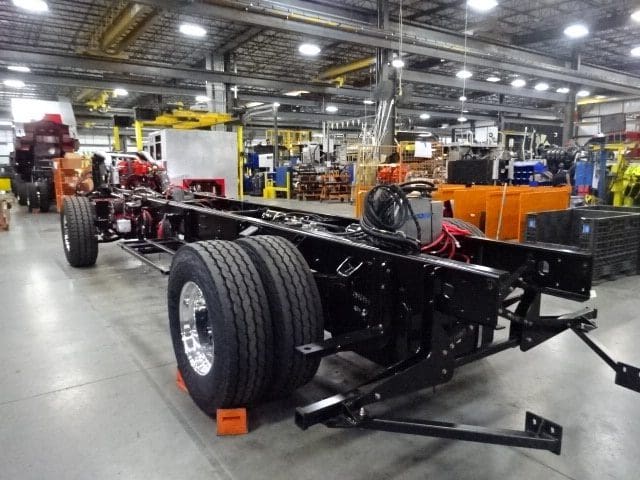

The cab continued the paint process, the frame build began, the pump house began initial assembly, and the body continued fabrication.

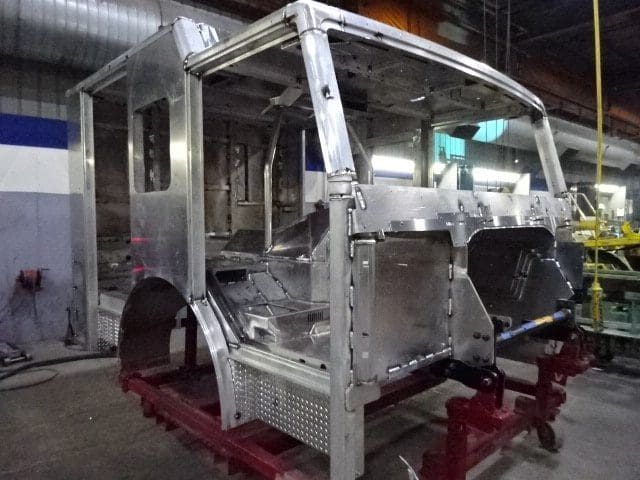

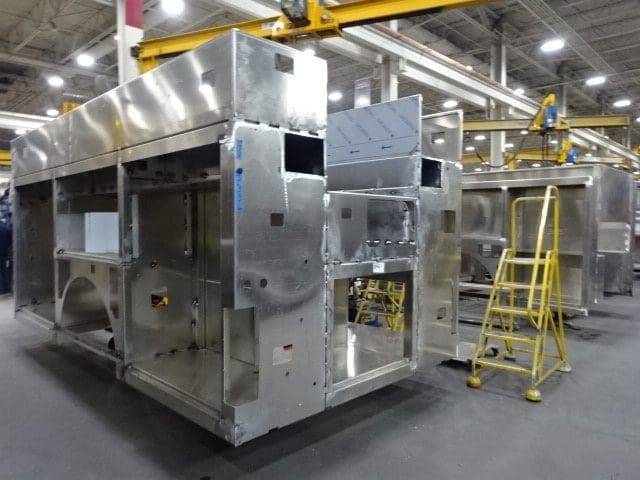

02-17-23

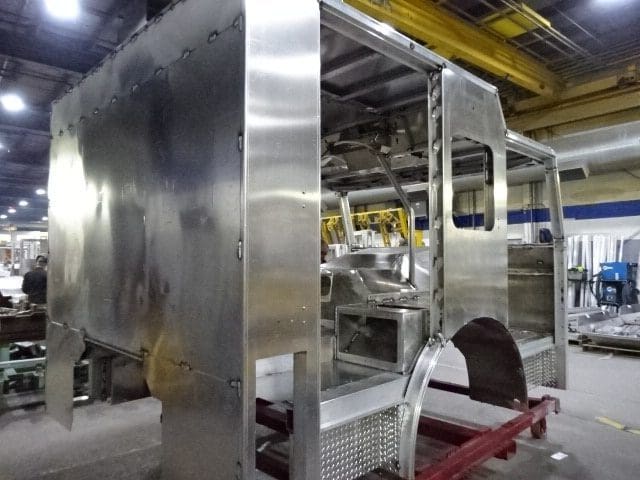

This Pierce apparatus is now in production. In this report, the cab began fabrication
