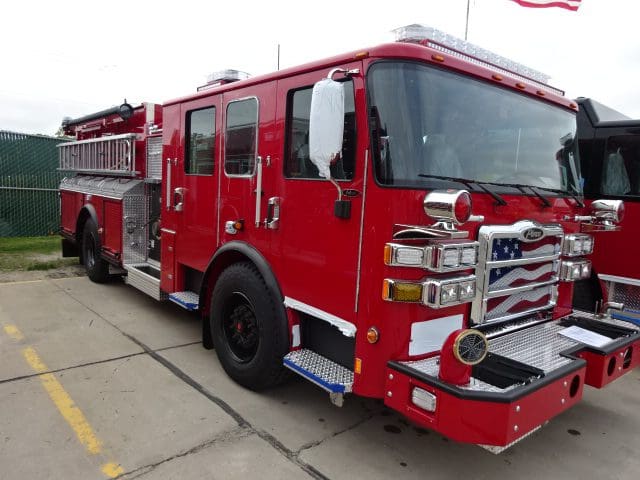

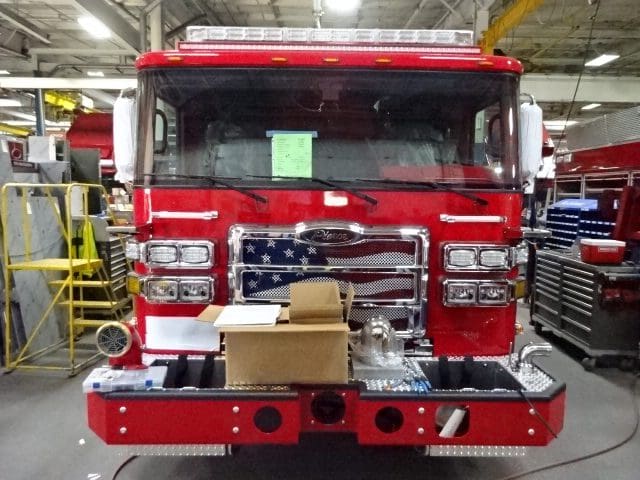

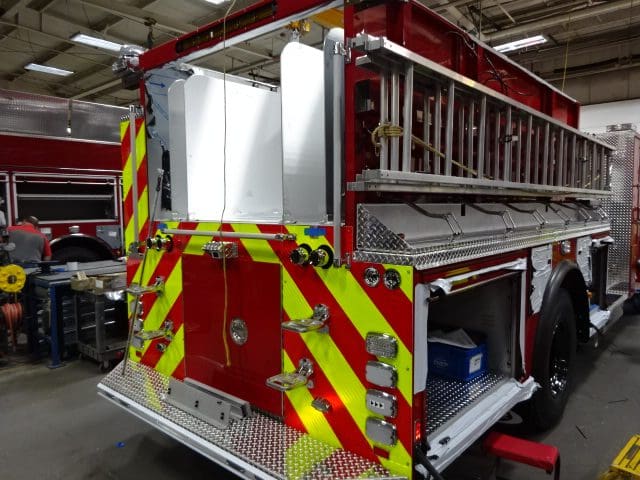

05-26-23

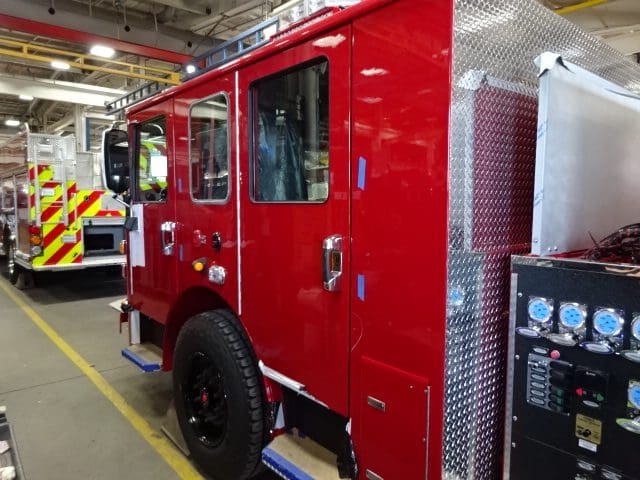

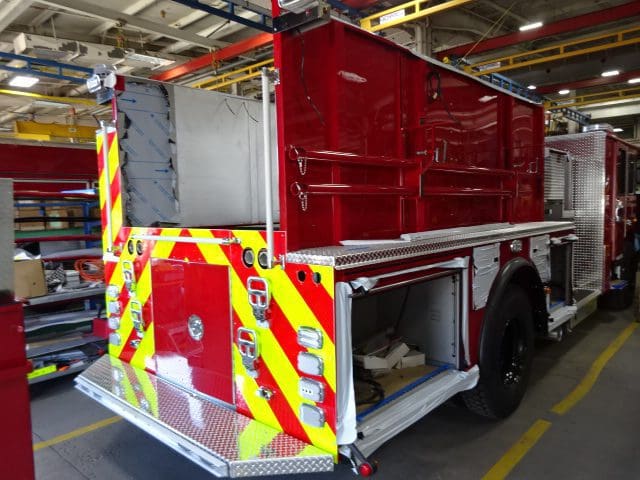

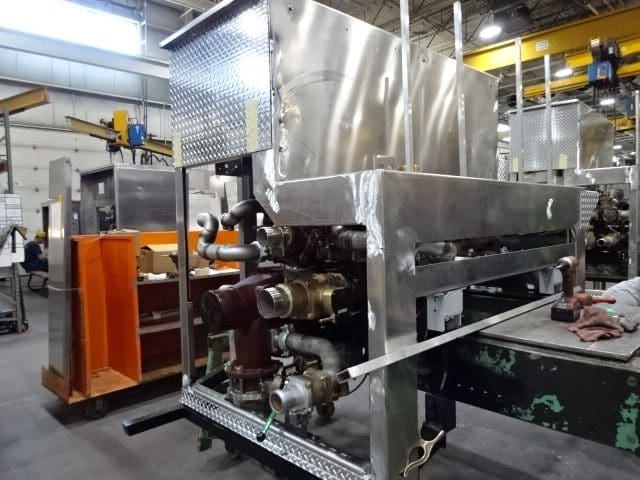

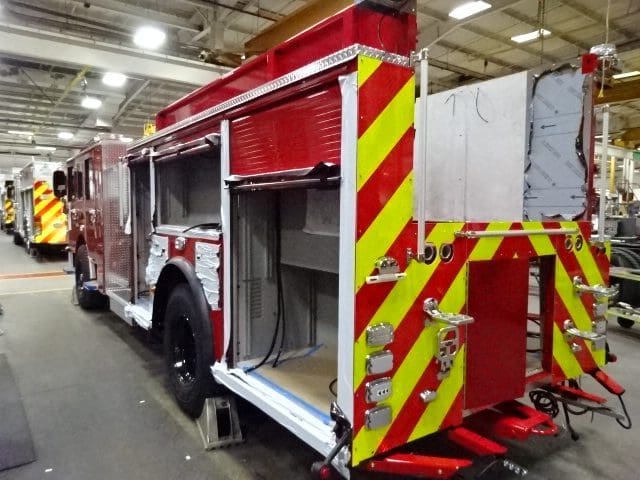

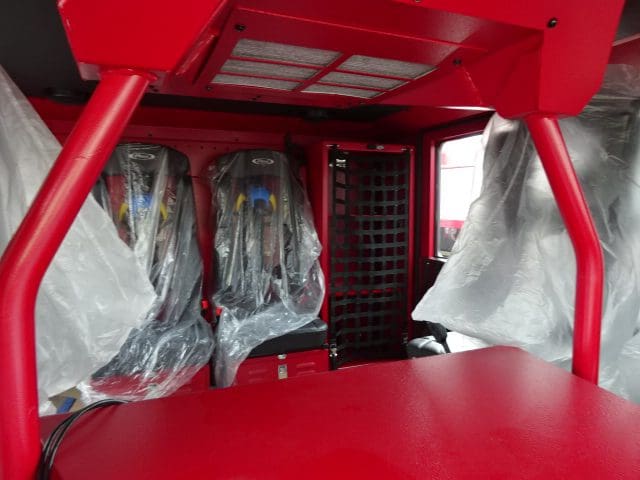

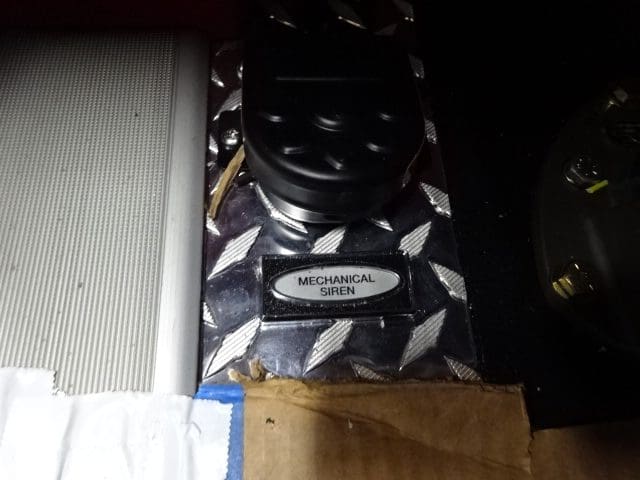

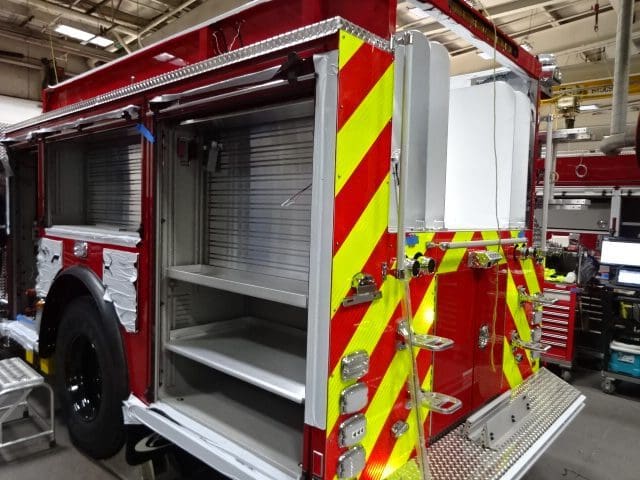

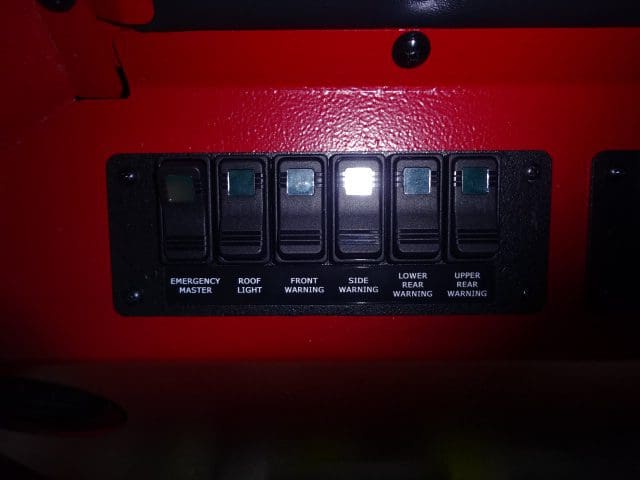

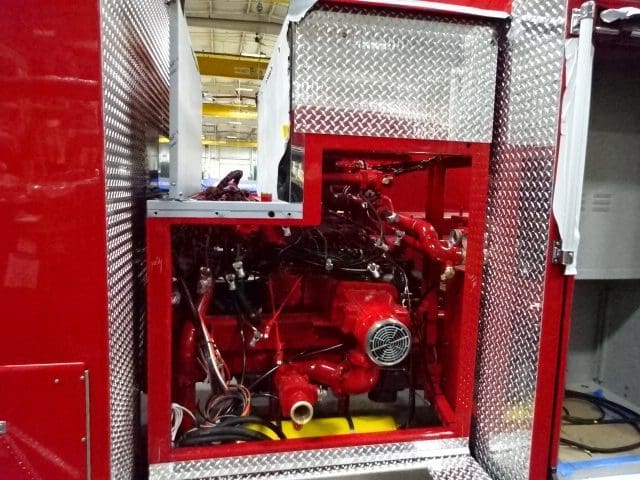

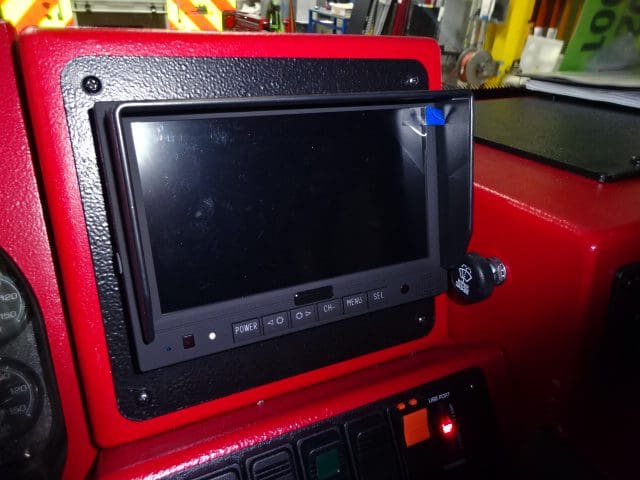

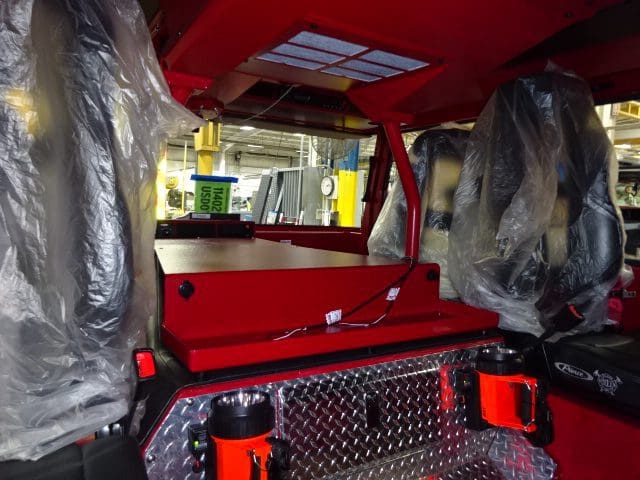

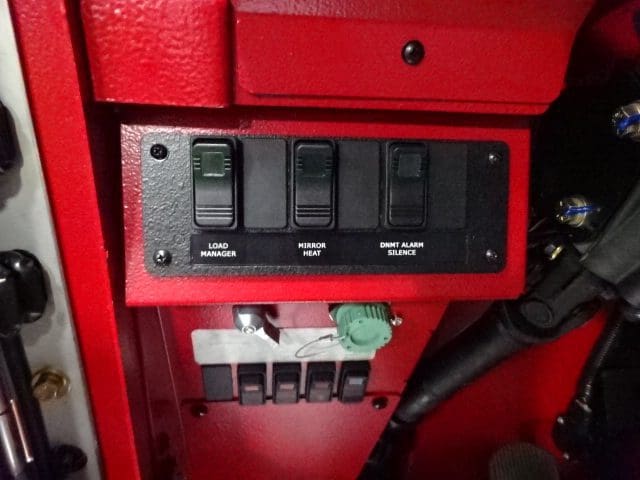

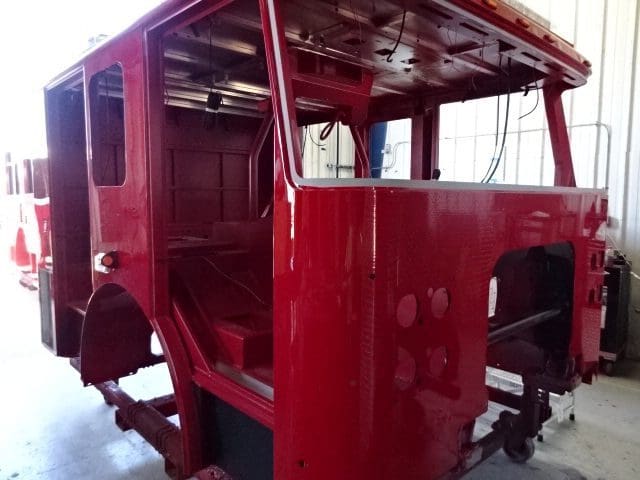

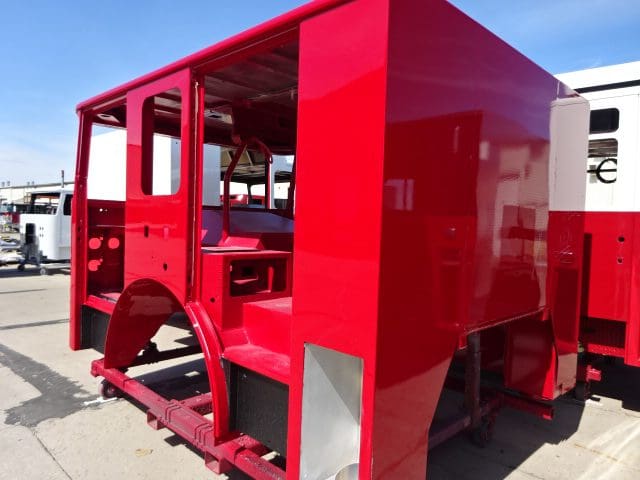

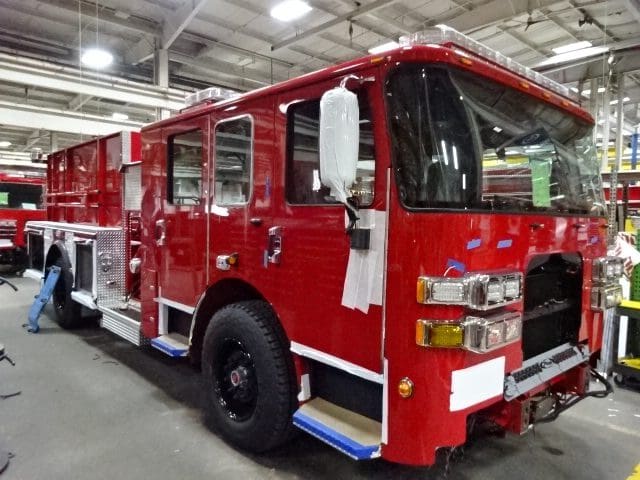

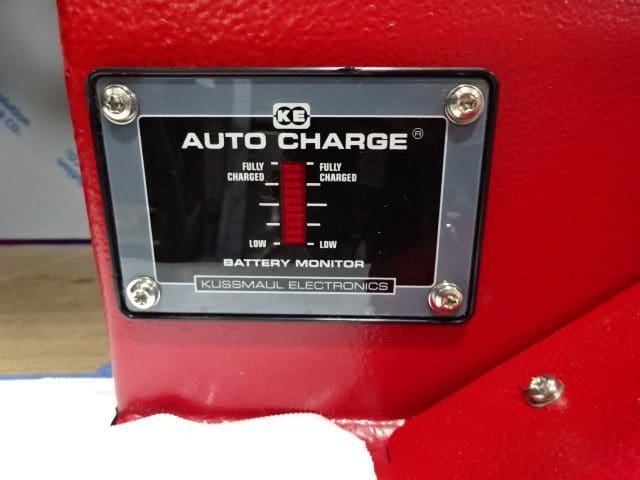

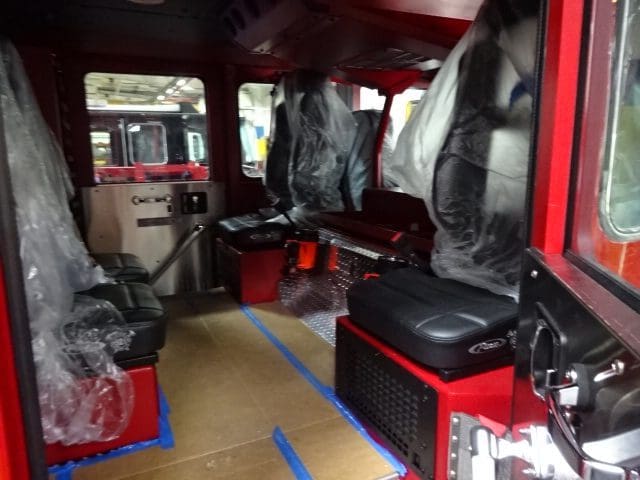

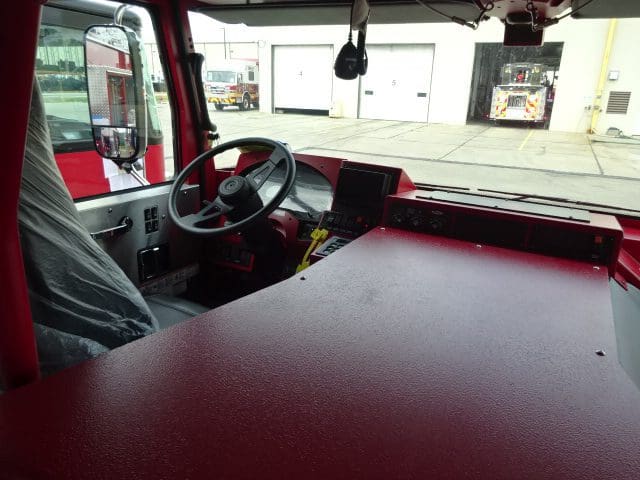

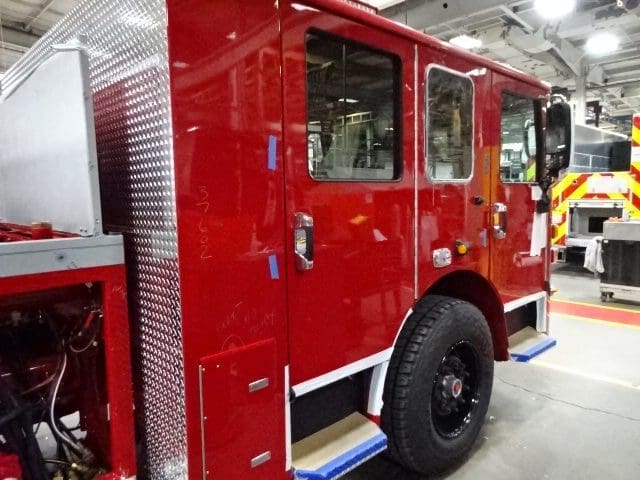

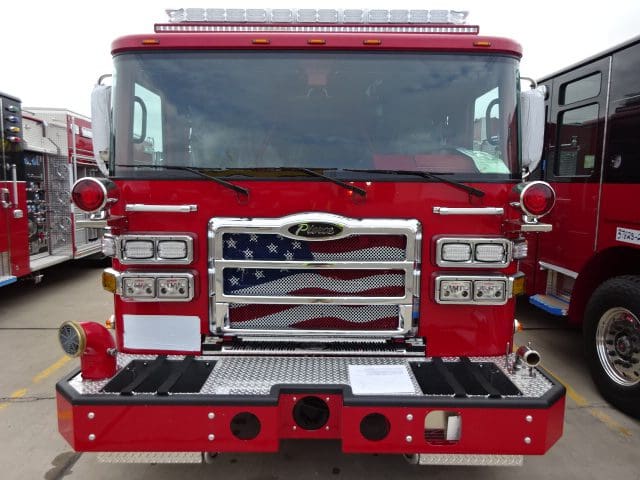

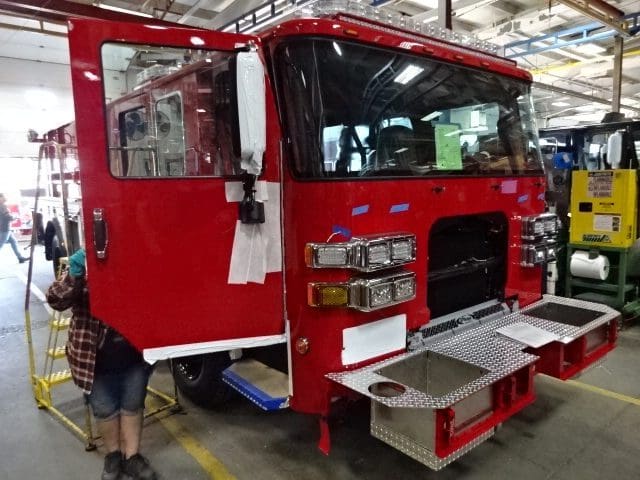

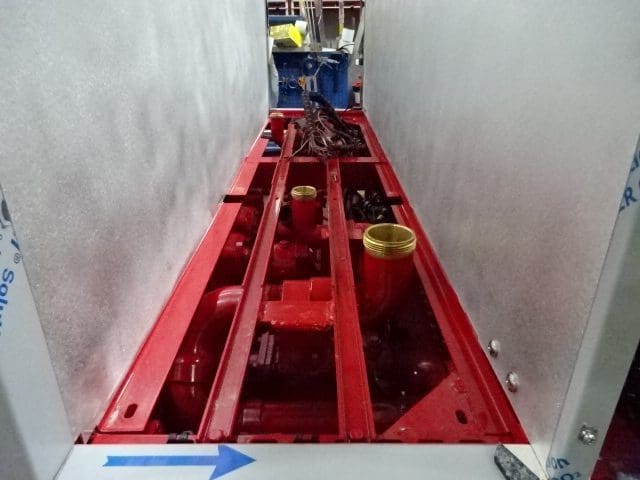

In this report the apparatus completed final assembly and released to test. Once complete, it will release to quality and graphics where any remaining content will be applied. It will then be made ready for final inspection.
05-12-23

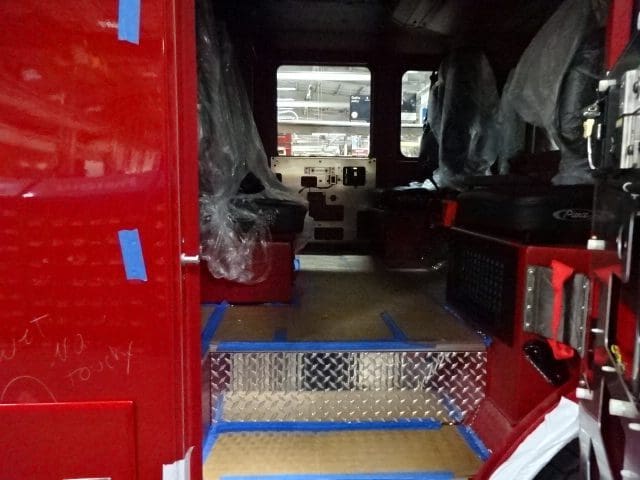

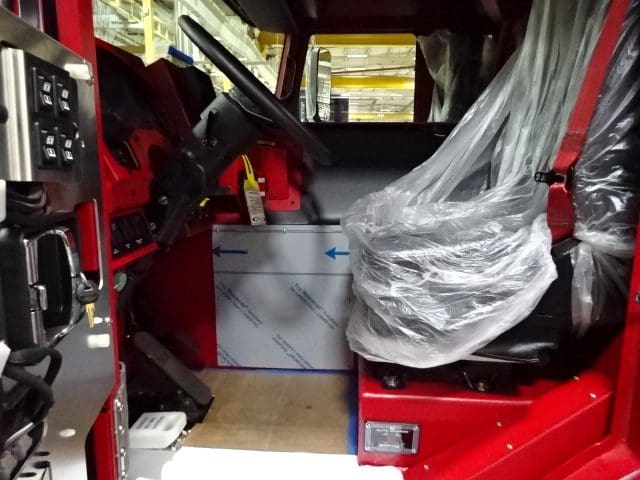

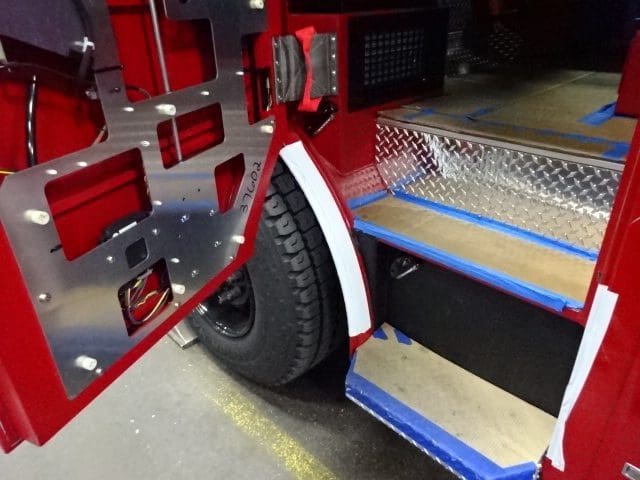

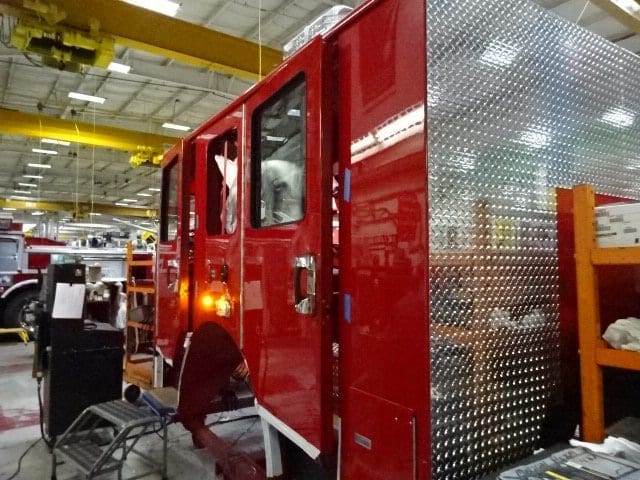

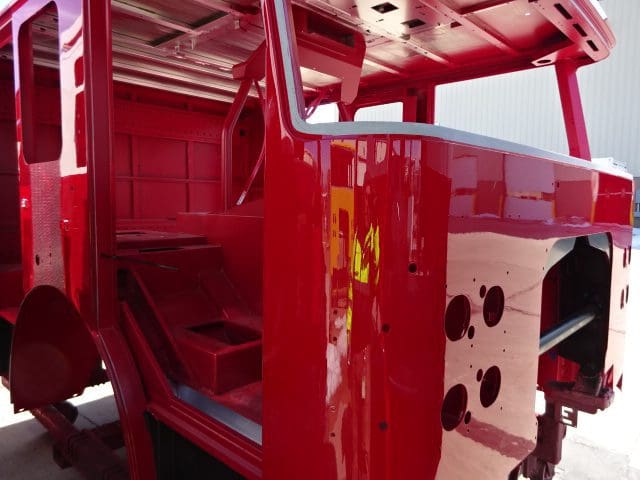

In this report, your apparatus began final assembly. In the next report final assembly may continue.
05-05-23

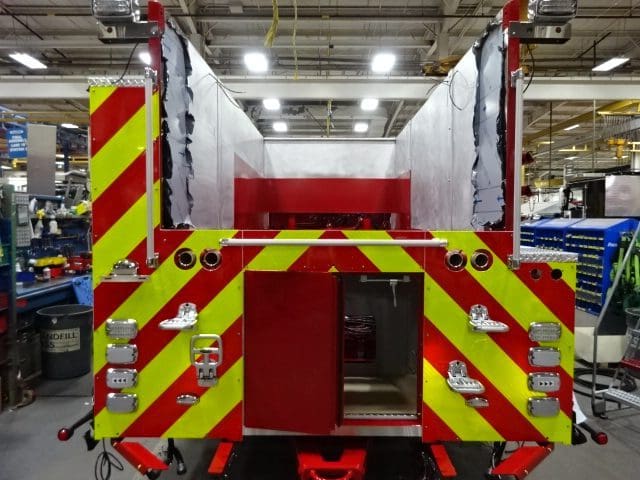

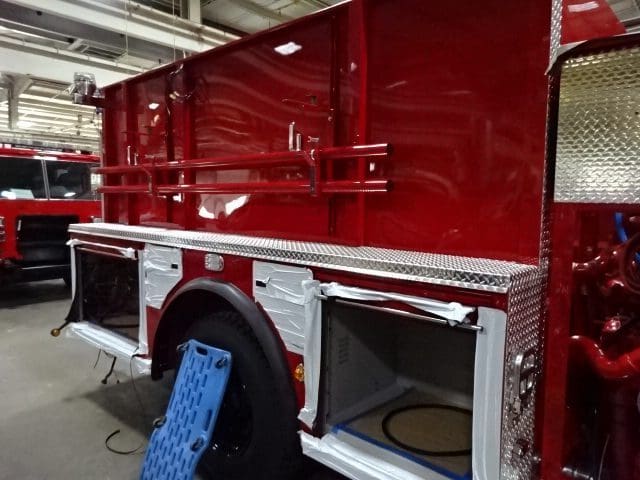

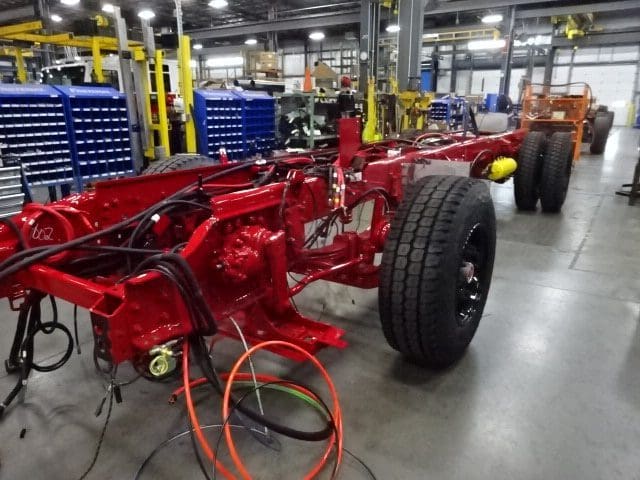

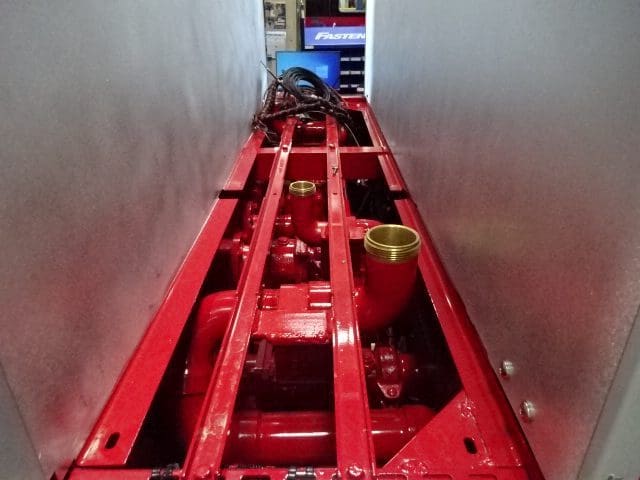

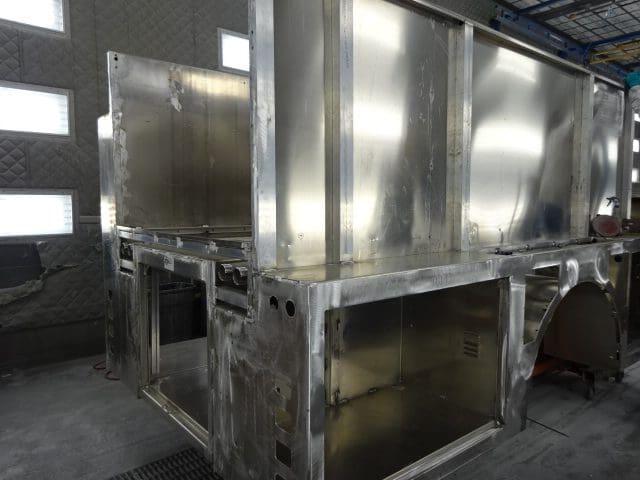

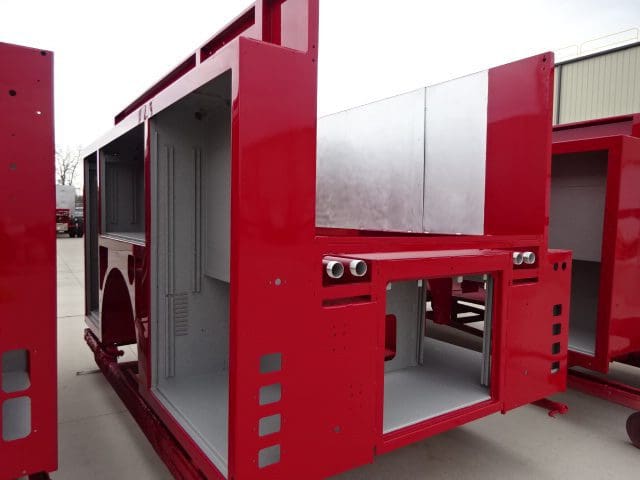

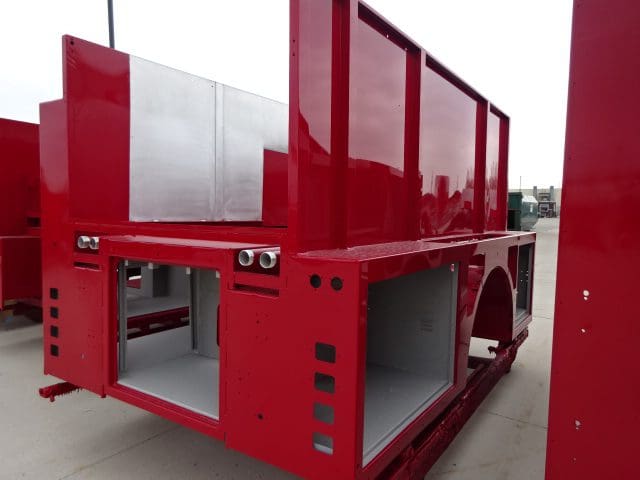

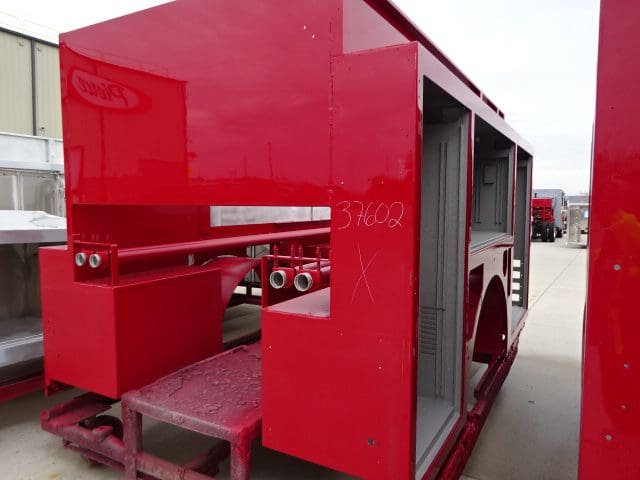

The cab, pump house, and body were installed on the frame while assembly continued.
04-28-23
The cab made progress through initial assembly and was staged, the frame build continued, and the pump house and body remained staged.
04-21-23
The cab continued initial assembly, the frame build continued, and the pump house and body remained staged.
04-14-23

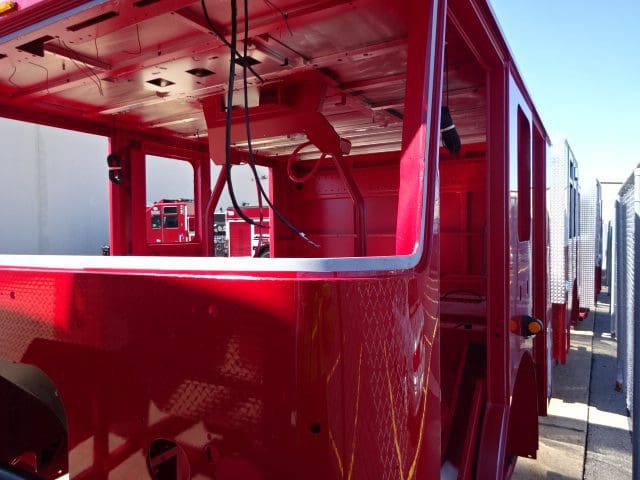

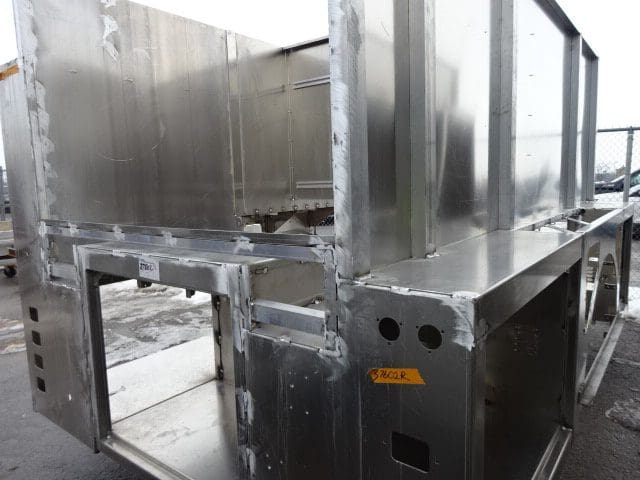

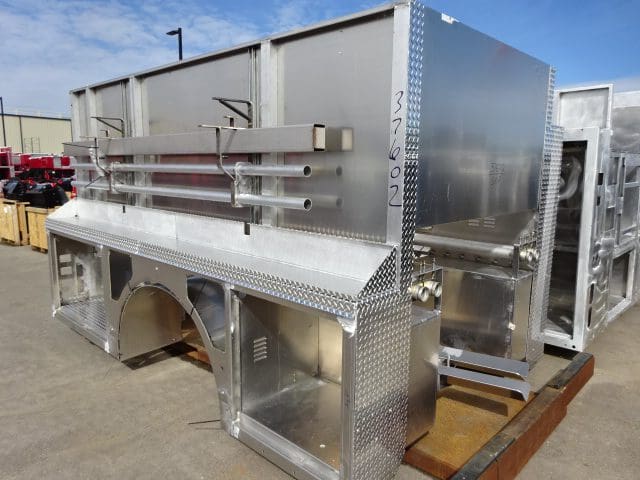

The cab continued initial assembly, the frame build continued, the pump house completed initial assembly and was staged, and your body made progress through paint and was staged.
04-07-23

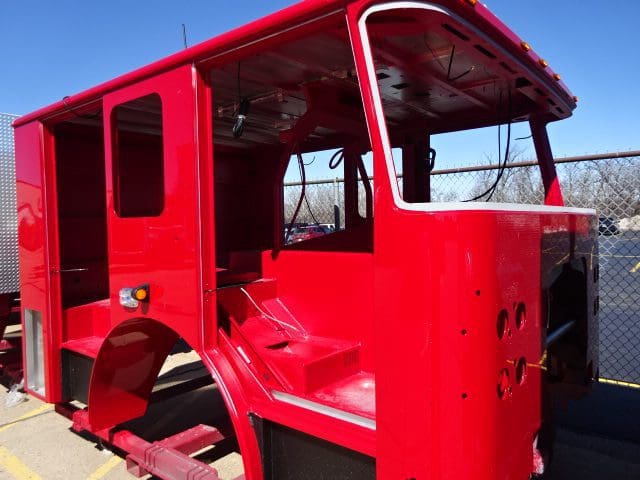

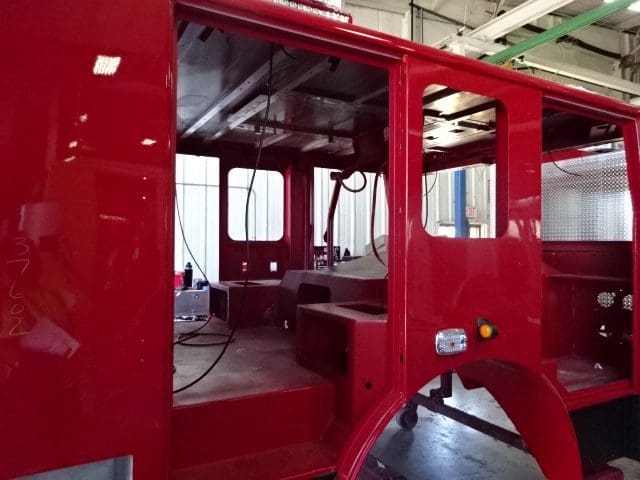

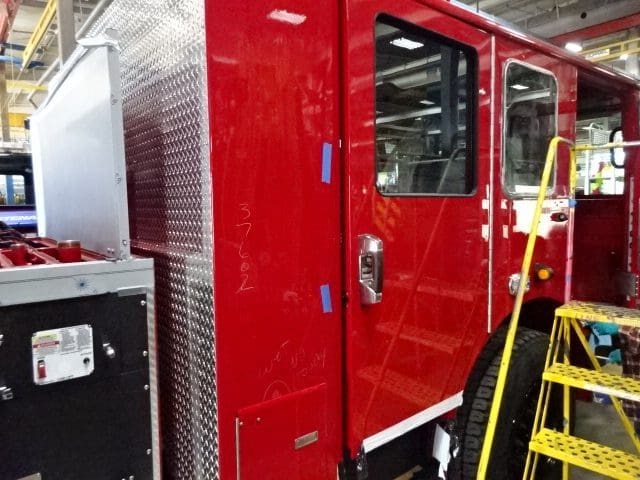

The cab began initial assembly, the frame build continued, the pump house remained staged, and the body continued the paint process
03-31-23

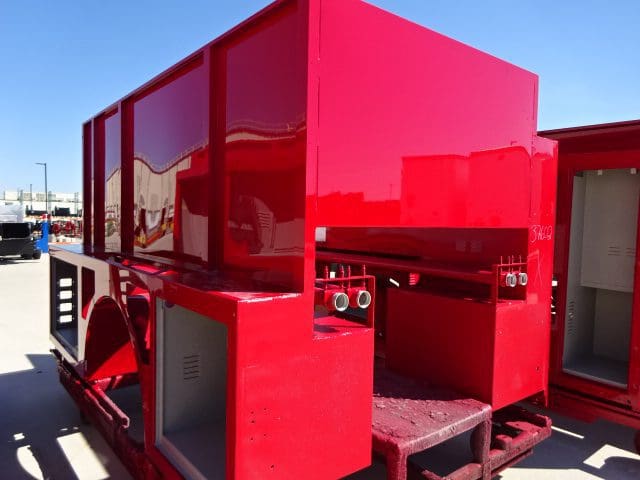

The cab was staged, the frame build

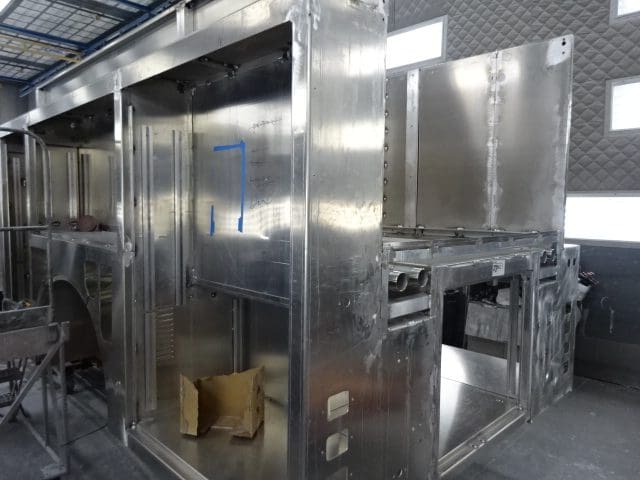

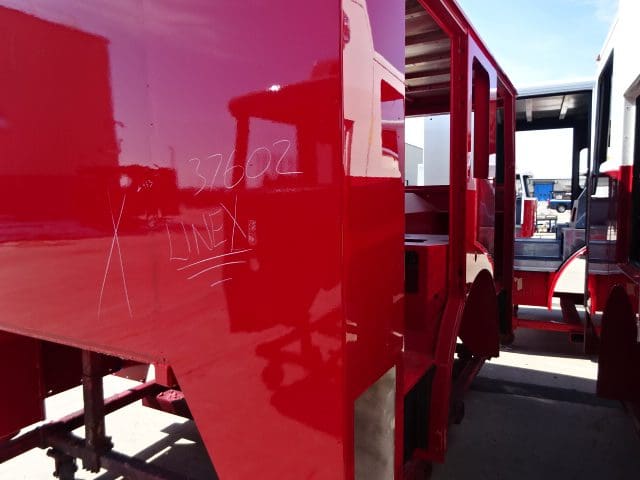

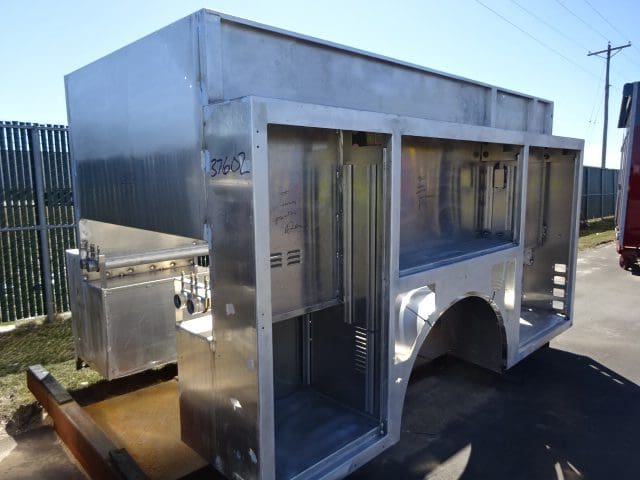

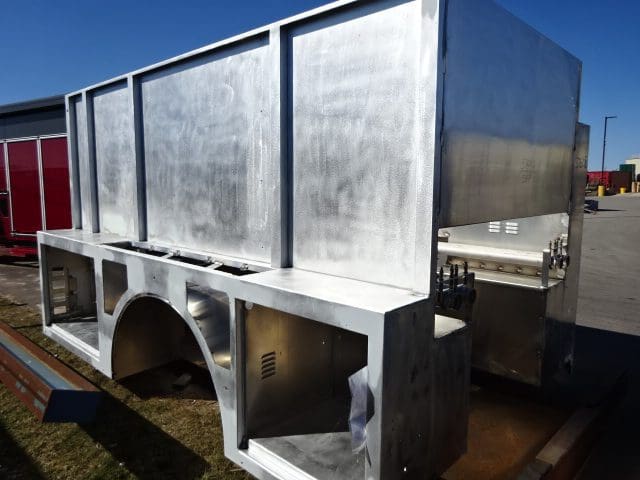

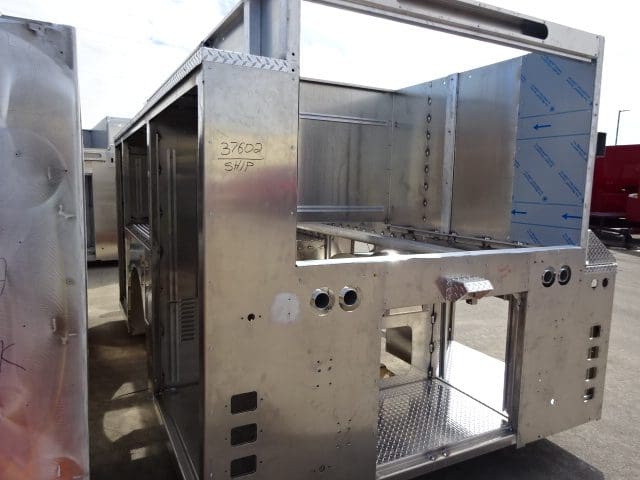

continued, the pump house was painted, and the body completed began the paint process.
03-24-23

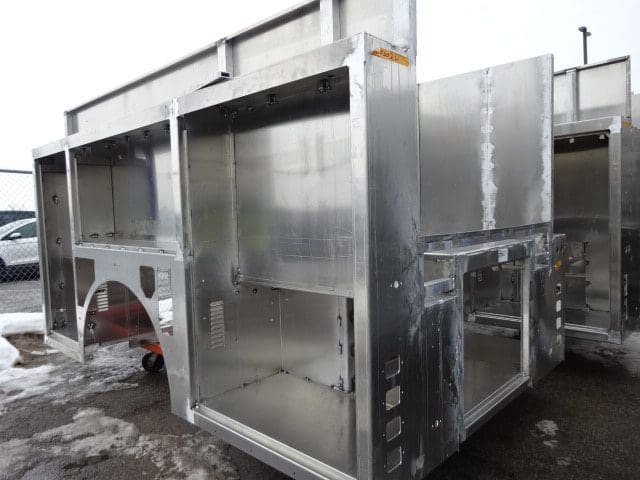

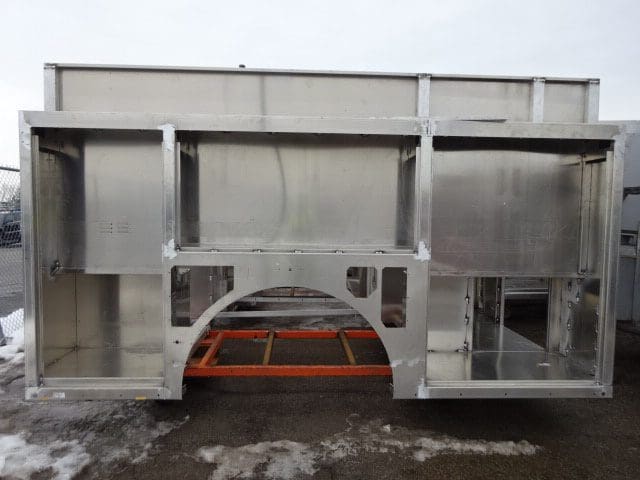

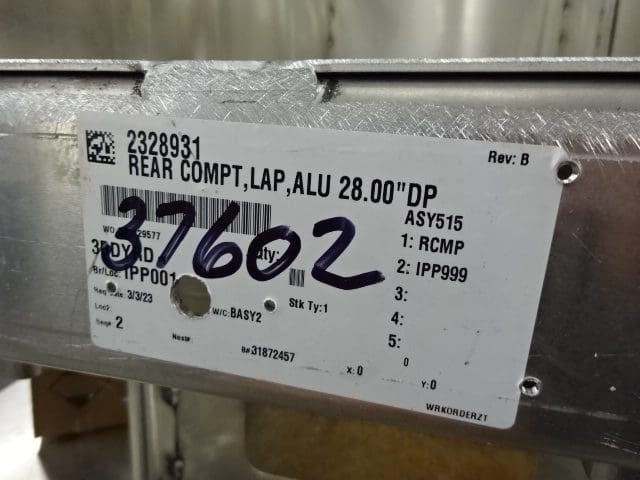

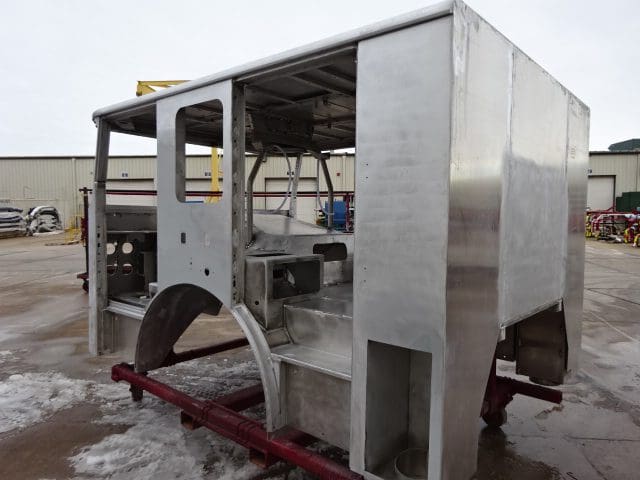

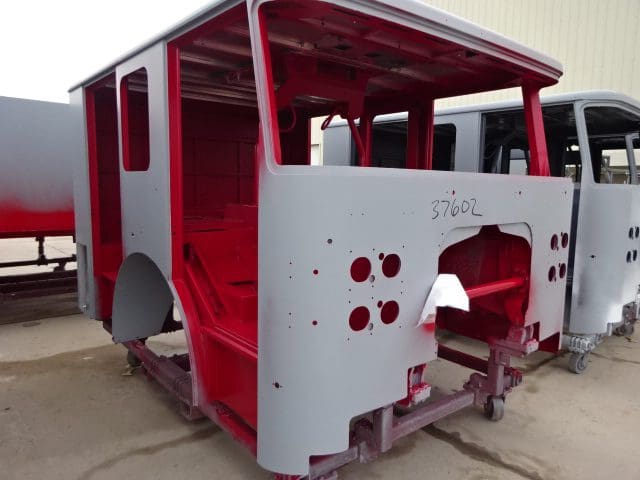

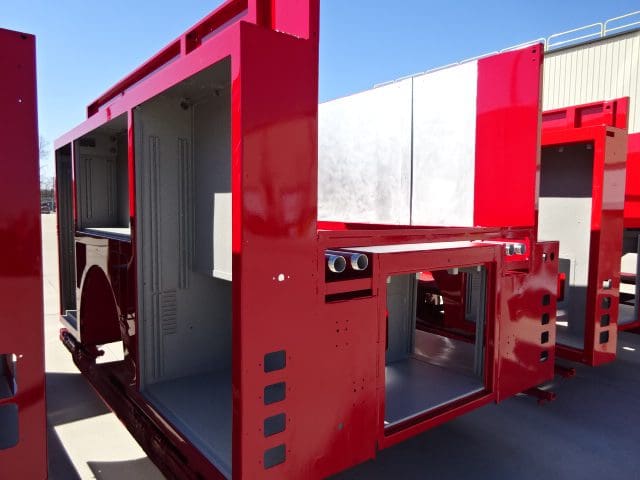

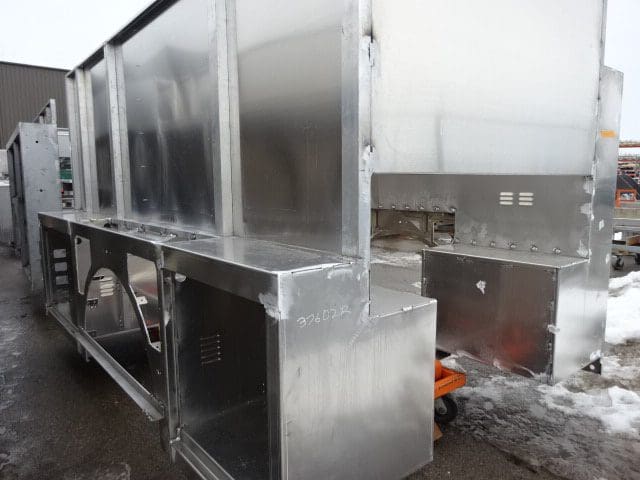

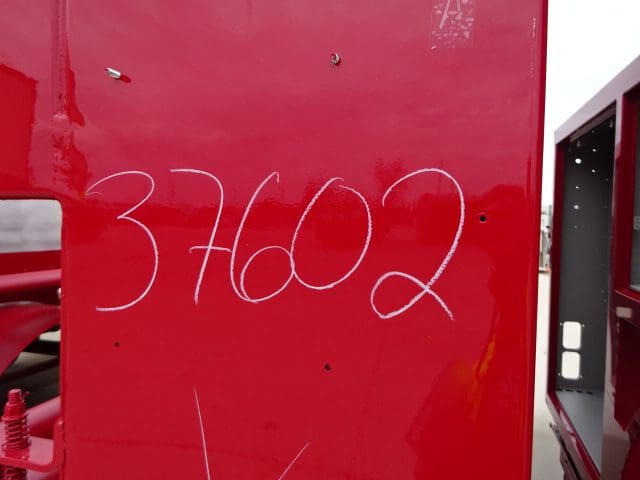

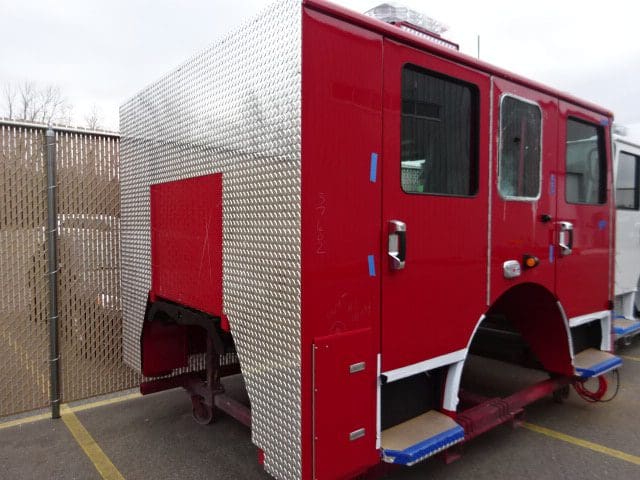

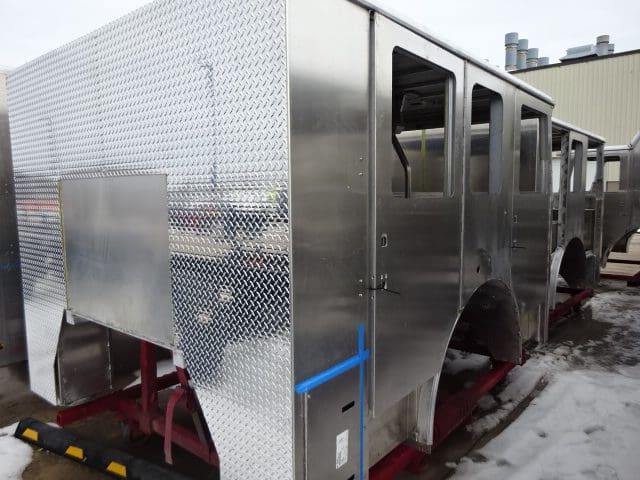

The cab was having protective coating applied (no photos), the frame build continued, the pump house began initial assembly, and the body completed fabrication and was staged
03-17-23

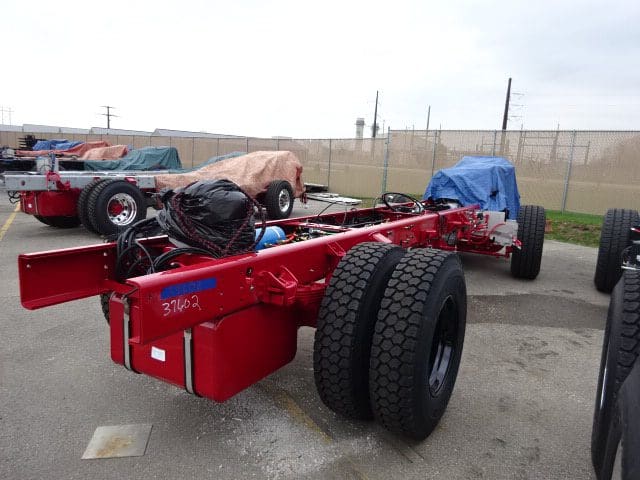

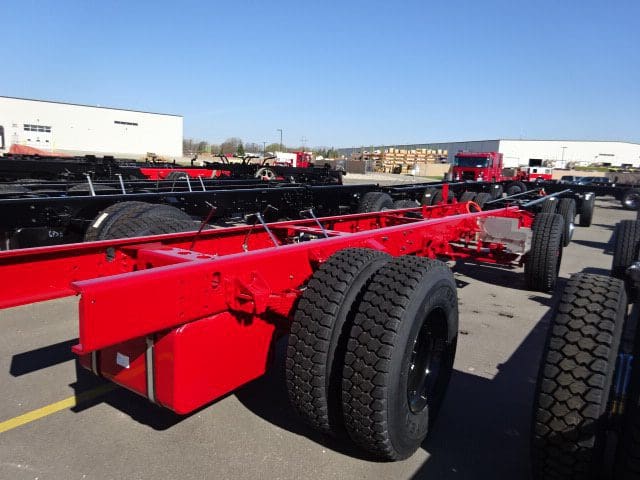

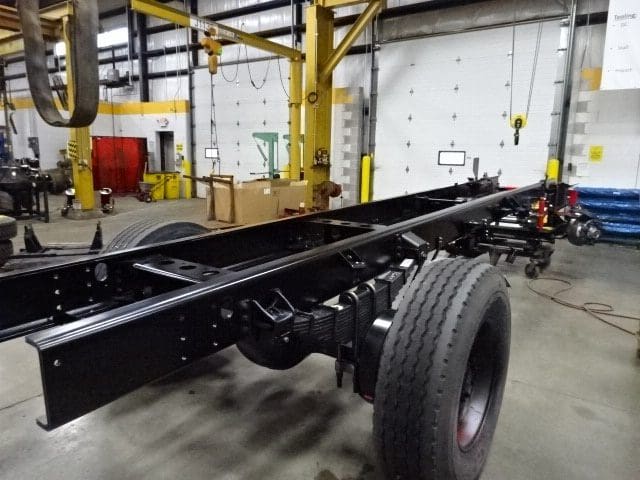

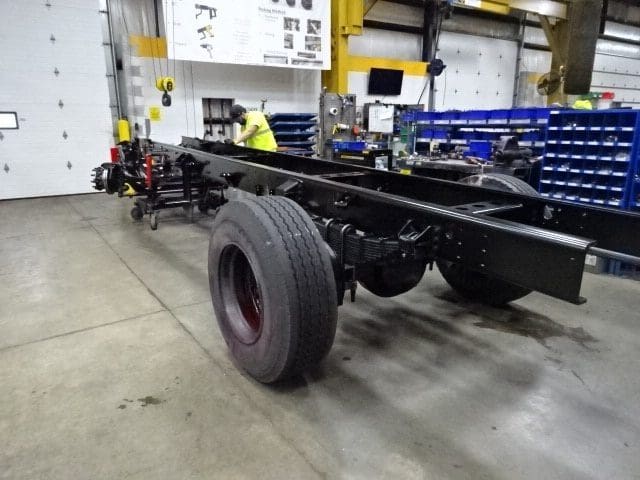

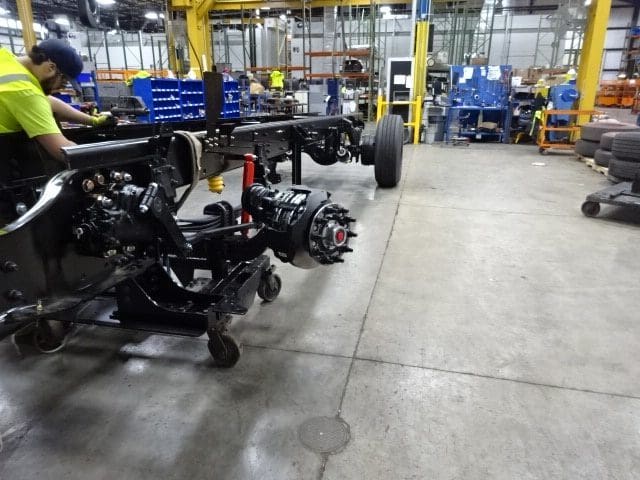

The cab continued through paint, the frame build began, and the body began fabrication.
03-03-23

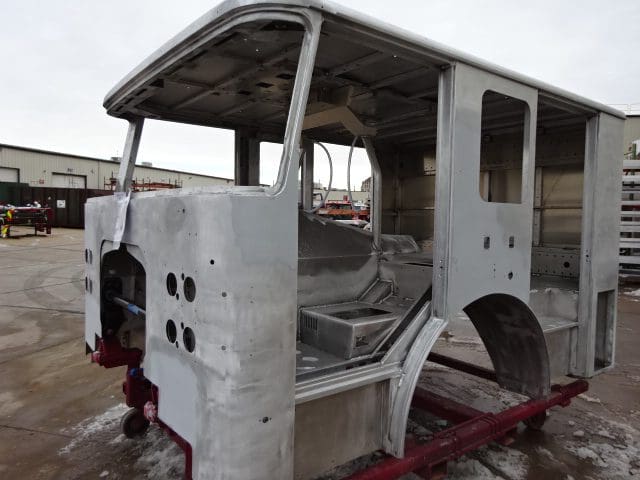

This Pierce apparatus is now in production. In this report, the cab was fabricated and staged.
