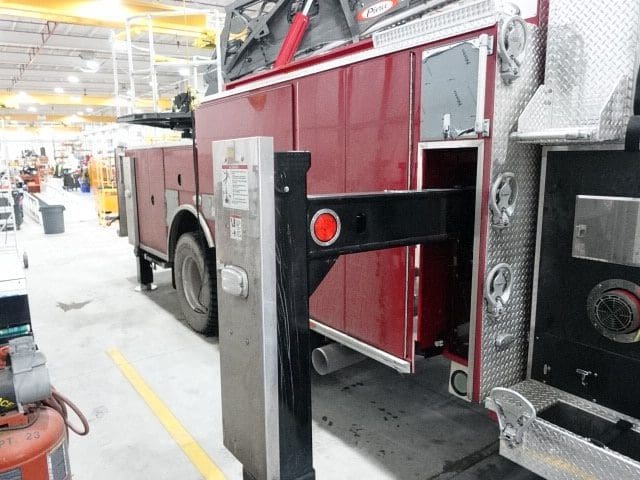

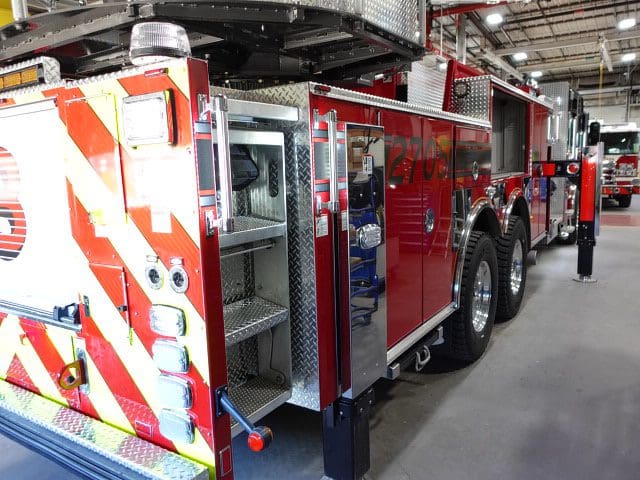

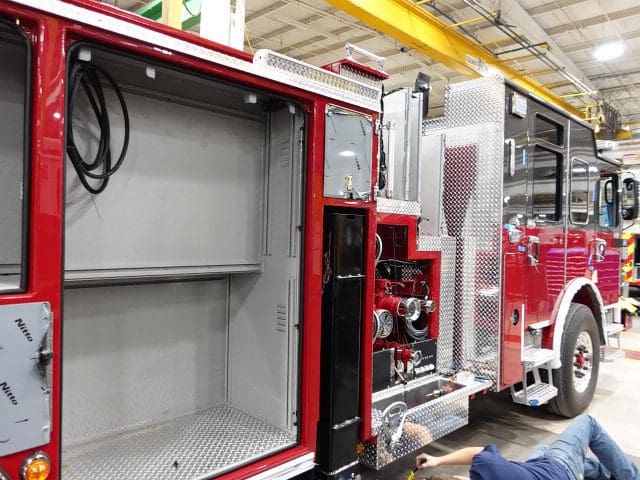

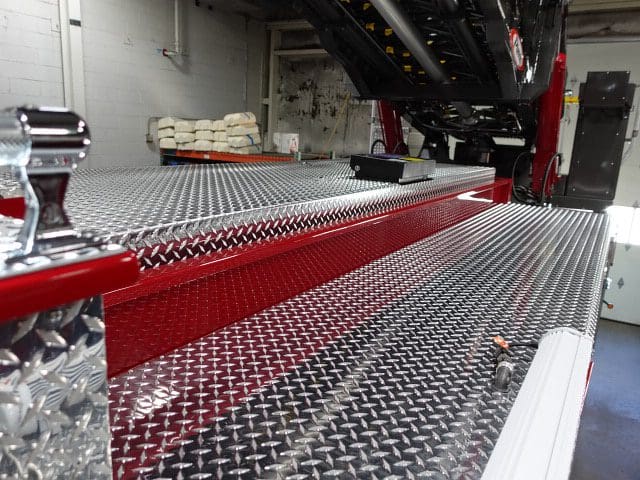

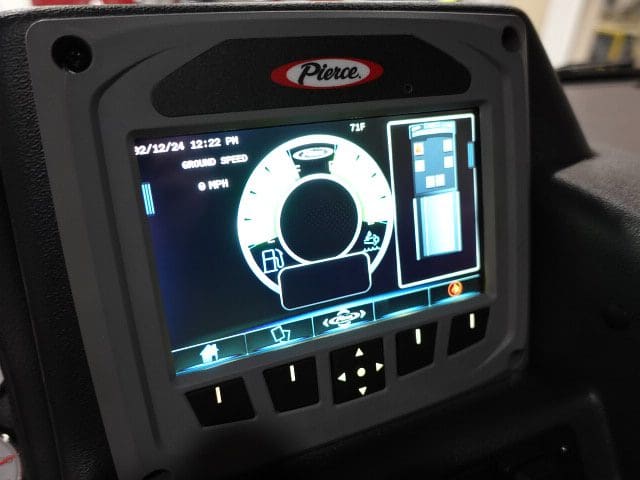

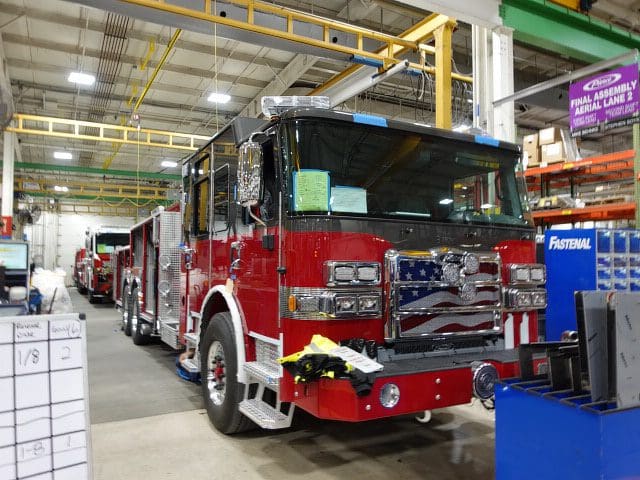

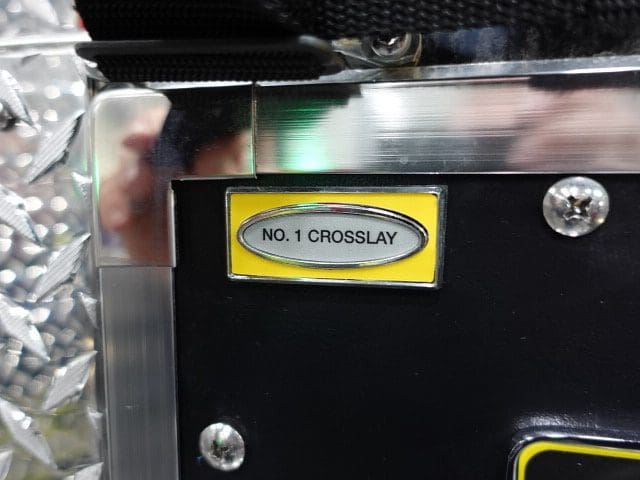

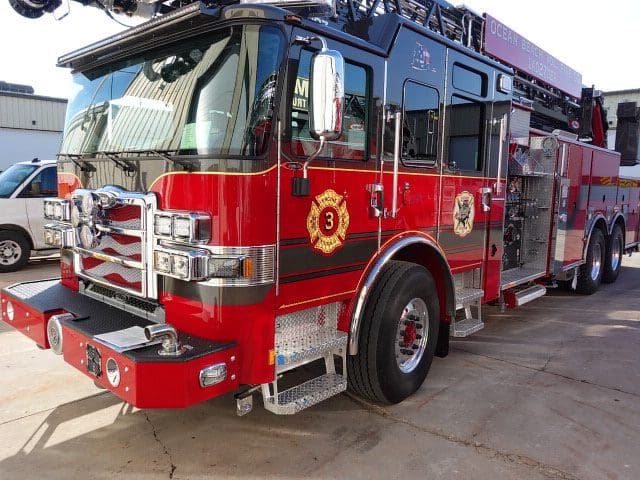

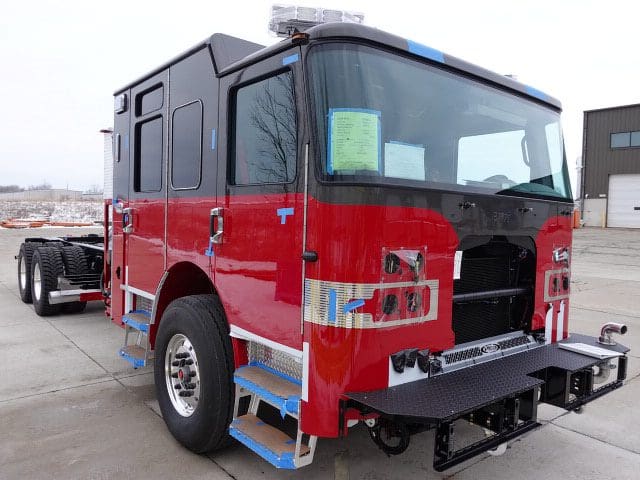

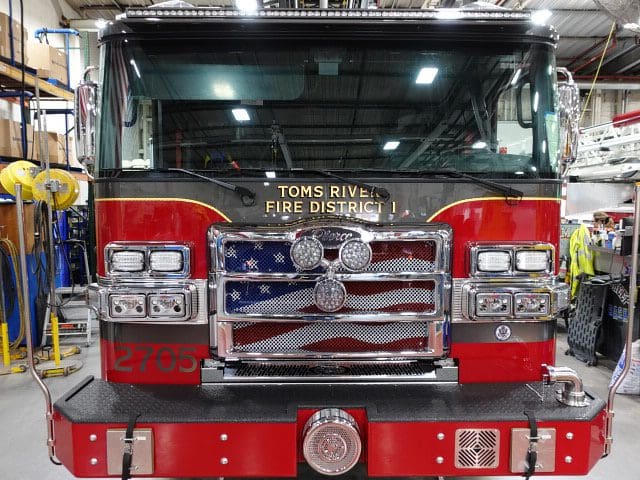

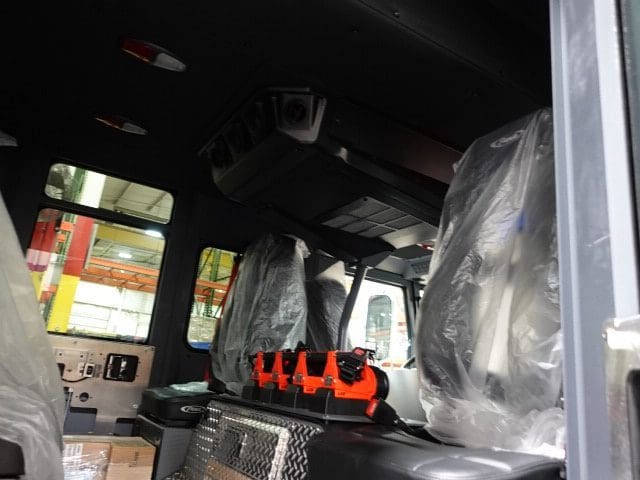

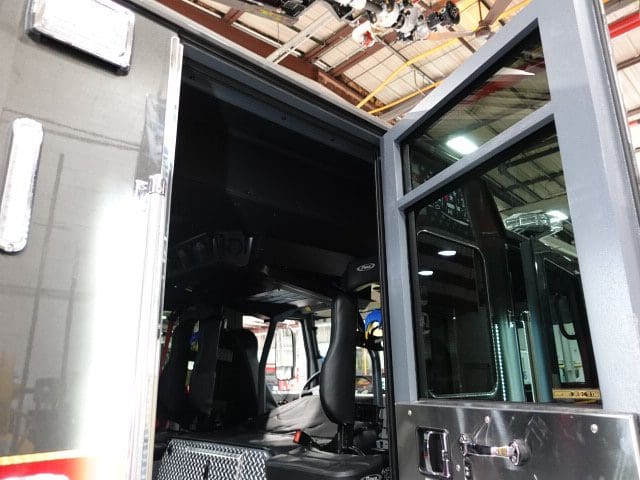

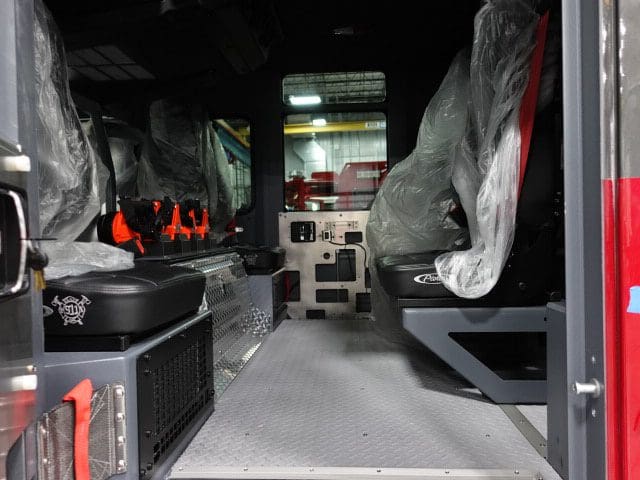

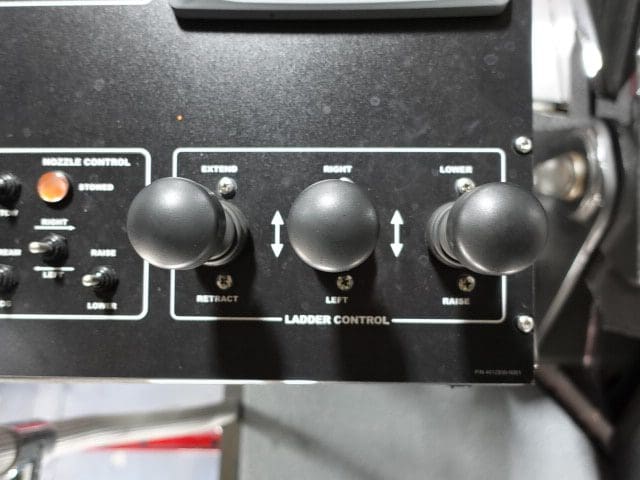

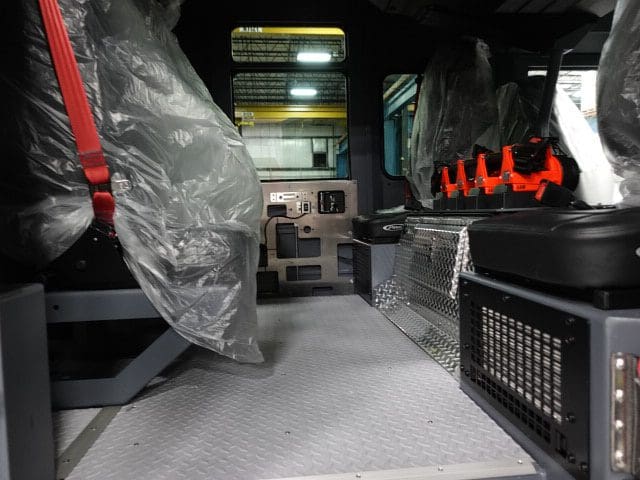

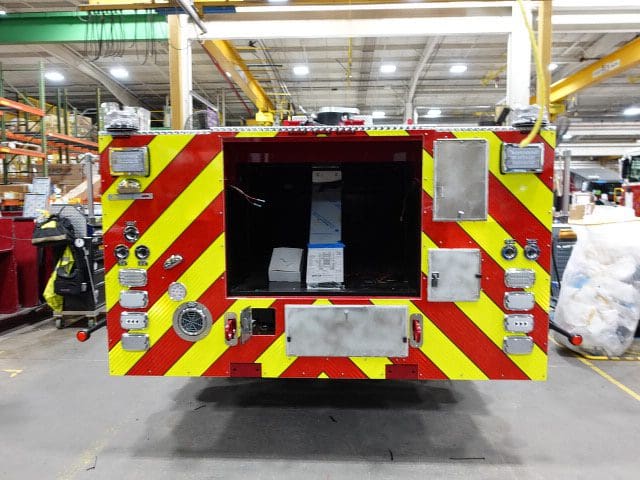

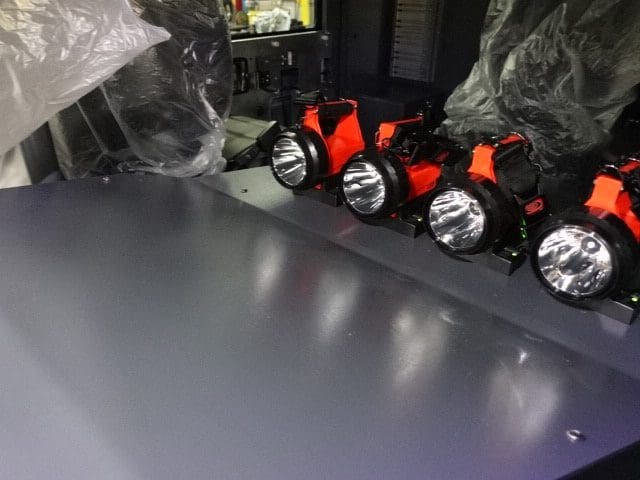

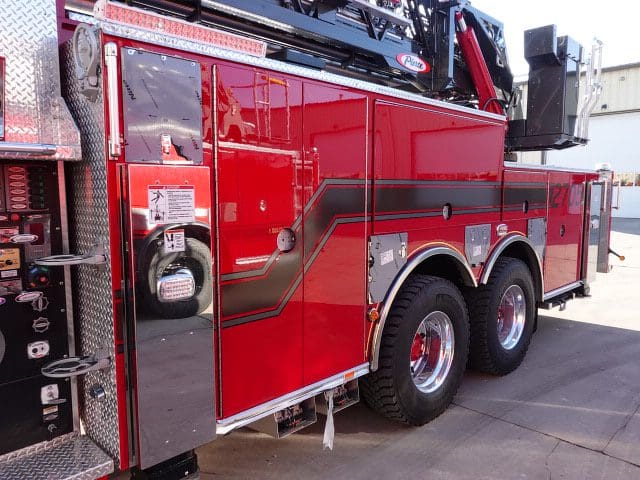

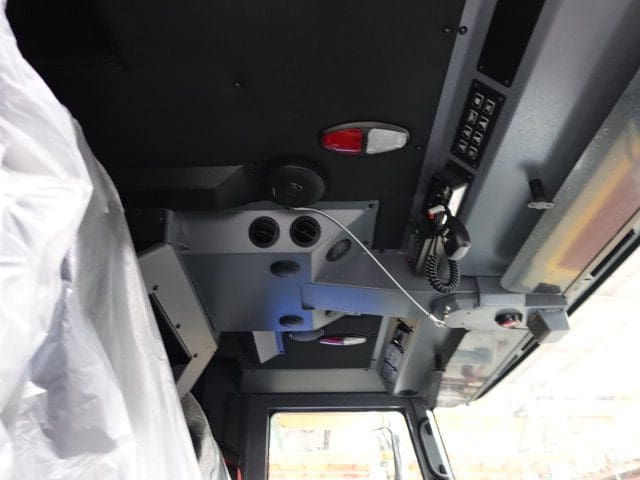

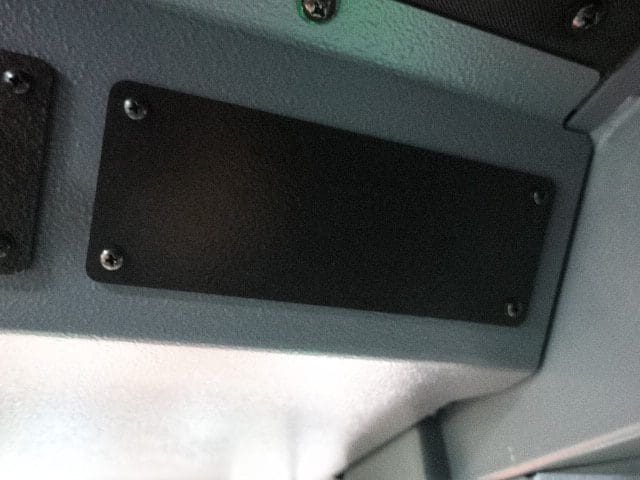

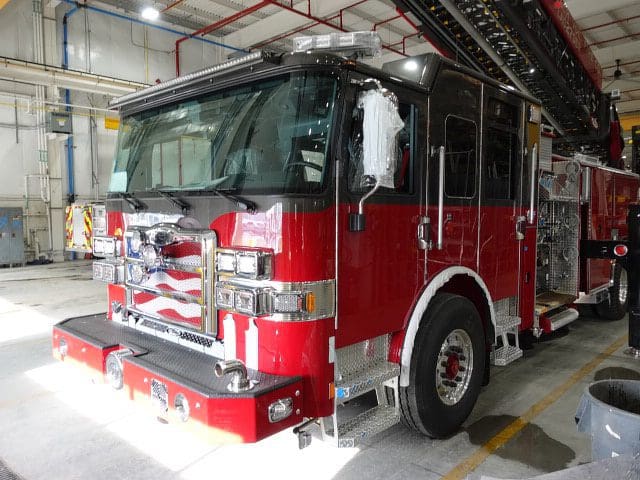

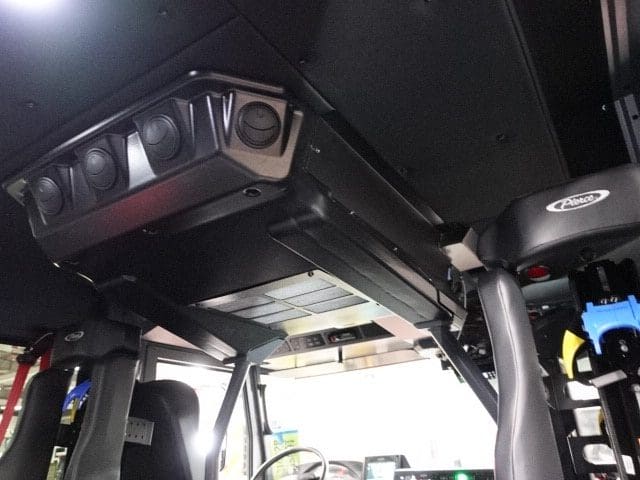

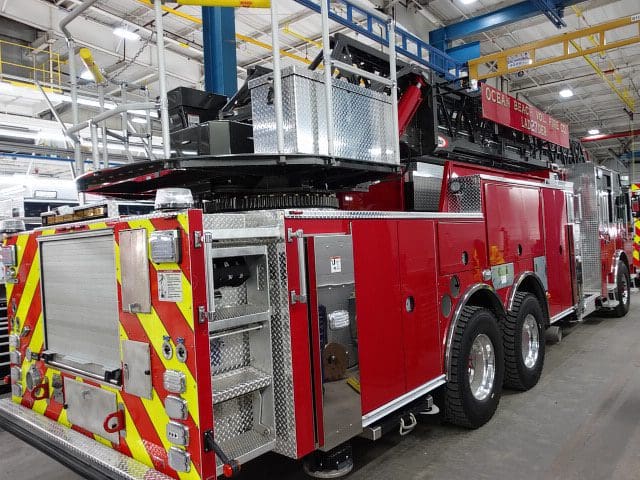

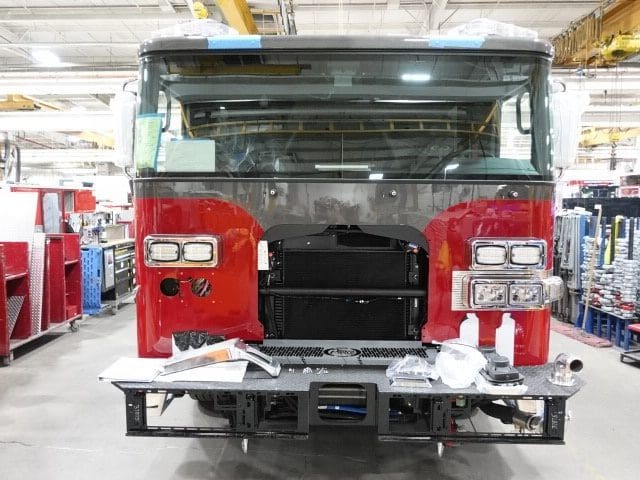

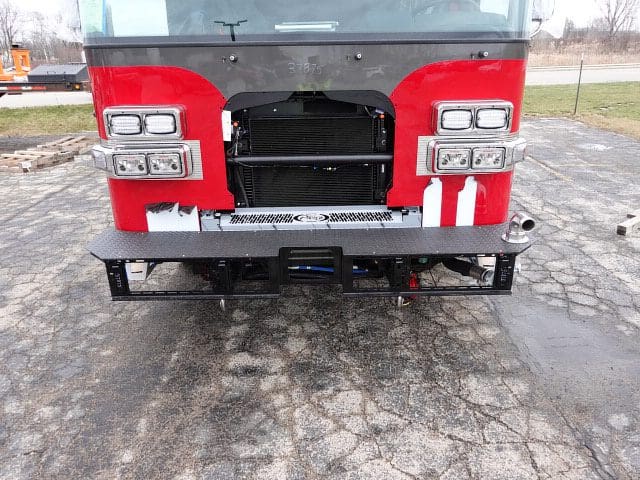

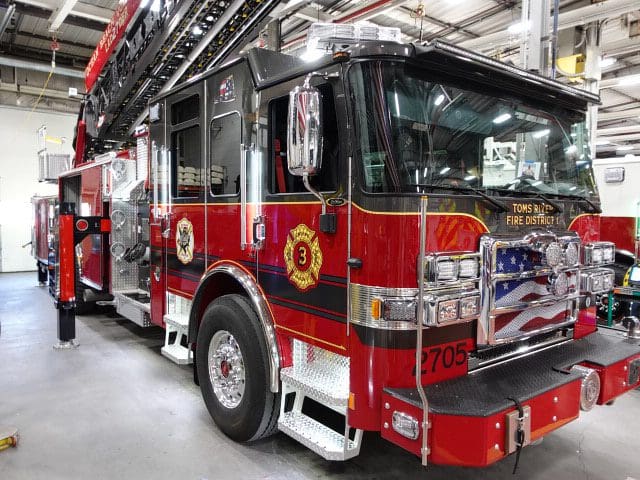

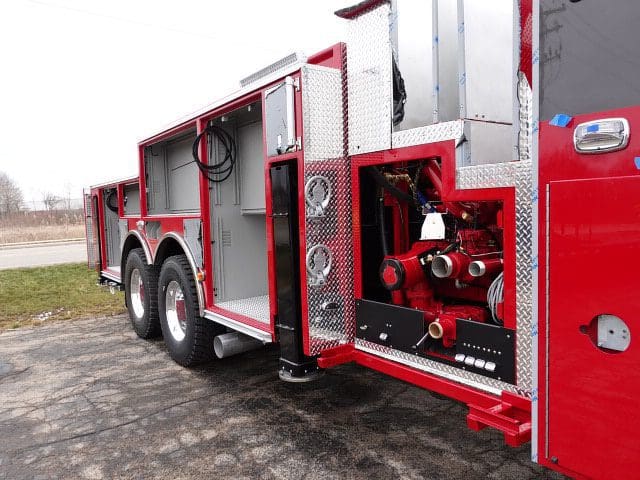

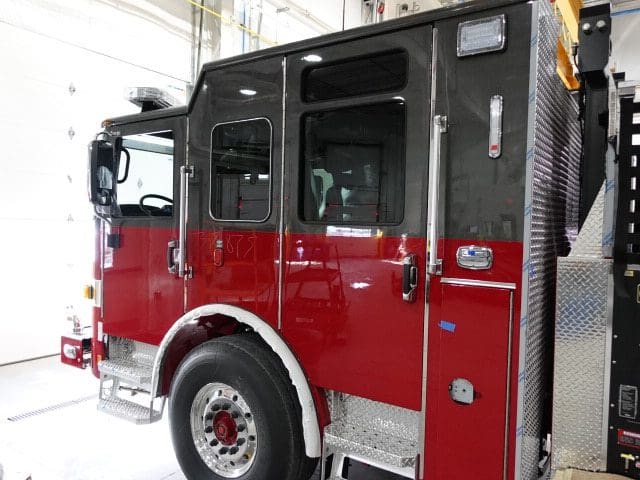

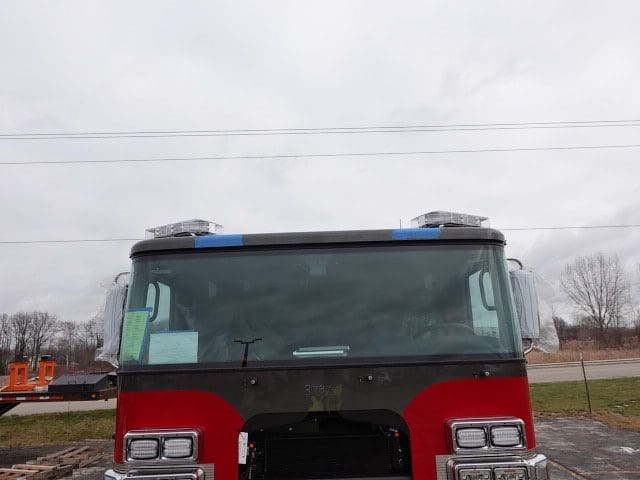

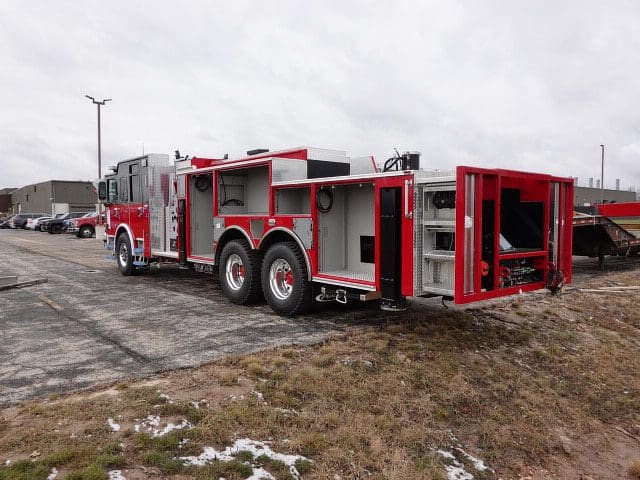

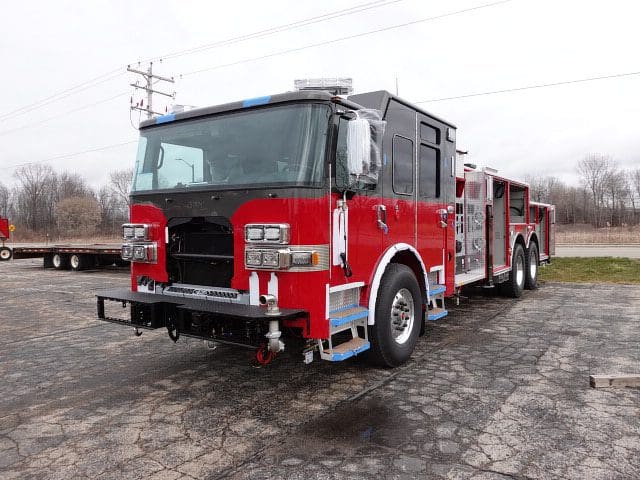

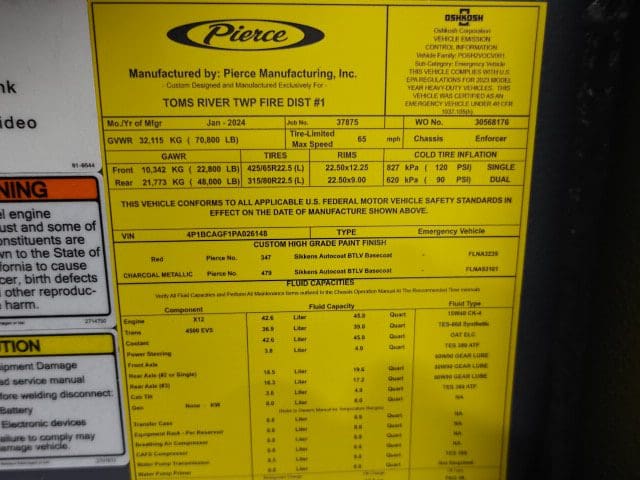

02-16-24

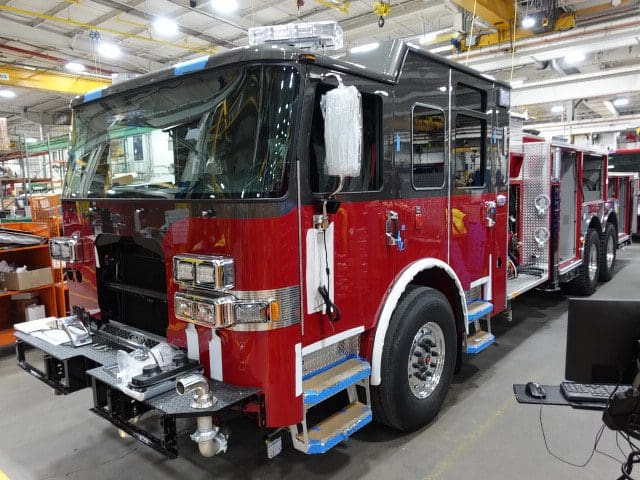

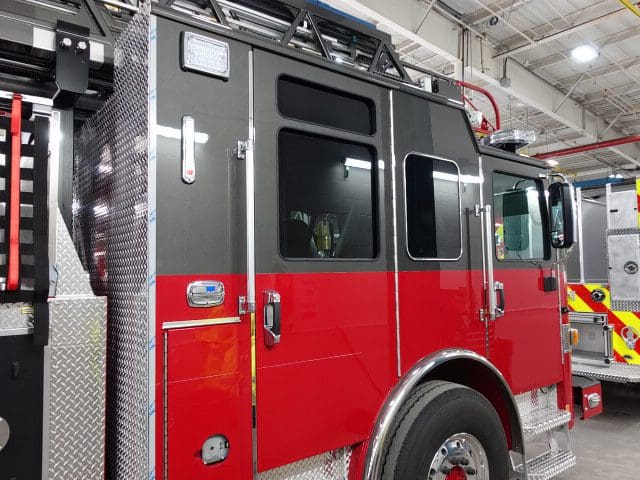

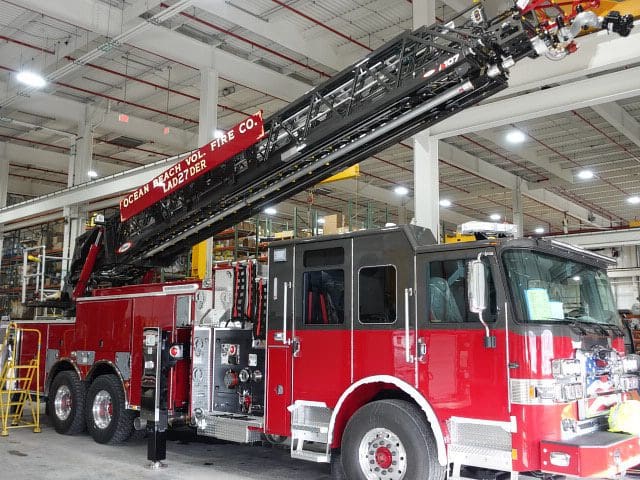

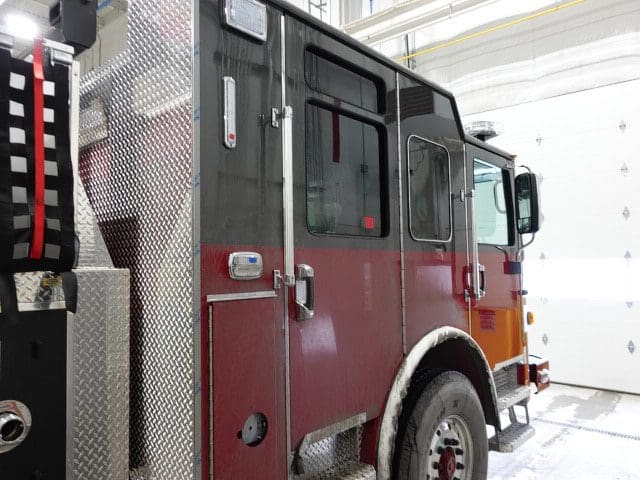

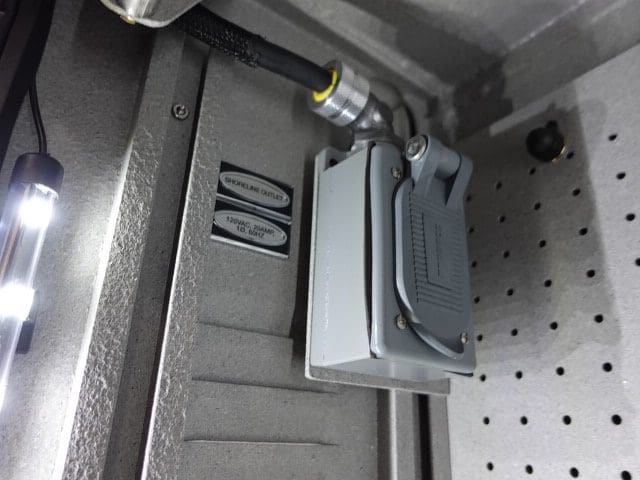

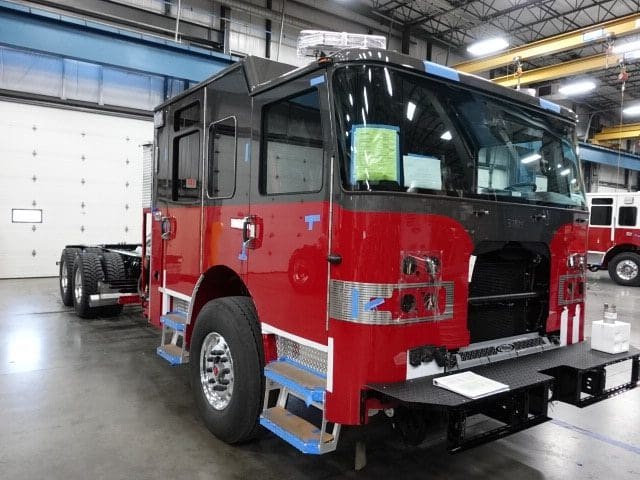

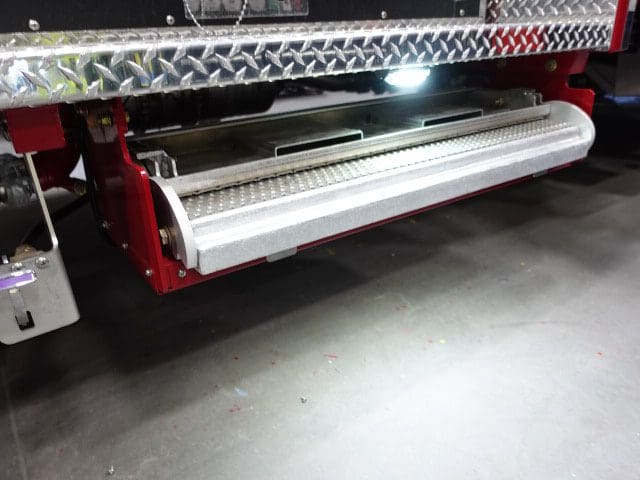

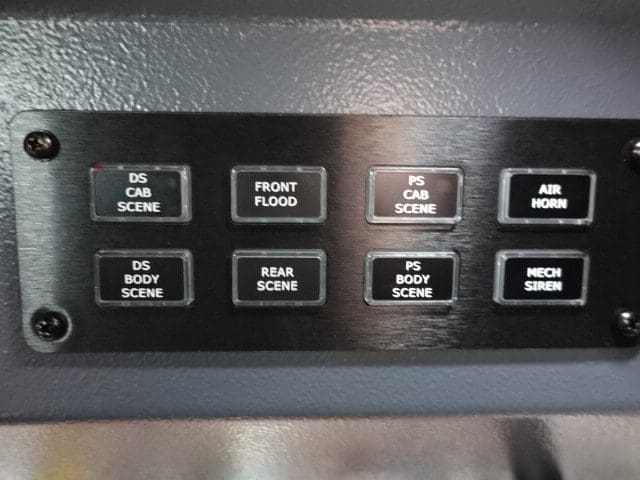

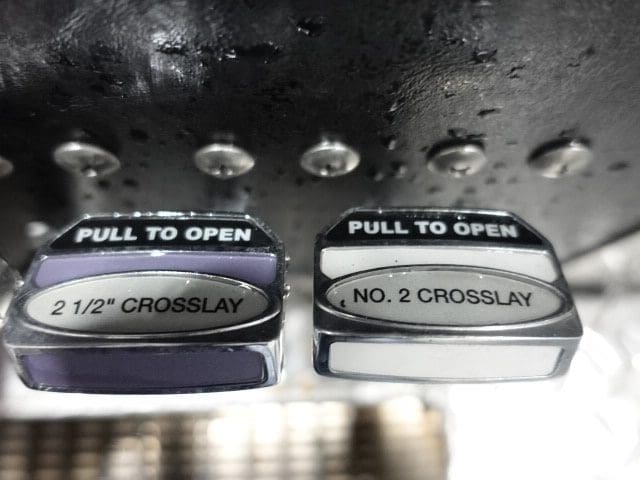

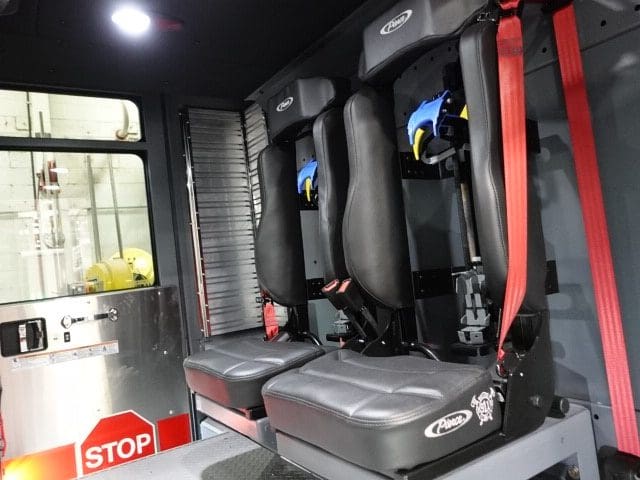

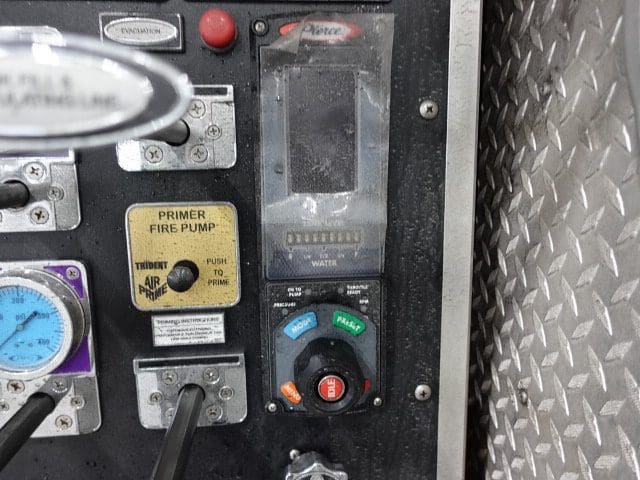

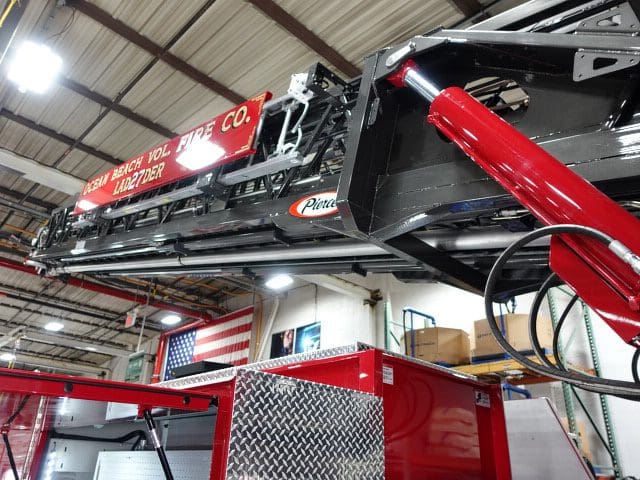

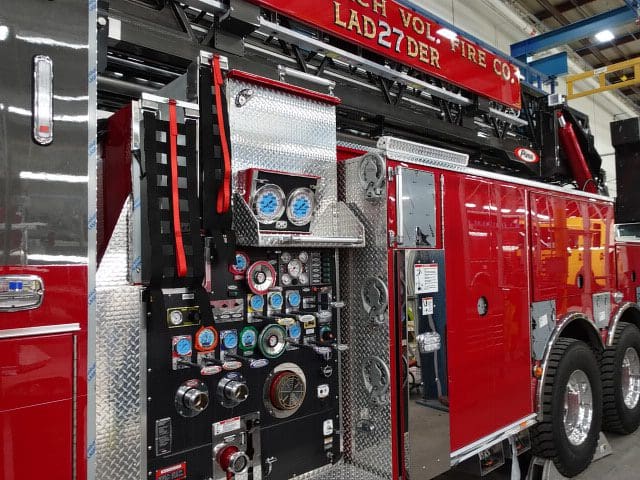

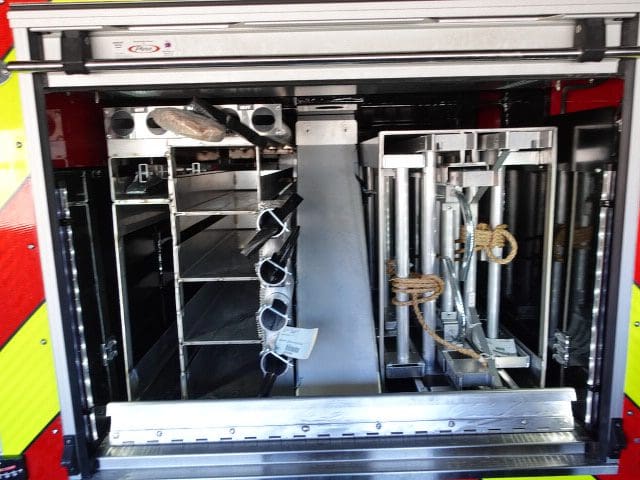

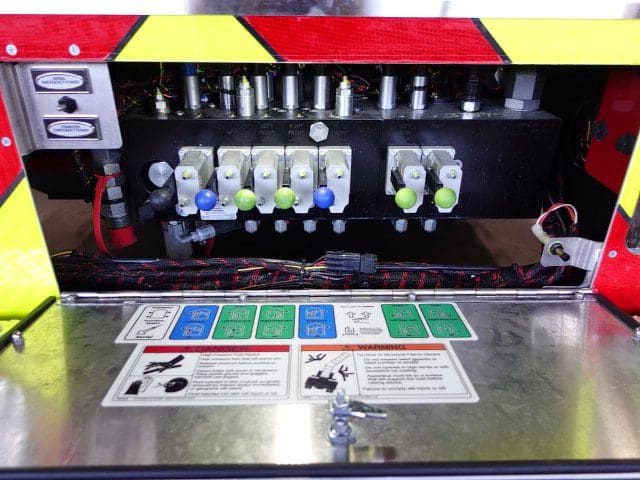

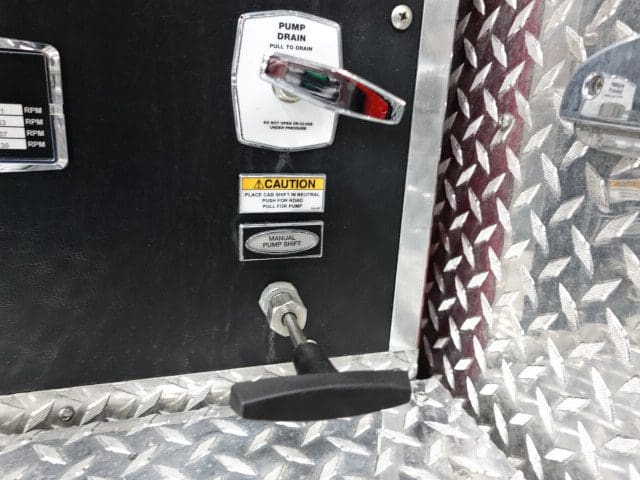

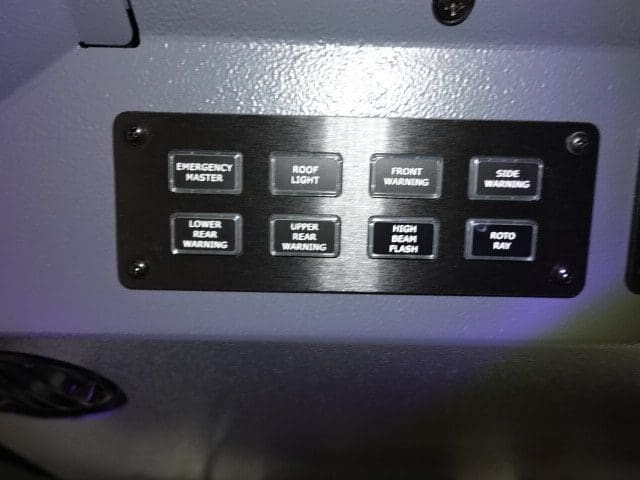

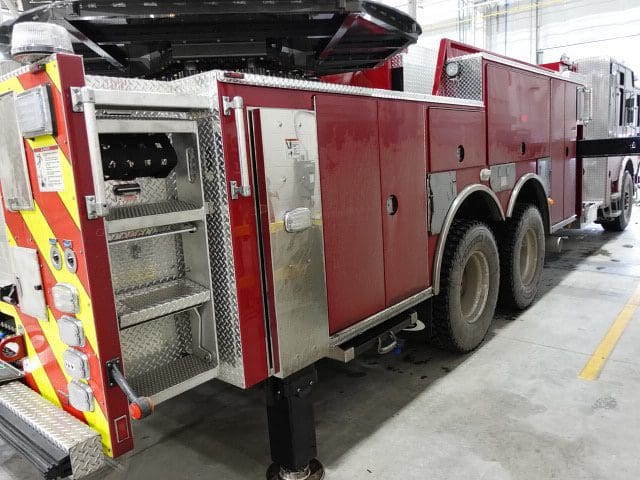

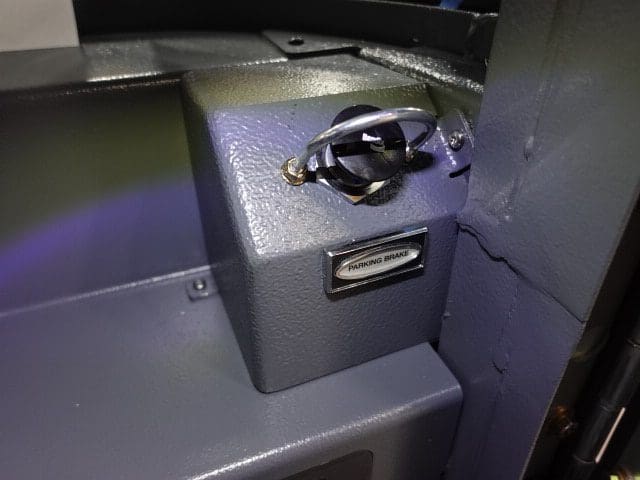

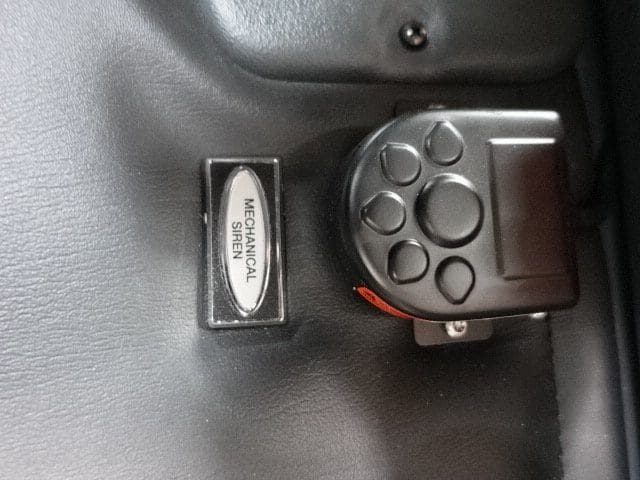

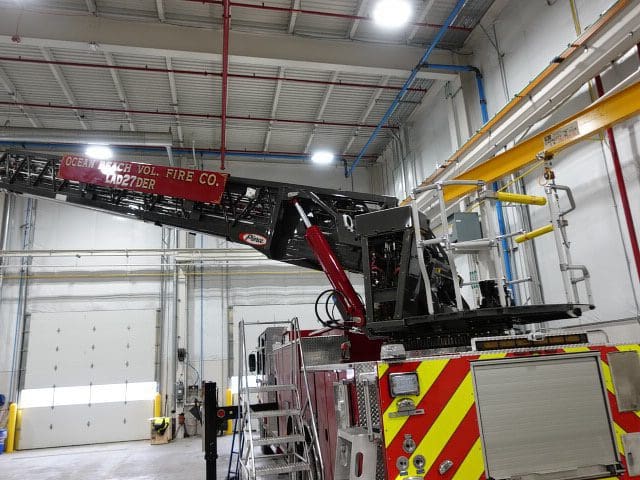

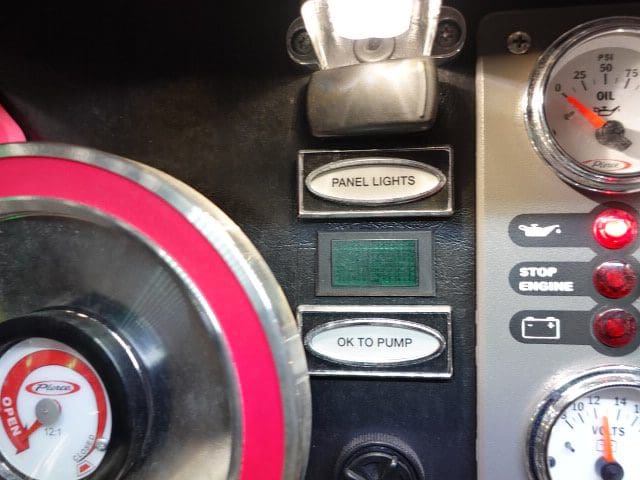

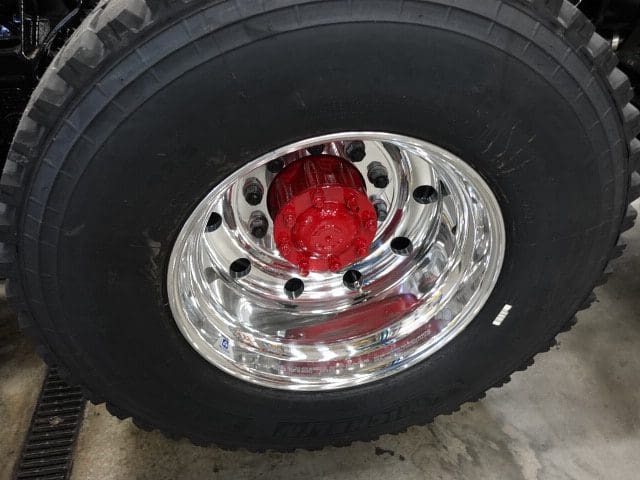

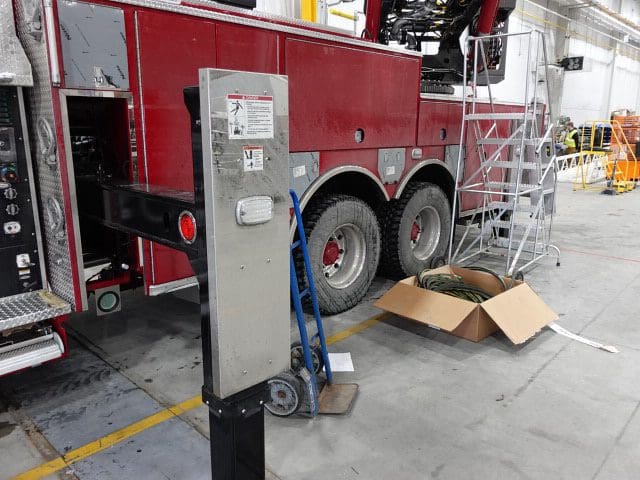

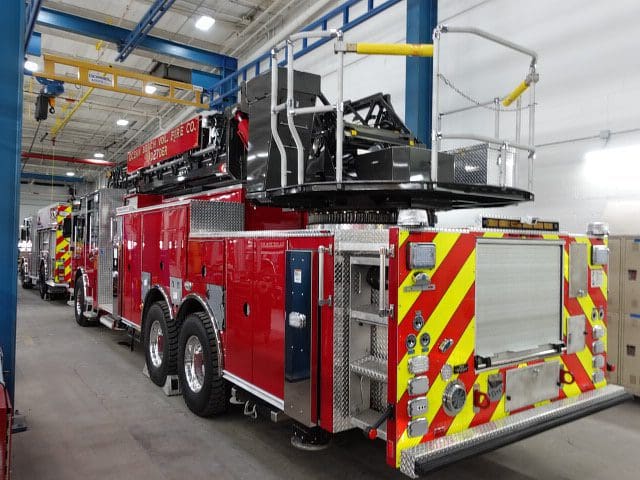

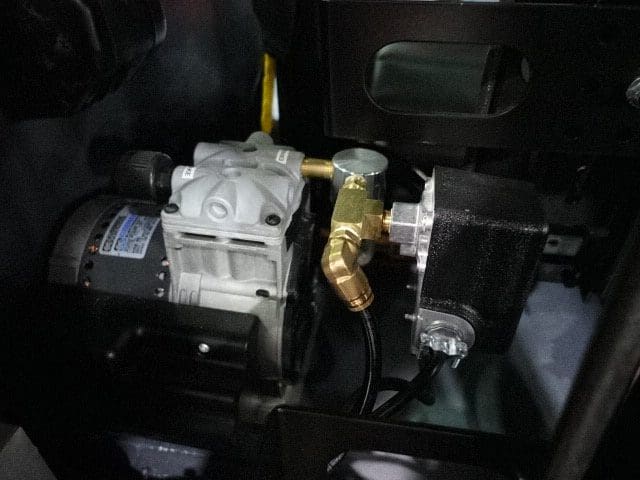

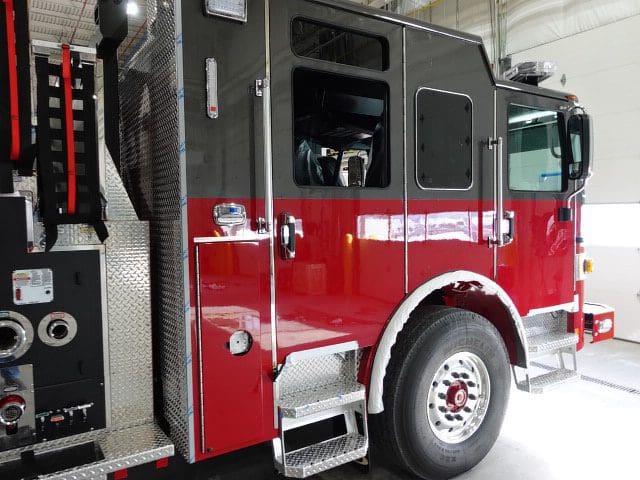

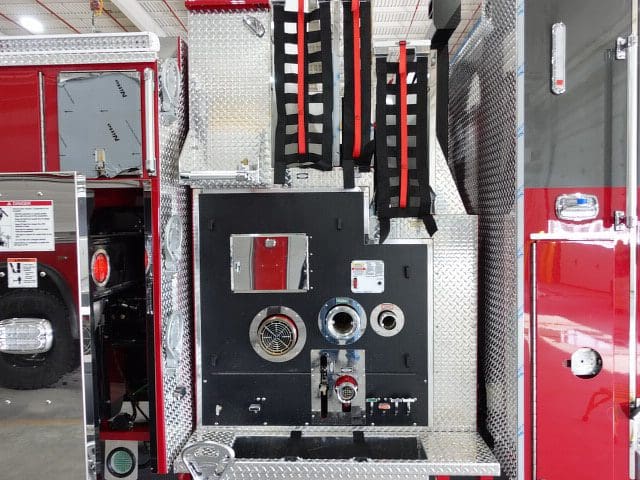

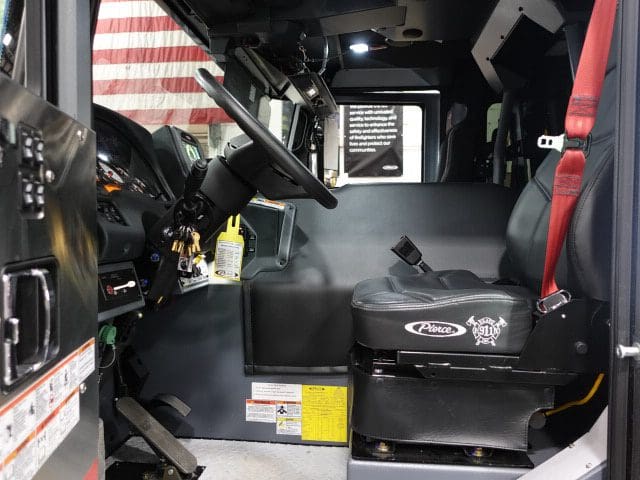

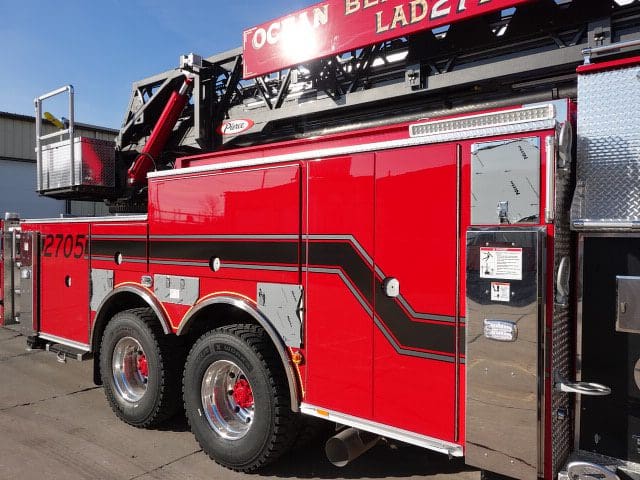

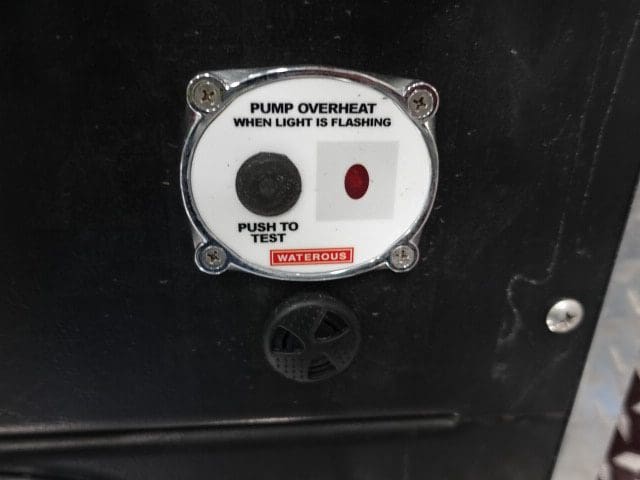

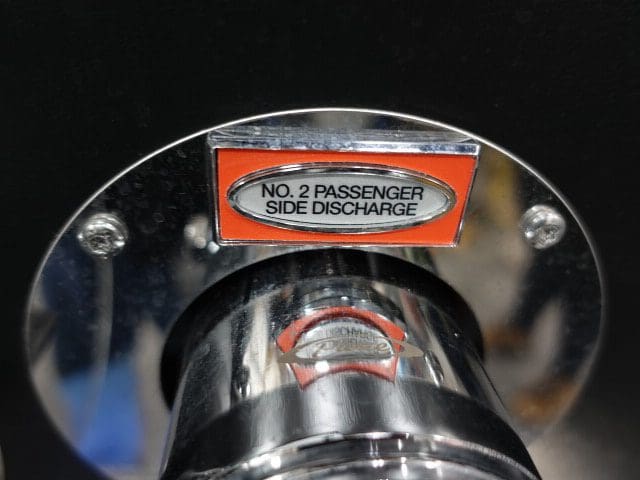

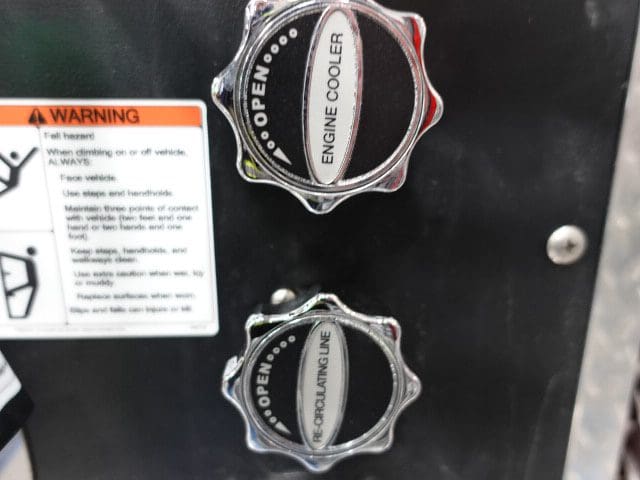

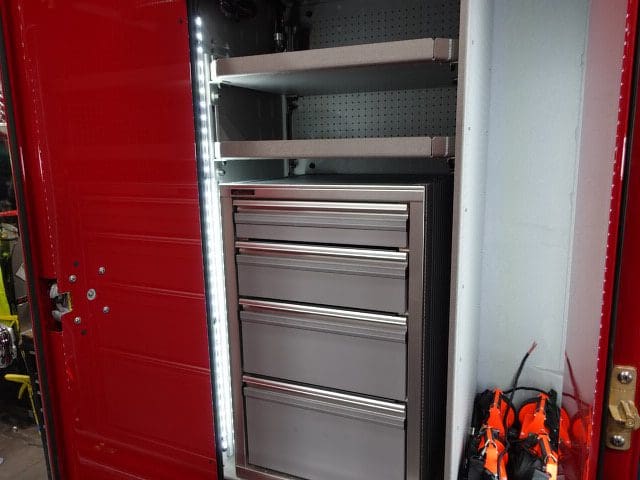

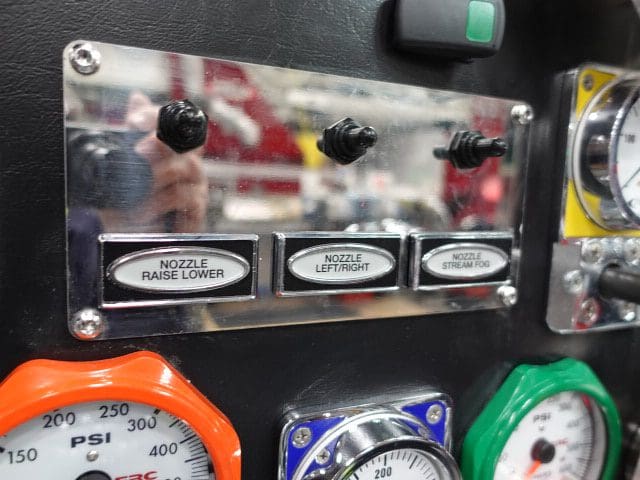

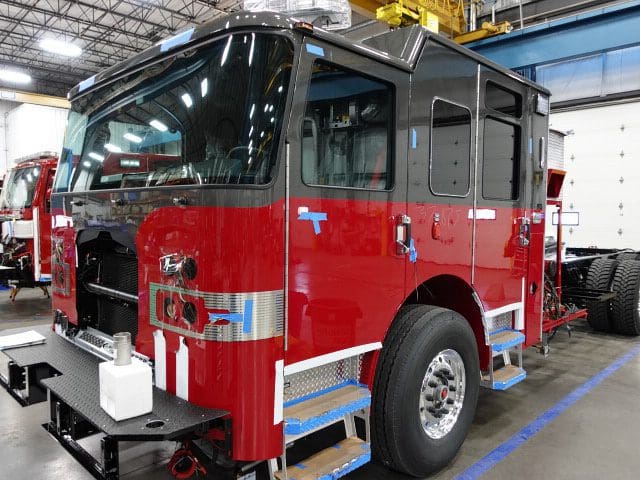

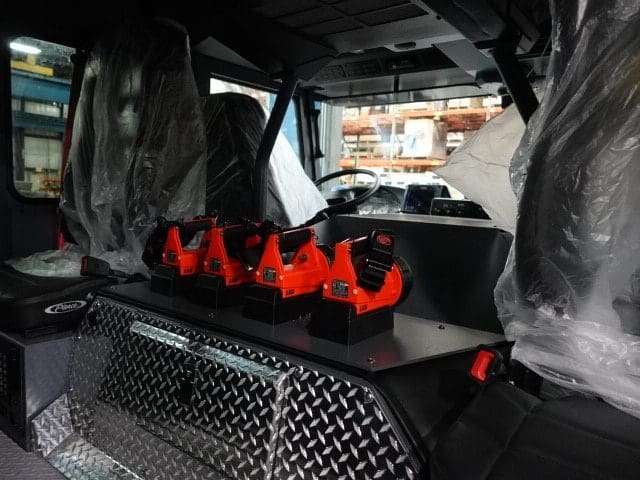

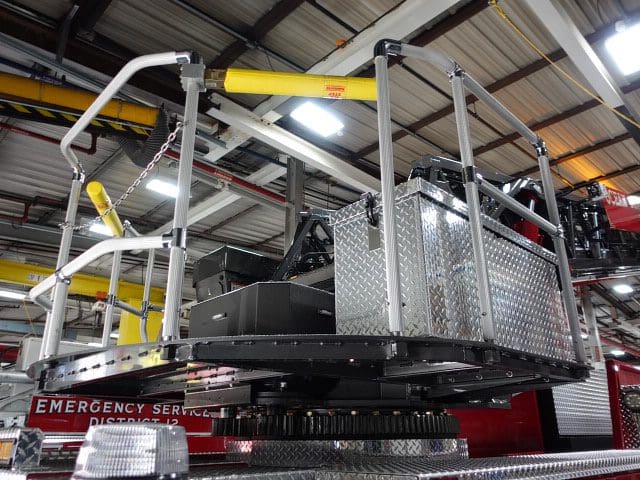

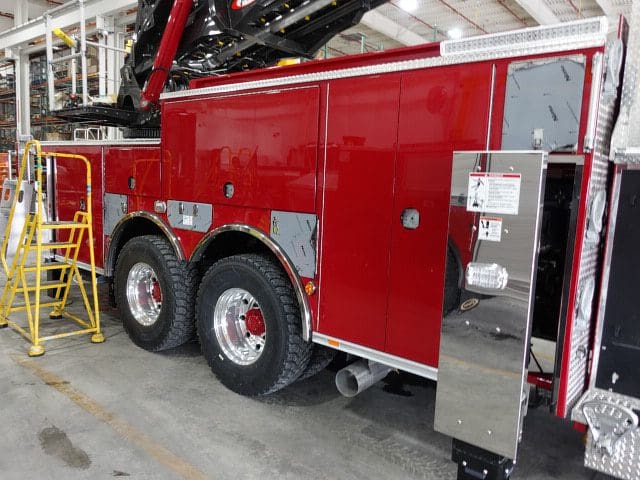

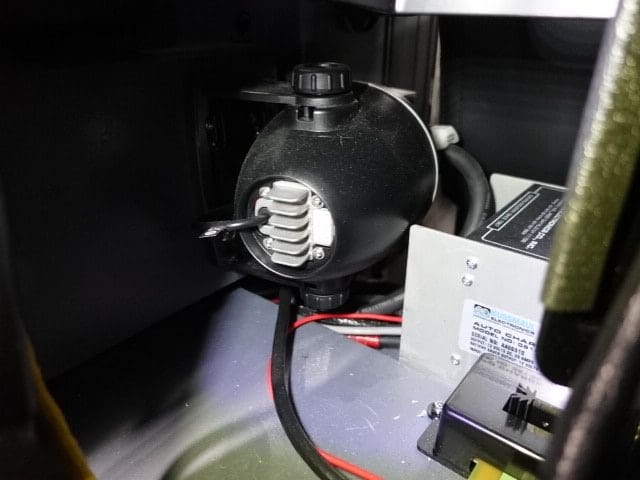

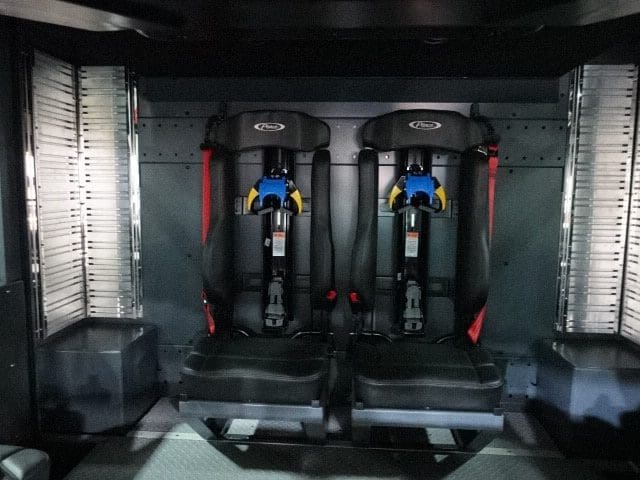

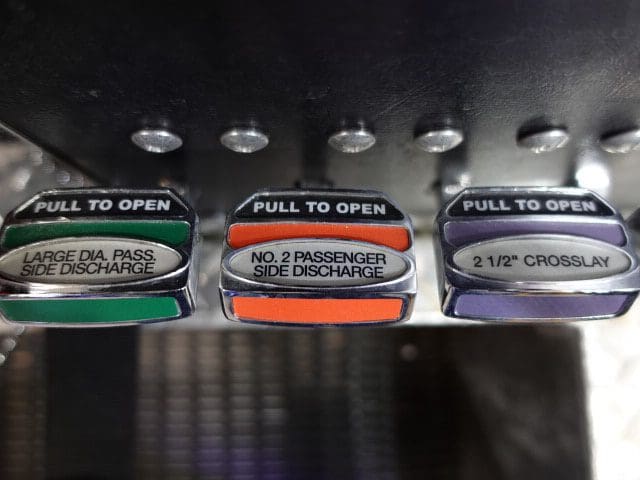

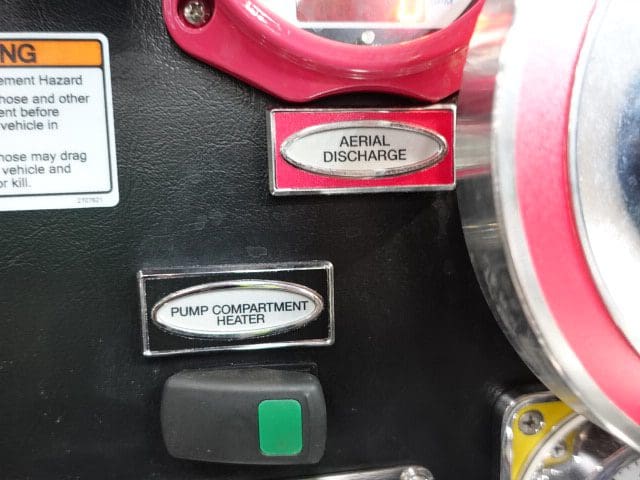

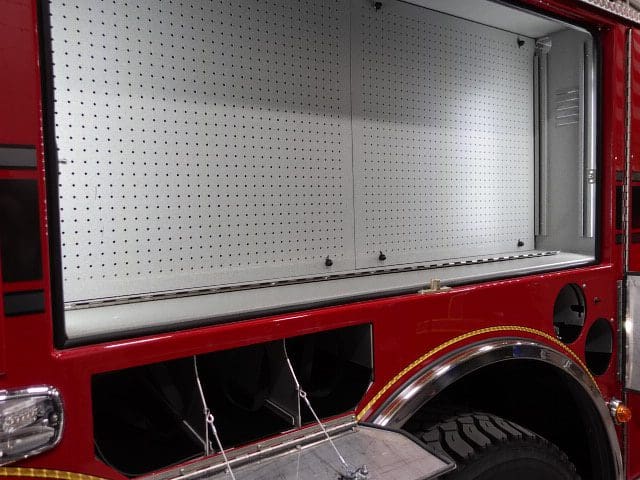

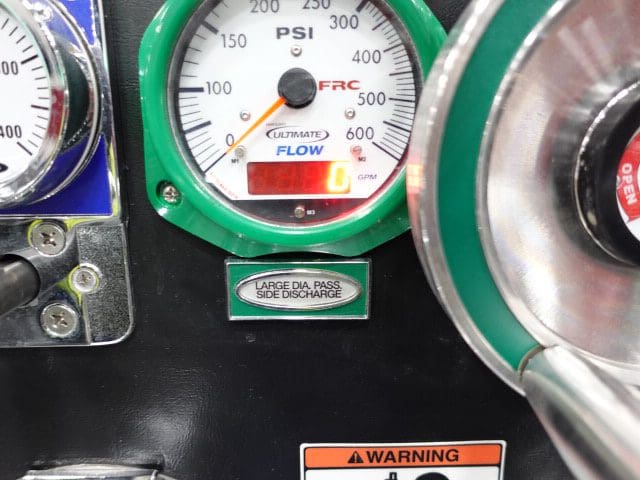

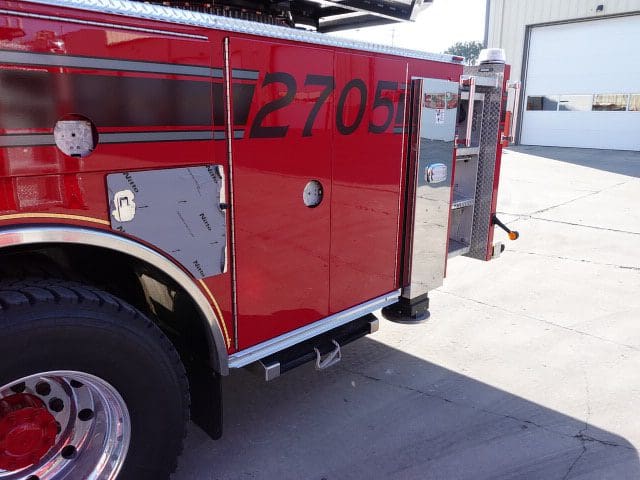

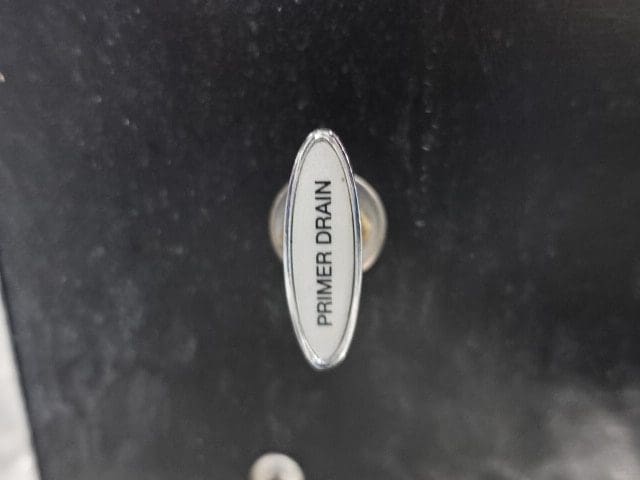

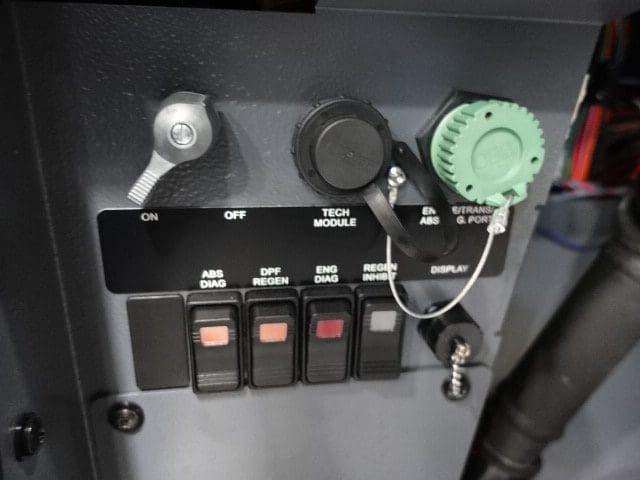

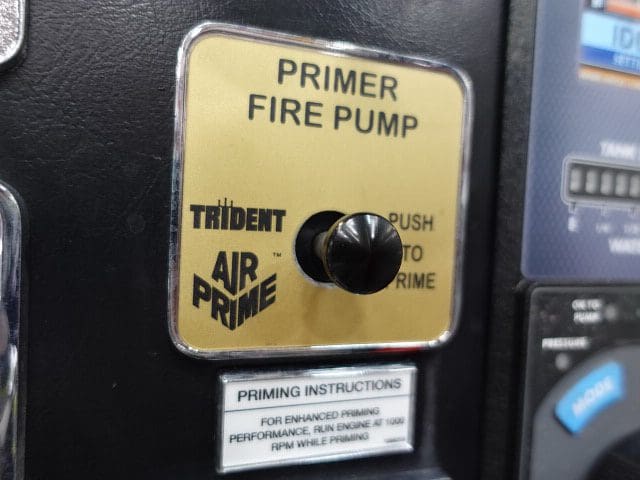

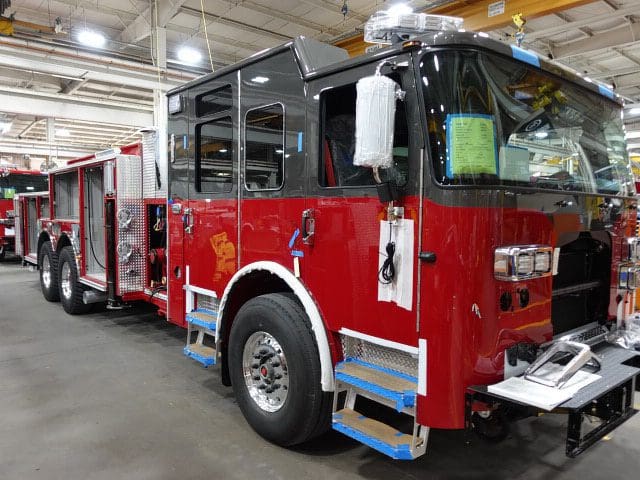

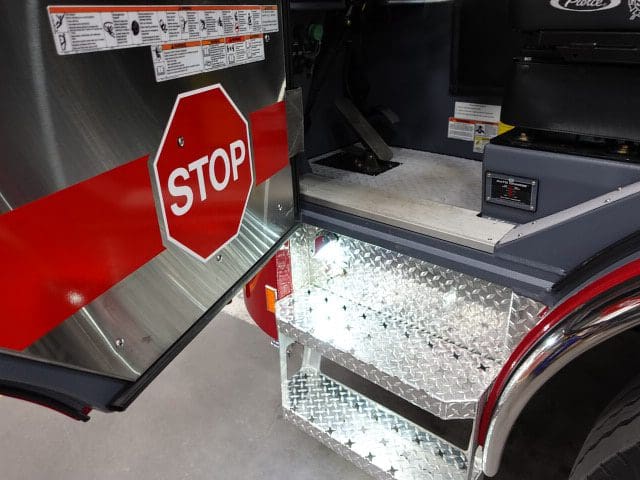

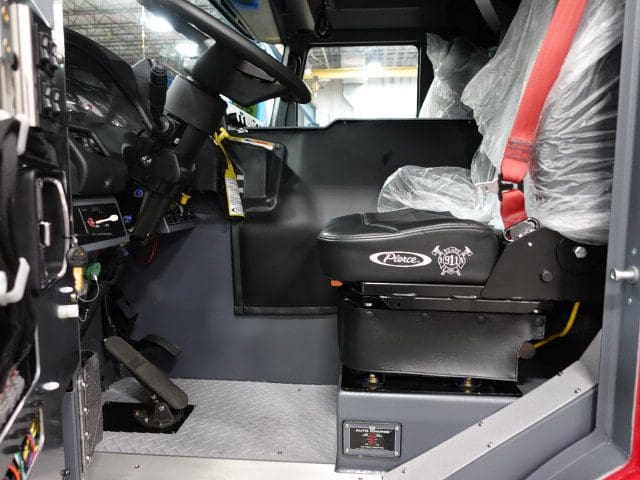

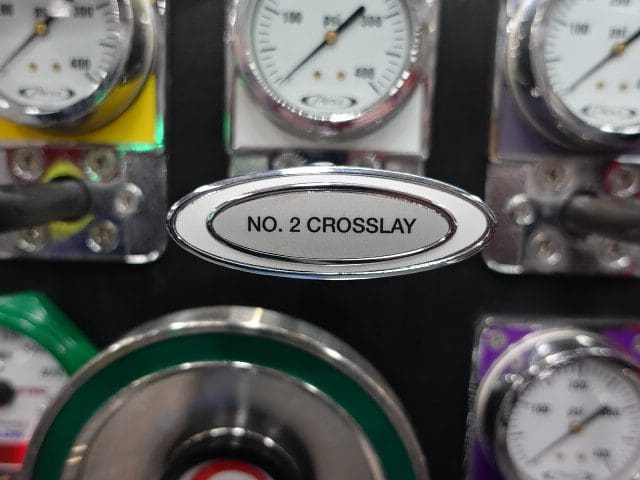

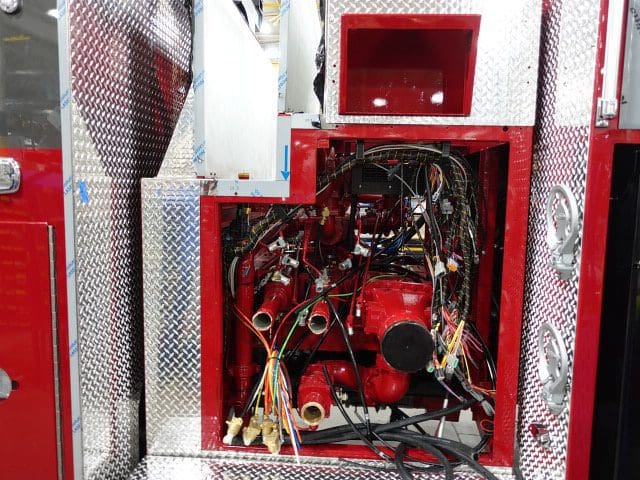

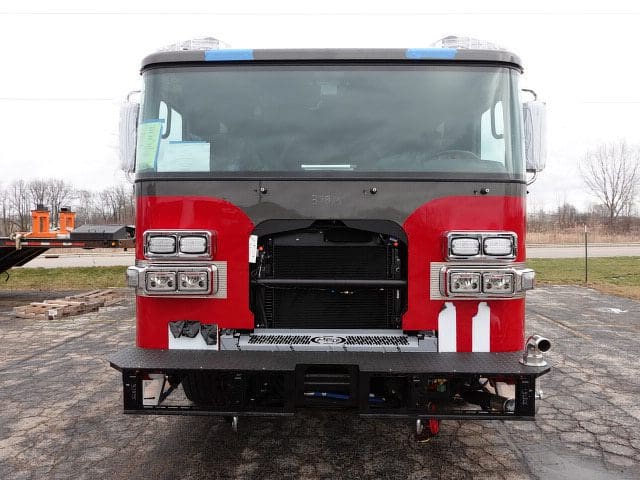

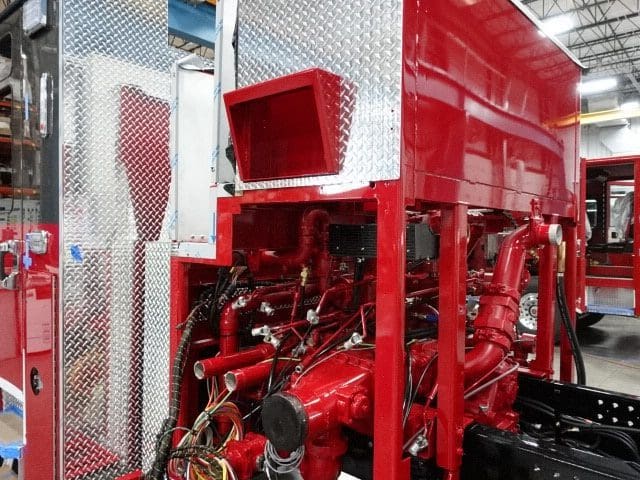

In this report, the apparatus continued the quality

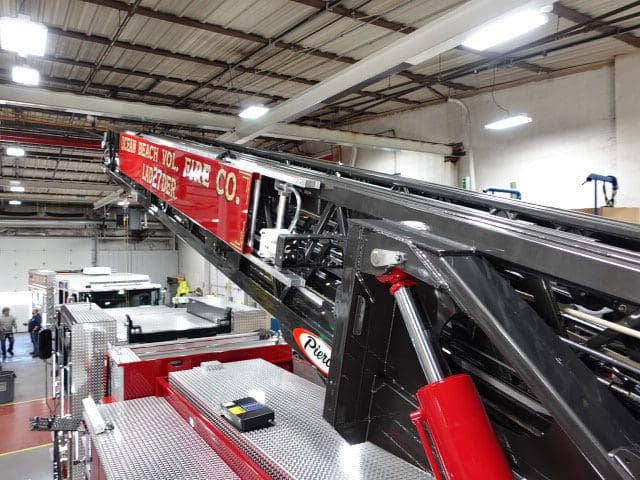

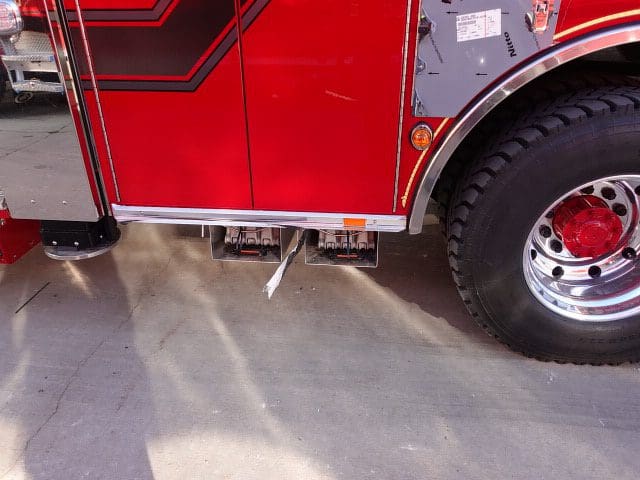

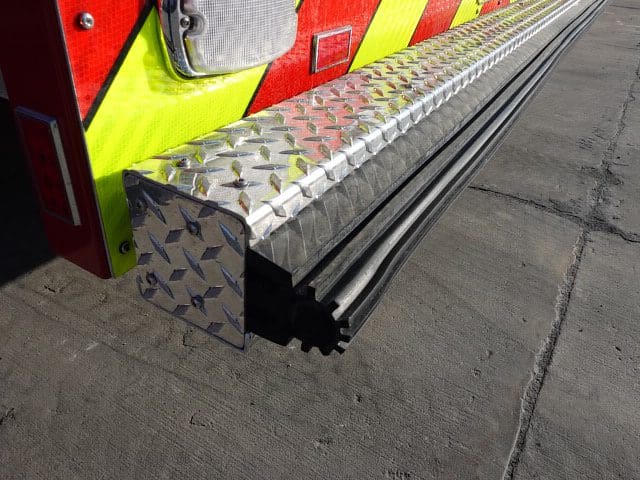

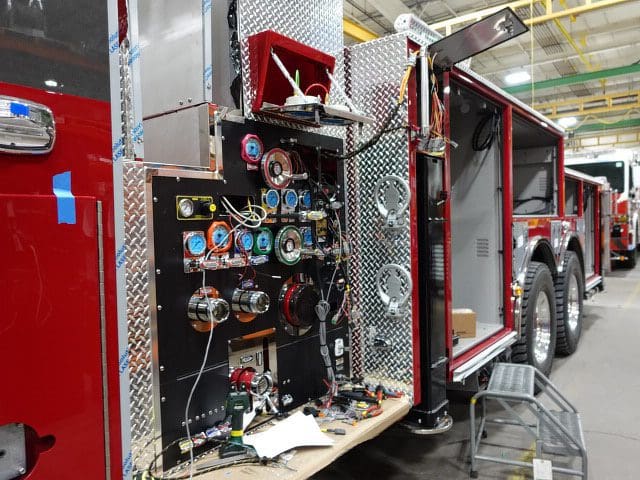

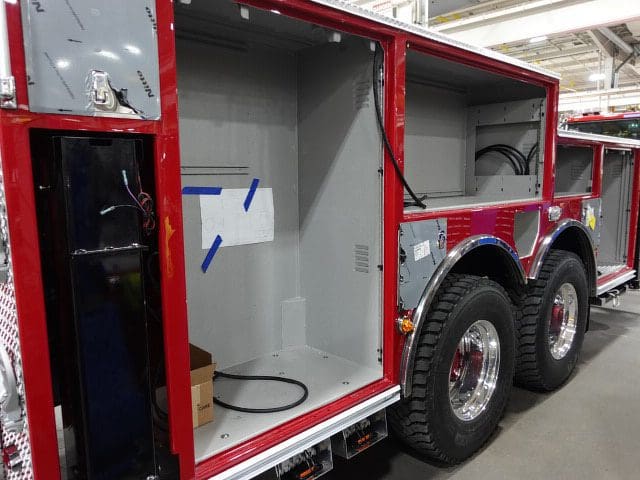

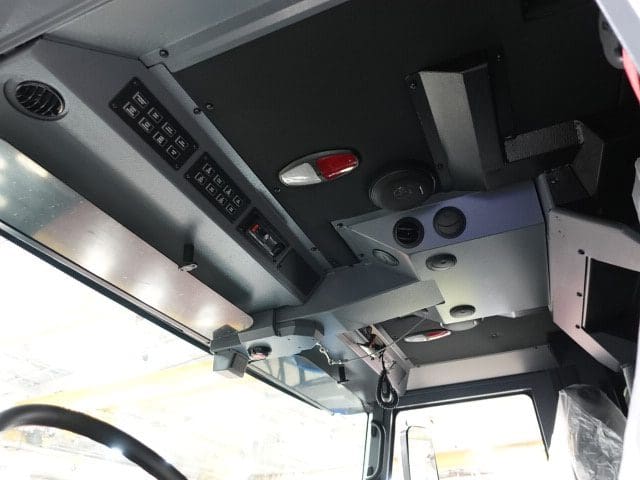

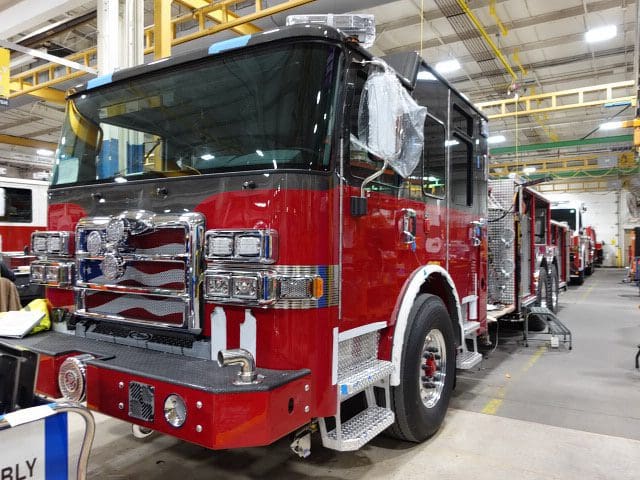

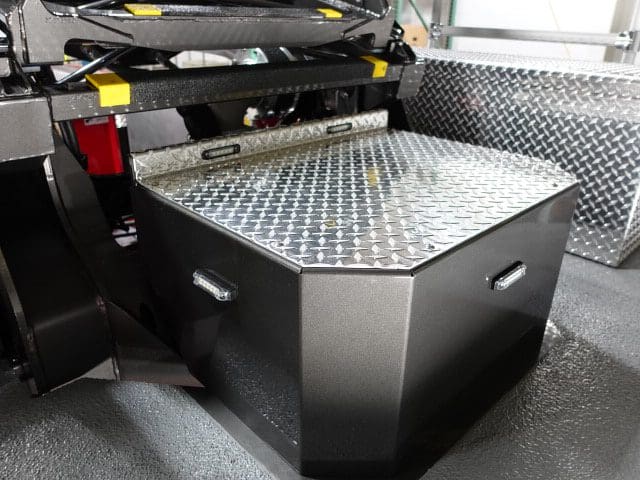

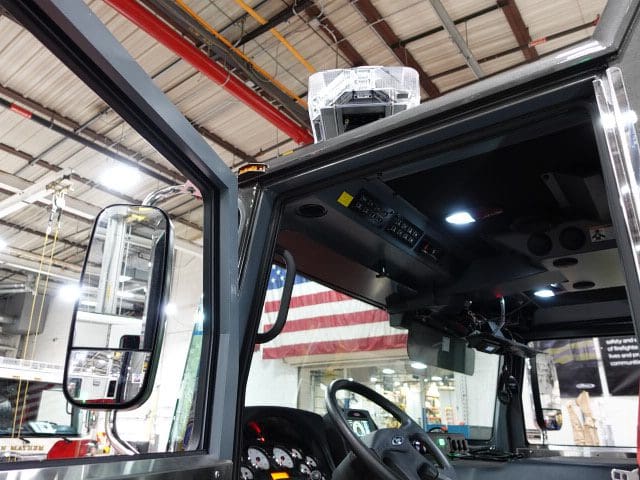

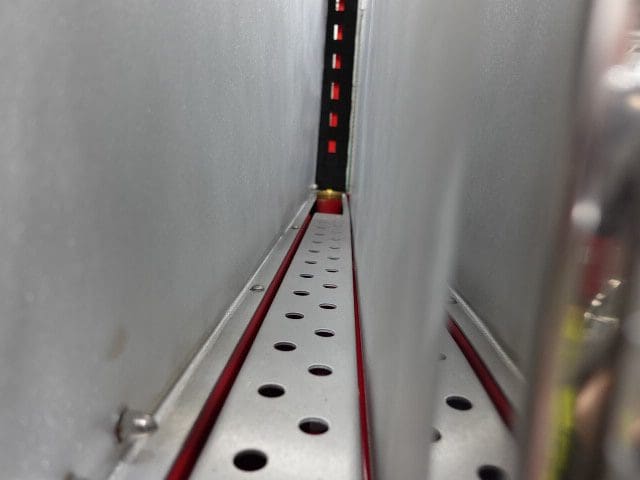

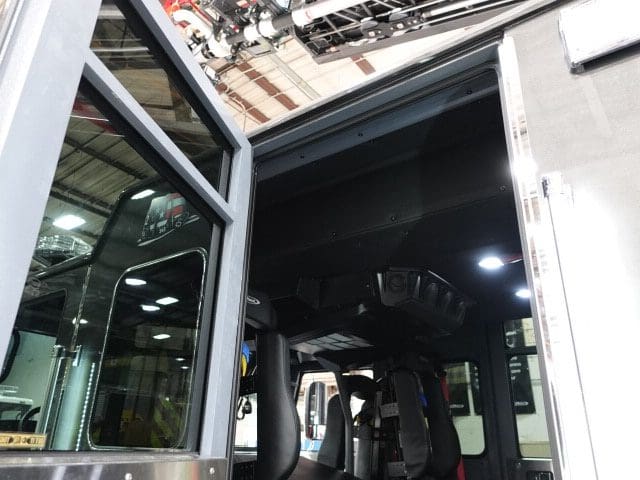

process where any remaining content will be installed.

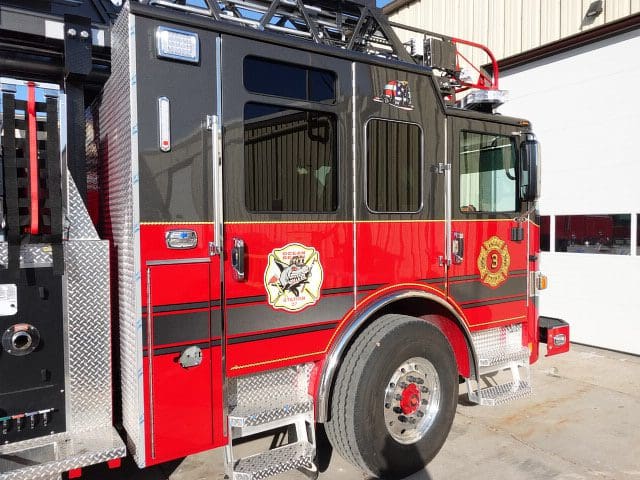

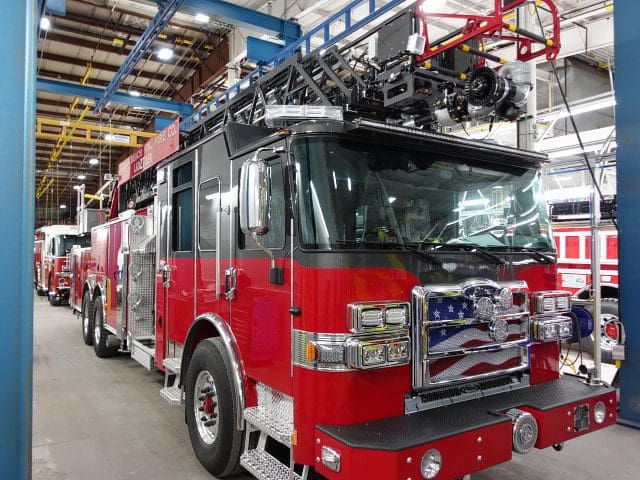

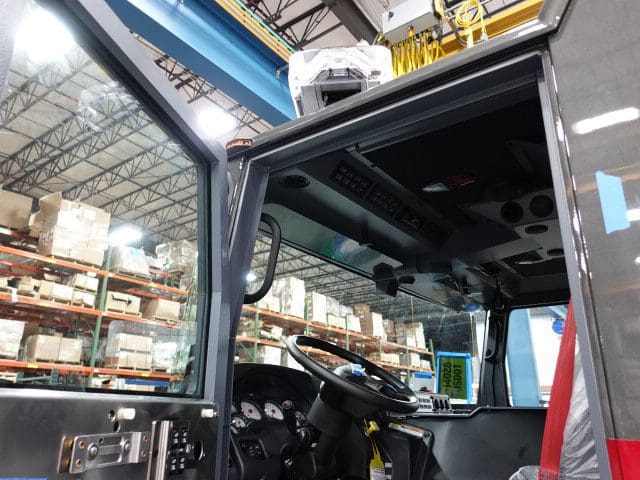

Once finished it will be made ready for customer

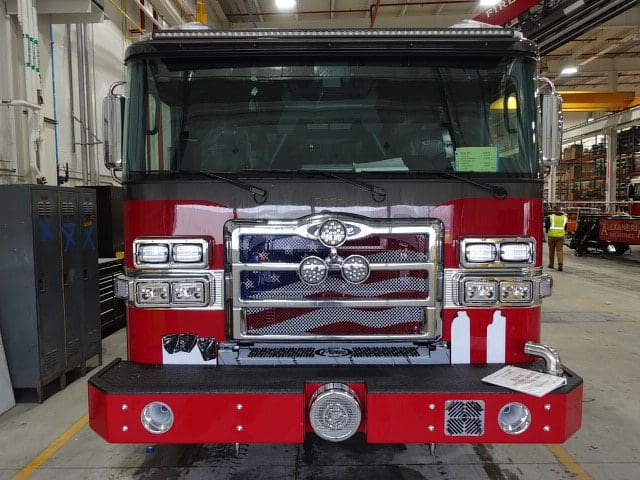

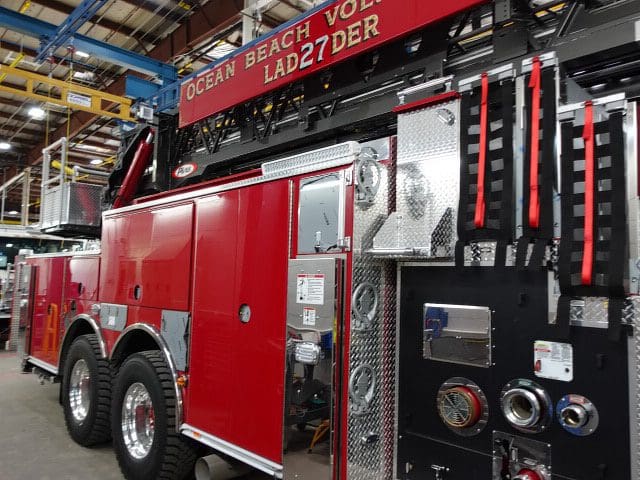

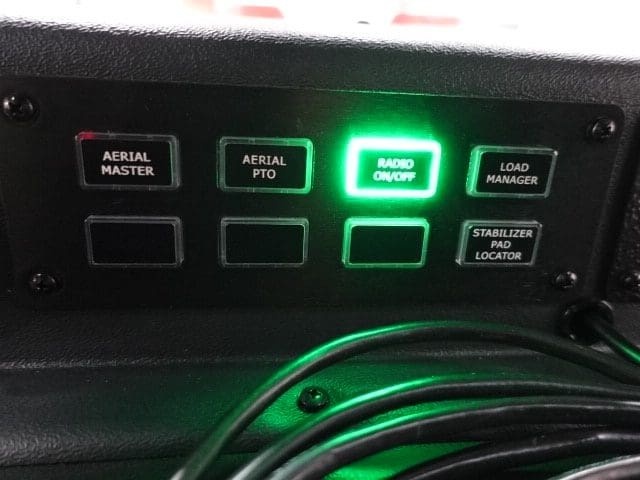

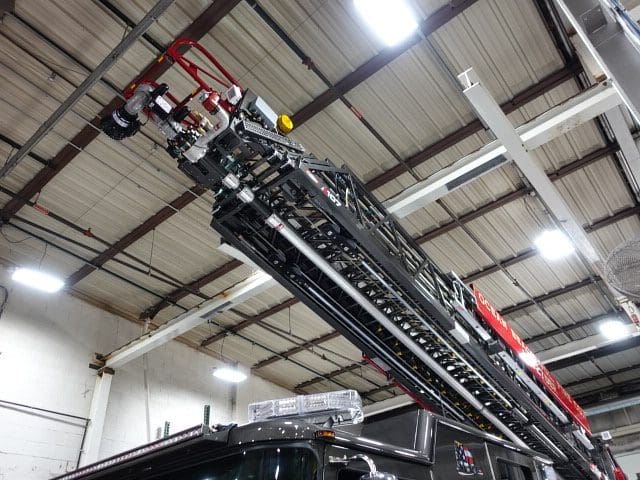

acceptance inspection. This is the last scheduled report.

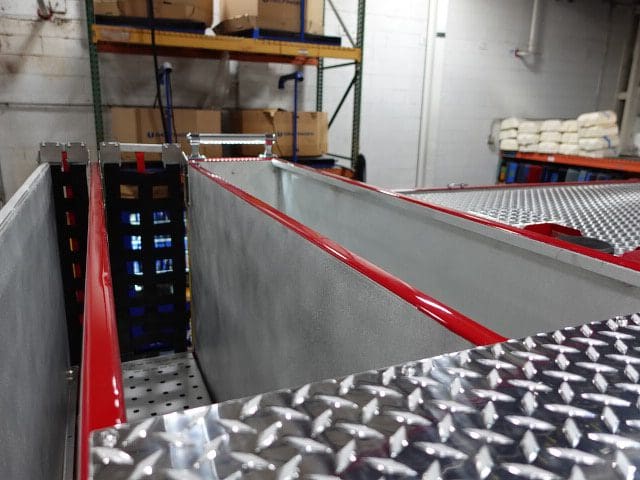

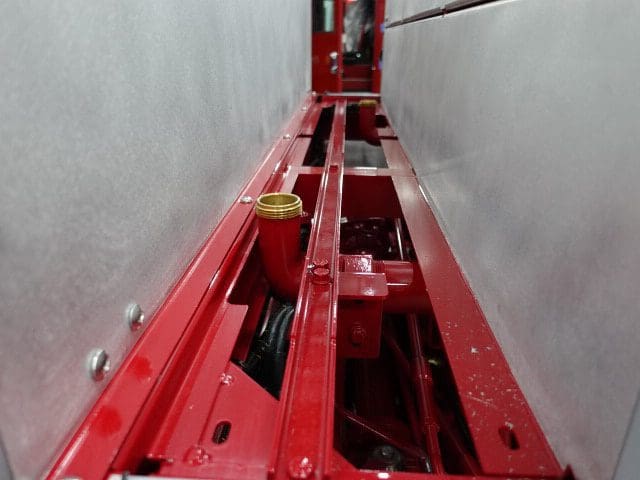

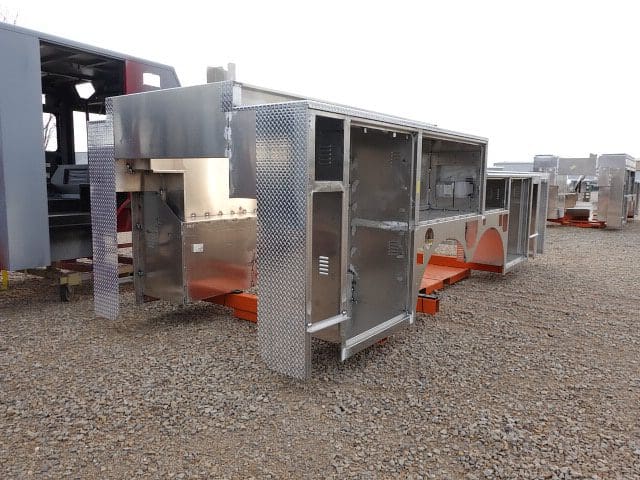

02-02-24

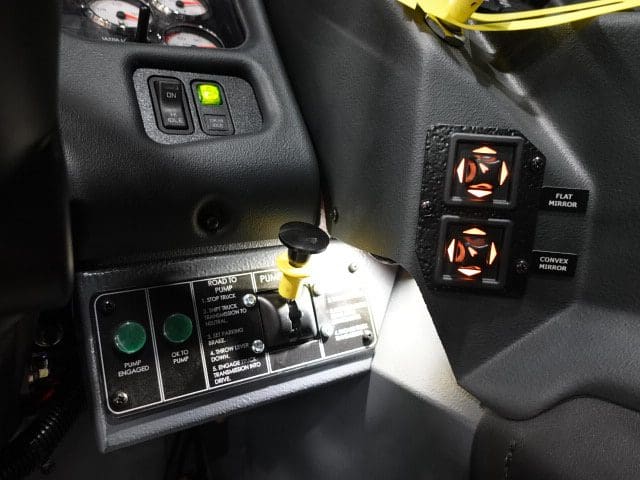

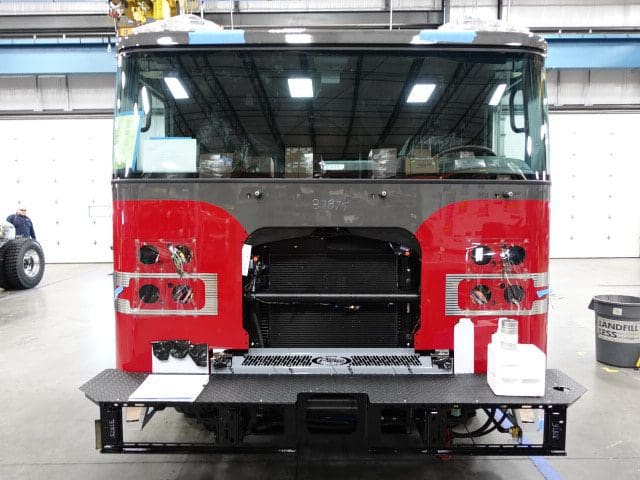

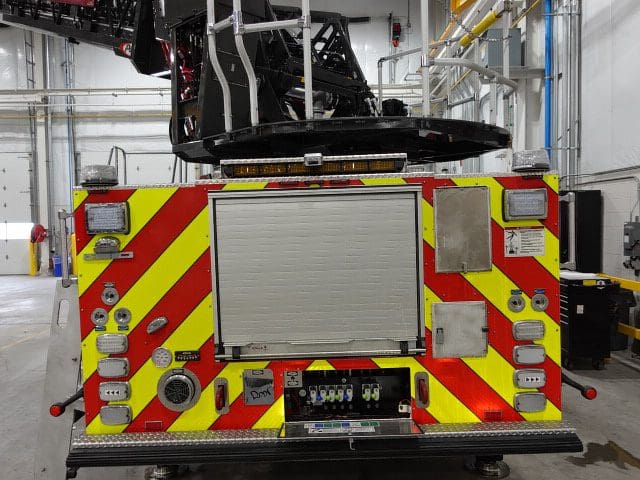

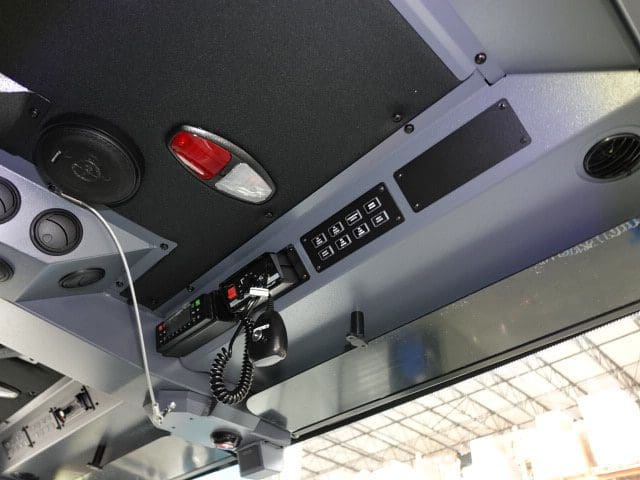

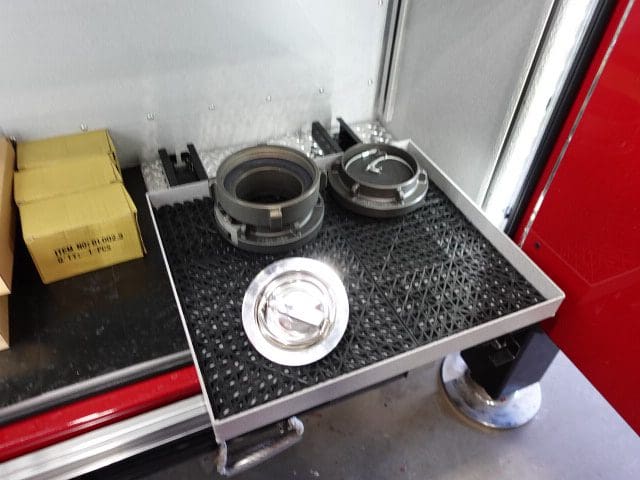

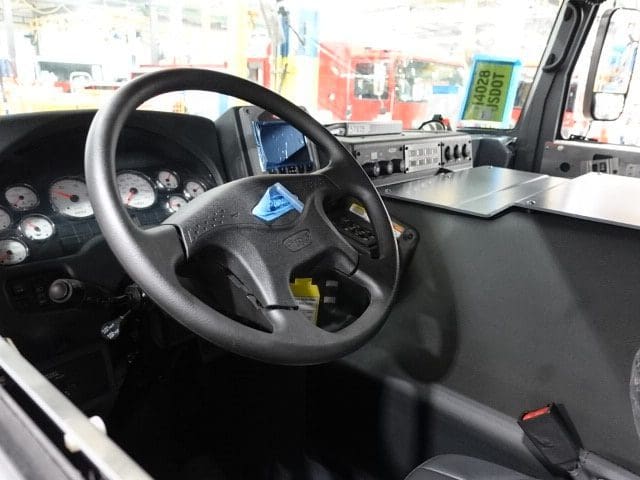

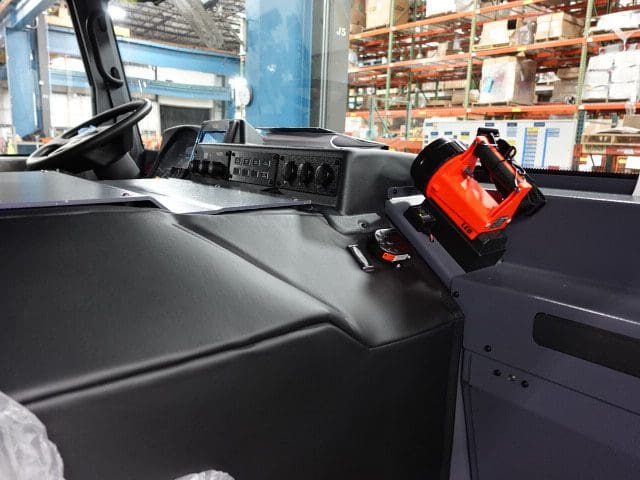

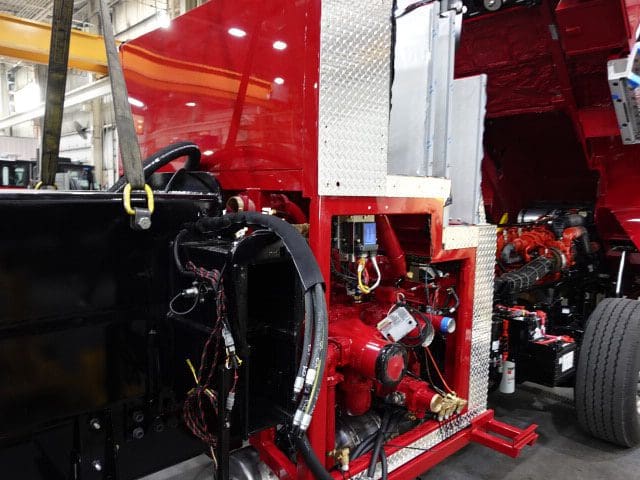

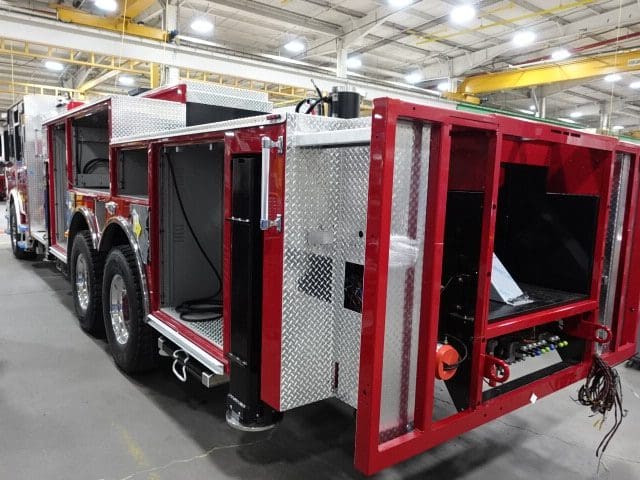

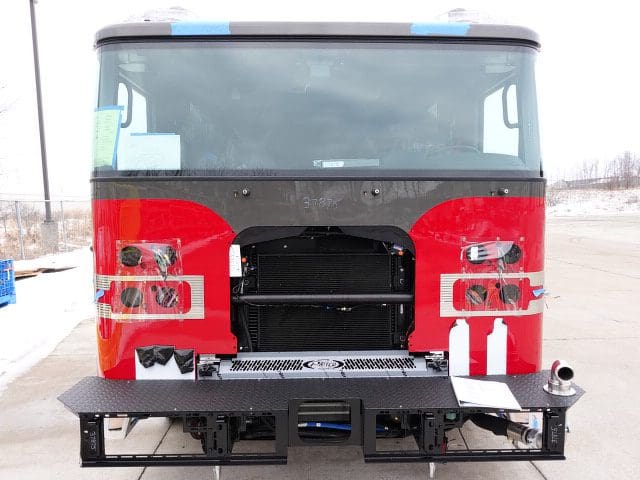

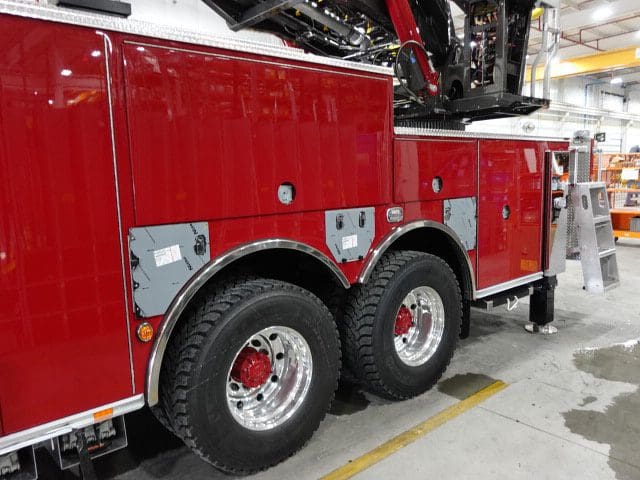

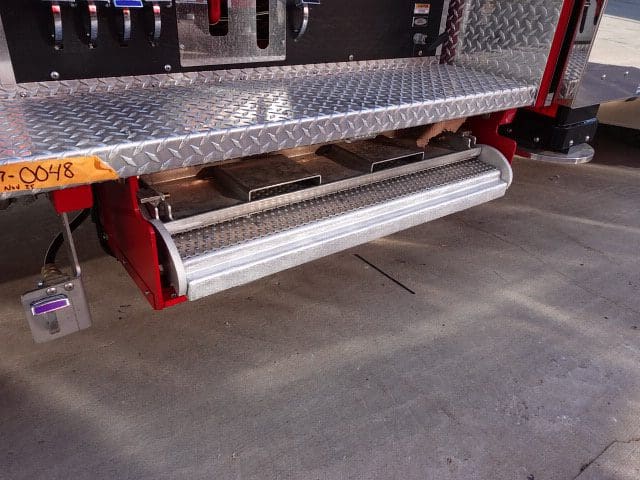

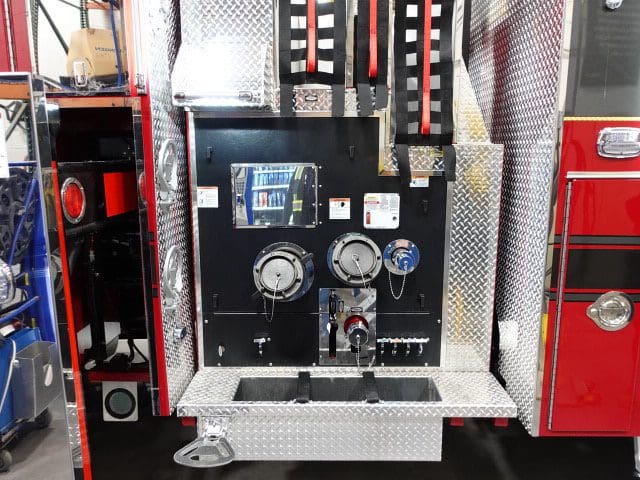

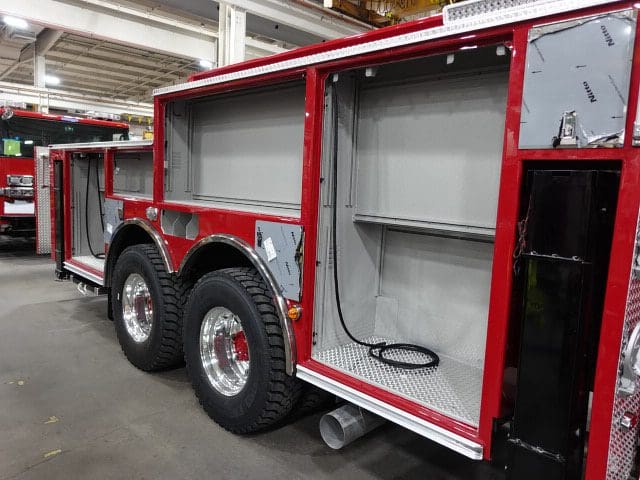

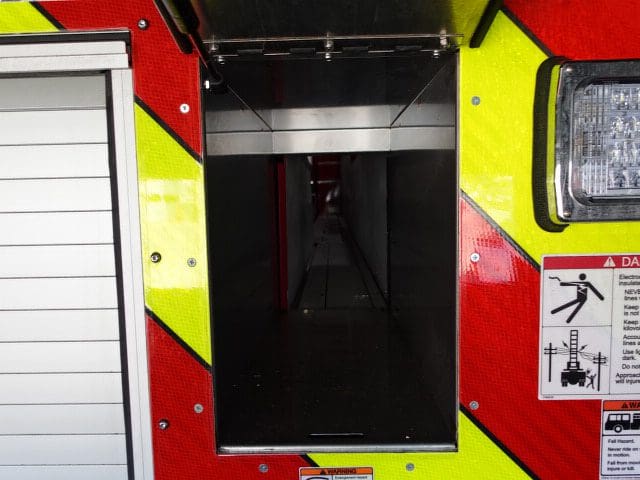

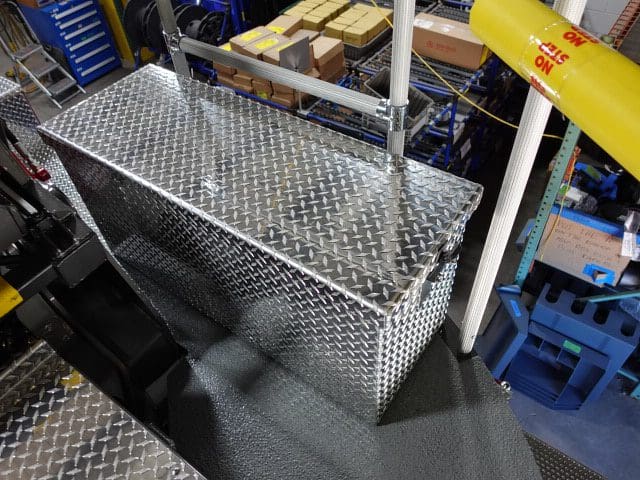

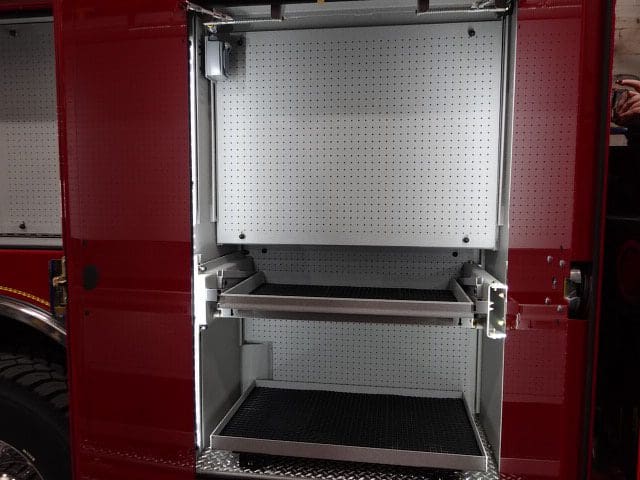

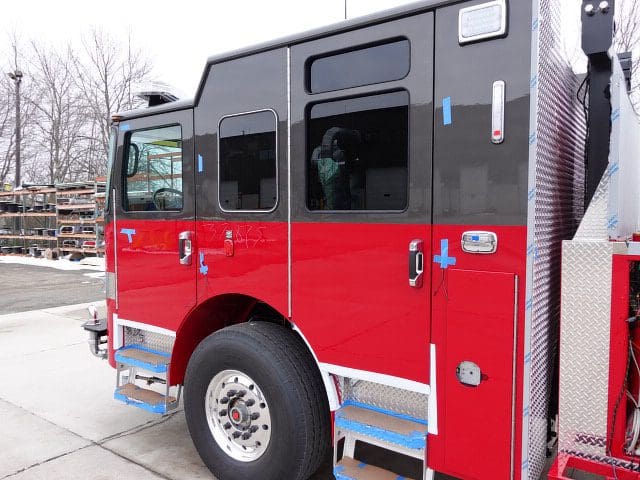

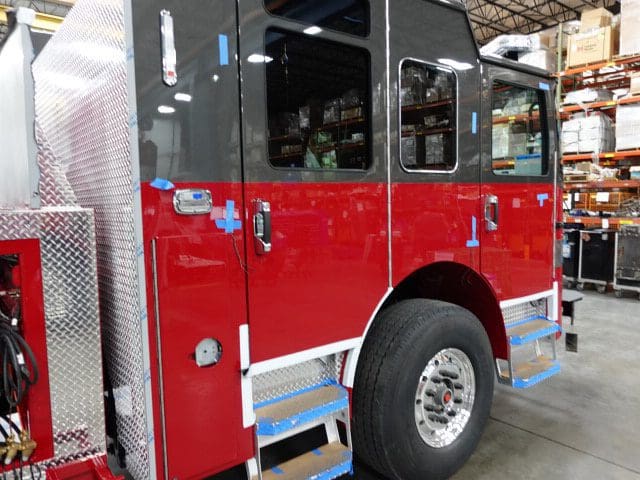

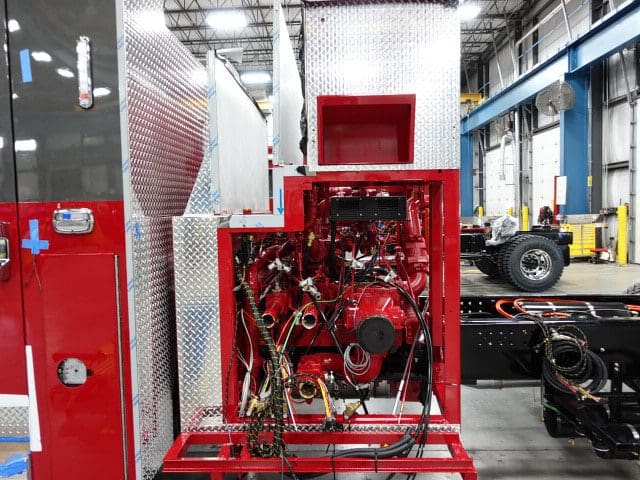

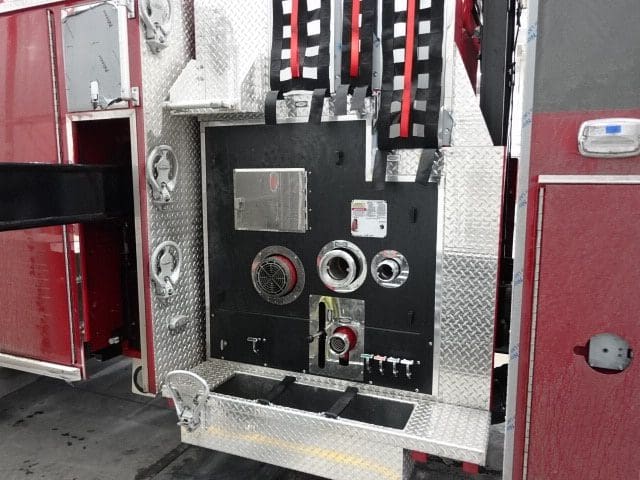

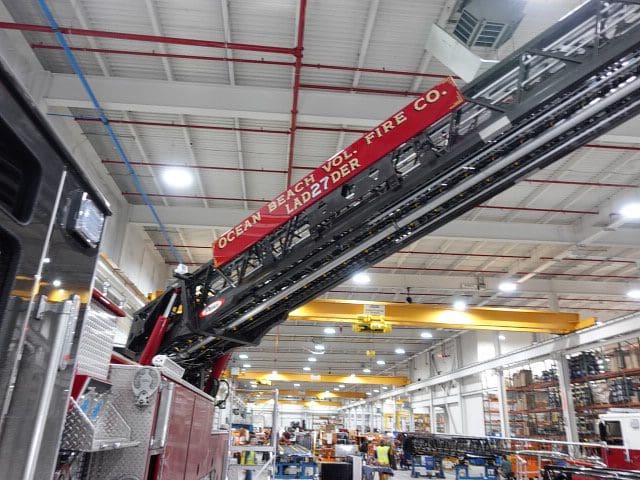

In this report, the apparatus completed testing and was released to quality and graphics.
01-26-24

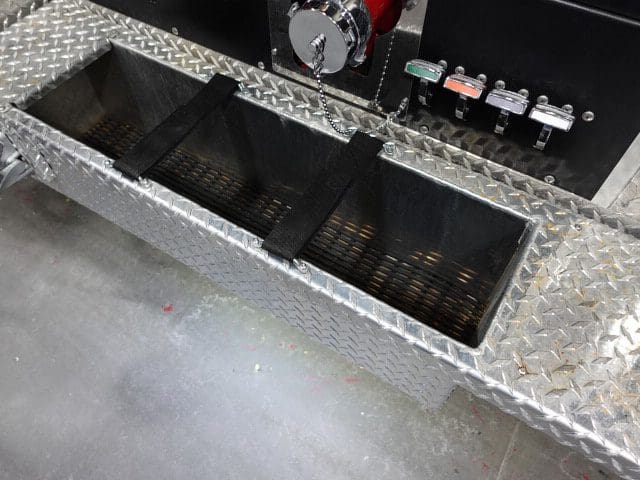

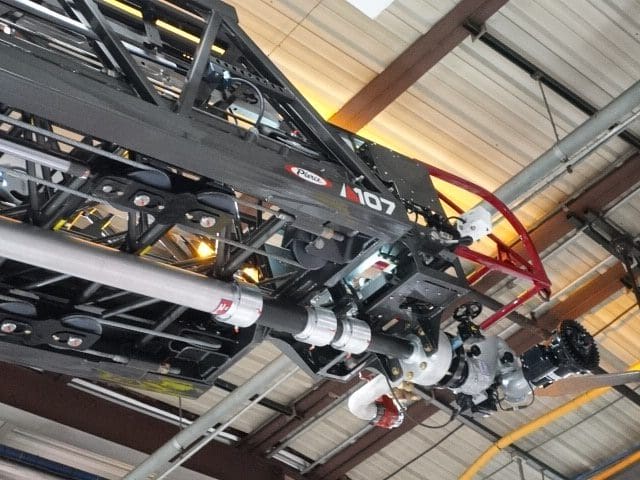

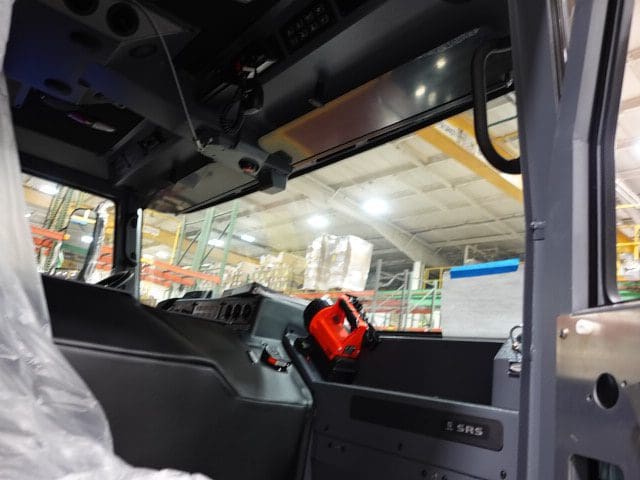

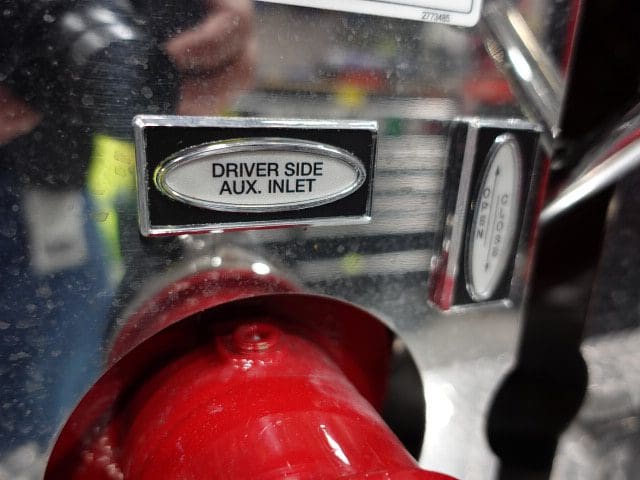

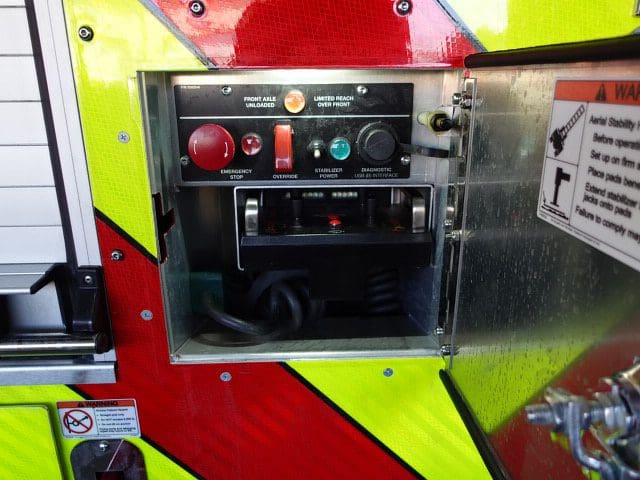

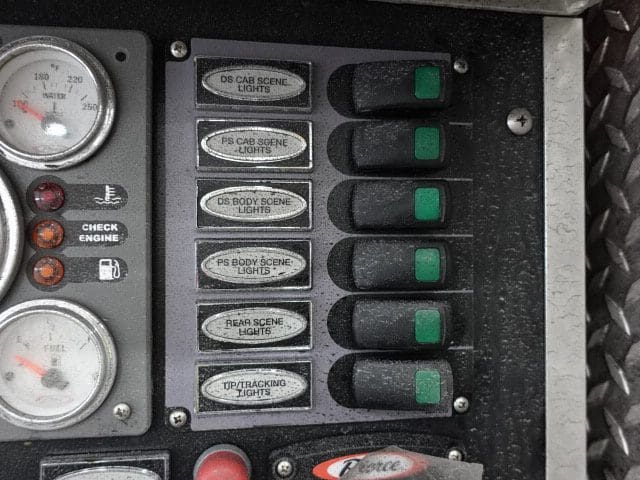

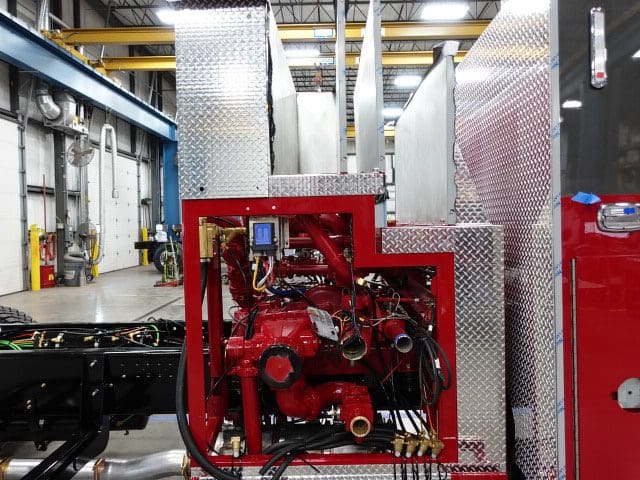

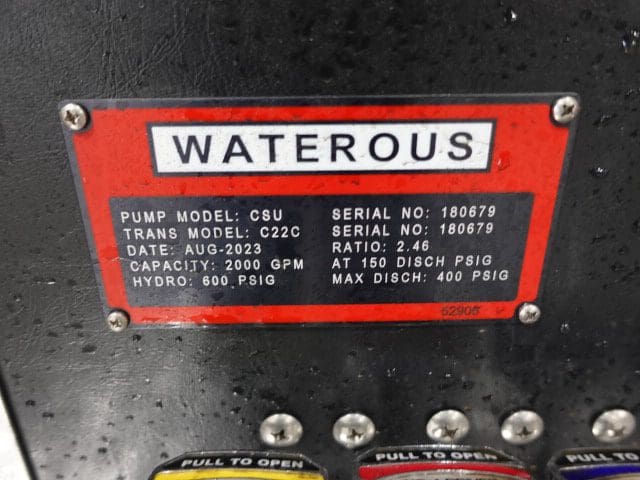

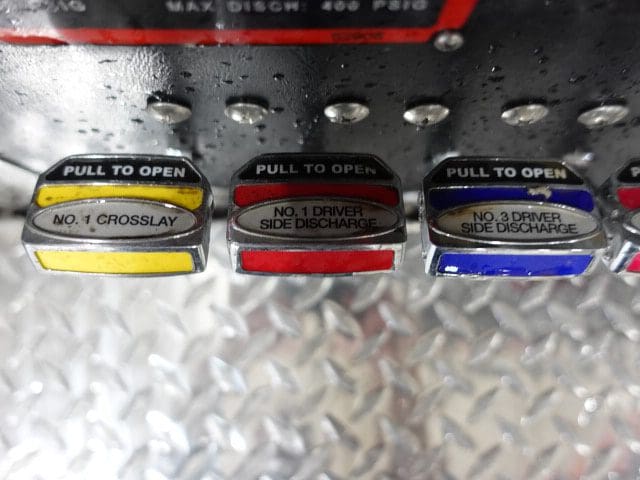

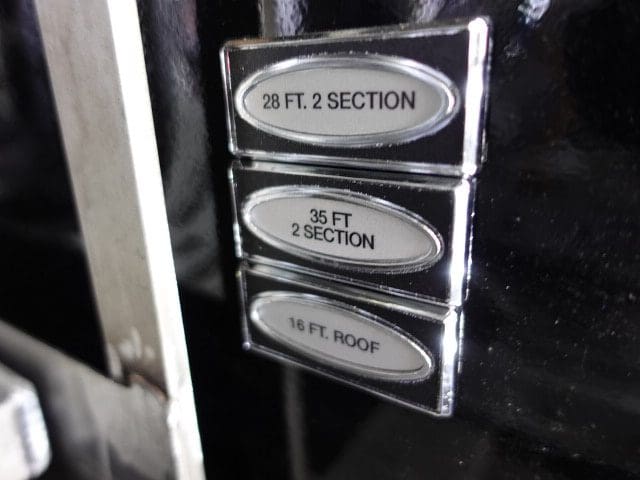

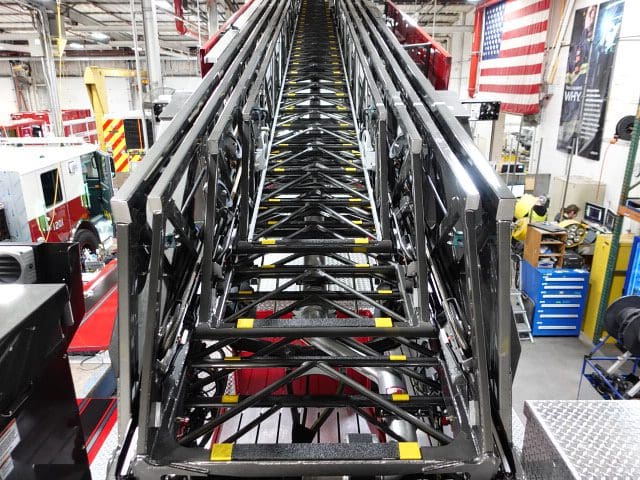

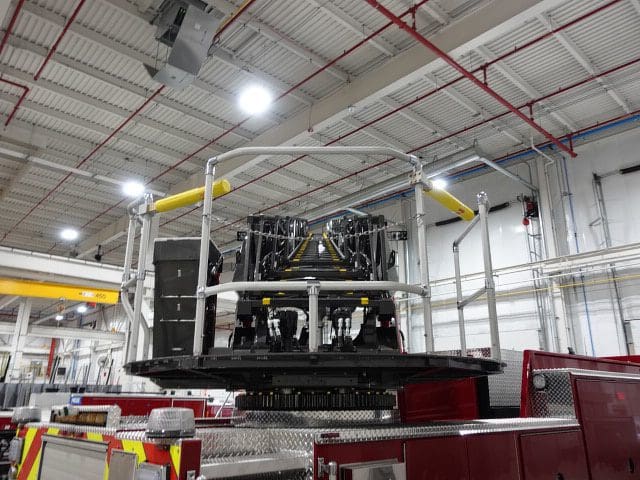

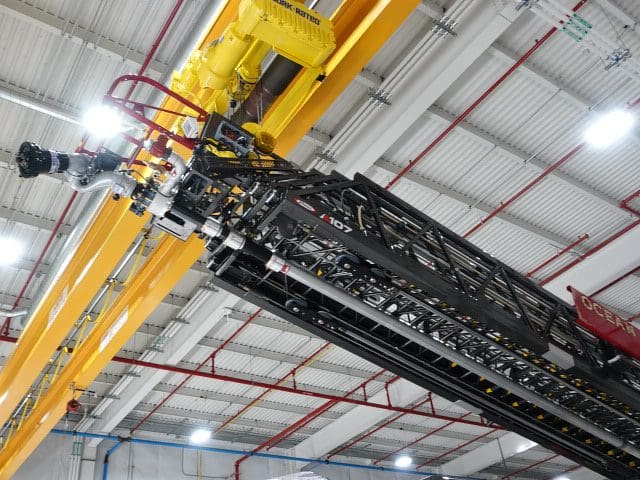

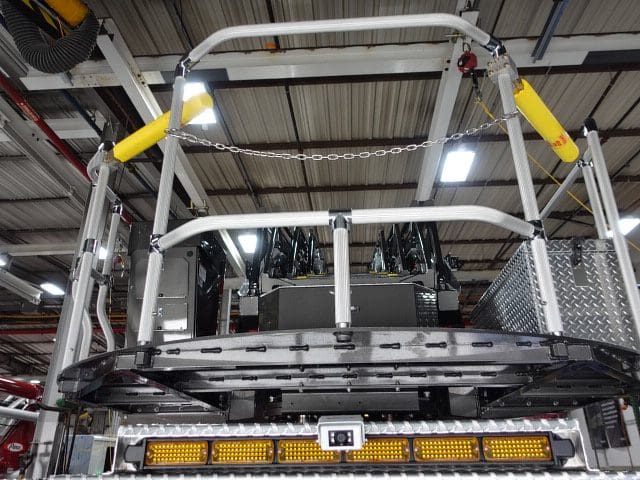

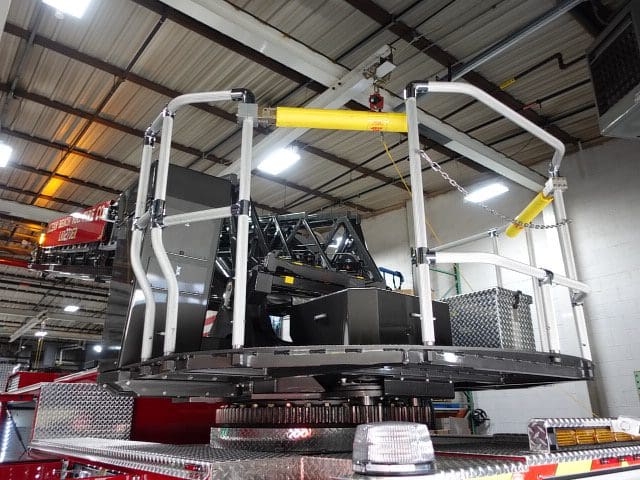

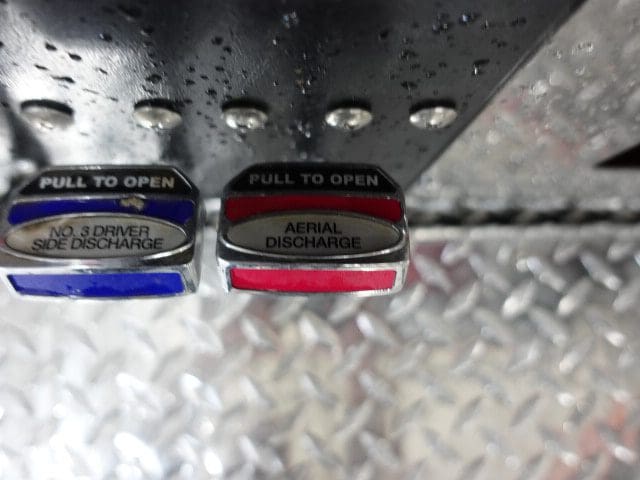

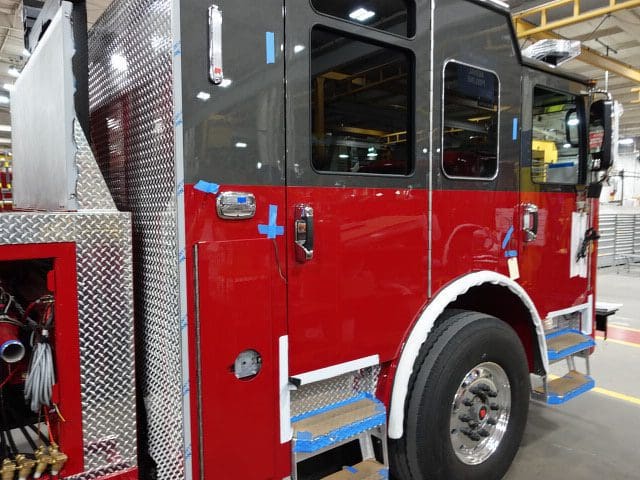

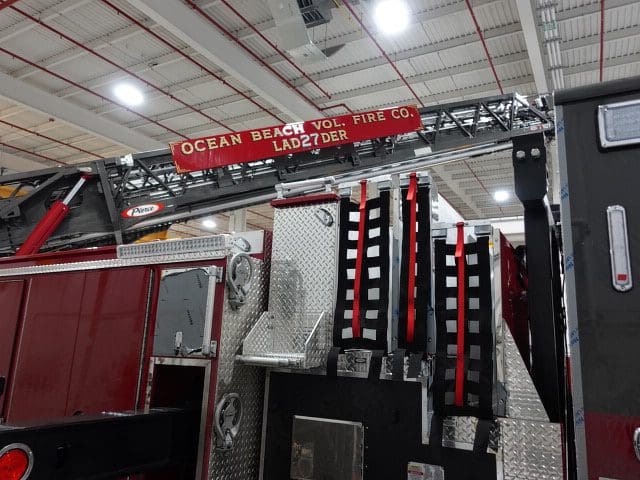

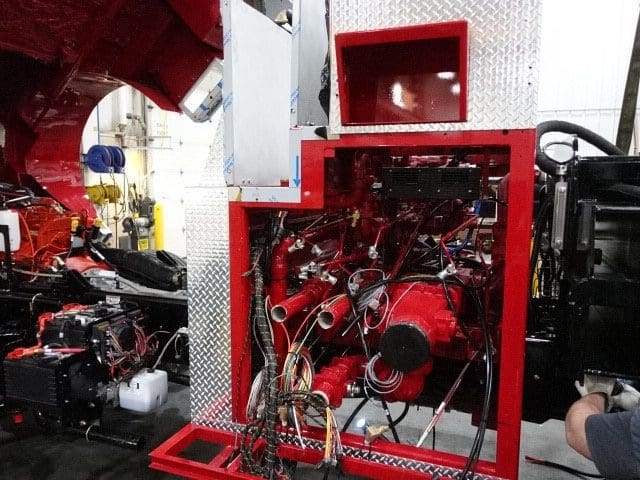

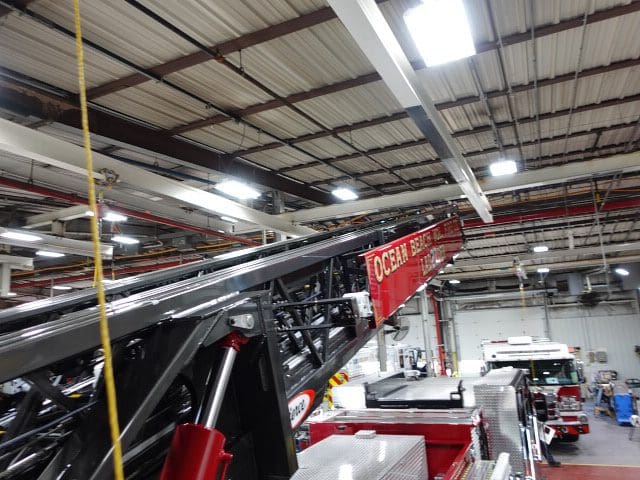

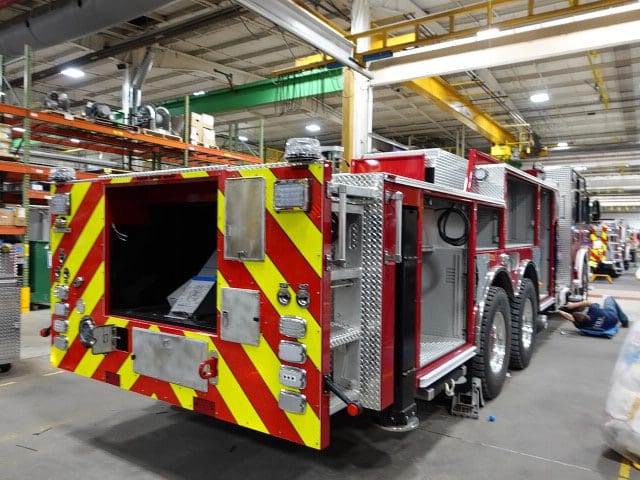

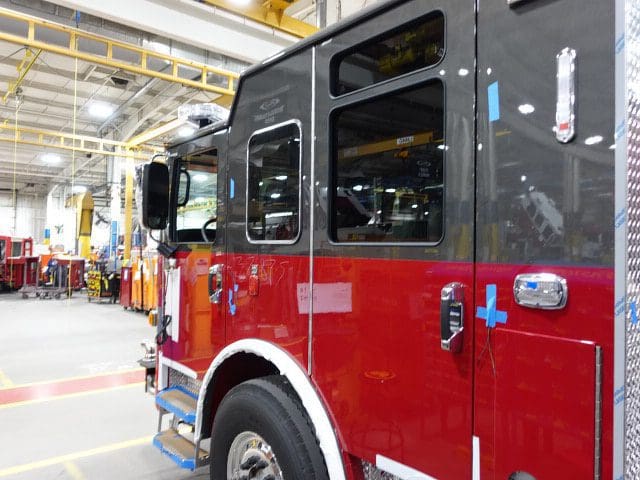

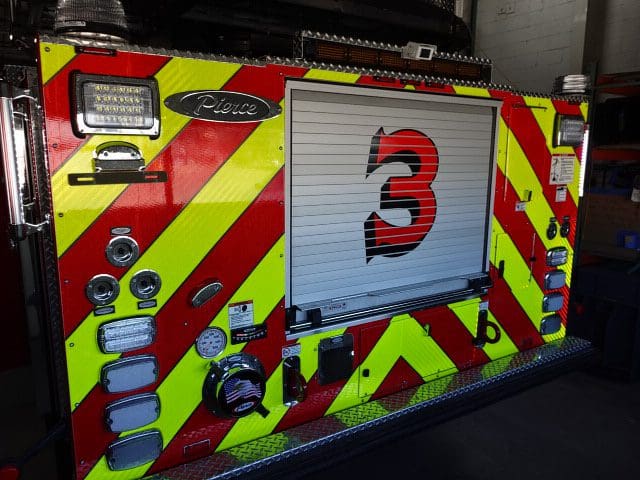

In this report, the aerial testing completed followed by the start of general test.

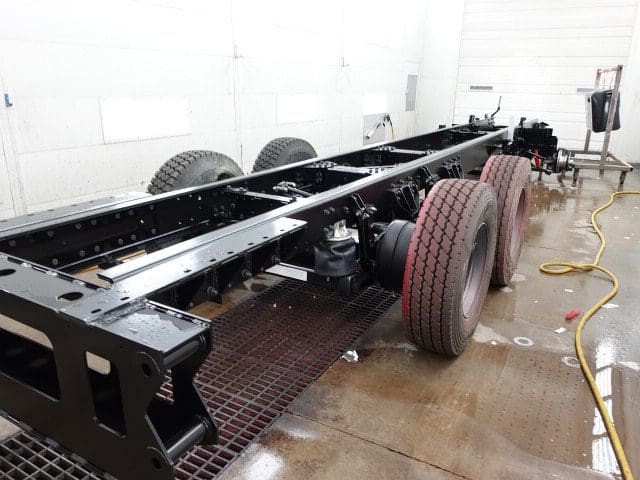

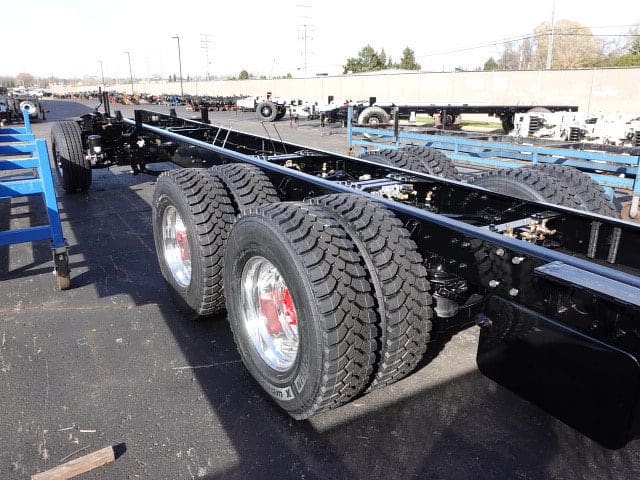

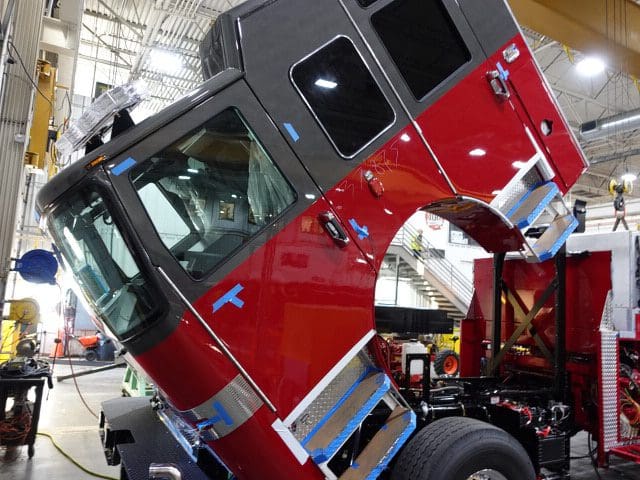

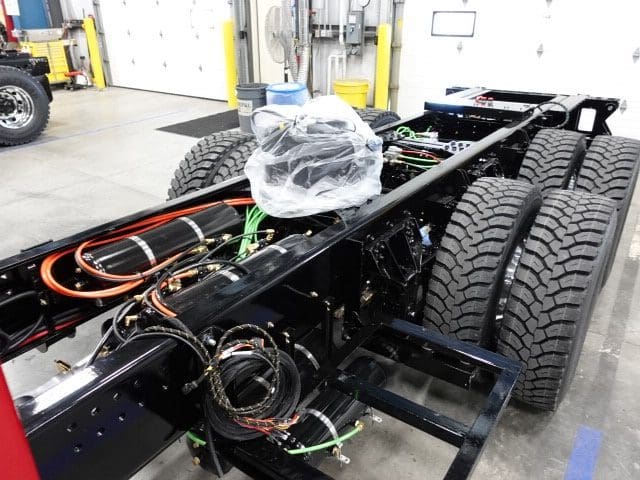

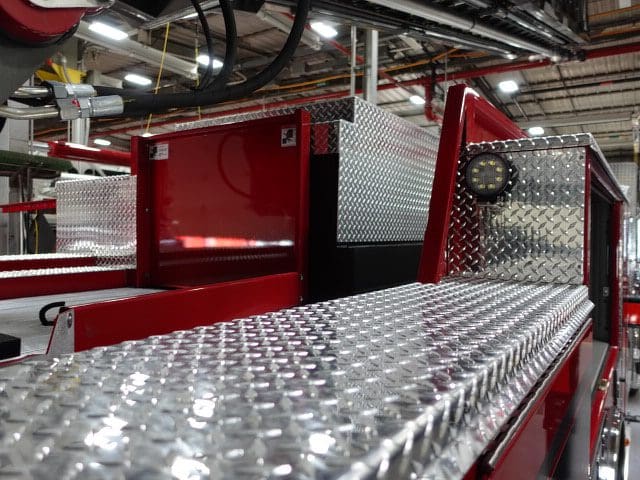

01-12-24

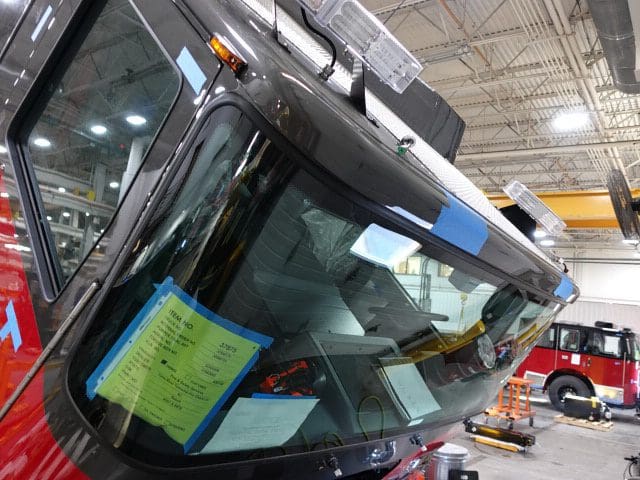

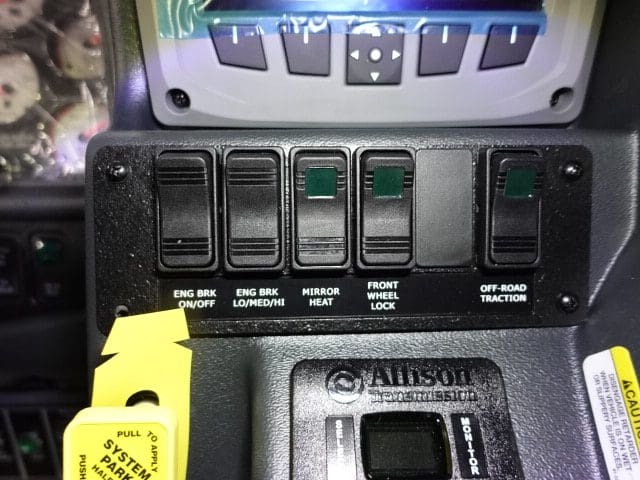

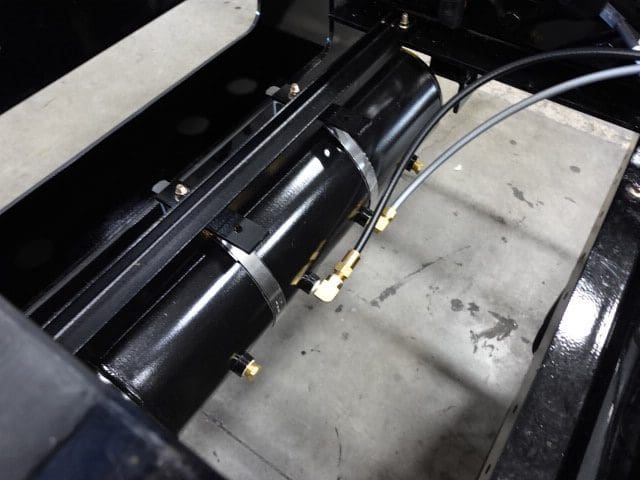

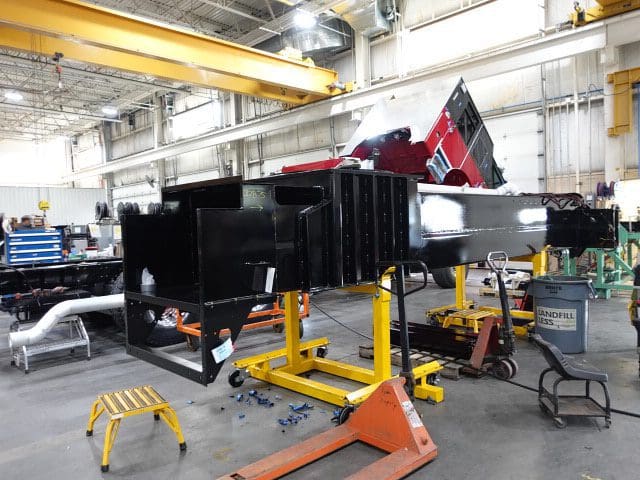

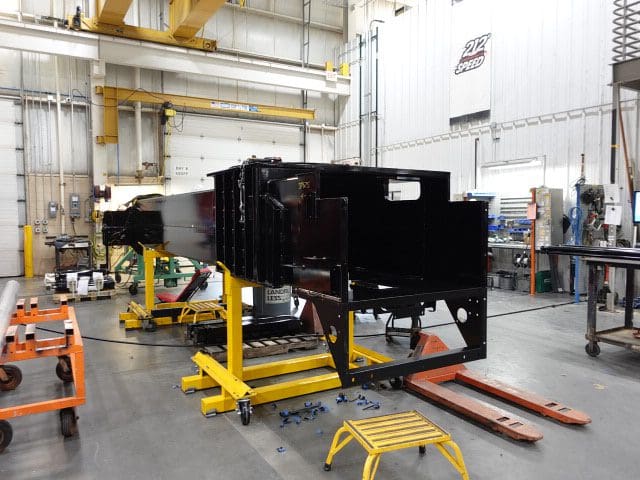

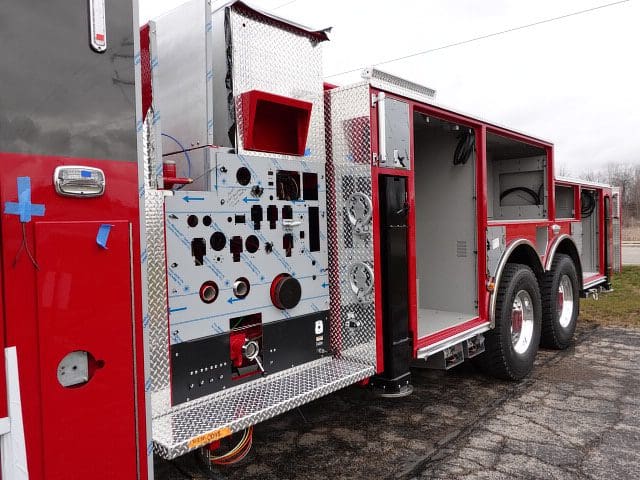

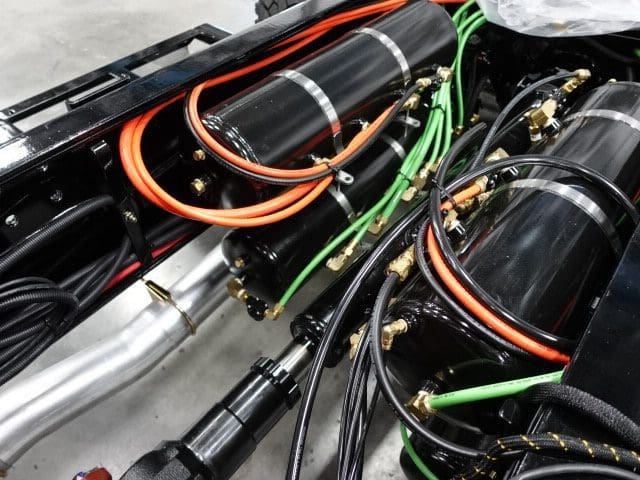

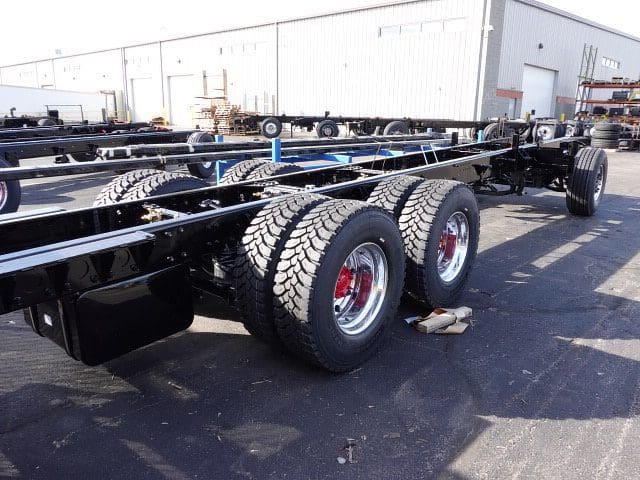

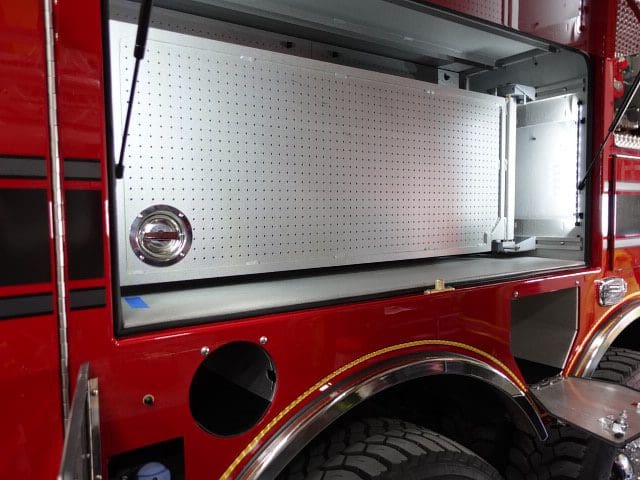

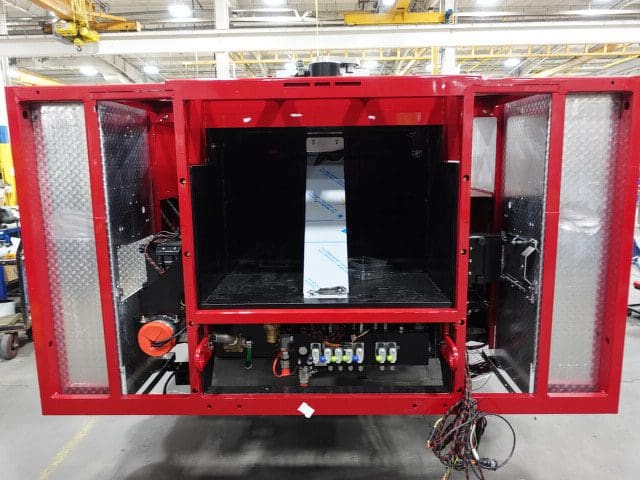

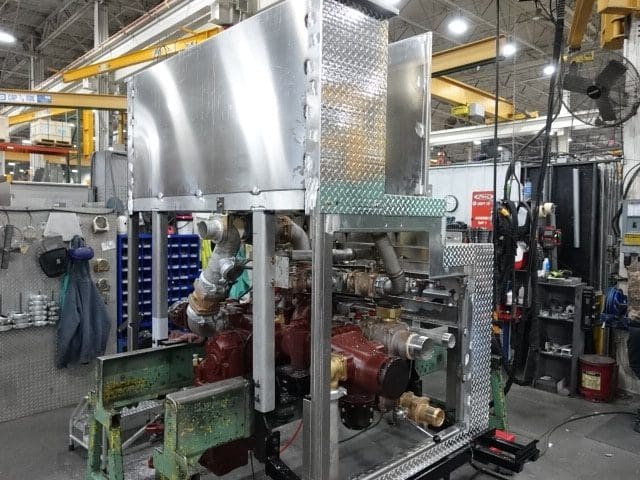

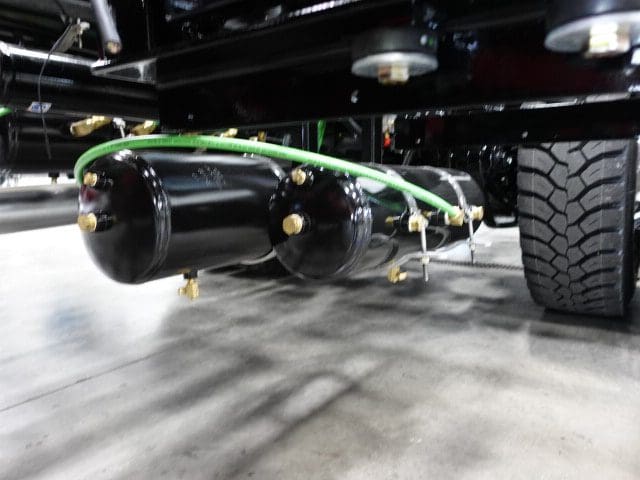

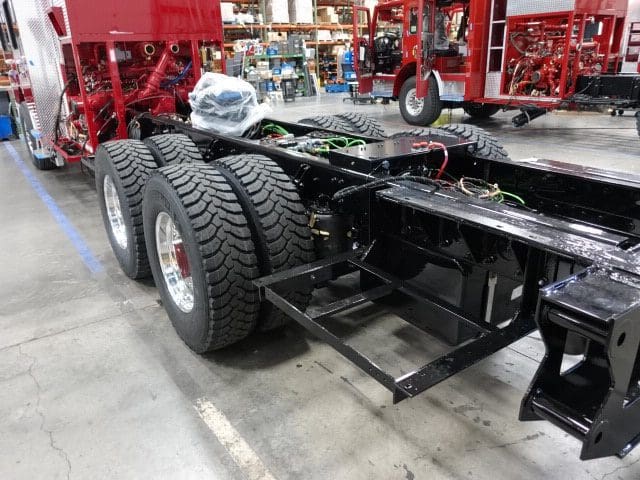

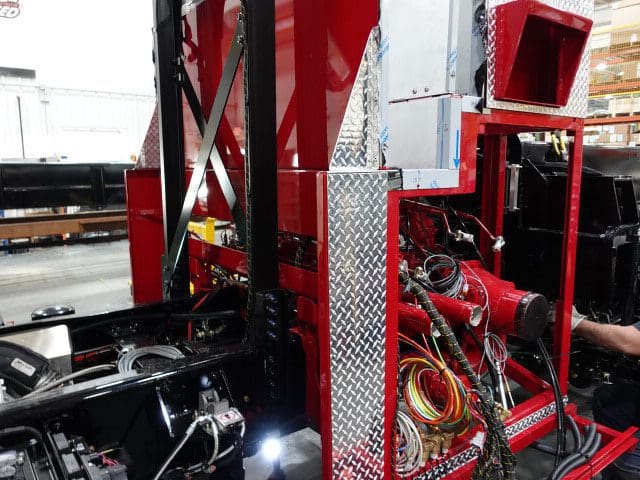

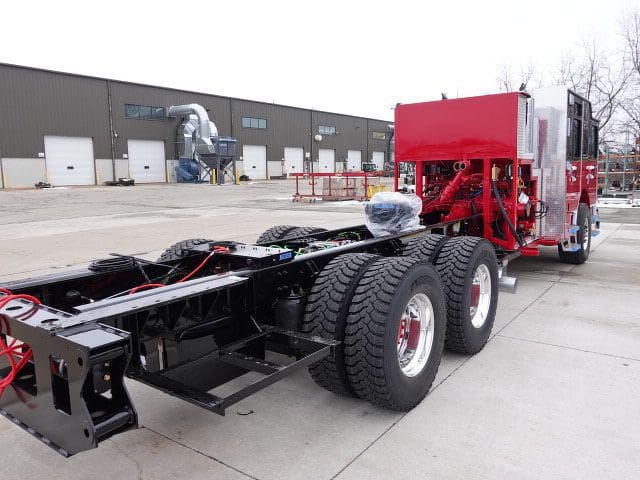

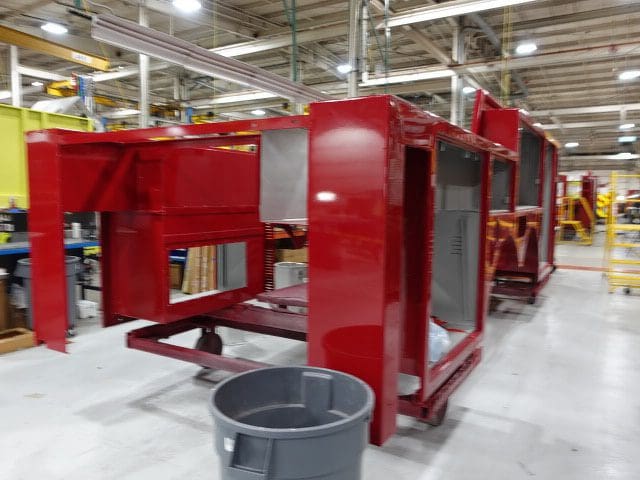

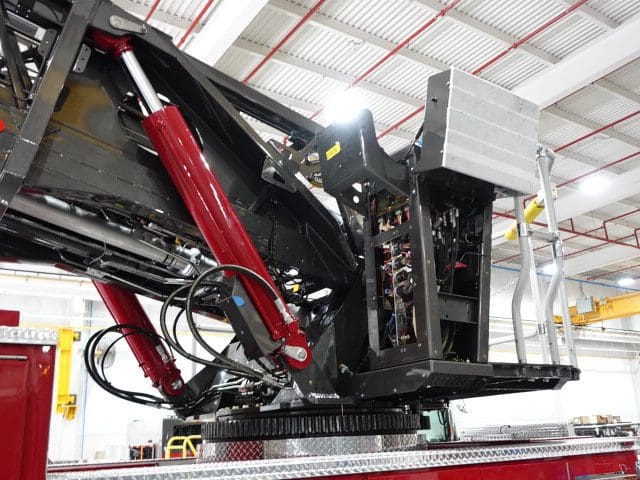

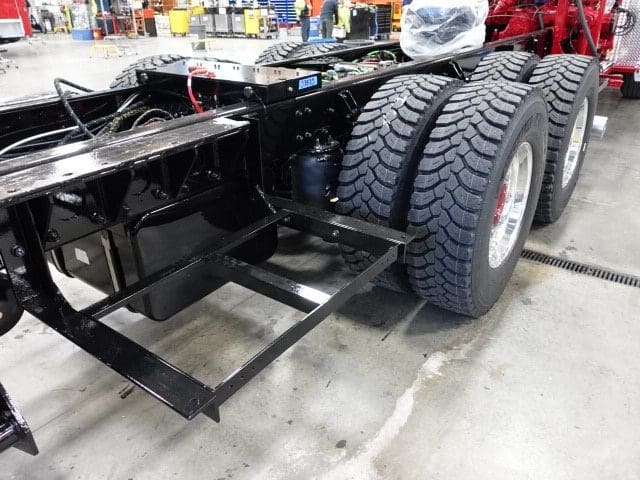

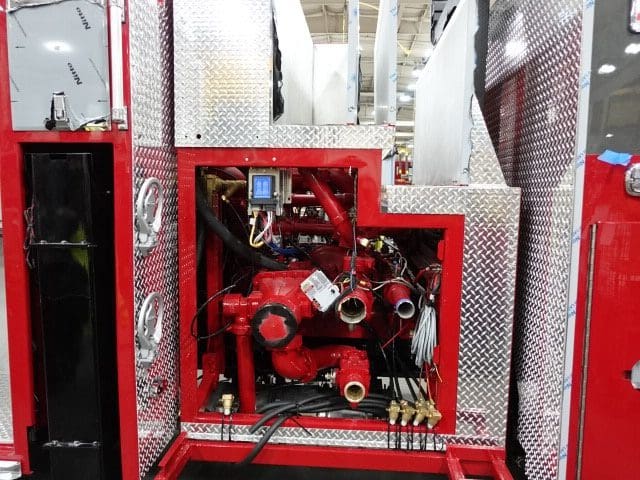

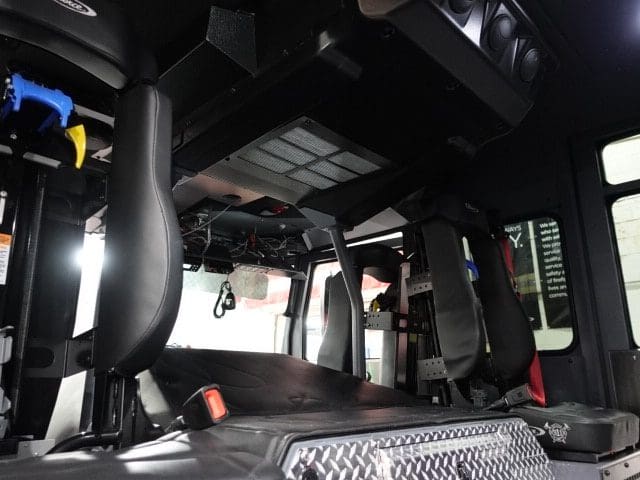

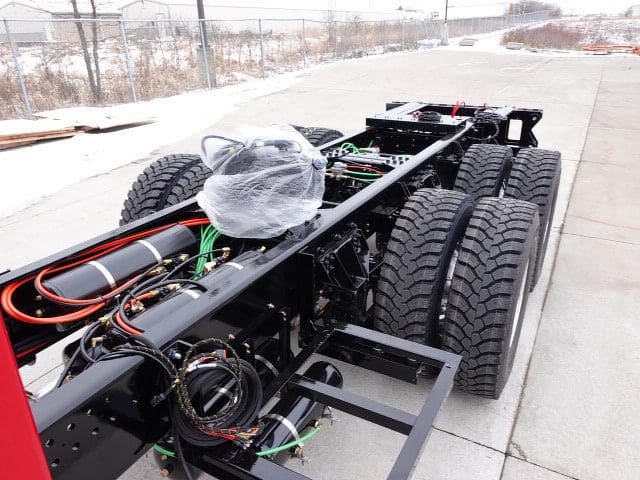

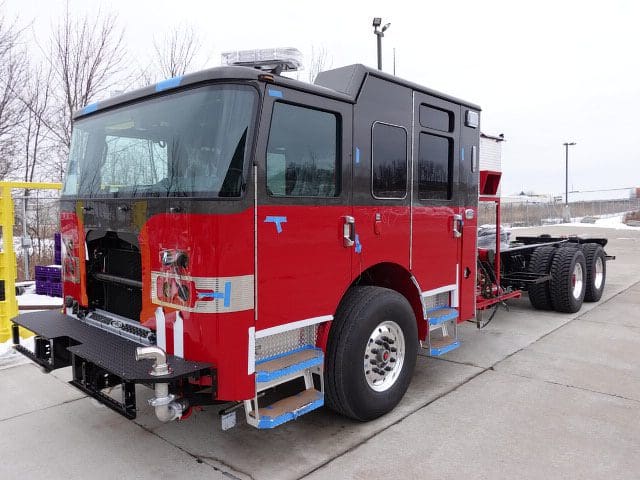

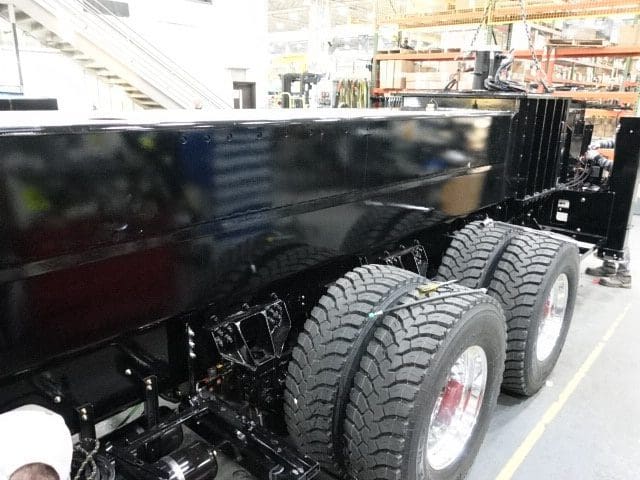

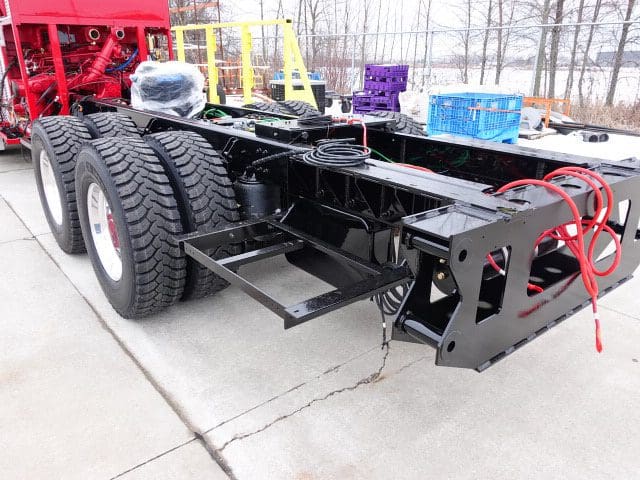

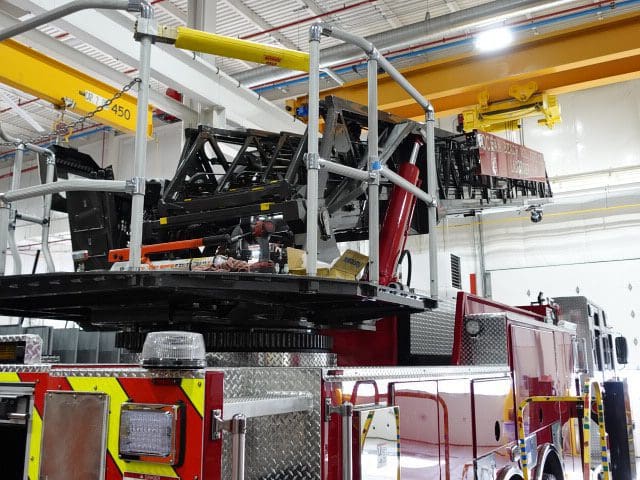

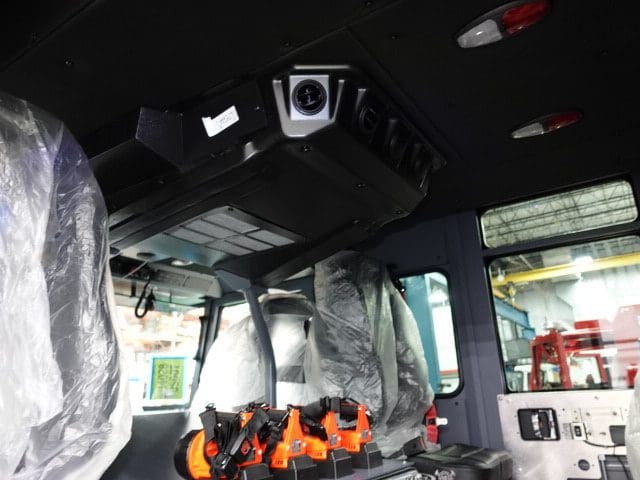

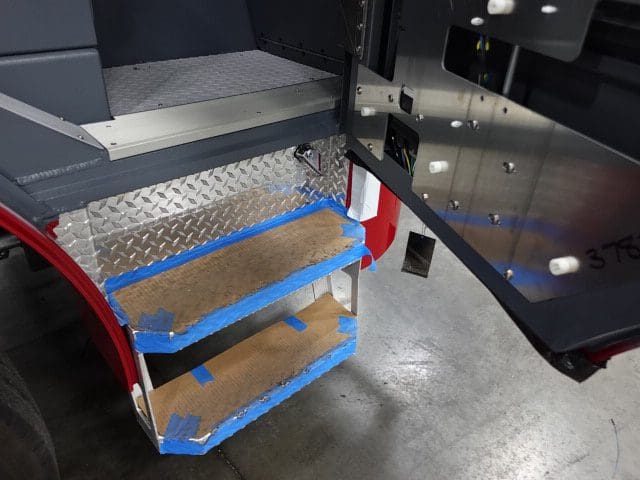

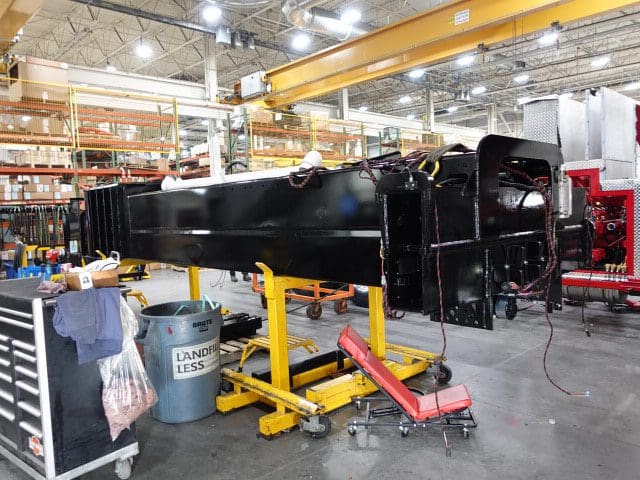

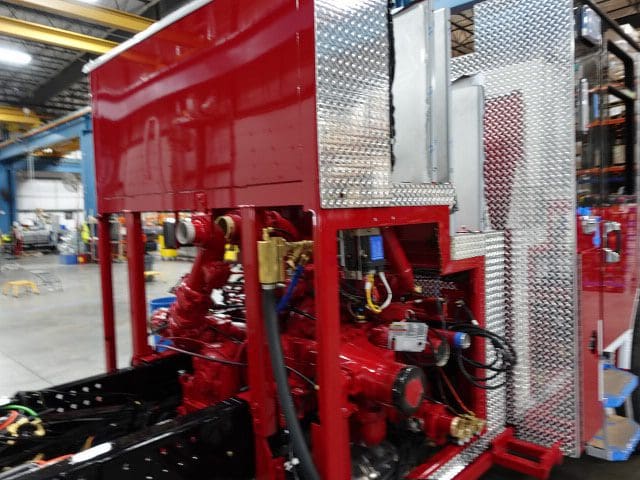

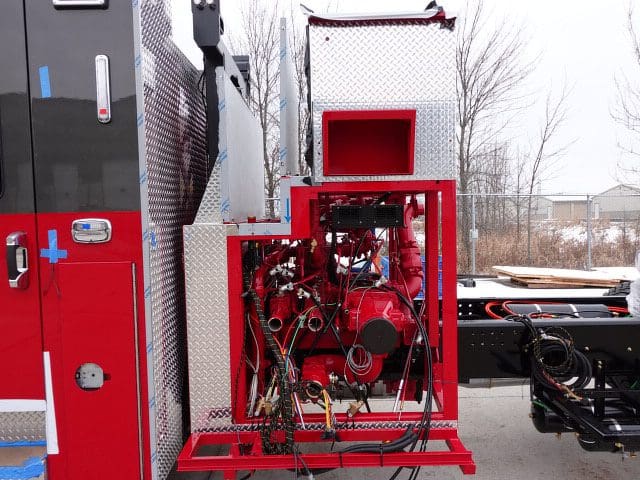

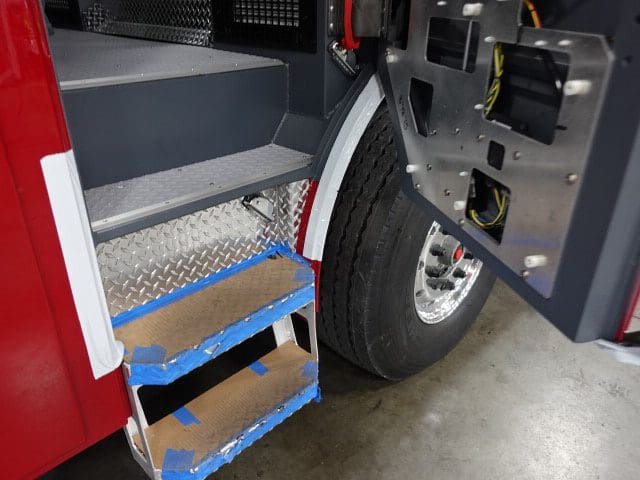

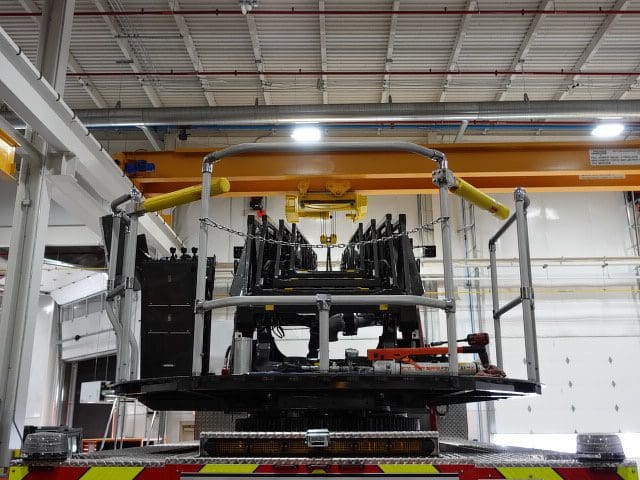

In this report, the apparatus completed initial assembly and began final assembly.
12-22-23

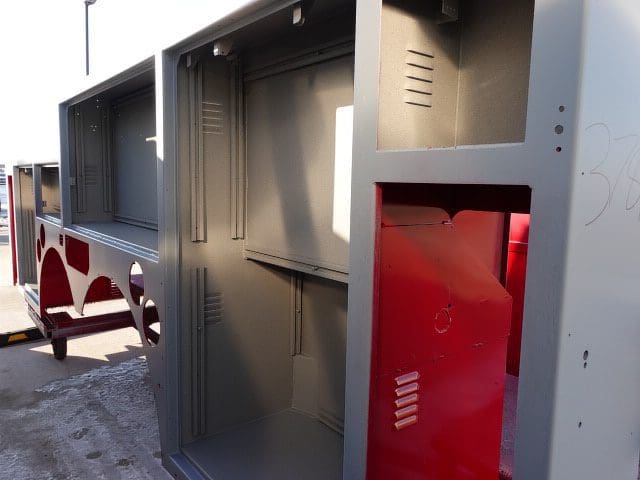

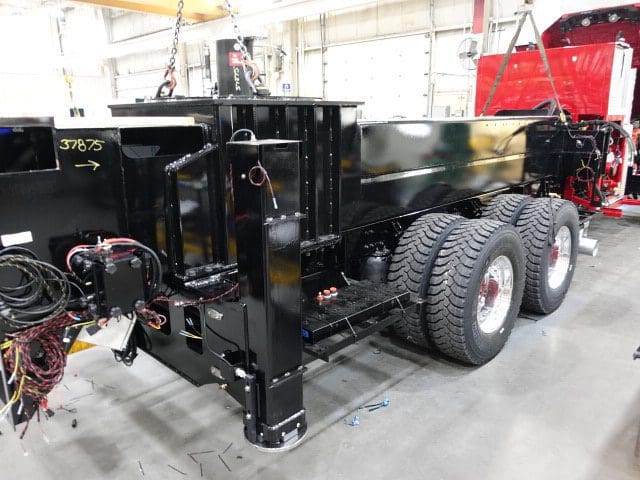

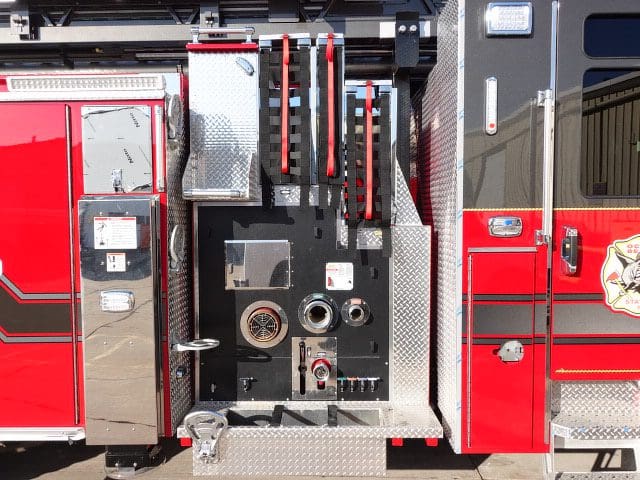

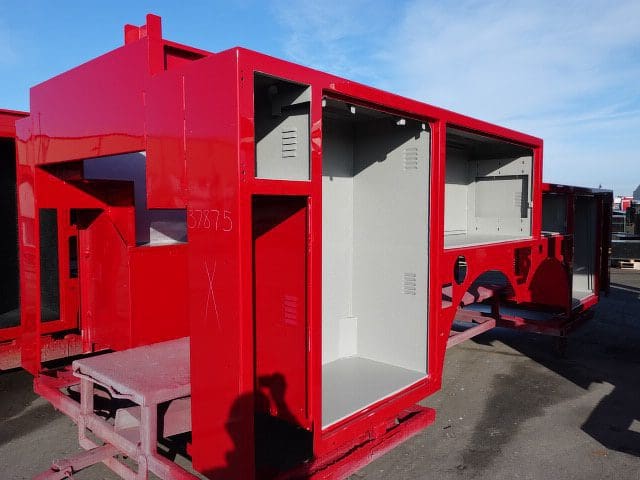

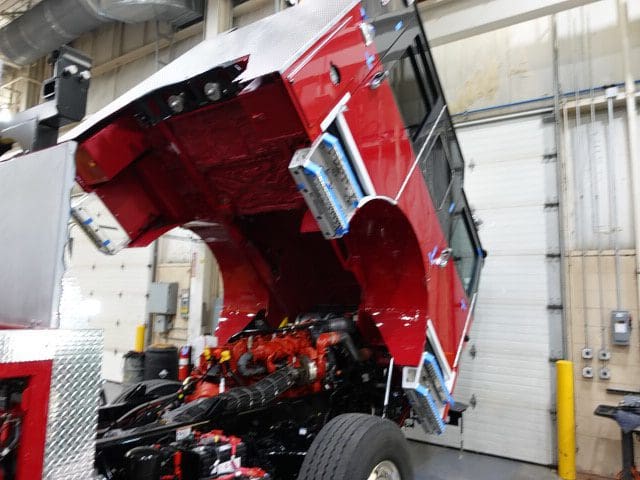

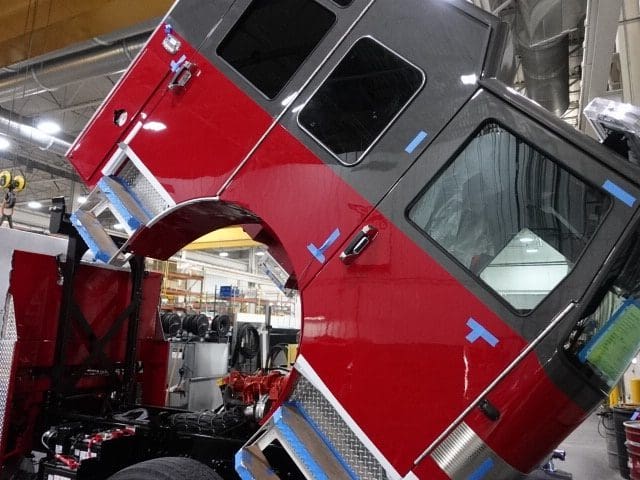

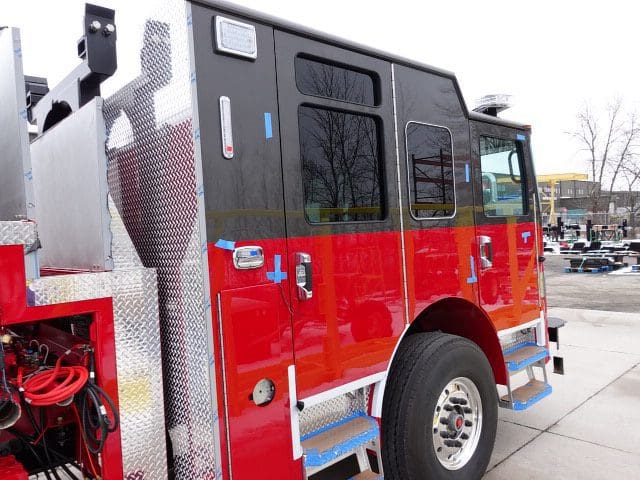

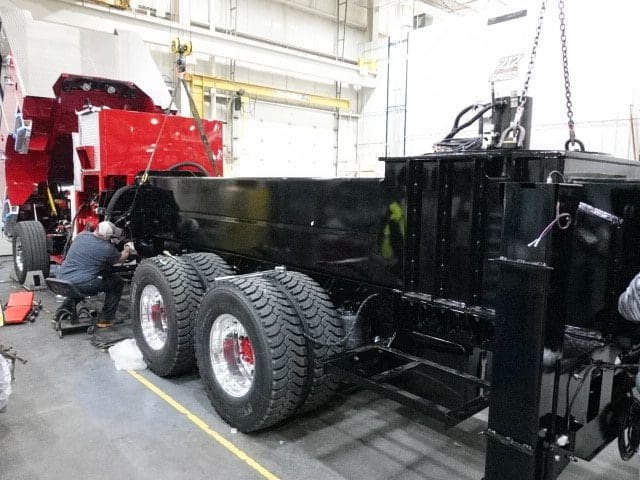

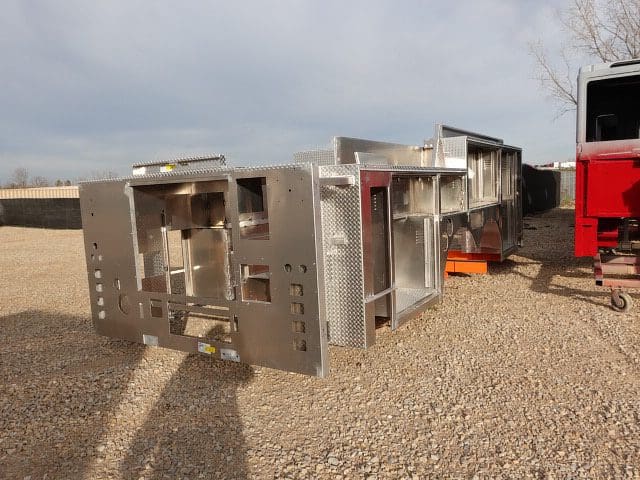

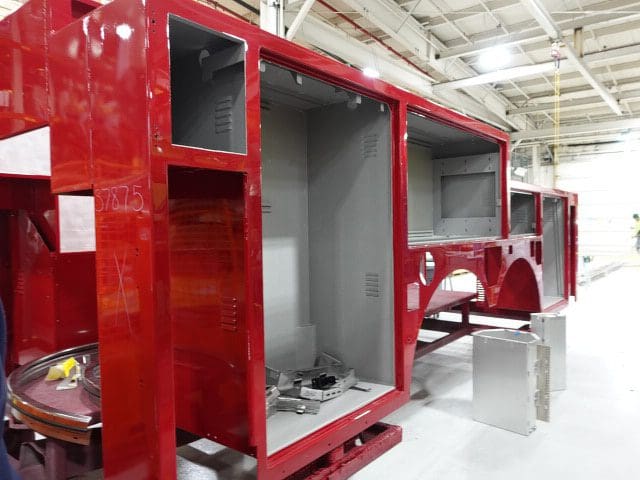

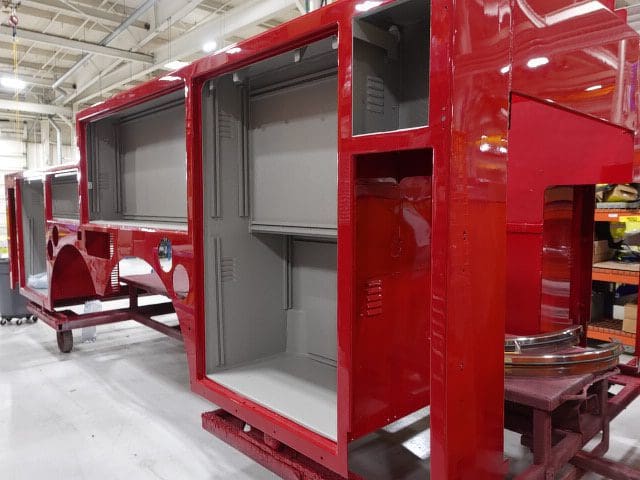

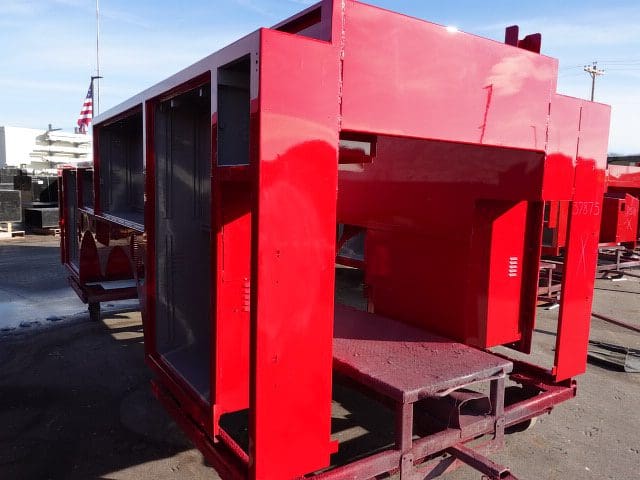

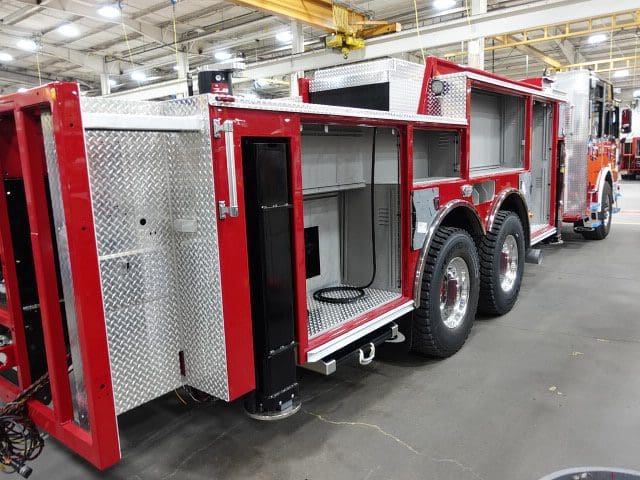

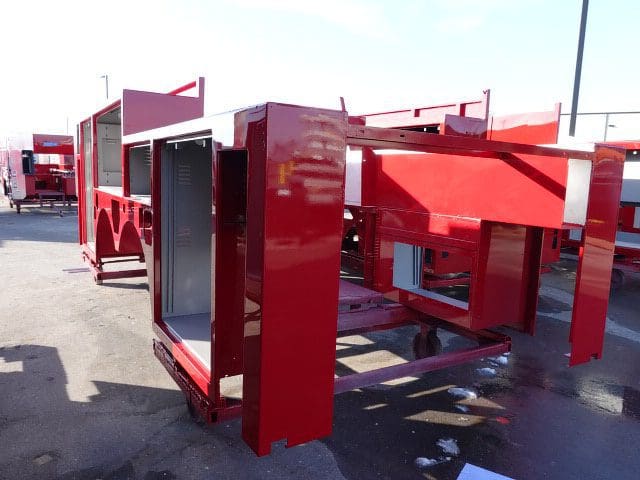

In this report, the body completed initial assembly and was merged with the chassis.

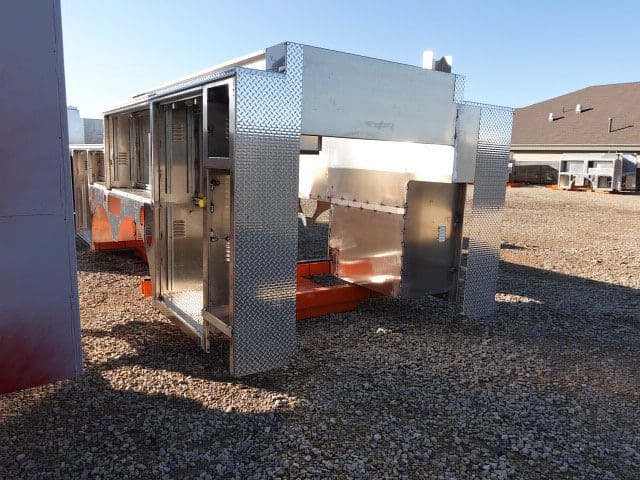

12-15-23

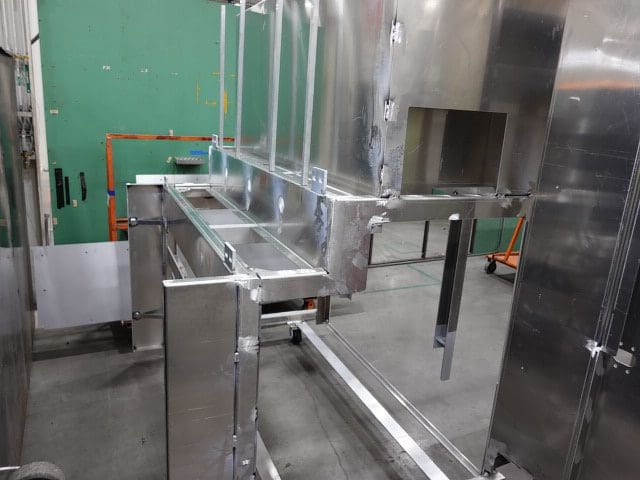

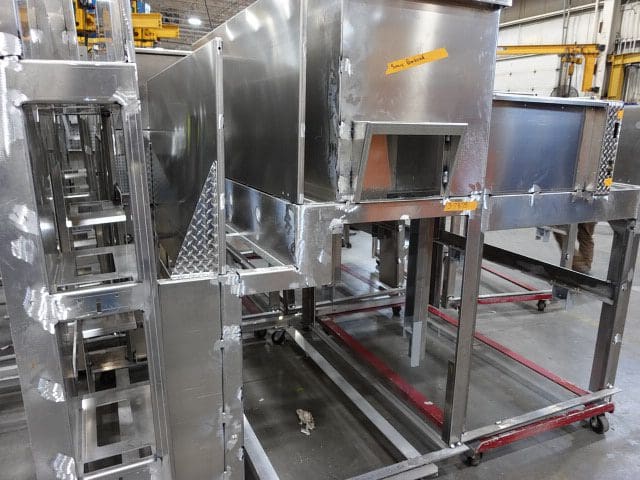

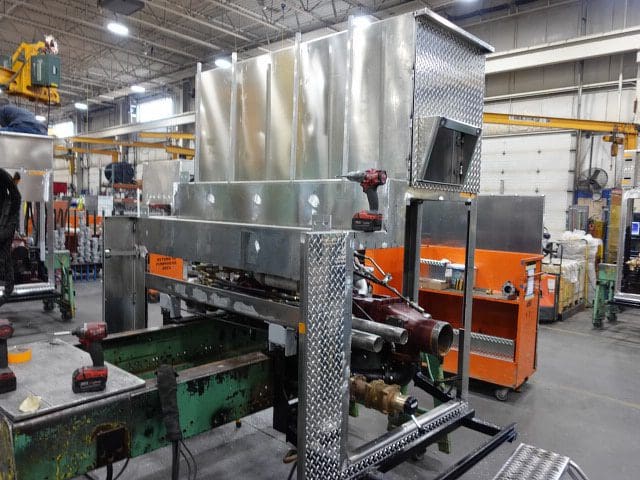

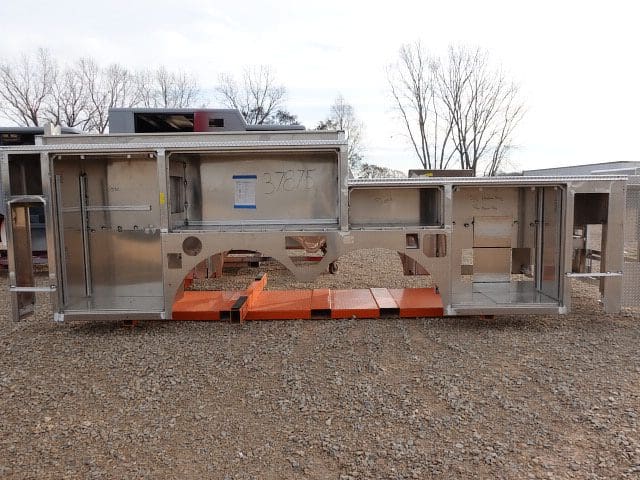

In this report, the torque box was being installed on the chassis while the body began initial assembly.

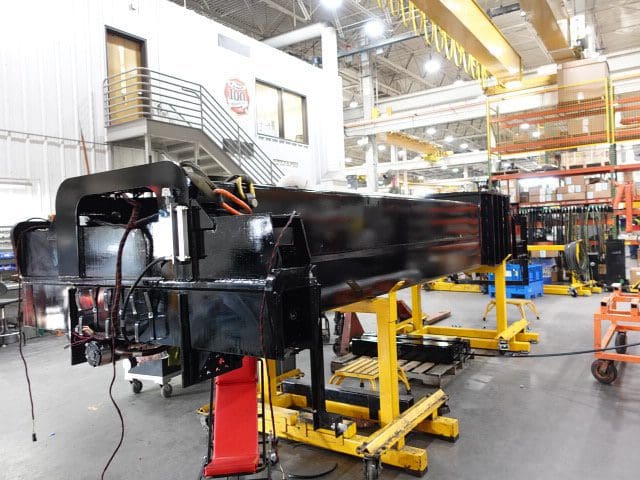

12-08-23

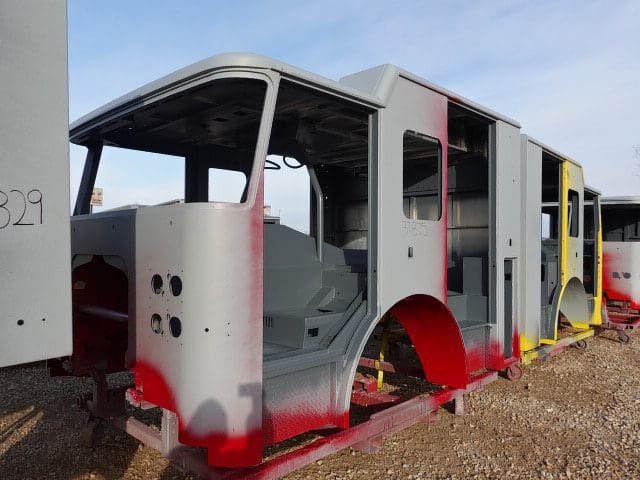

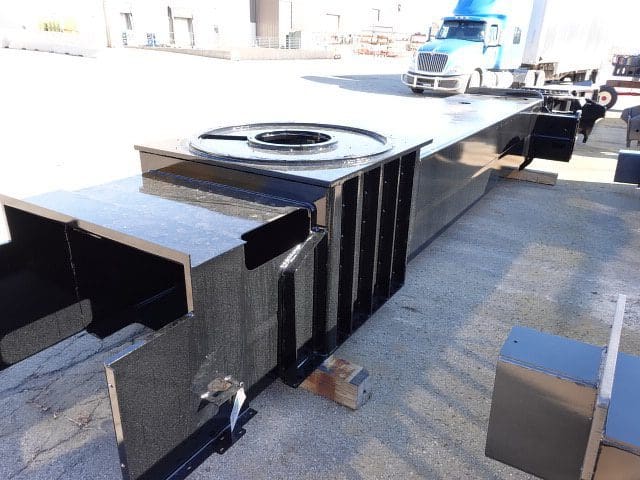

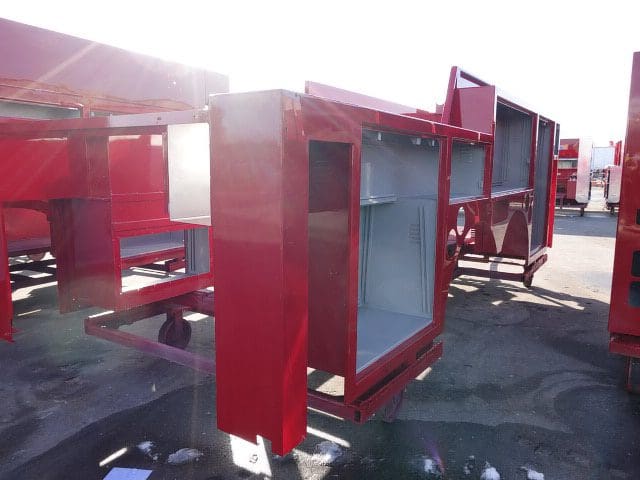

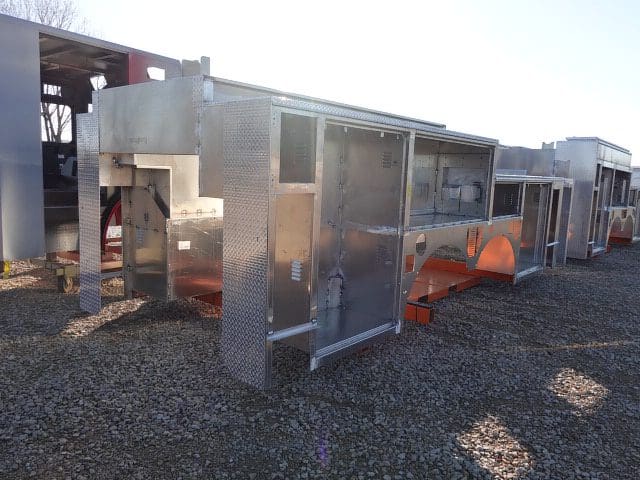

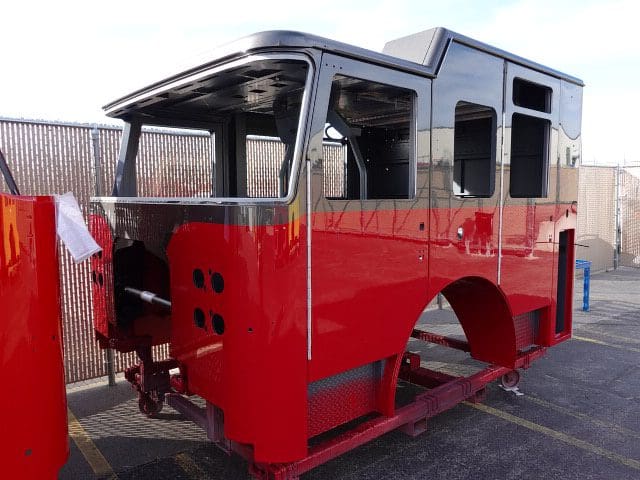

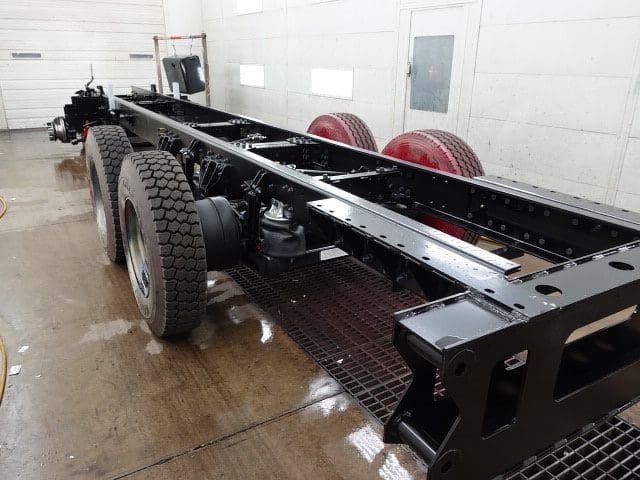

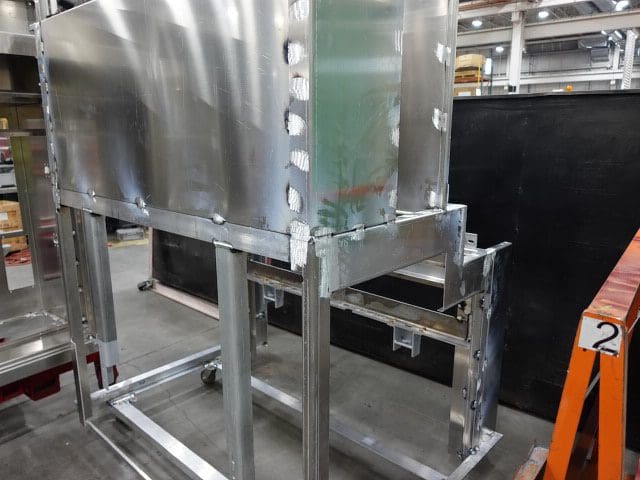

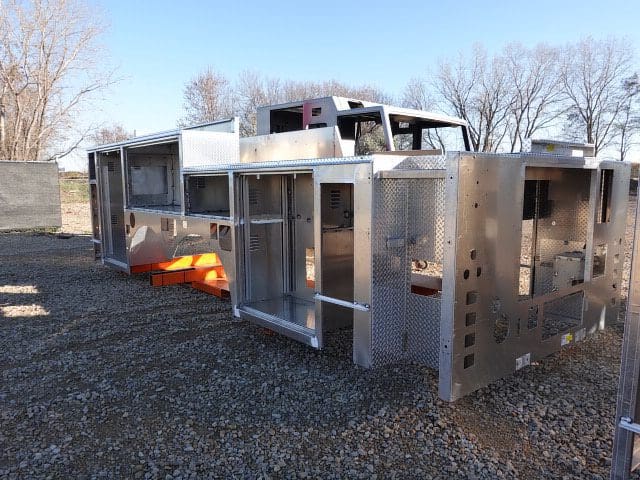

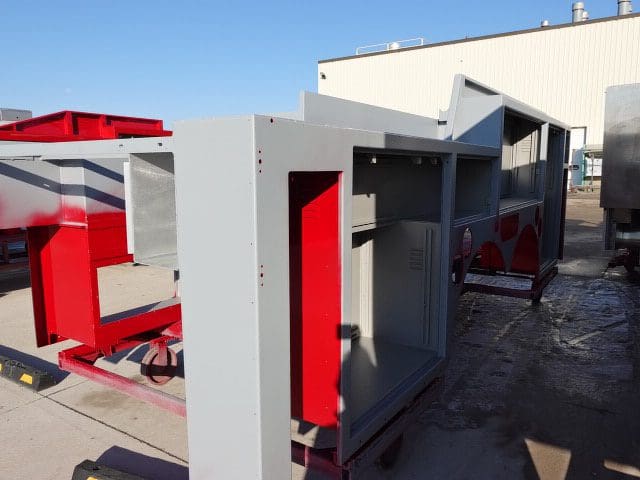

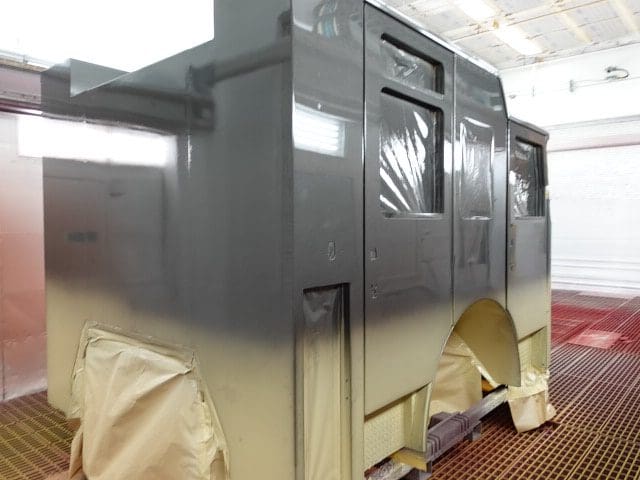

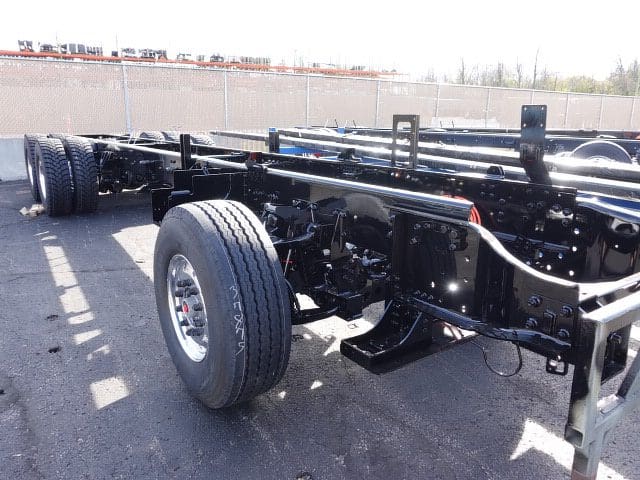

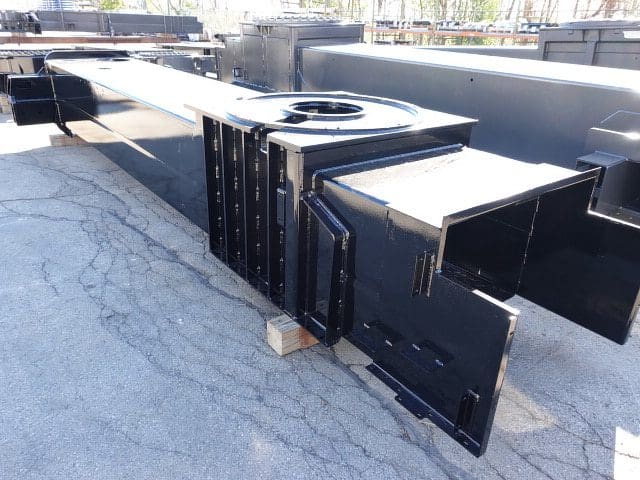

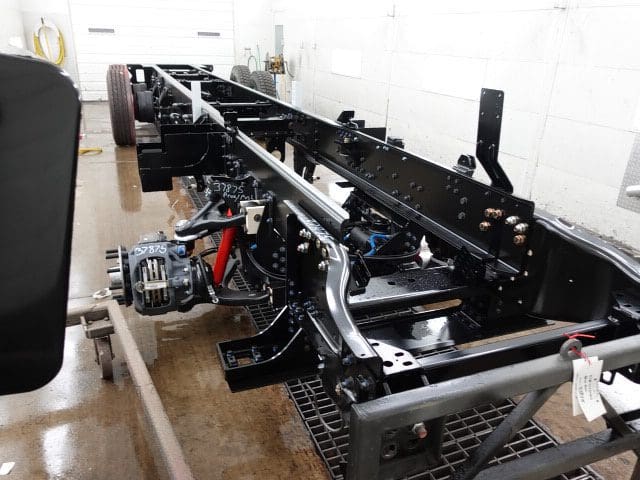

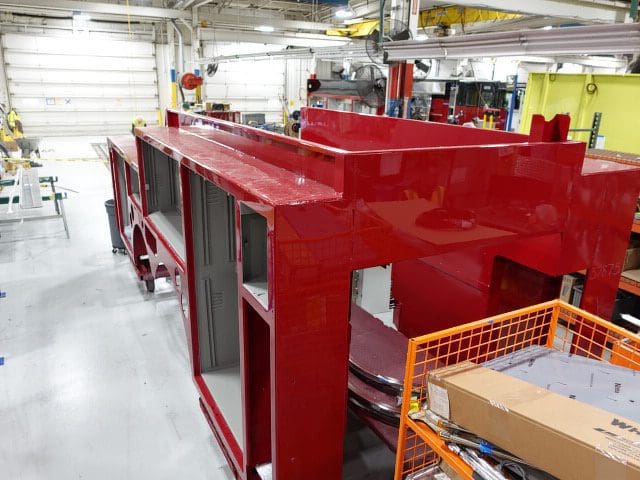

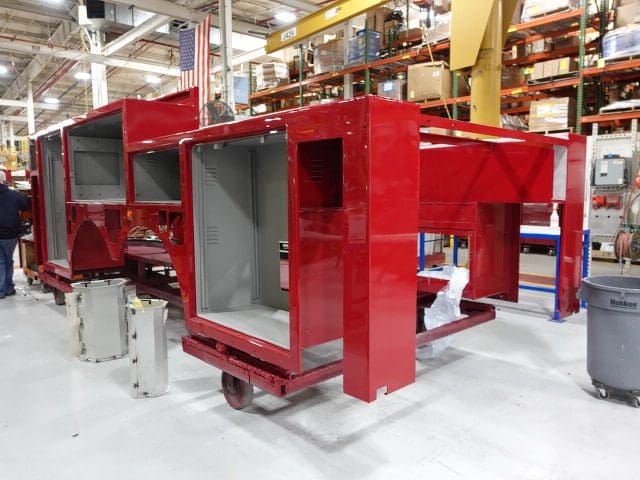

In this report, the chassis was staged to continue assembly, the torque box began initial assembly, and the body completed paint and was staged.
12-01-23

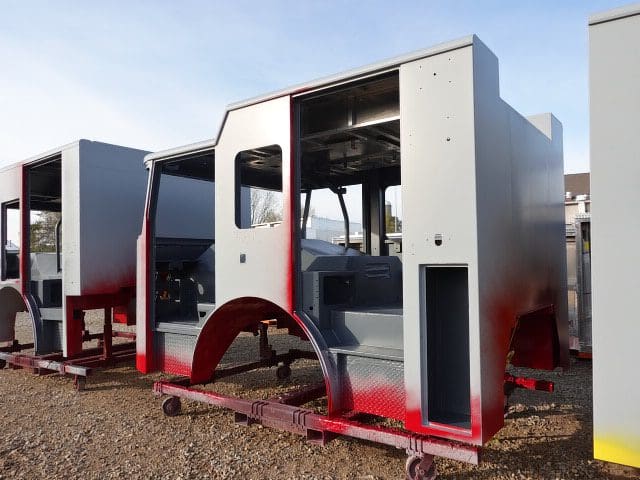

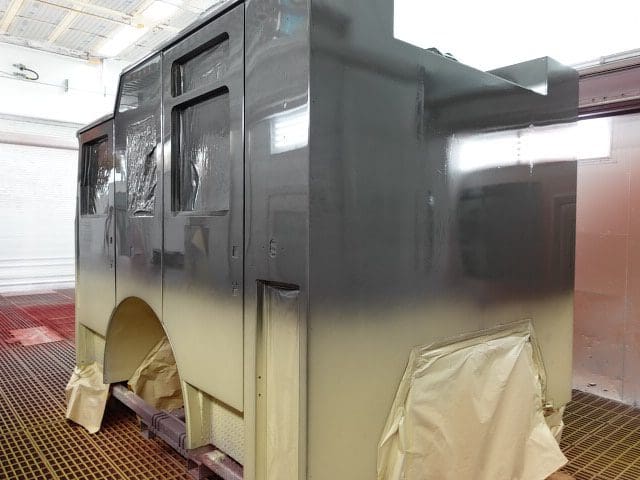

In this report, the cab and pump house were installed on the frame, the torque box remained staged (no photos), and the body began the paint process.
11-17-23
In this report, the cab completed paint, the frame build continued, the pump house began initial assembly, the torque box remained staged (no photos), and the body remained staged.
11-10-23

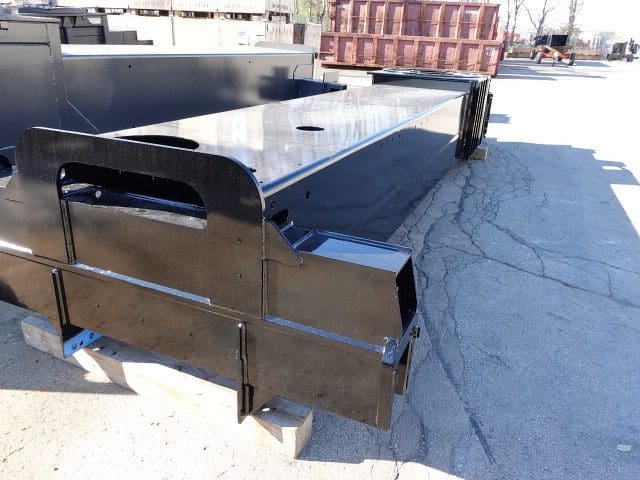

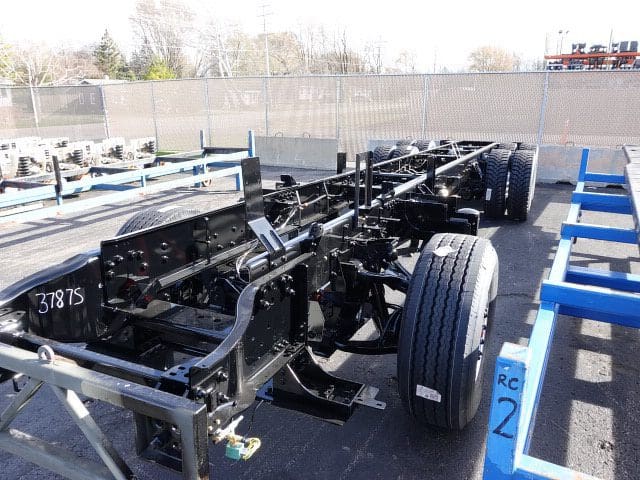

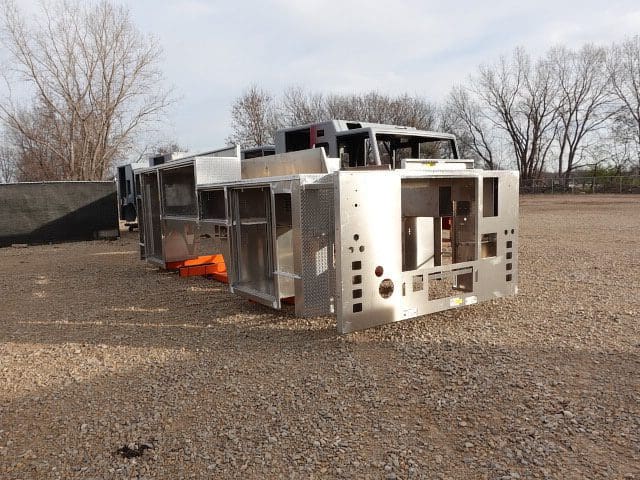

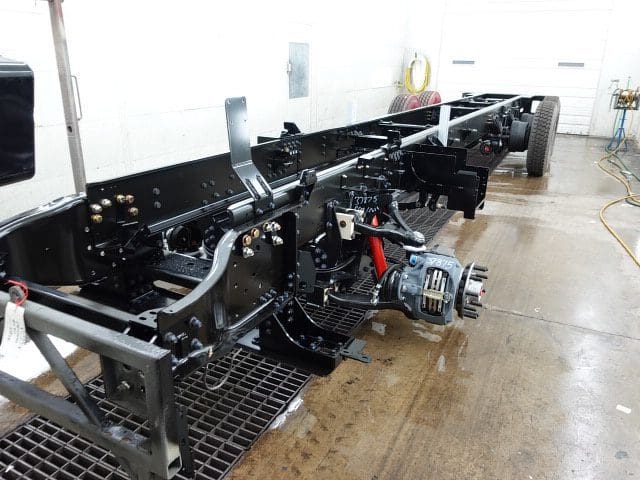

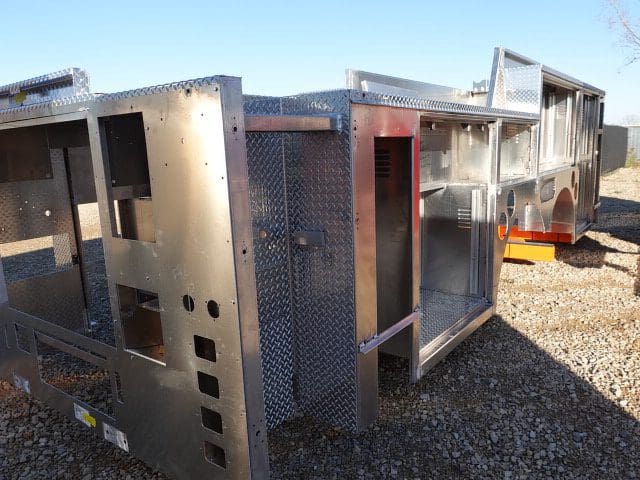

In this report, the cab continued through paint, the frame build began, the pump house structure remained staged, the torque box was staged, and the body was fabricated then staged.
11-03-23

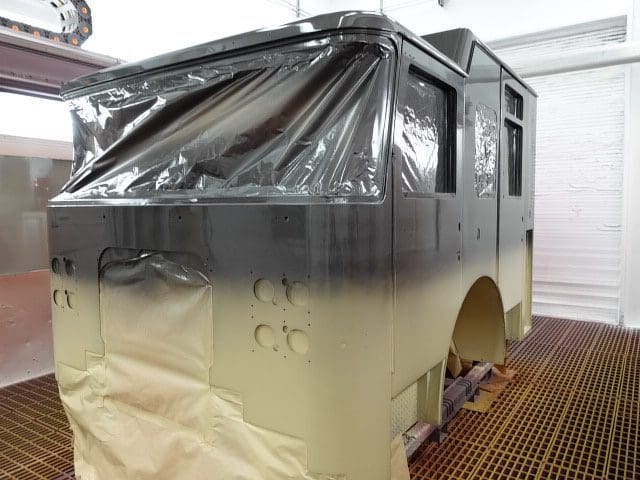

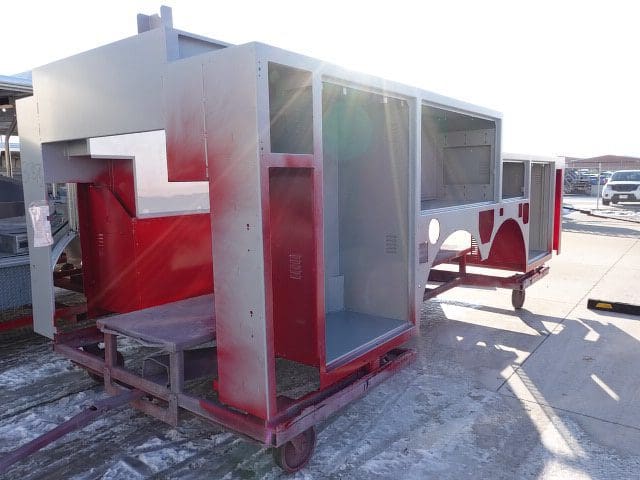

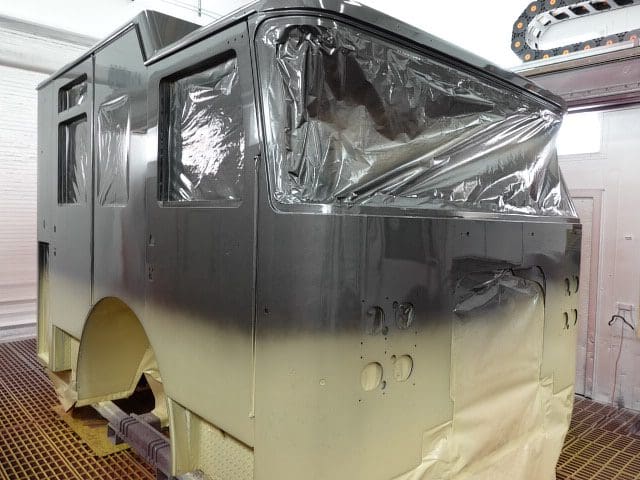

In this report, the cab began the paint process while the pump house structure remained staged.
