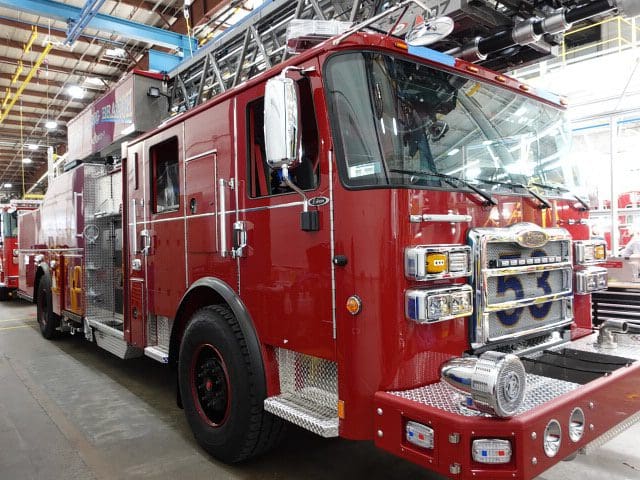

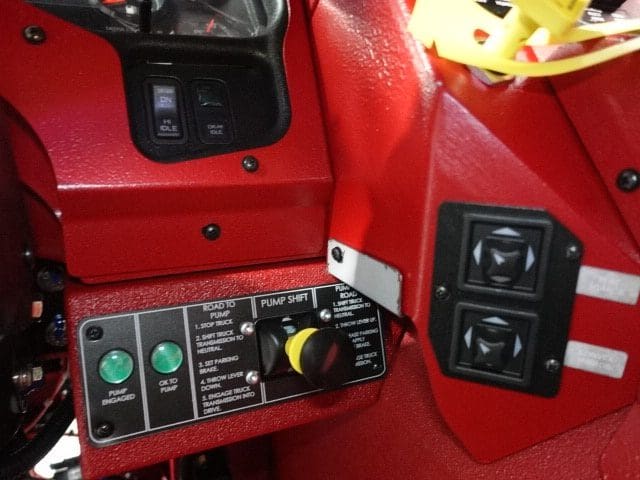

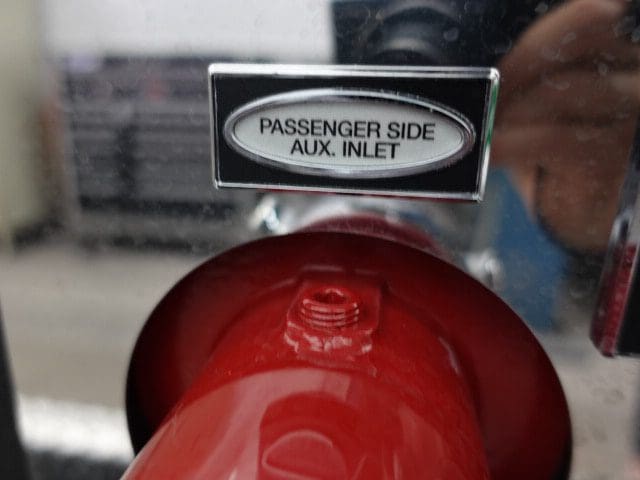

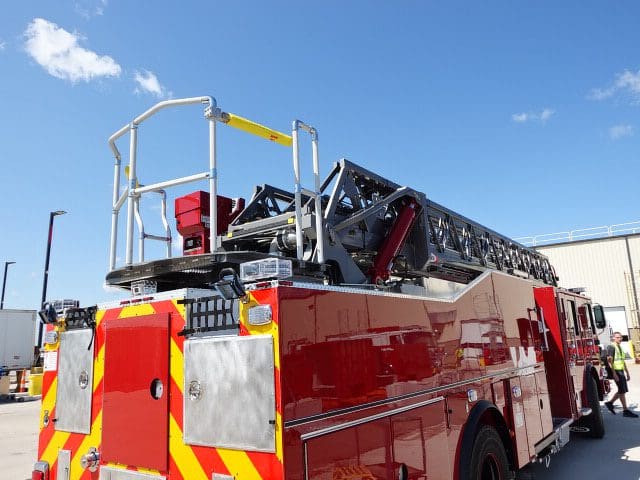

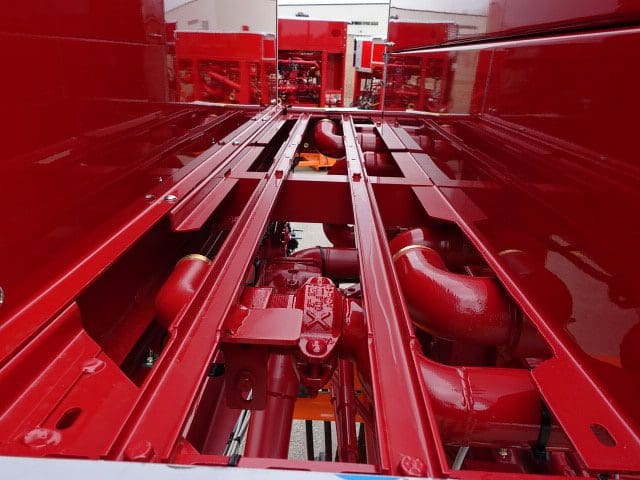

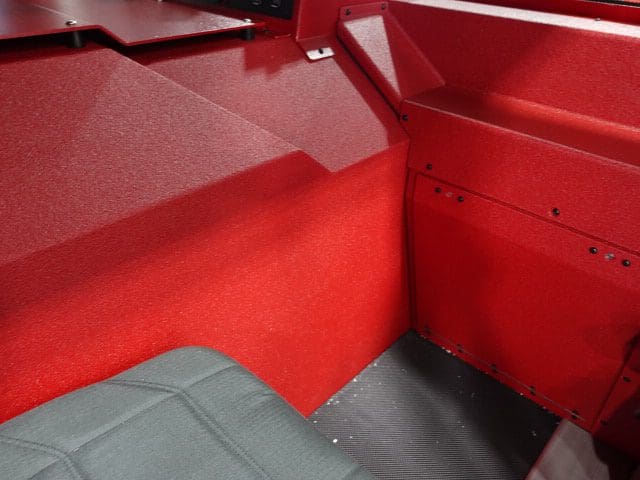

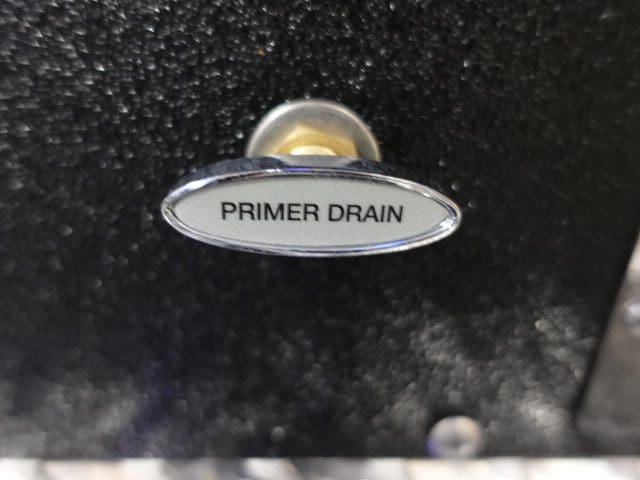

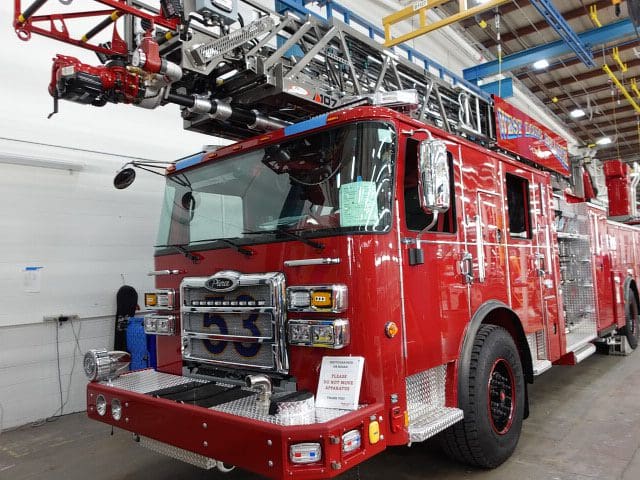

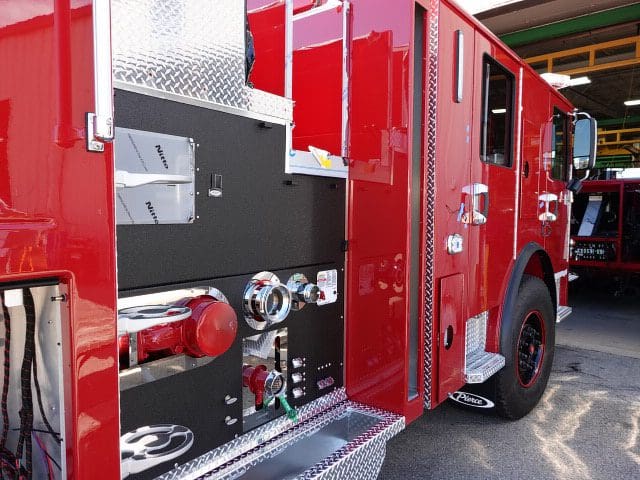

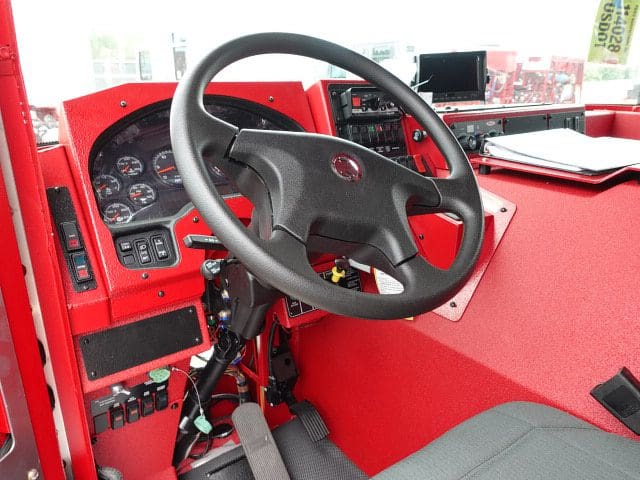

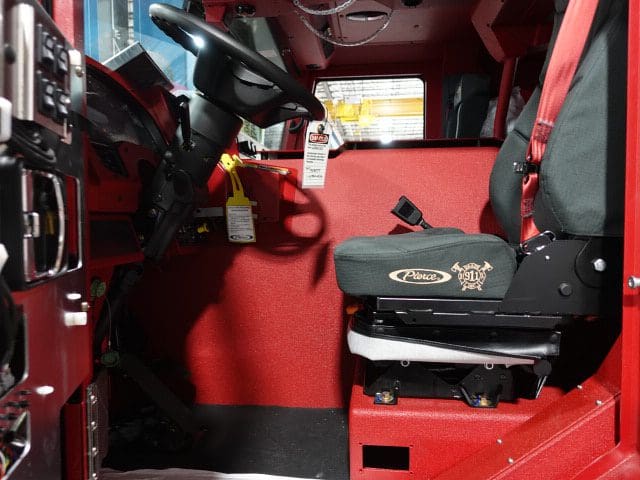

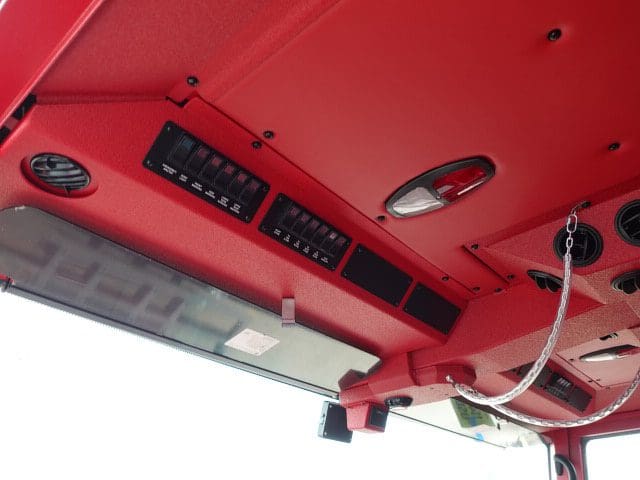

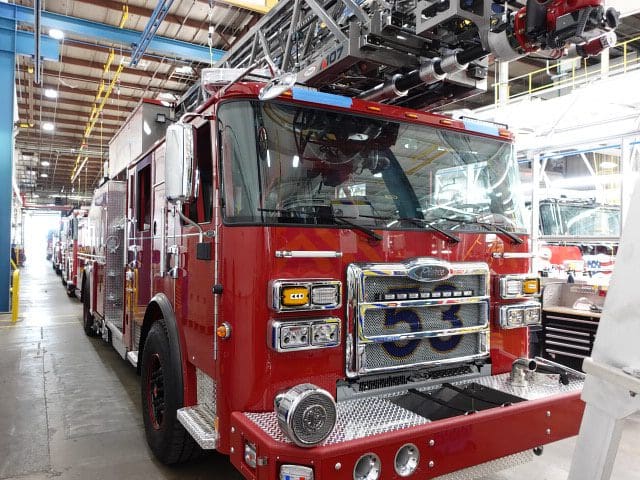

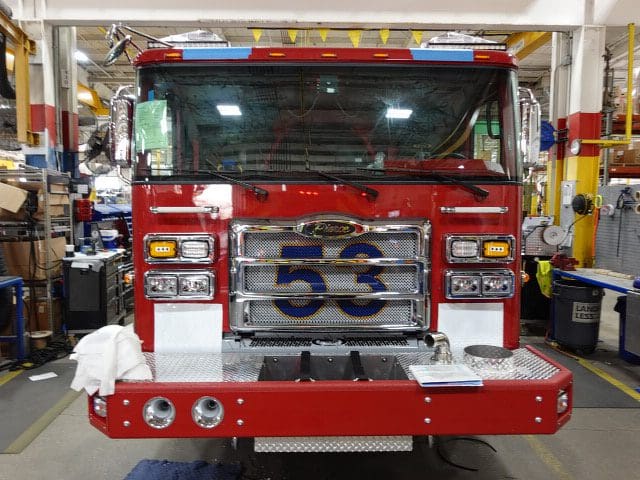

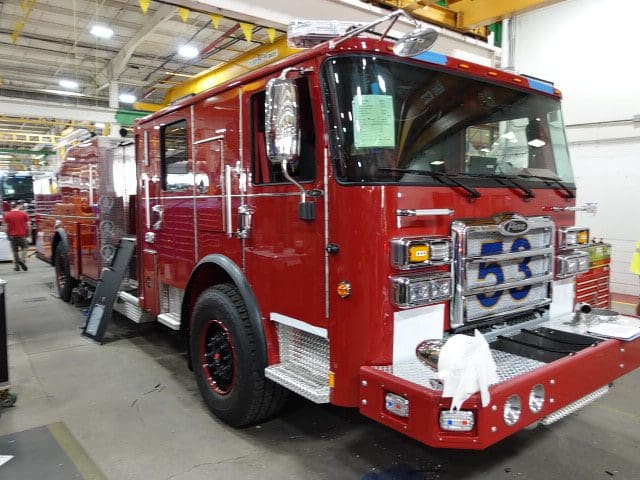

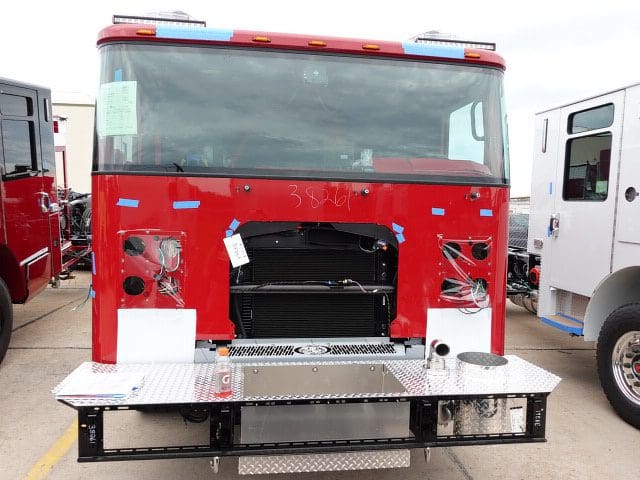

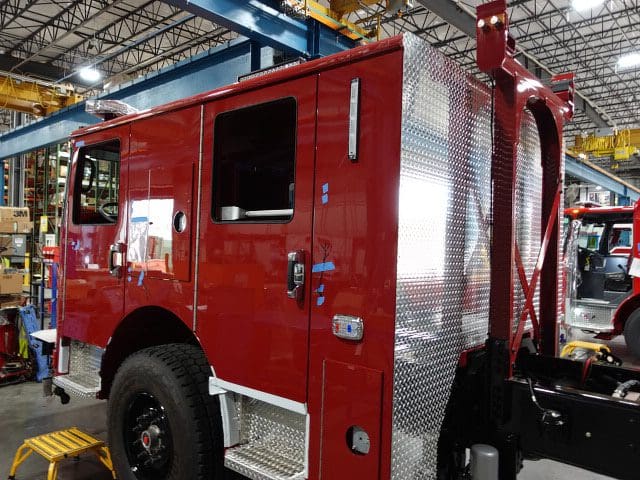

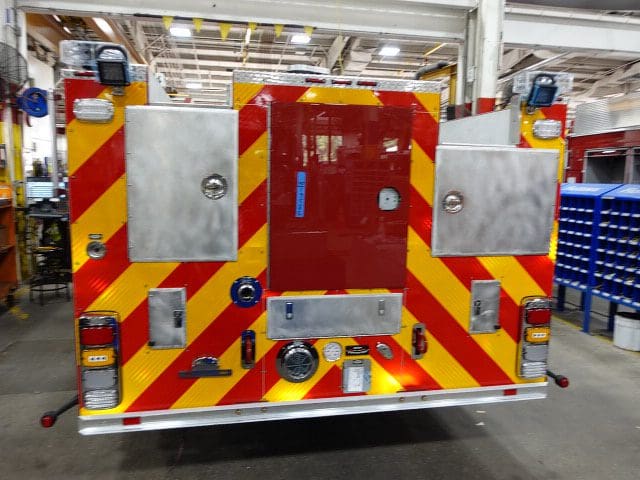

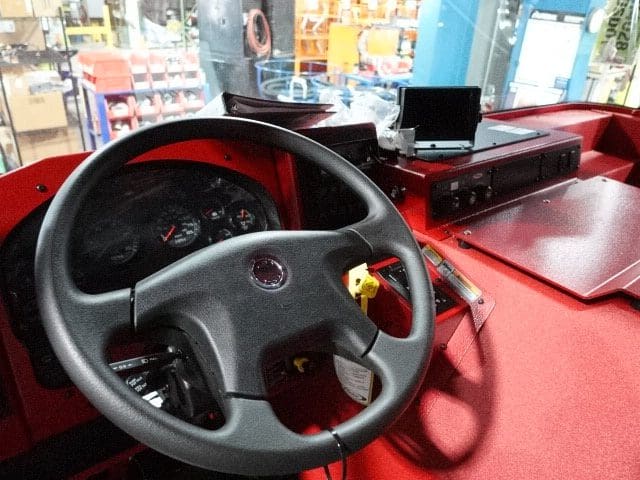

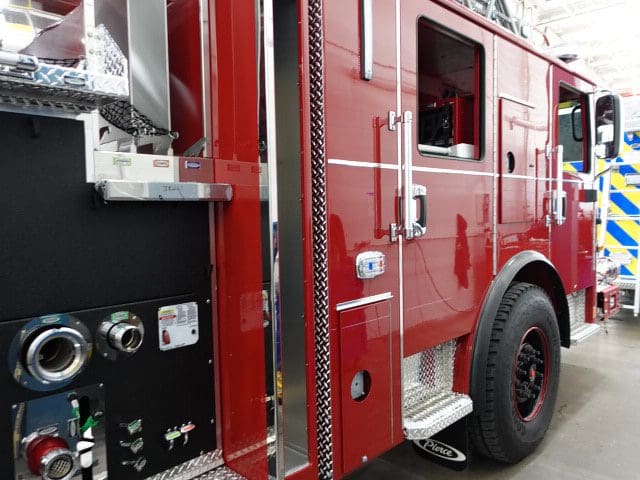

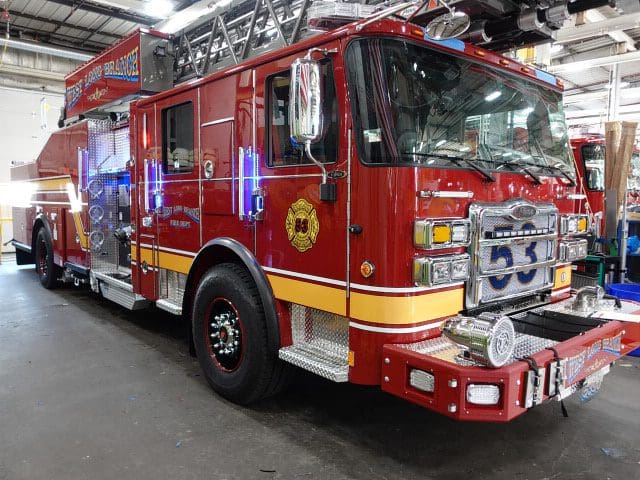

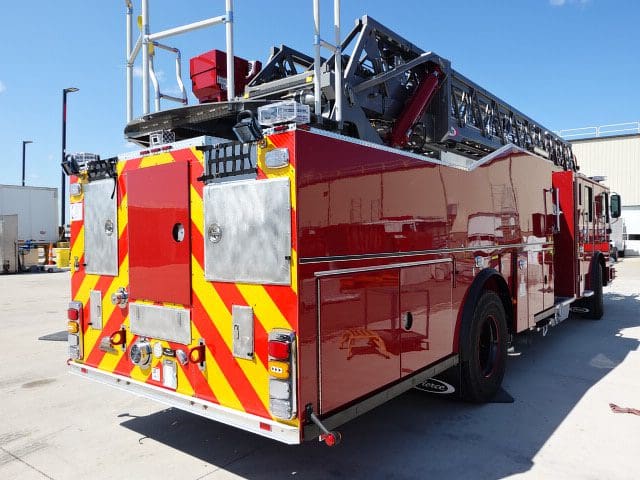

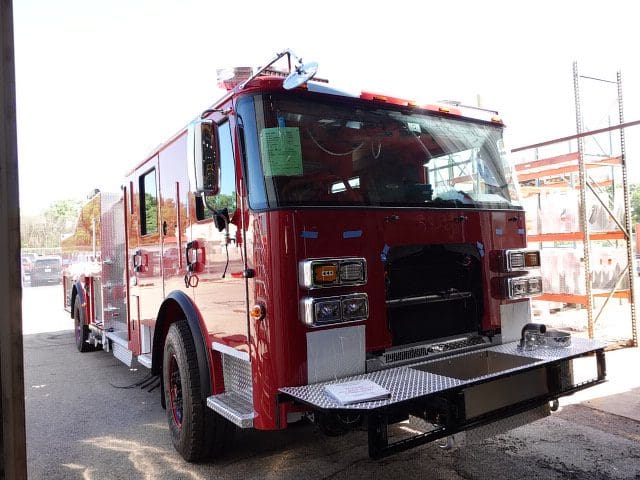

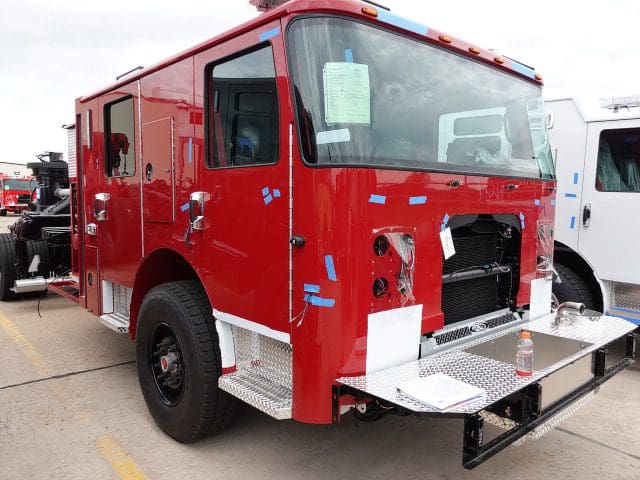

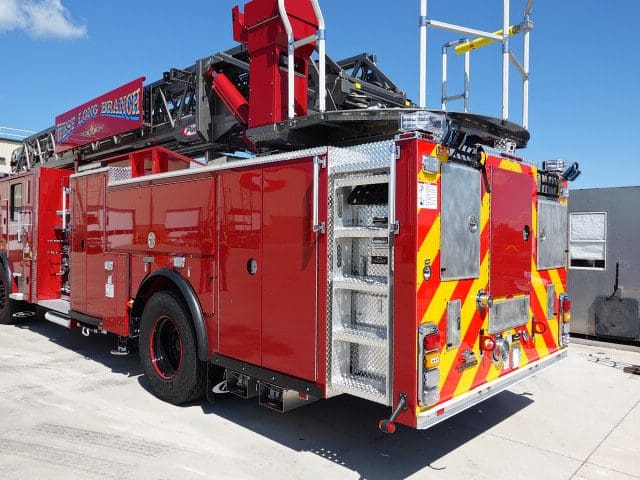

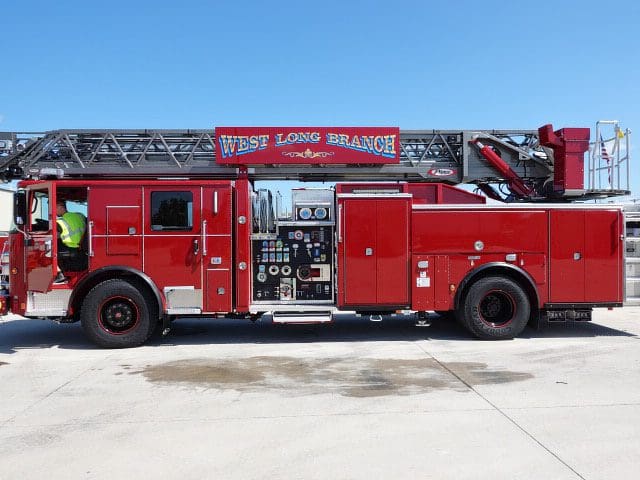

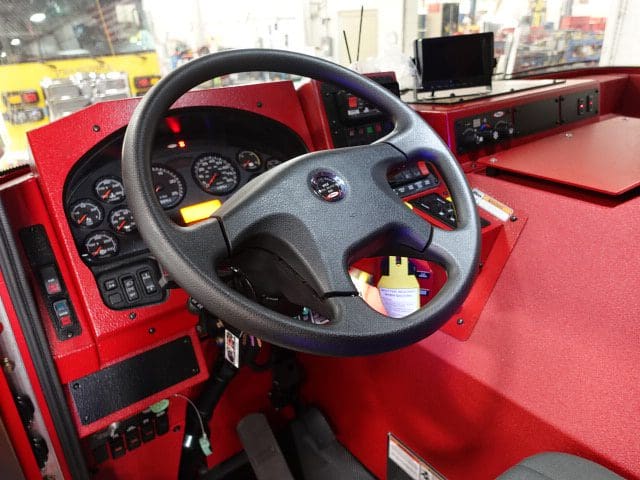

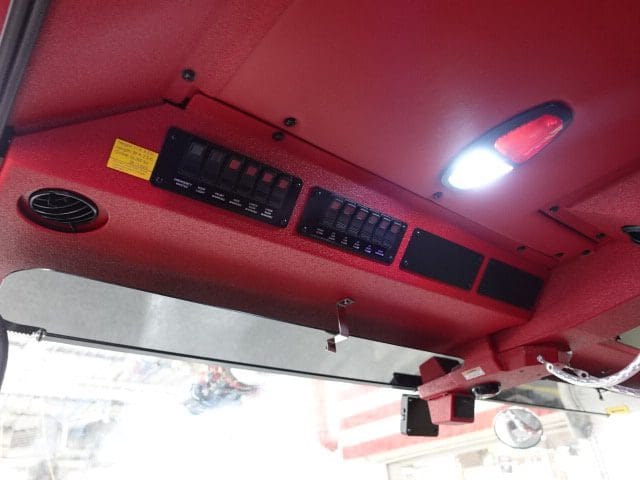

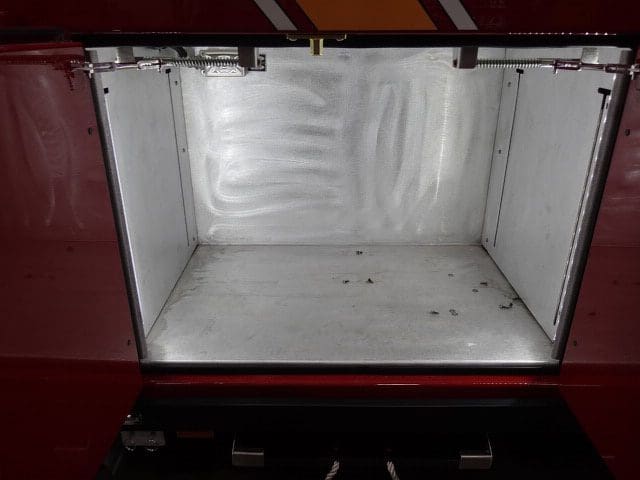

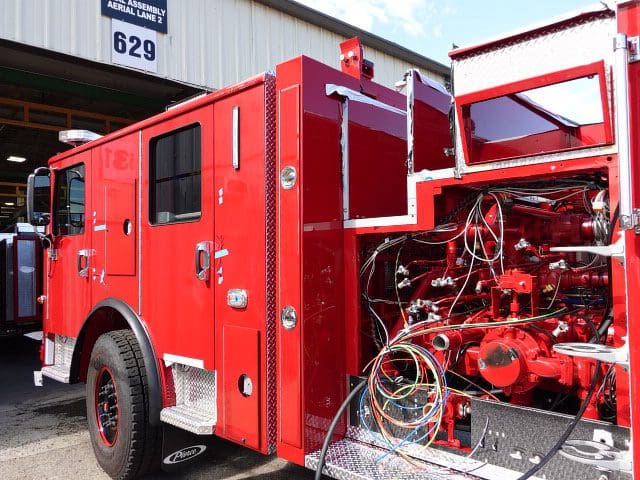

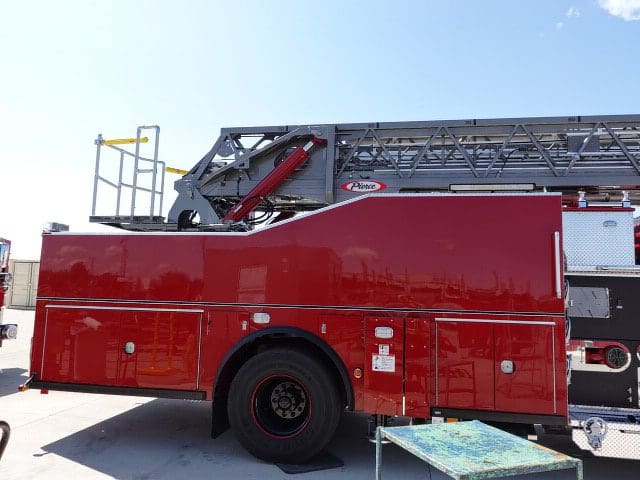

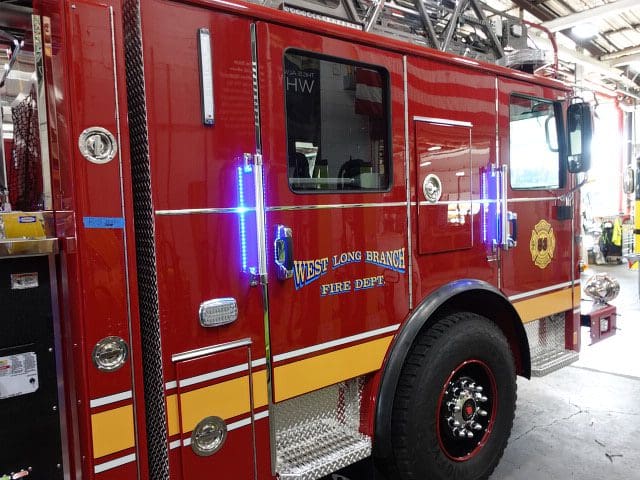

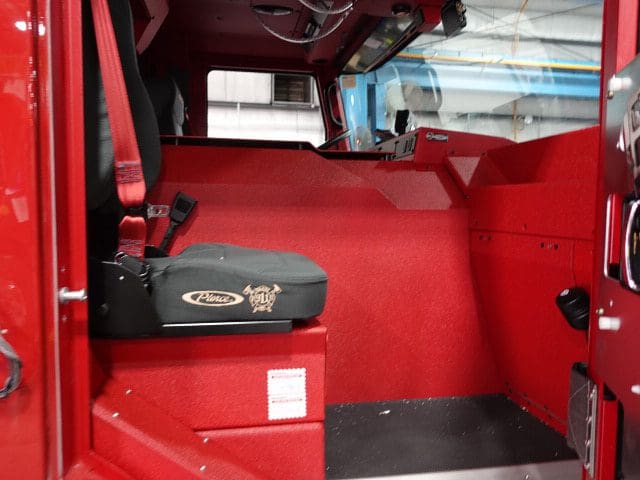

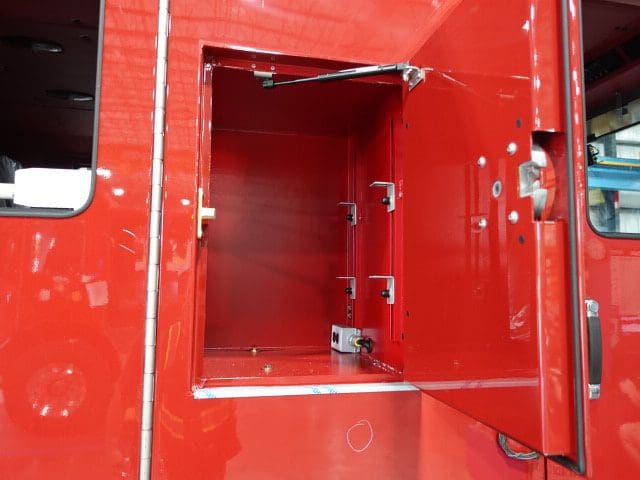

08-02-24

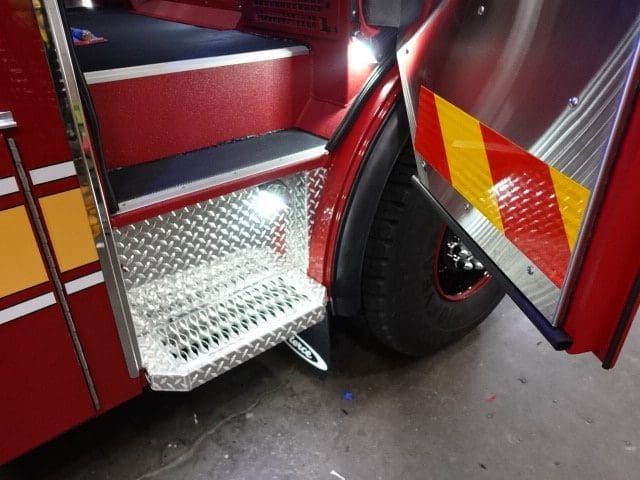

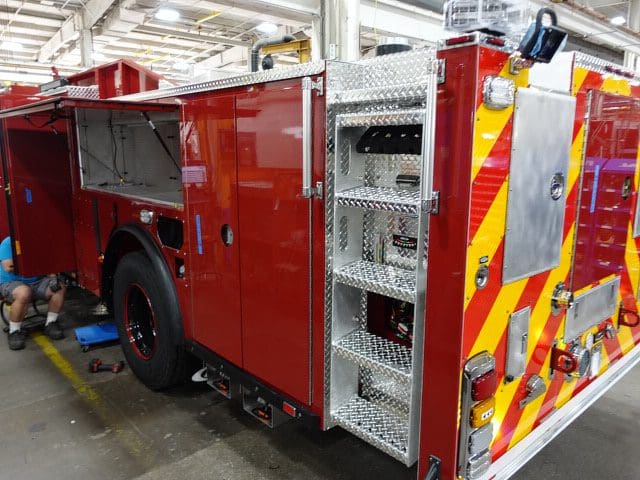

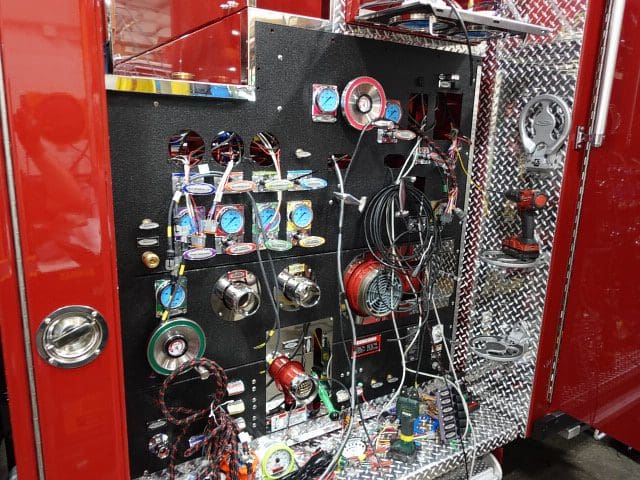

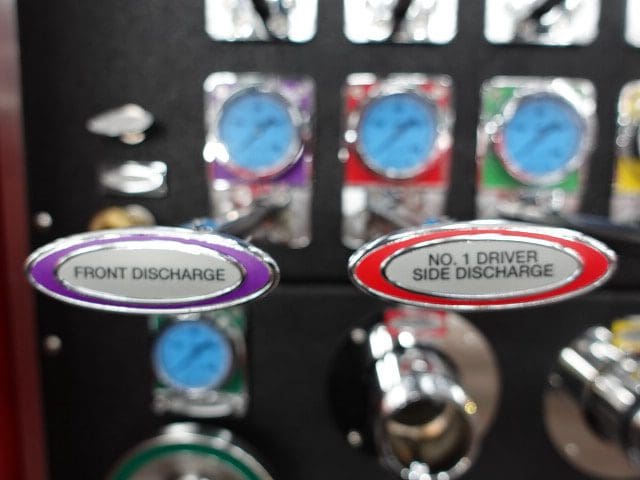

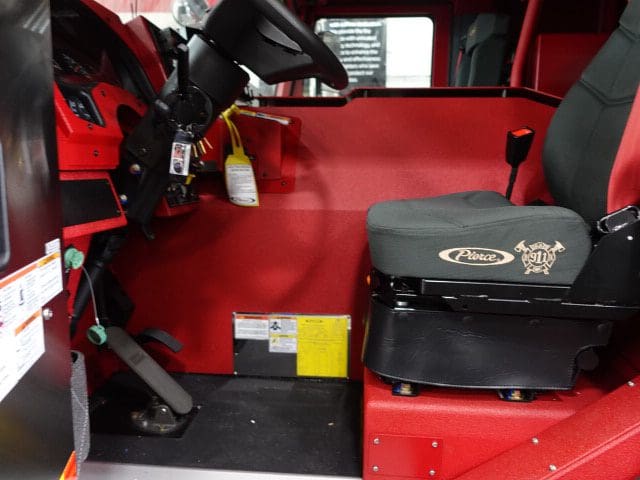

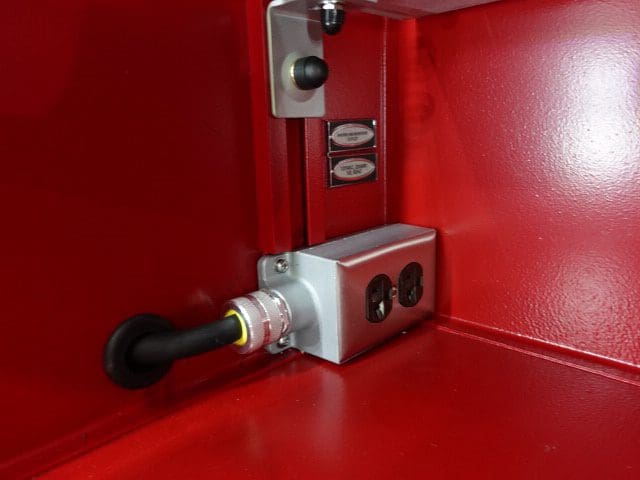

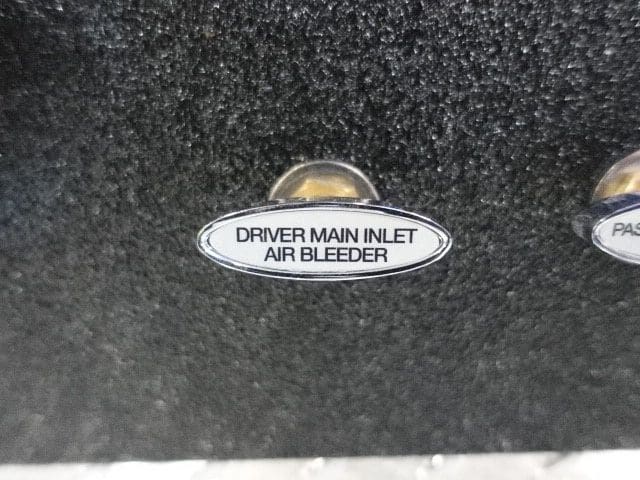

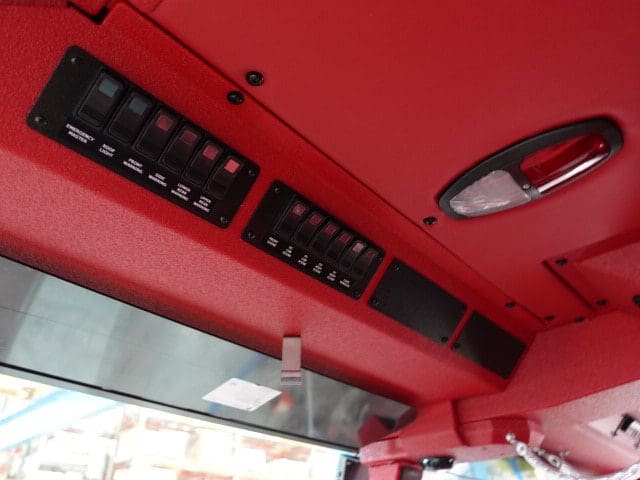

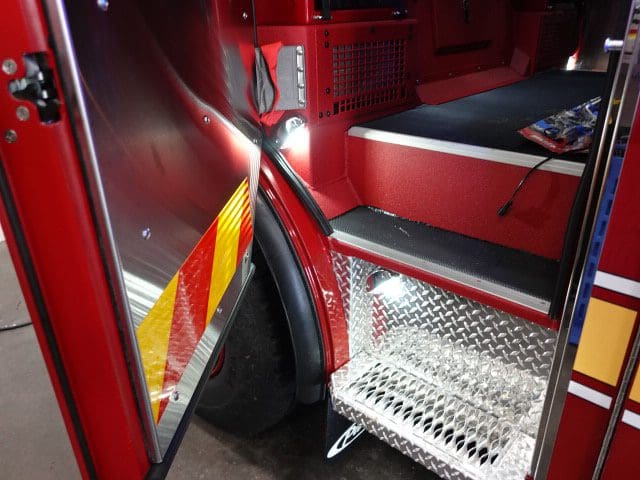

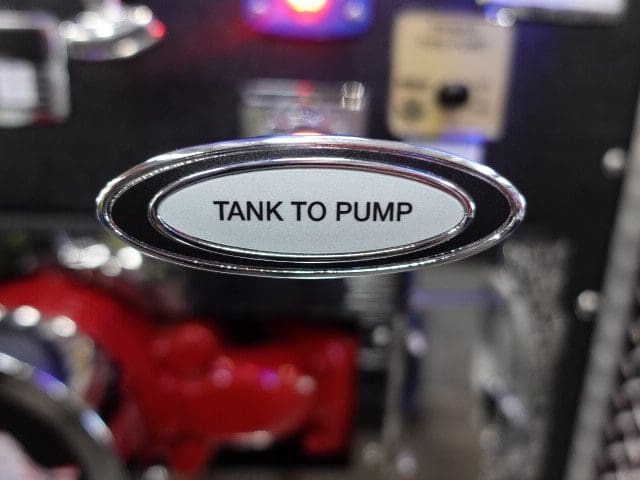

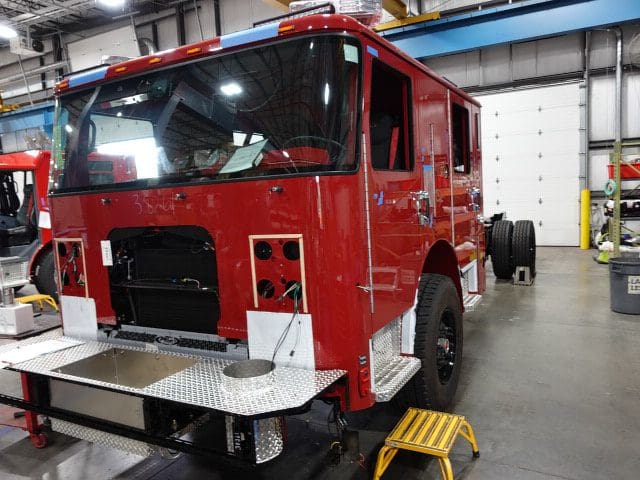

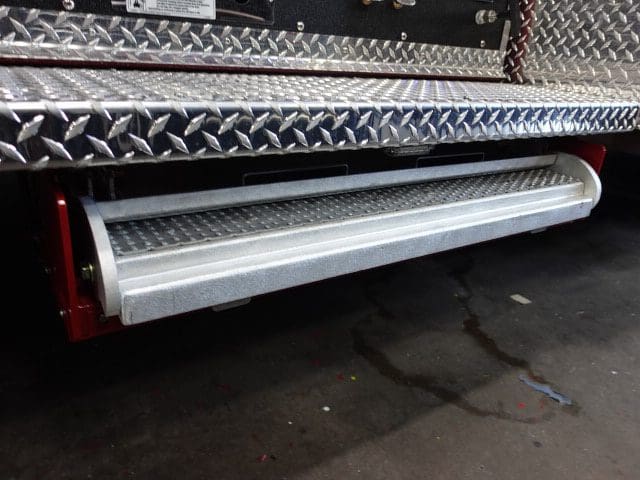

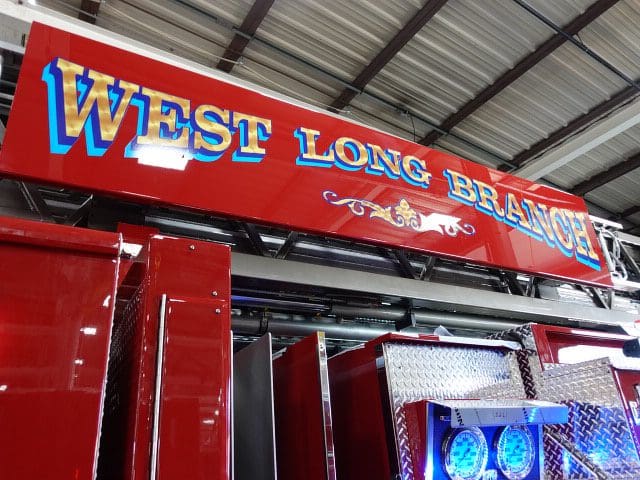

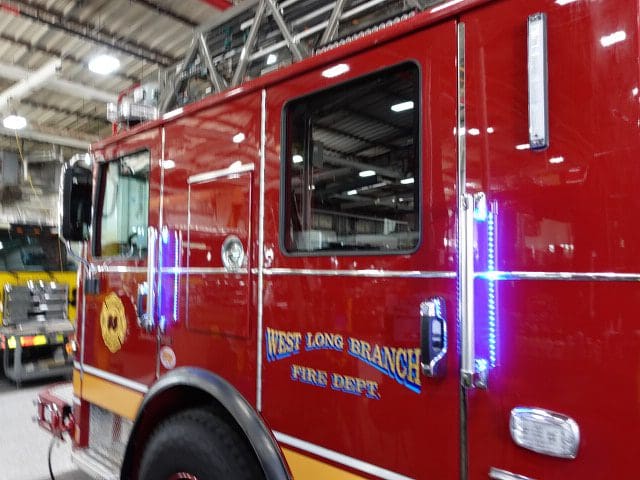

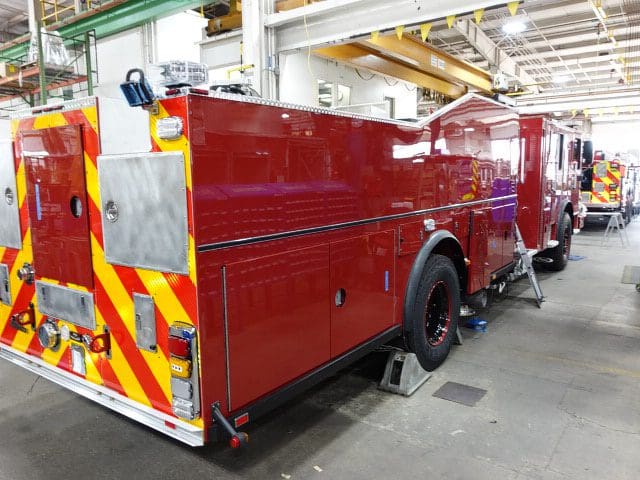

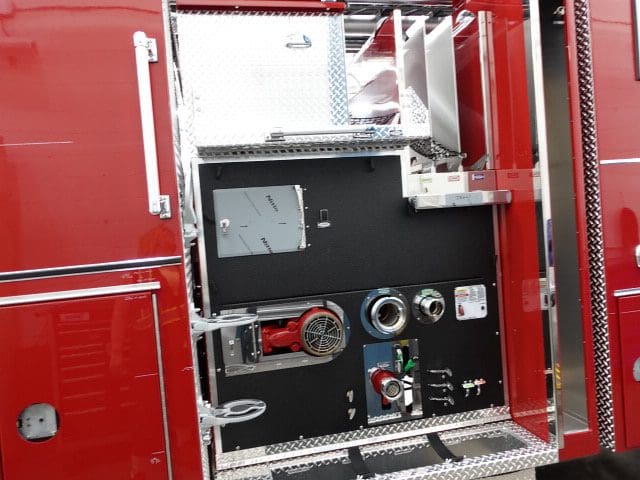

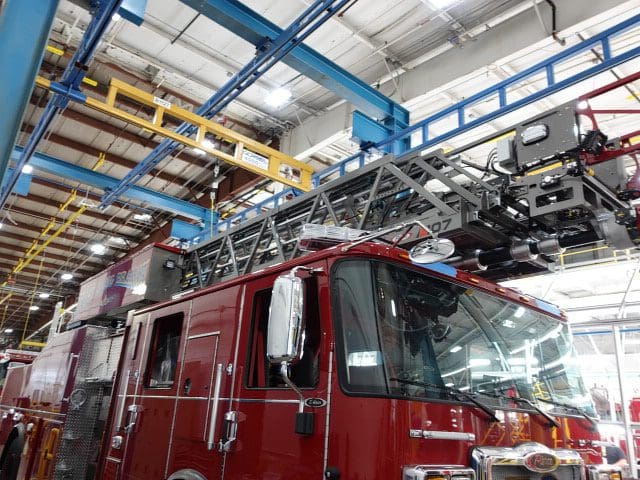

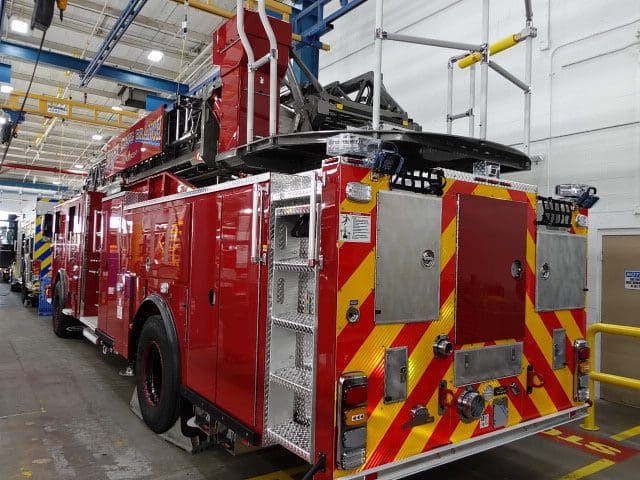

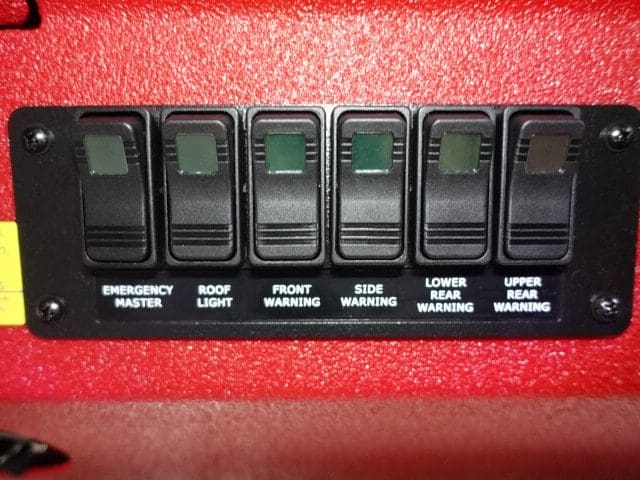

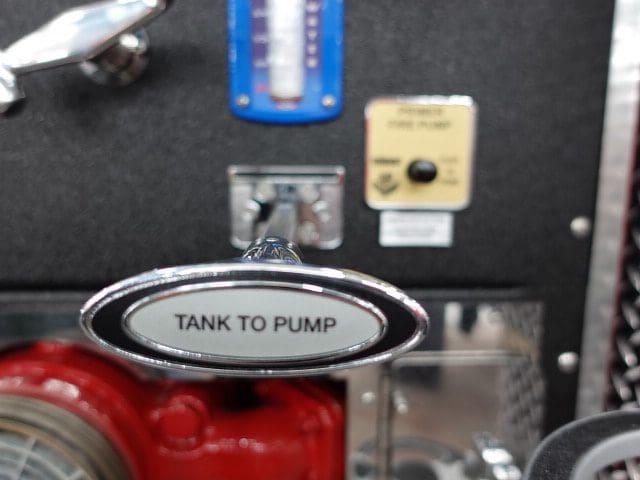

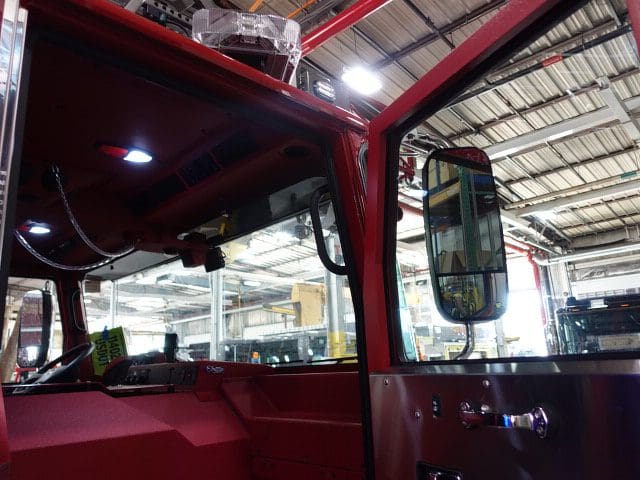

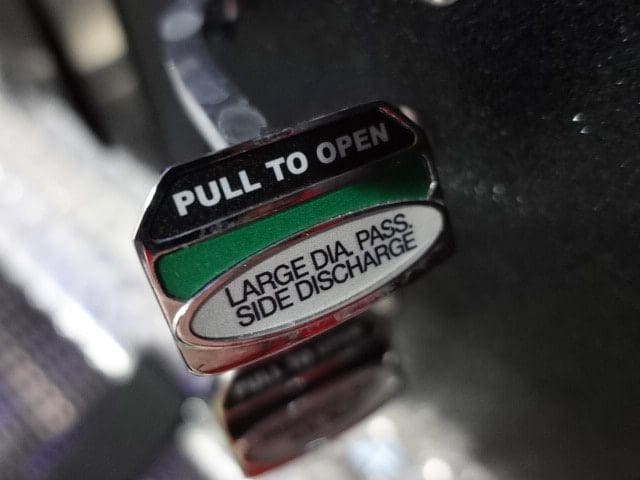

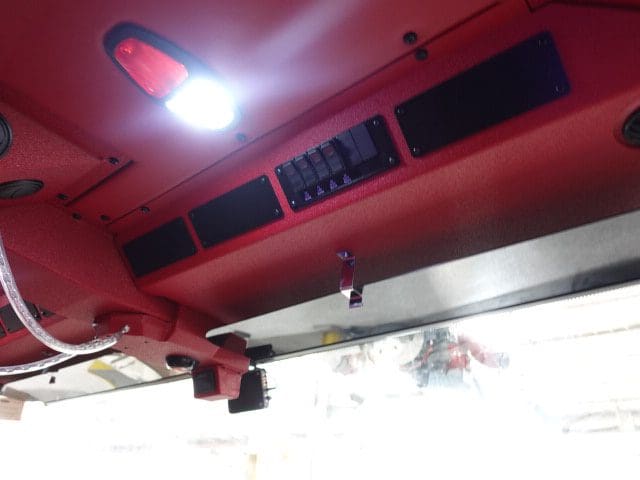

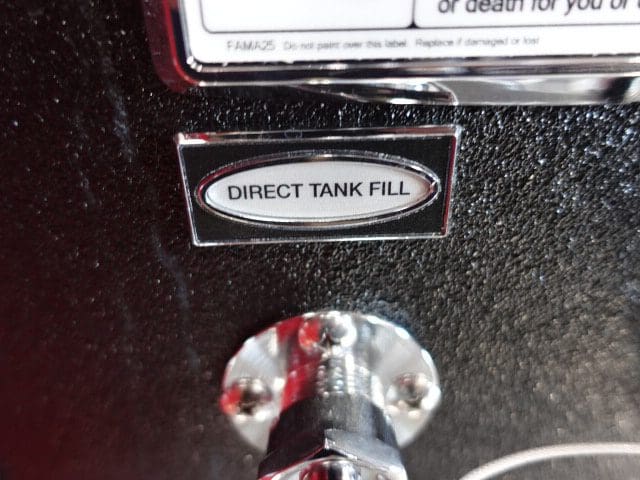

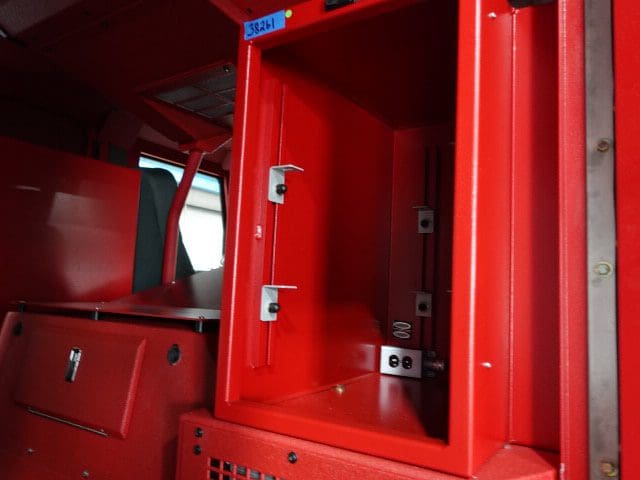

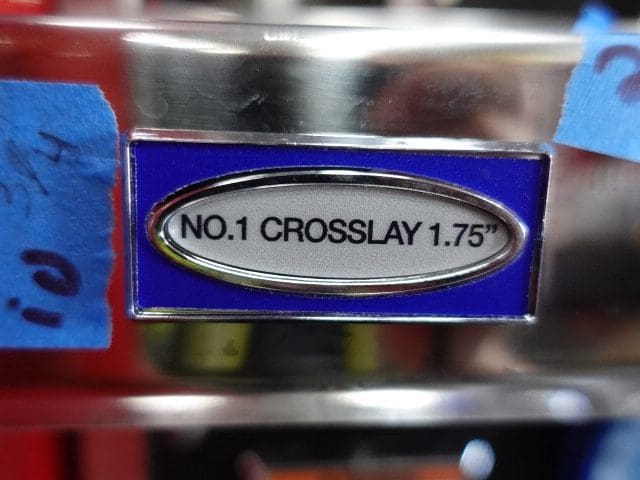

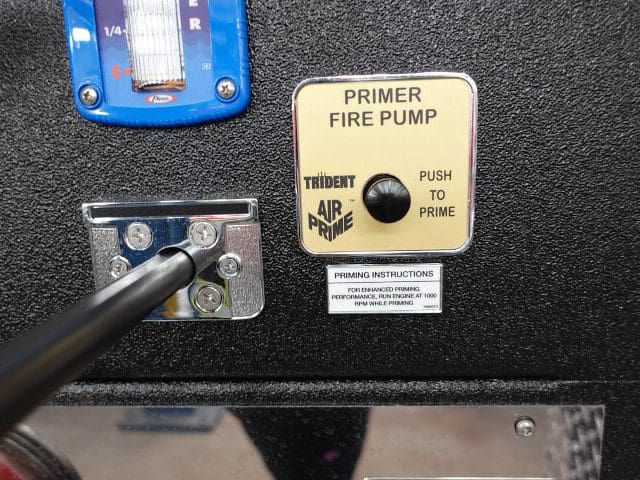

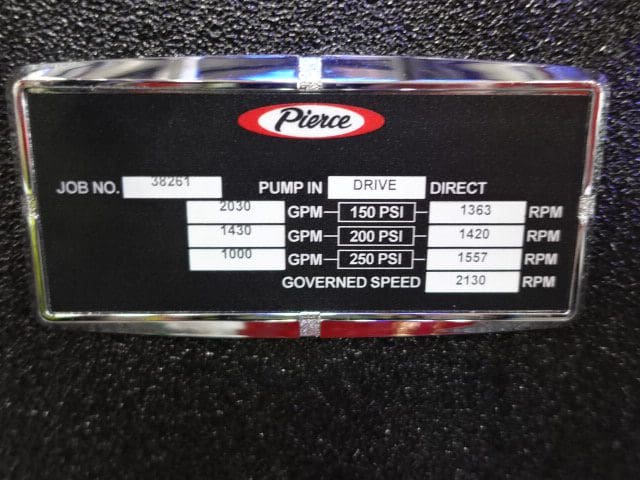

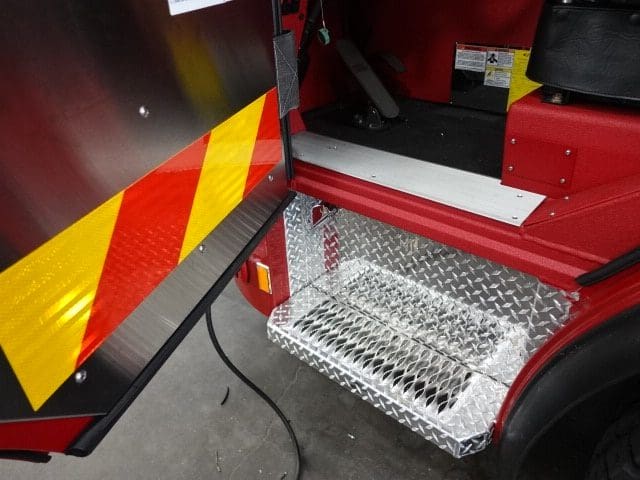

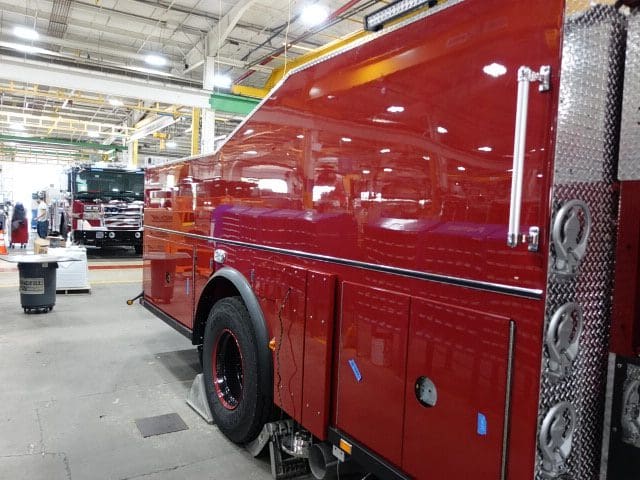

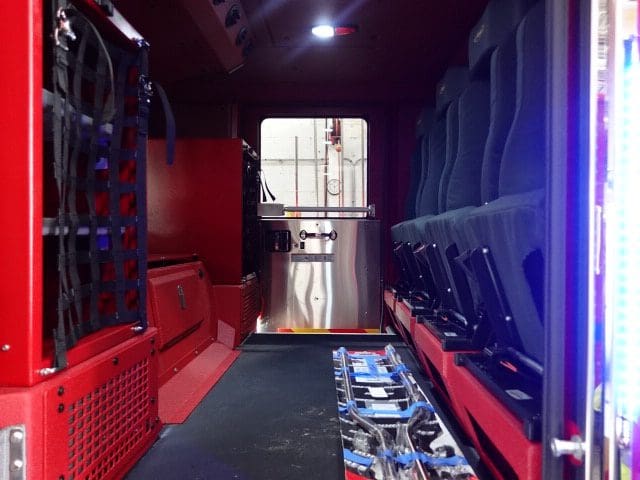

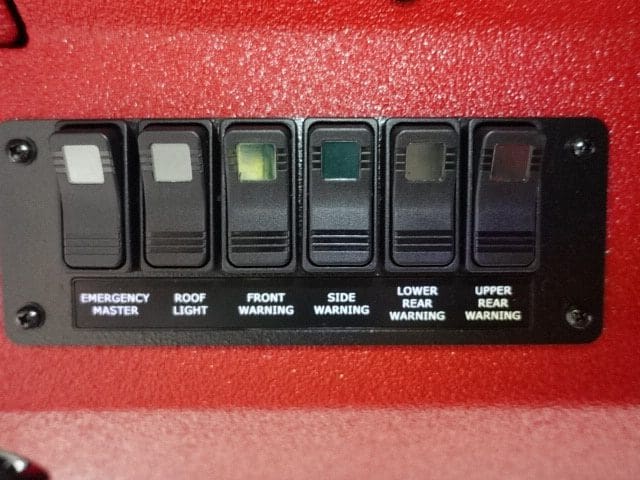

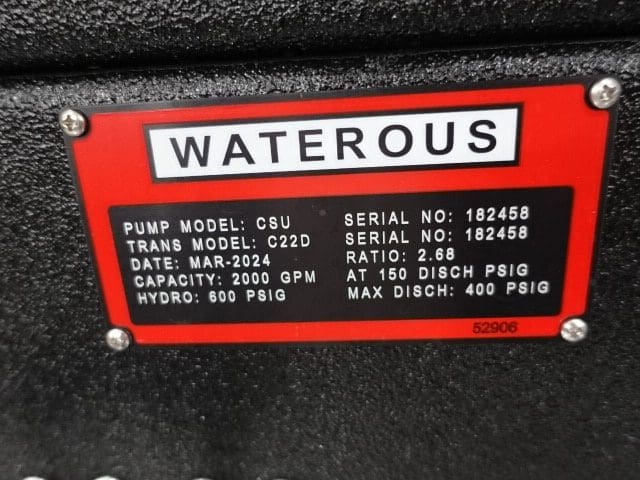

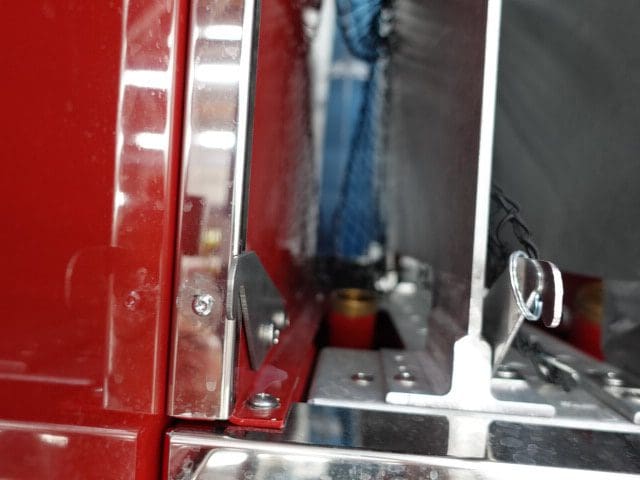

In this report, the apparatus continued the quality and
graphics process where any remaining content is applied.

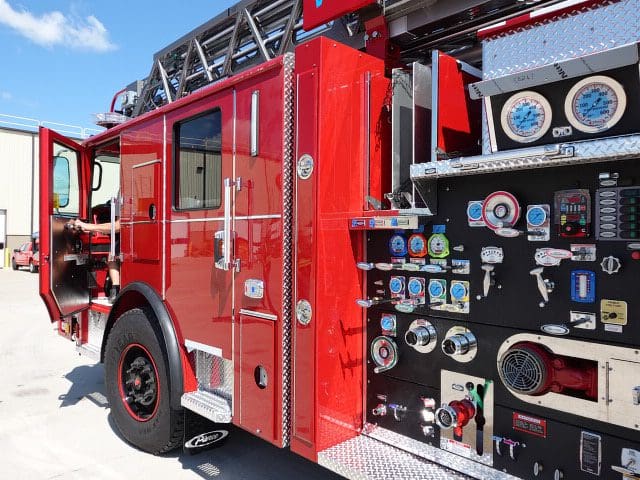

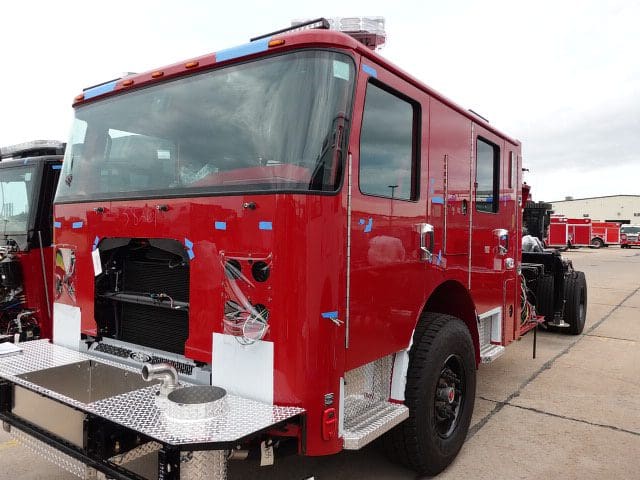

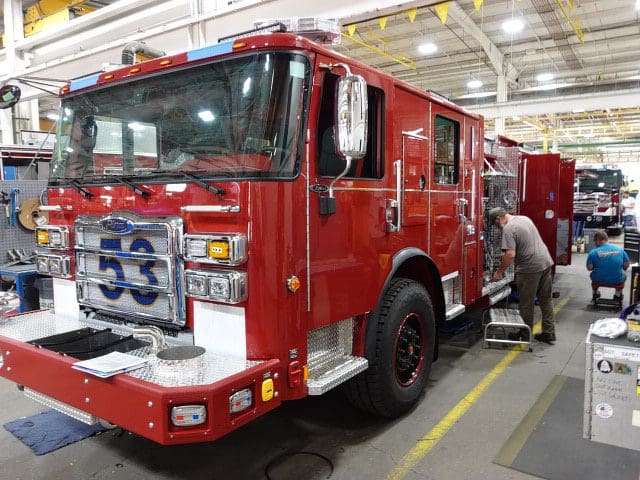

Once finished it will be made ready for the customer

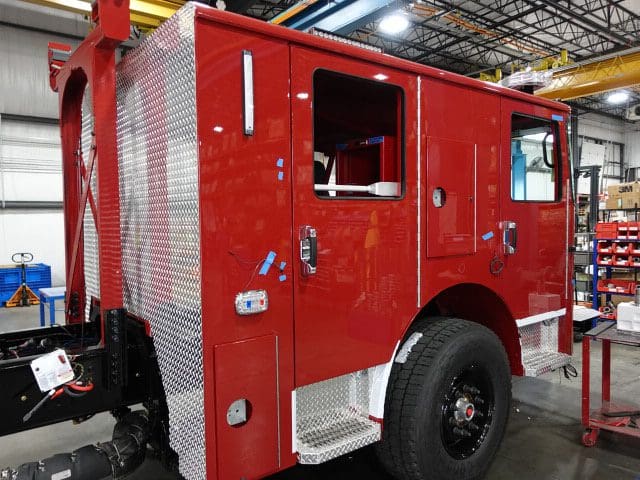

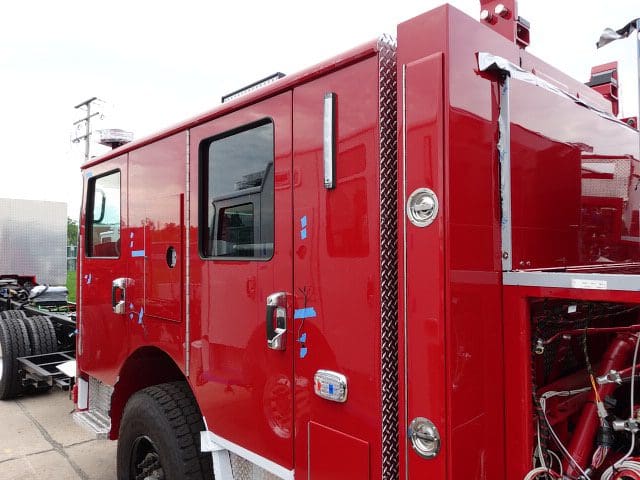

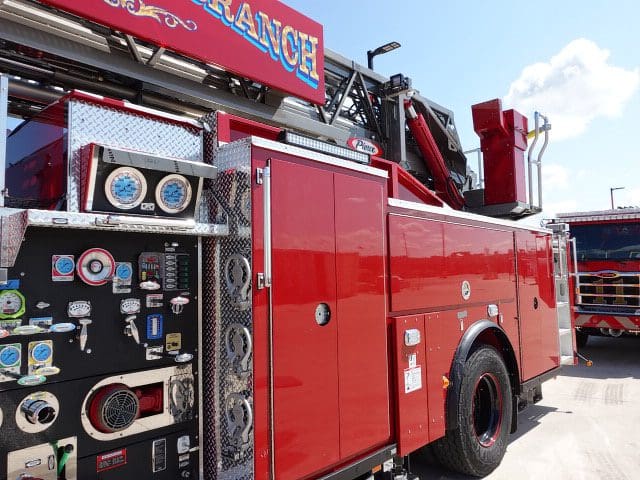

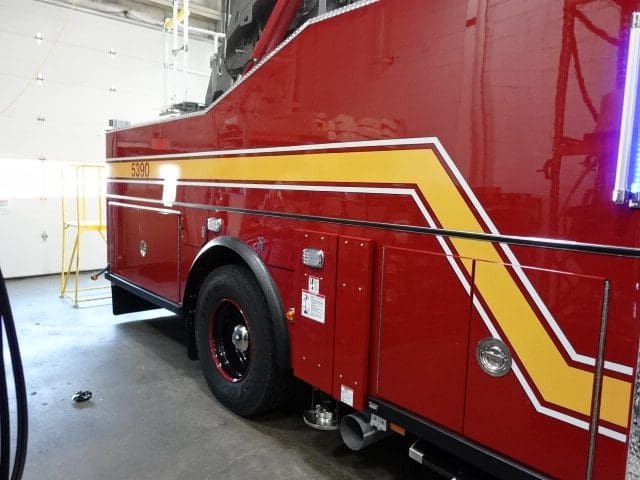

acceptance inspection. This is the last scheduled report.
07-26-24

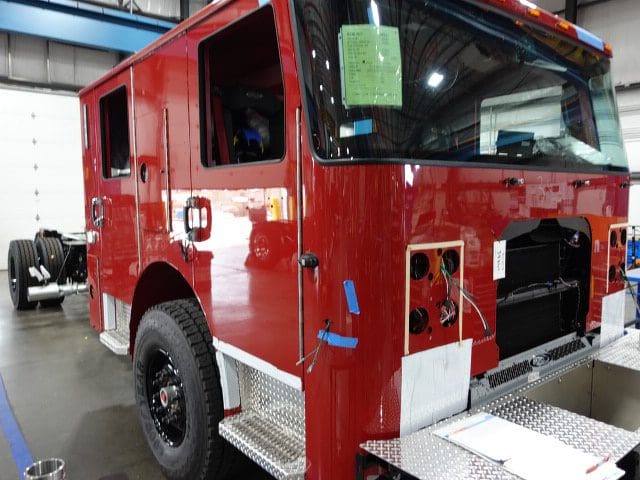

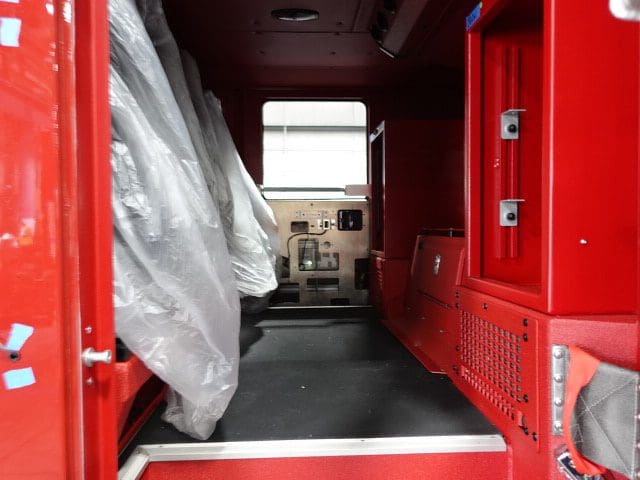

In this report, the apparatus completed testing and was released to quality and graphics where any remaining content will be applied.
07-19-24

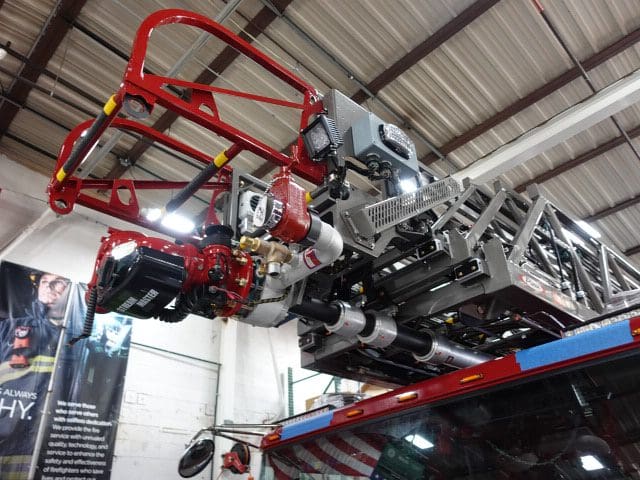

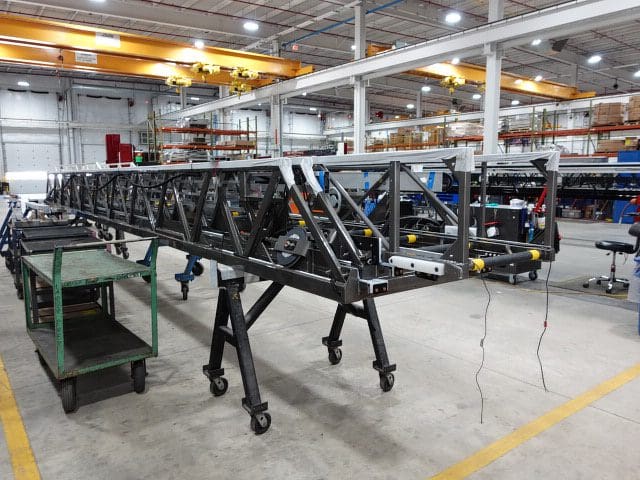

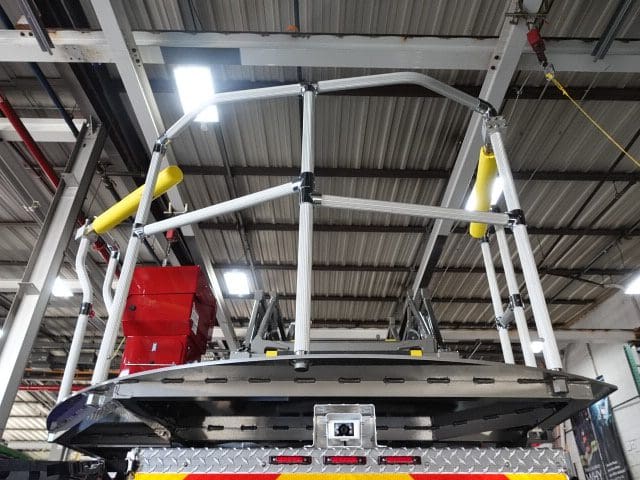

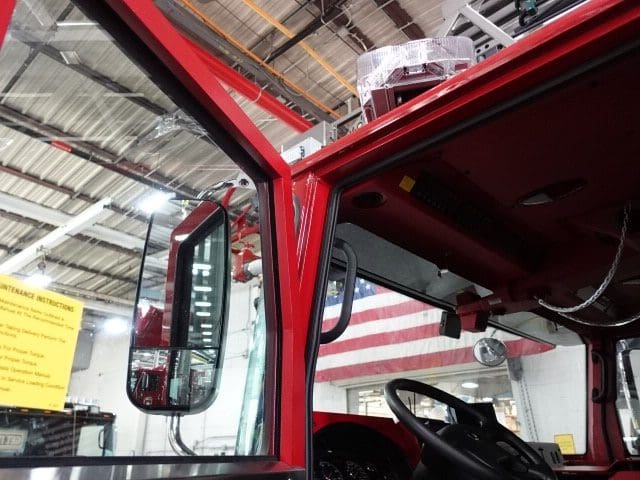

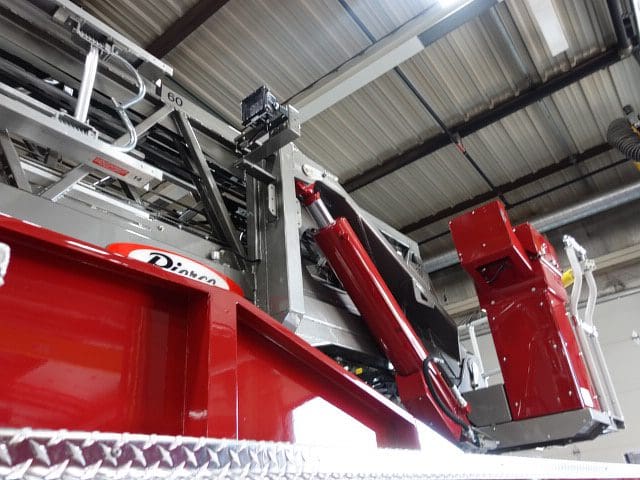

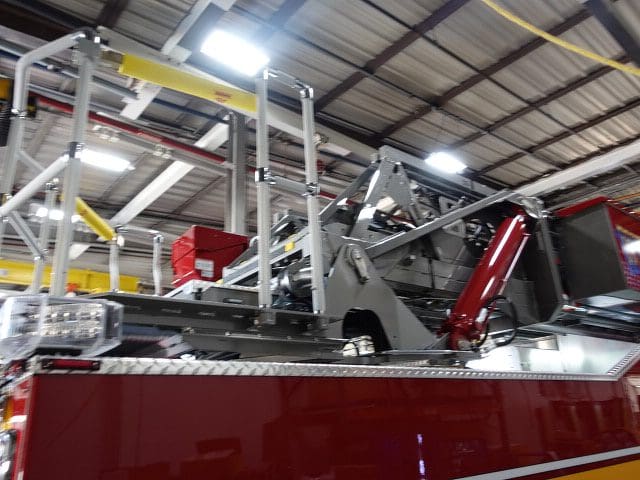

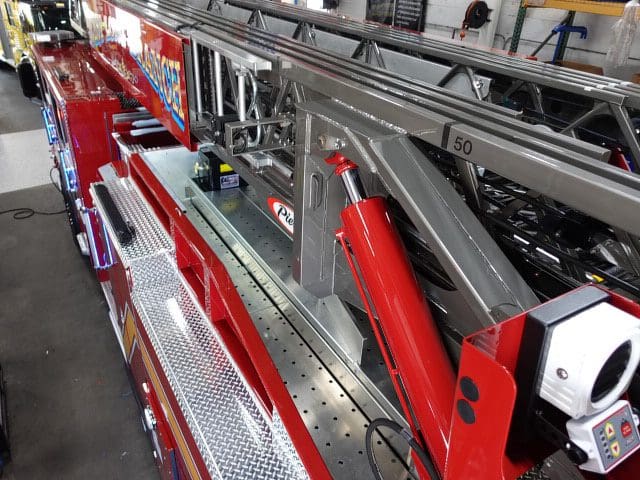

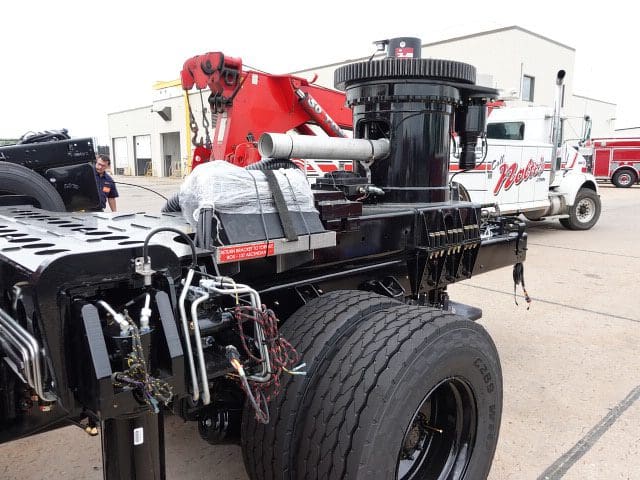

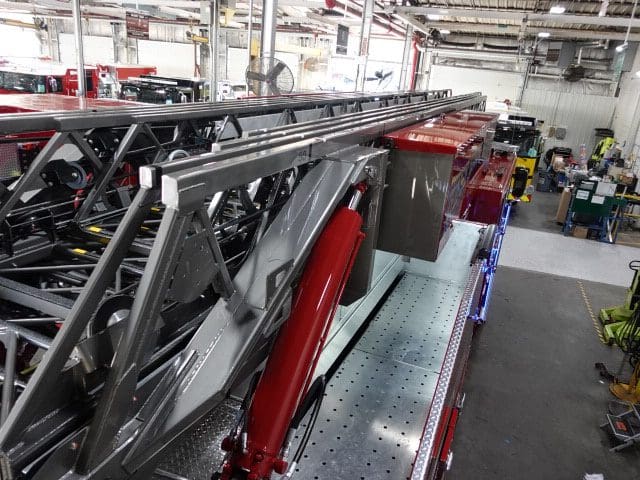

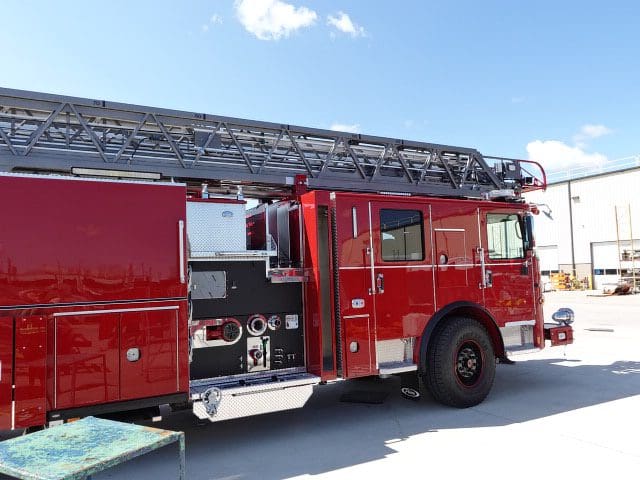

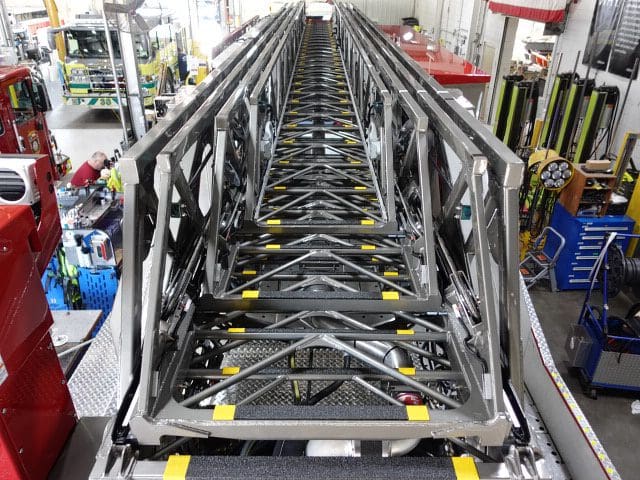

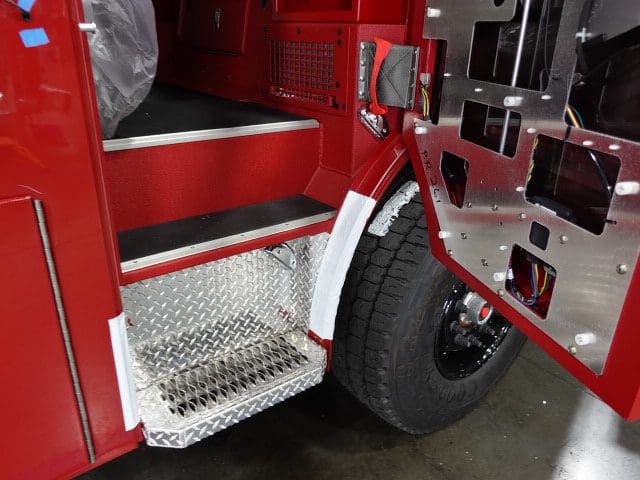

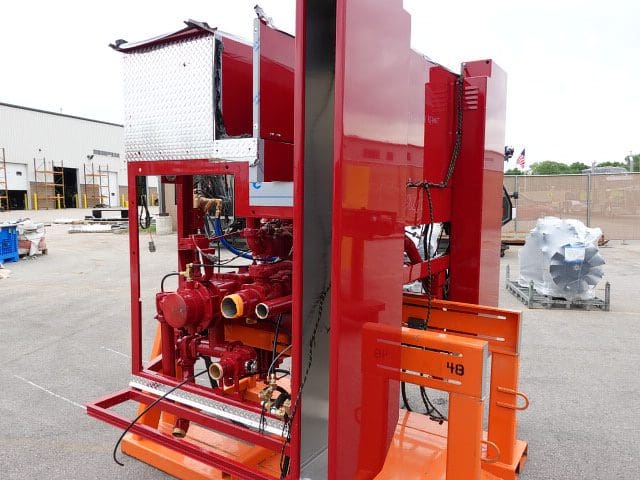

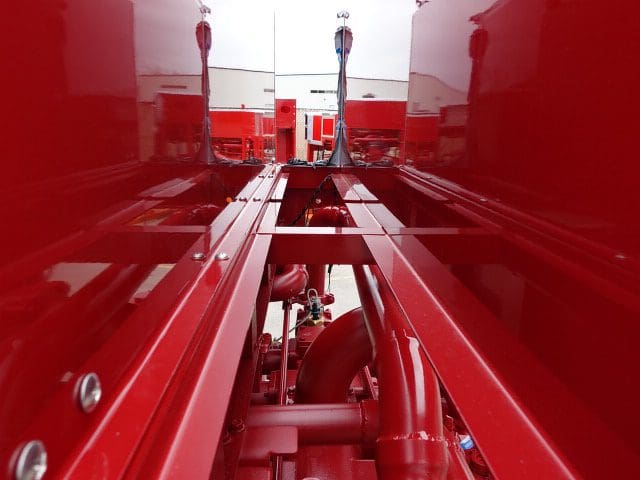

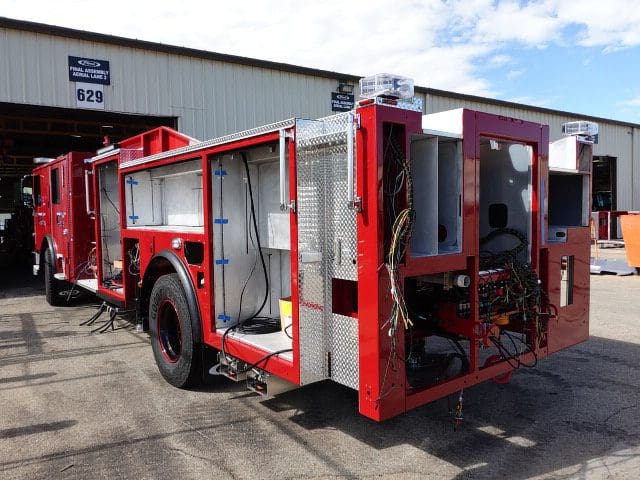

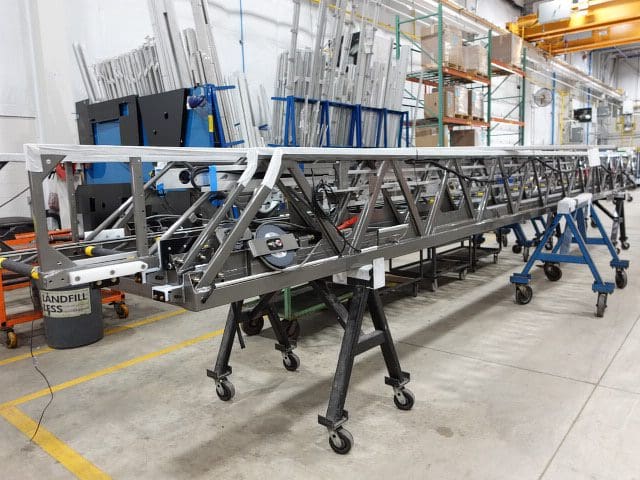

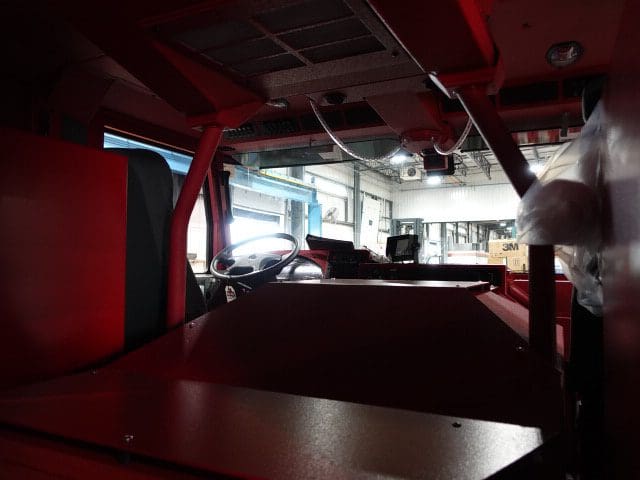

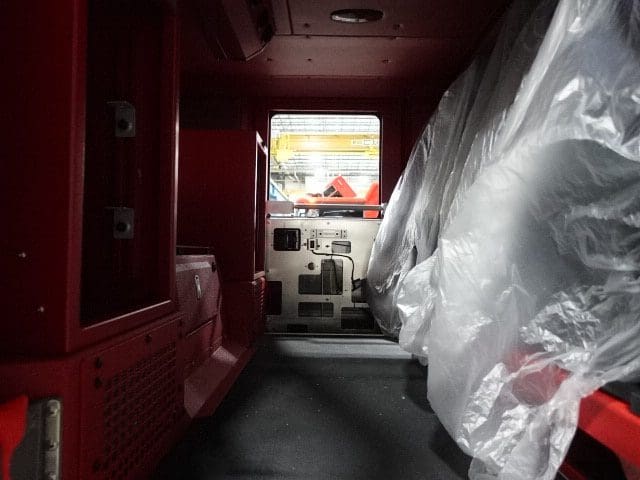

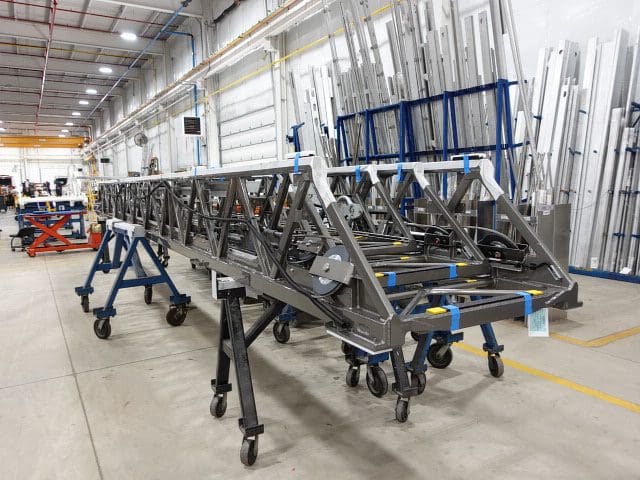

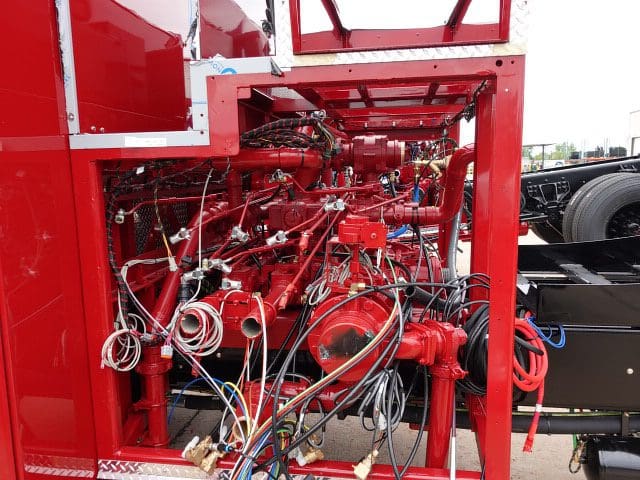

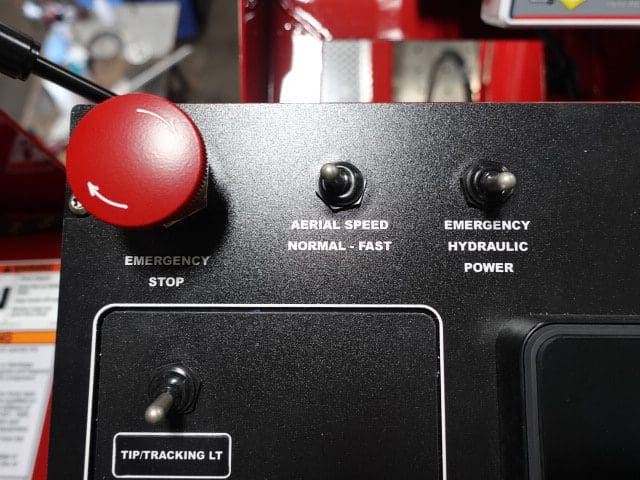

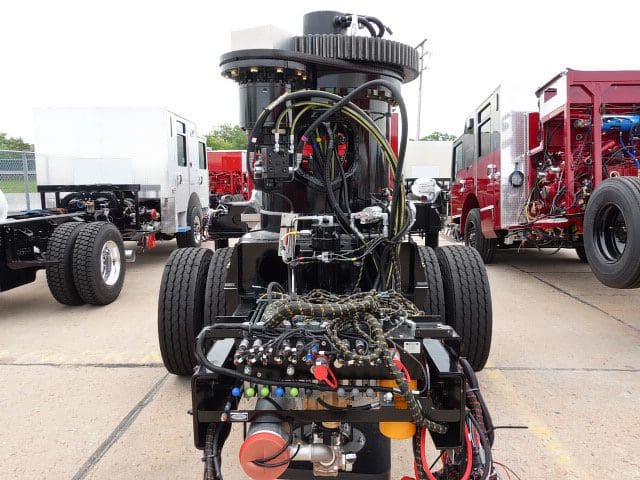

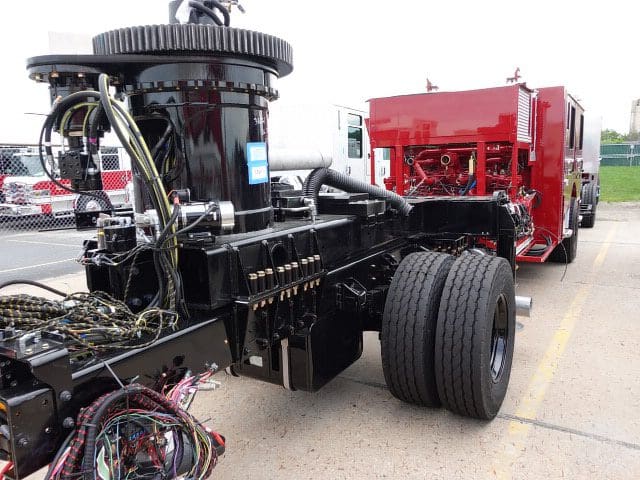

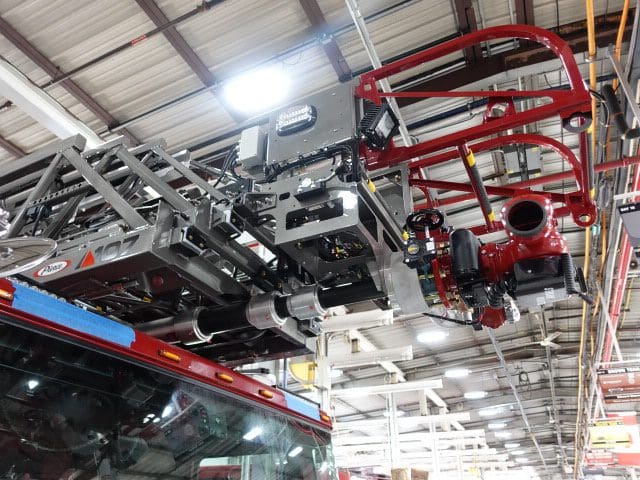

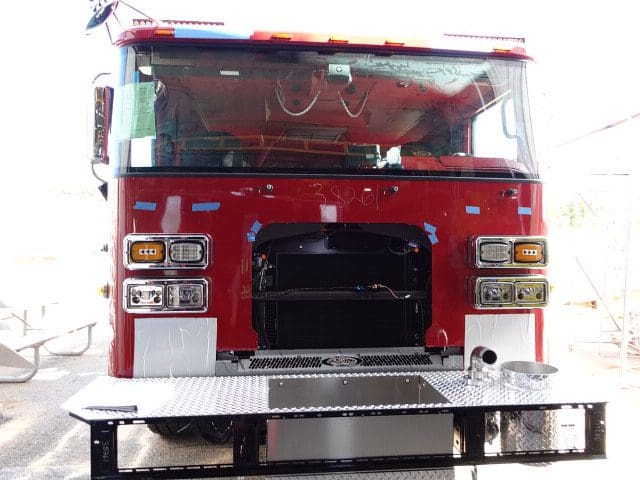

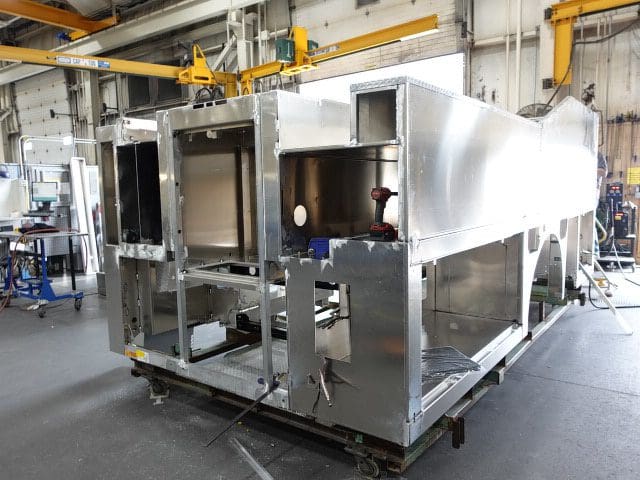

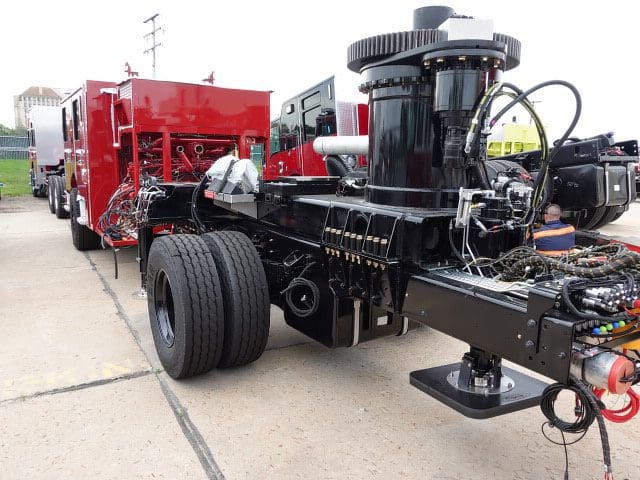

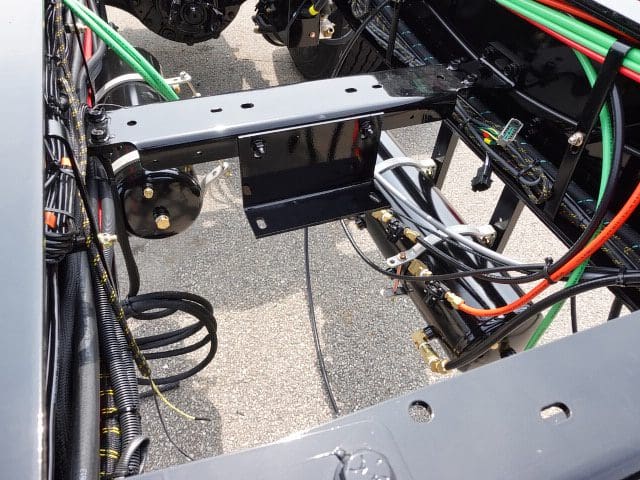

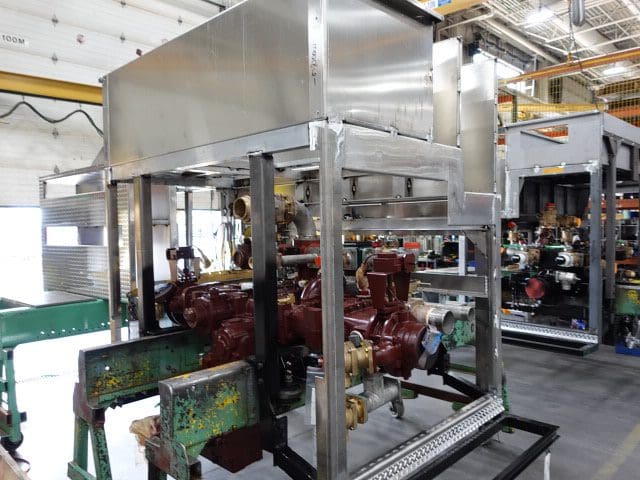

In this report, the apparatus completed final assembly while the aerial device completed initial assembly then was pinned to the apparatus and followed by the start of aerial testing.

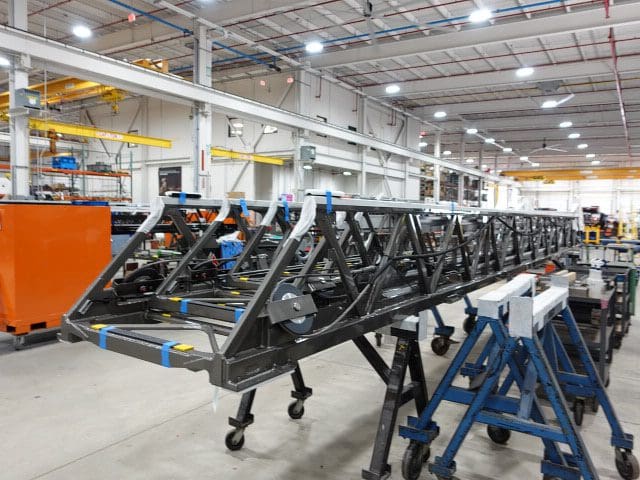

07-12-24

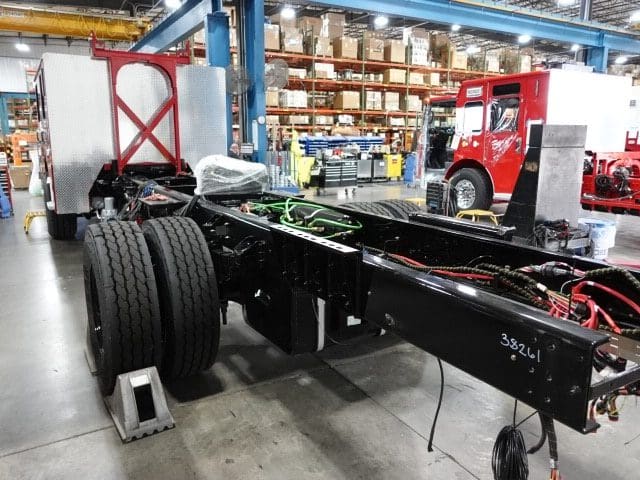

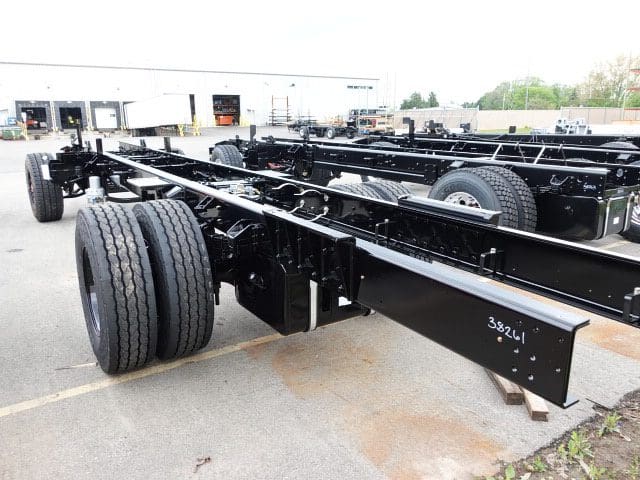

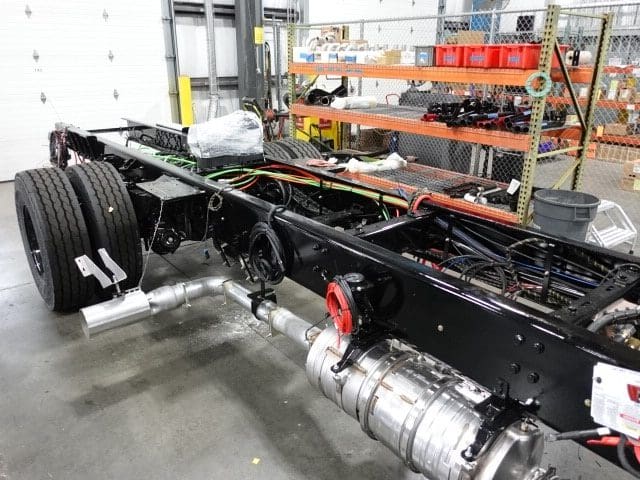

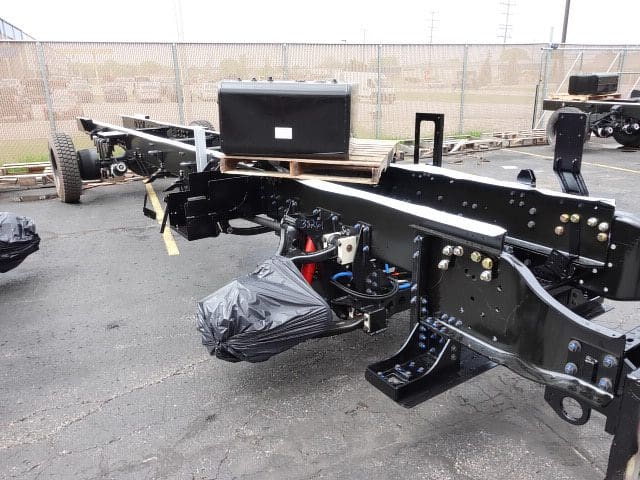

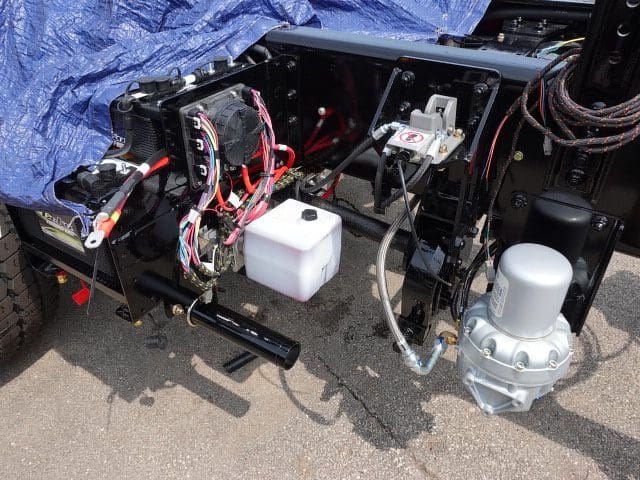

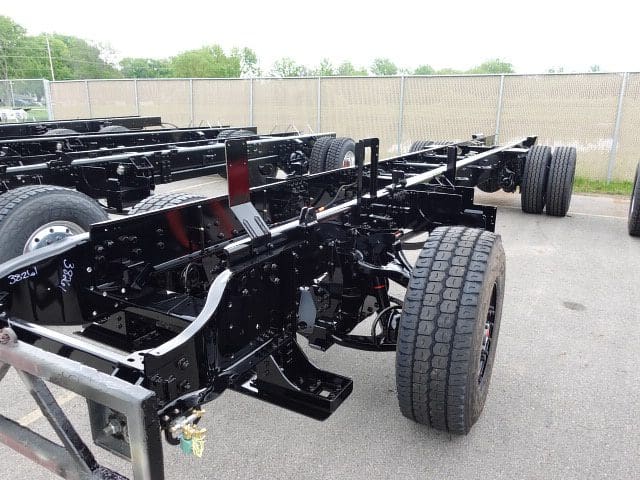

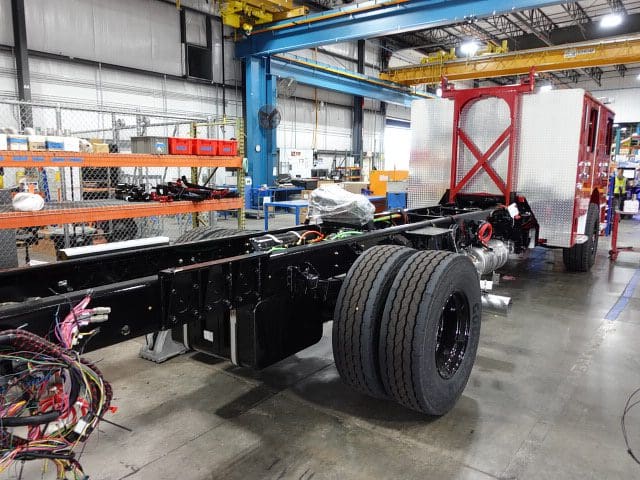

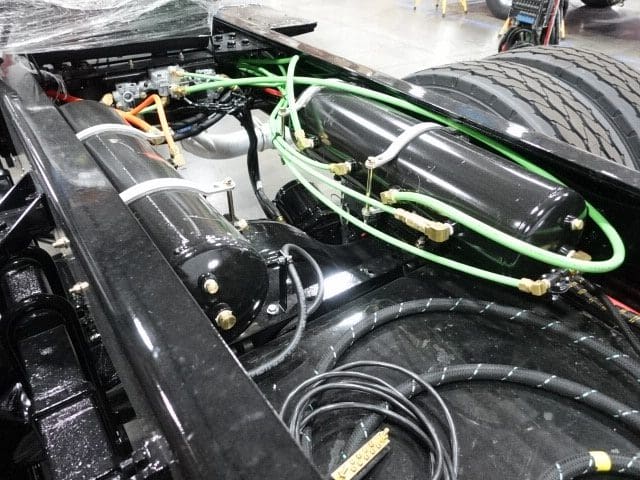

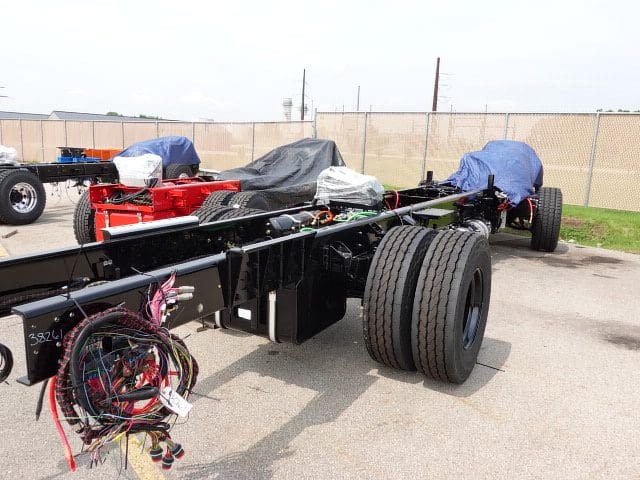

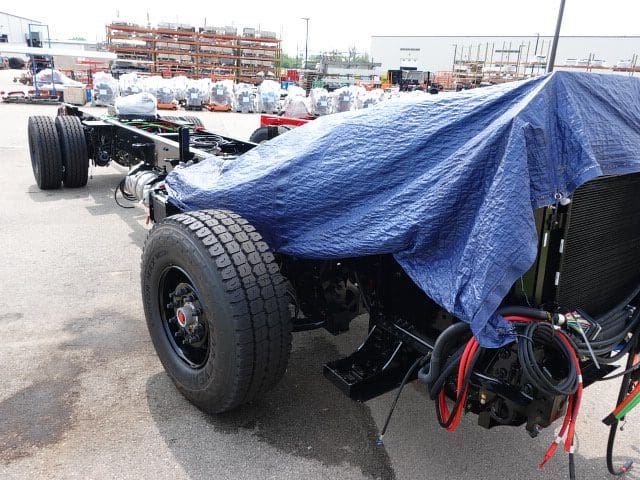

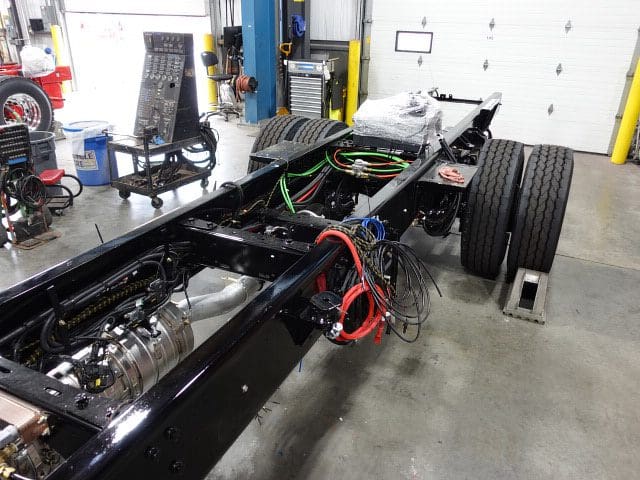

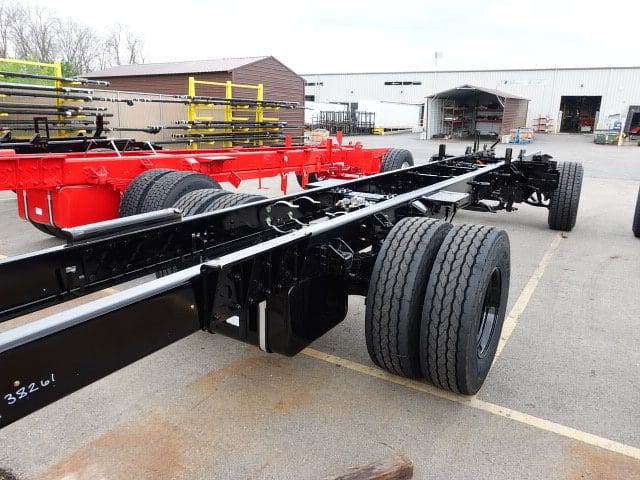

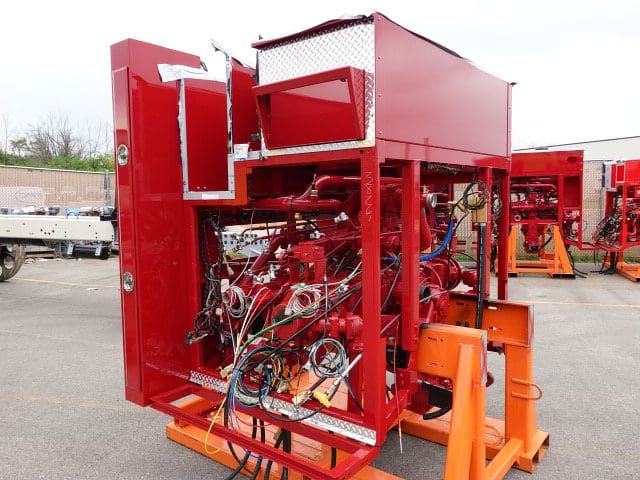

In this report, the apparatus began final assembly while the aerial device arrived and began initial assembly.

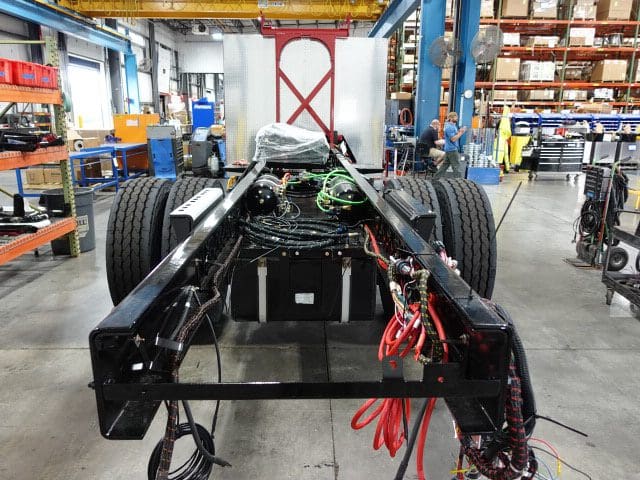

06-28-24

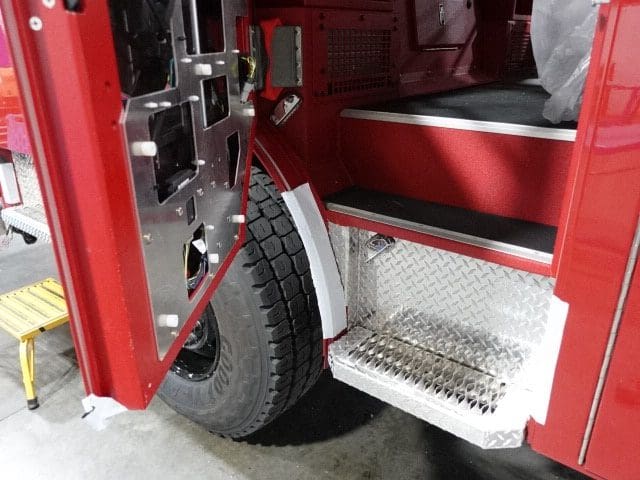

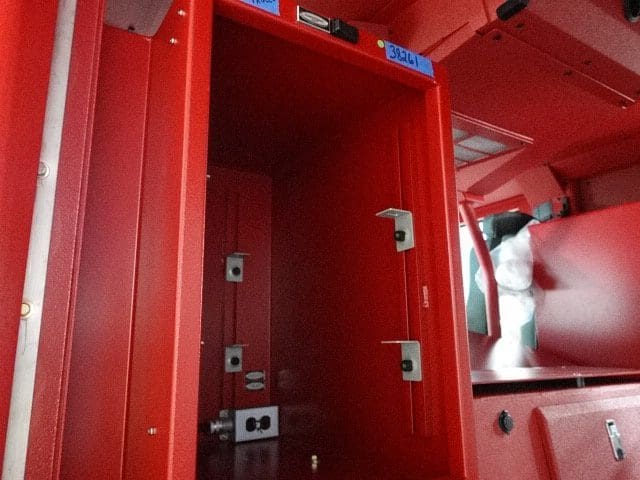

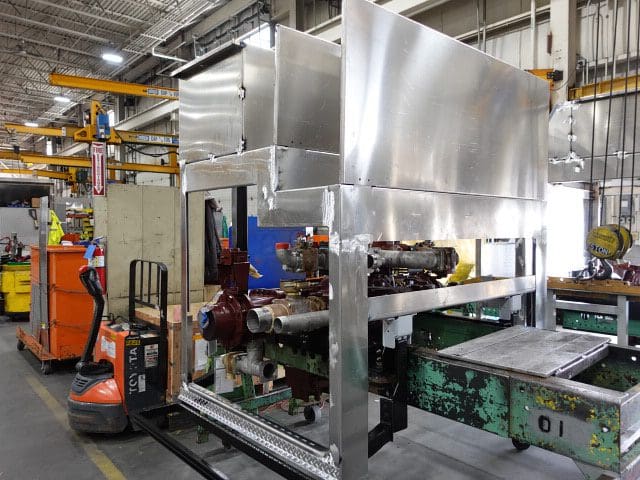

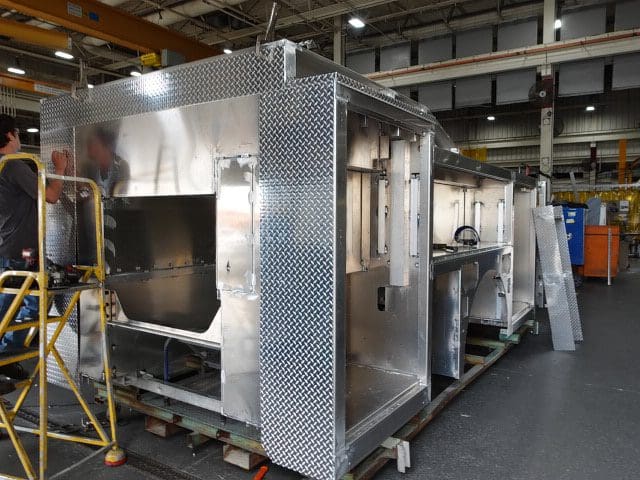

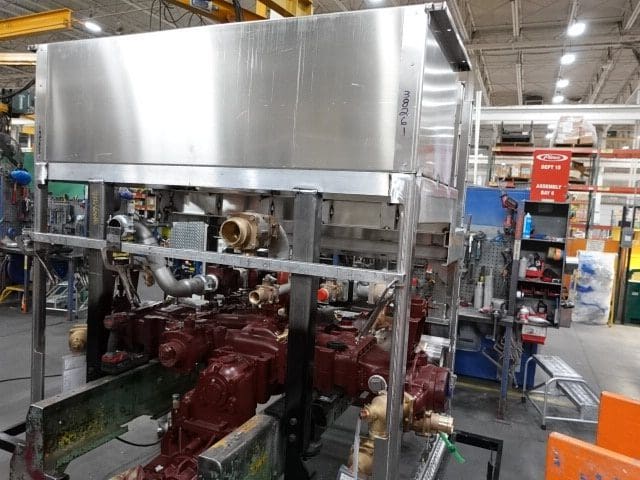

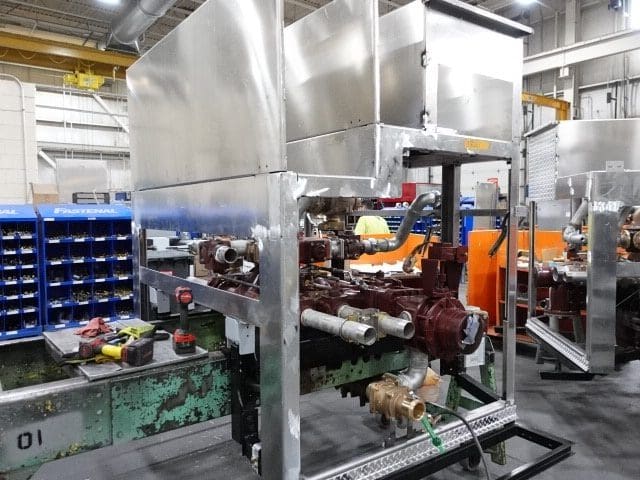

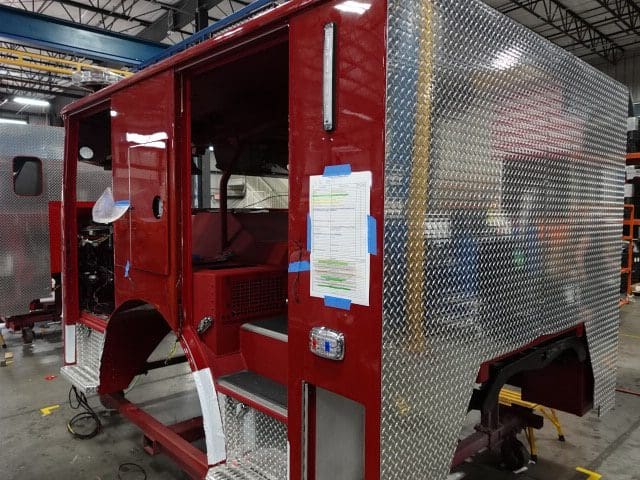

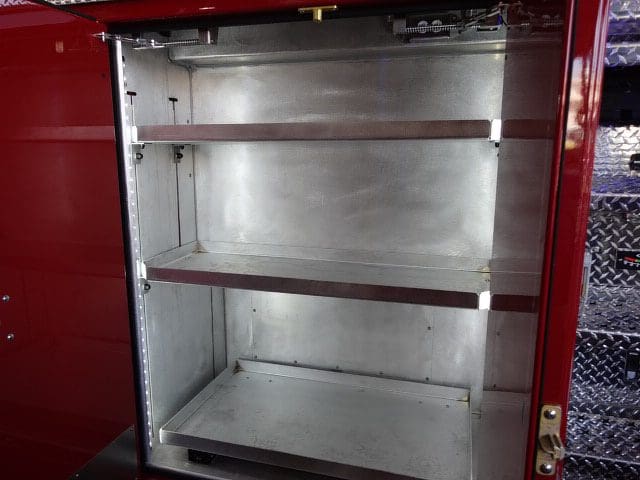

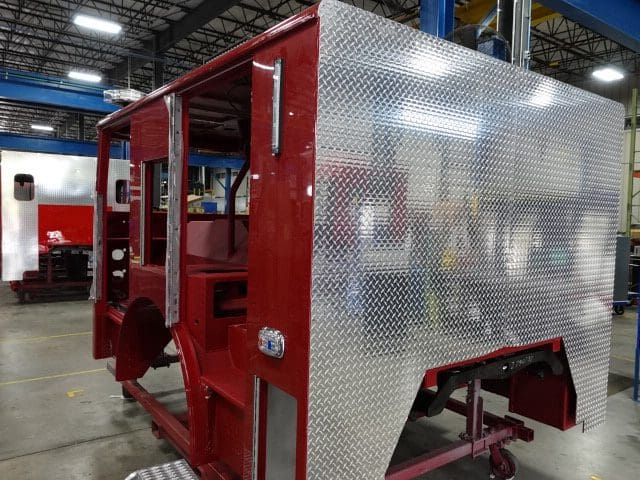

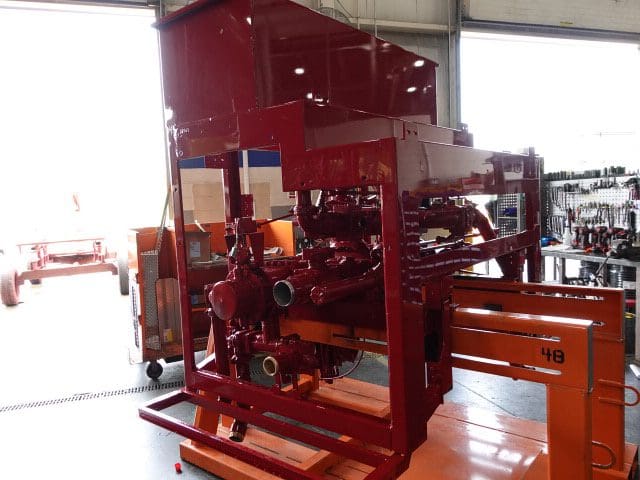

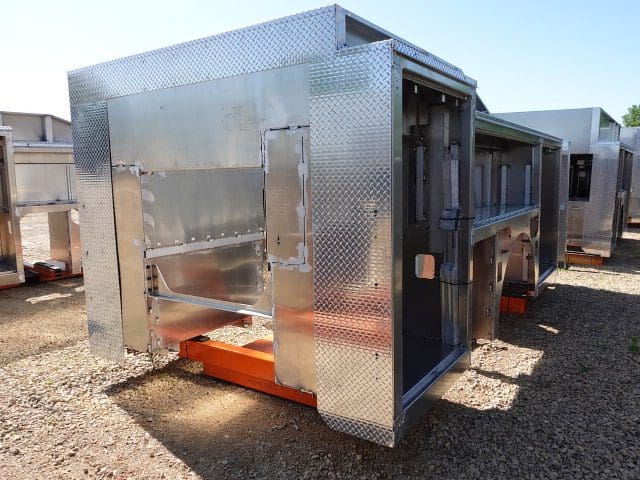

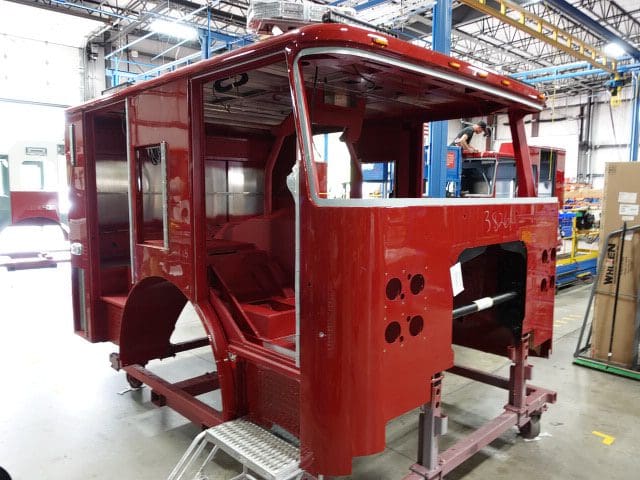

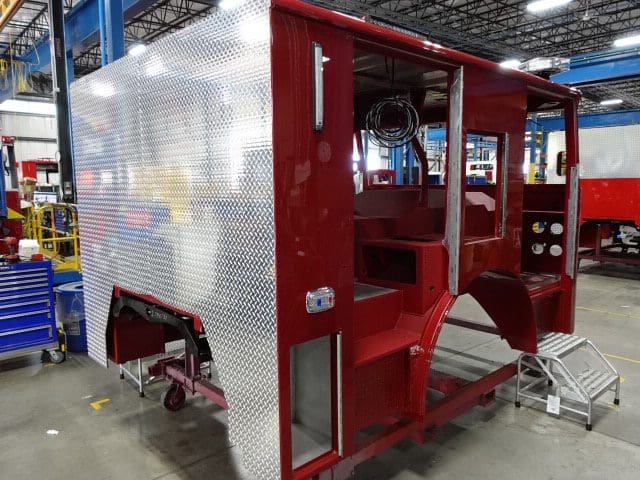

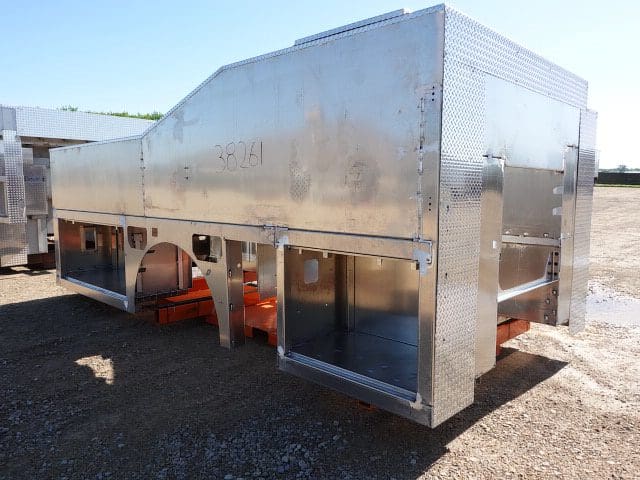

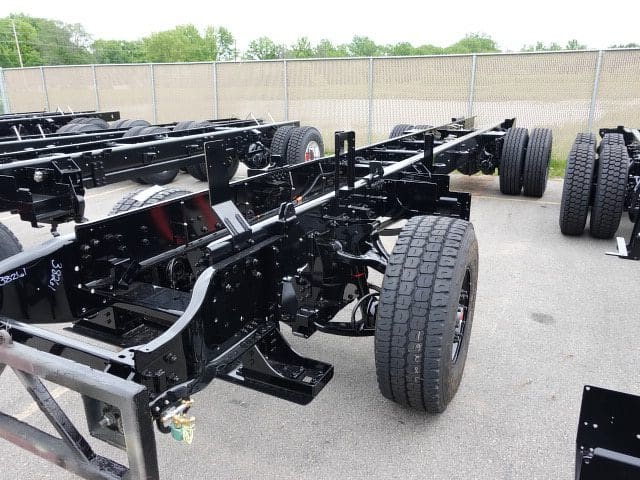

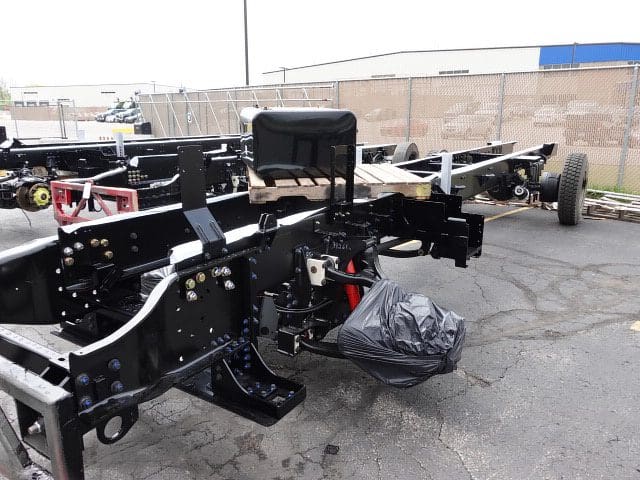

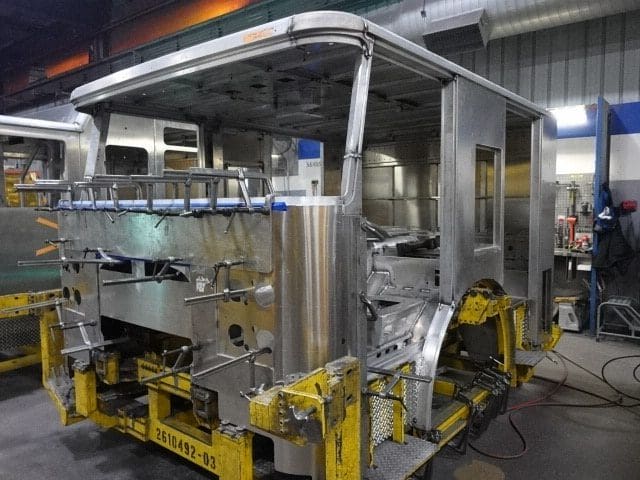

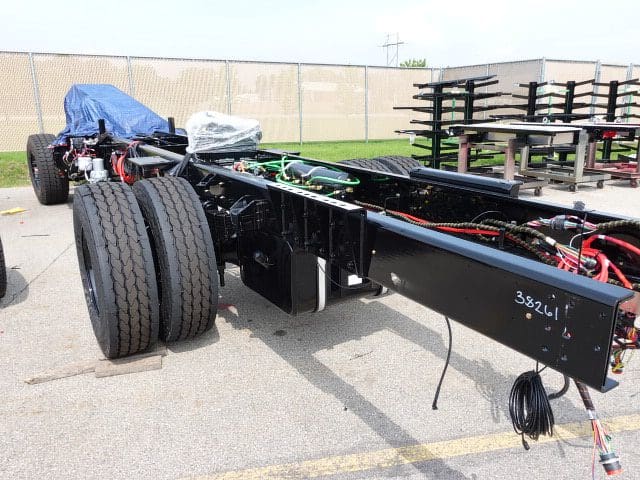

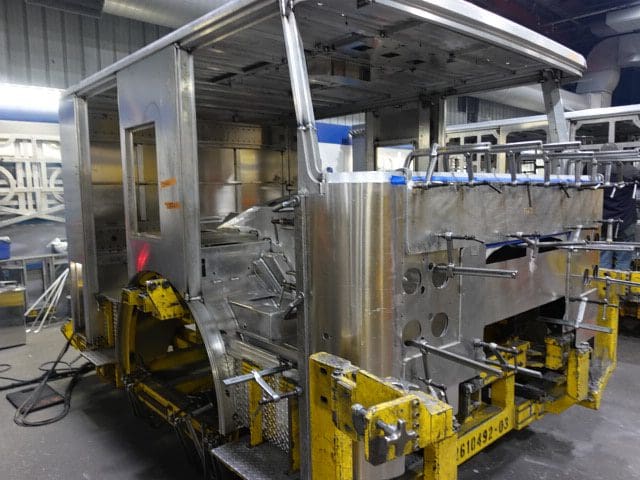

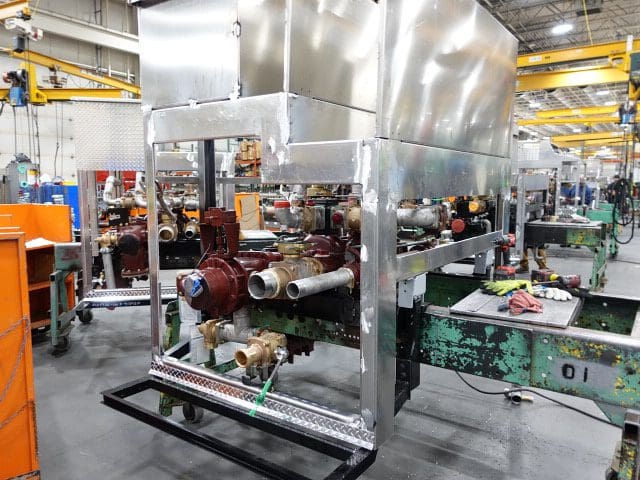

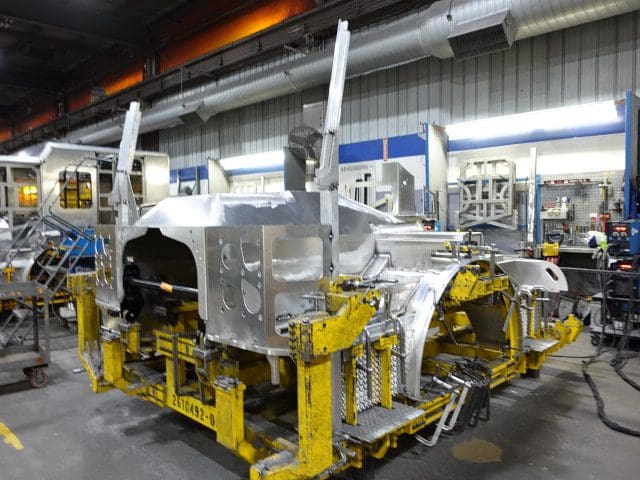

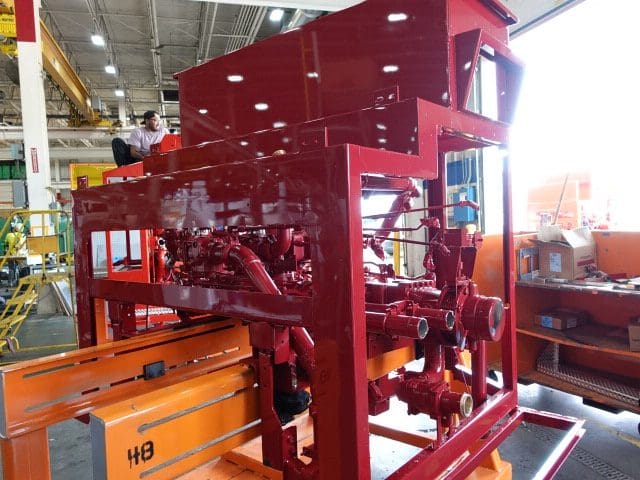

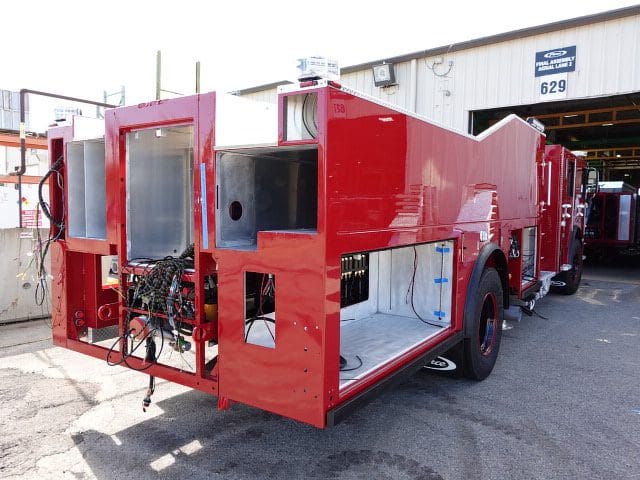

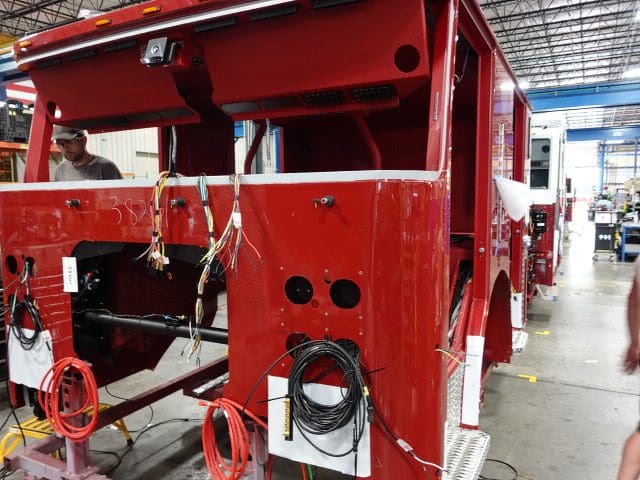

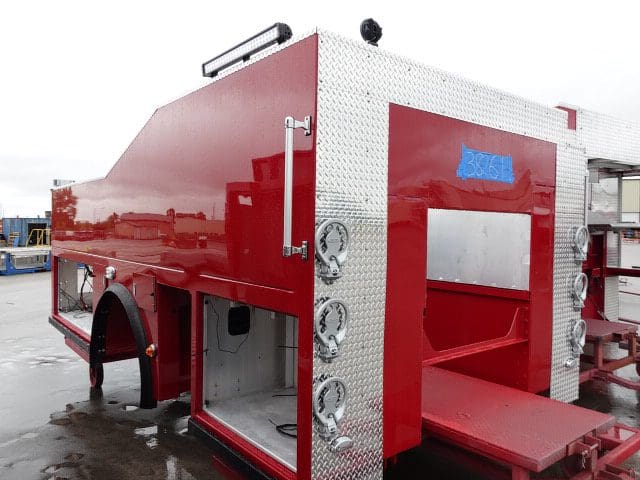

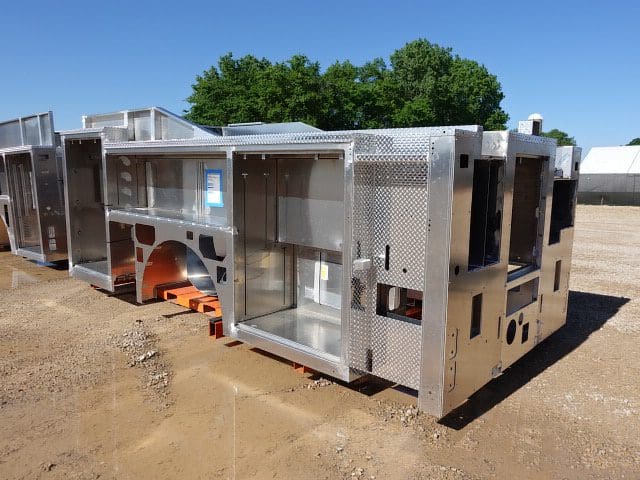

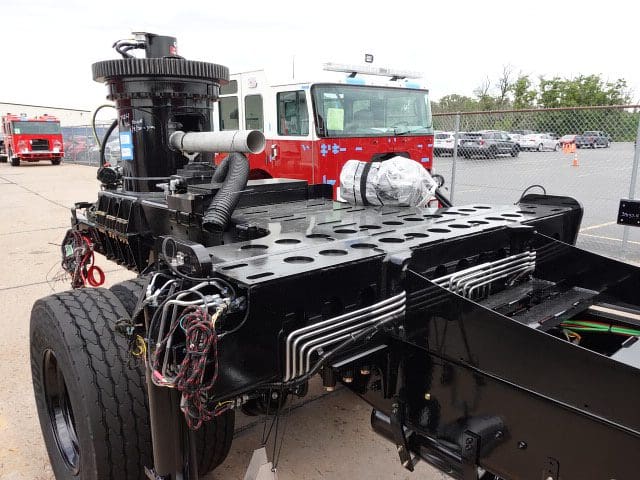

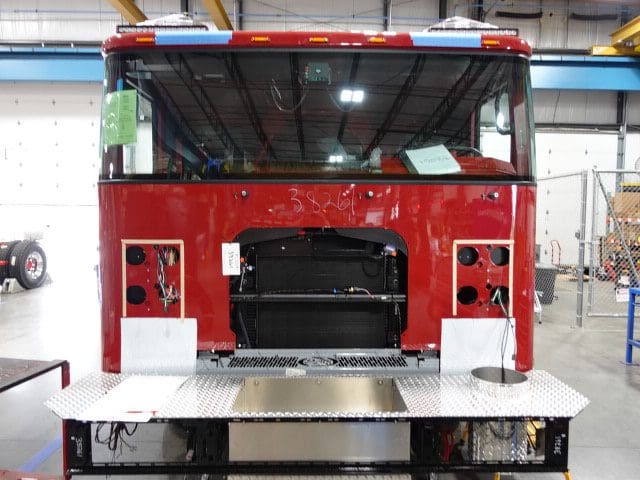

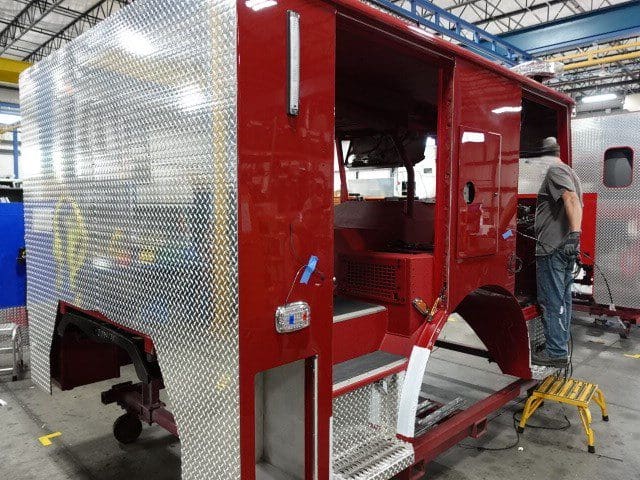

In this report, the body was merged with the chassis followed by the completion of initial assembly.

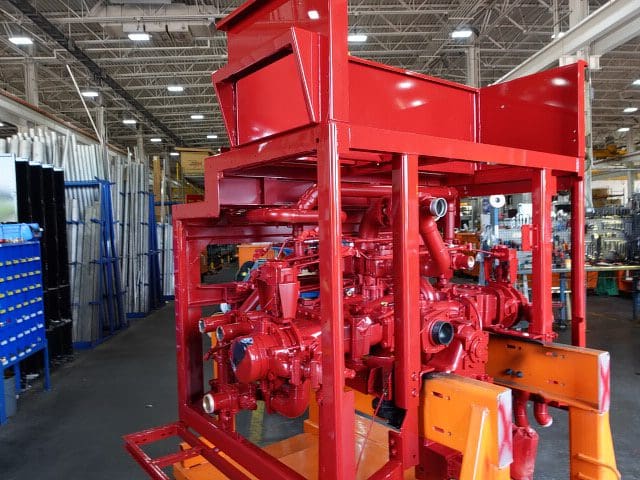

06-21-24

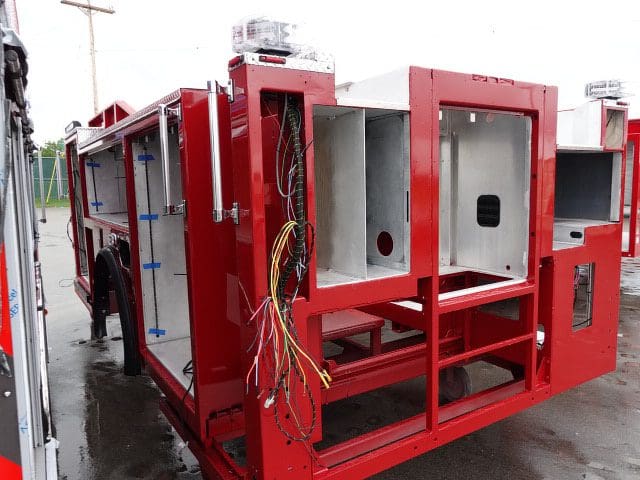

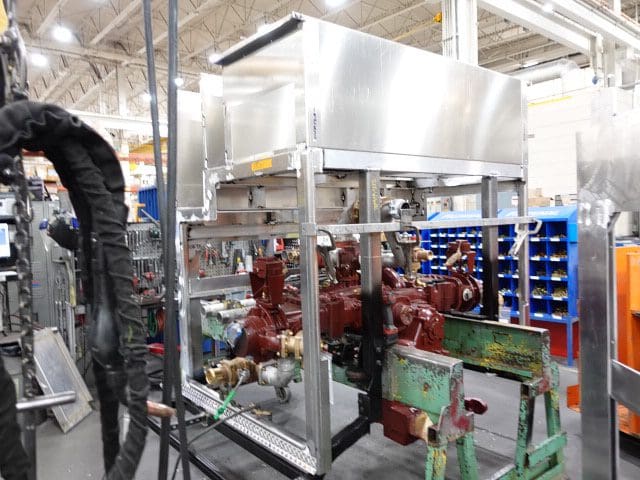

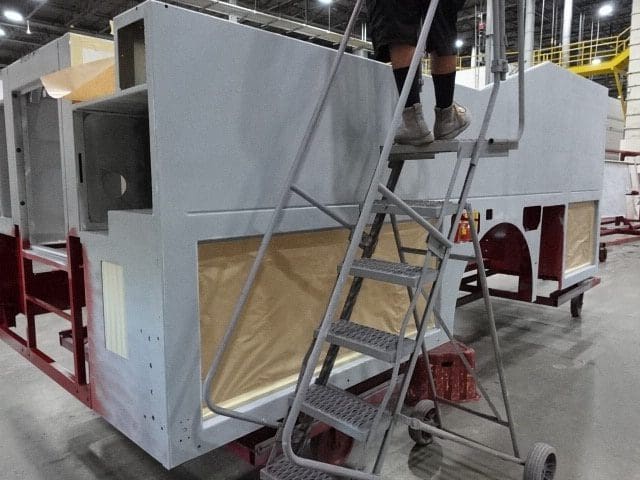

In this report, the pump house and pedestal were merged with the chassis with assembly continuing while the body completed paint and initial assembly.

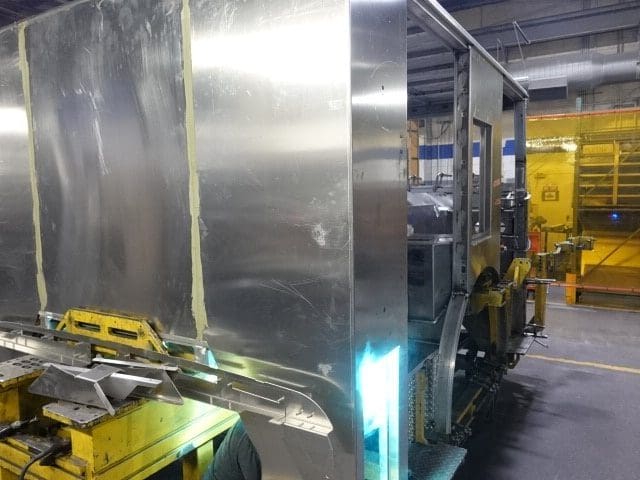

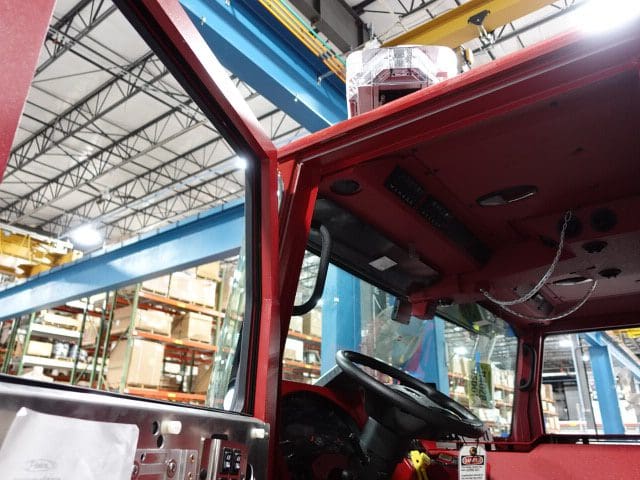

06-14-24

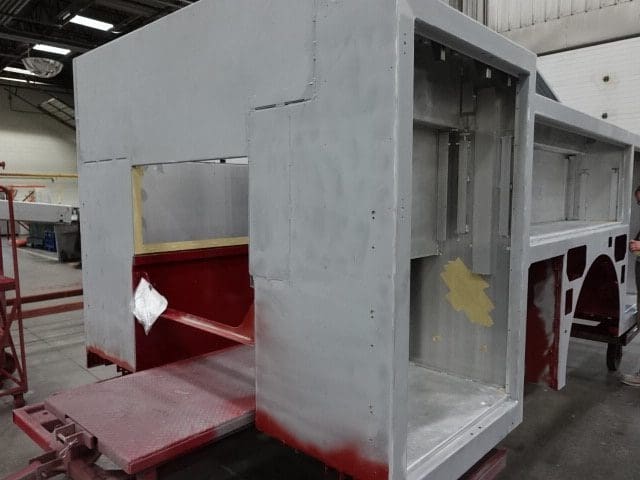

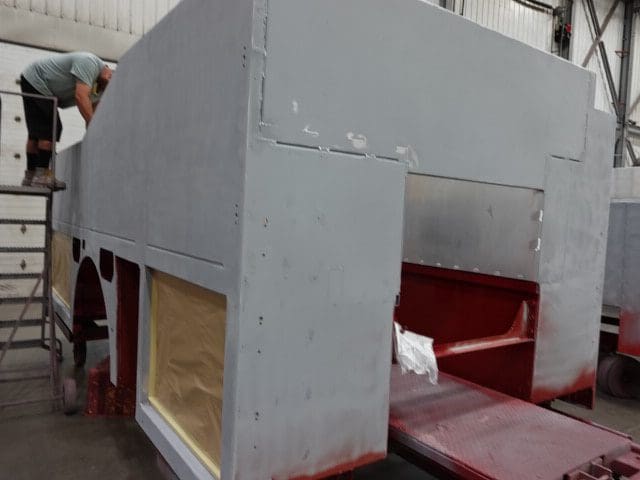

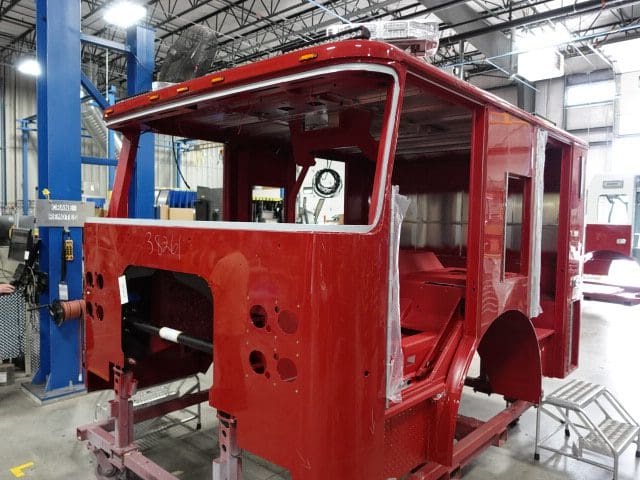

In this report, the cab was installed on the frame, the pump house completed initial assembly, the pedestal was staged, and the body began the paint process.
06-07-24
In this report, the cab continued initial assembly, the frame build continued, the pump house was painted then continued initial assembly, and the body remained staged.
05-31-24

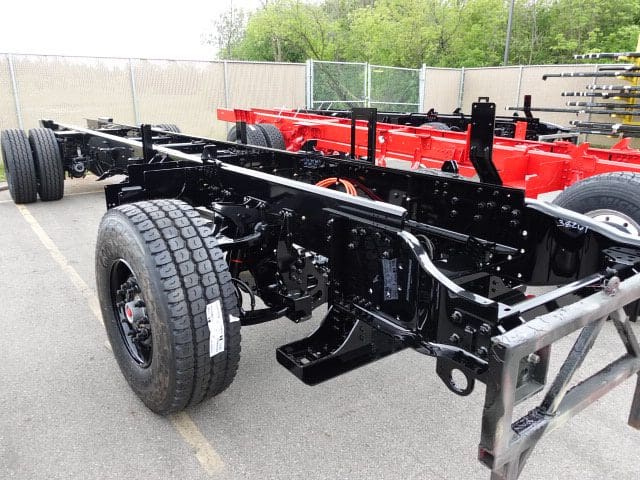

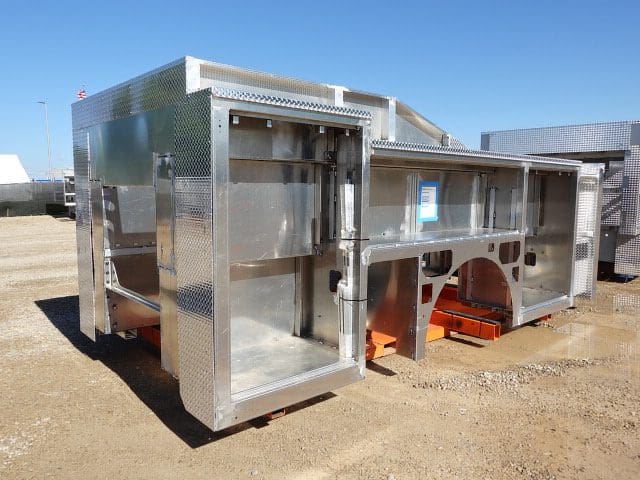

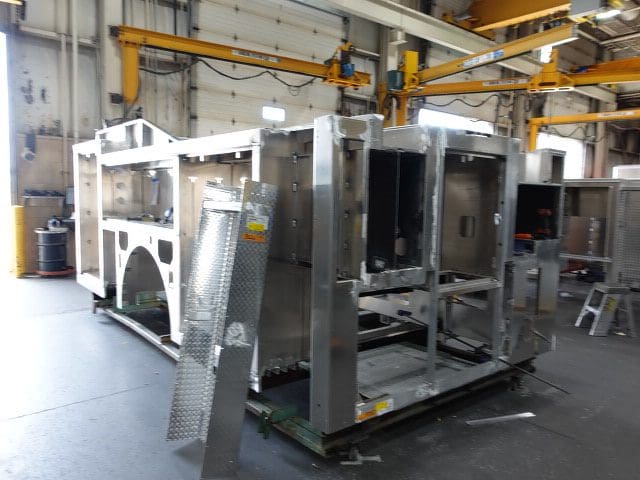

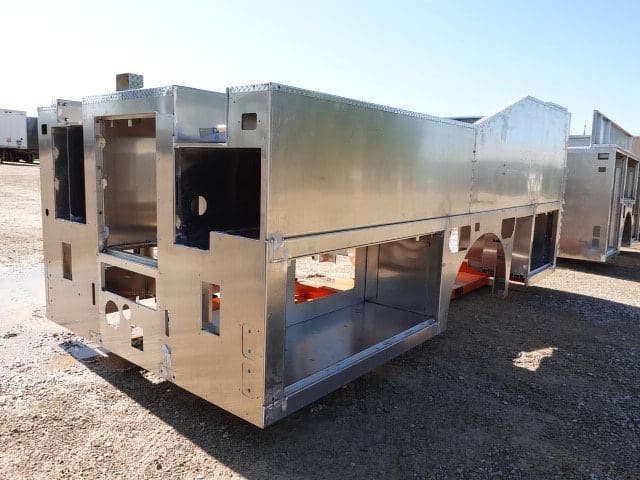

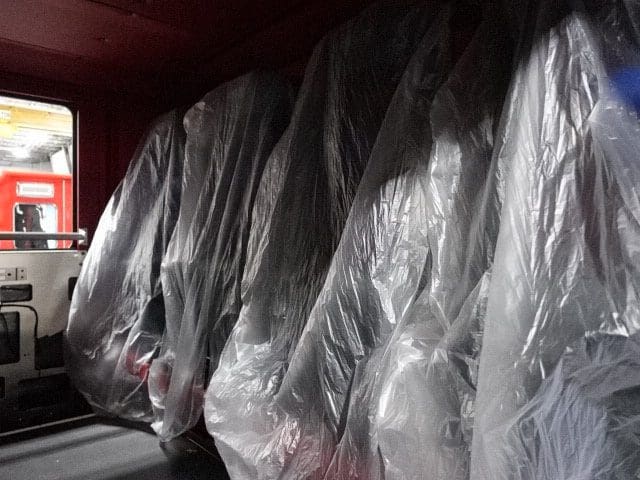

In this report, the cab began initial assembly, the frame build continued, the pump house continued initial assembly, and the body completed fabrication.
05-24-24

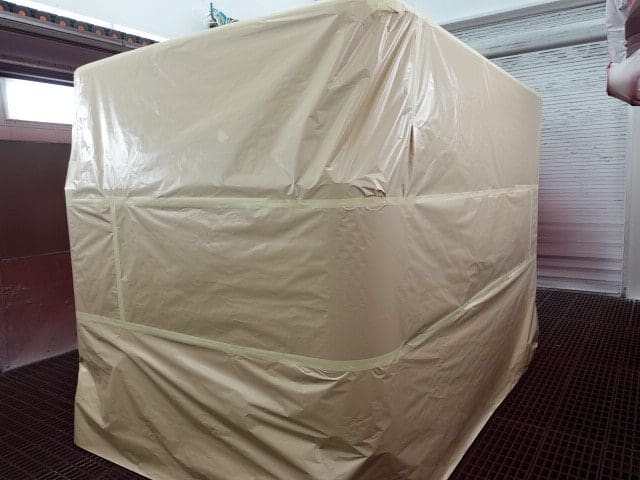

In this report, the cab was offsite having protective coating applied (no photos), the frame build continued, the pump house began initial assembly, and the body began fabrication.
05-17-24

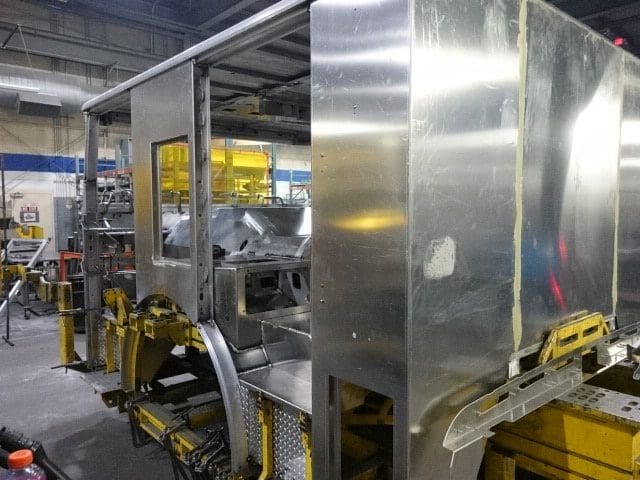

In this report, the cab completed fabrication and began the paint process while the frame build began.
05-03-24
This new Pierce apparatus is now in production! In this report, the cab began fabrication.
