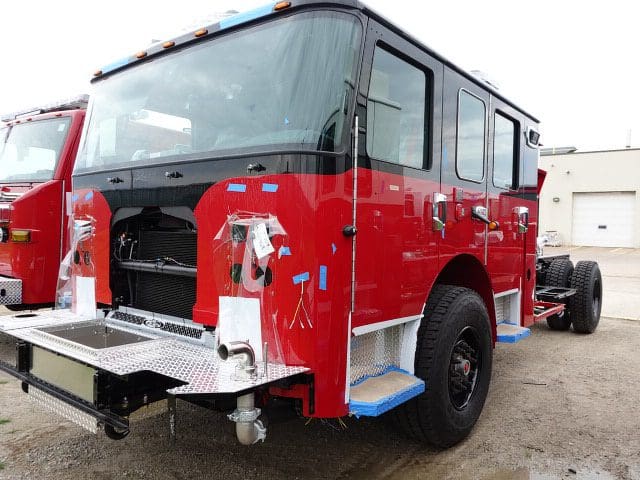

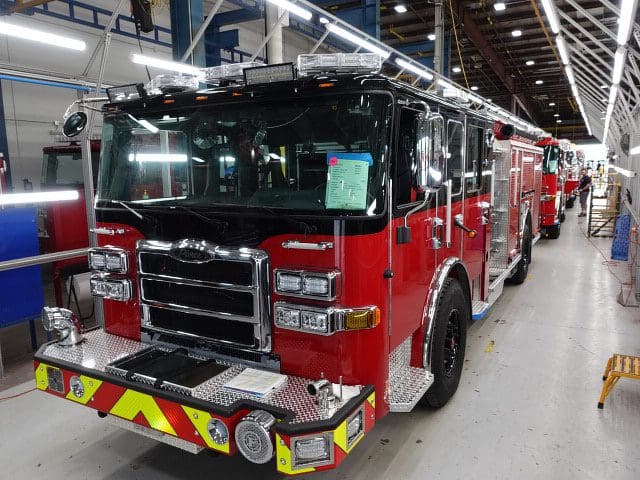

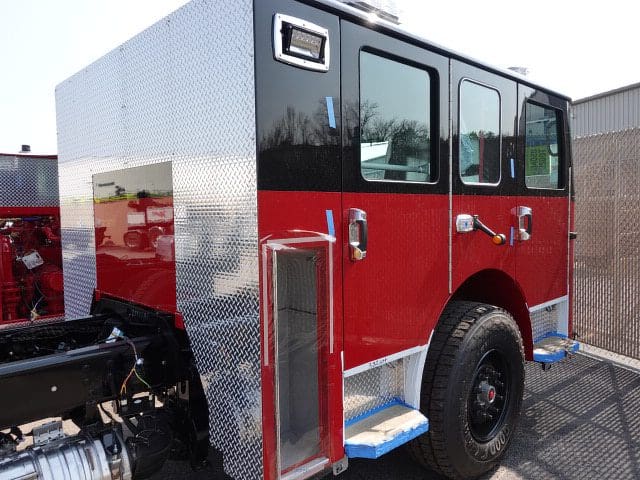

06-28-24

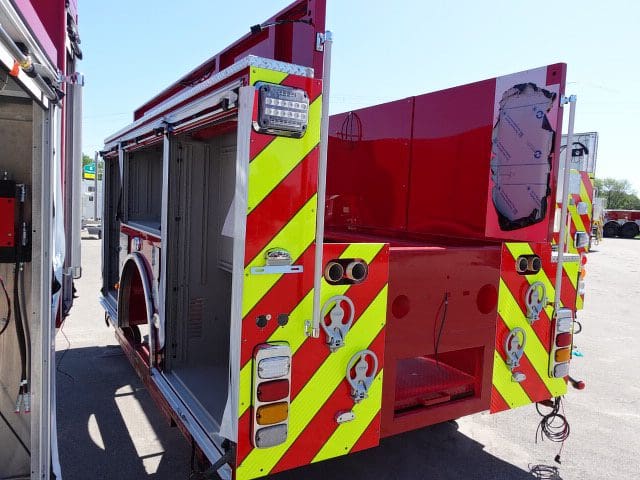

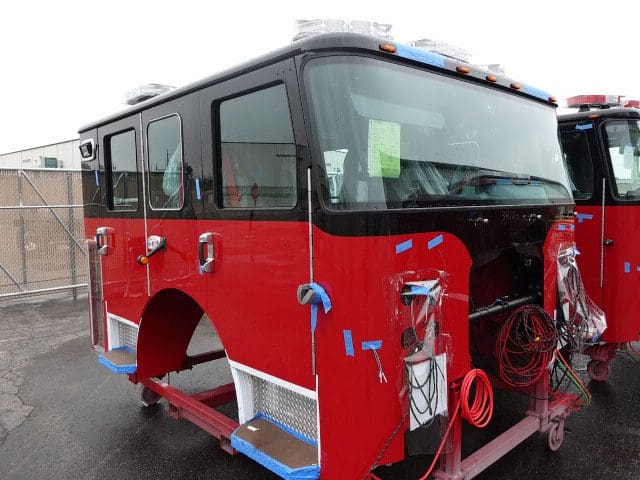

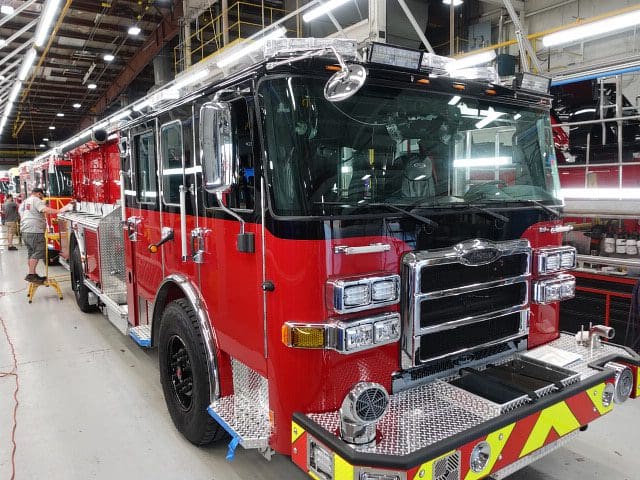

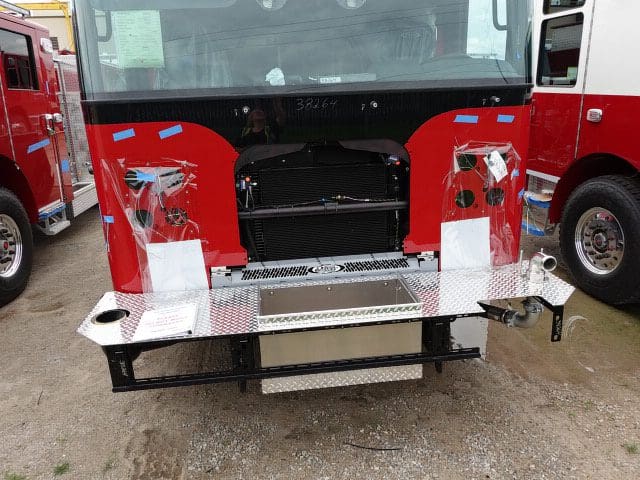

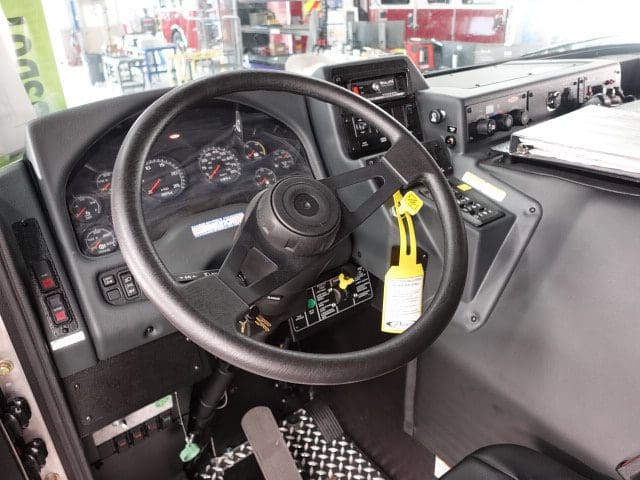

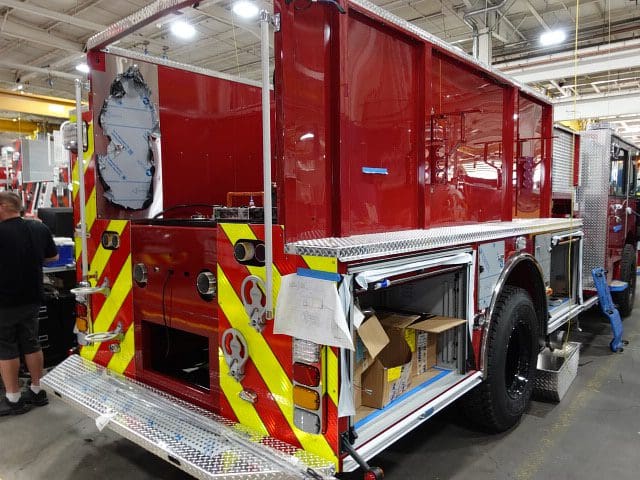

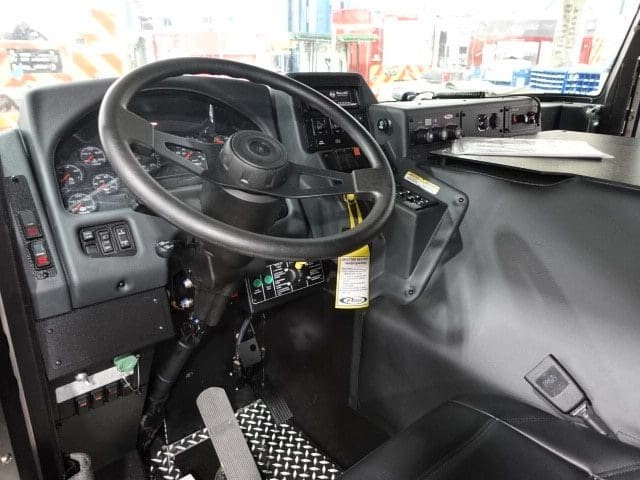

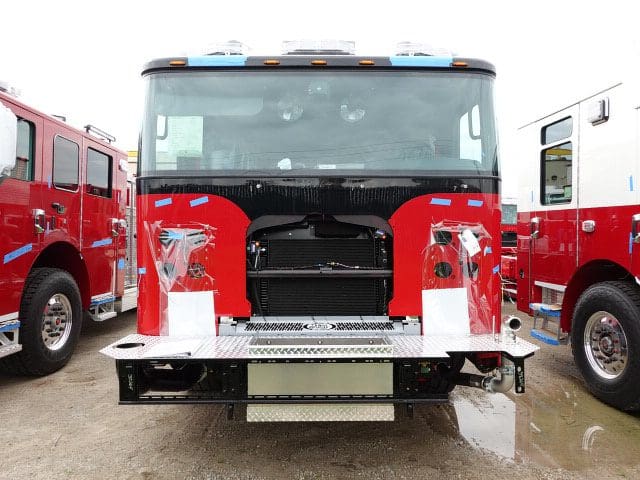

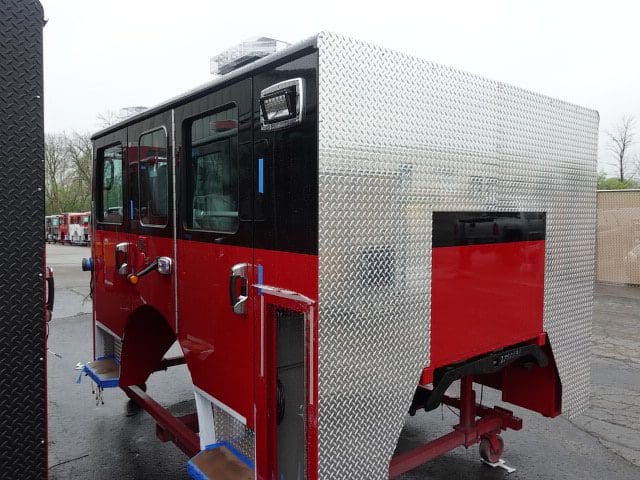

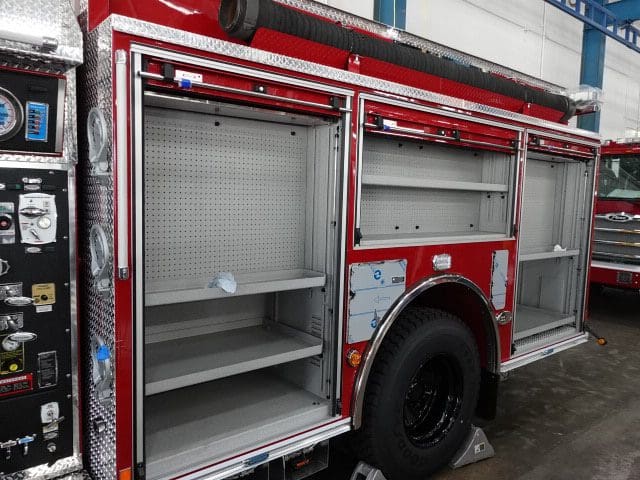

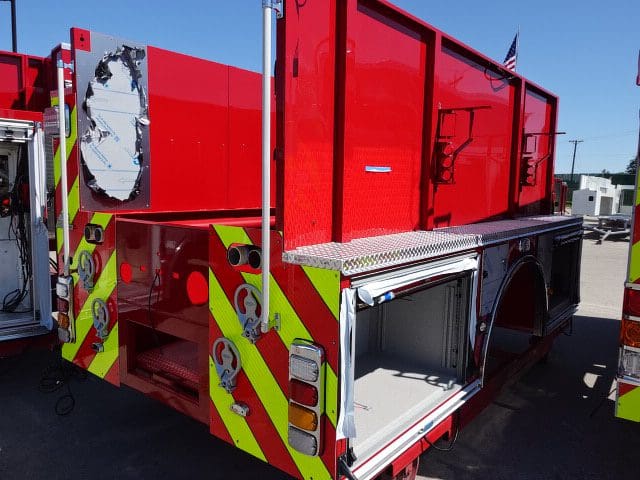

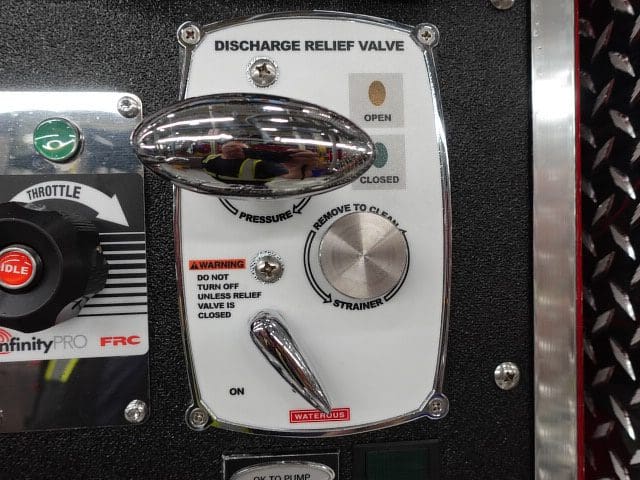

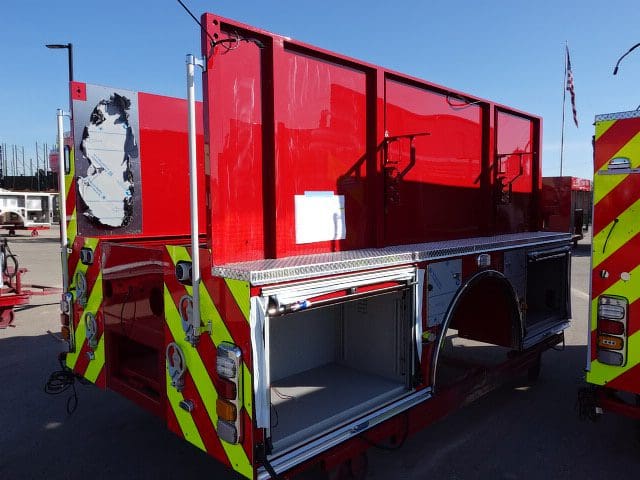

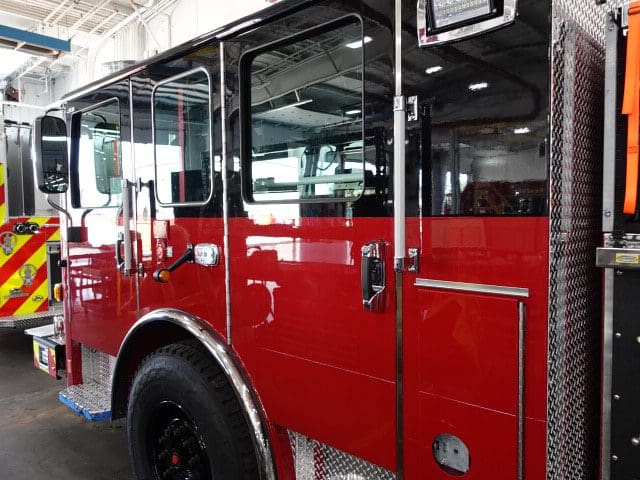

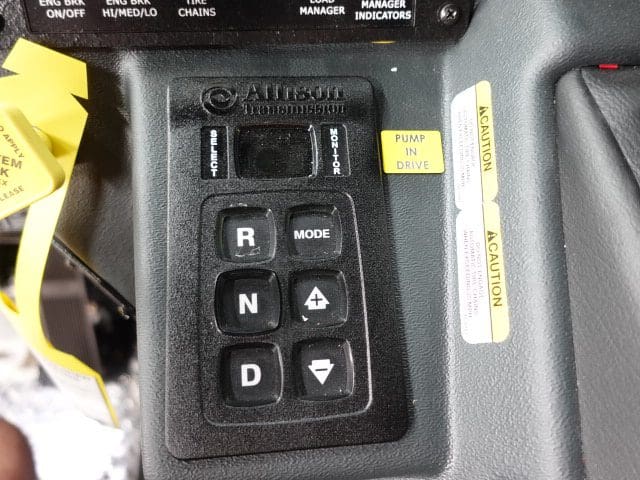

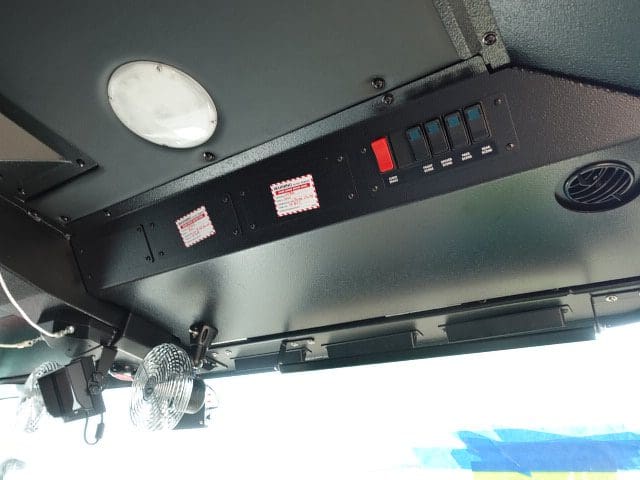

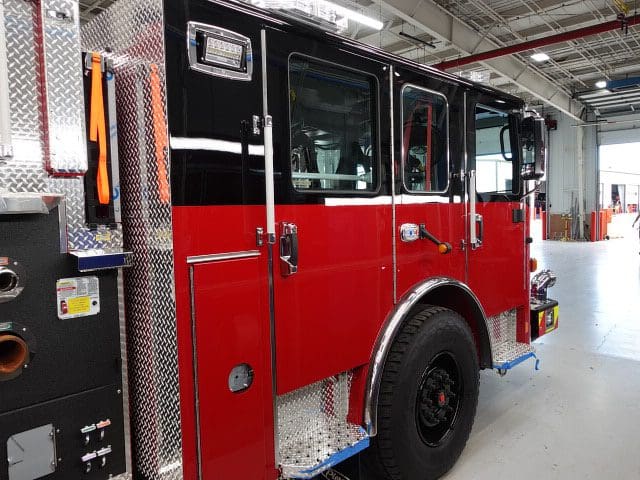

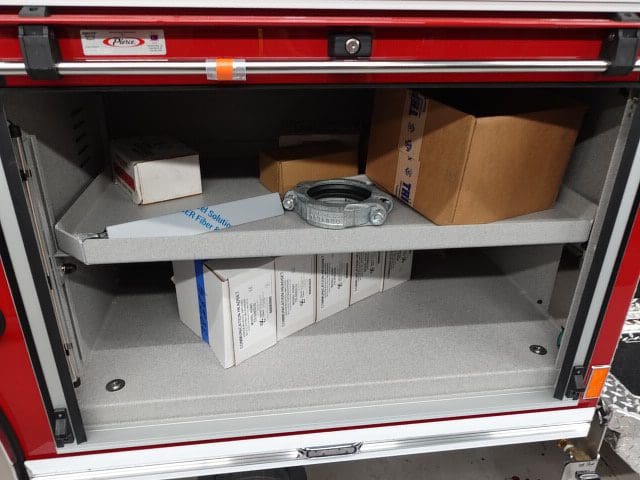

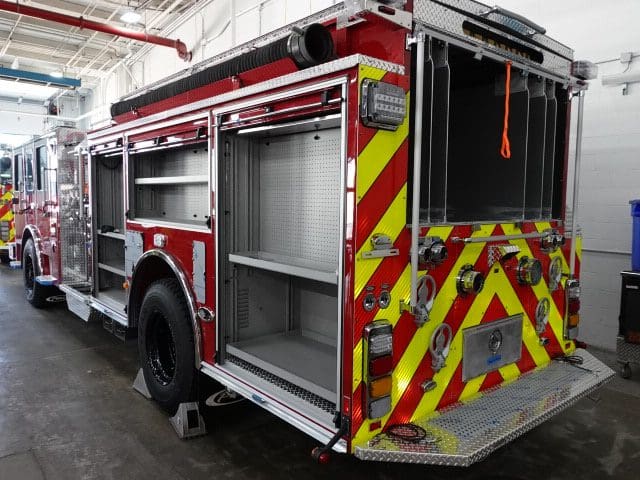

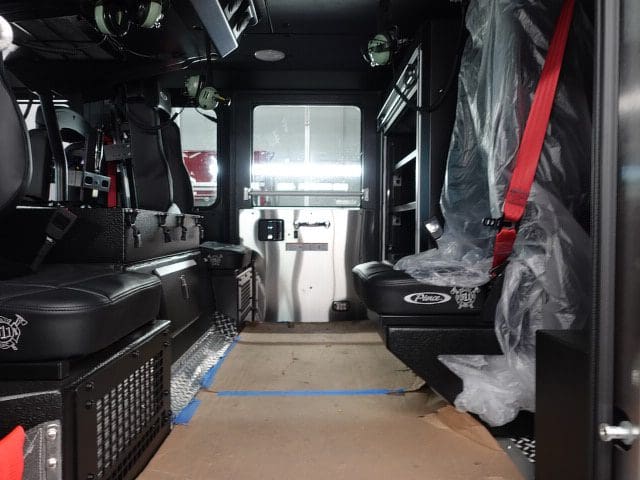

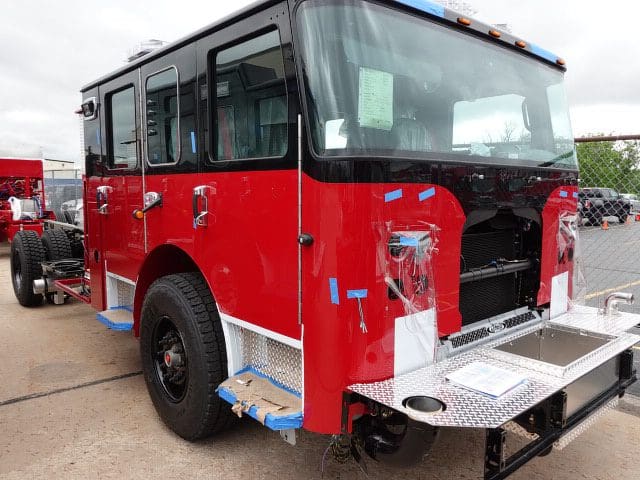

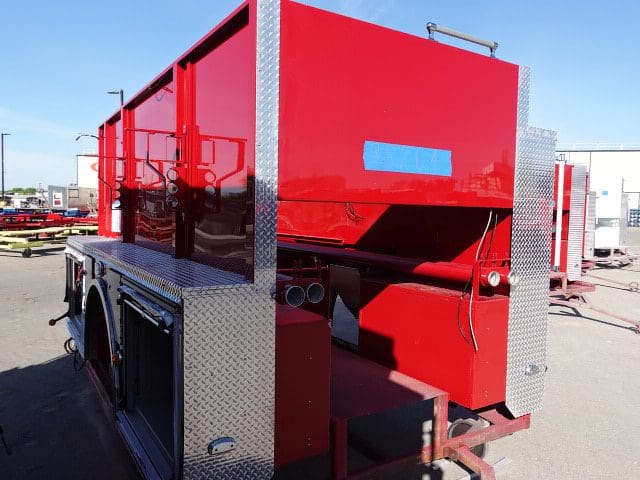

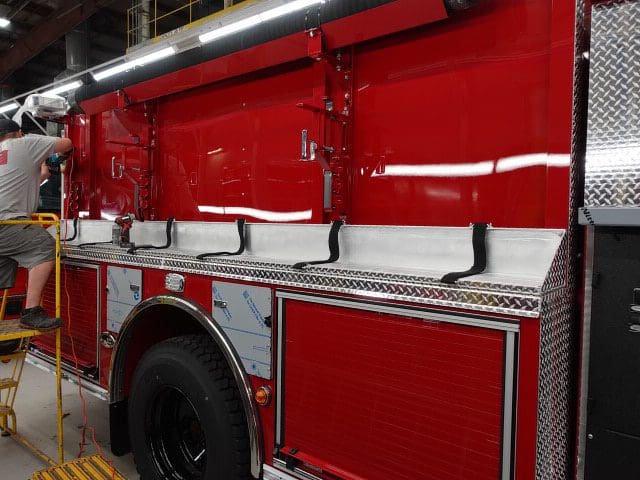

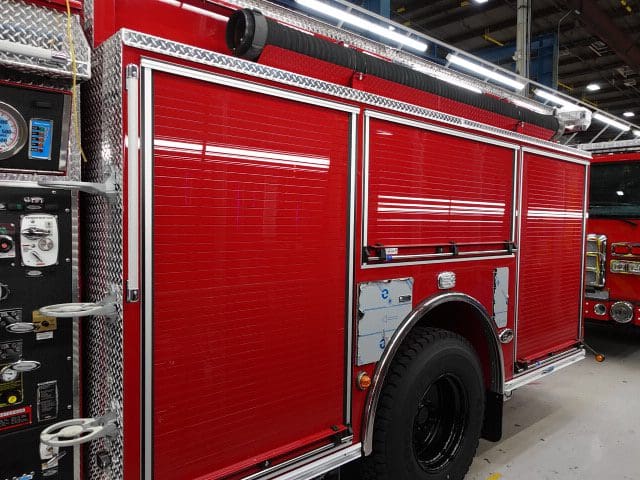

In this report, the apparatus continued the quality and graphics process where any remaining content will be applied. Once finished the apparatus will be made ready for the customer acceptance
inspection. This is the last scheduled report.
06-21-24

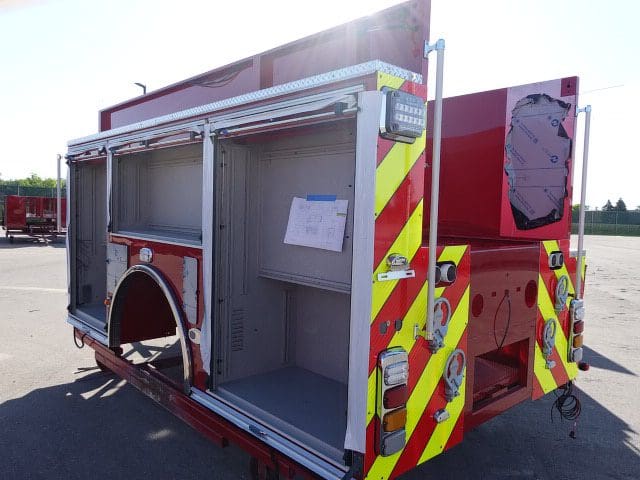

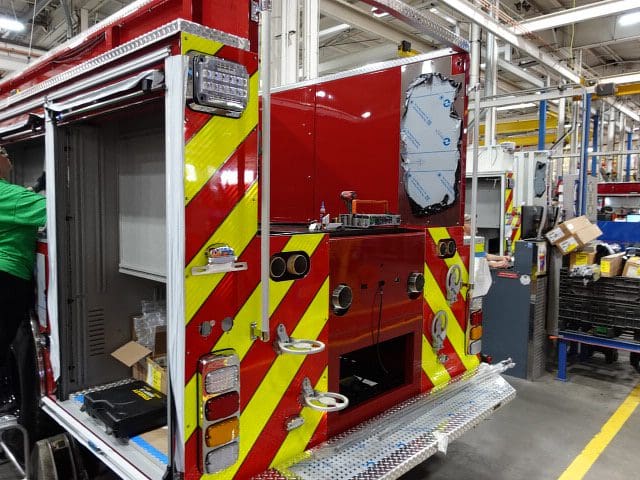

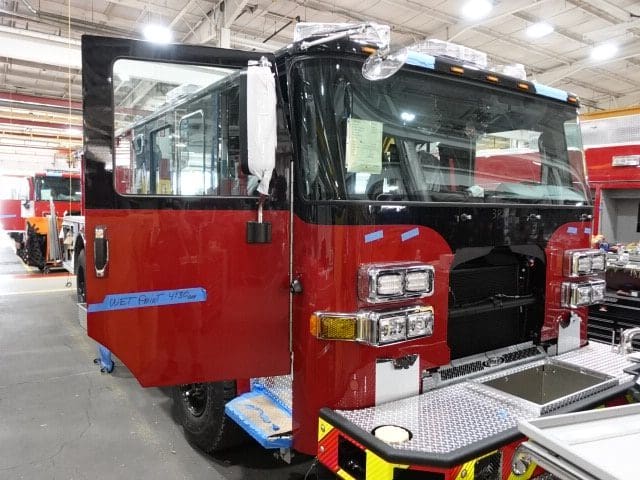

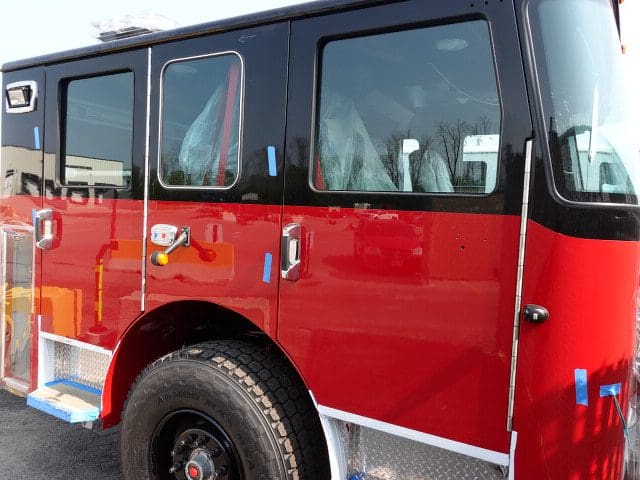

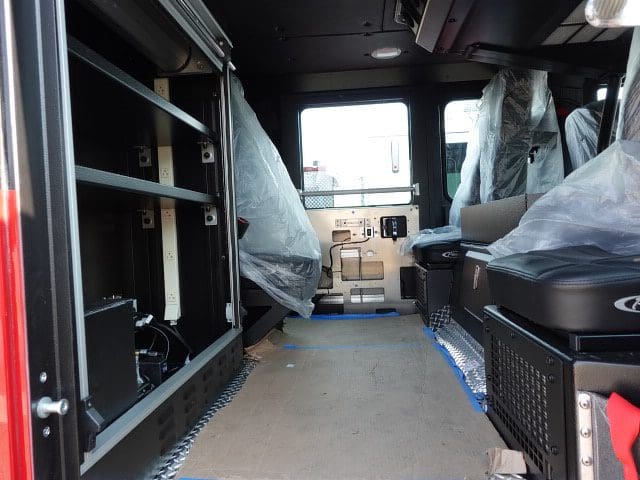

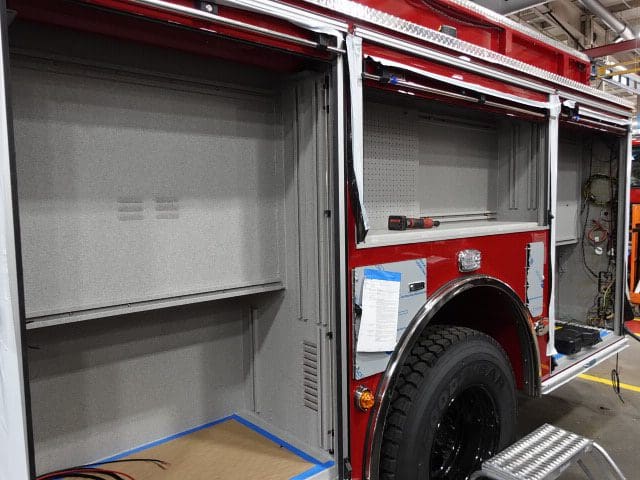

In this report, the apparatus completed test and released to quality and graphics where any remaining content will be applied.

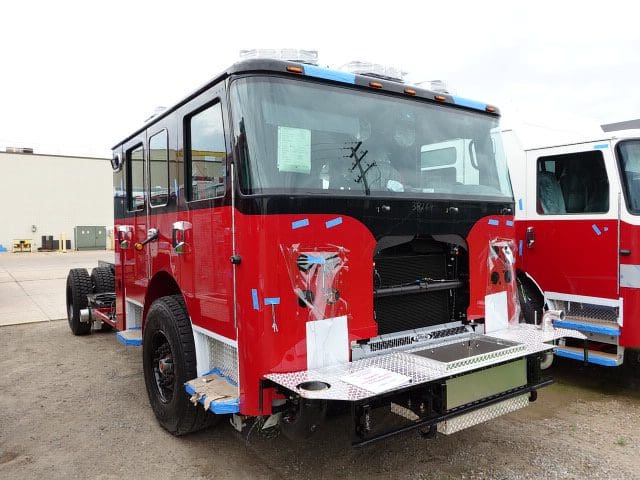

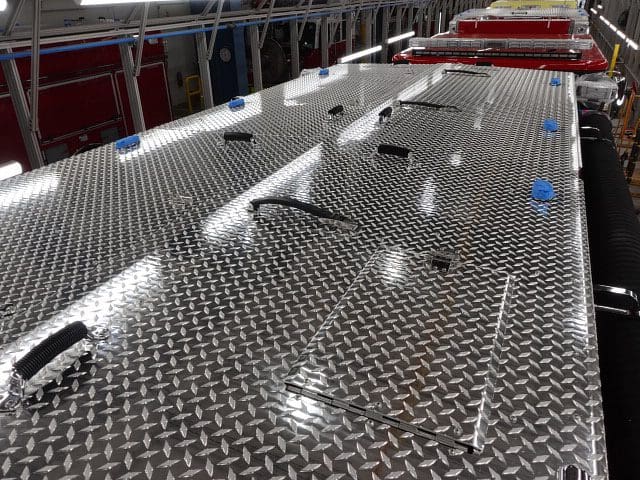

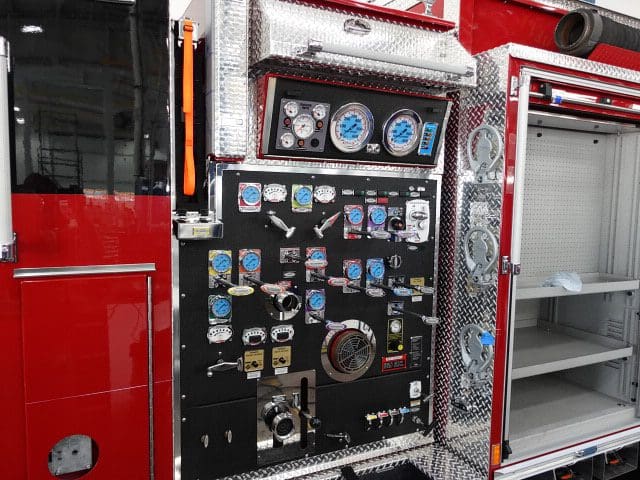

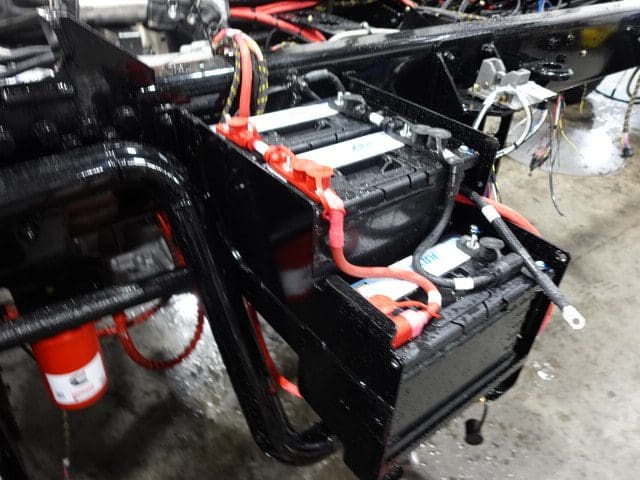

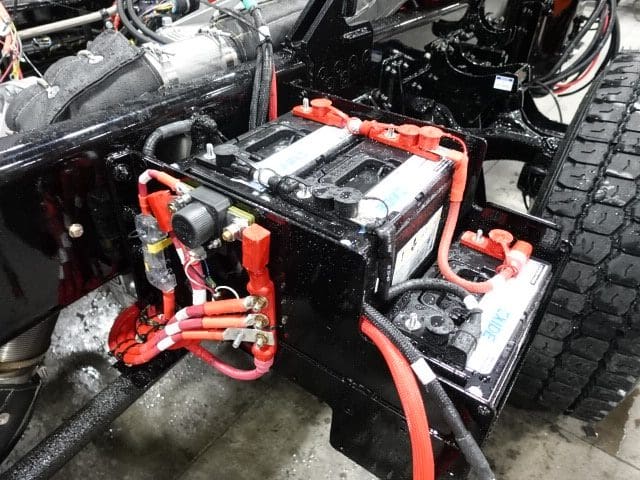

06-07-24

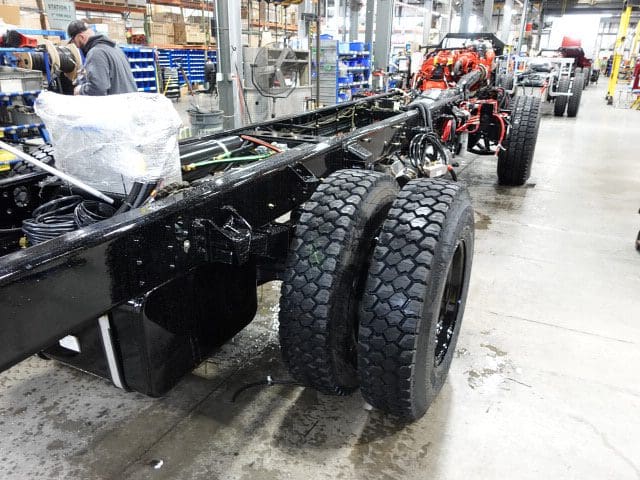

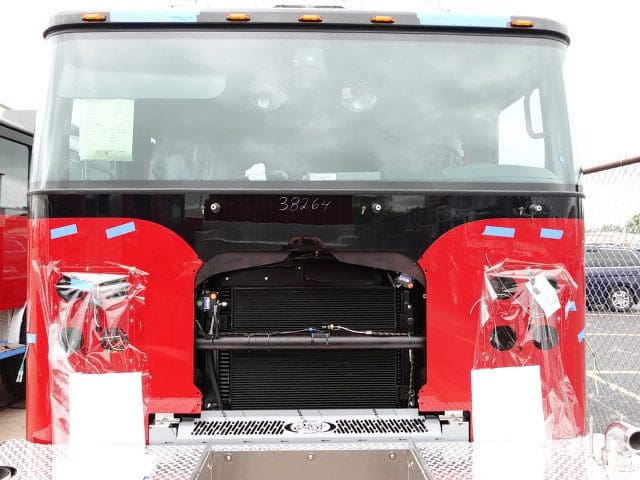

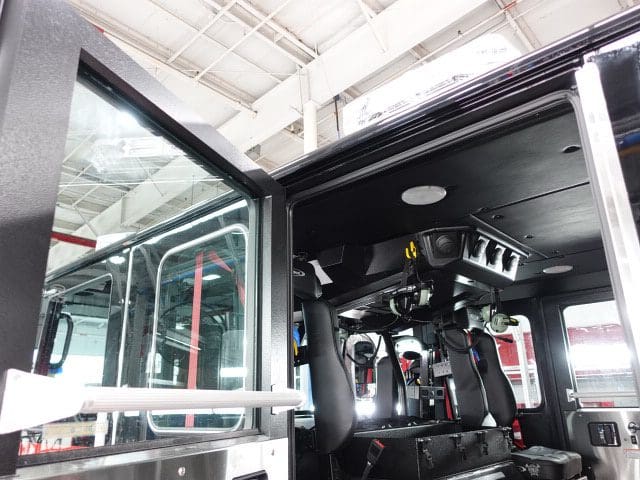

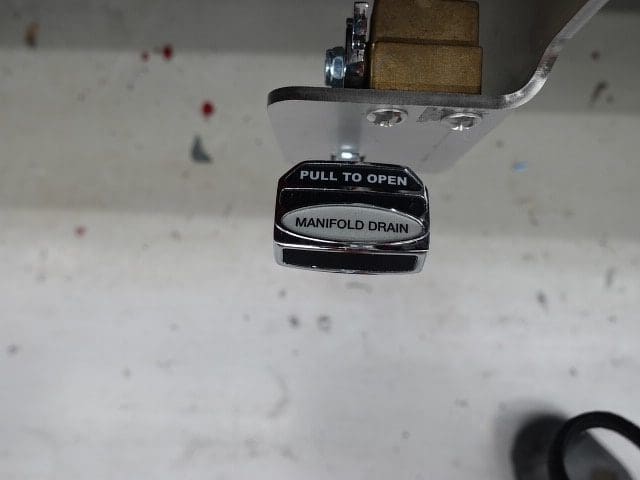

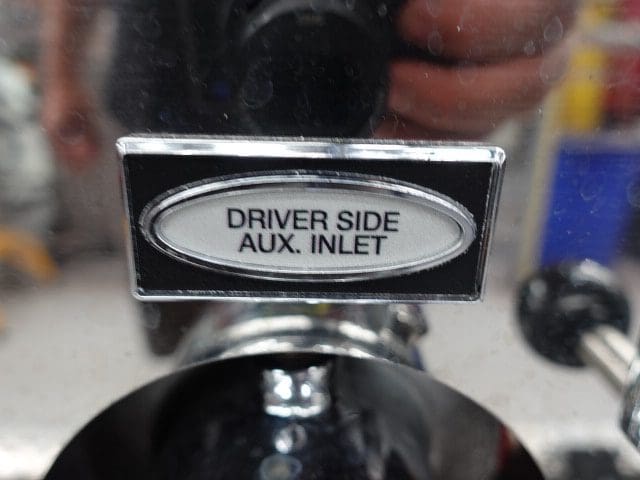

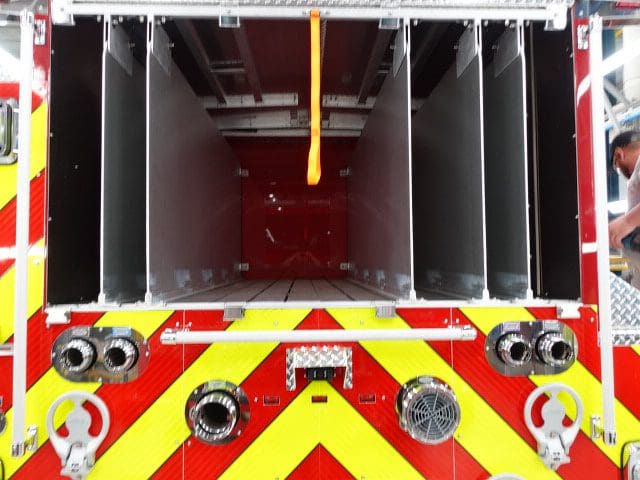

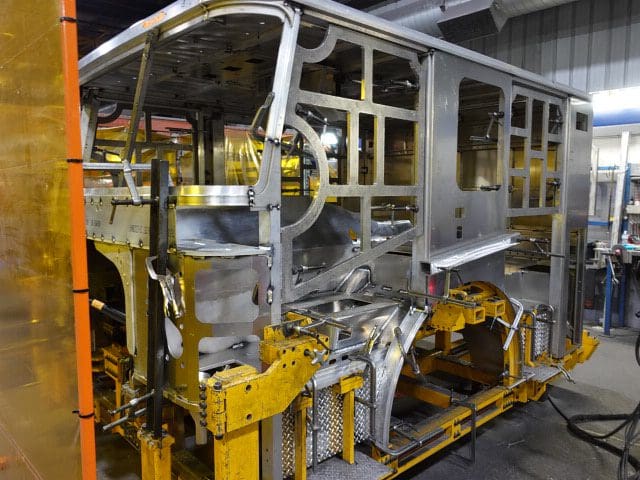

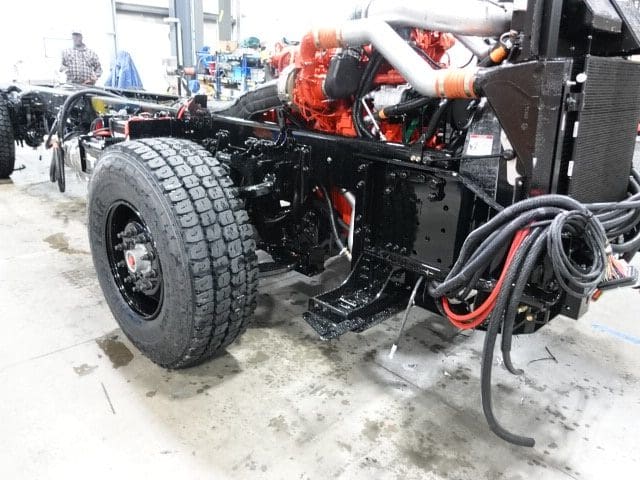

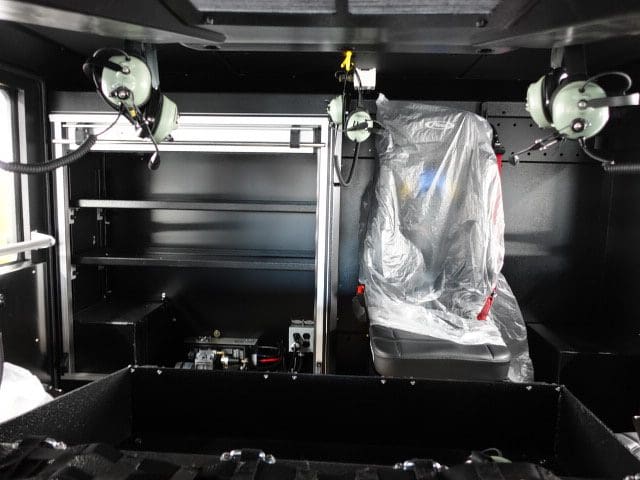

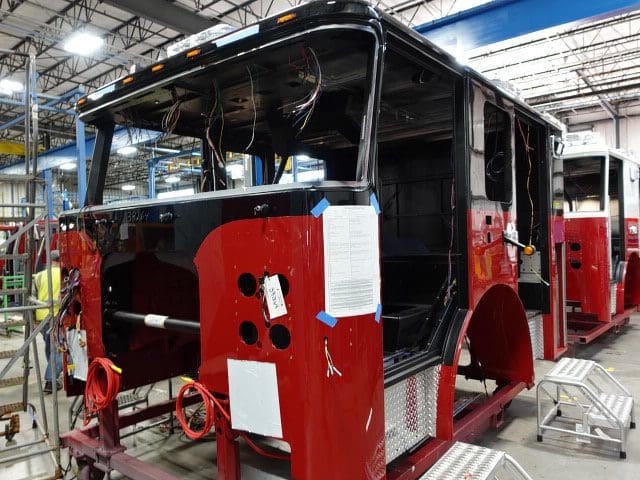

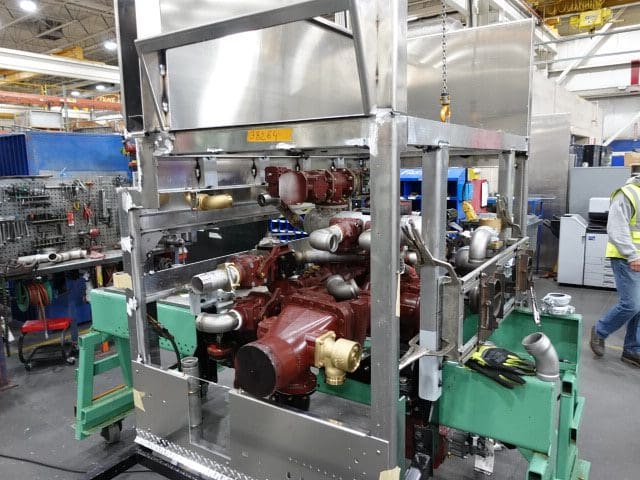

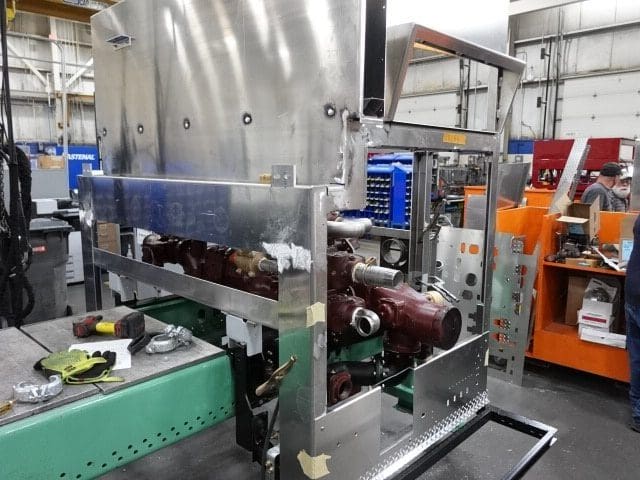

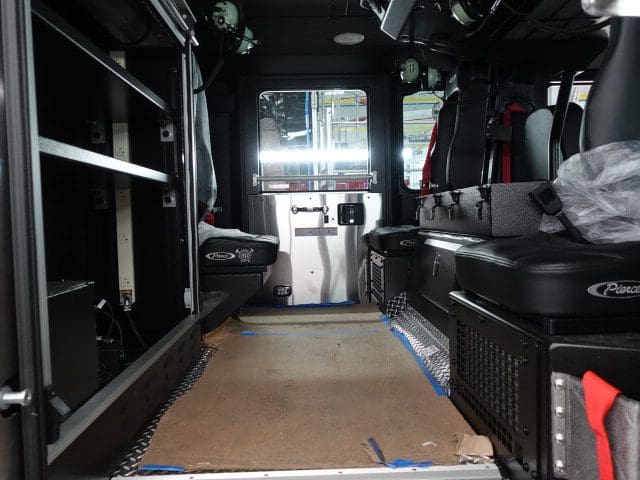

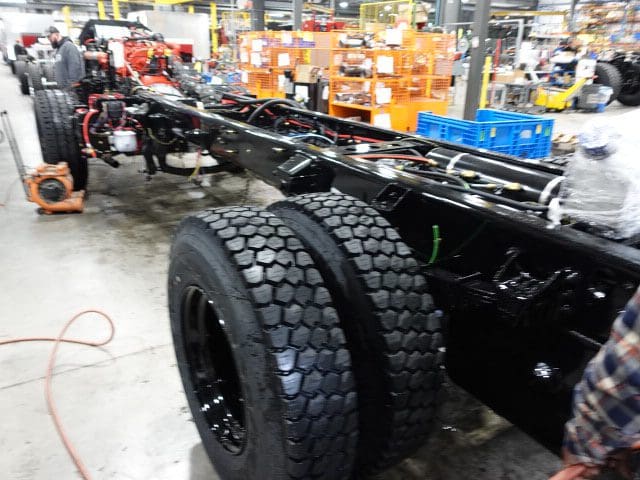

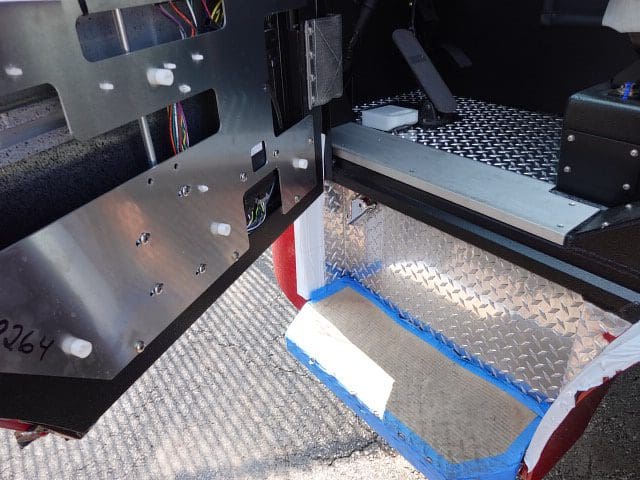

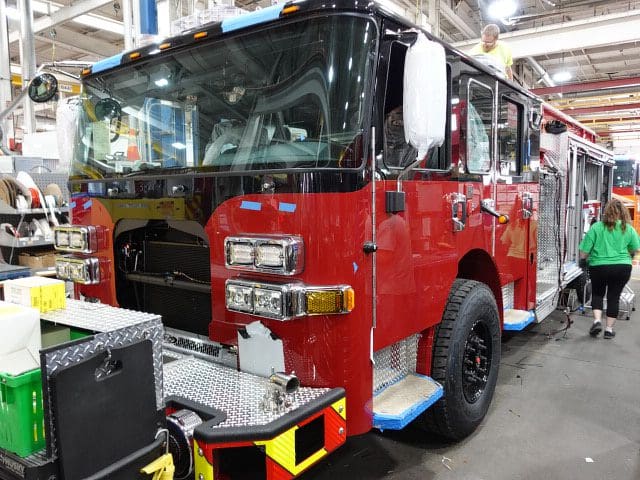

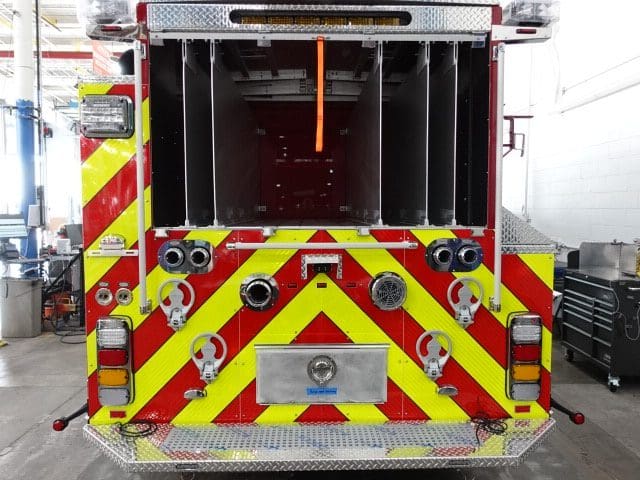

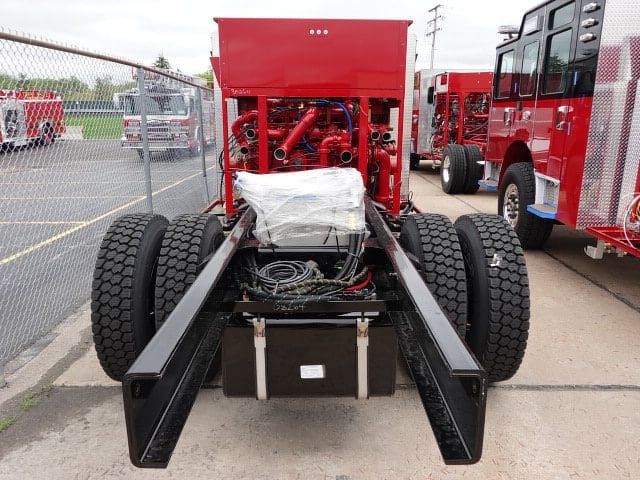

In this report, the body was merged with the chassis followed by the start of final assembly.
05-31-24

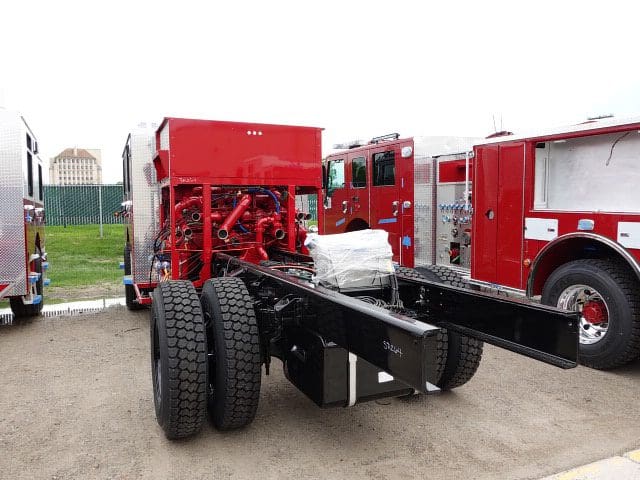

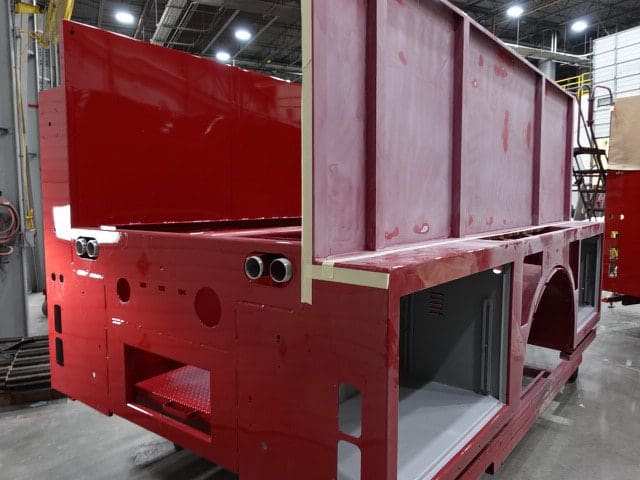

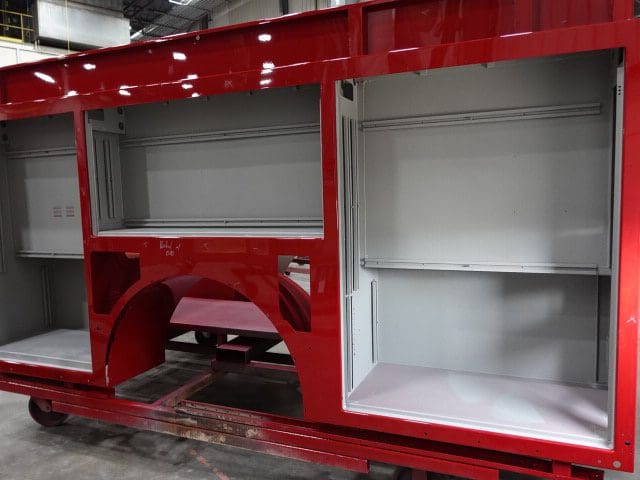

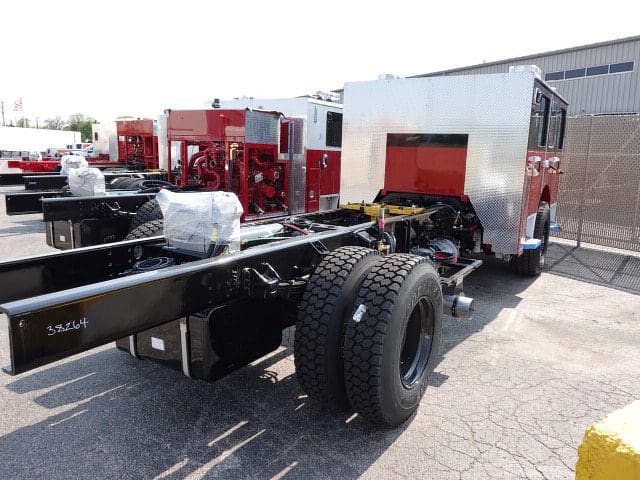

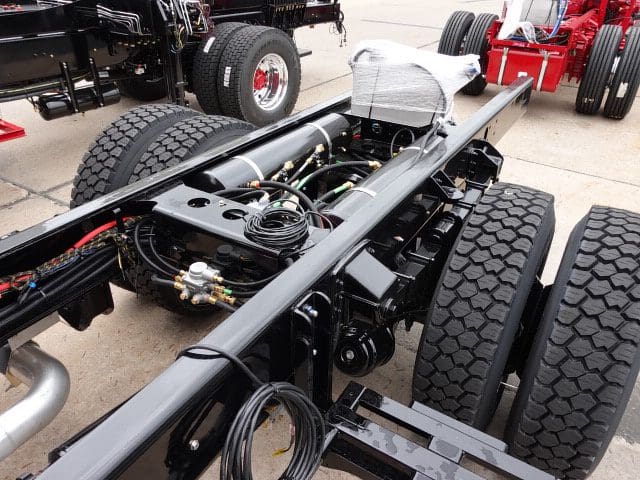

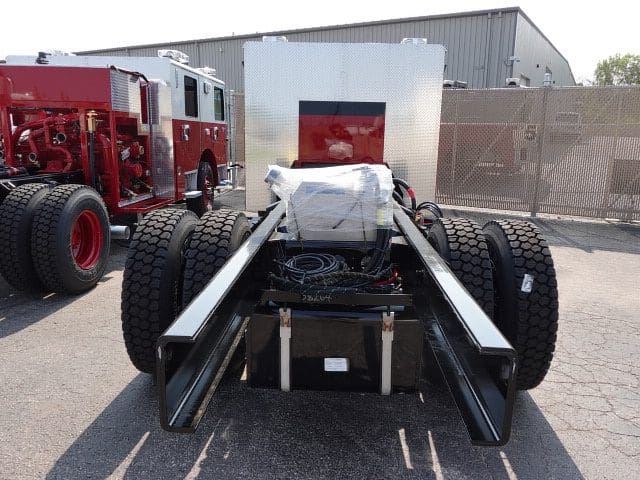

In this report, the chassis was staged to continue assembly while the body remained staged.
05-24-24

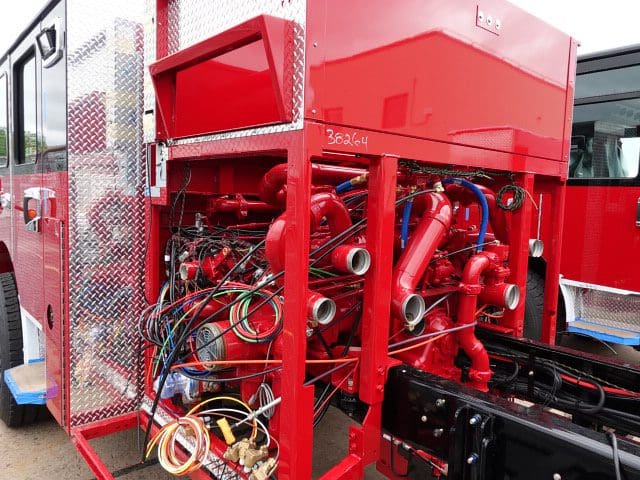

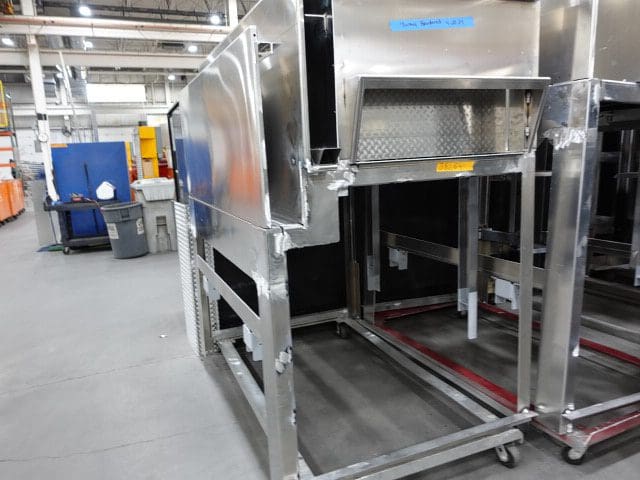

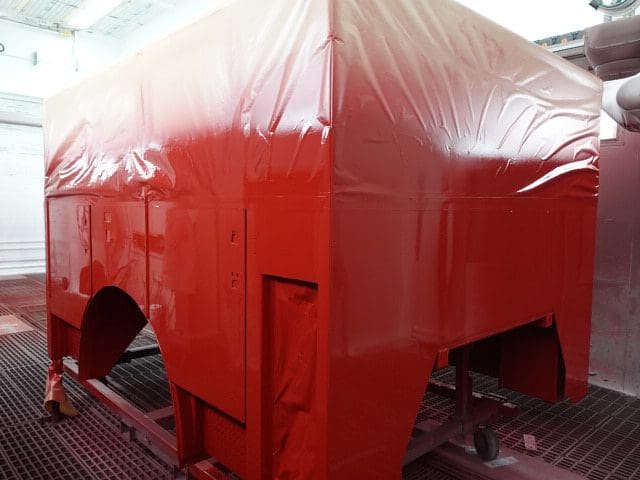

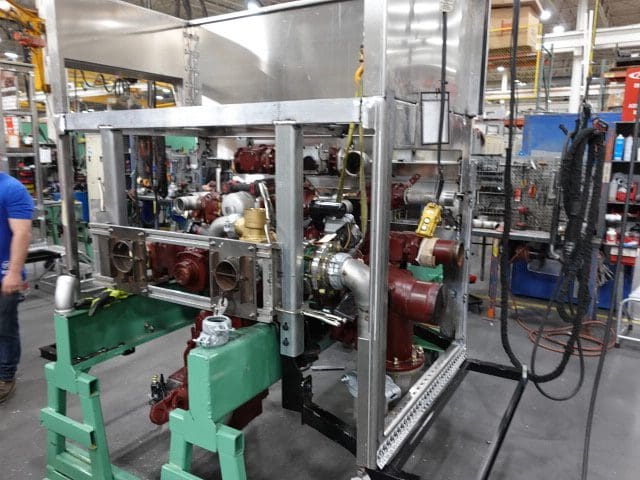

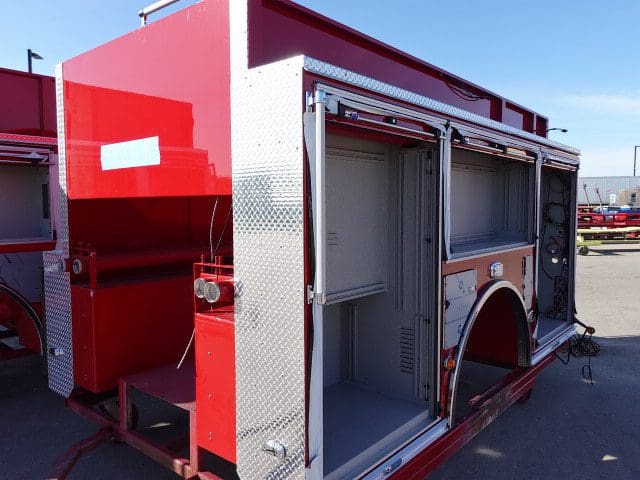

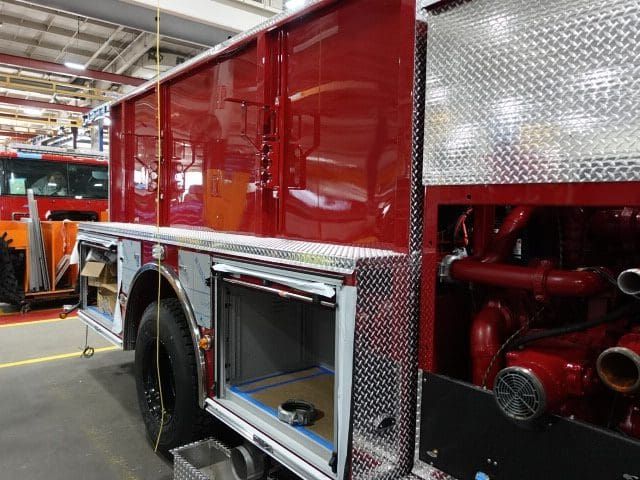

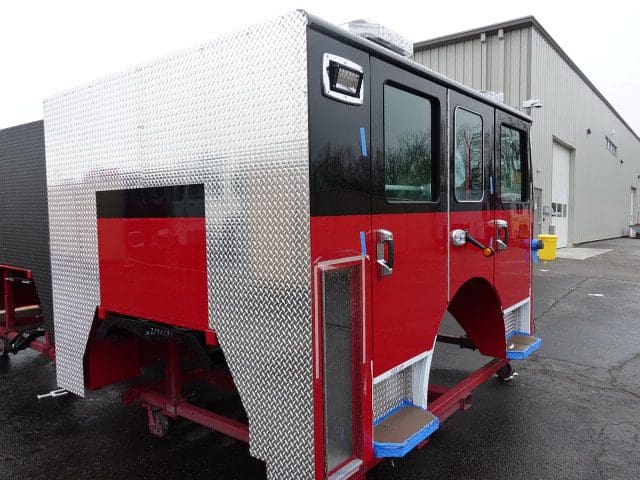

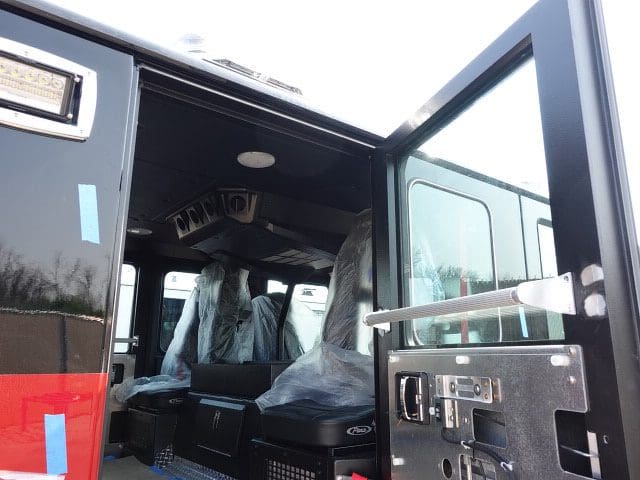

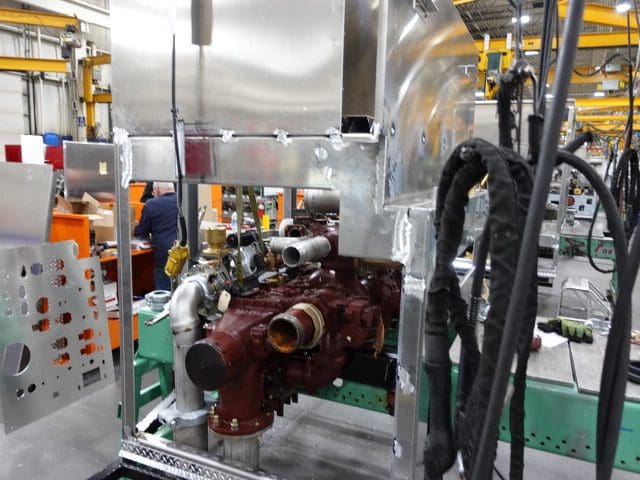

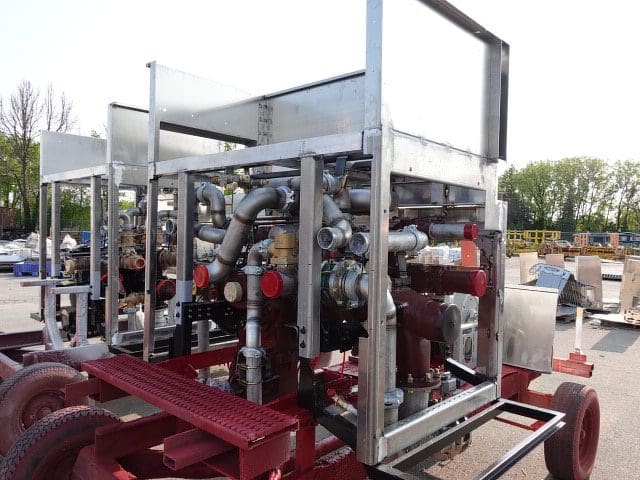

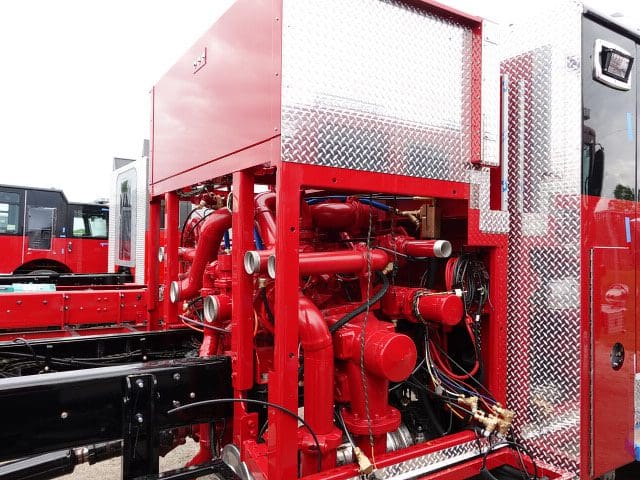

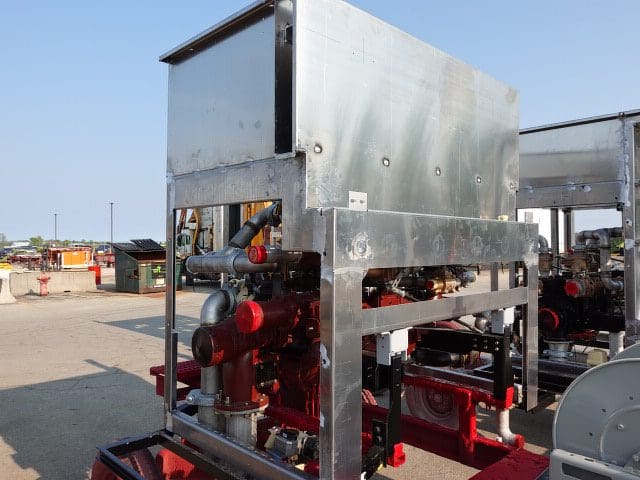

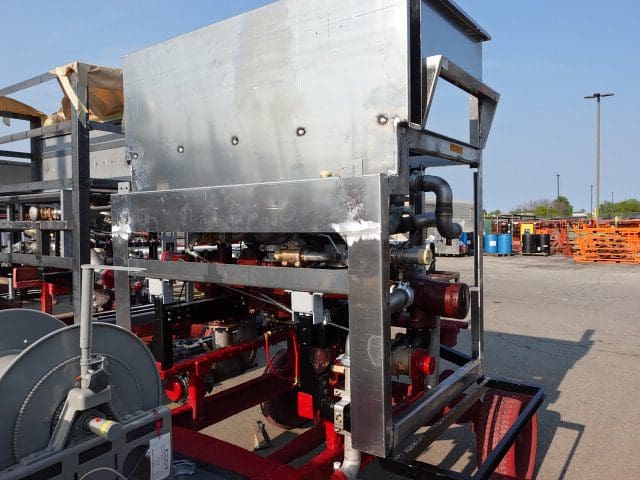

In this report, the pump house completed initial assembly and was installed on the chassis while the body completed paint and initial assembly.
05-17-24

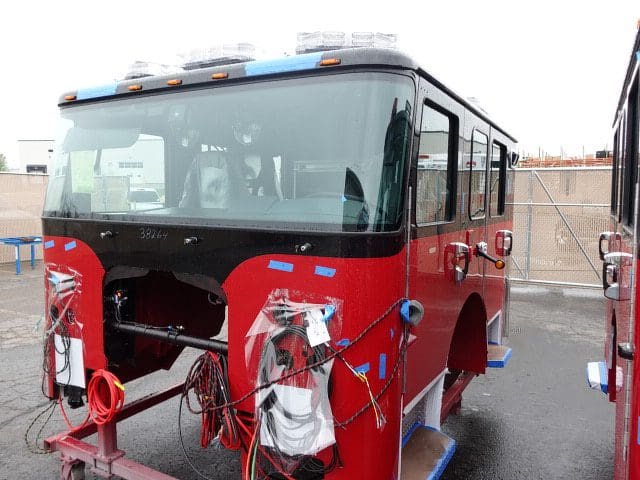

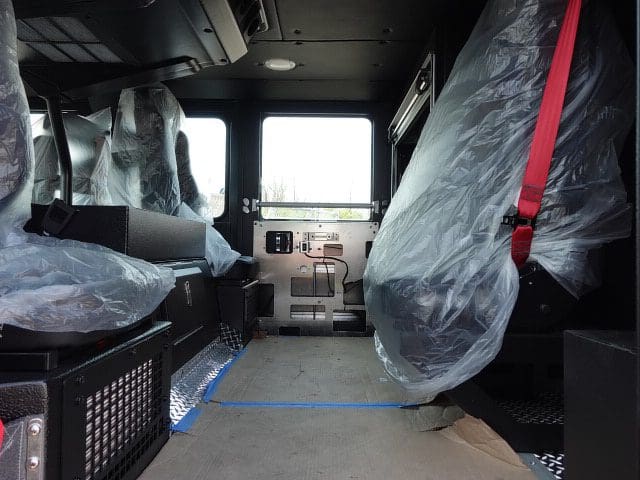

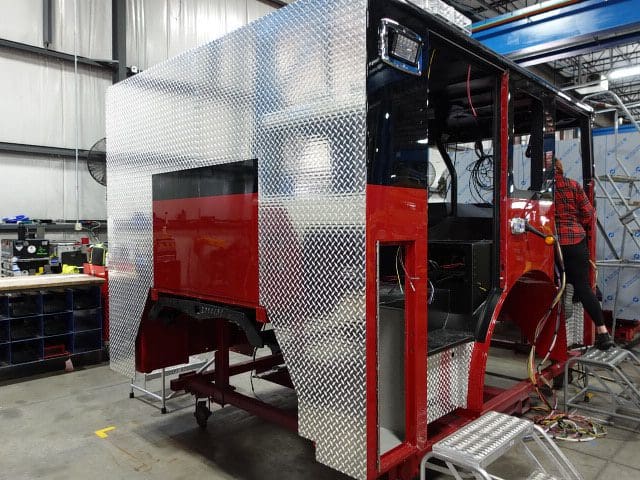

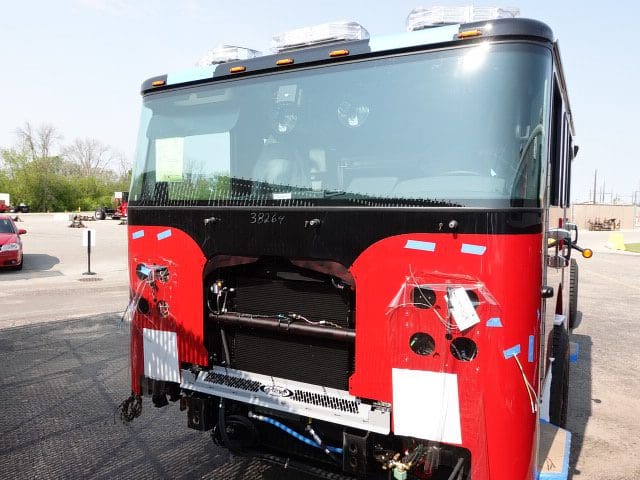

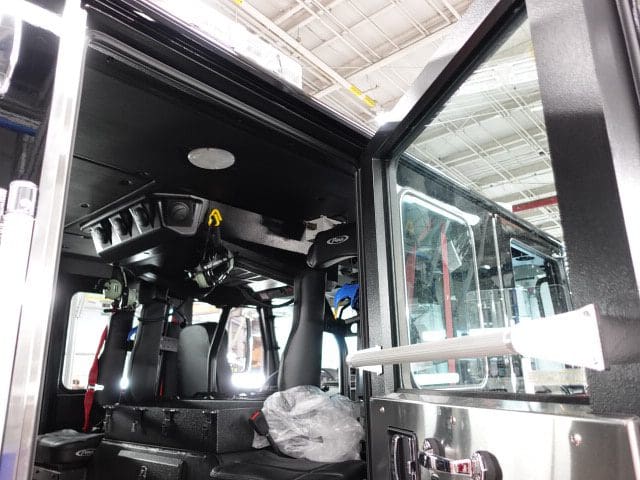

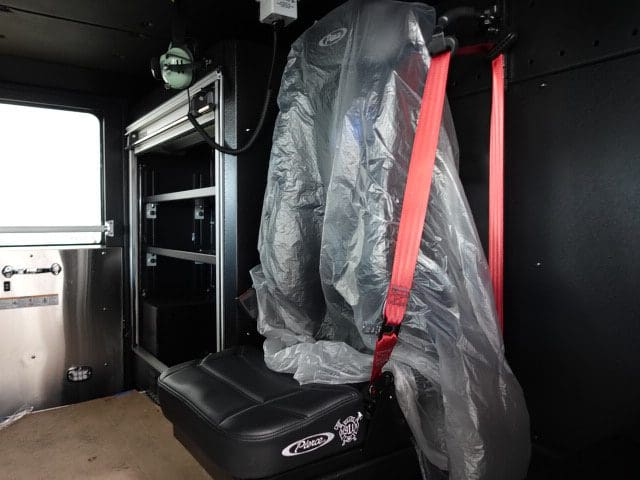

In this report, the cab was installed on the frame, the pump house continued initial assembly, and the body continued through paint.

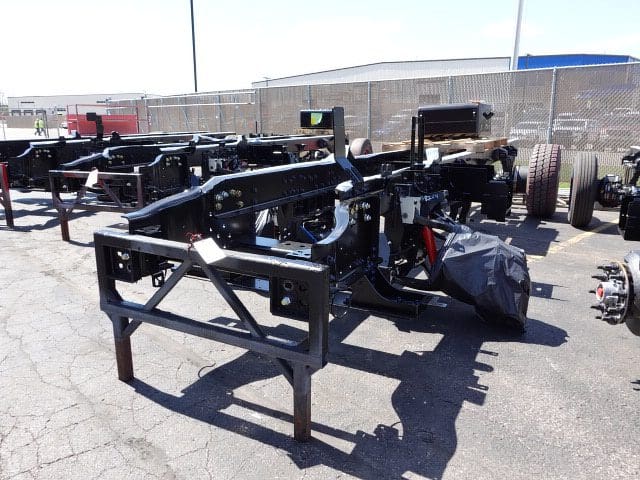

05-10-24

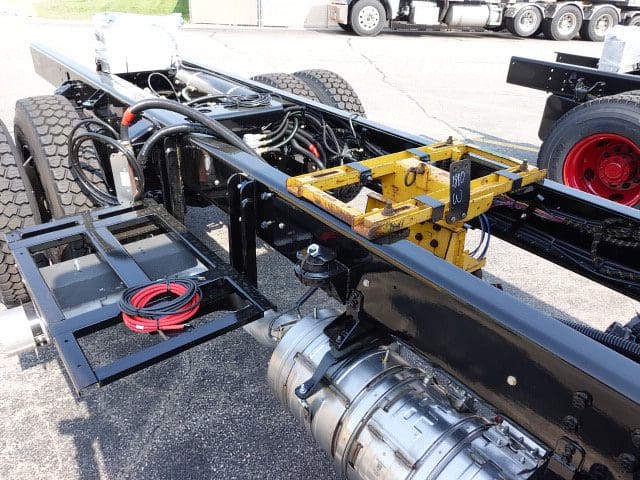

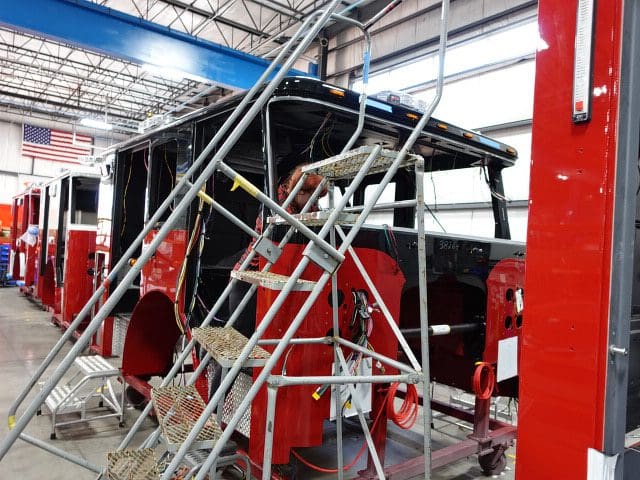

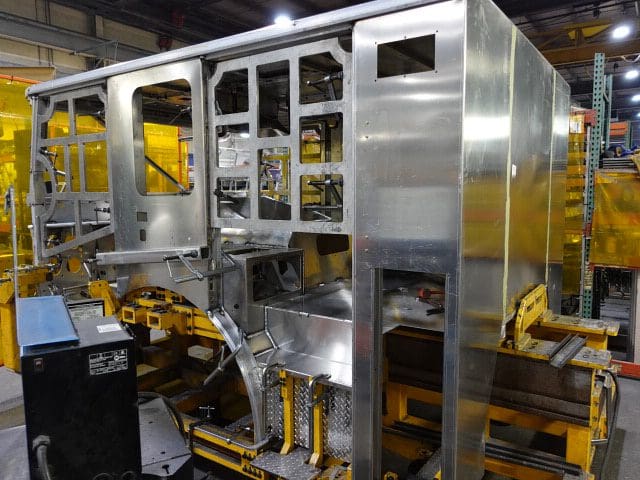

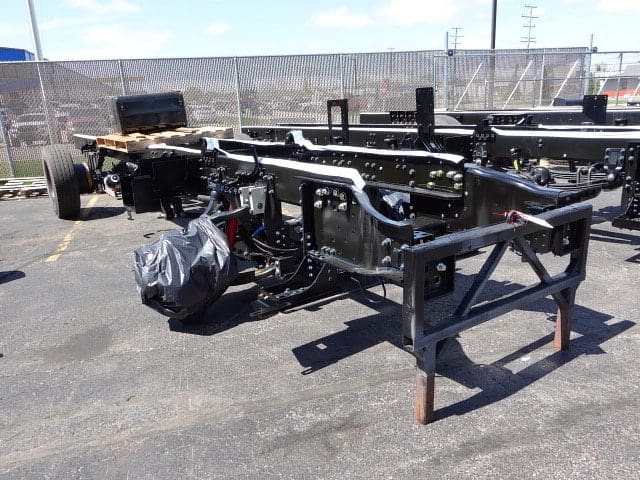

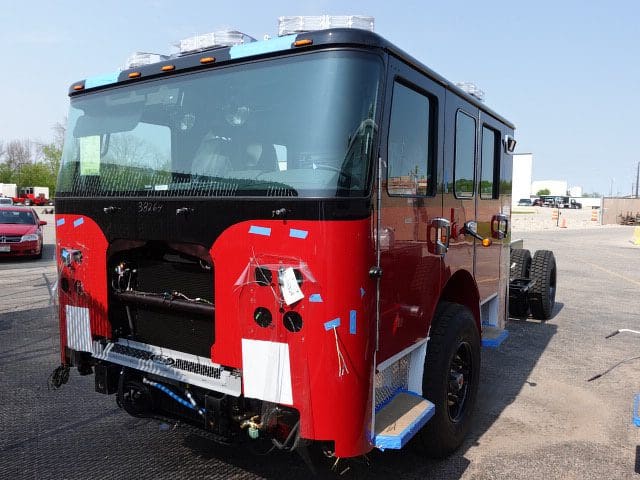

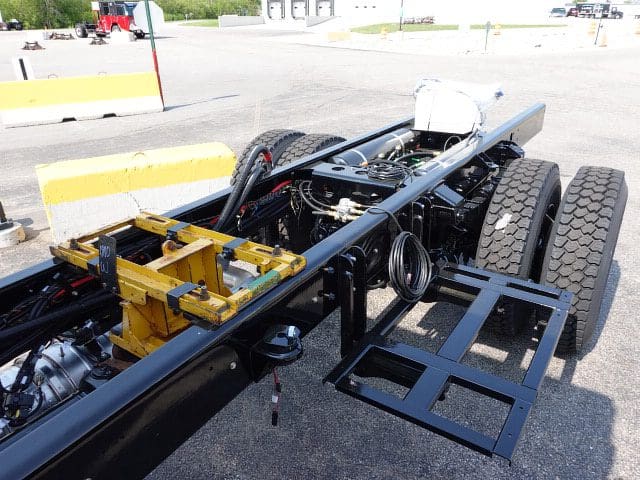

In this report, the cab completed initial assembly, the frame build continued, the pump house began initial assembly, and the body began the paint process.
05-03-24

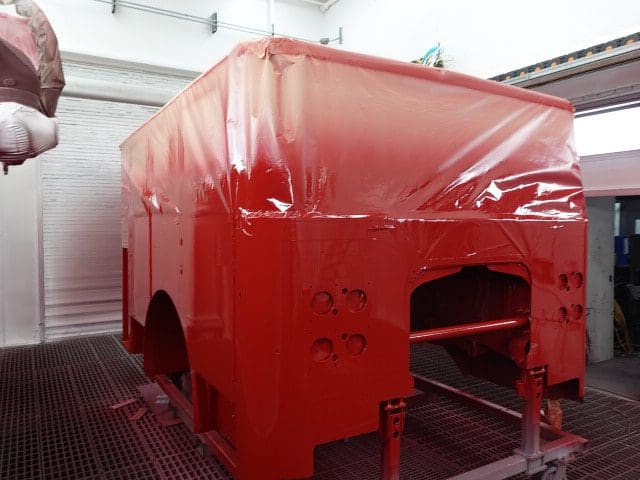

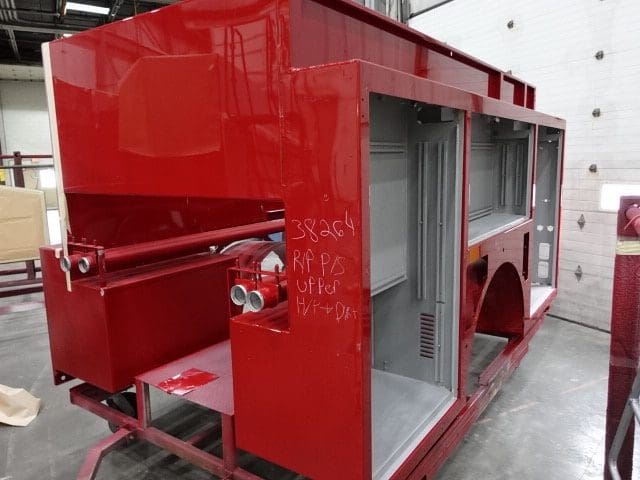

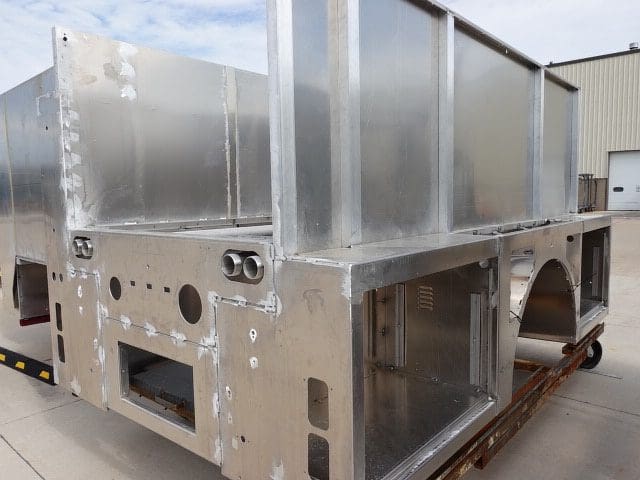

In this report, the cab completed the paint process and began initial assembly, the frame build began, the pump house structure remained staged, and the body was fabricated and staged.

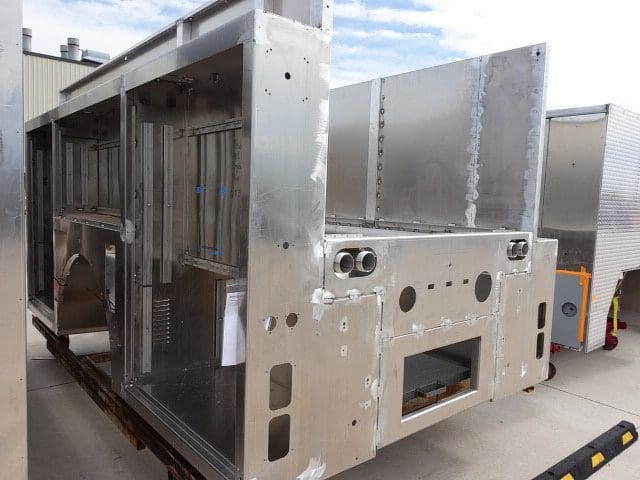

04-26-24

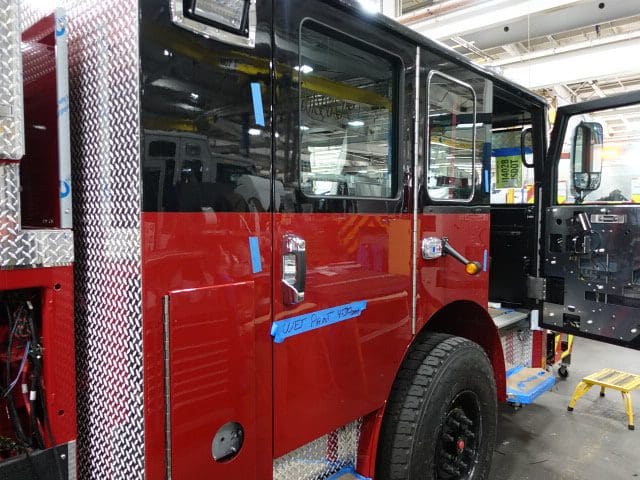

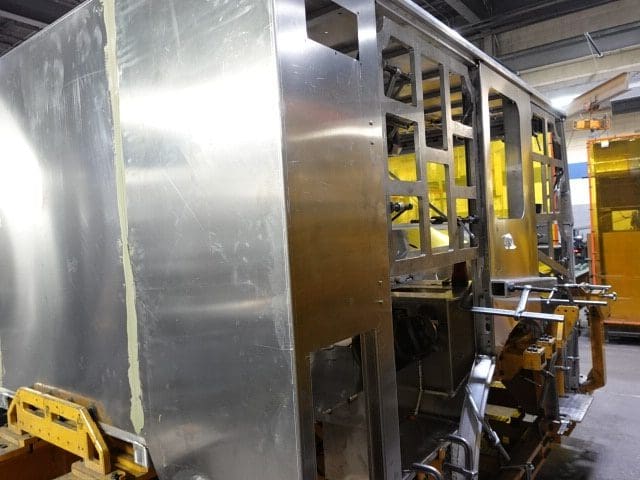

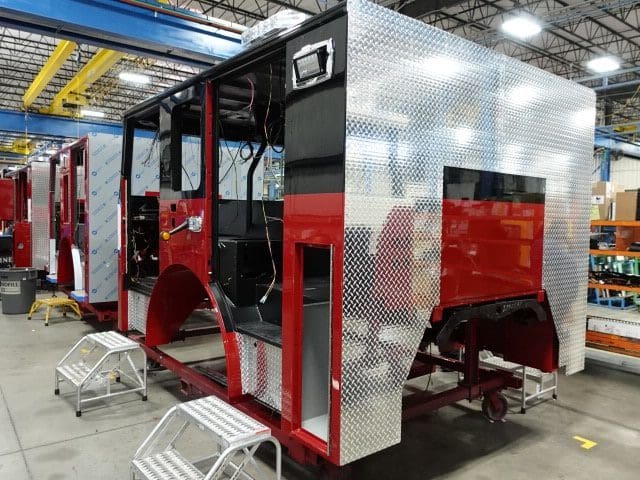

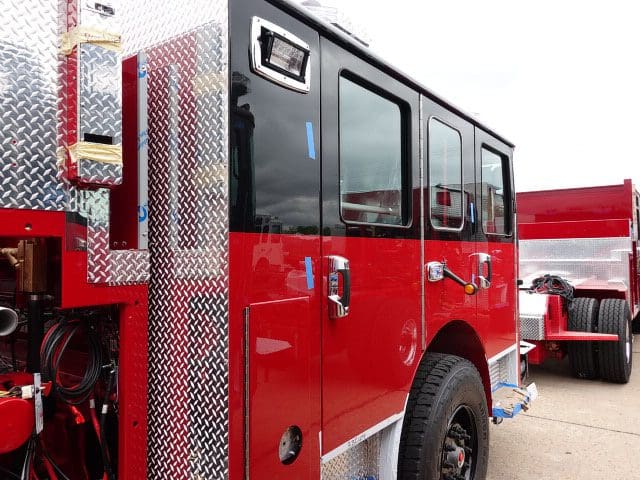

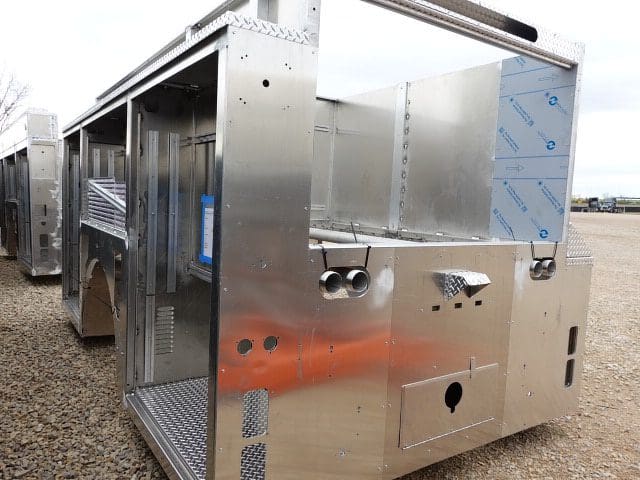

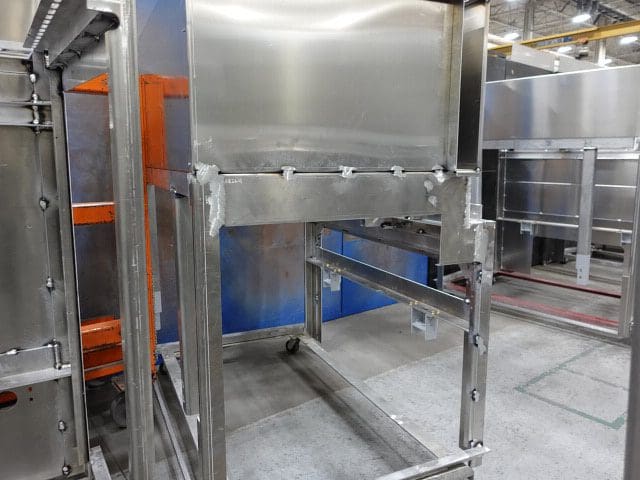

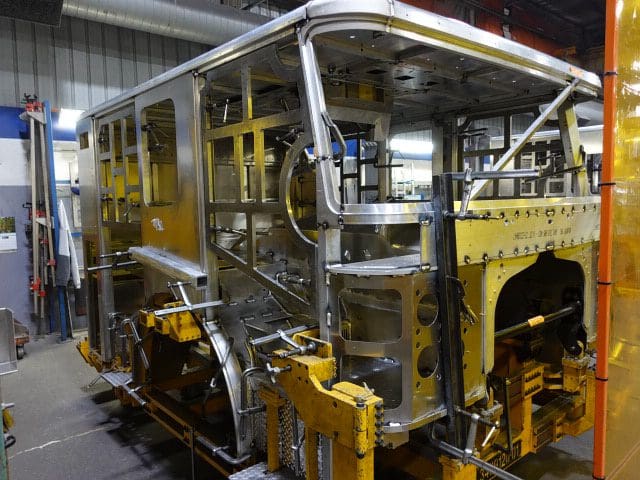

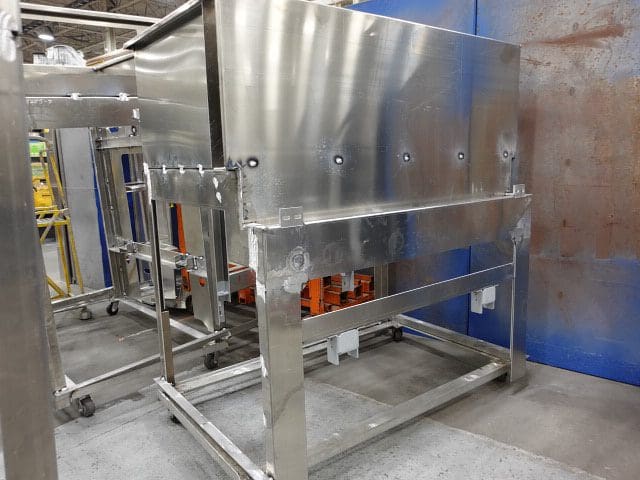

In this report, the cab completed fabrication and began the paint process while the pump house structure was fabricated.
04-19-24

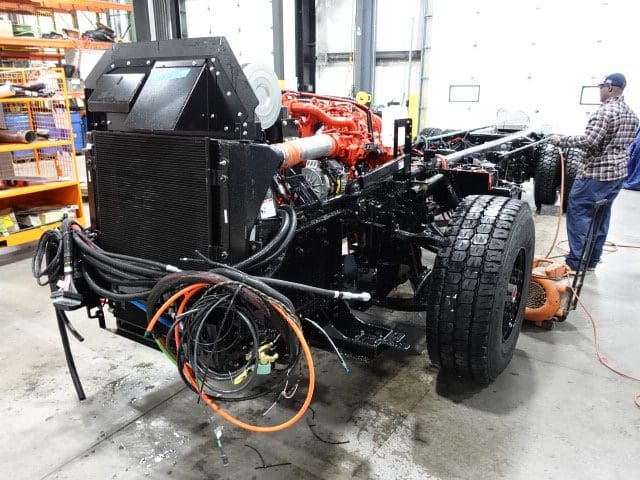

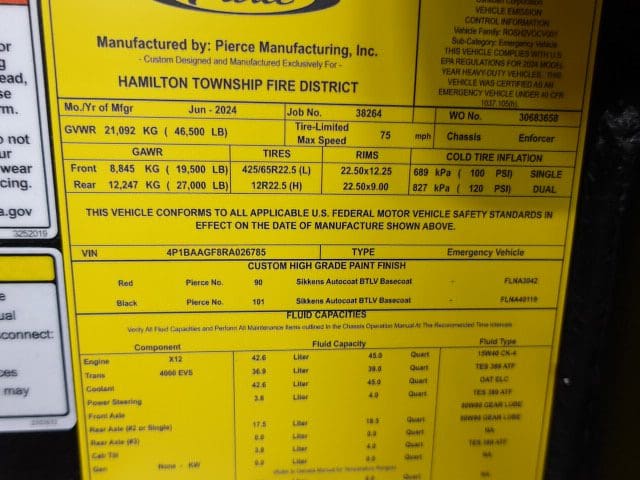

This new Pierce apparatus is now in production! In this report, the cab began fabrication.
