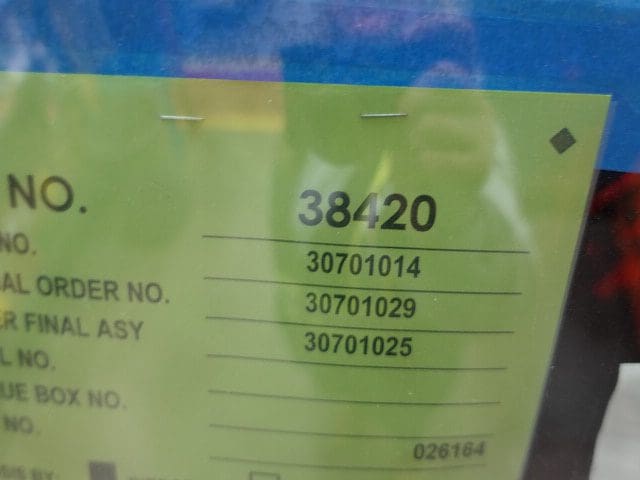

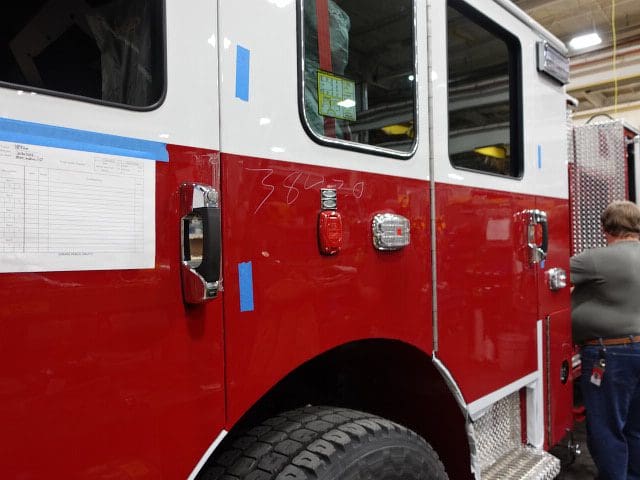

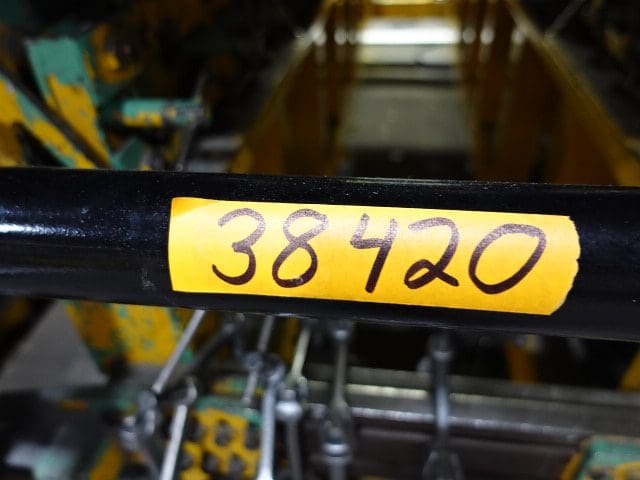

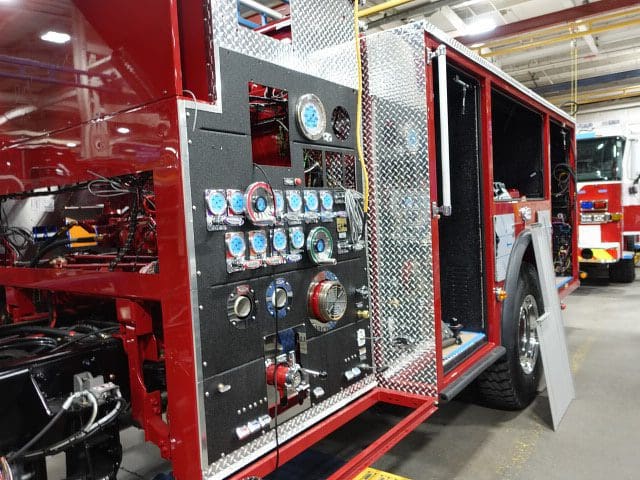

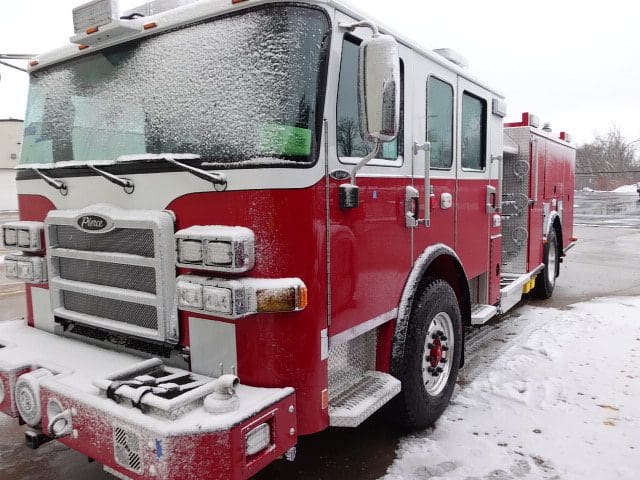

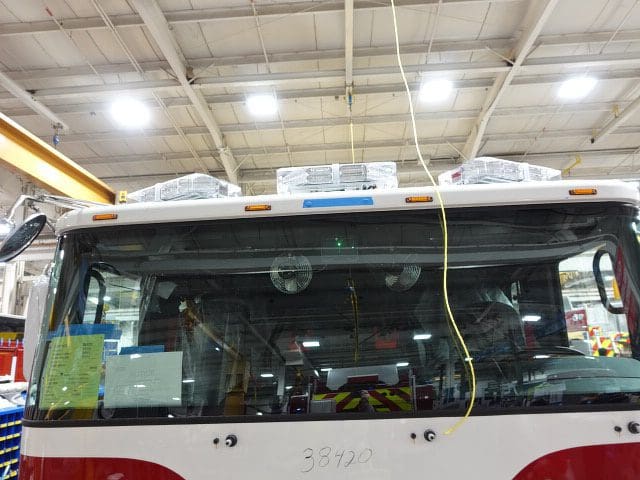

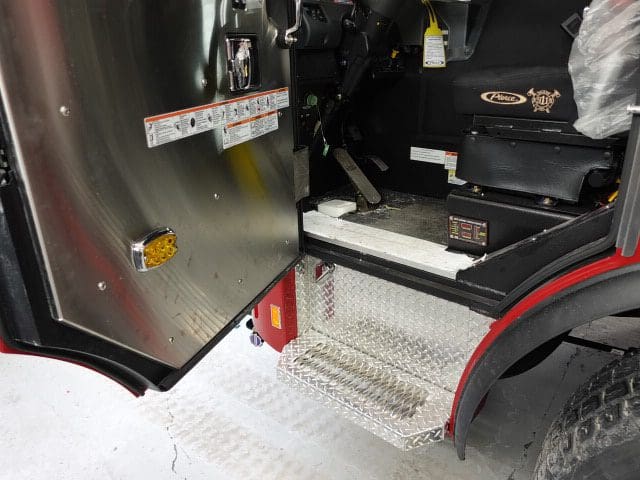

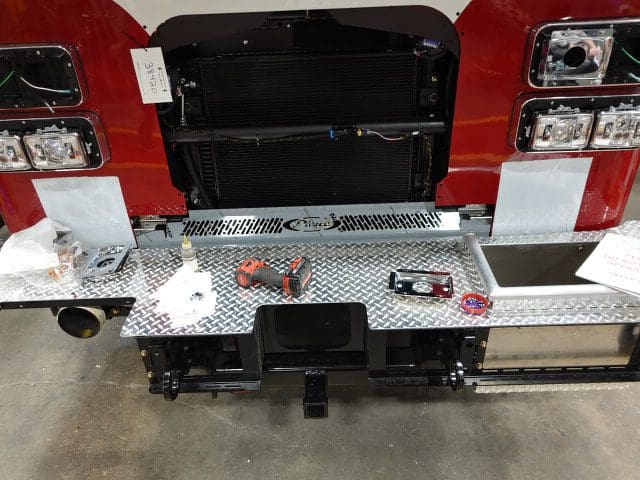

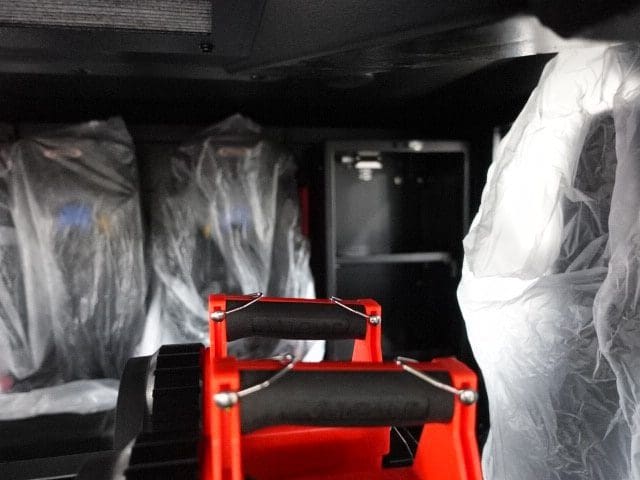

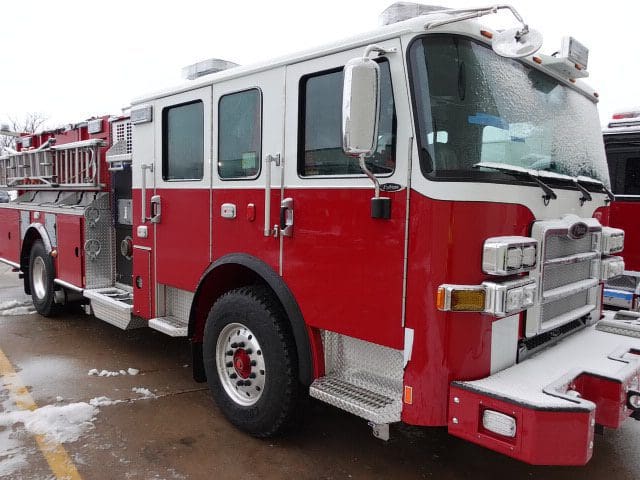

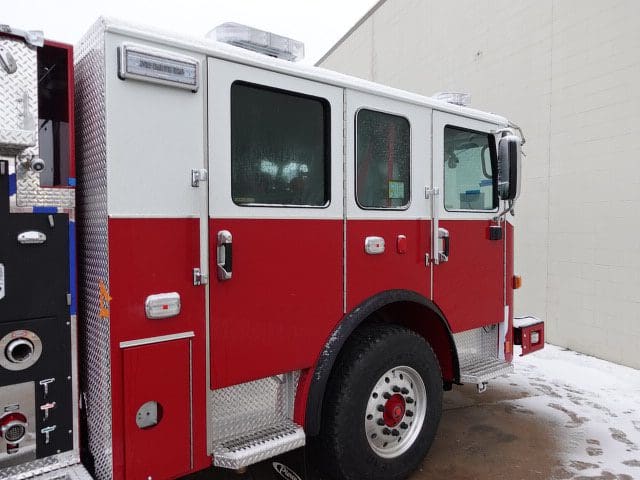

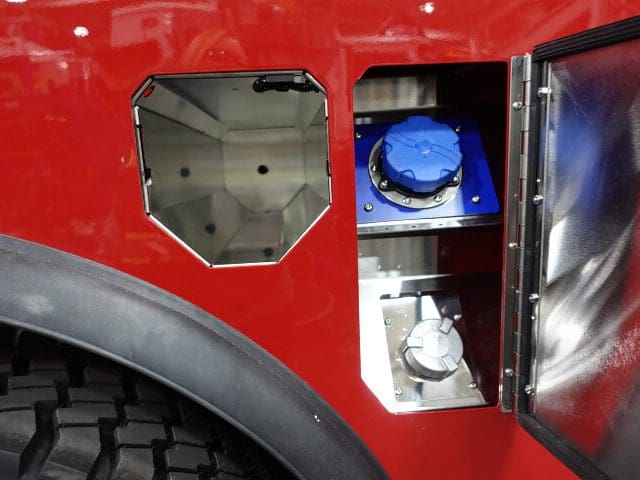

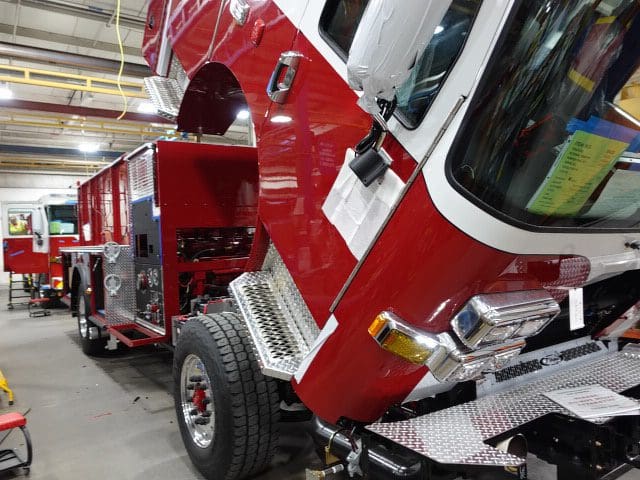

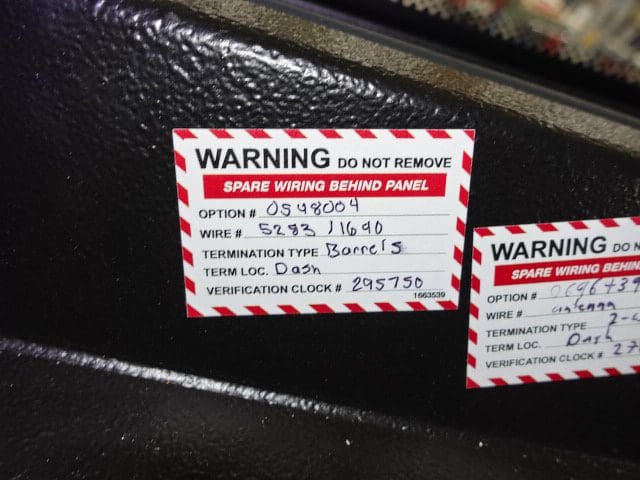

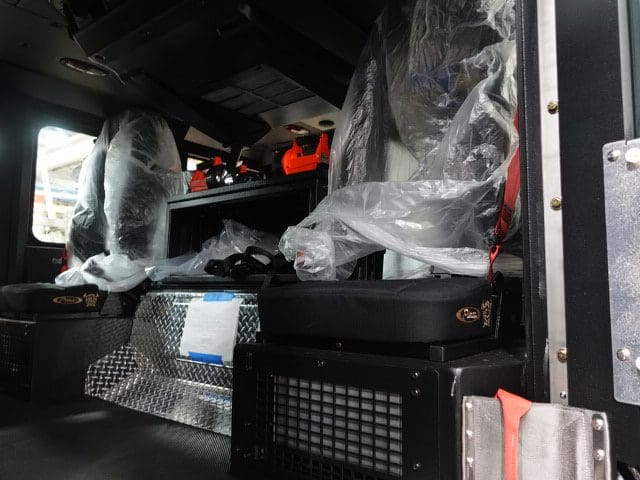

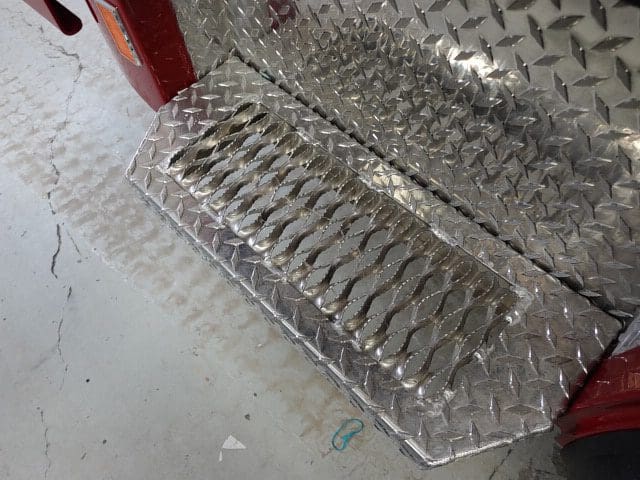

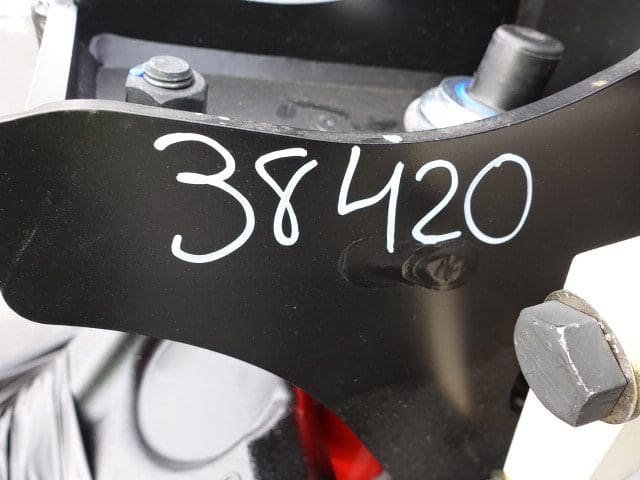

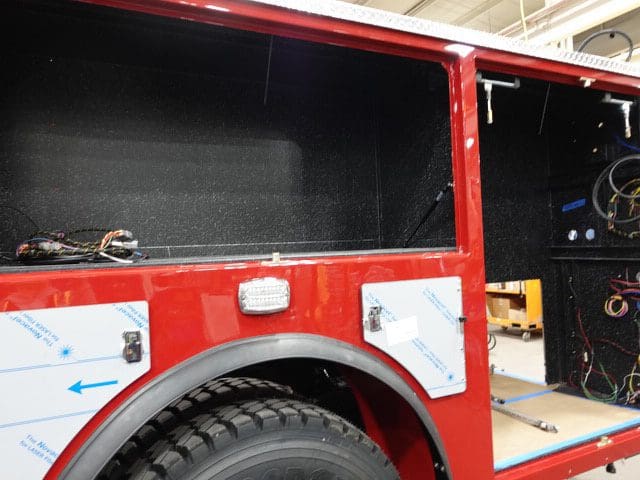

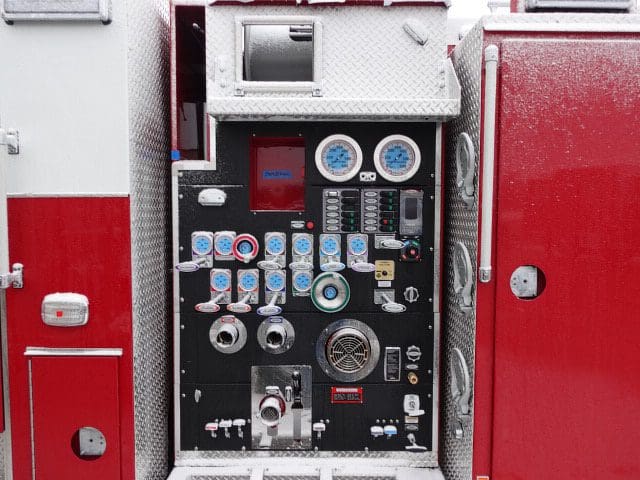

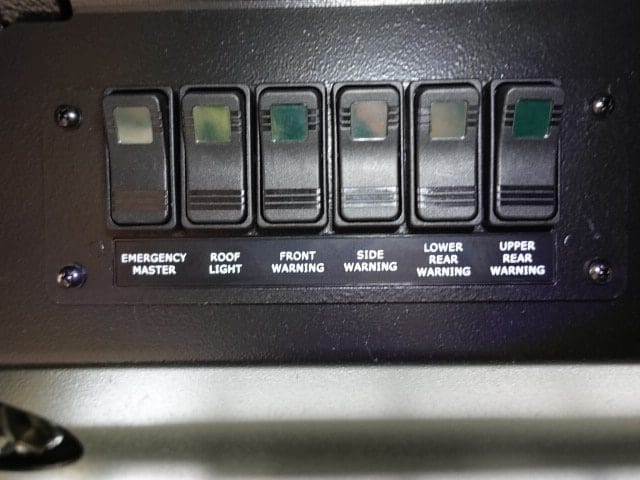

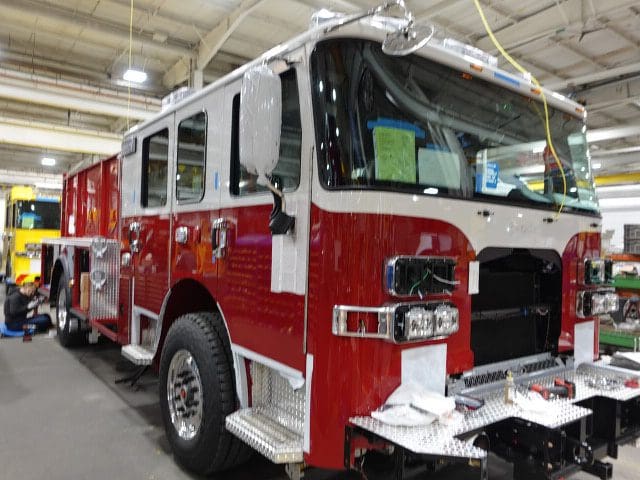

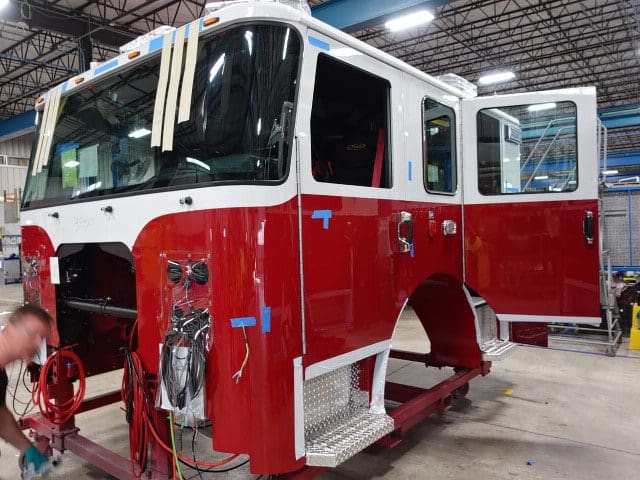

01-26-24

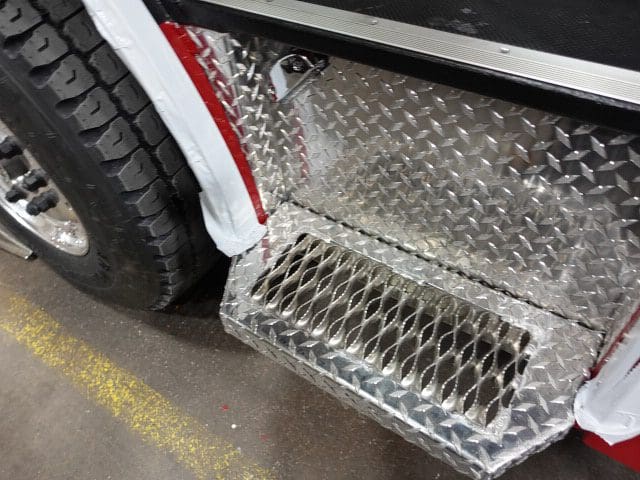

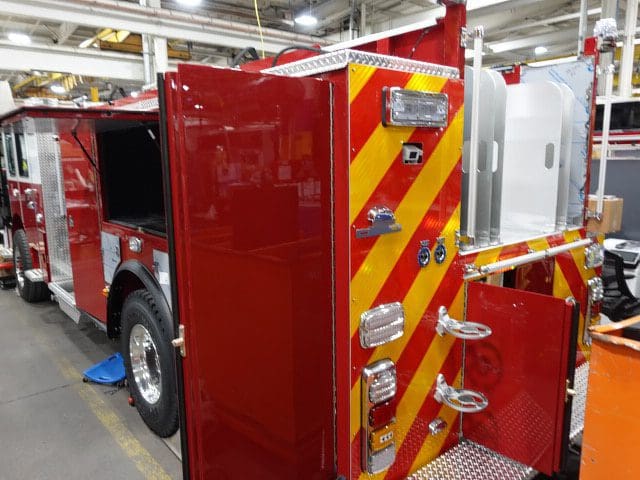

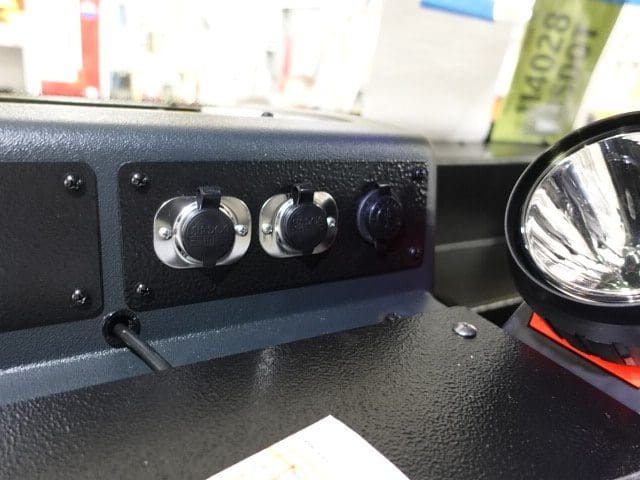

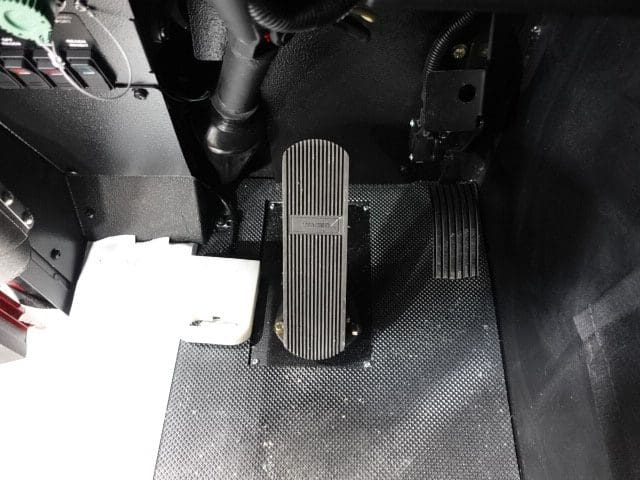

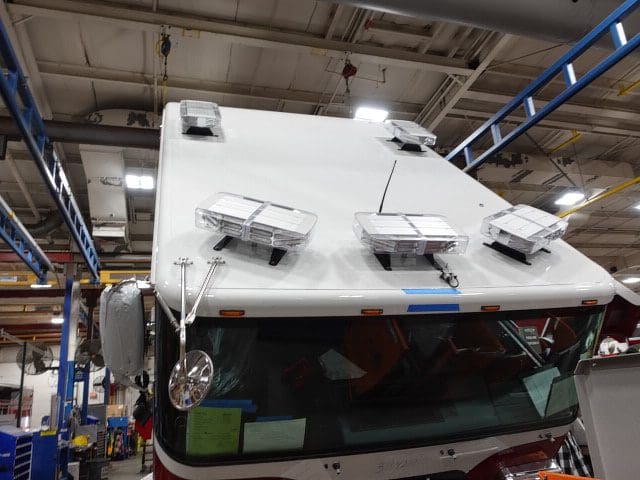

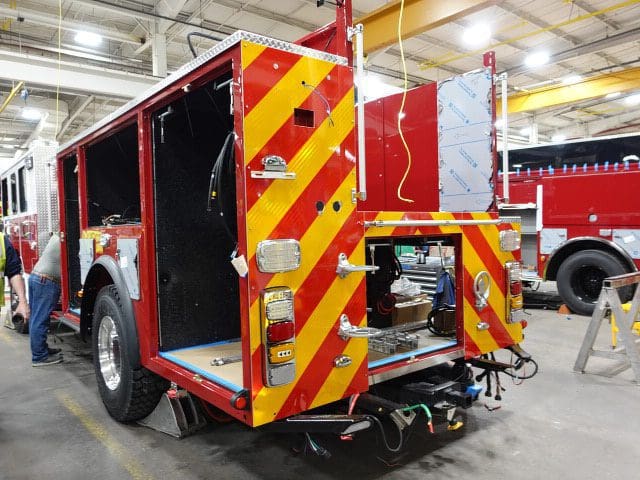

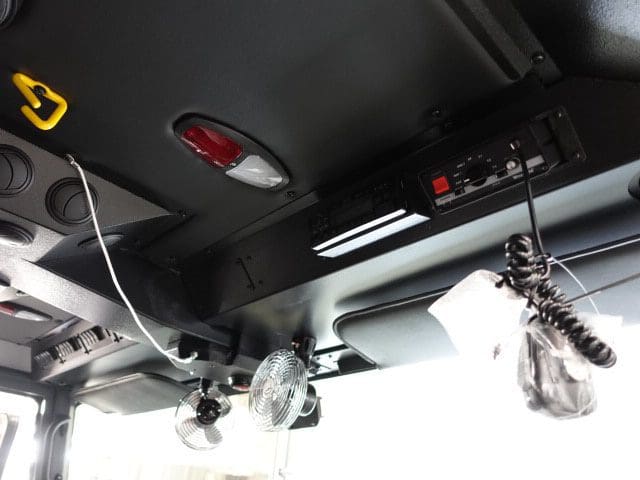

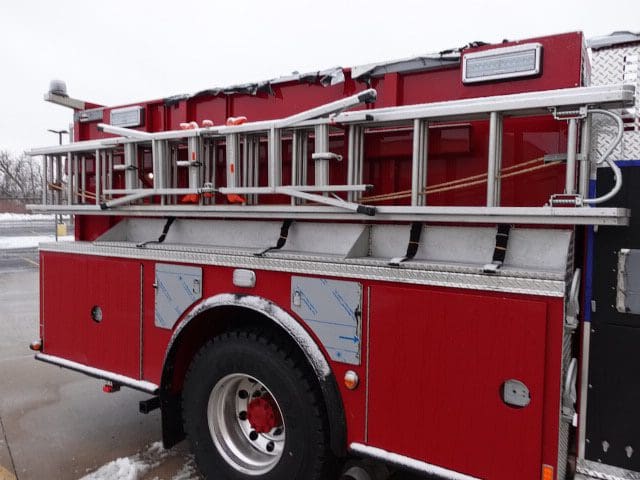

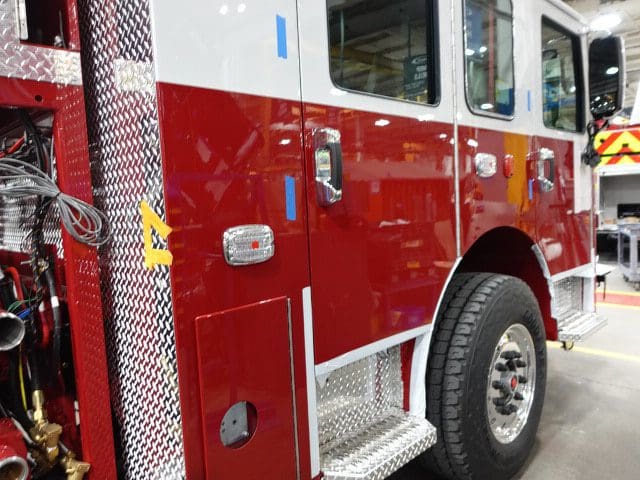

In this report, the apparatus continued the quality and

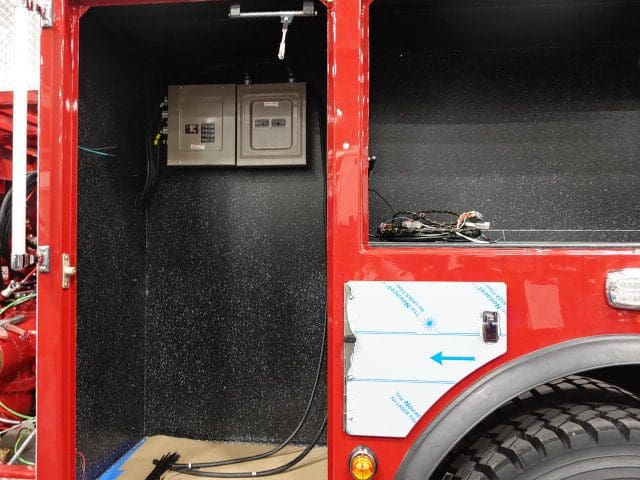

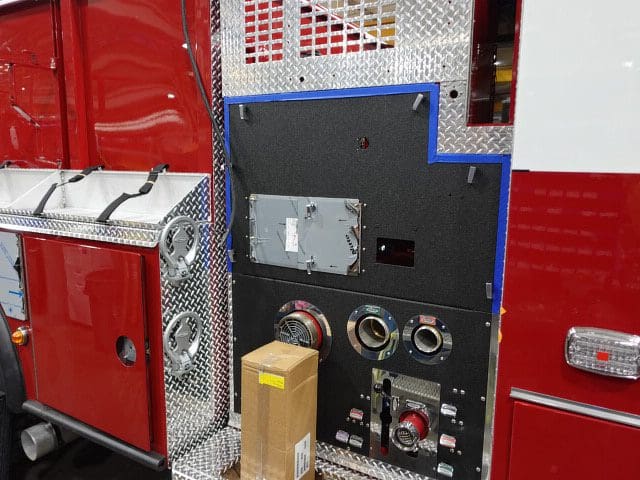

graphics process where any additional content is
applied. Once complete it will be made ready for

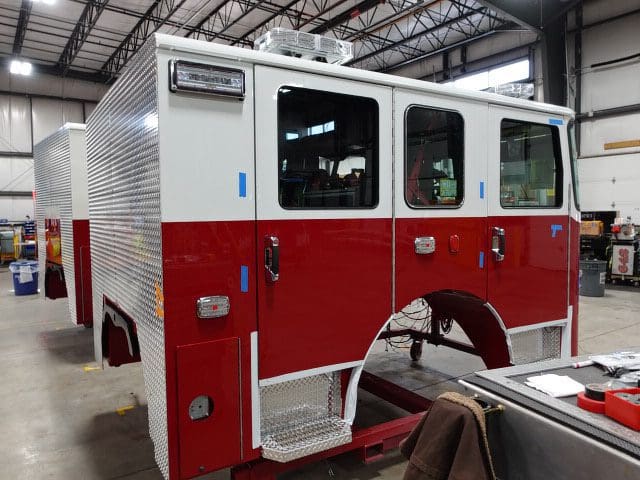

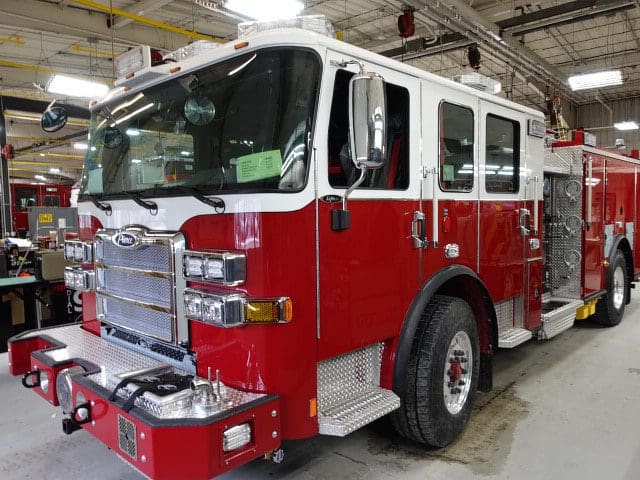

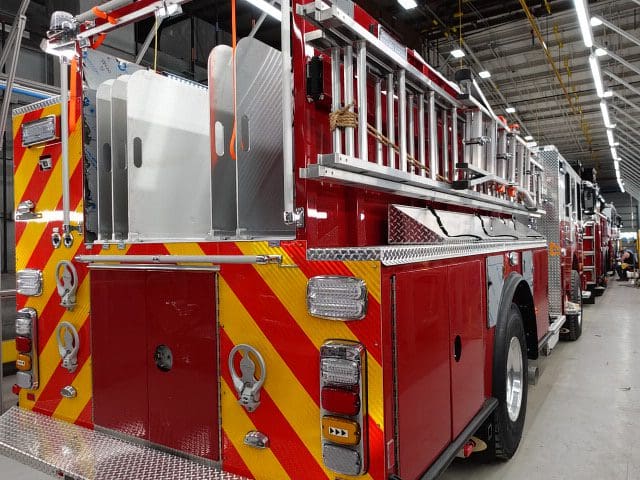

final inspection. This is the last scheduled report.
01-19-24

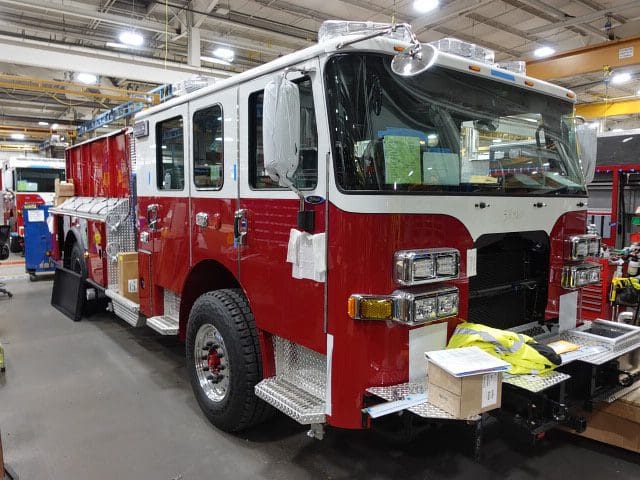

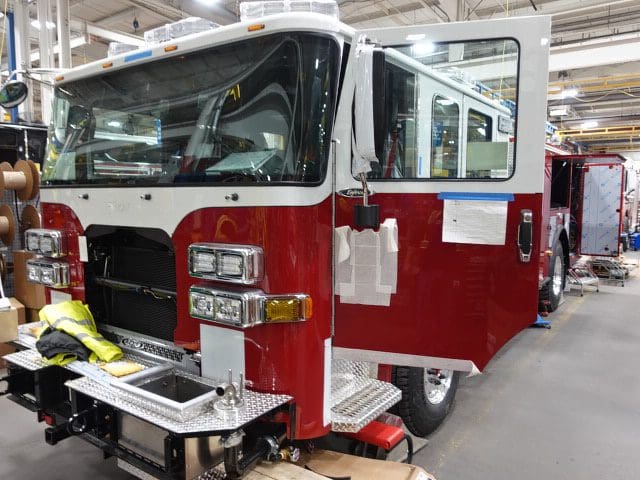

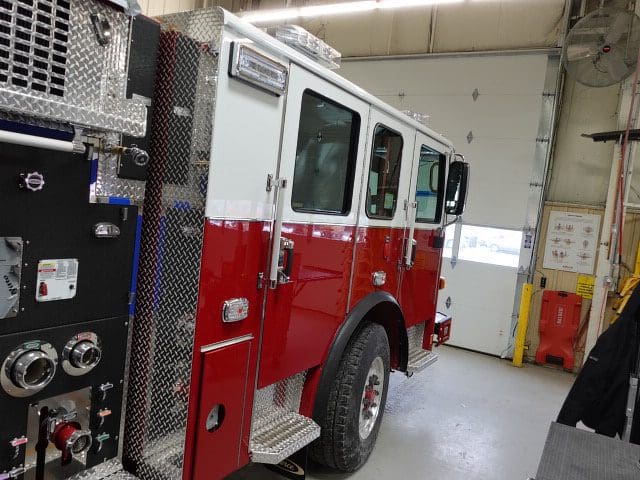

In this report, the apparatus completed testing and was released to quality and graphics.
01-12-24

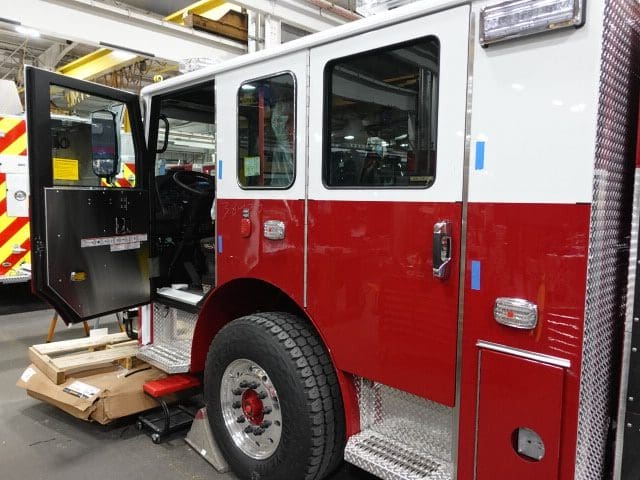

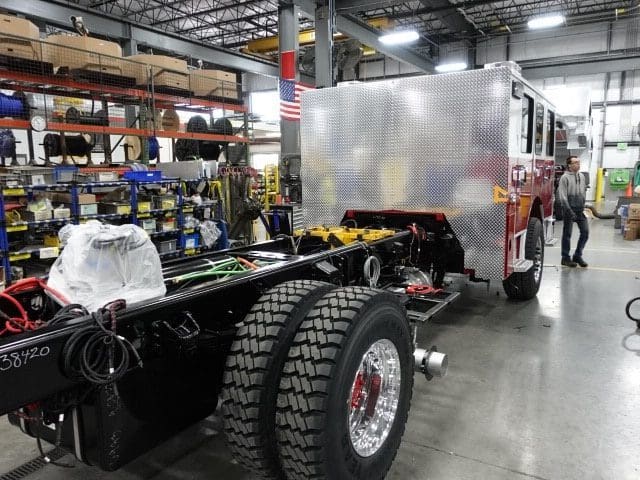

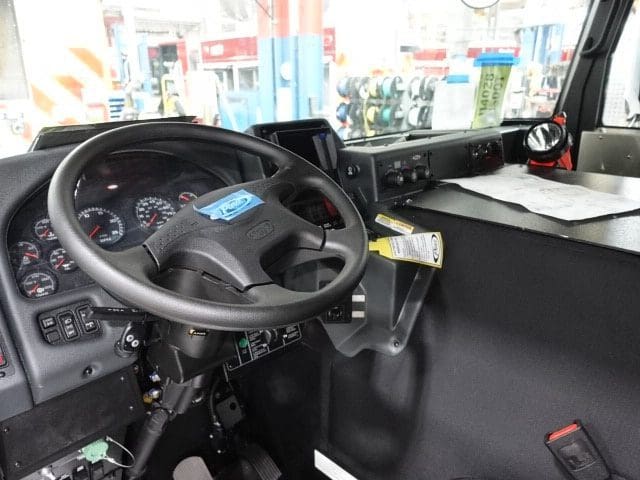

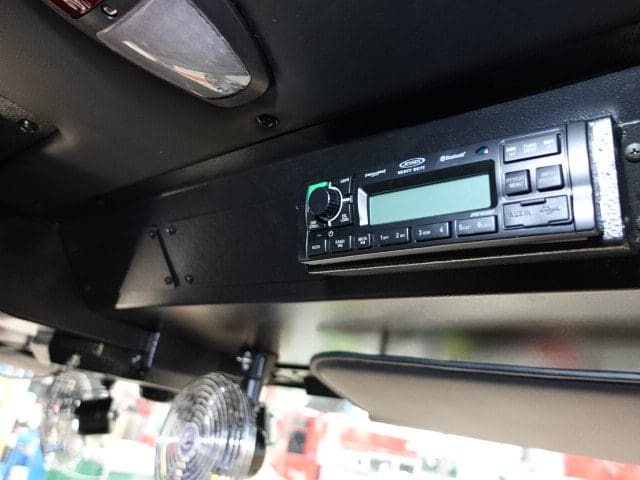

In this report, the apparatus completed final assembly and was released for testing.

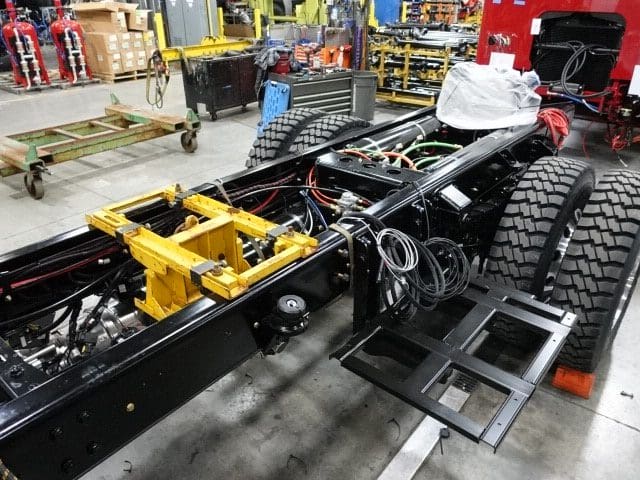

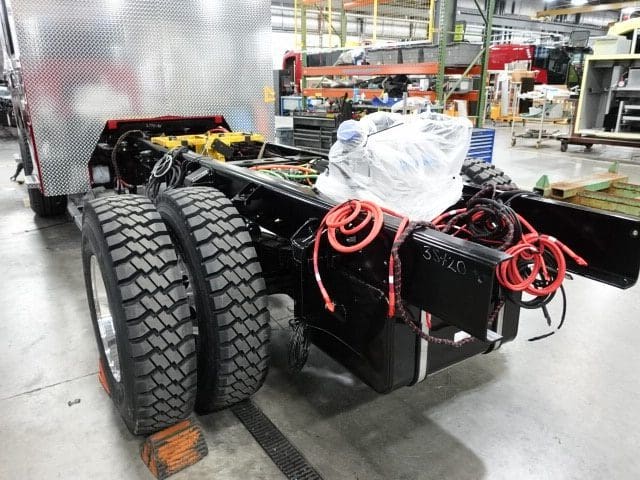

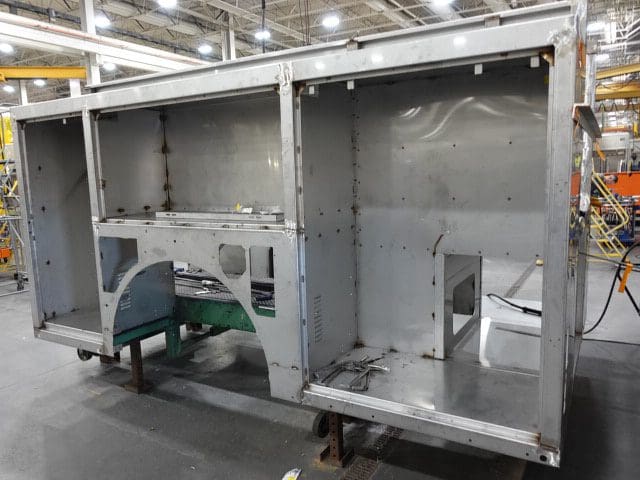

12-22-23

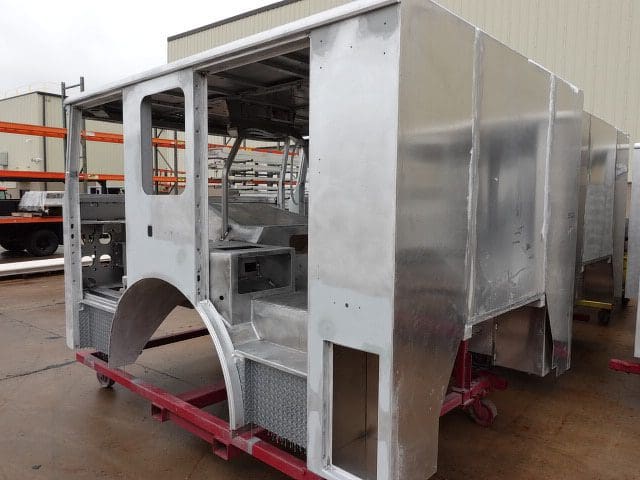

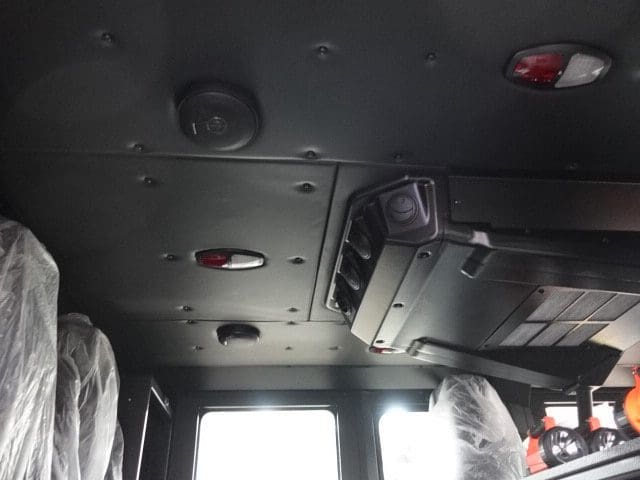

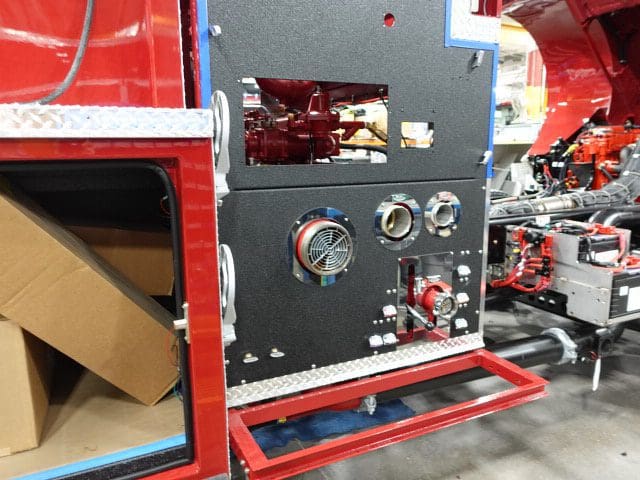

In this report, the apparatus completed initial assembly and began final assembly.
12-15-23

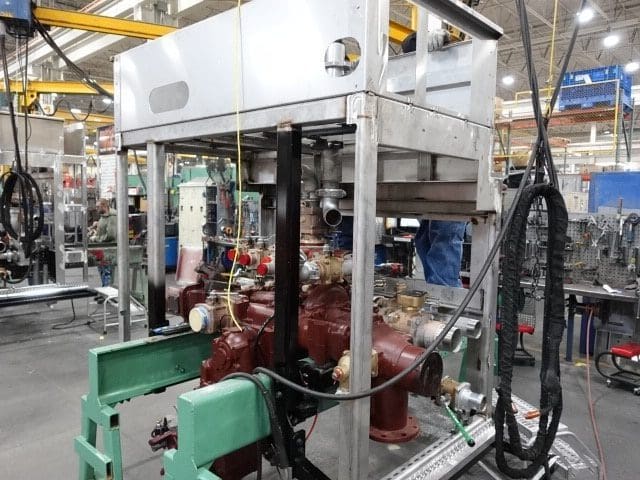

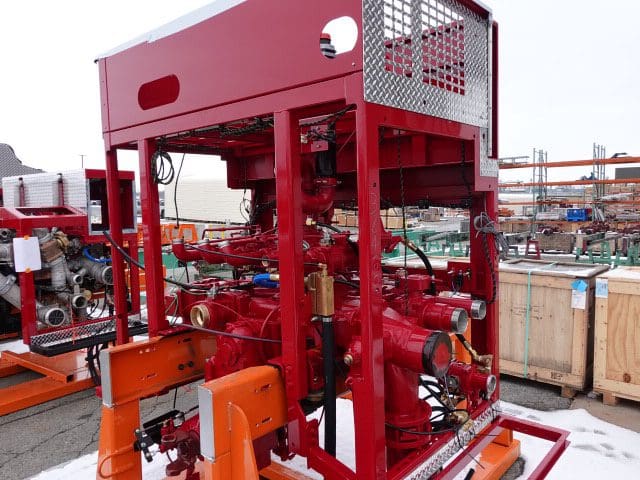

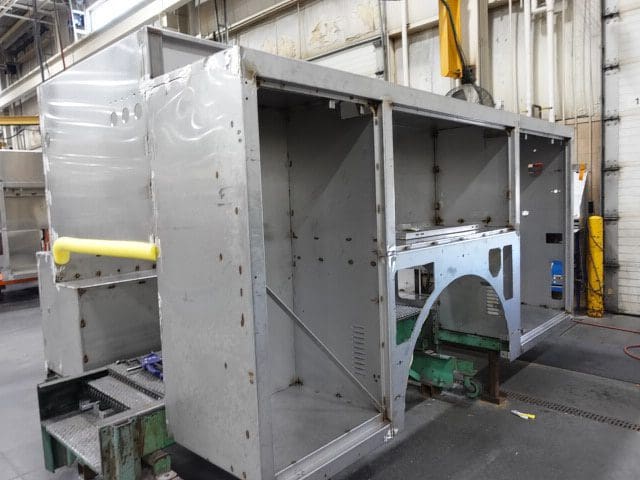

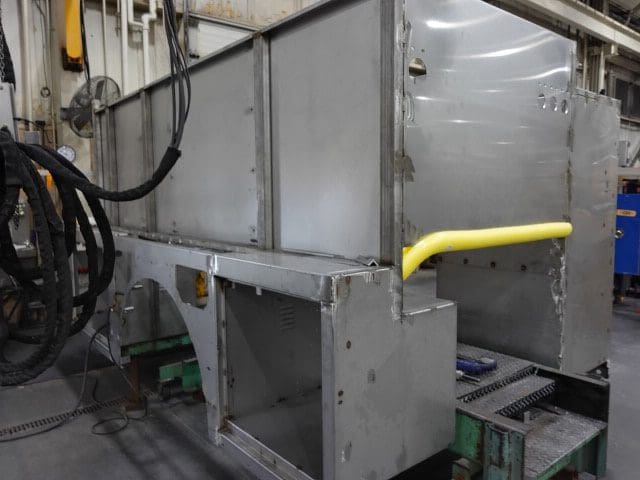

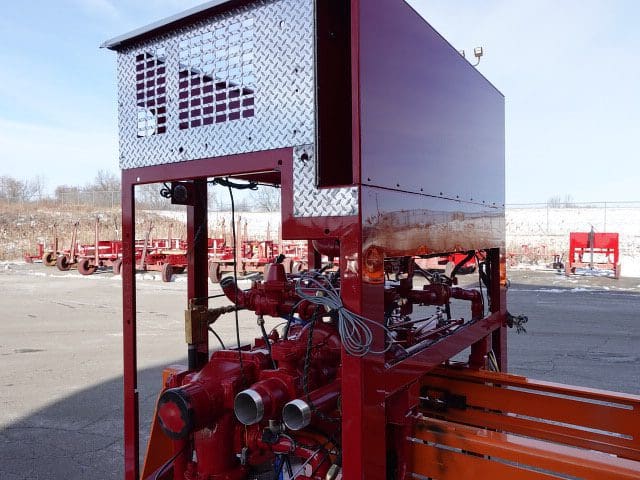

In this report, the pump house and body were installed on the chassis while assembly continued.

12-08-23

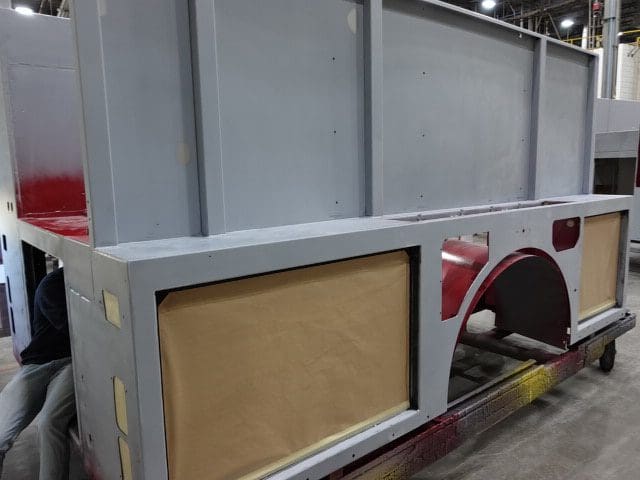

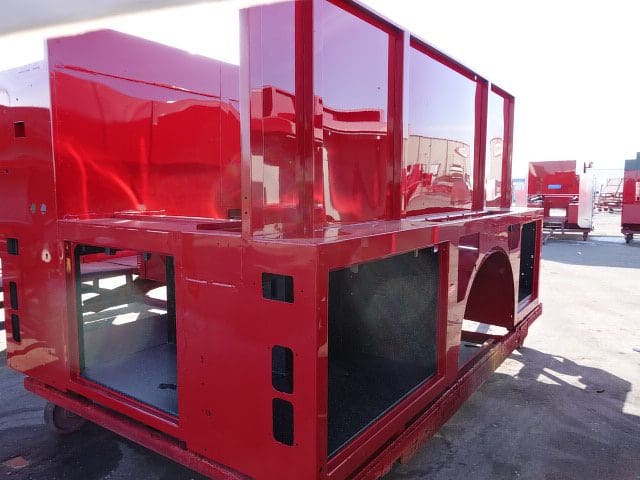

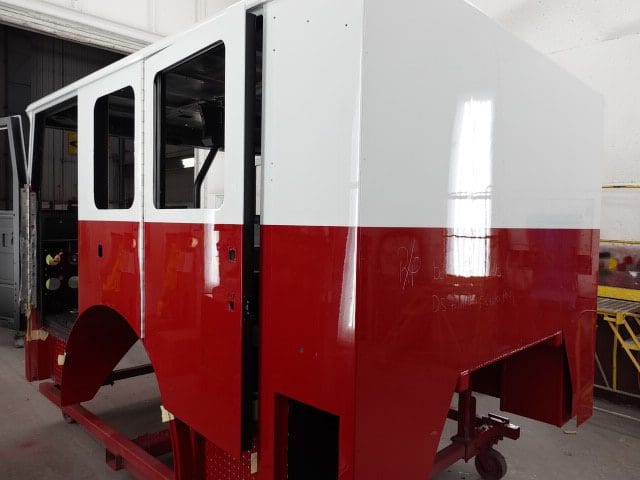

In this report, the cab was installed on the frame, the pump house was staged, and the body completed paint and was staged.
12-01-23

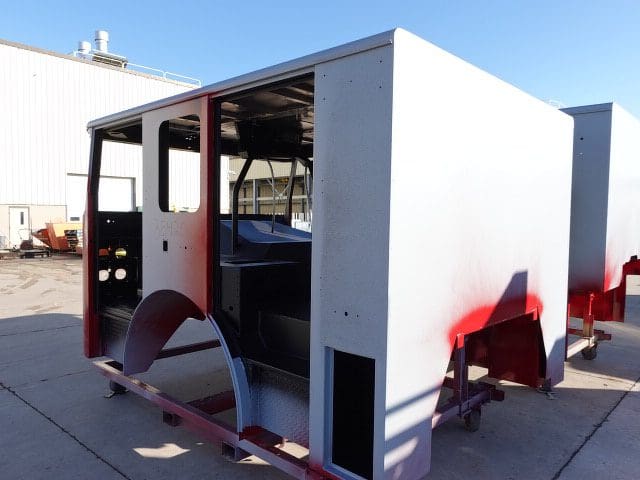

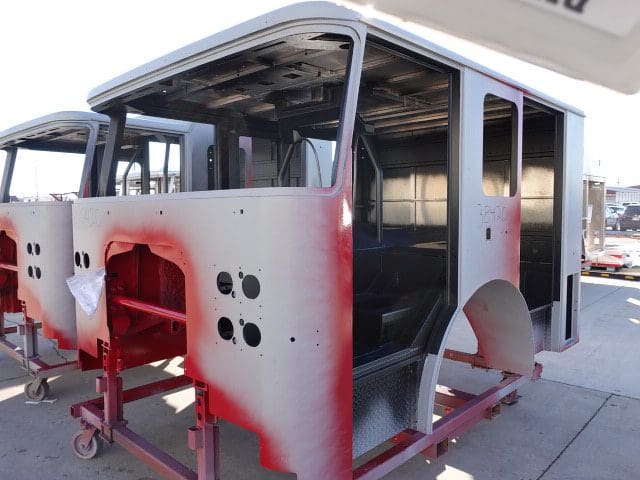

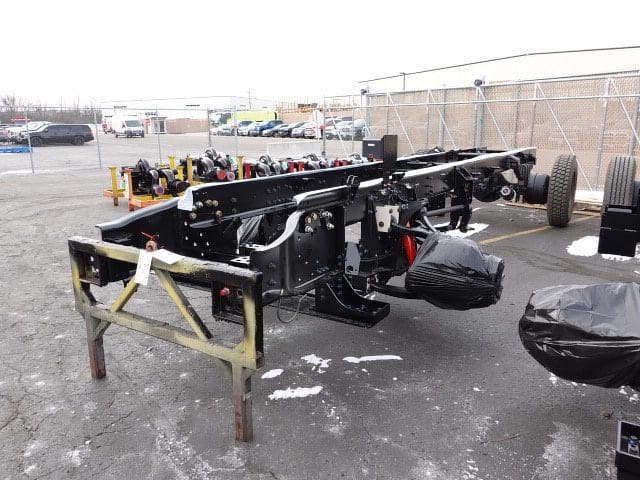

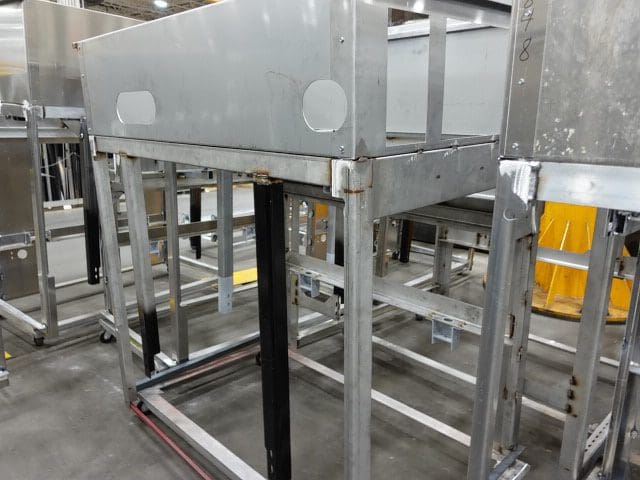

In this report, the cab completed paint and began initial assembly, the frame build began, the pump house continued initial assembly, and the body began the paint process.
11-17-23
In this report, the cab continued through paint, the pump house began initial assembly, and the body completed fabrication and was staged.
11-10-23

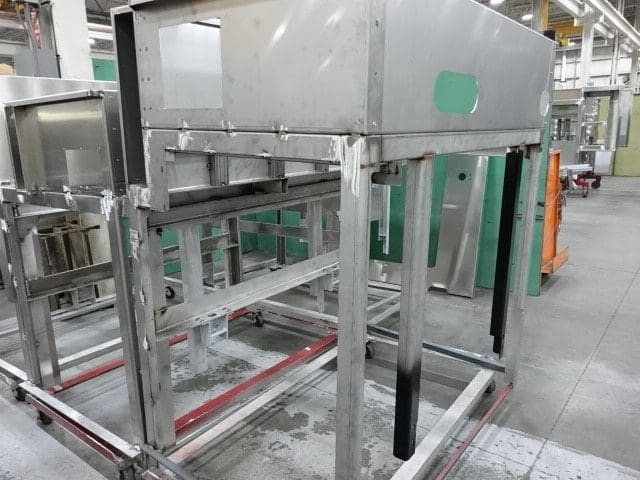

In this report, the cab continued the paint process, the pump house structure remained staged, and the body began fabrication.

11-03-23
In this report, the cab was unavailable for photos while the pump house structure remained staged.
10-27-23

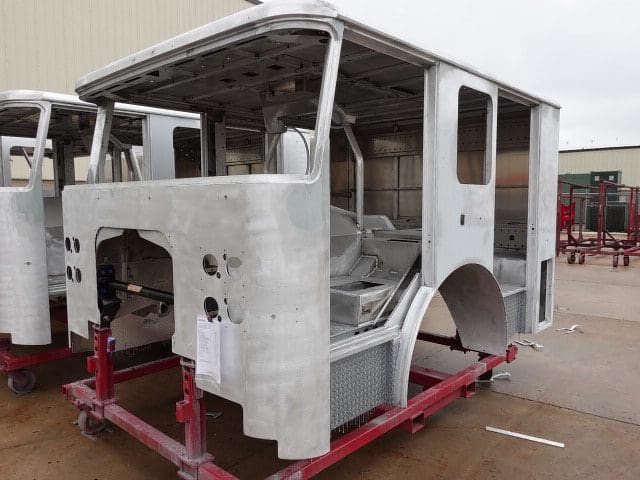

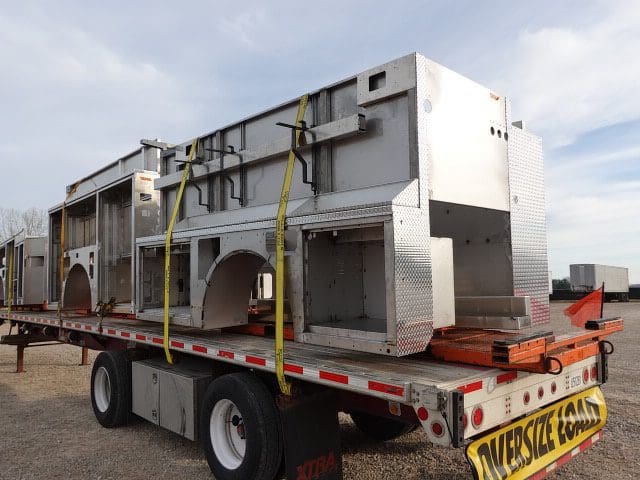

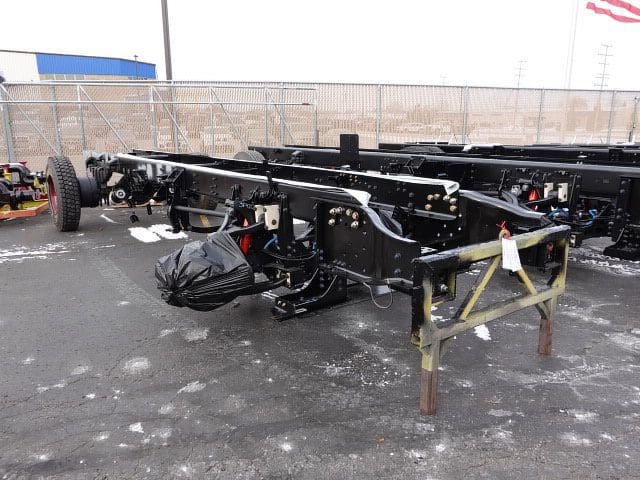

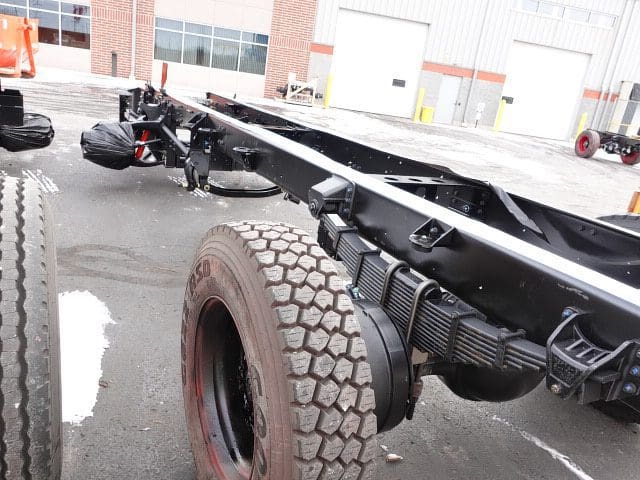

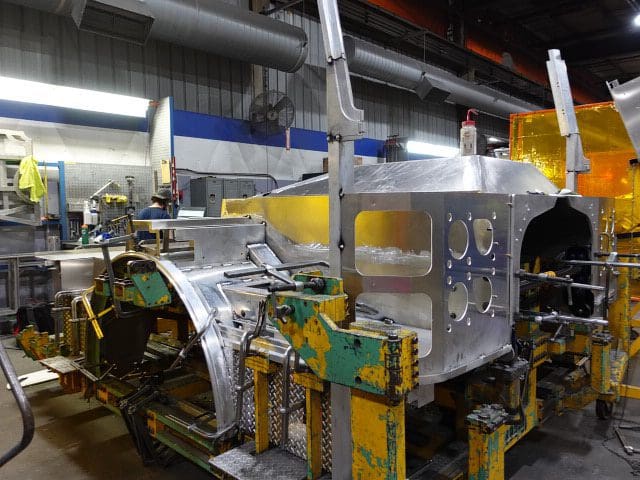

In this report, the cab completed fabrication and began the paint process while the pump house structure was fabricated.
10-20-23

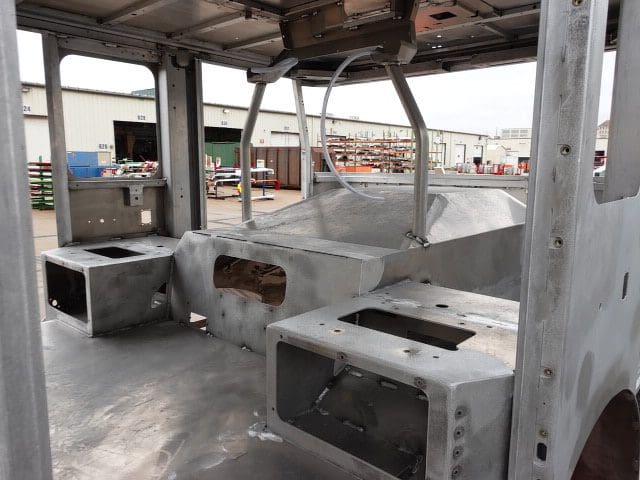

This Pierce apparatus is now in production. In this report, the cab began fabrication and was staged.
