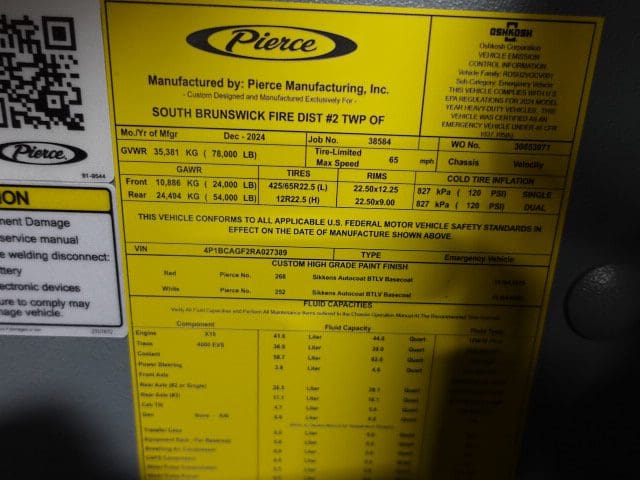

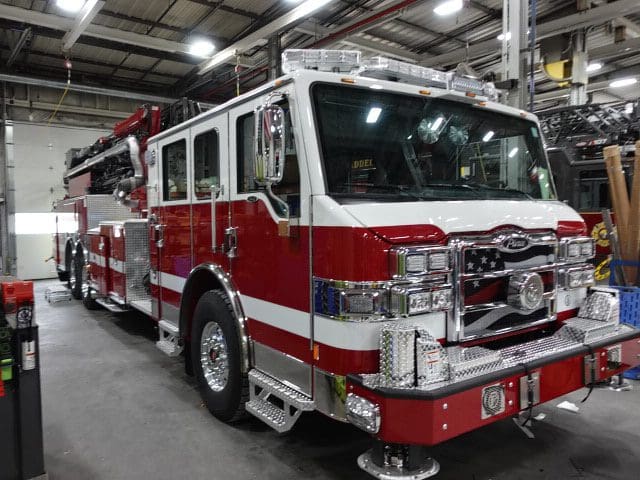

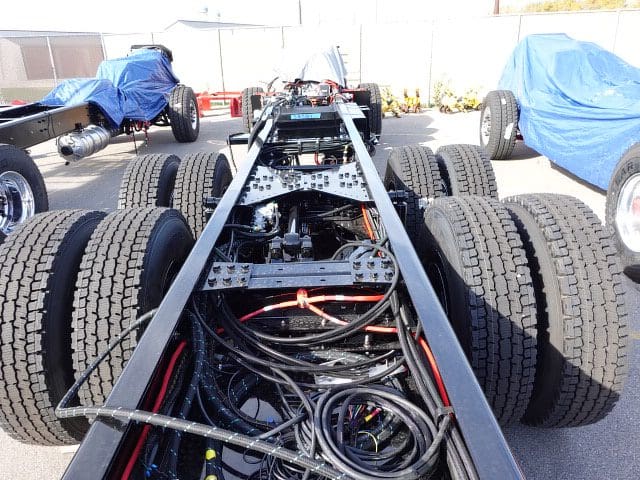

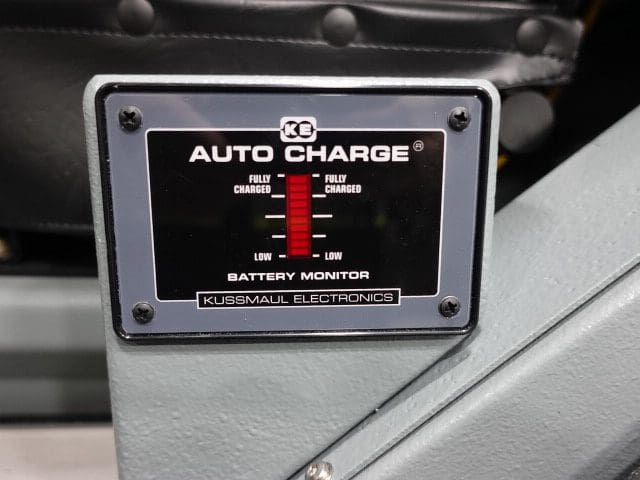

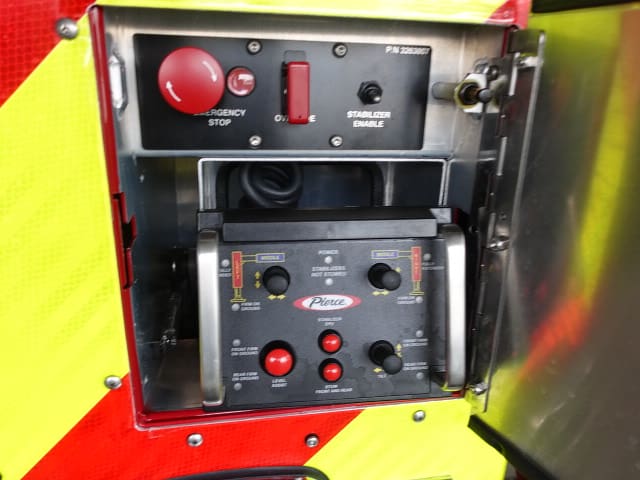

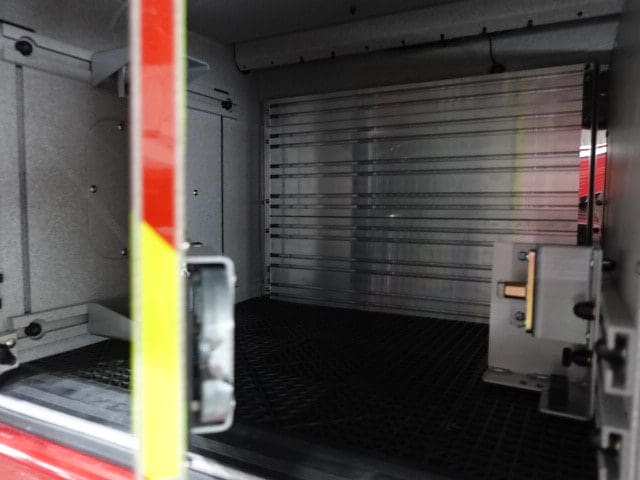

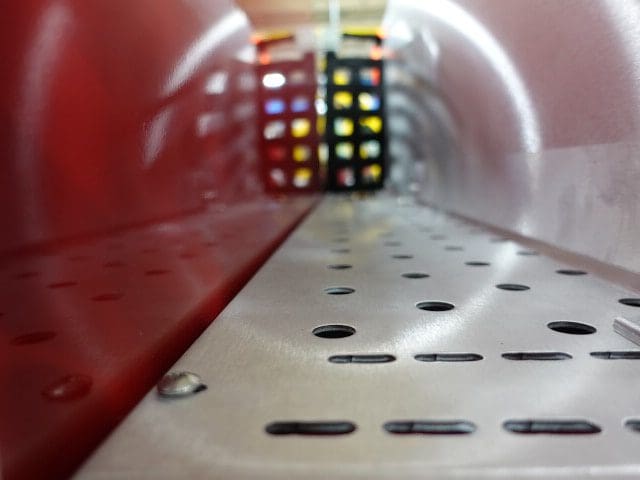

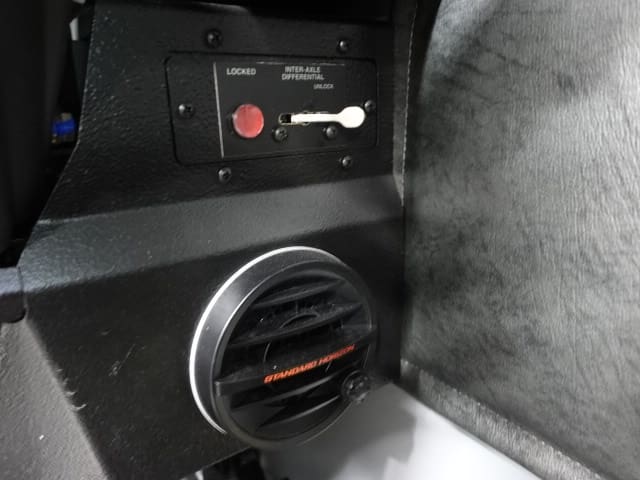

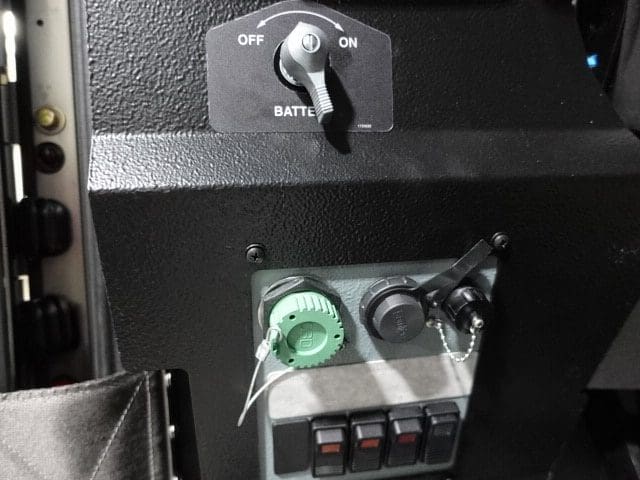

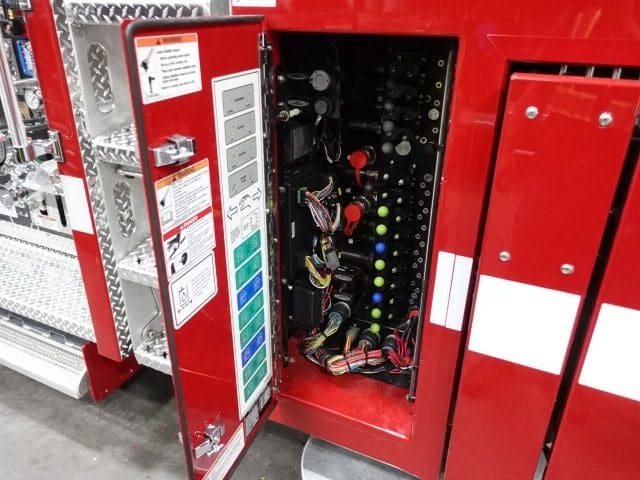

12-13-24

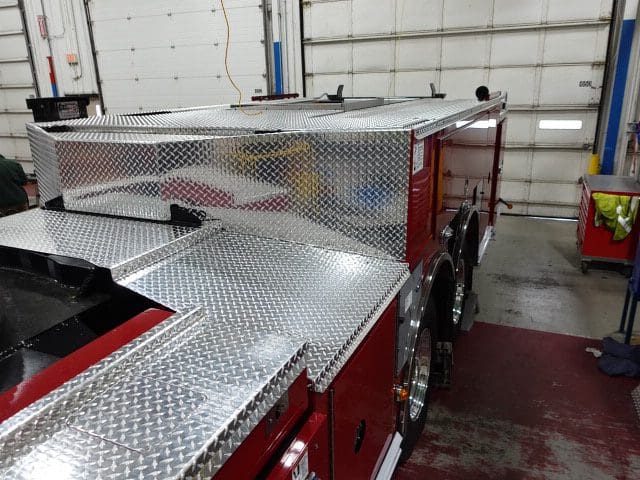

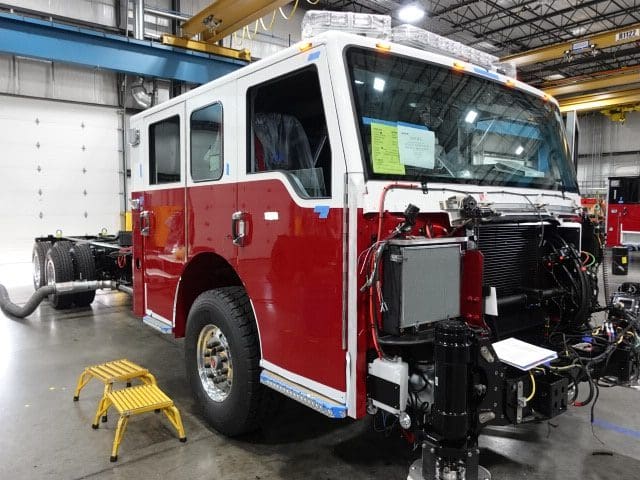

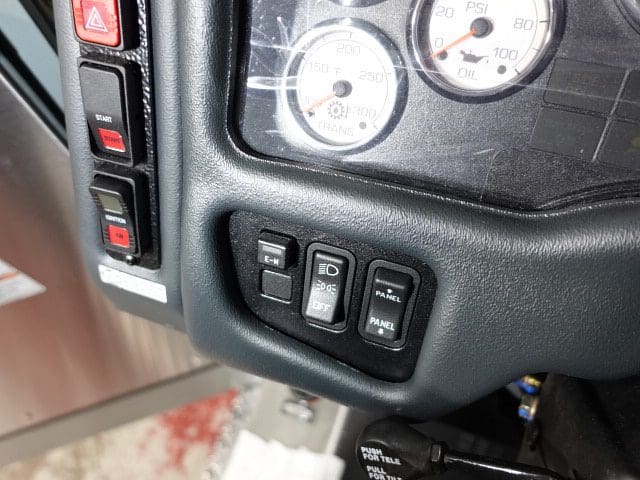

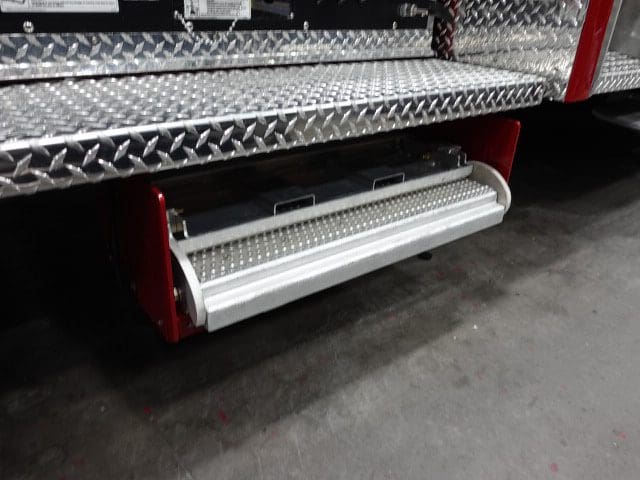

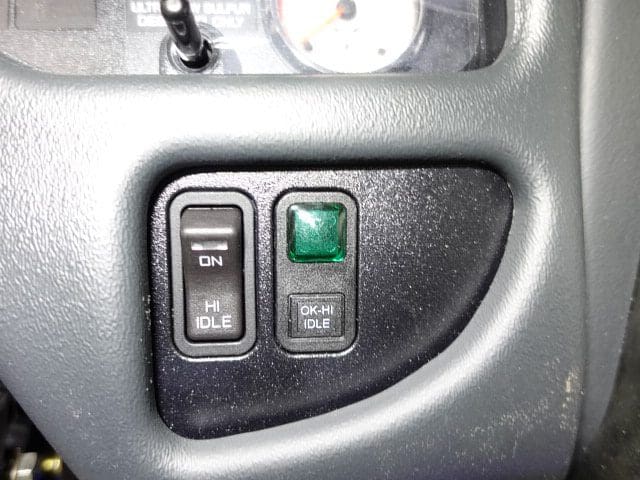

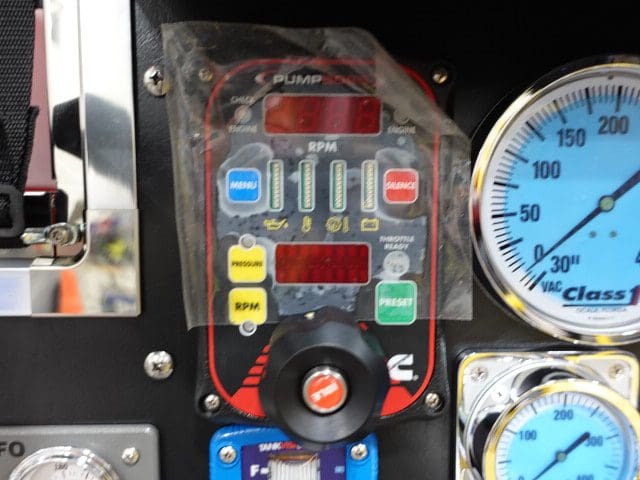

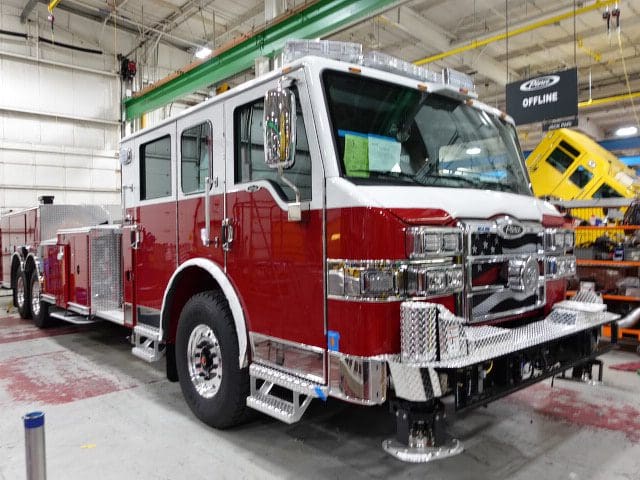

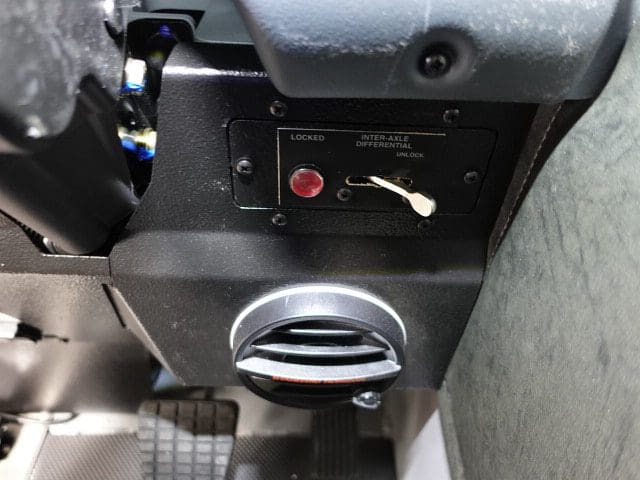

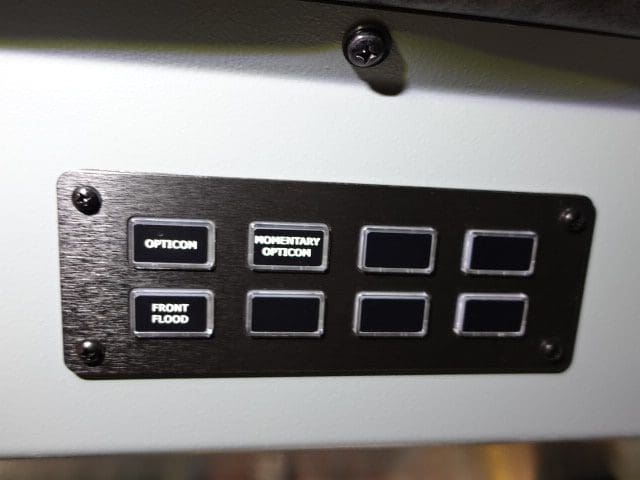

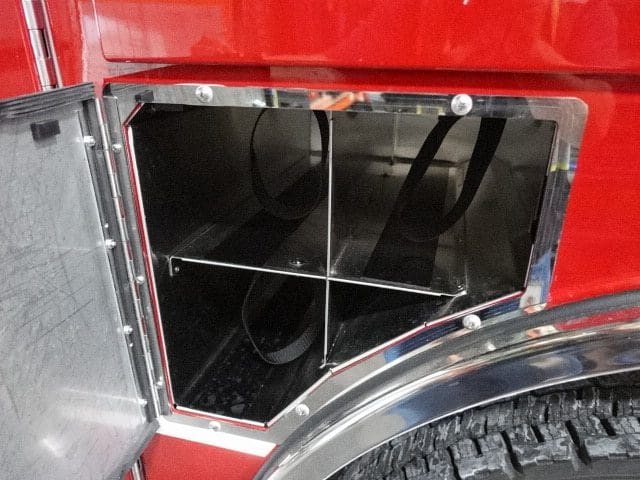

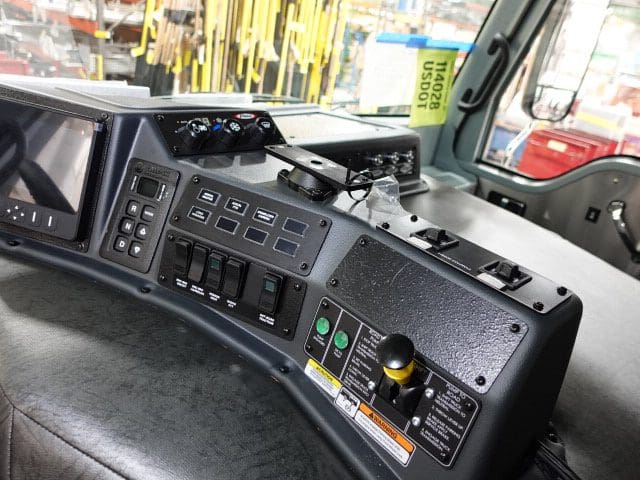

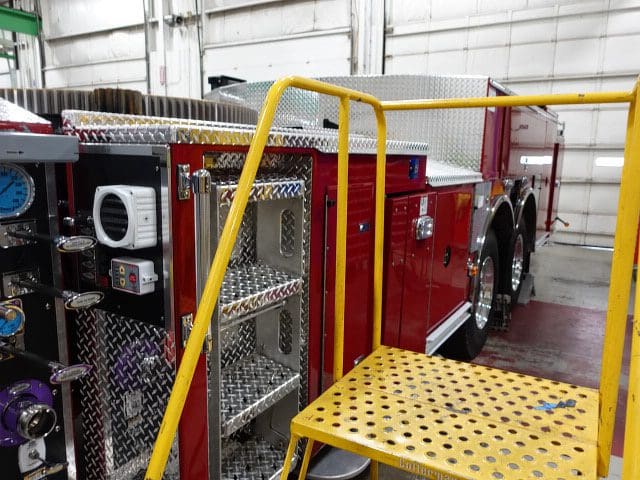

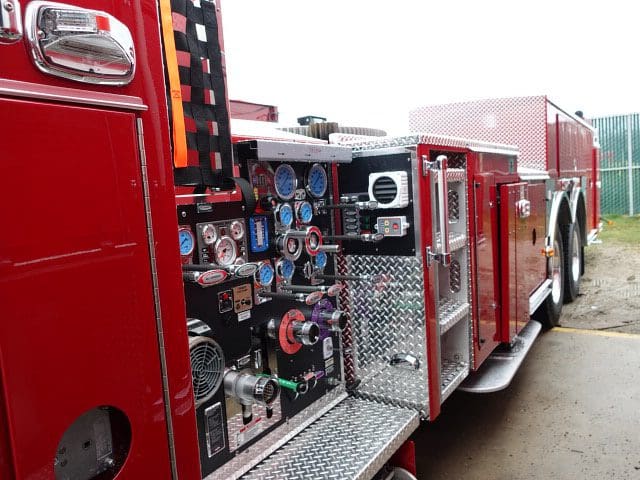

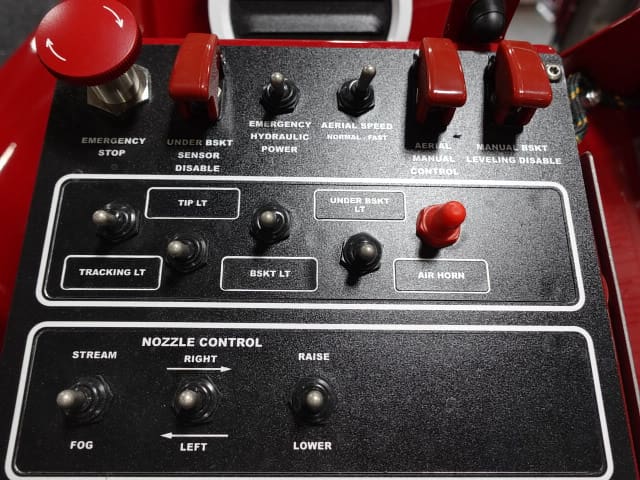

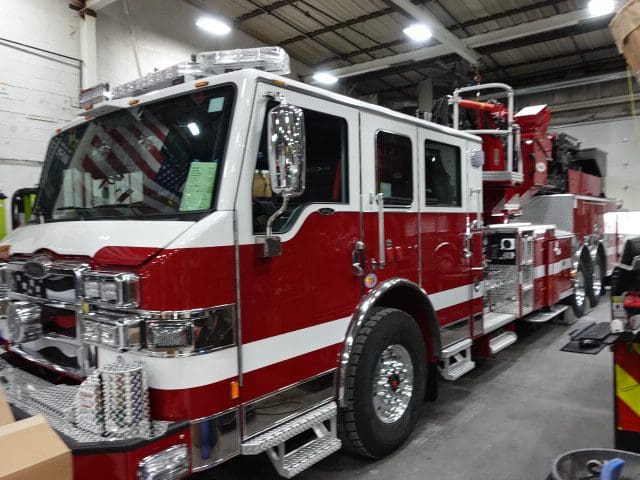

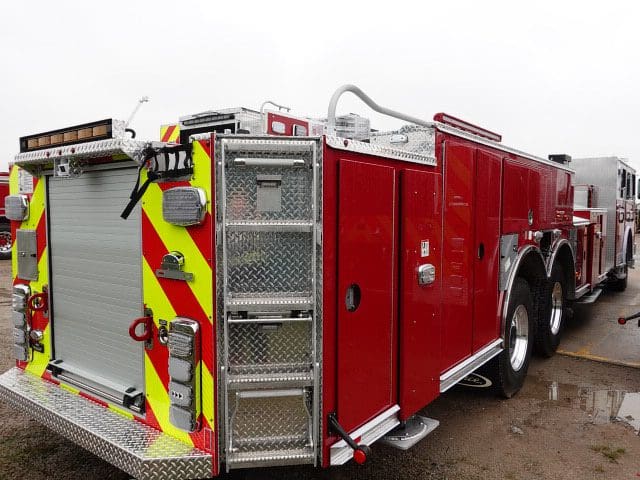

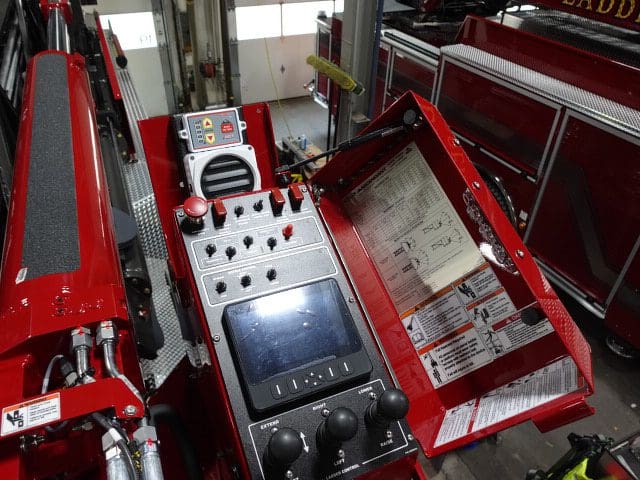

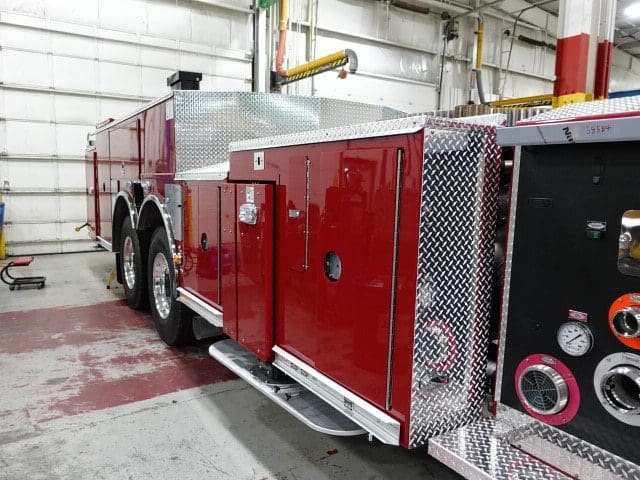

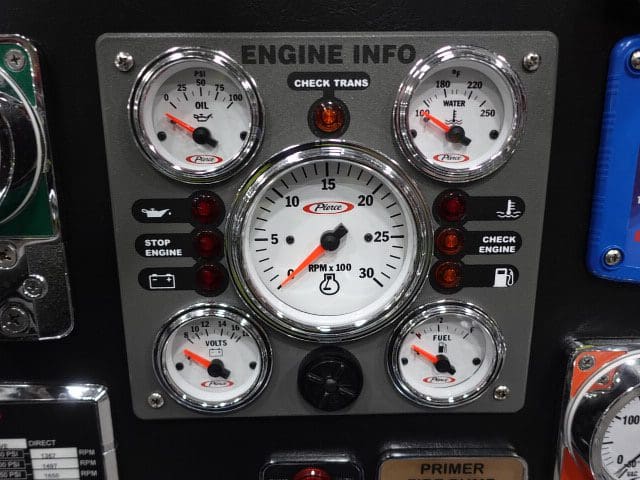

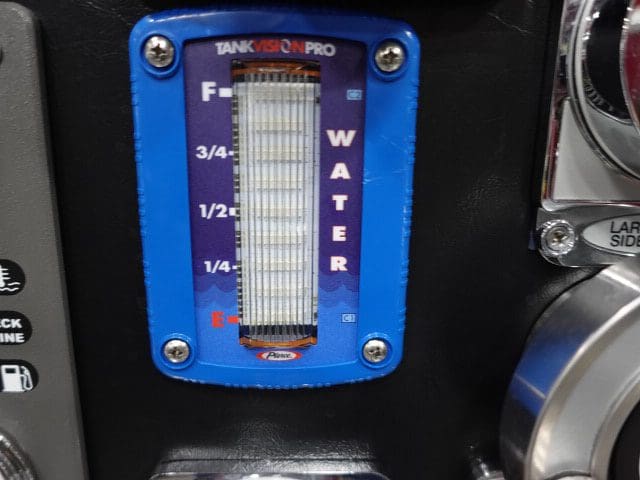

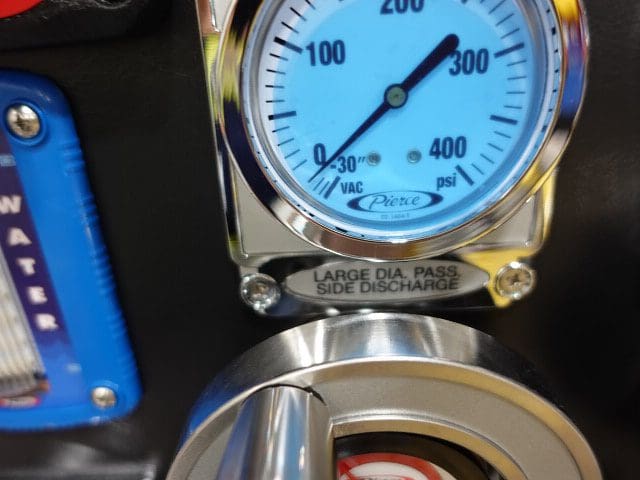

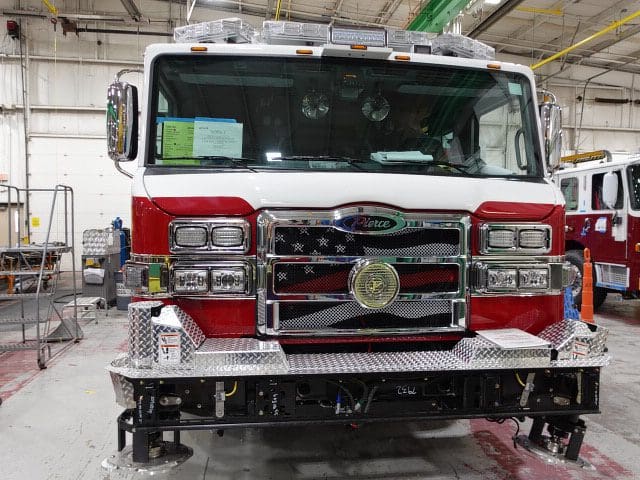

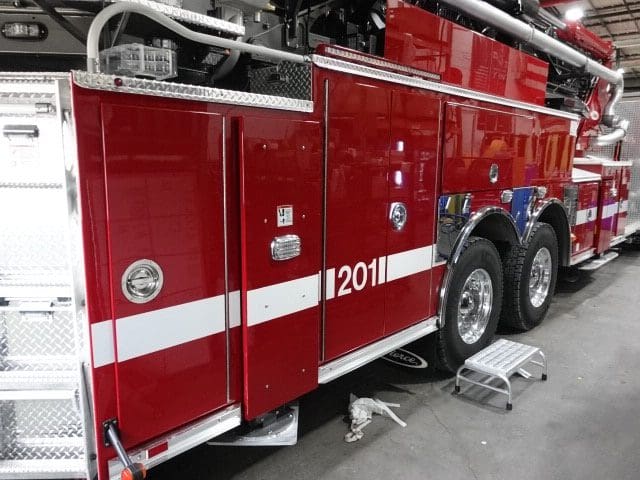

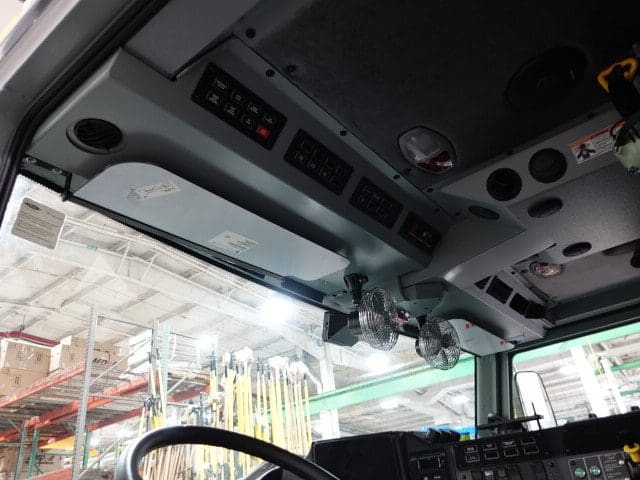

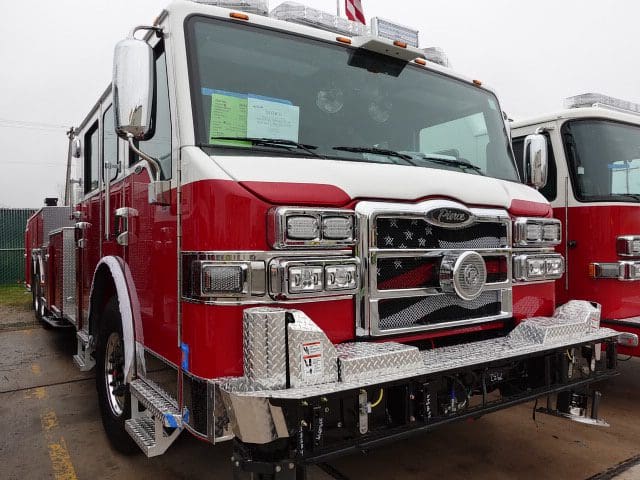

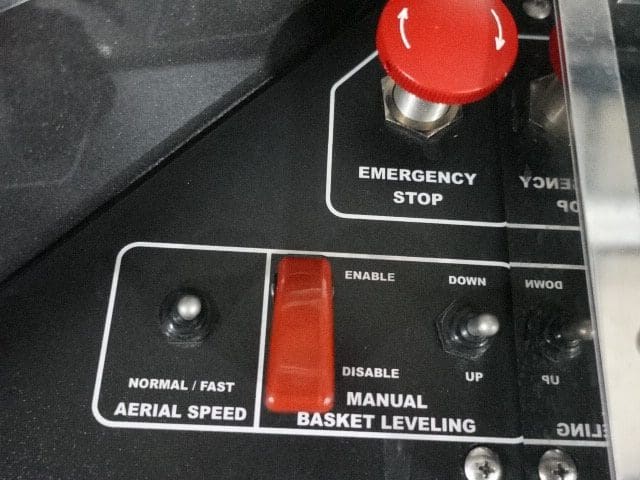

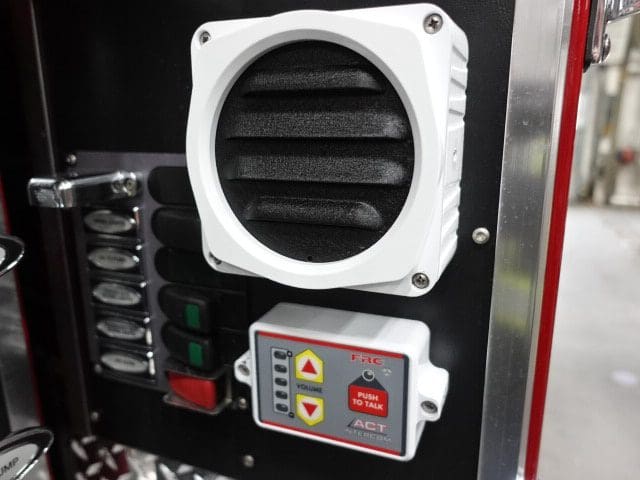

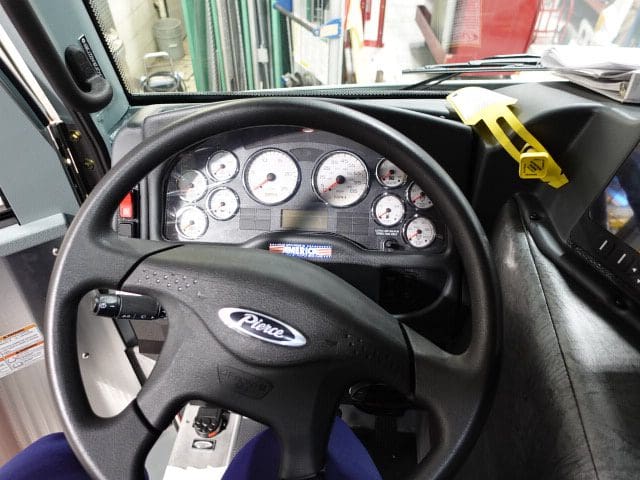

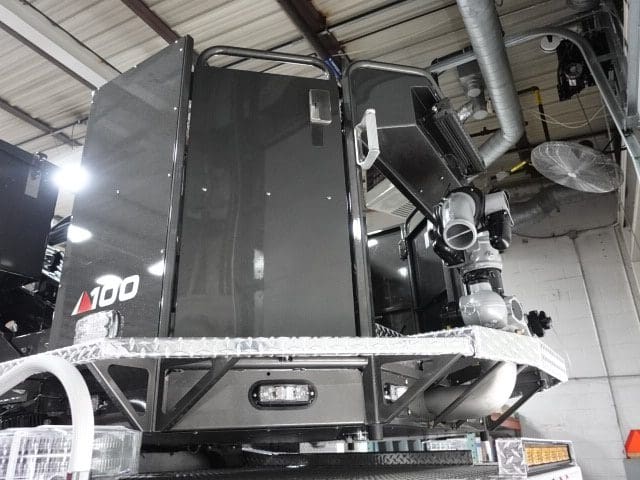

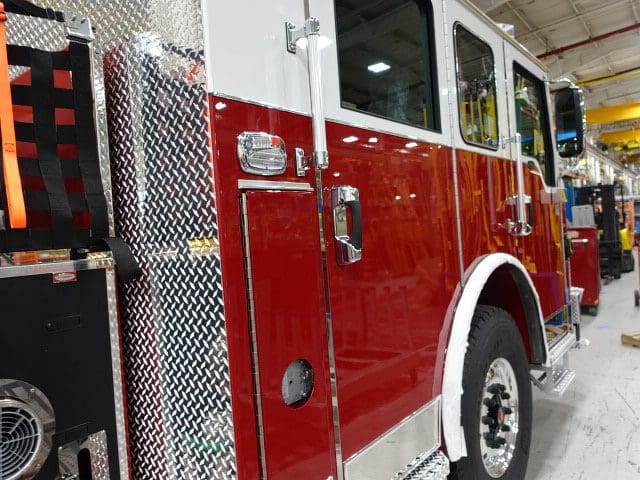

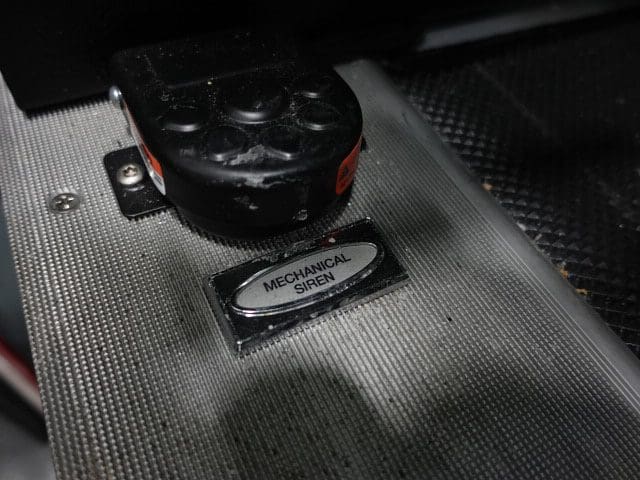

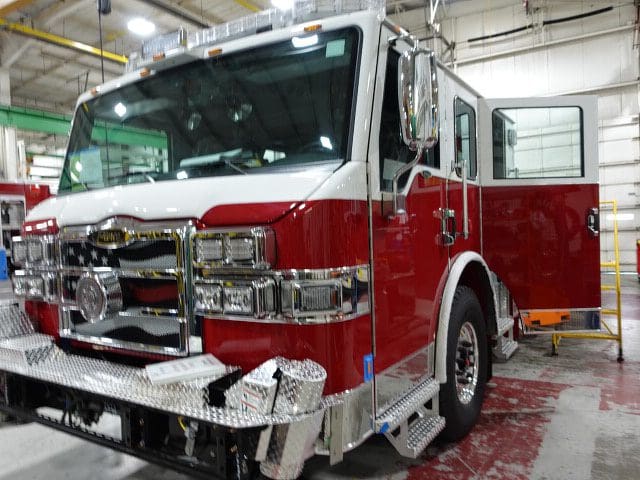

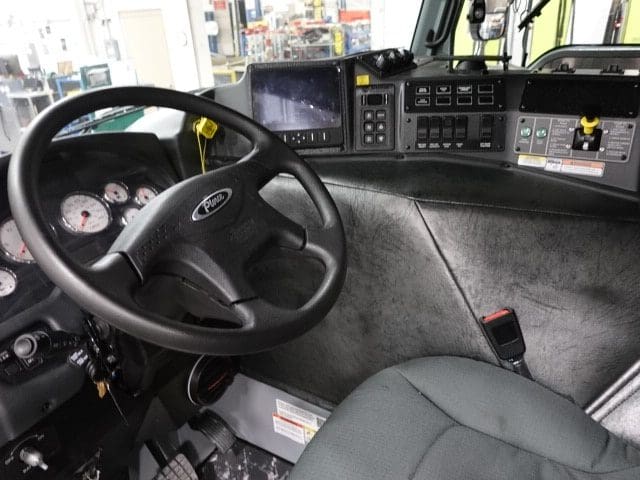

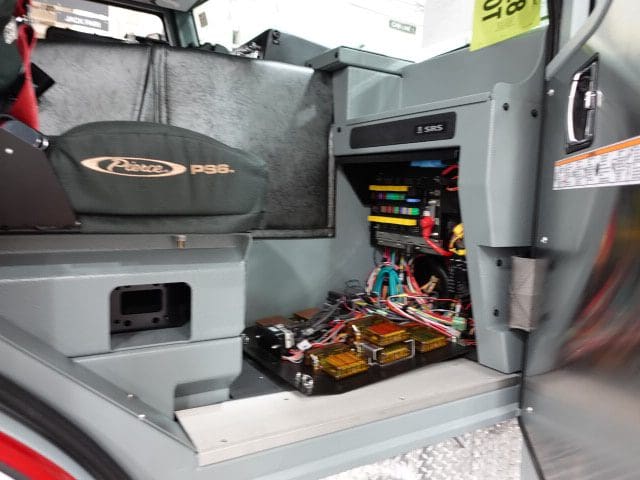

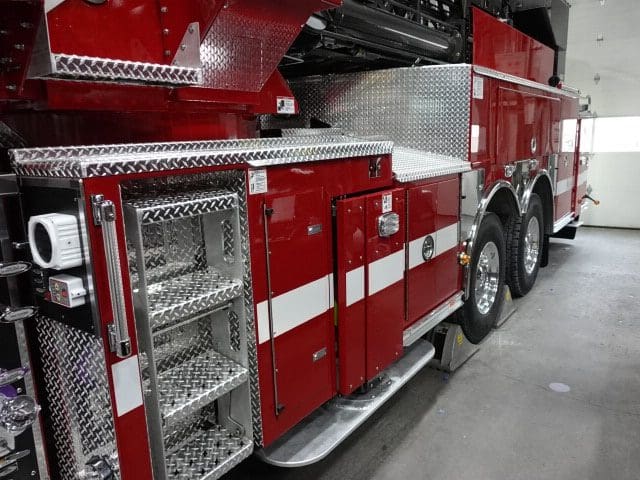

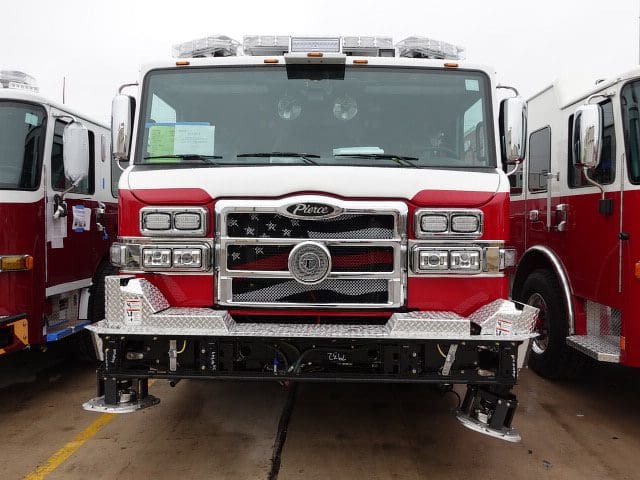

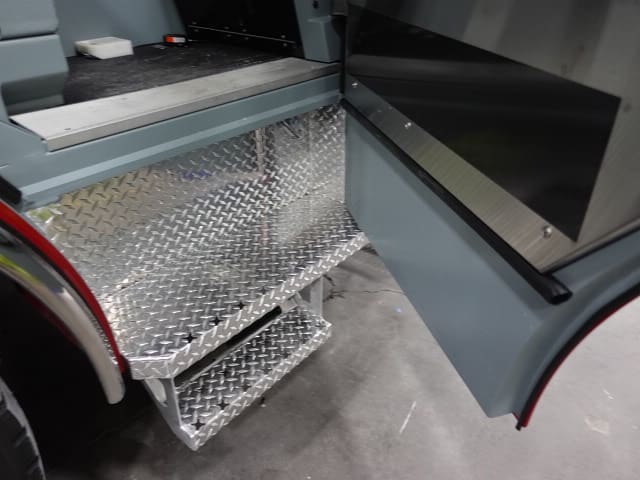

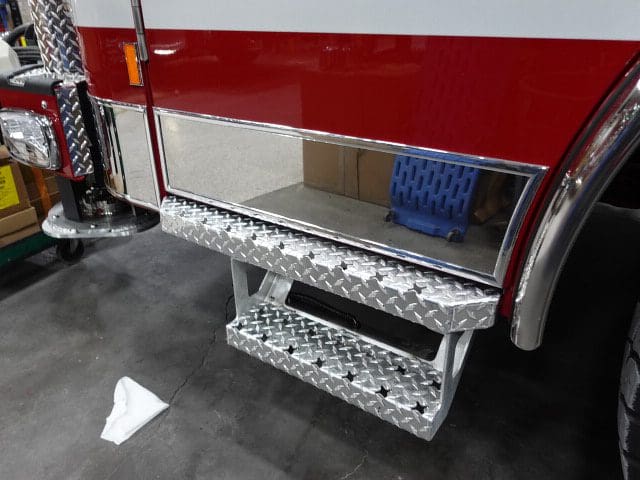

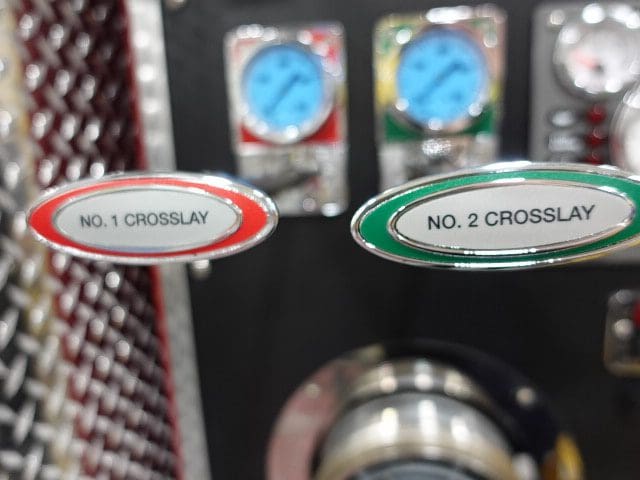

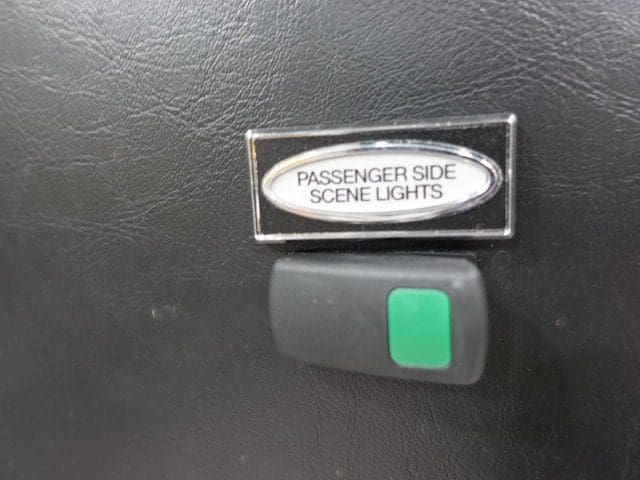

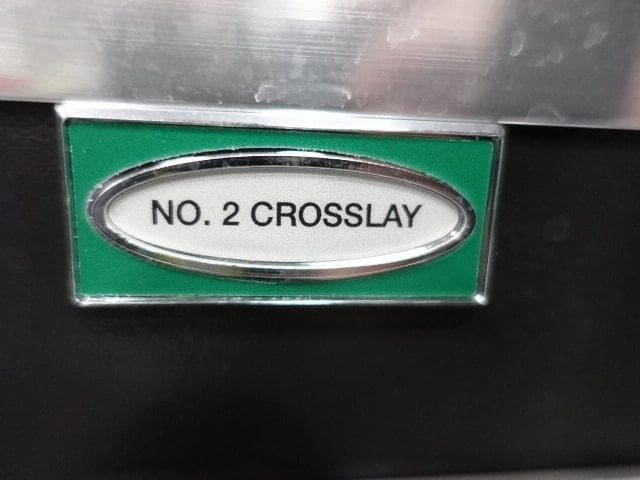

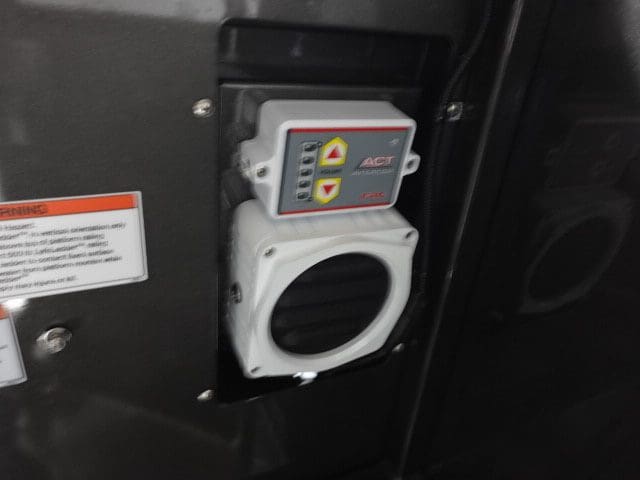

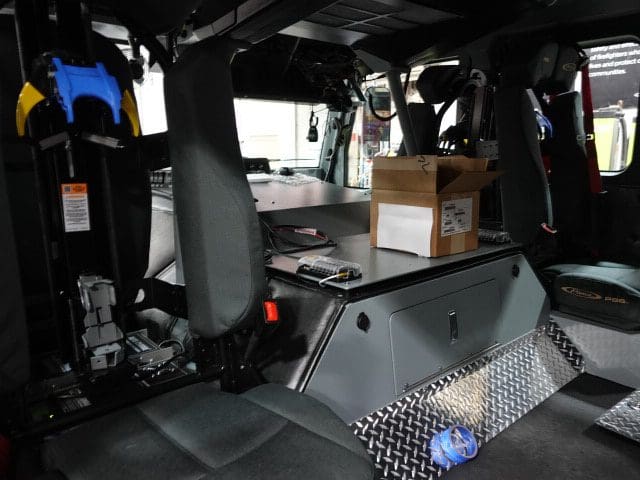

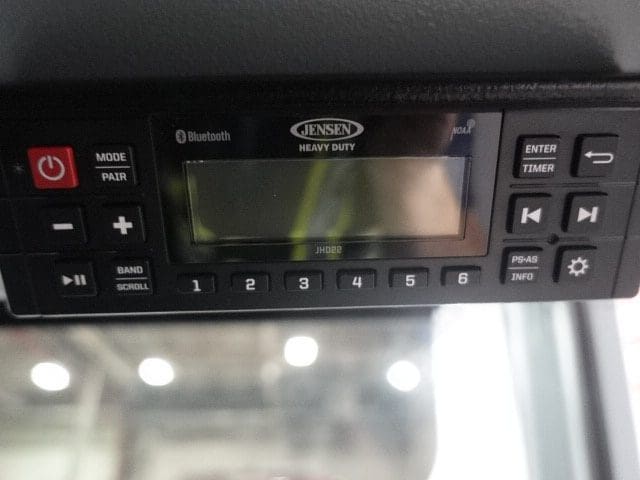

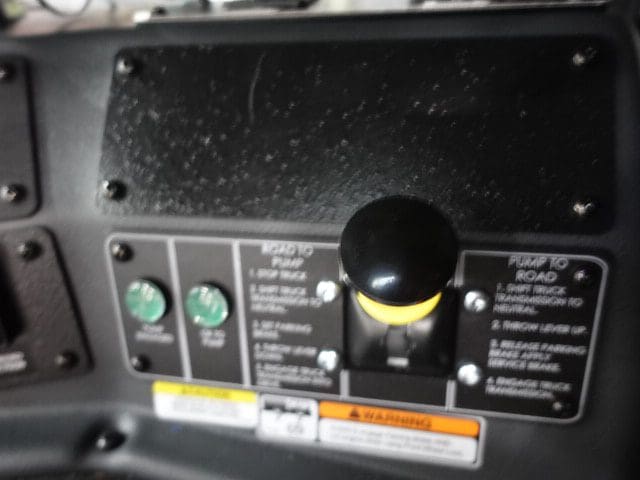

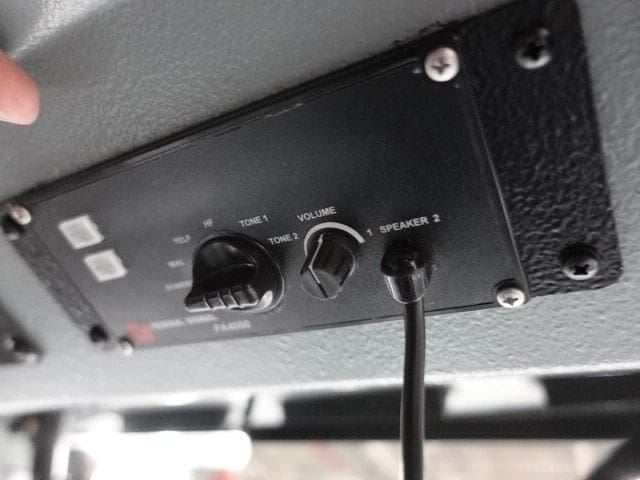

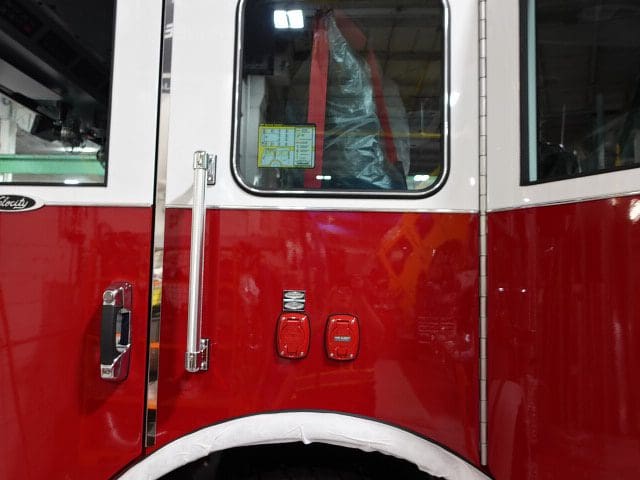

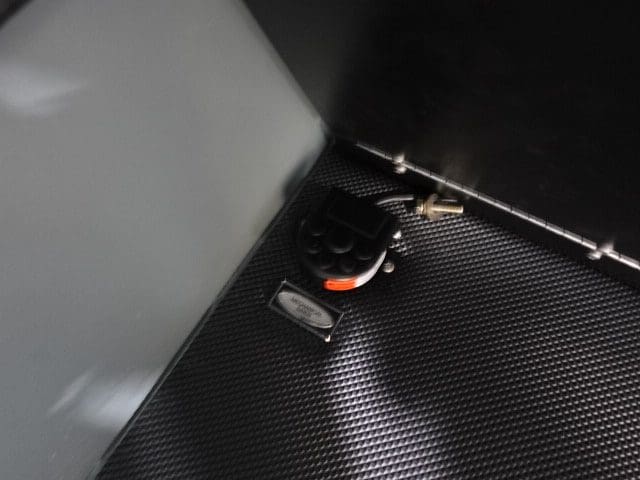

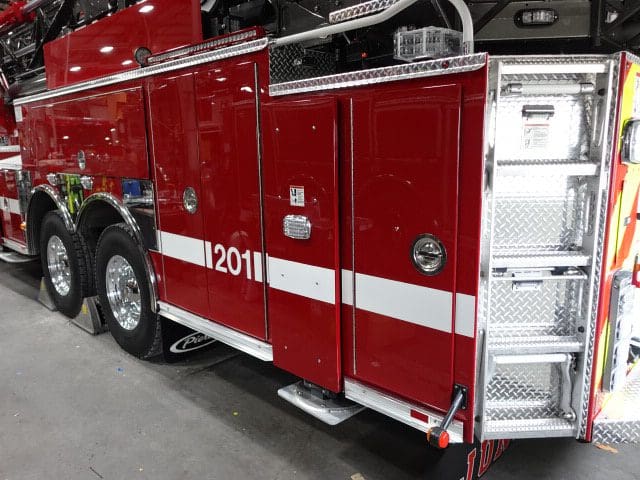

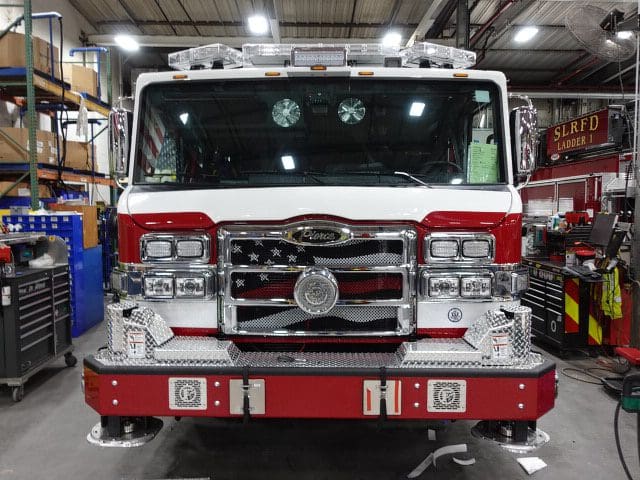

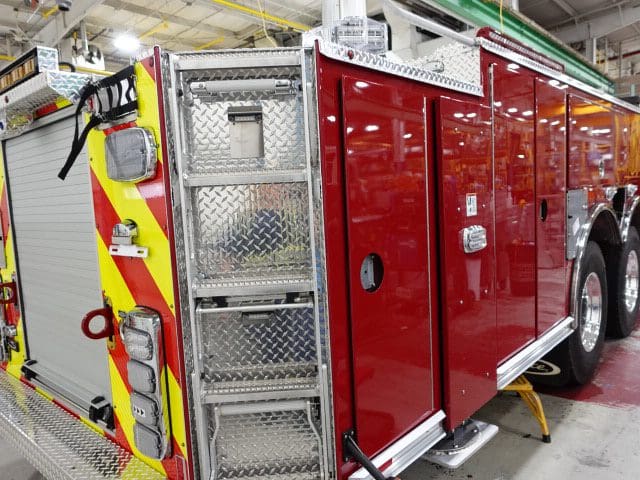

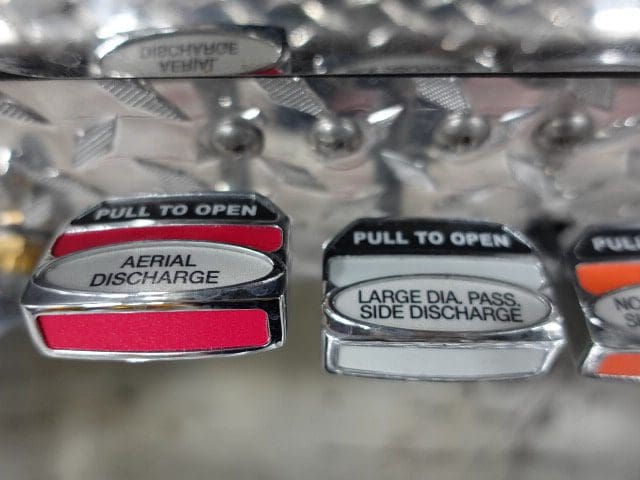

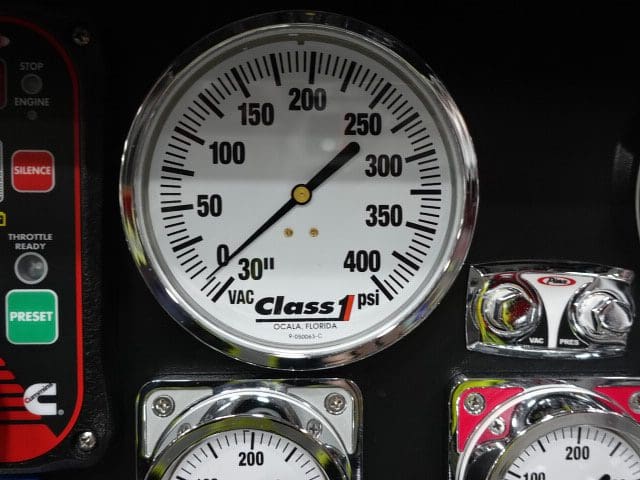

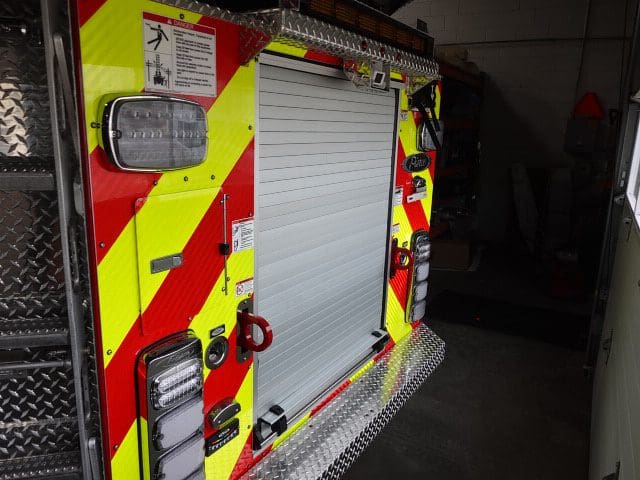

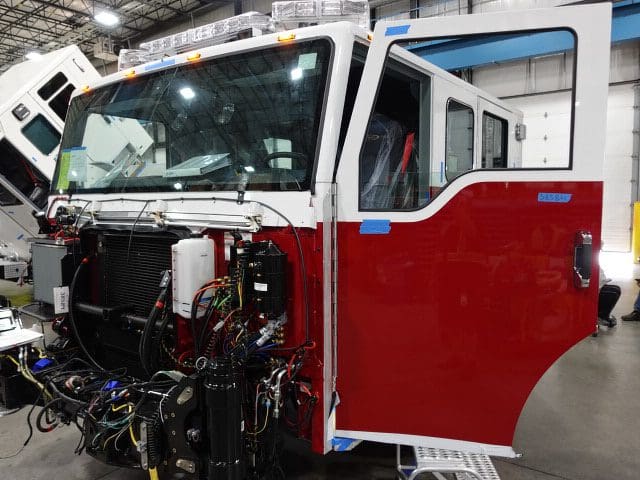

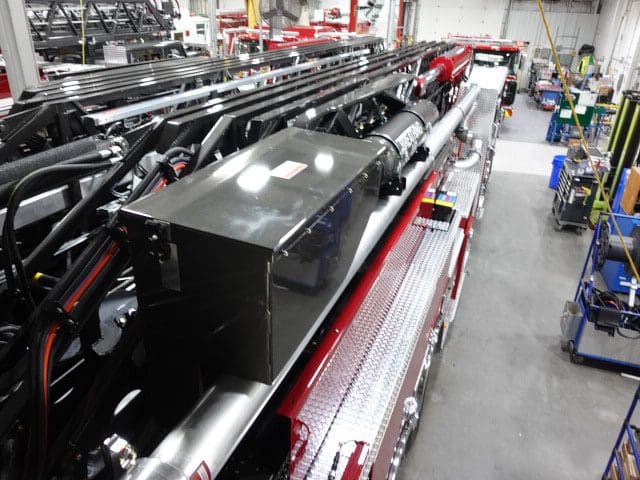

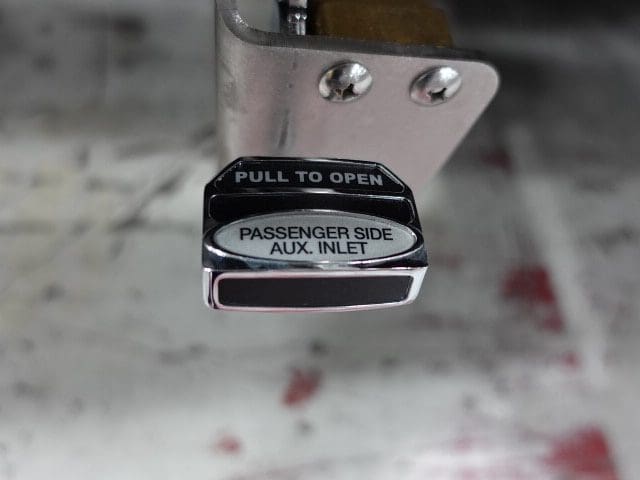

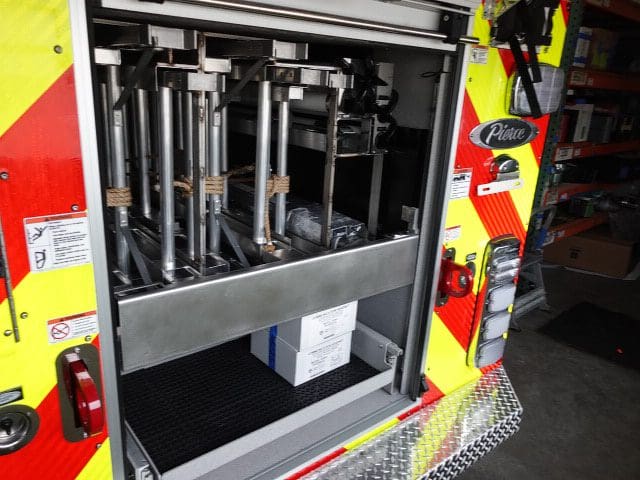

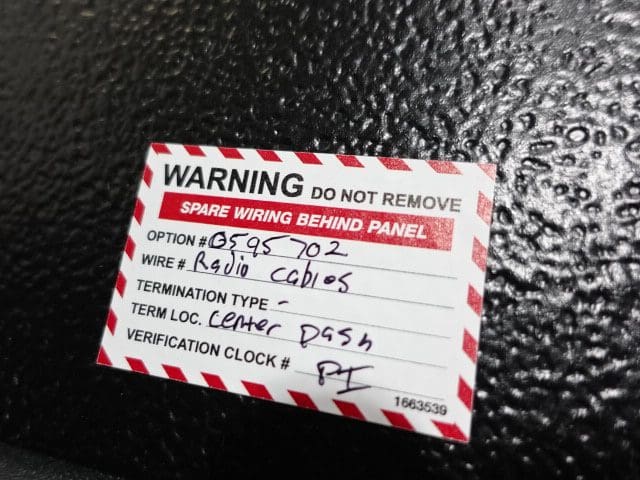

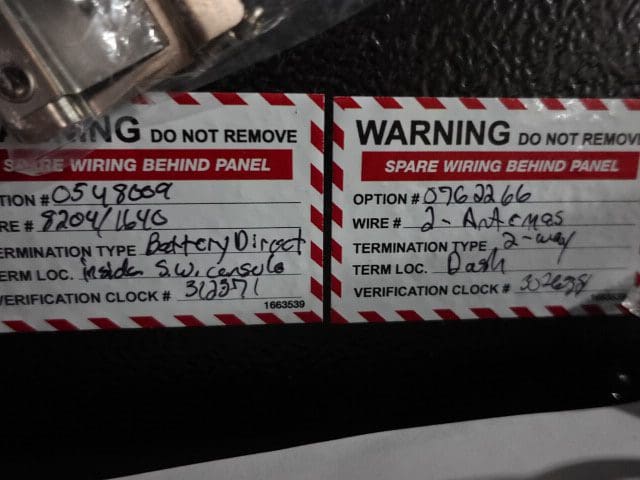

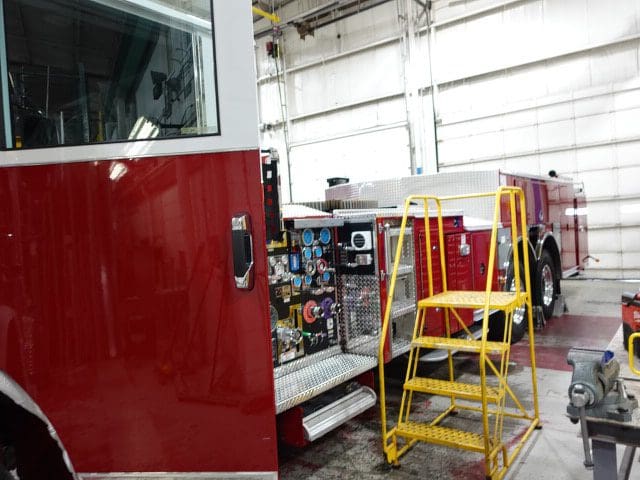

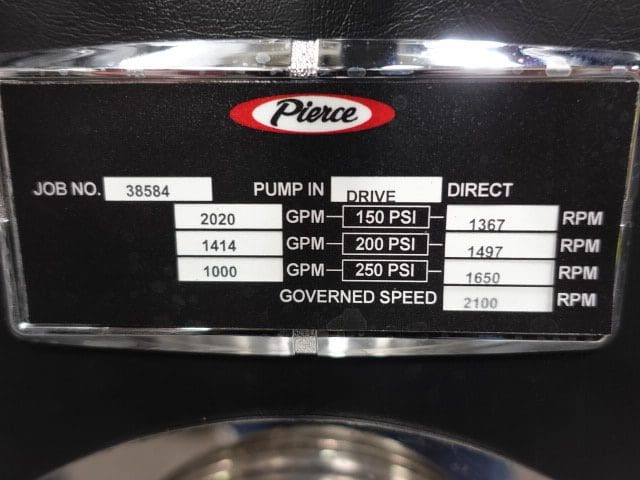

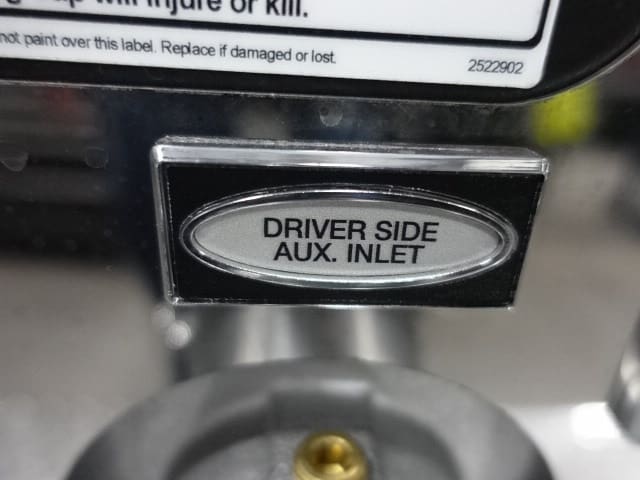

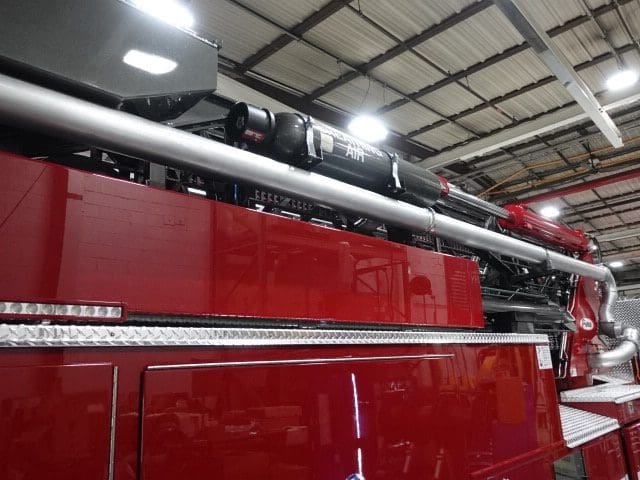

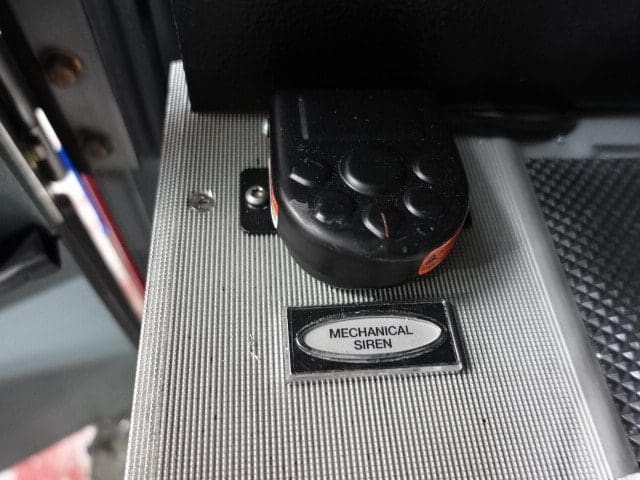

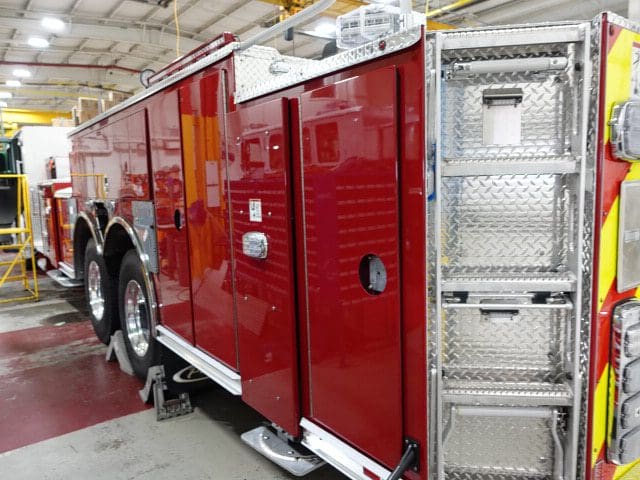

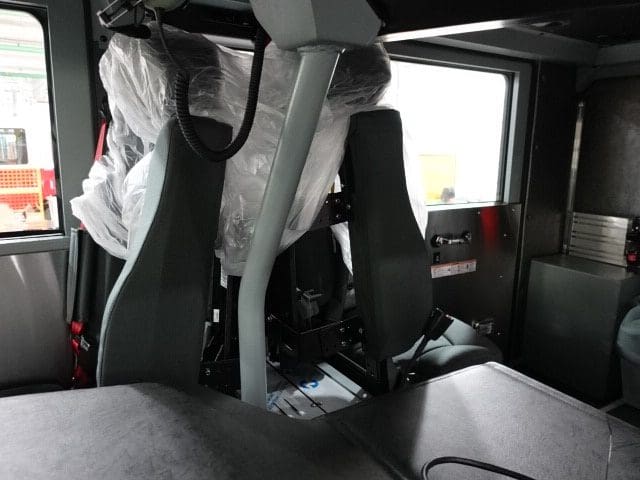

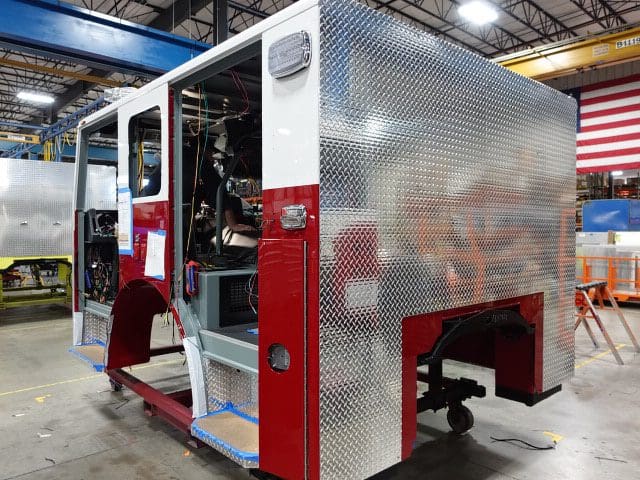

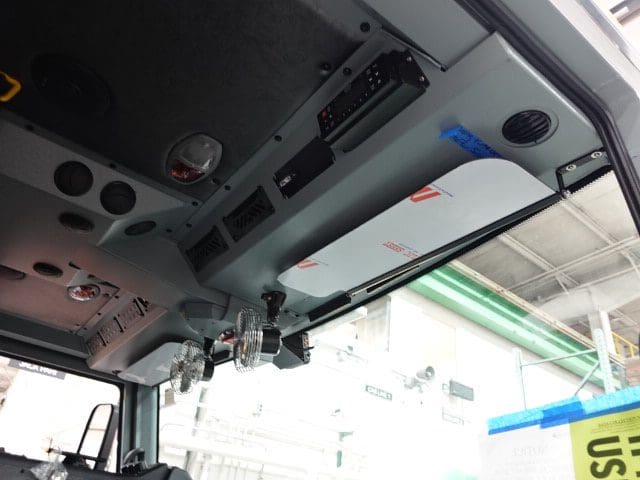

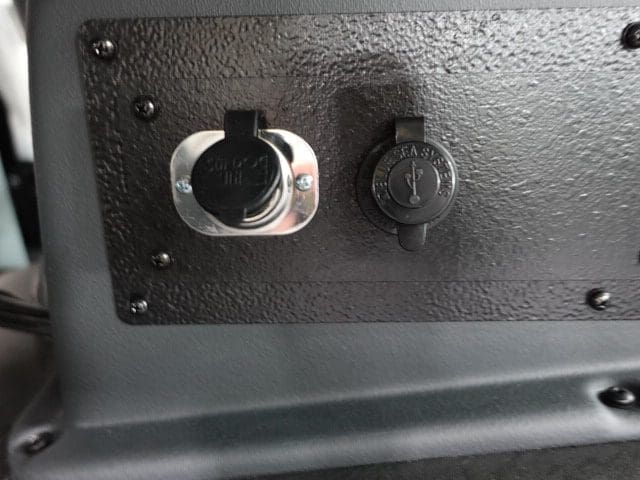

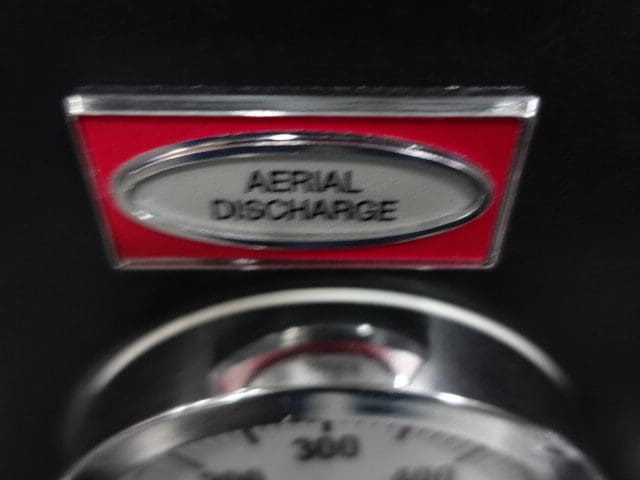

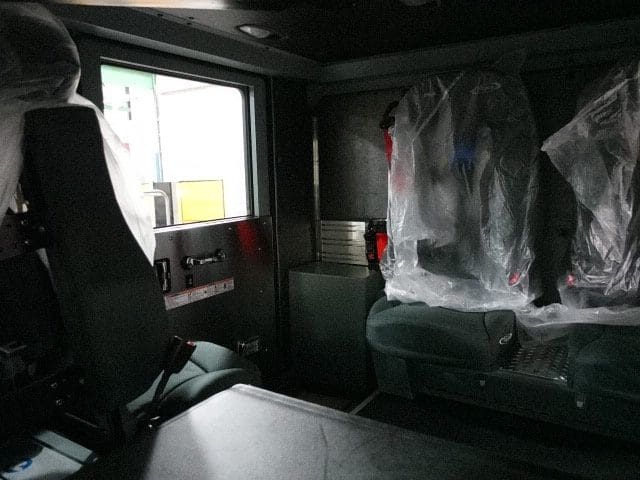

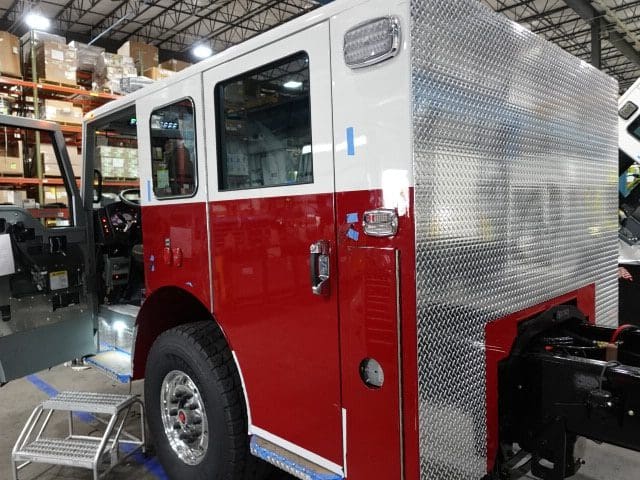

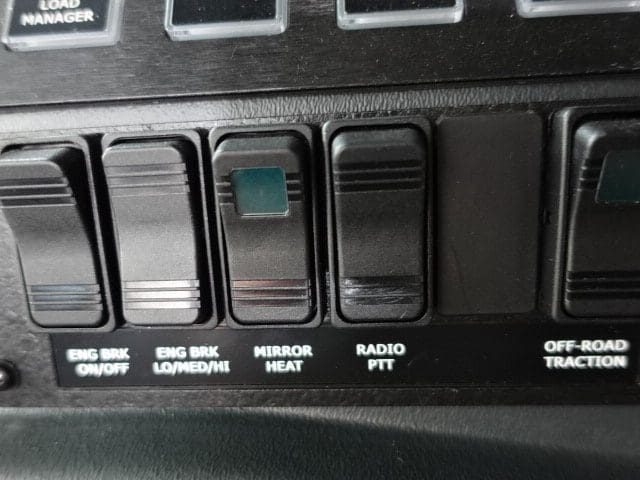

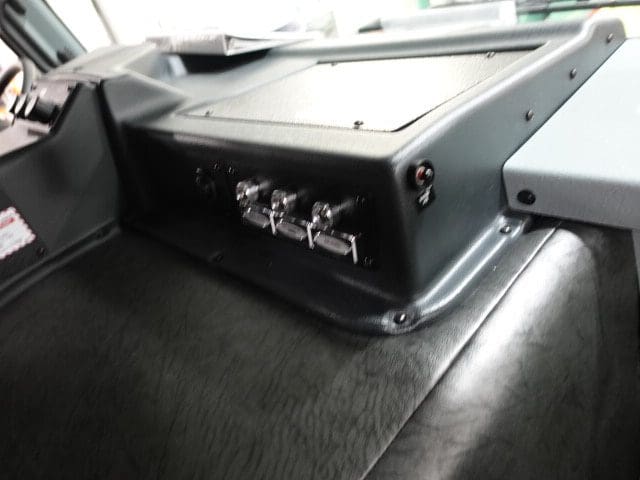

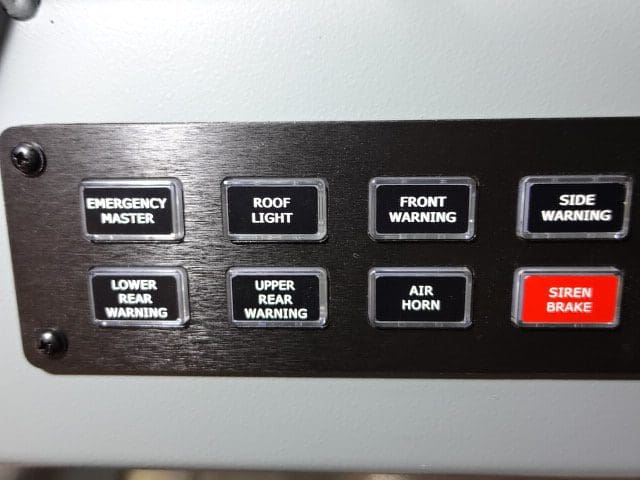

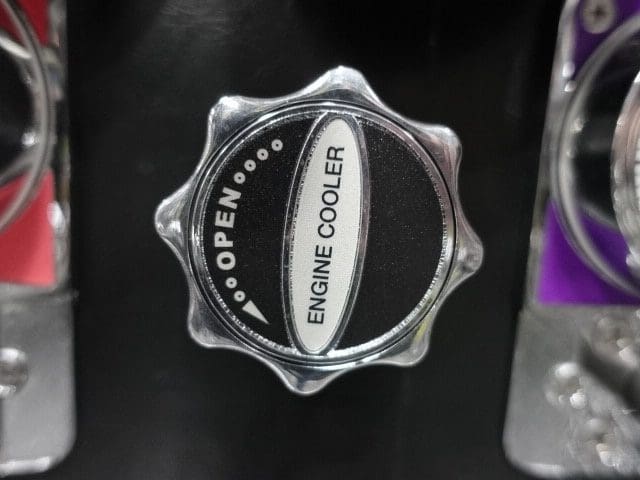

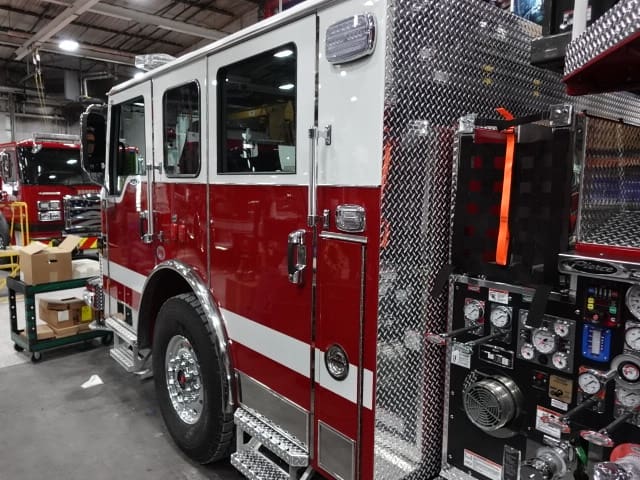

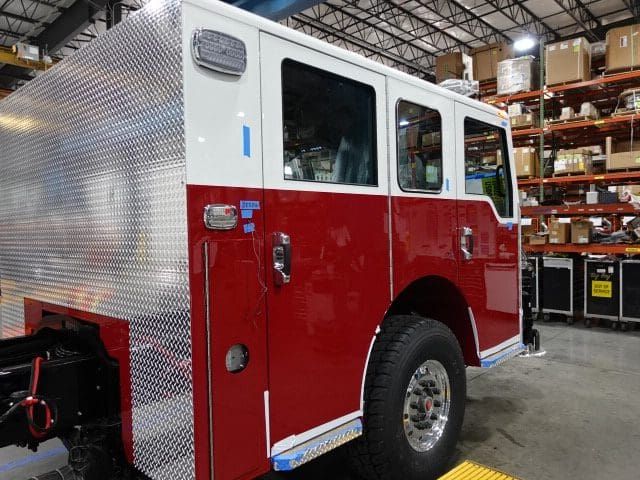

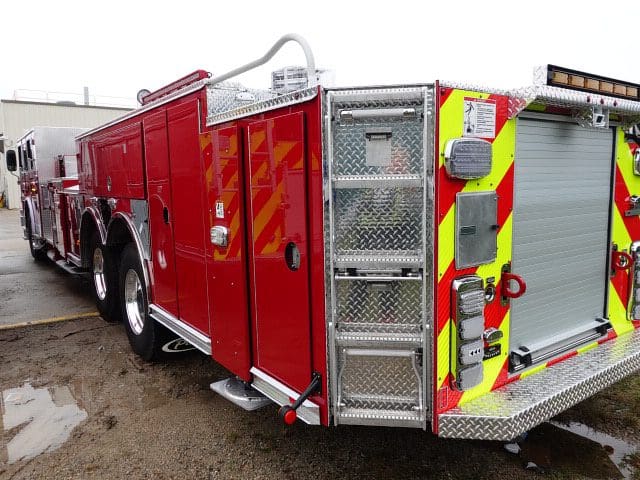

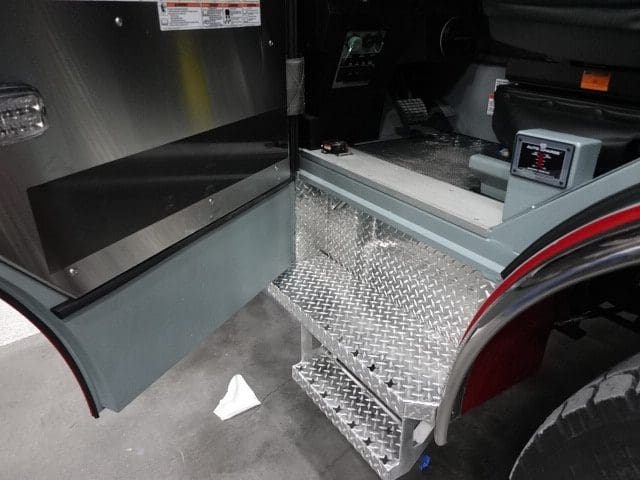

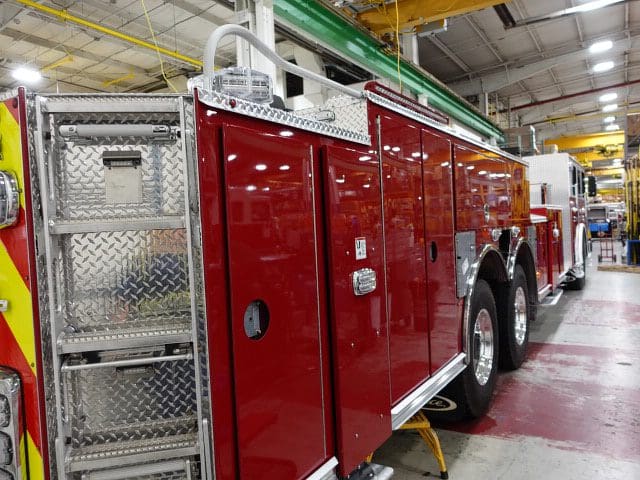

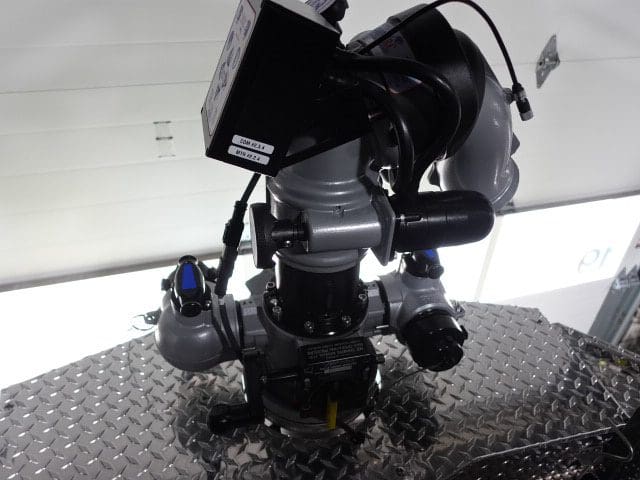

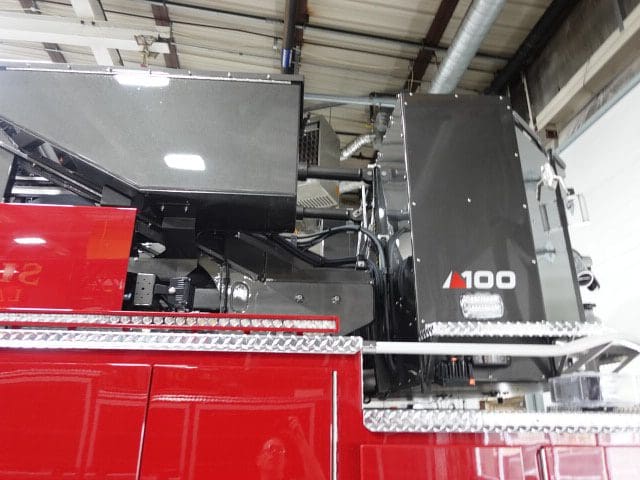

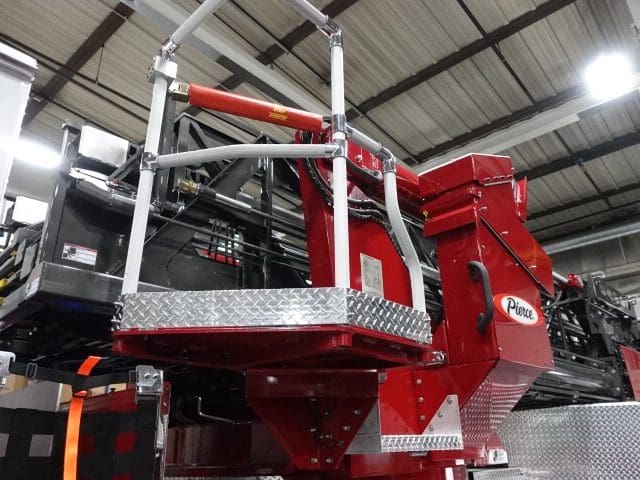

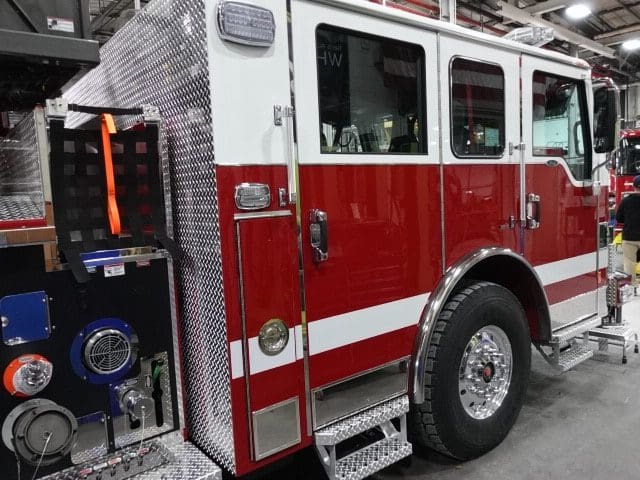

In this report, the apparatus completed testing and was released to quality and graphics where any remaining content will be applied. Once finished, it will be made ready for the customer acceptance inspection. This is the last scheduled report.
11-22-24

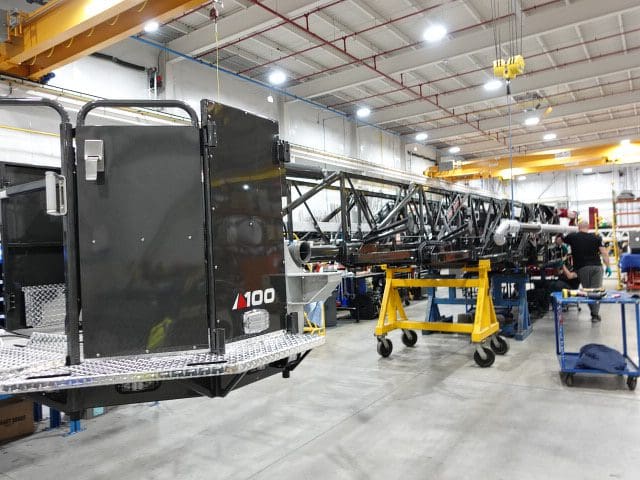

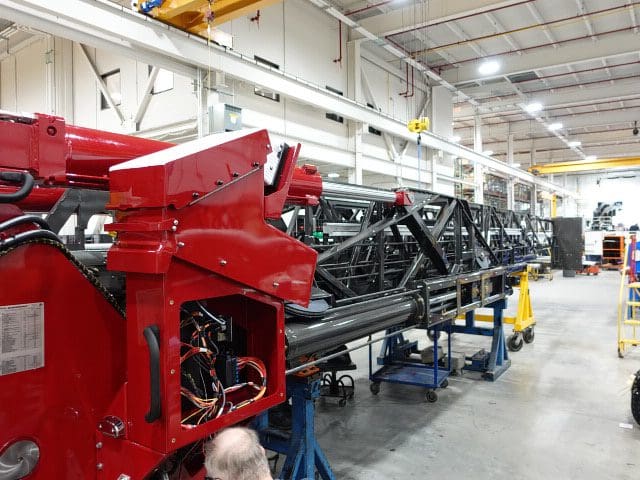

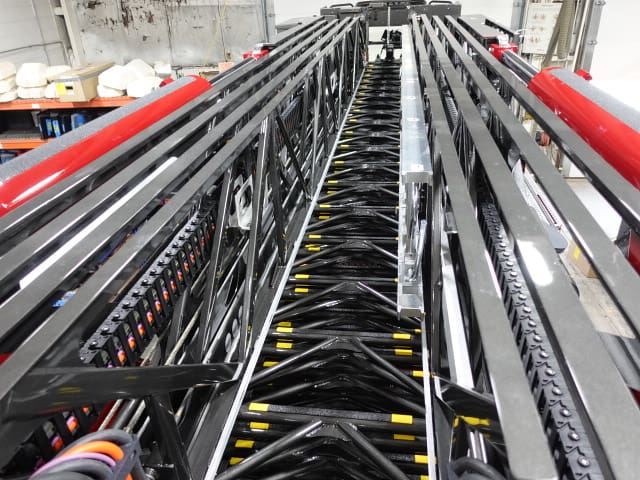

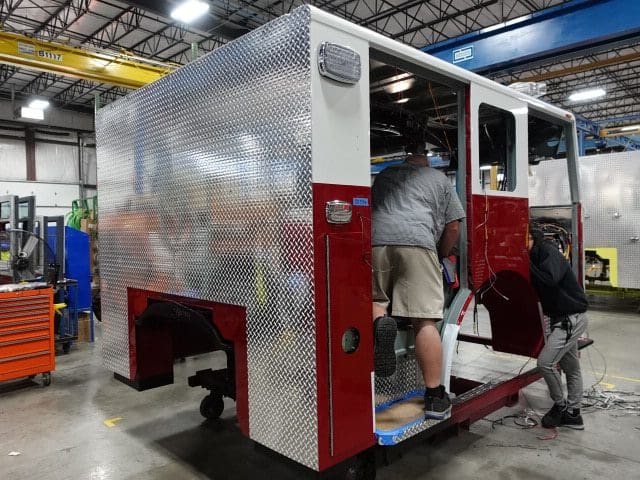

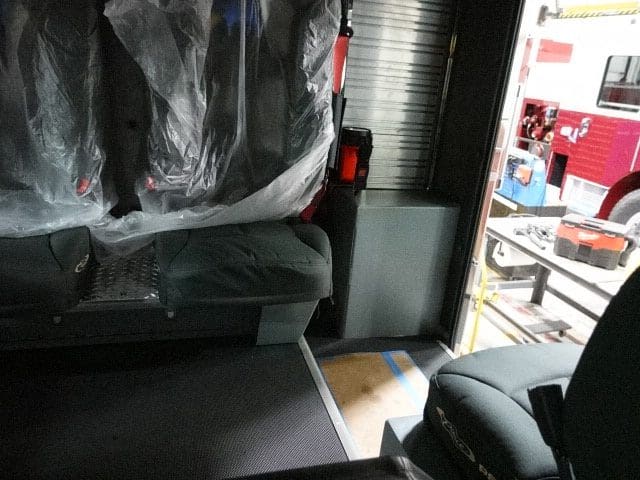

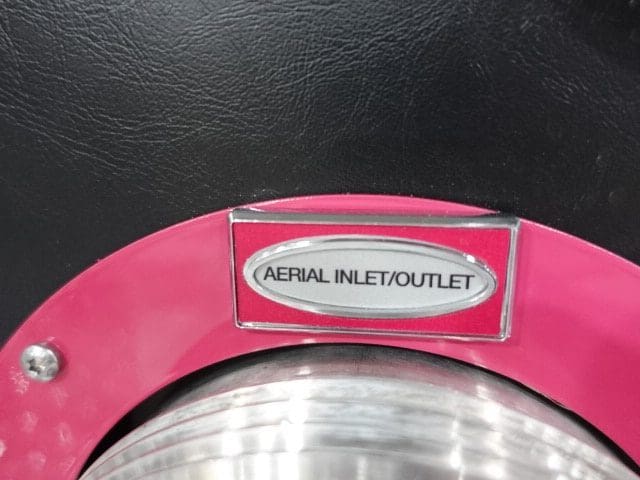

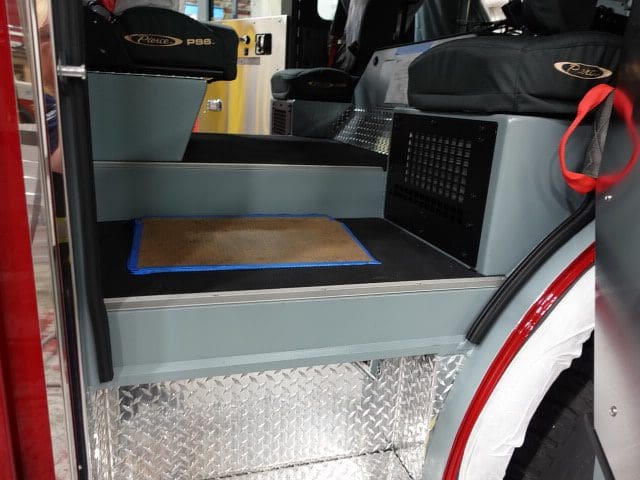

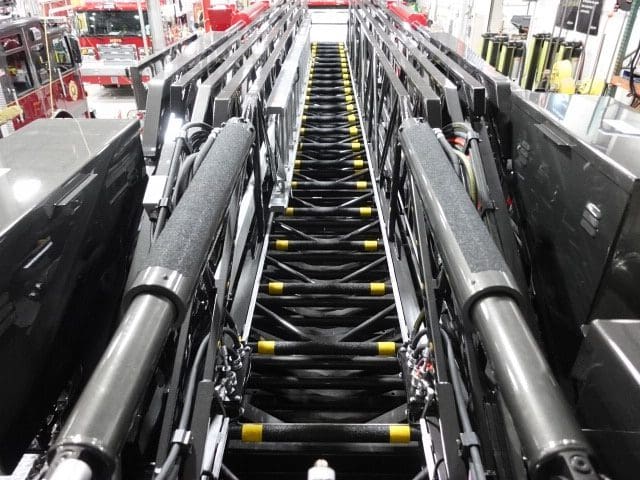

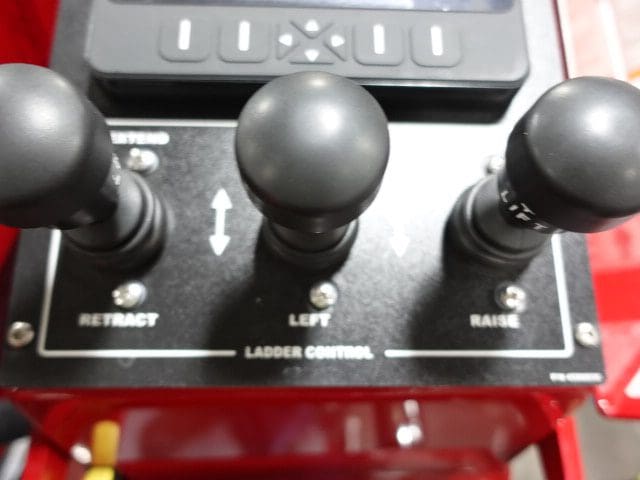

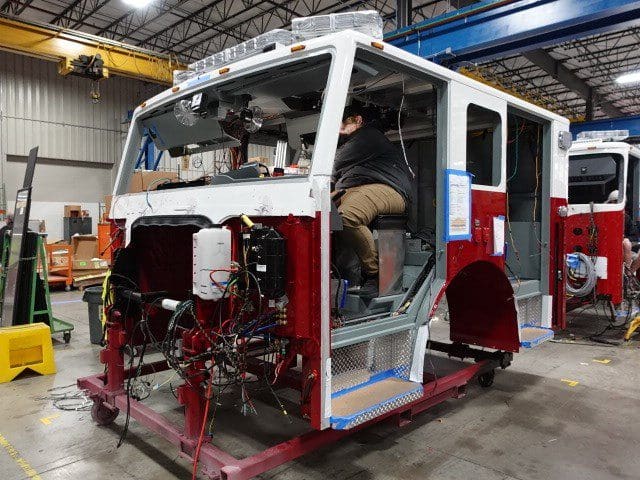

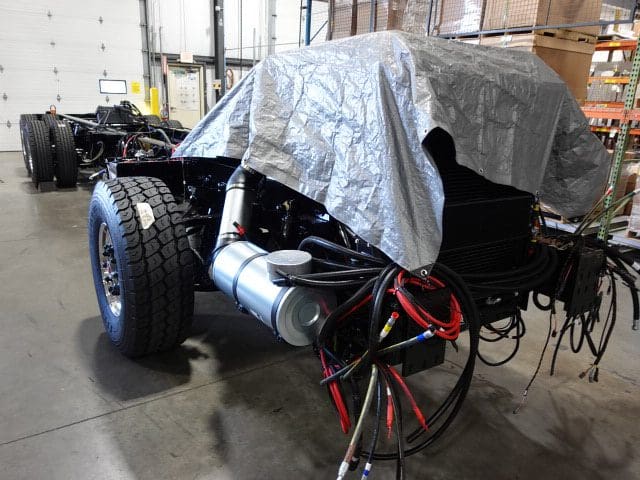

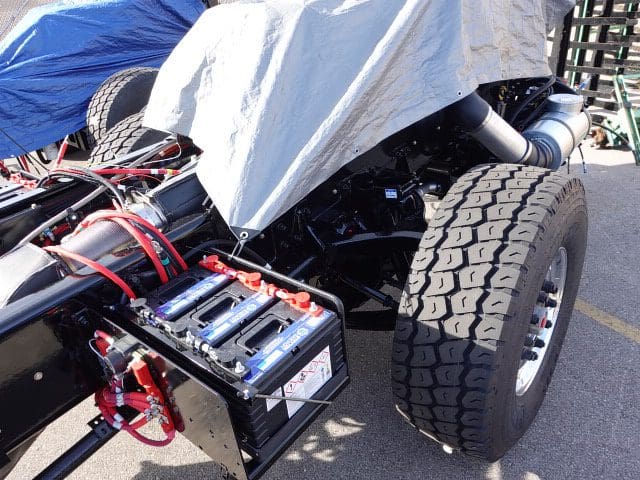

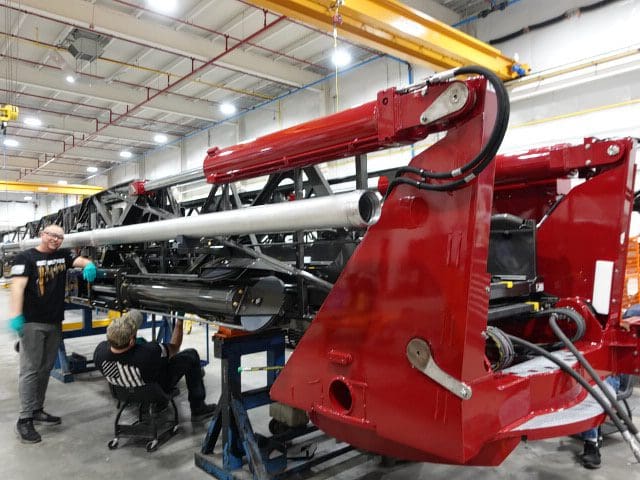

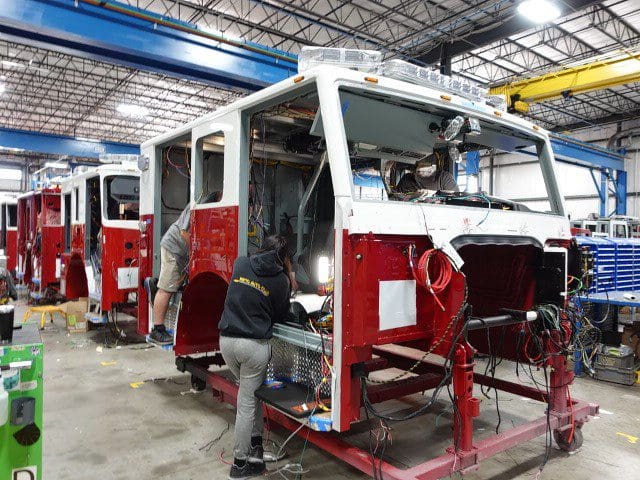

In this report, the apparatus continued some assembly in an offline area of production while the aerial device arrived and began initial assembly.
11-15-24

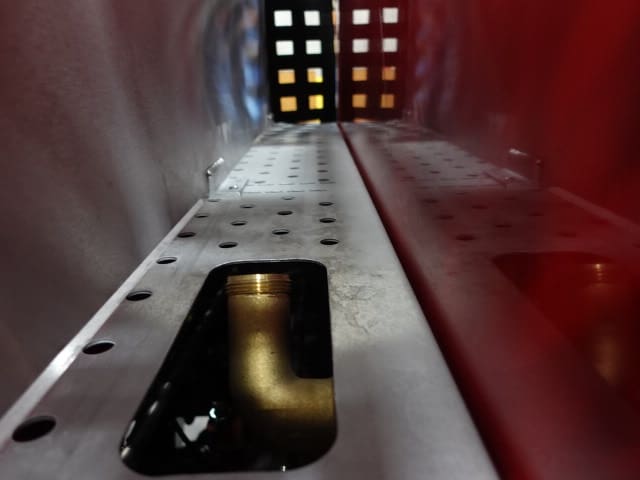

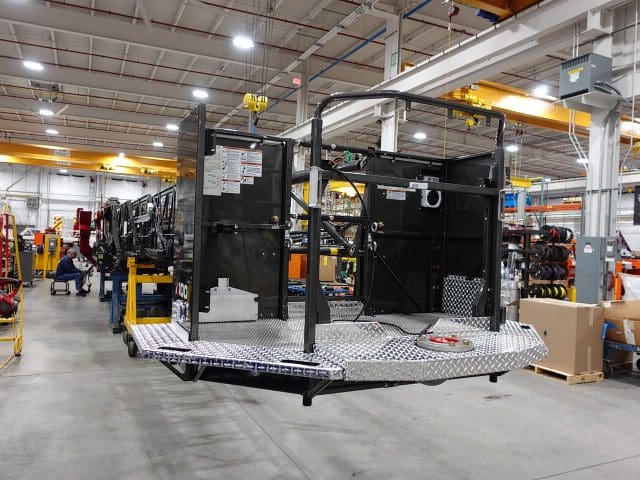

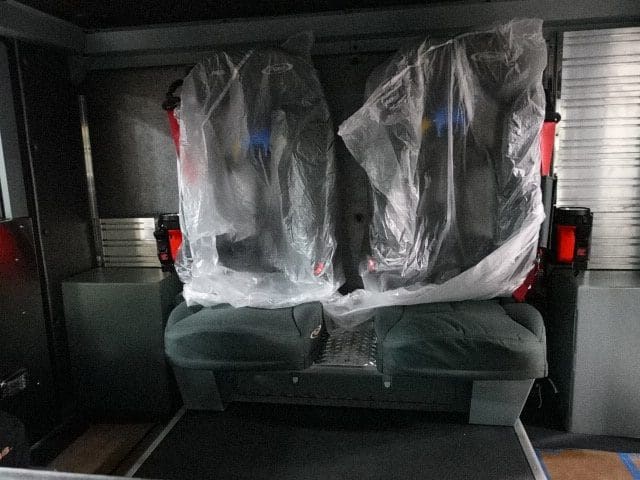

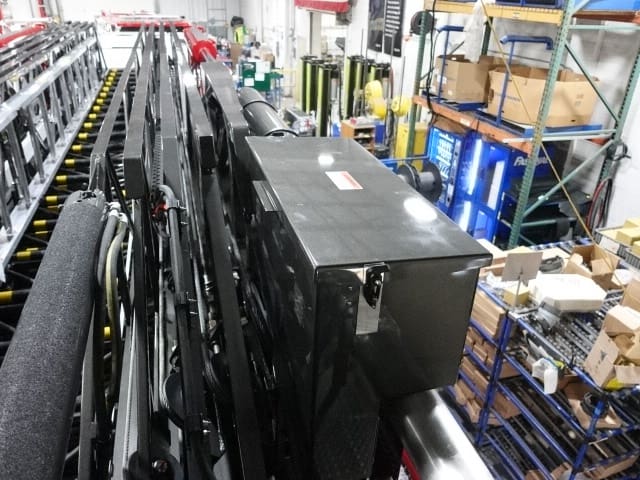

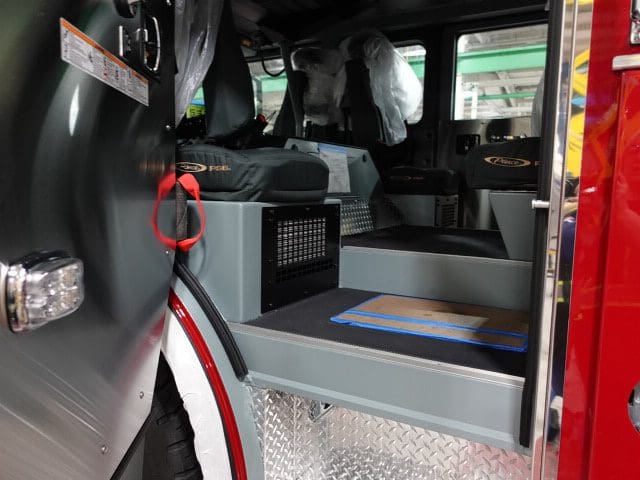

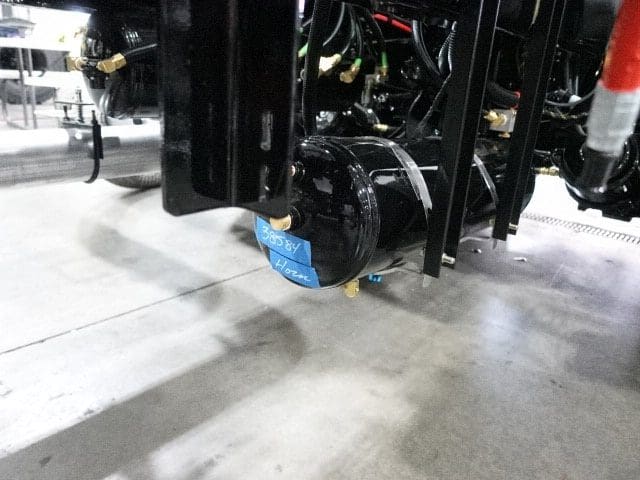

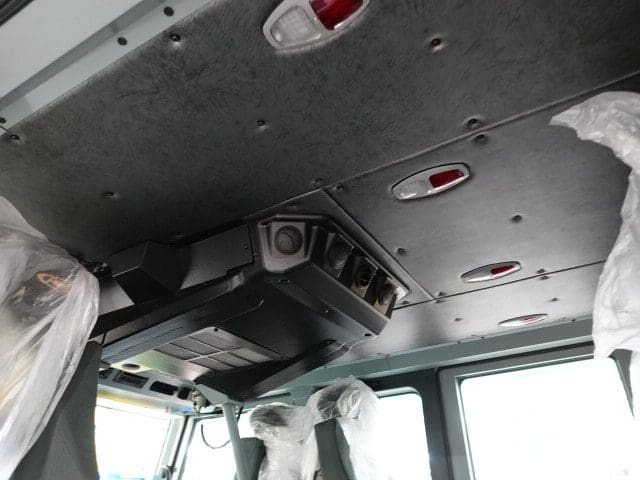

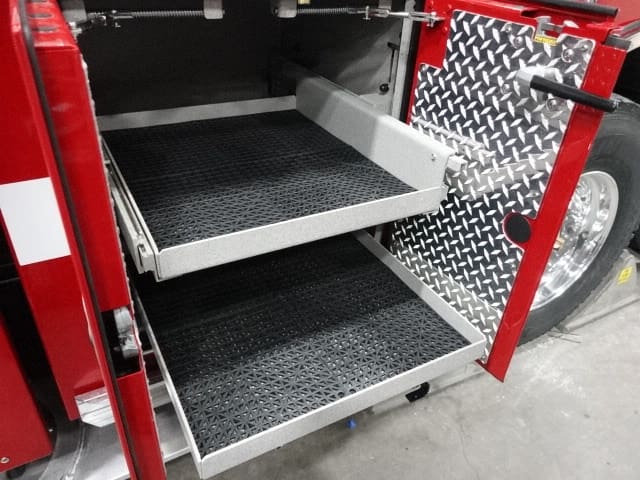

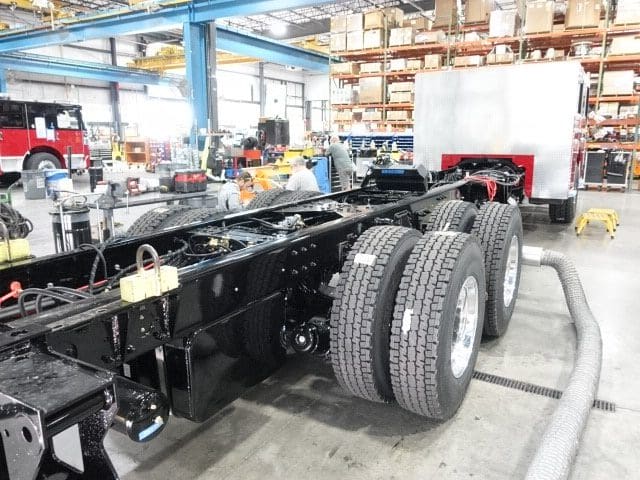

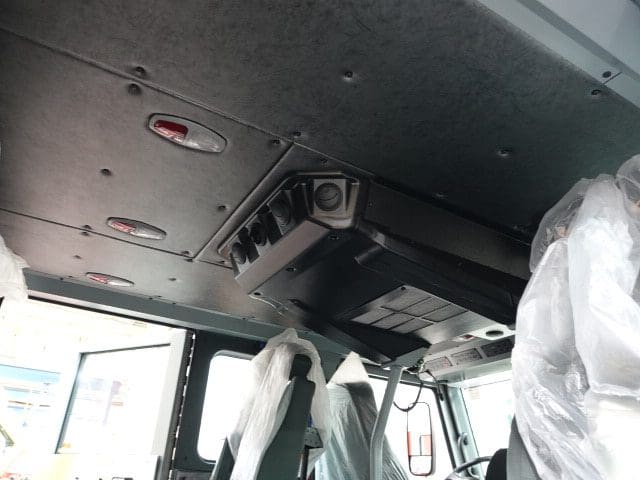

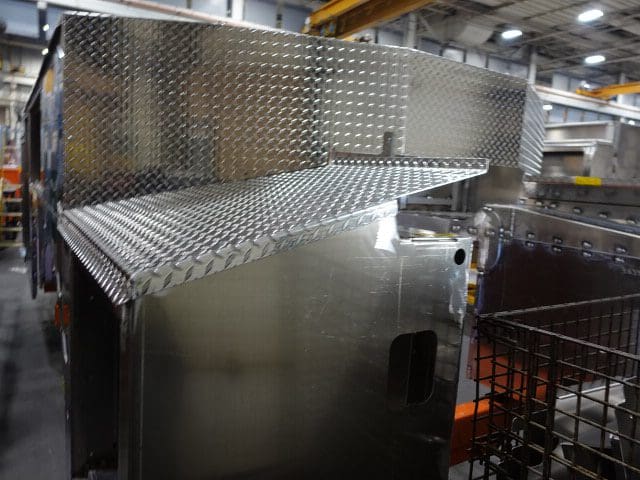

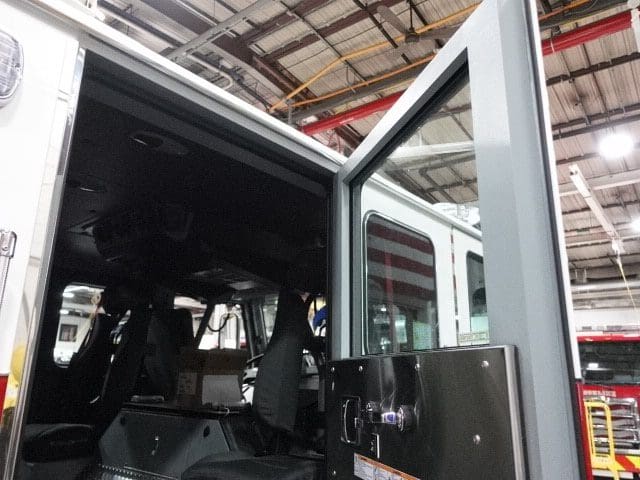

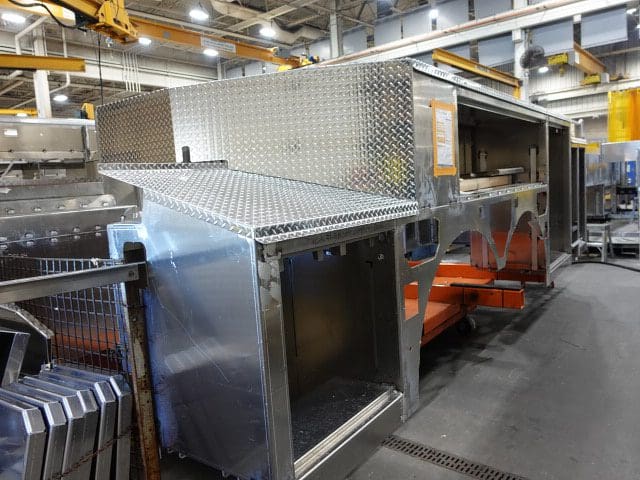

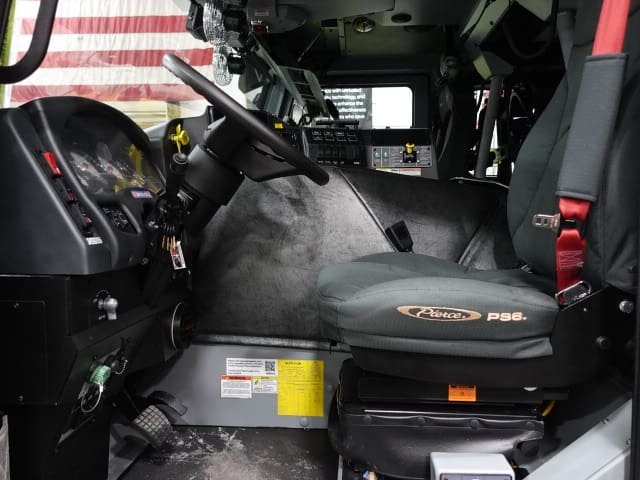

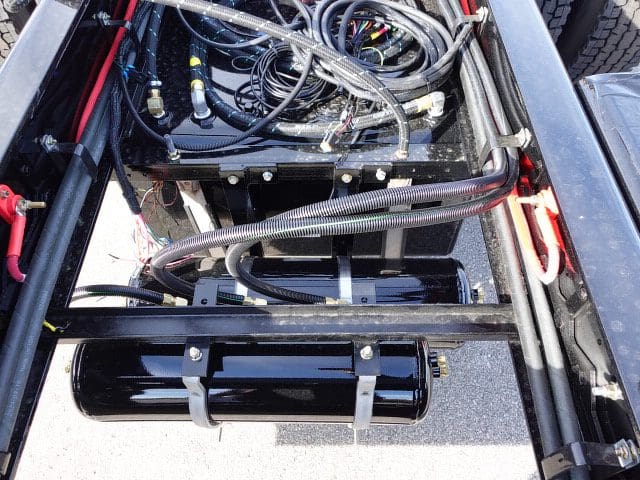

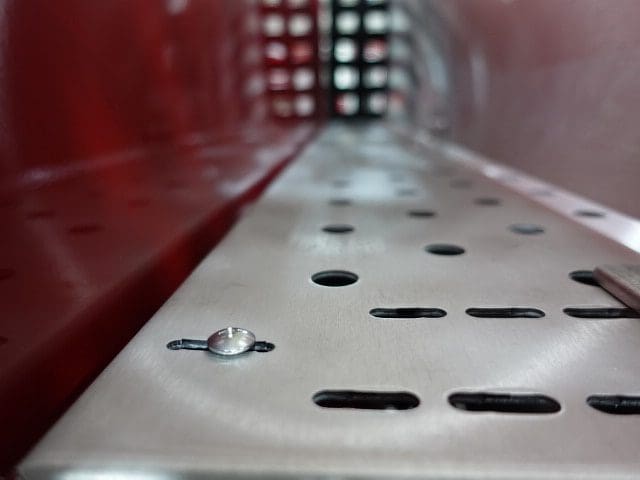

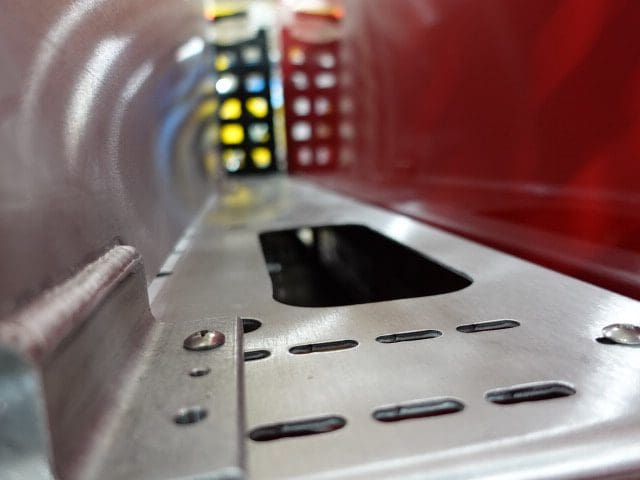

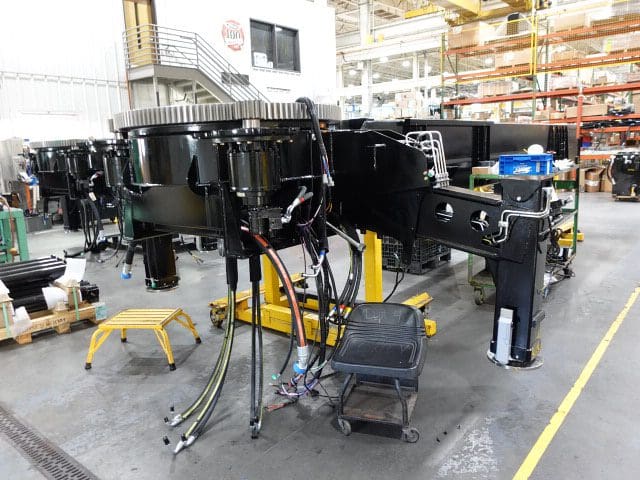

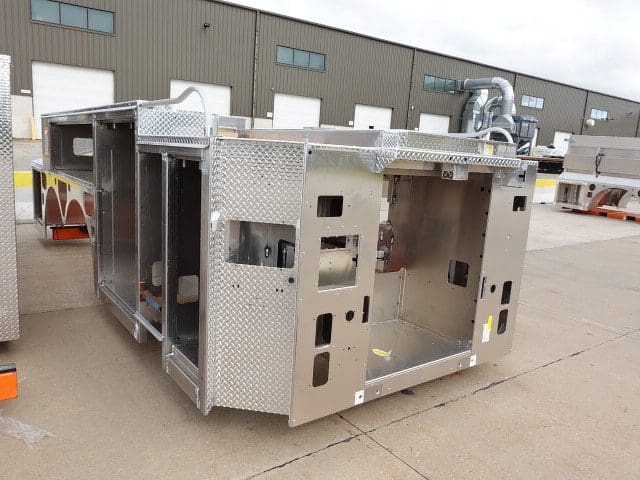

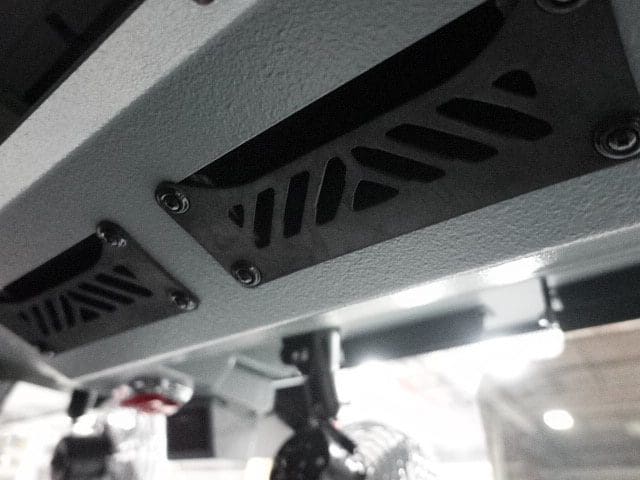

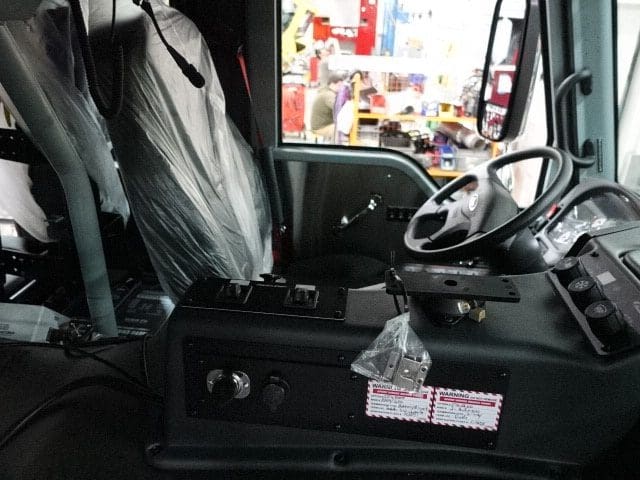

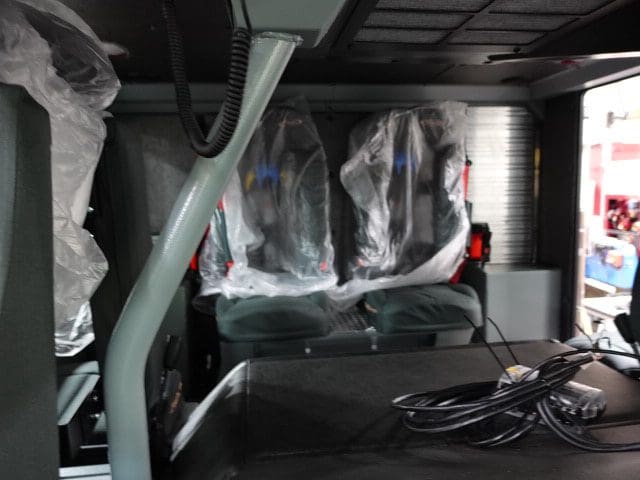

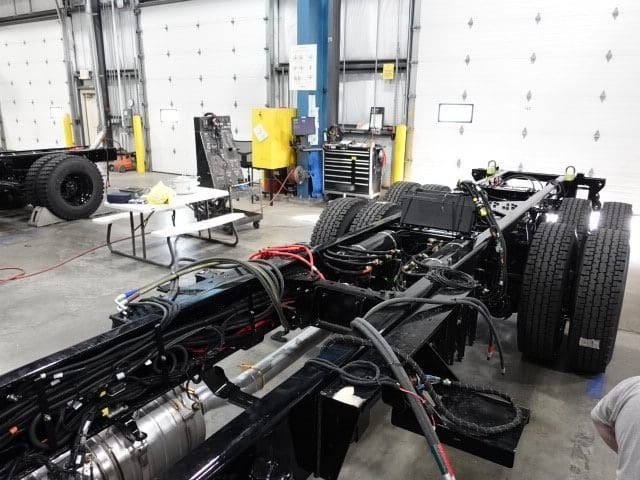

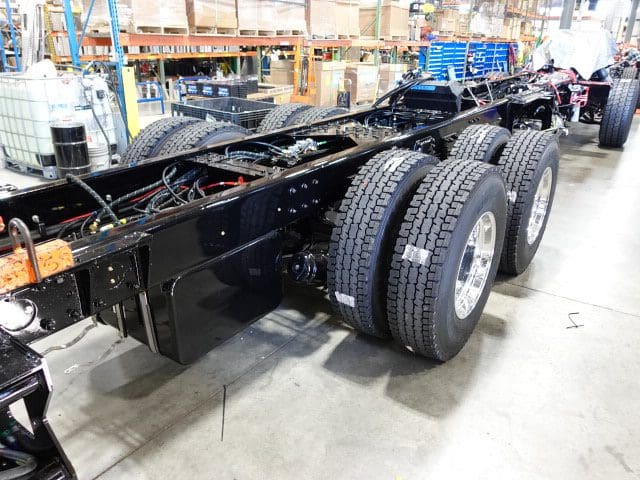

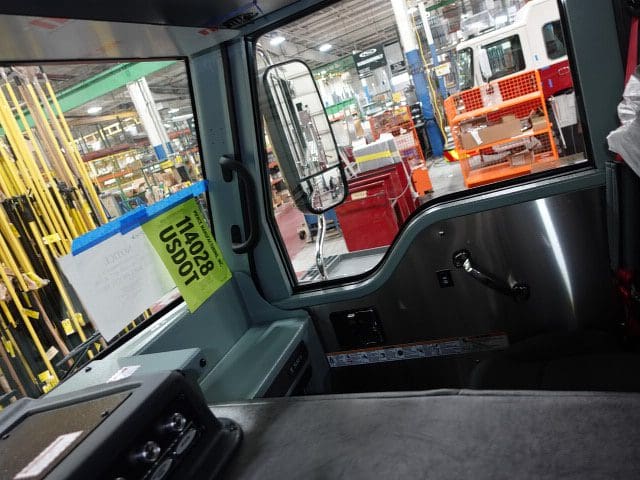

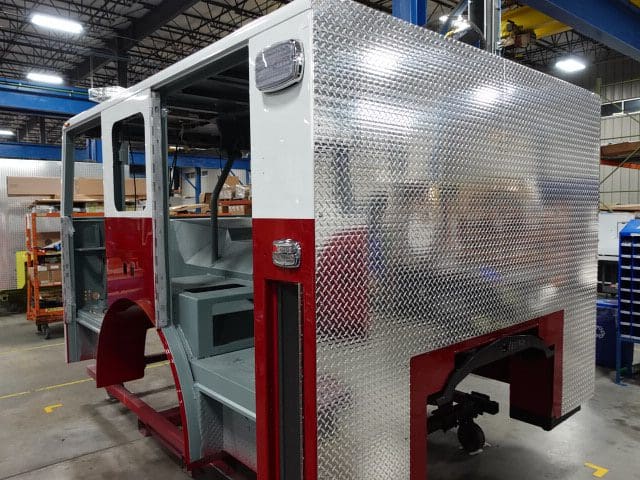

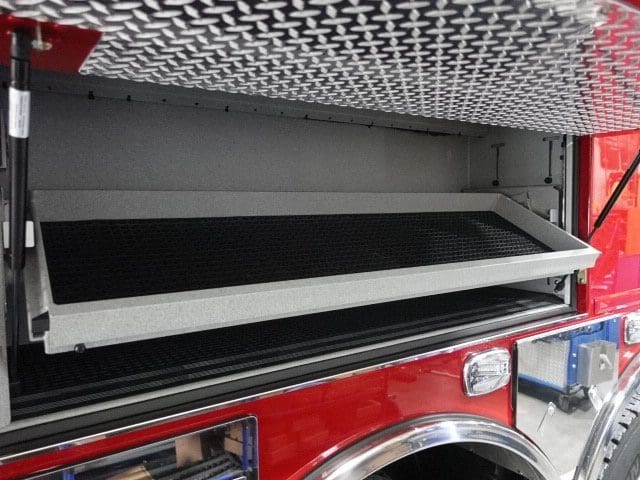

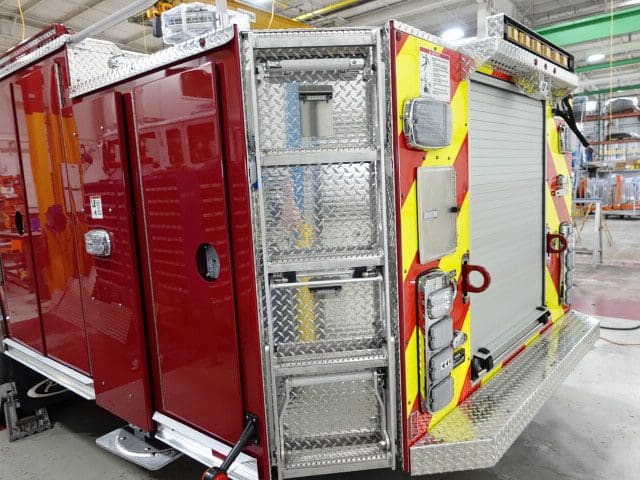

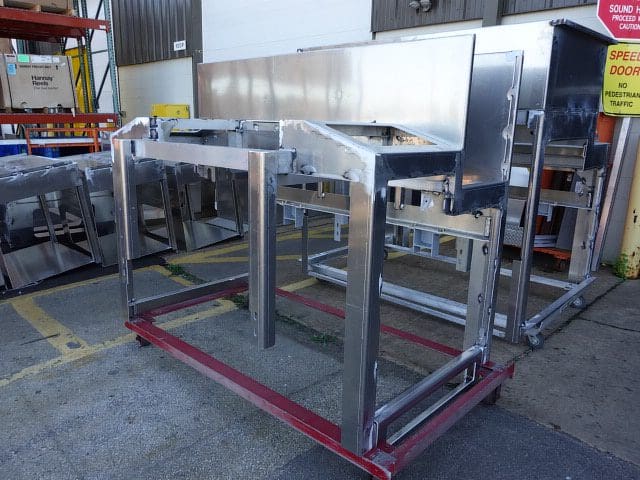

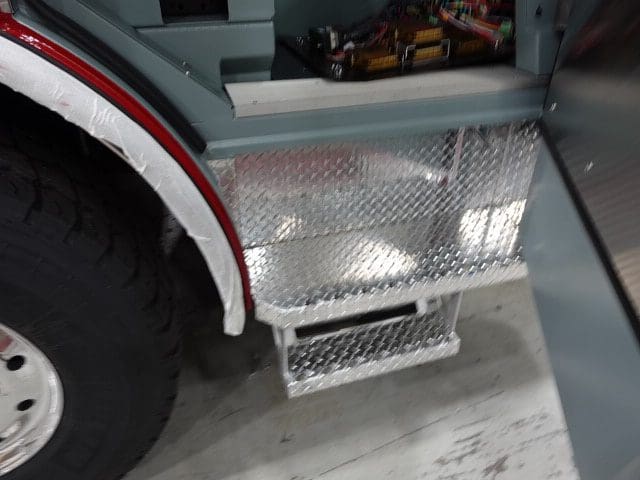

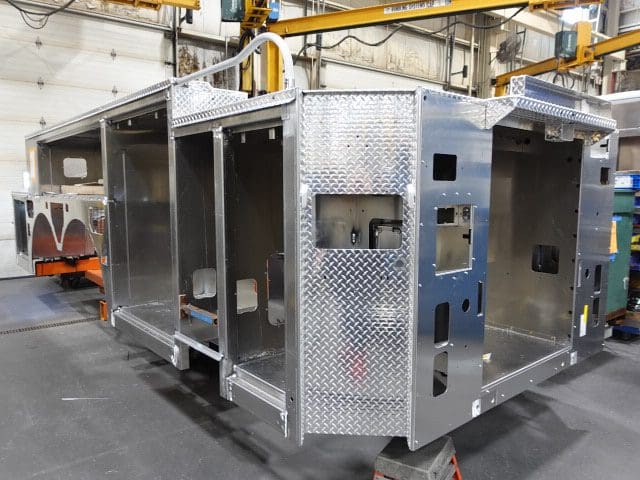

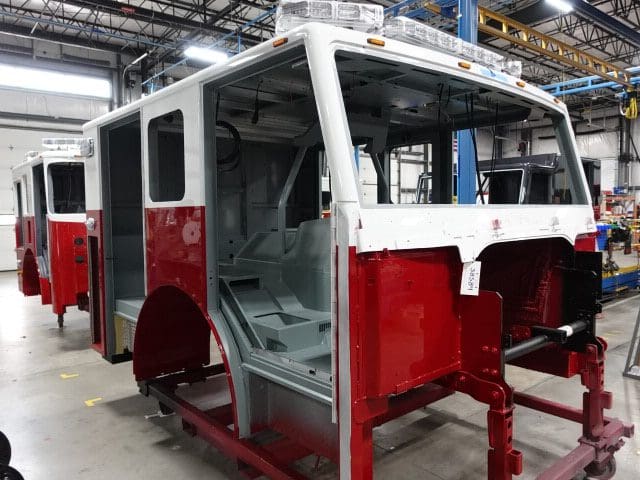

In this report, the body modules were installed on the body followed by the apparatus completing final assembly and release to initial testing.

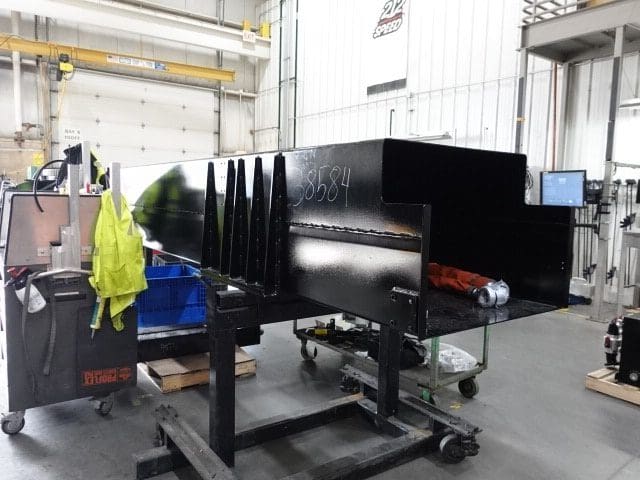

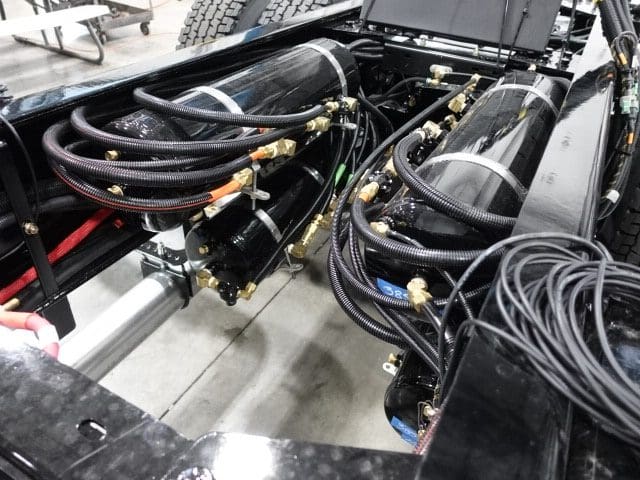

10-25-24

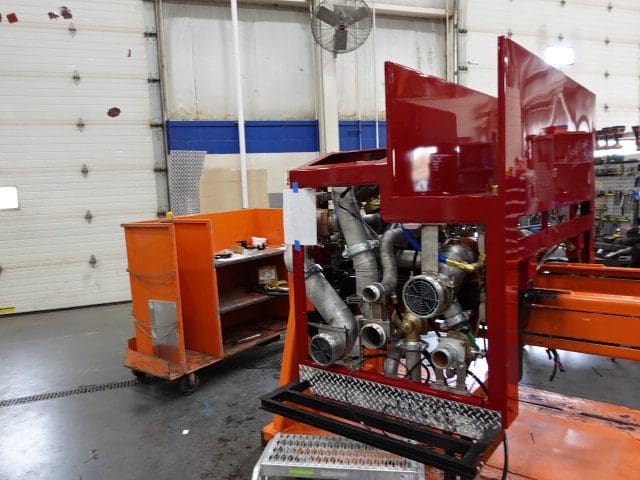

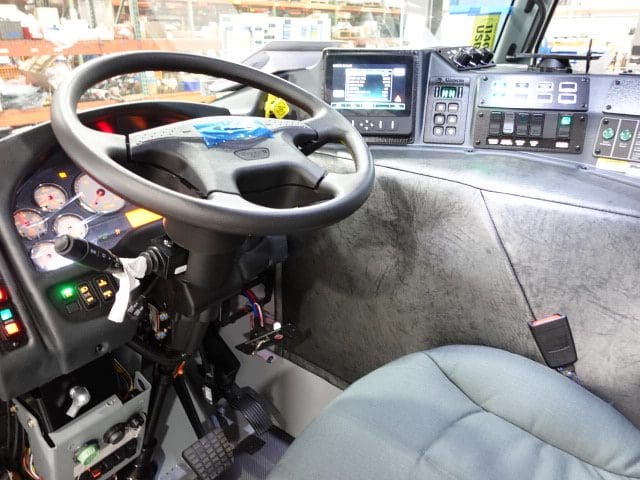

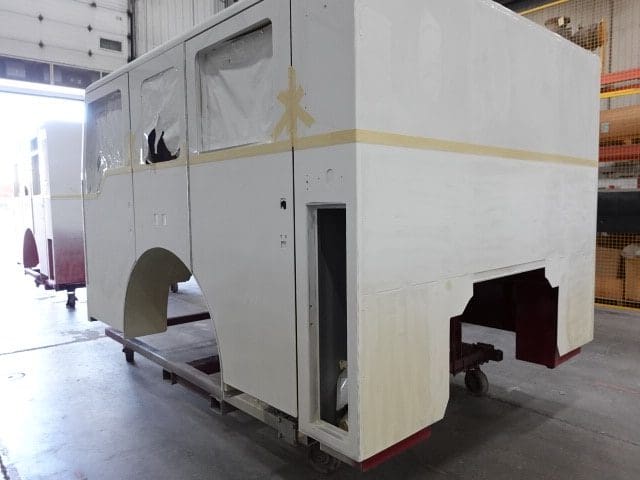

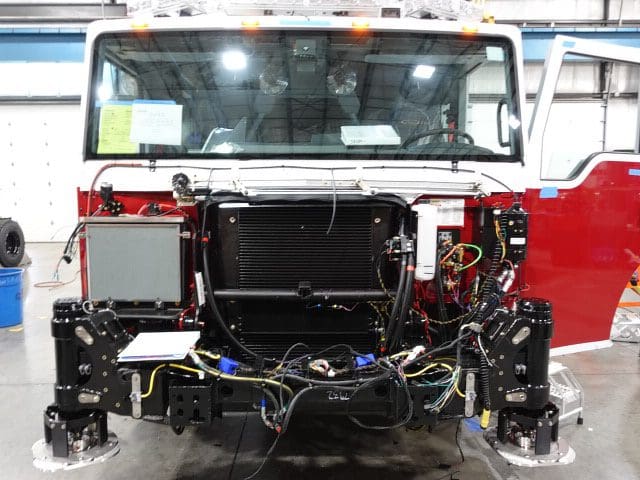

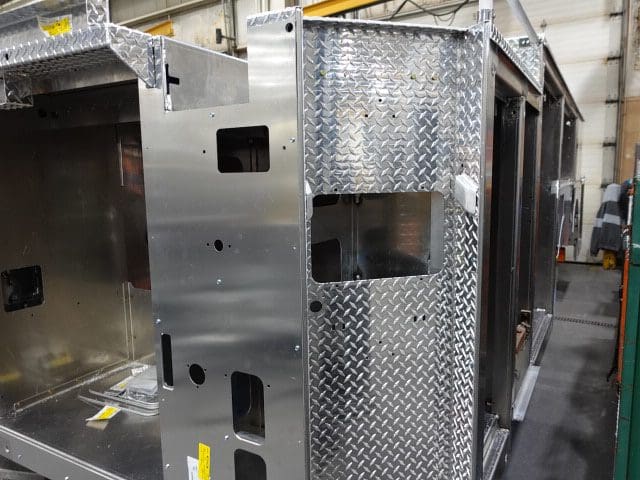

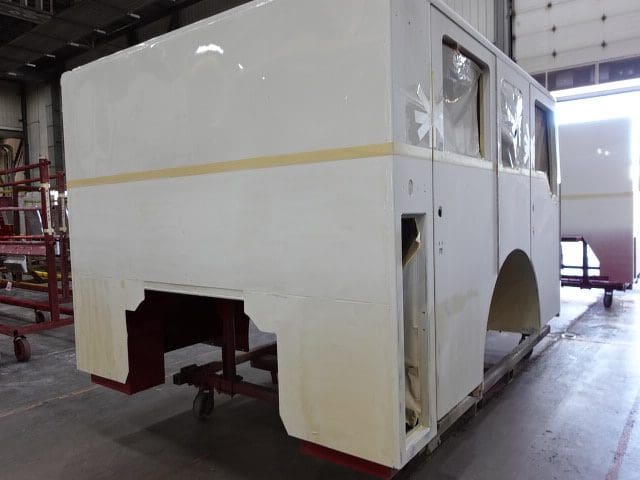

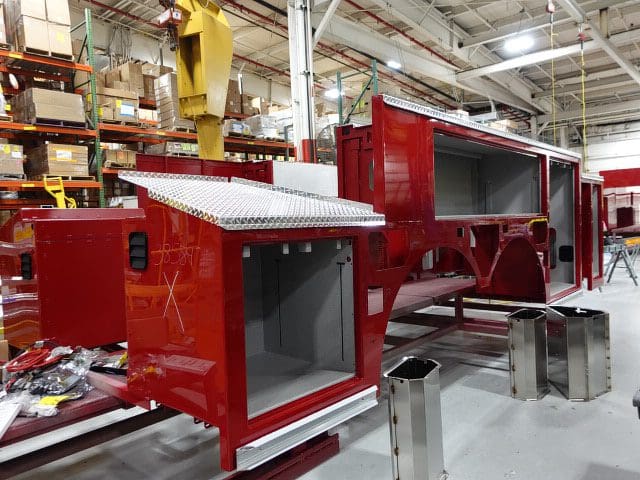

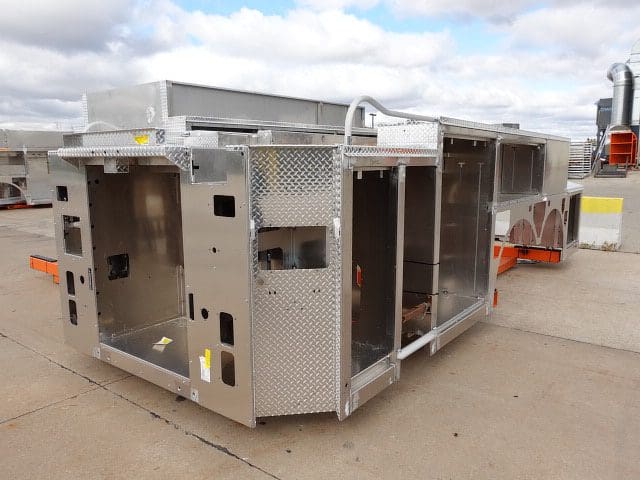

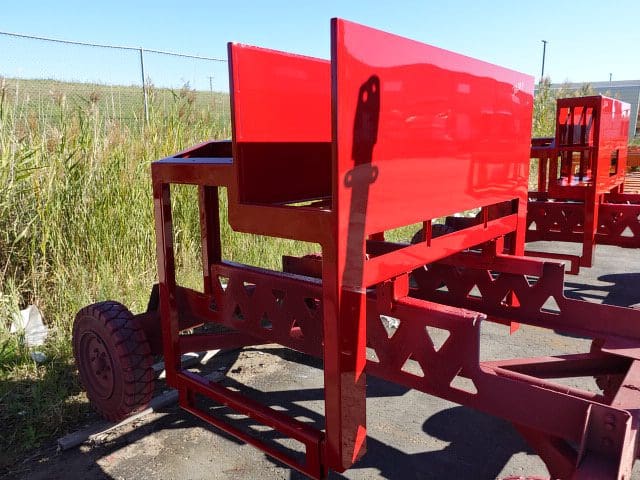

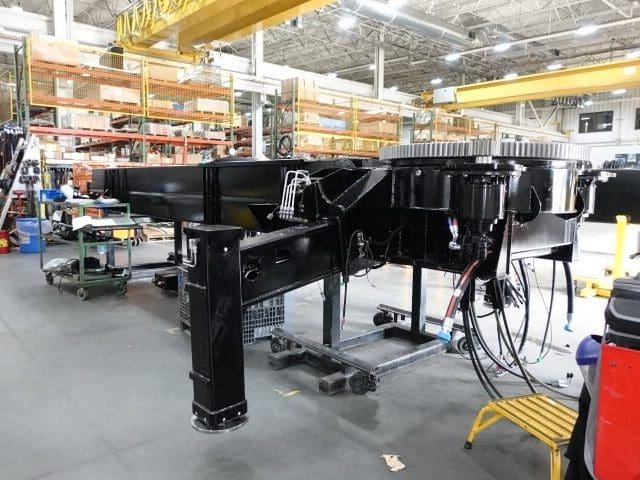

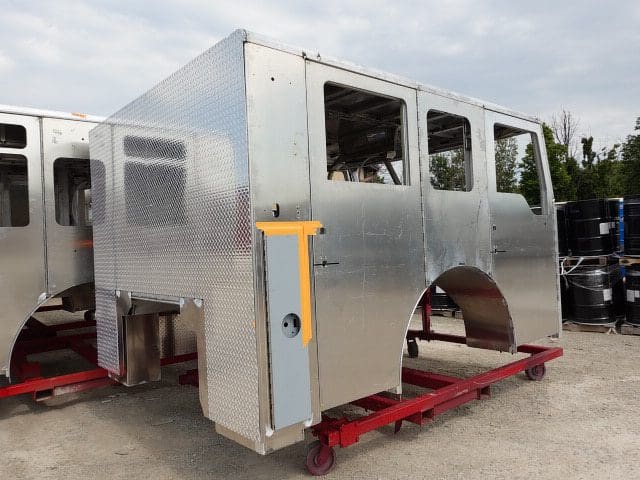

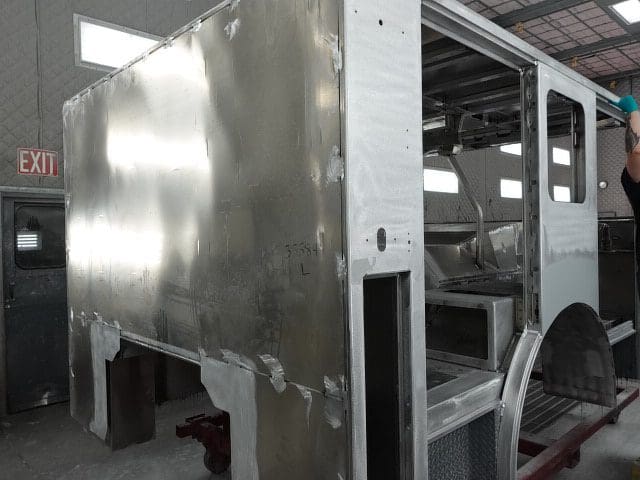

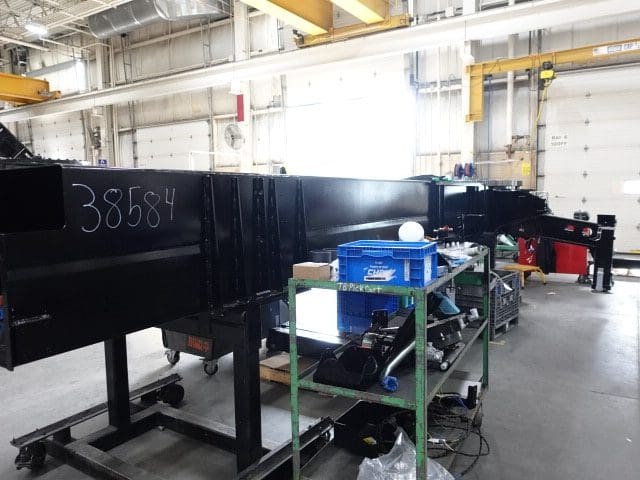

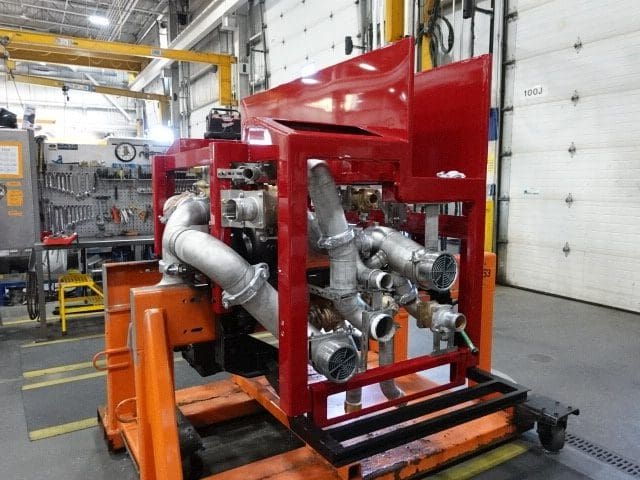

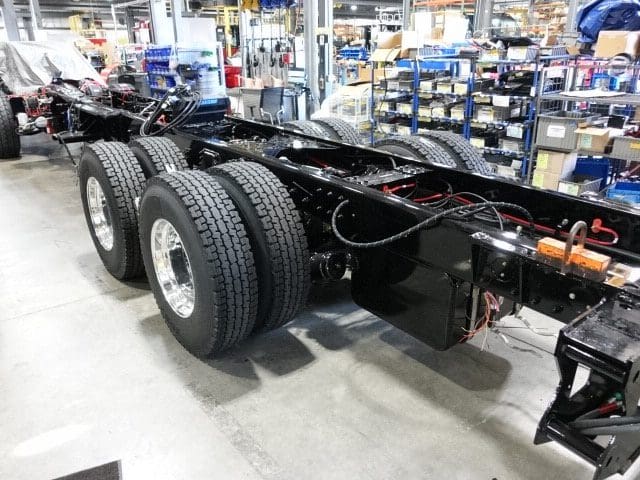

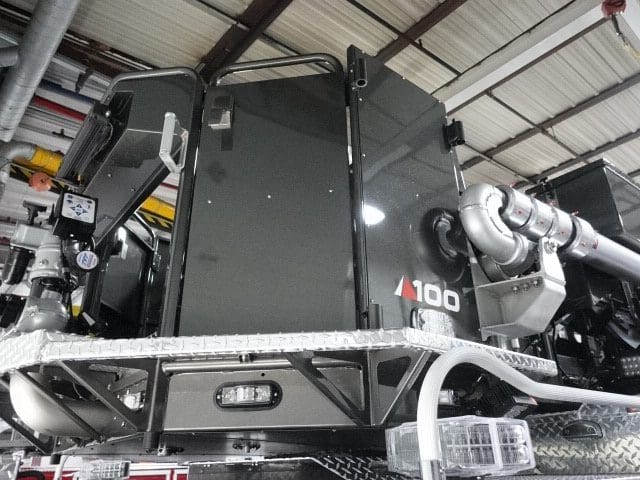

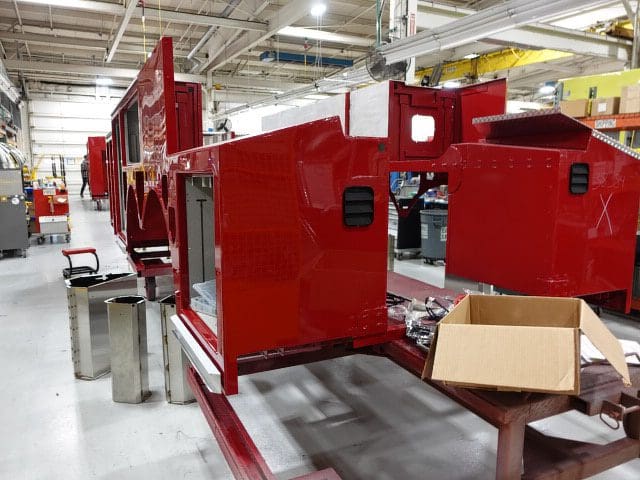

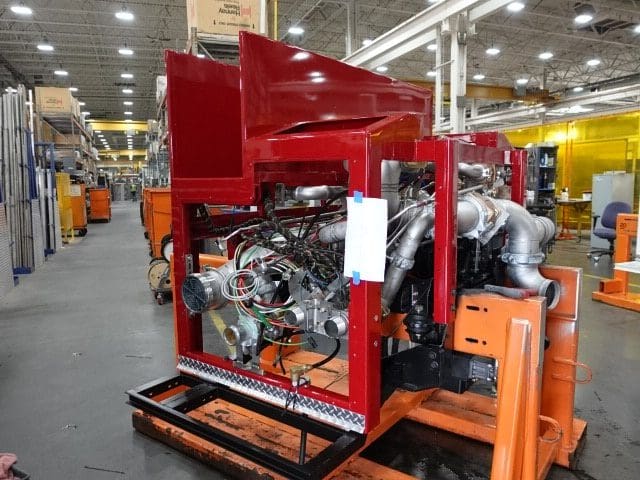

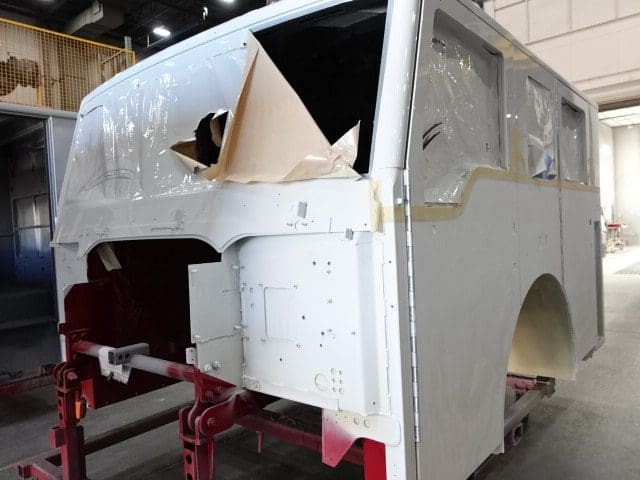

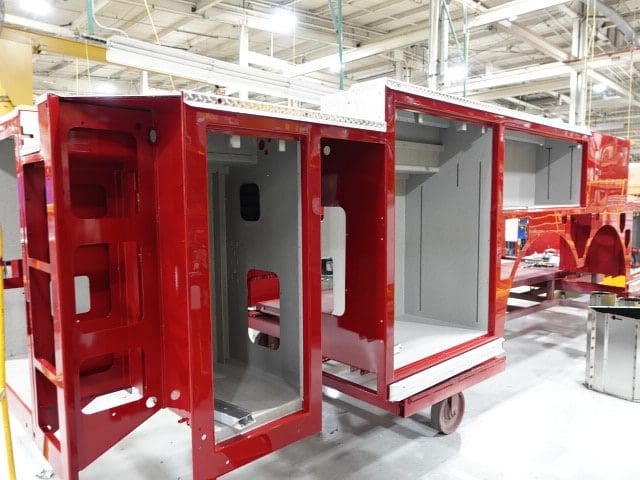

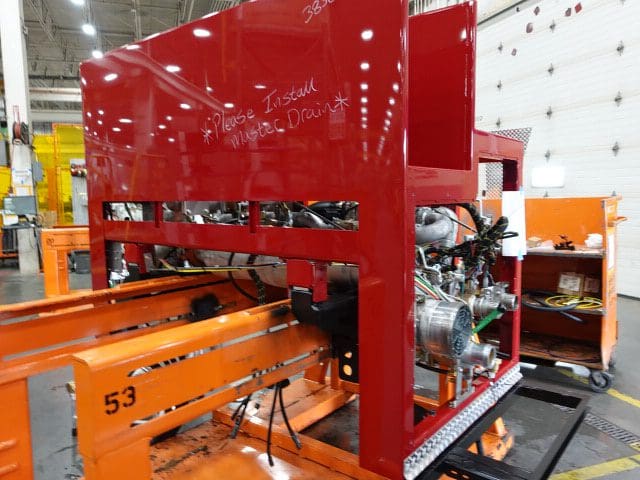

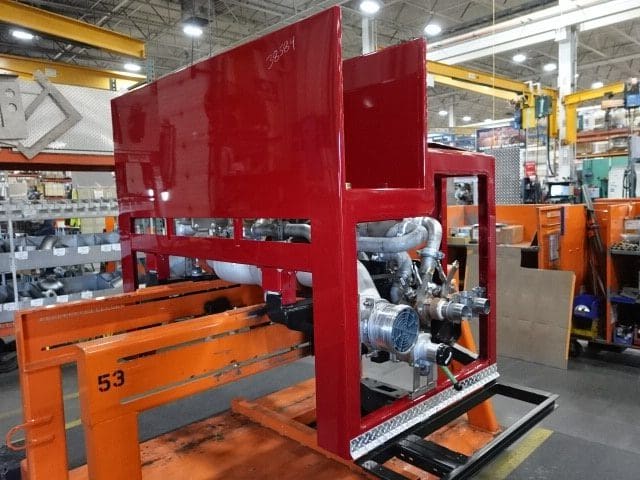

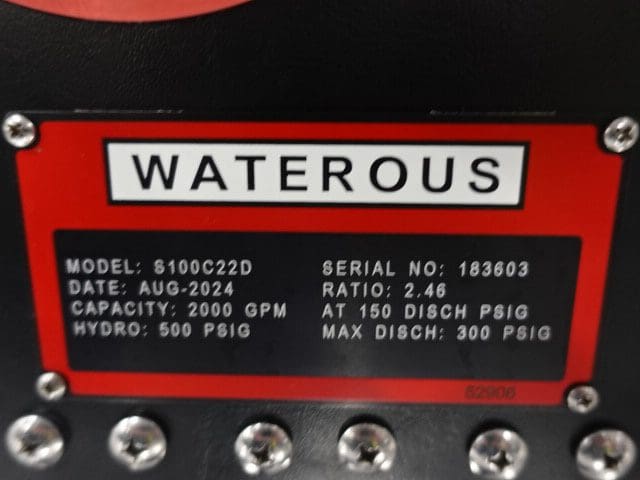

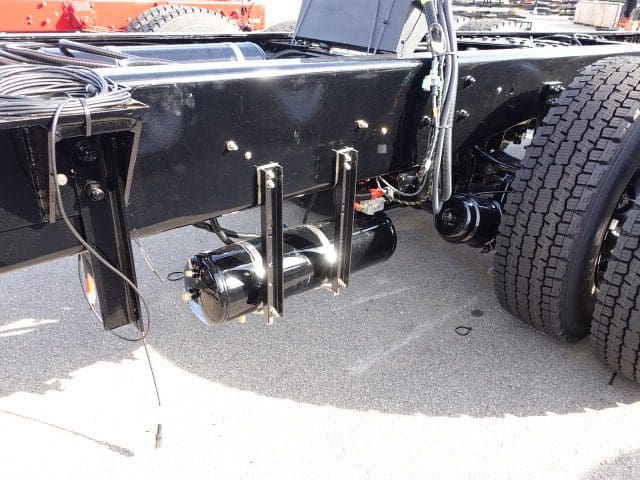

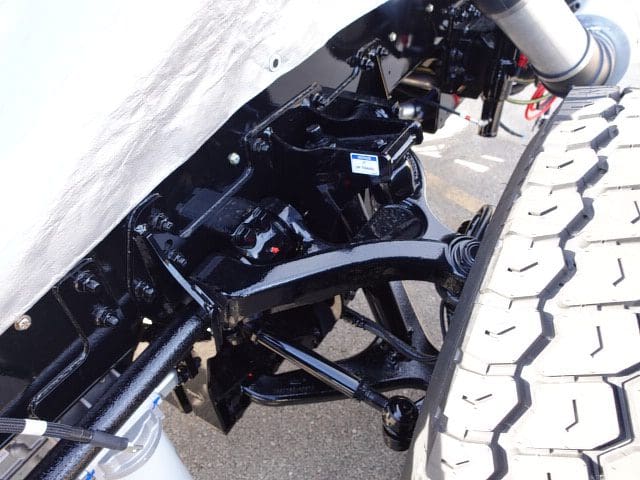

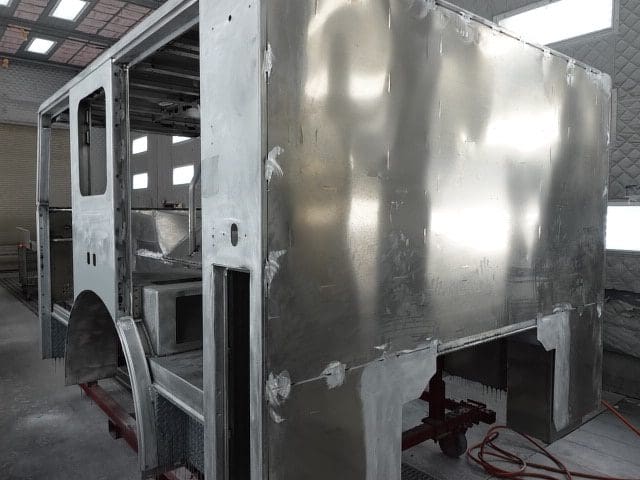

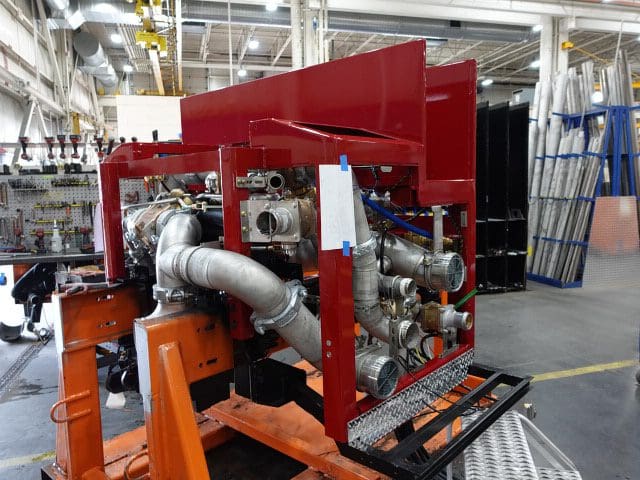

In this report, the cab completed initial assembly and was installed on the frame, the pump house and torque box continued initial assembly, the front body module began fabrication, and the rear body completed the paint process and began initial assembly.

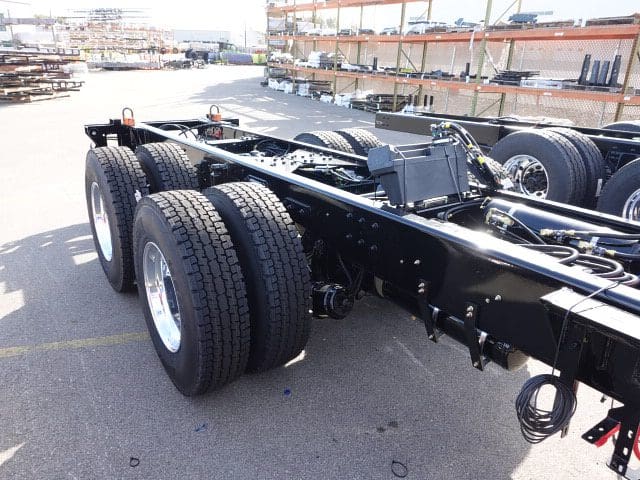

10-18-24

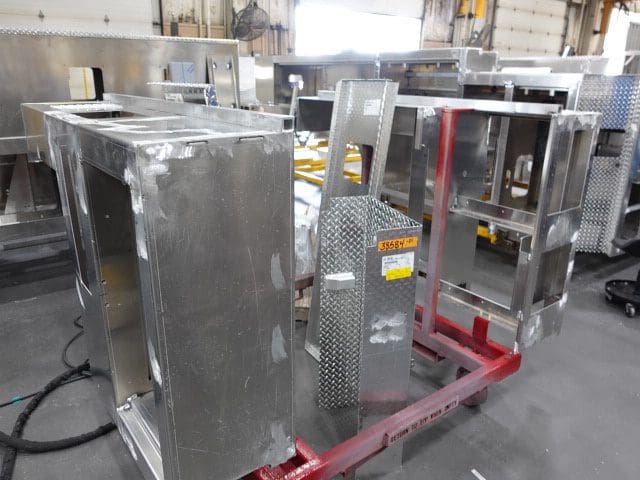

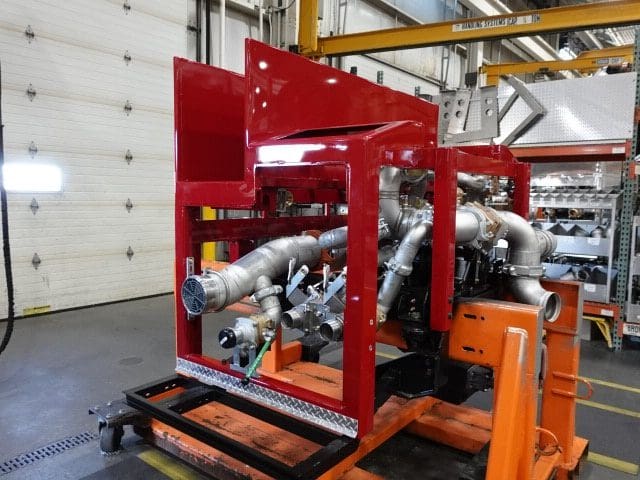

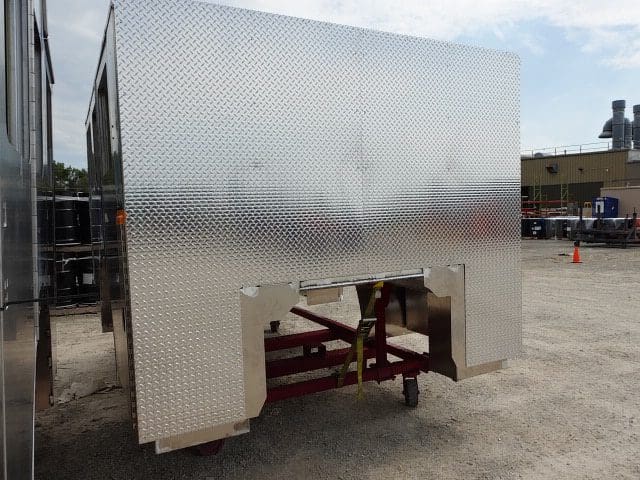

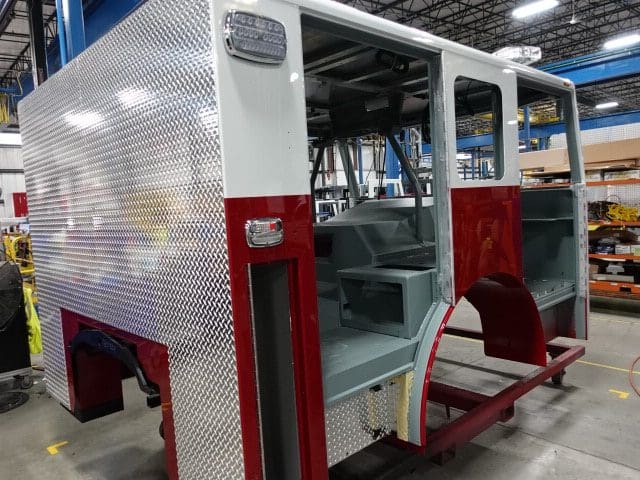

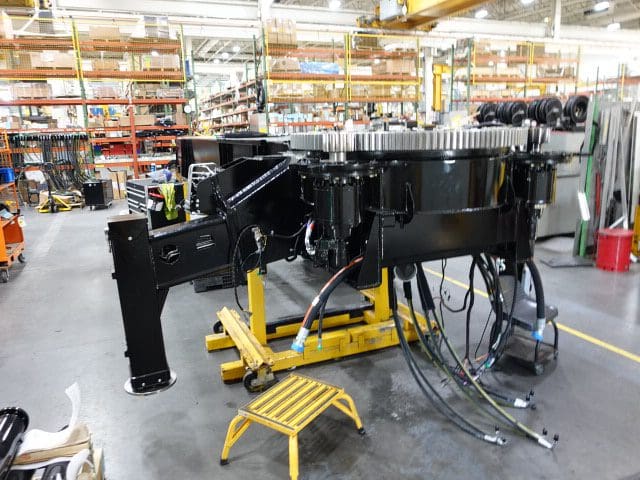

In this report, the cab continued initial assembly, the frame build continued, and the pump house began initial assembly, the torque box began initial assembly, and the rear body completed fabrication.
10-11-24
In this report, the cab began initial assembly, the frame build continued, and the pump house was painted and staged, and the rear body began fabrication.

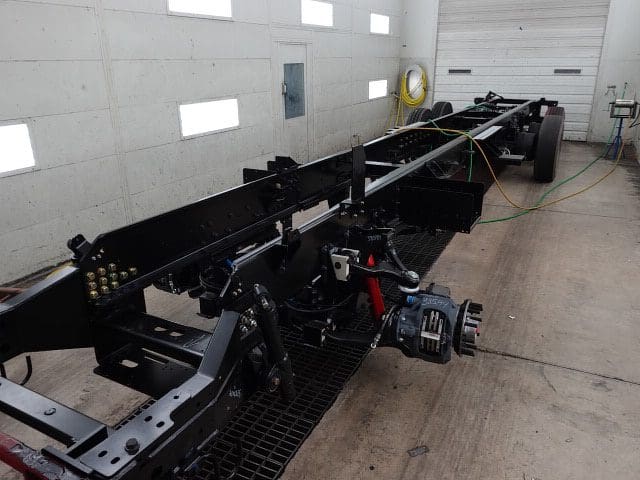

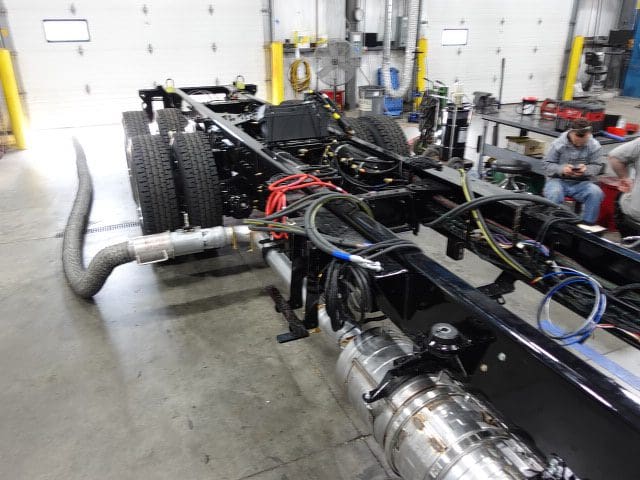

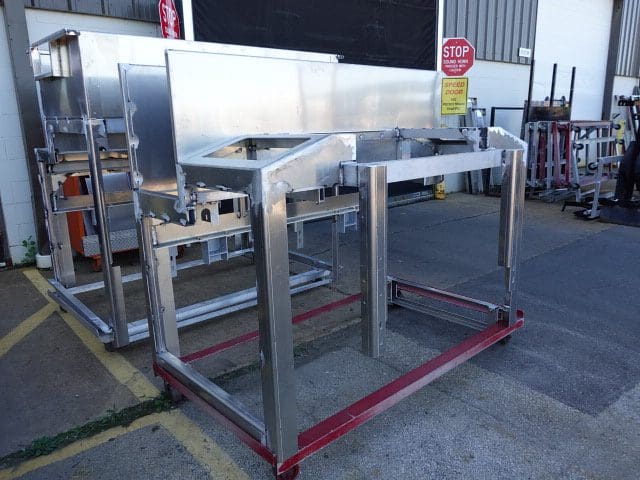

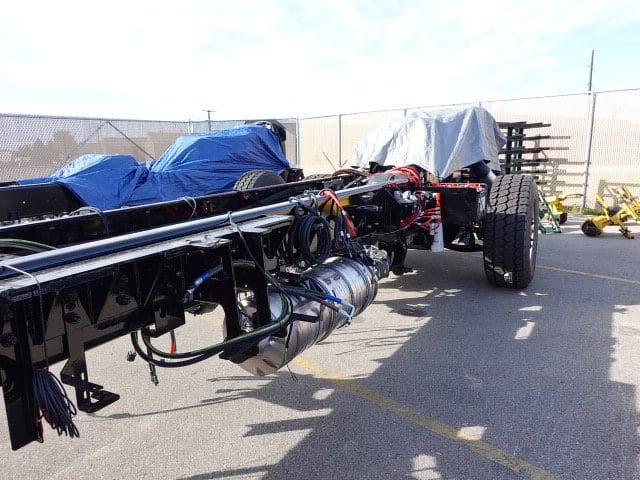

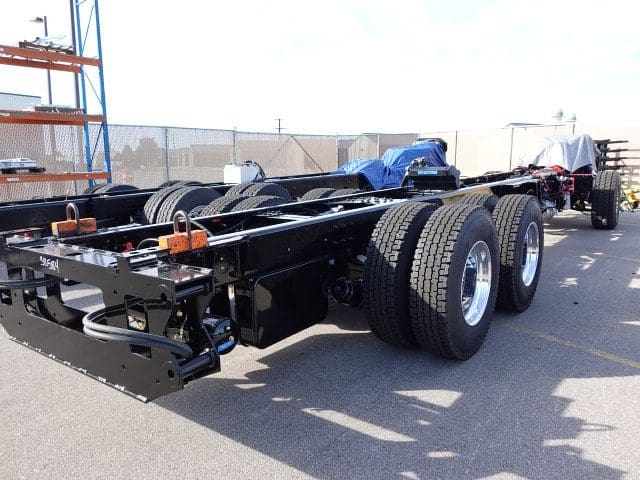

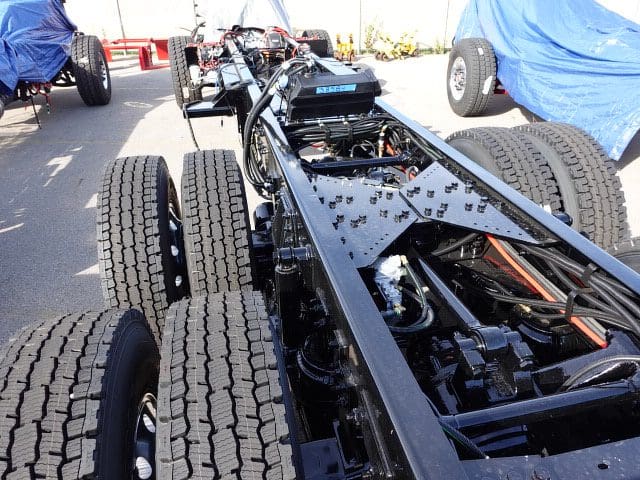

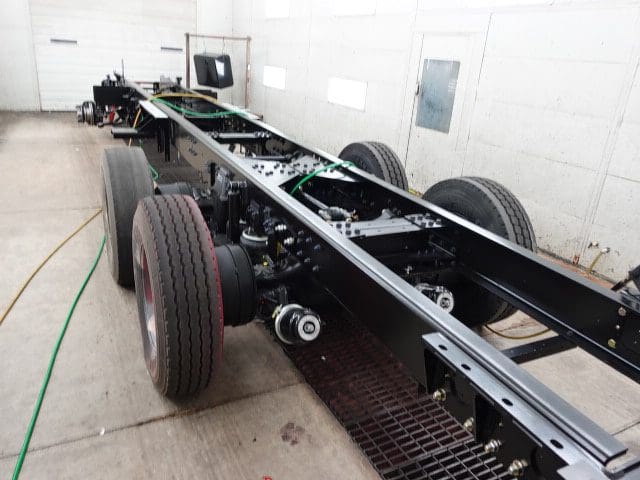

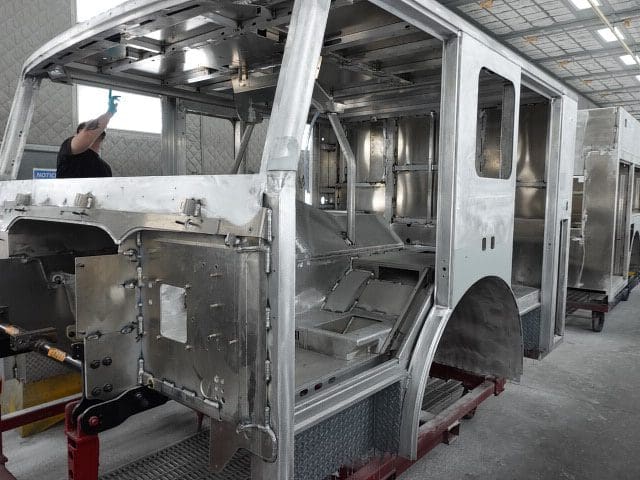

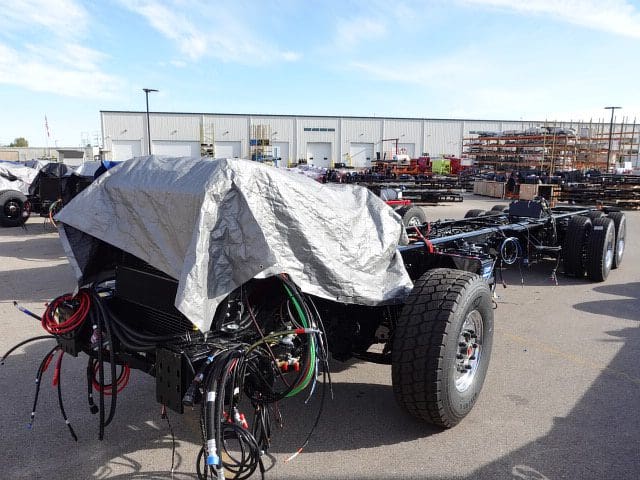

10-04-24

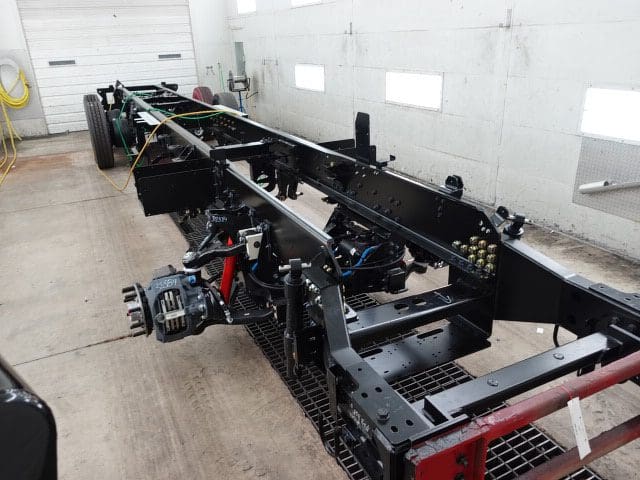

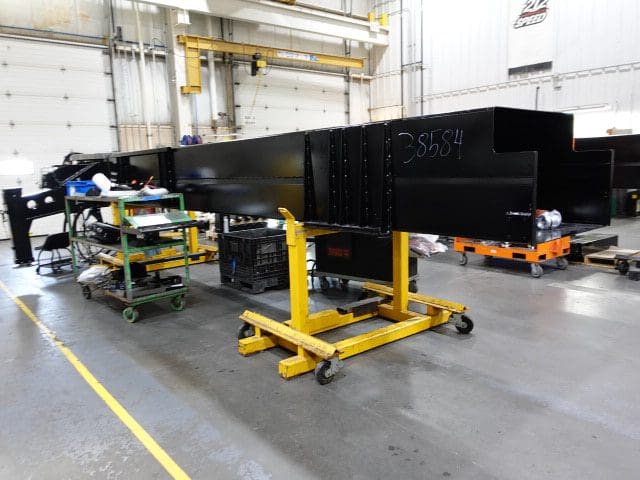

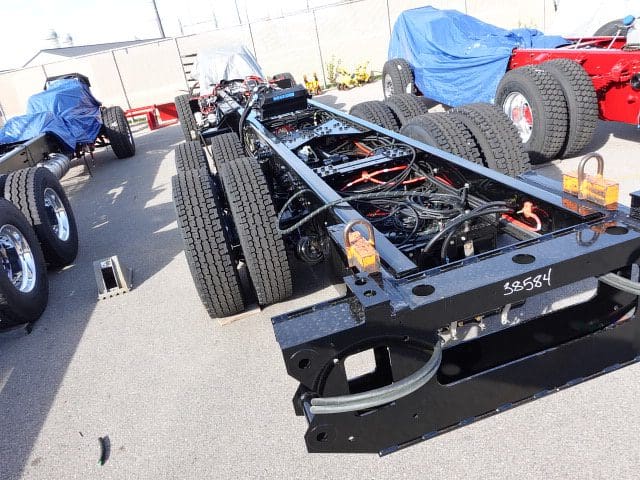

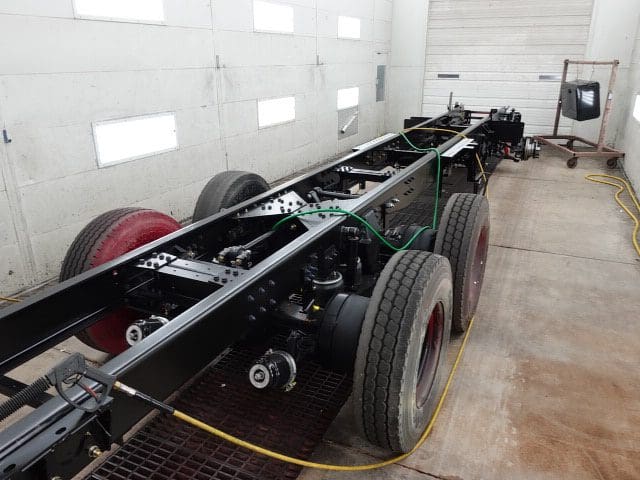

In this report, the cab was offsite having protective coating applied (no photos), the frame build began, and the pump house structure was fabricated.

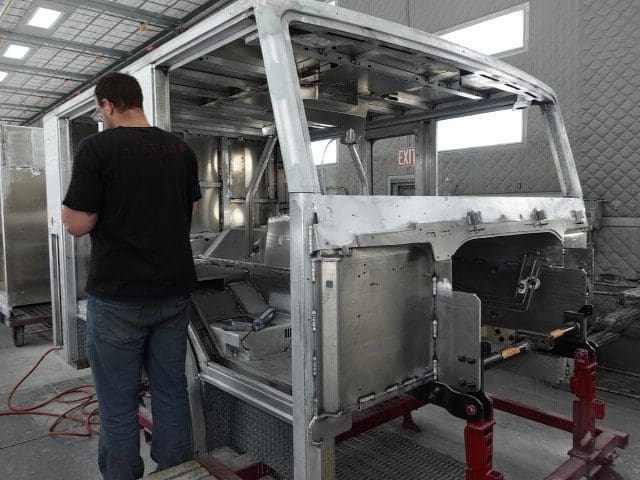

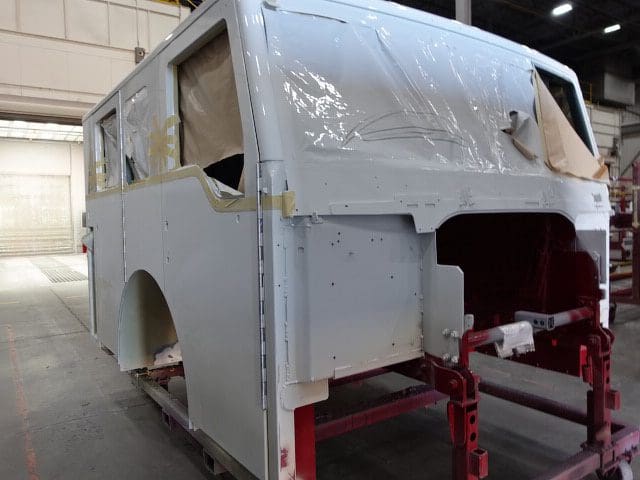

09-13-24

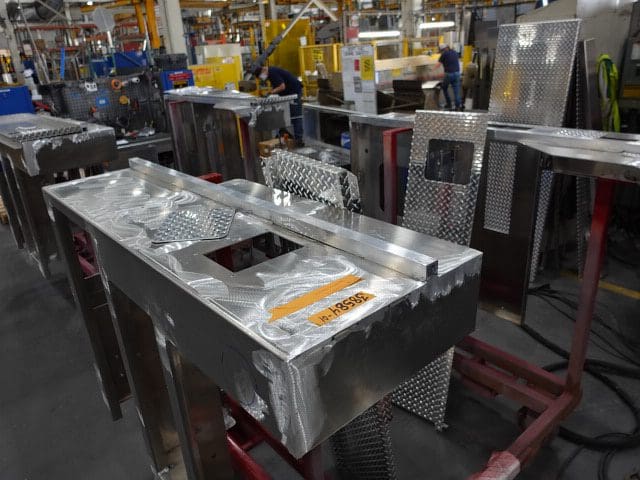

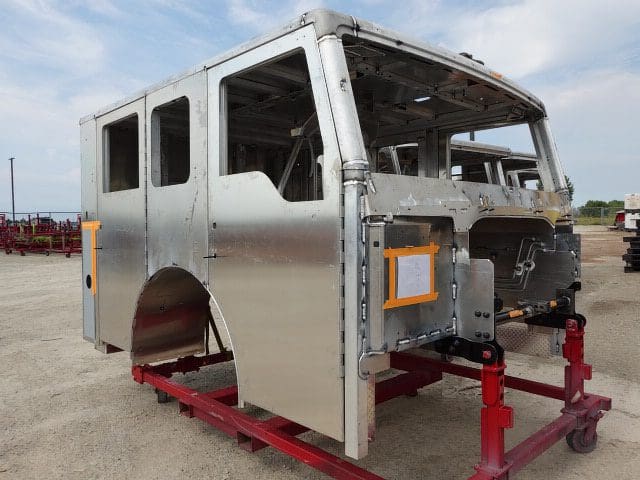

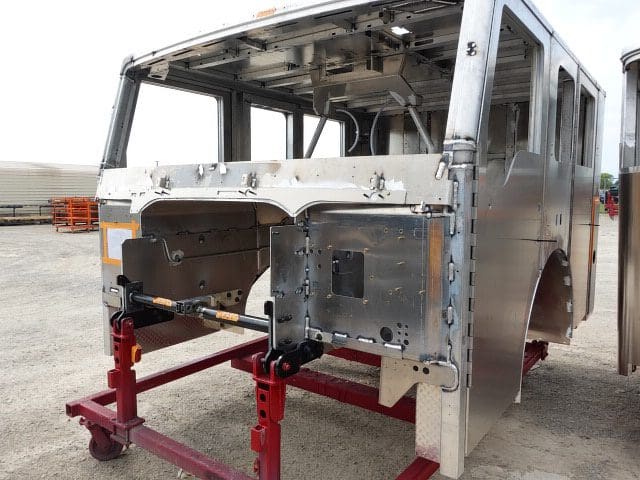

This new Pierce apparatus is now in production! In this report, the cab was fabricated and staged.
