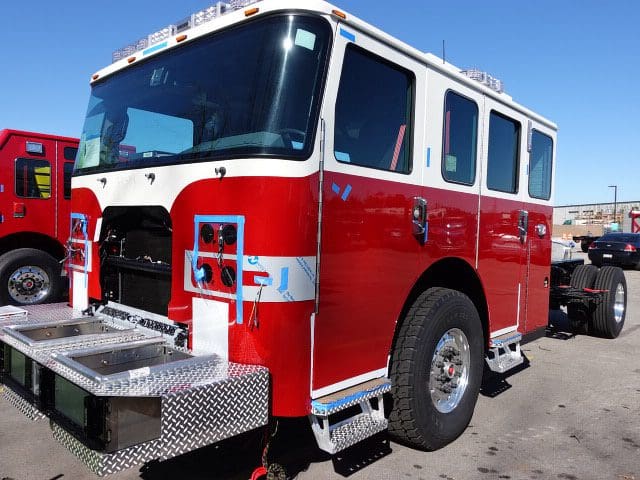

11-08-24

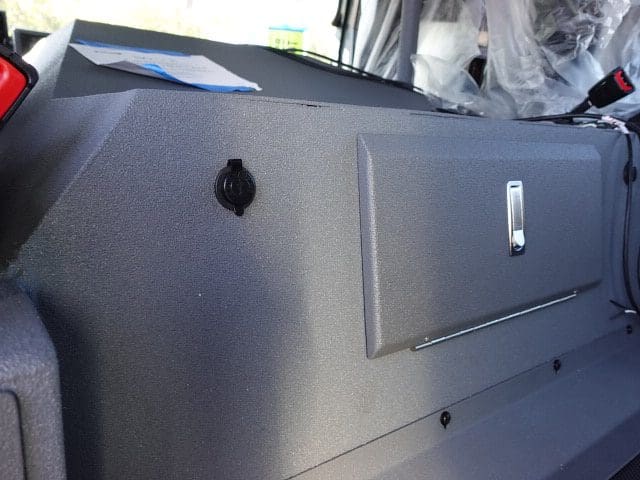

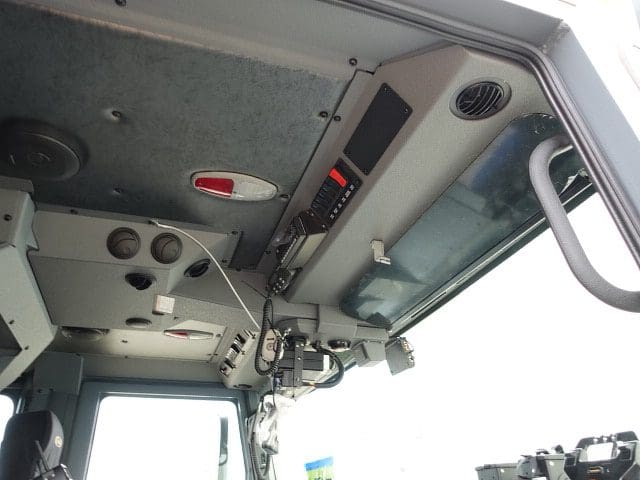

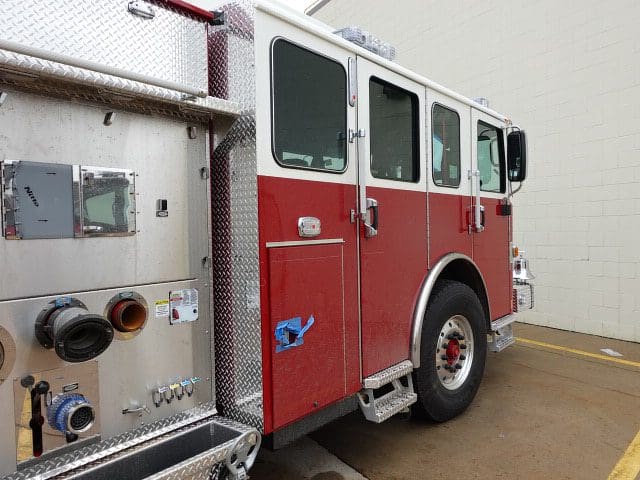

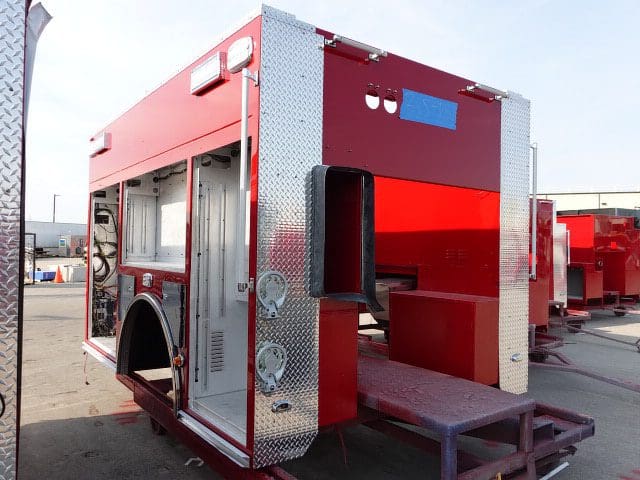

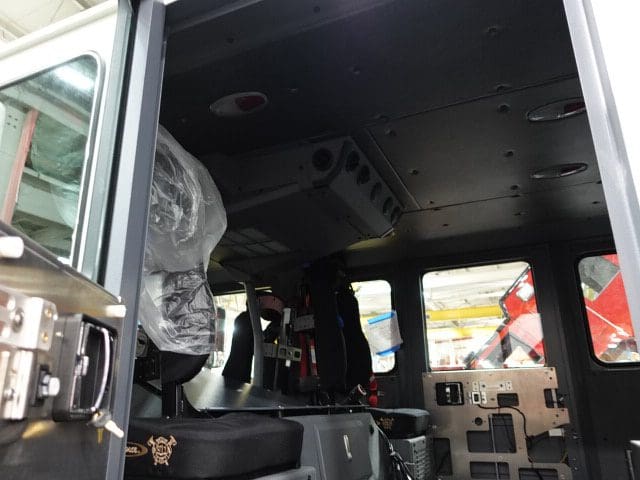

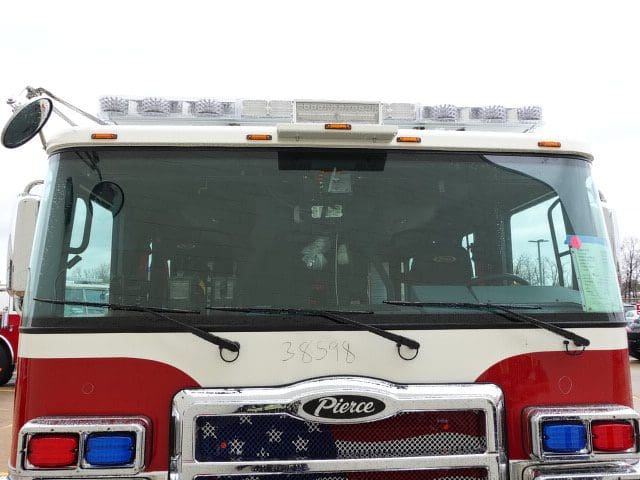

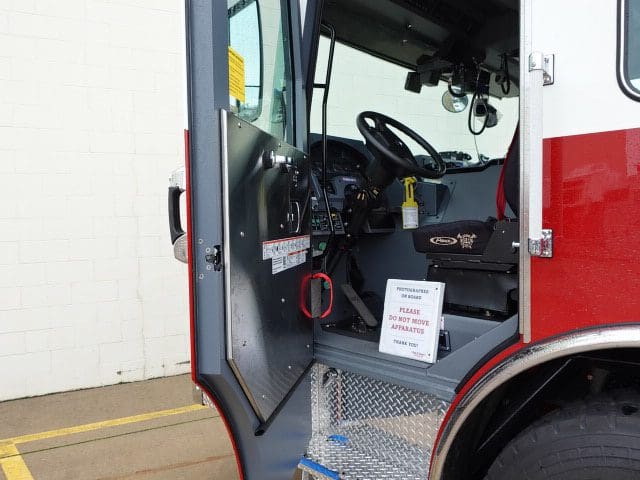

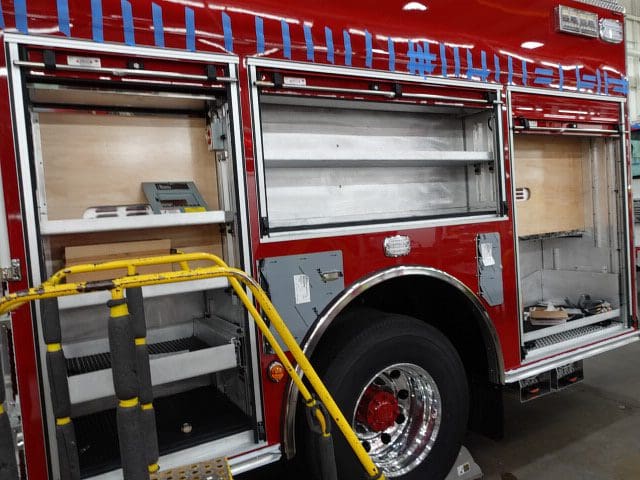

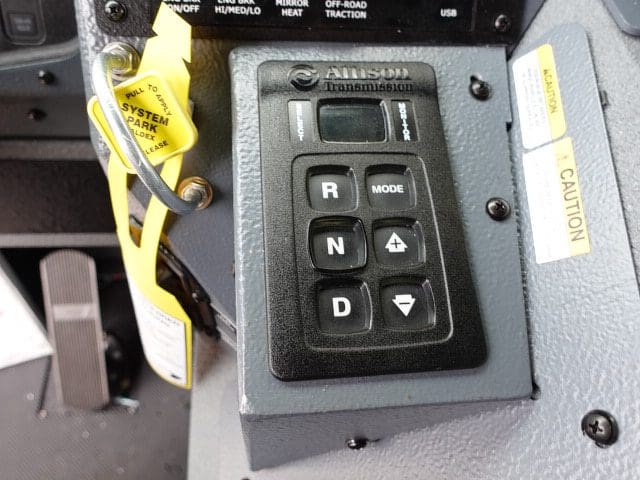

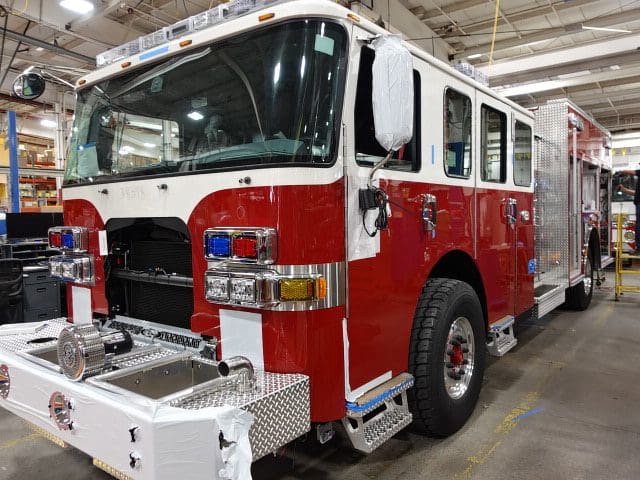

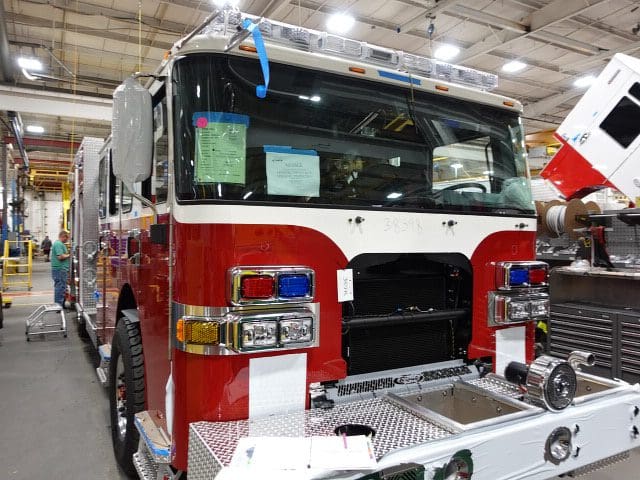

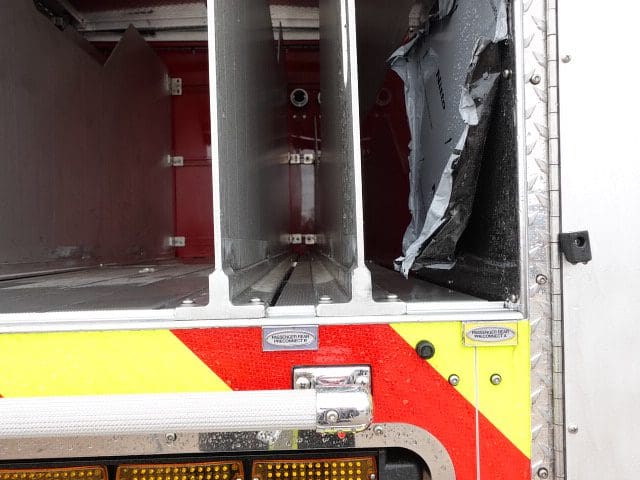

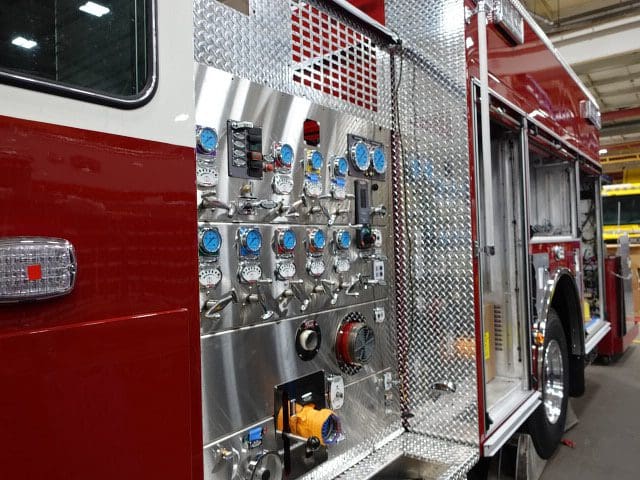

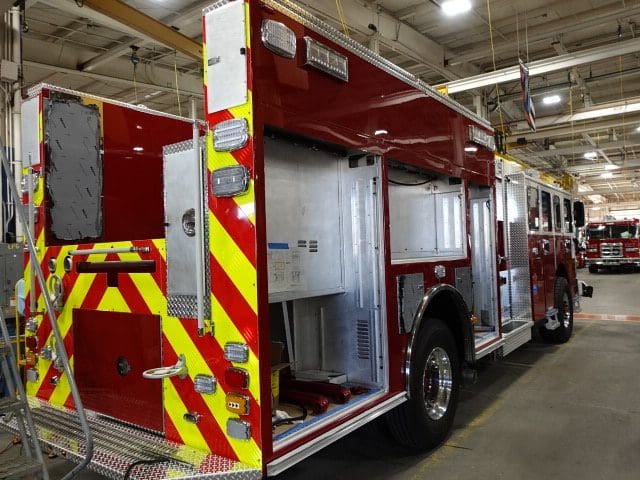

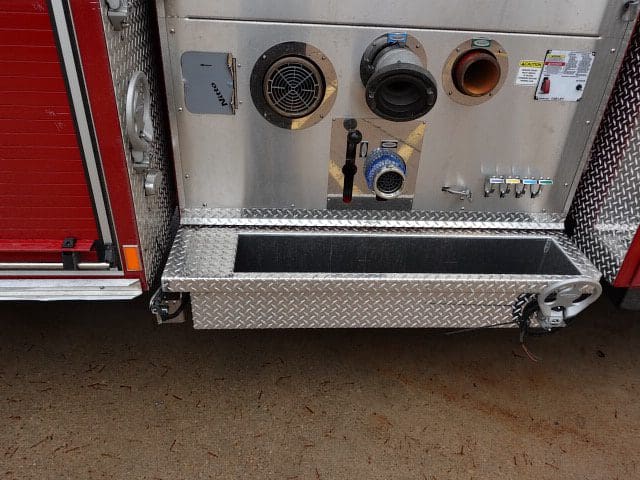

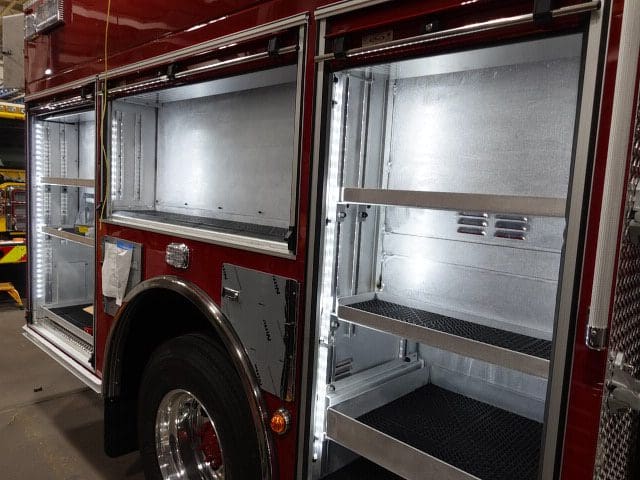

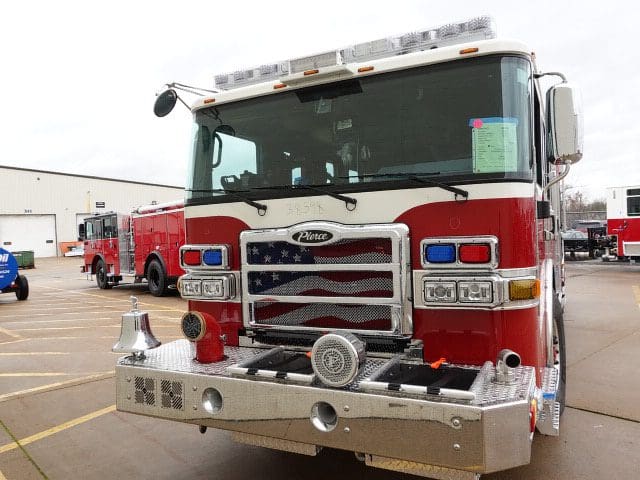

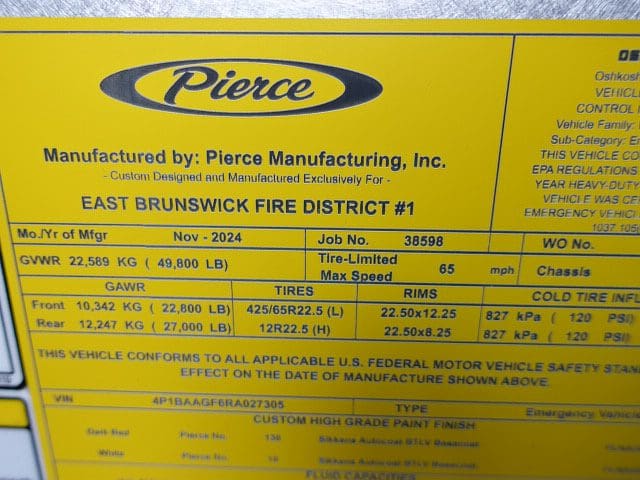

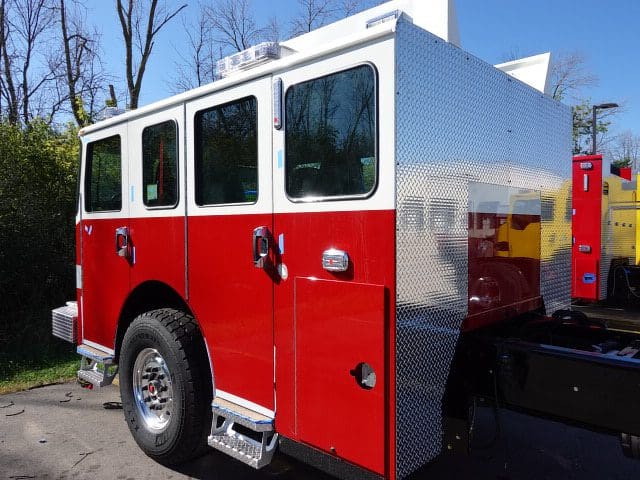

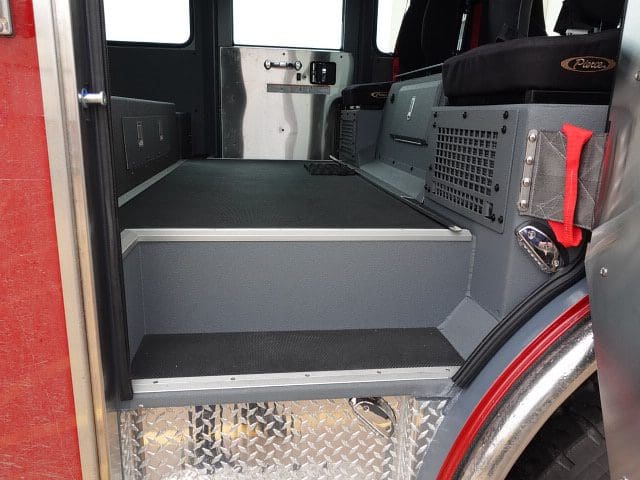

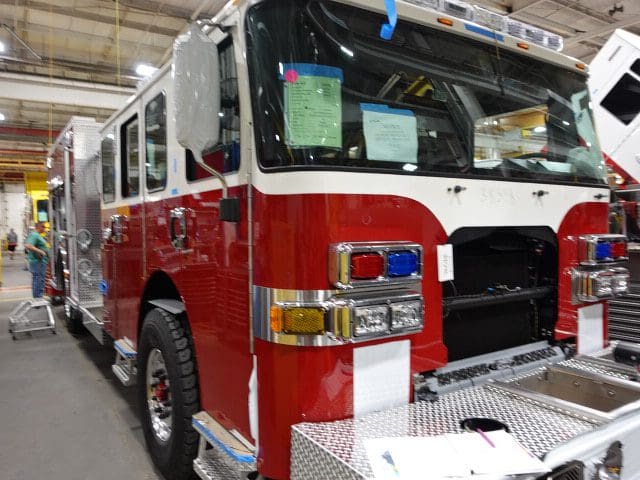

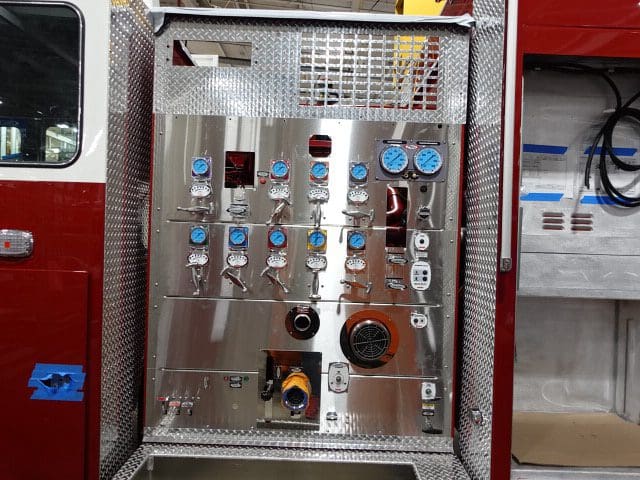

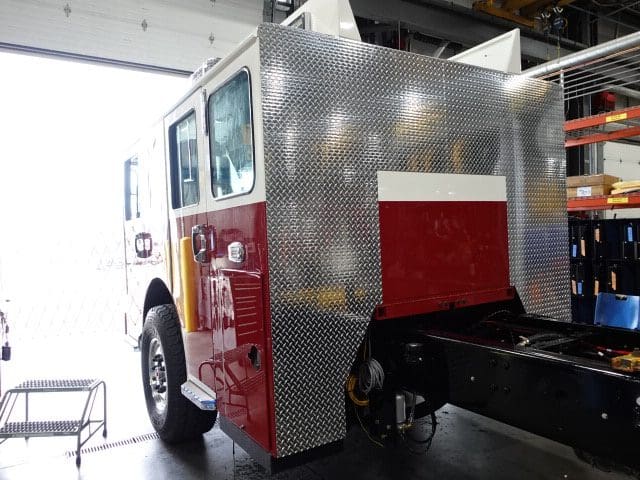

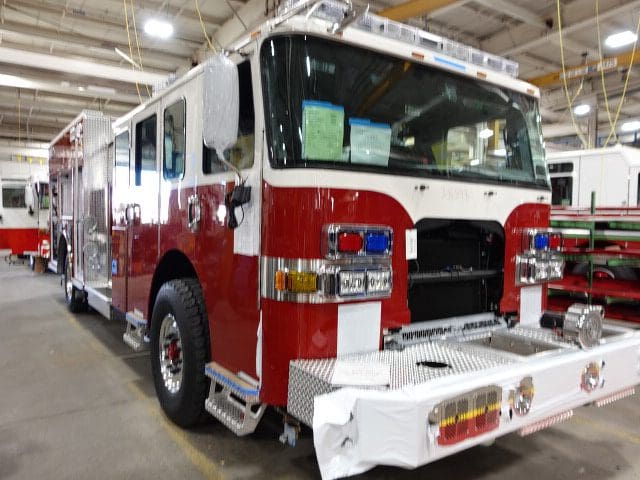

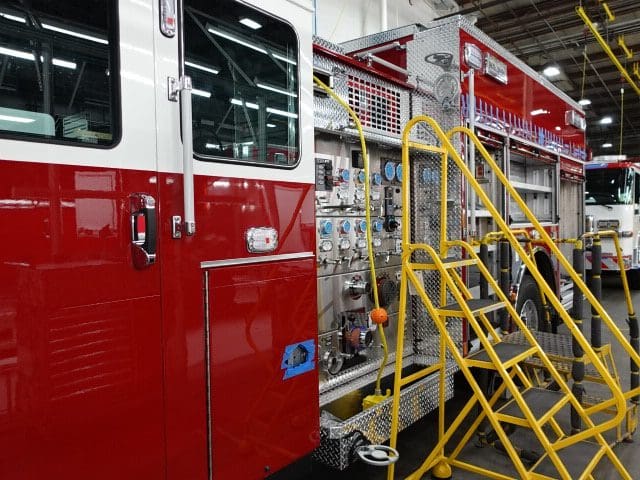

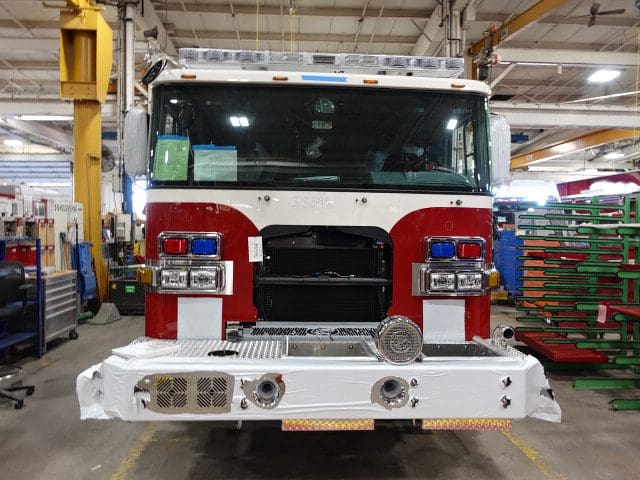

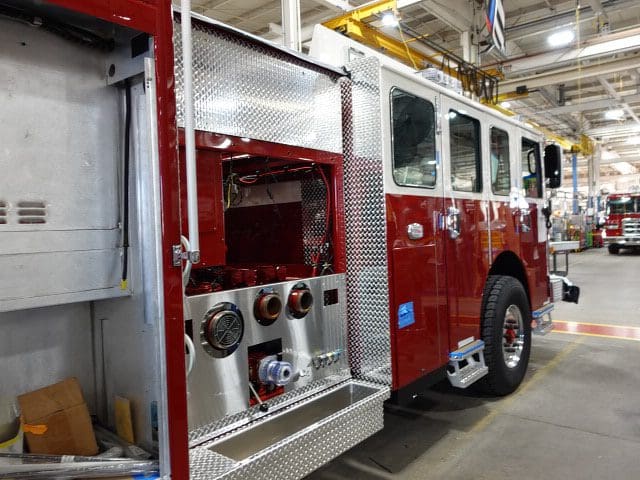

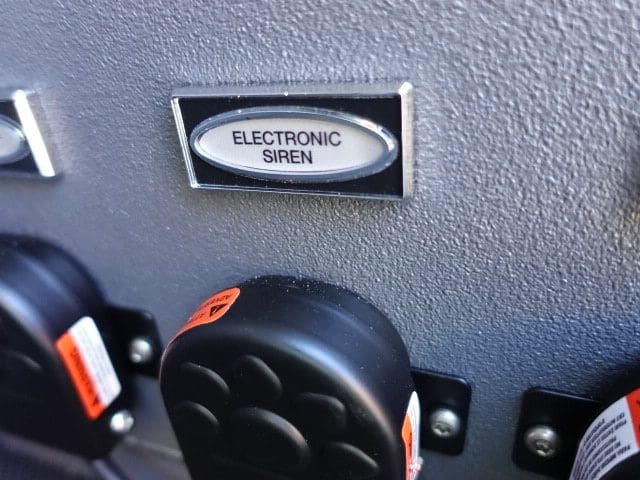

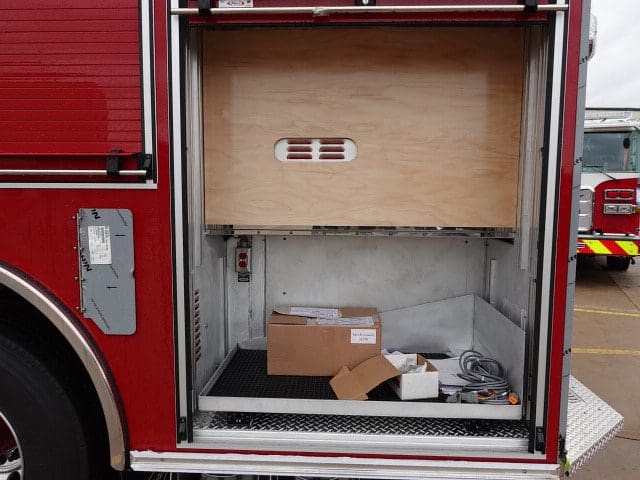

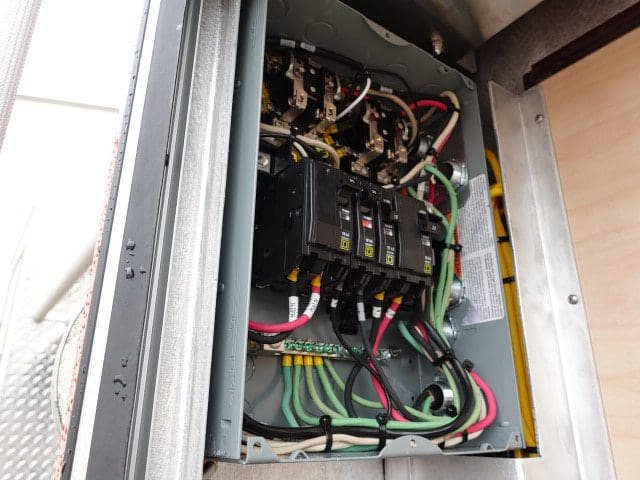

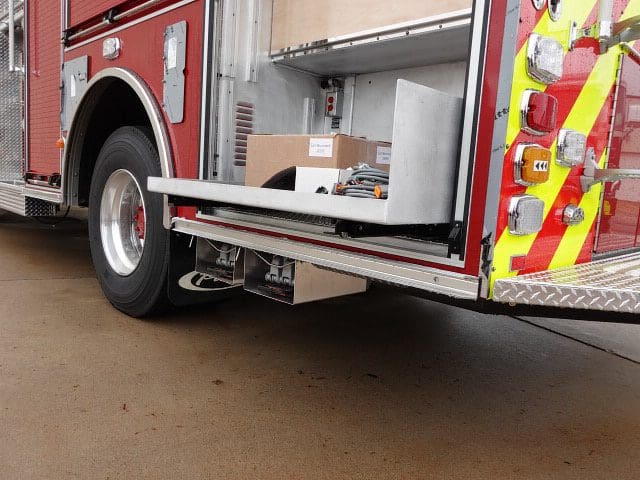

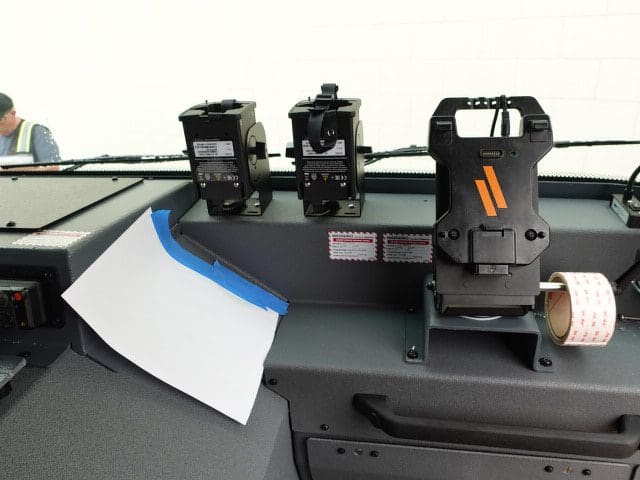

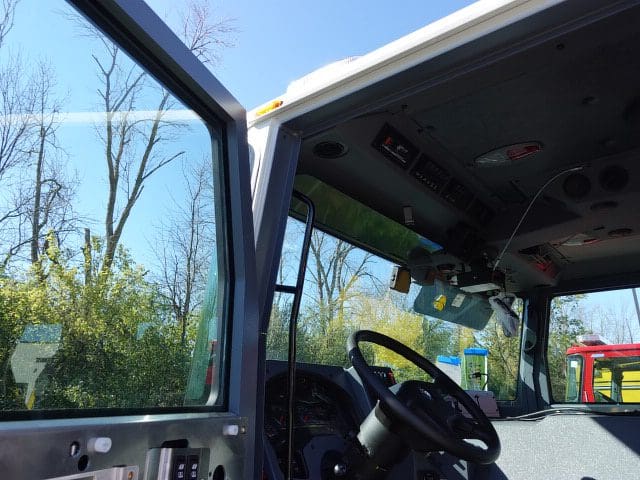

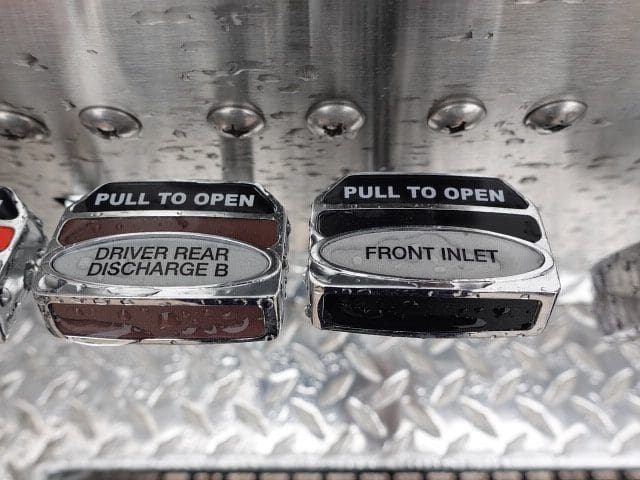

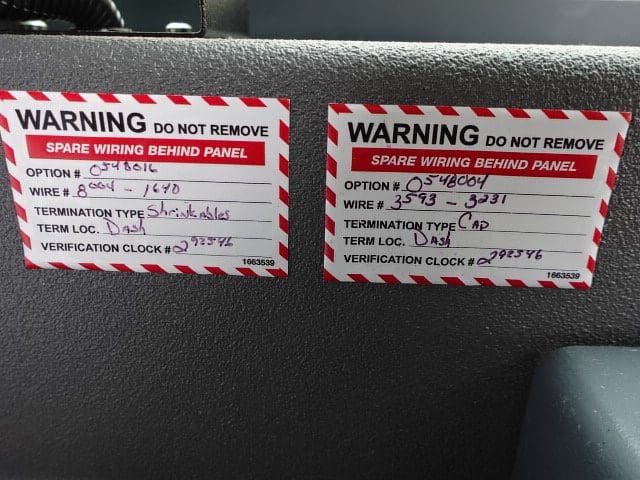

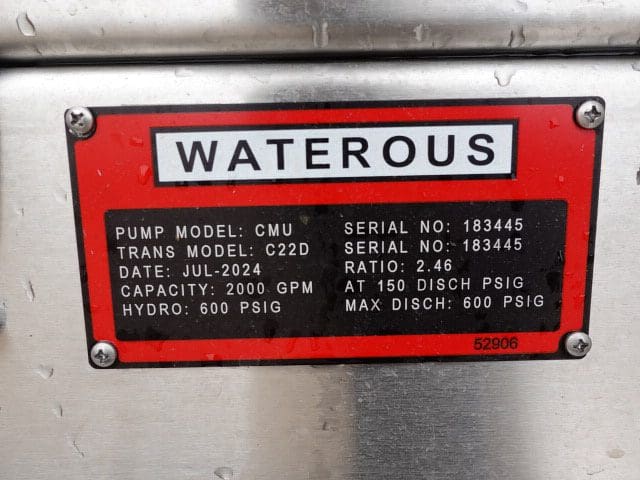

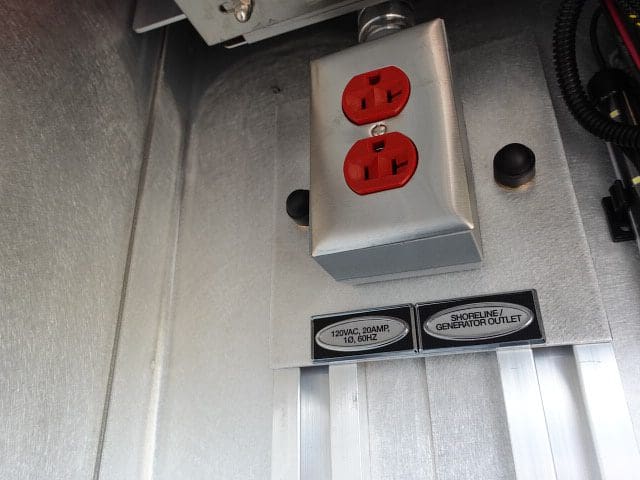

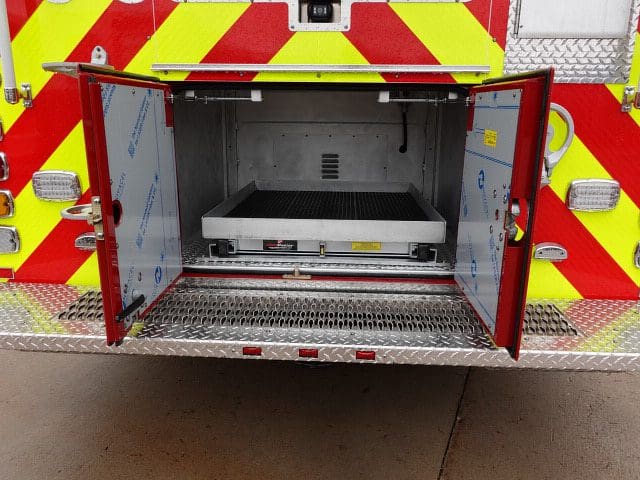

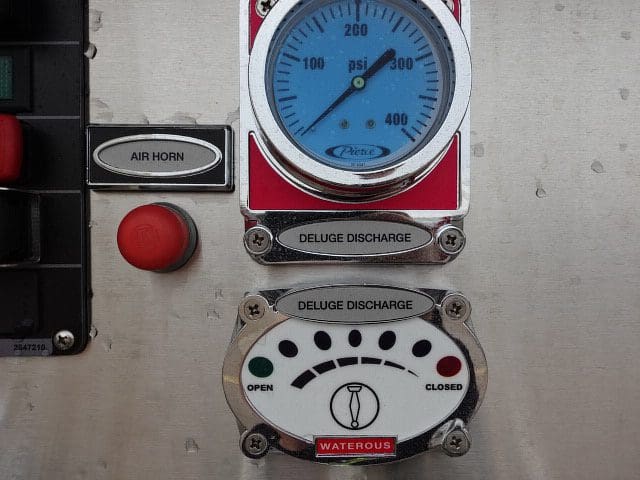

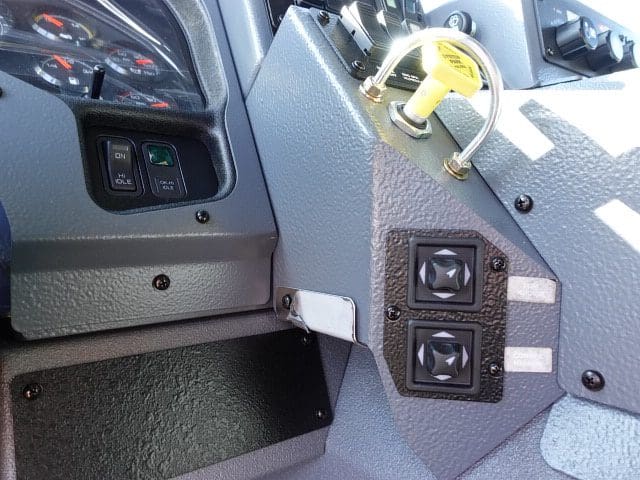

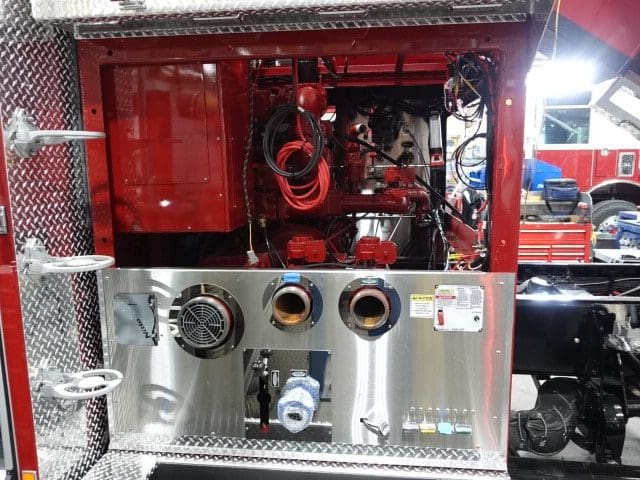

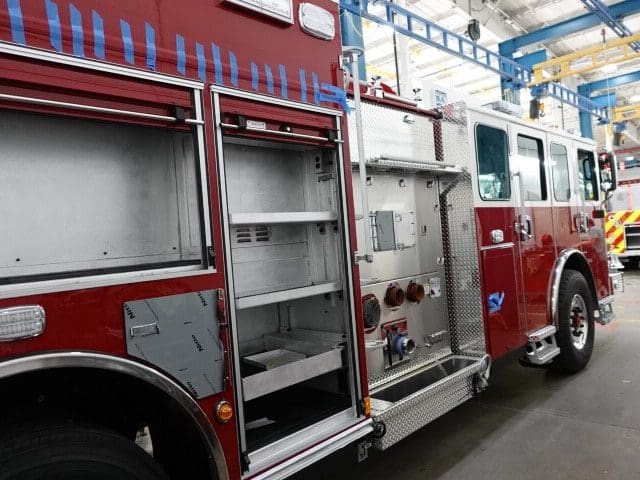

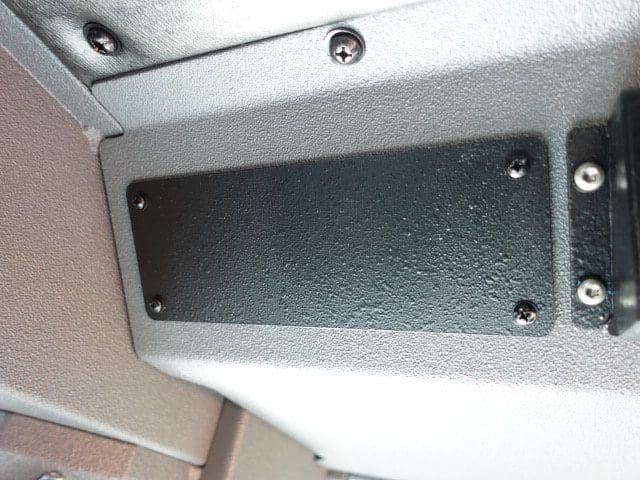

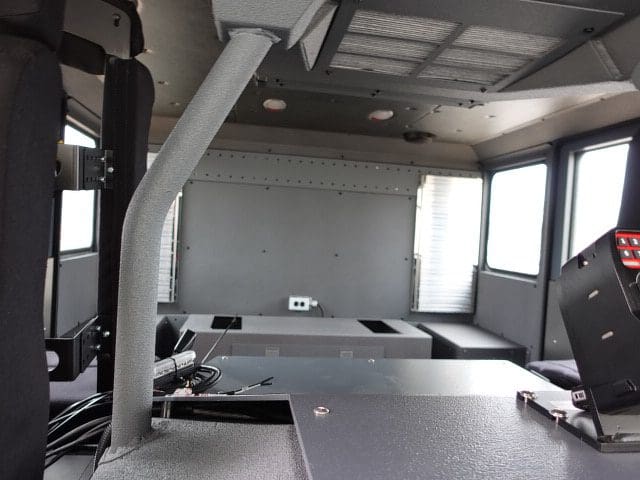

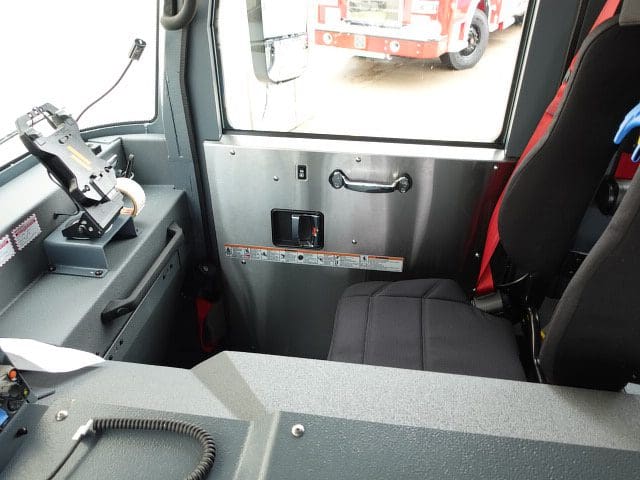

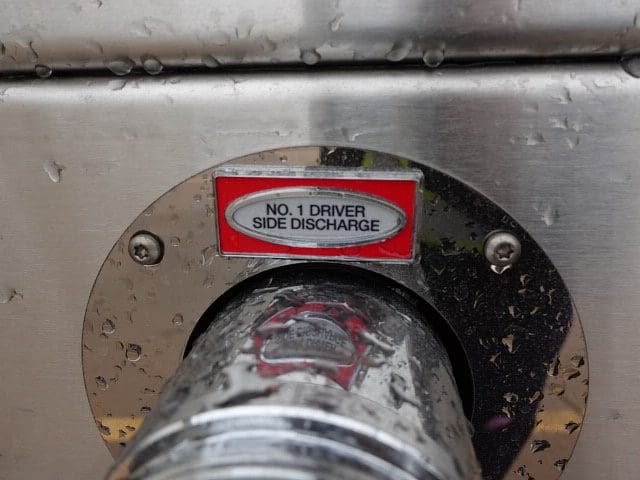

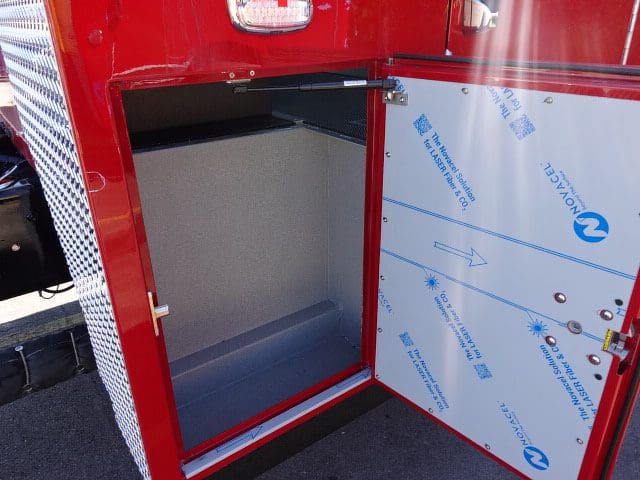

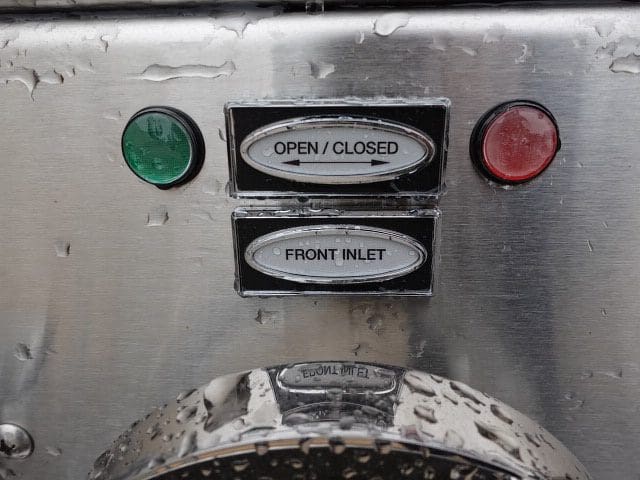

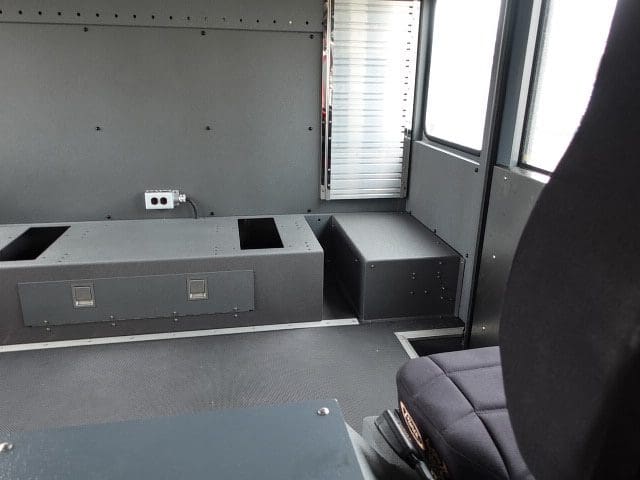

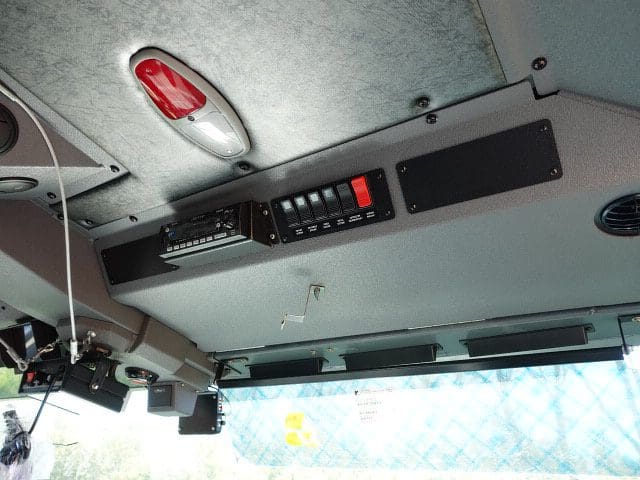

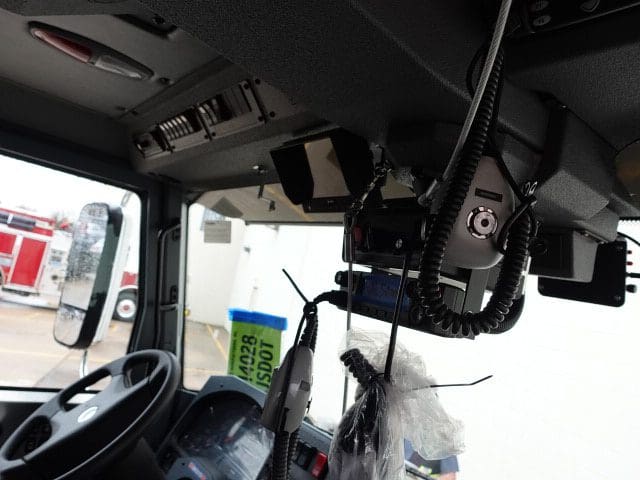

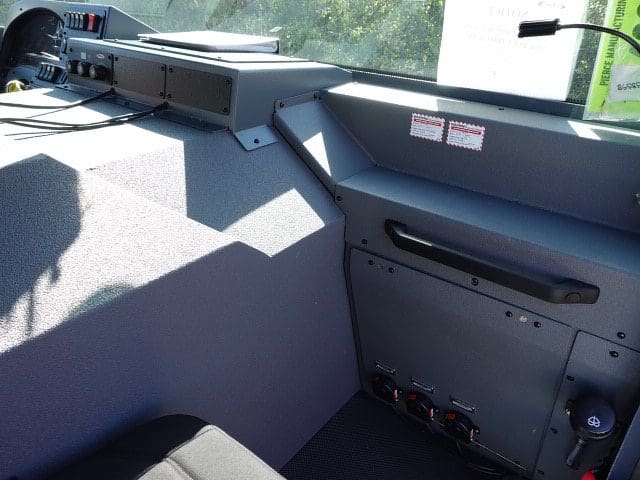

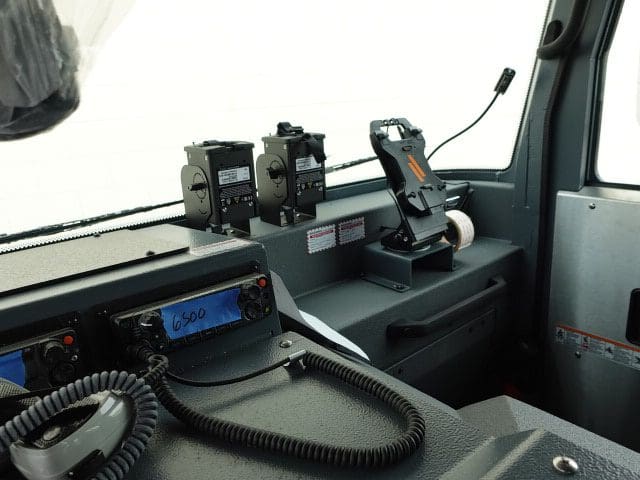

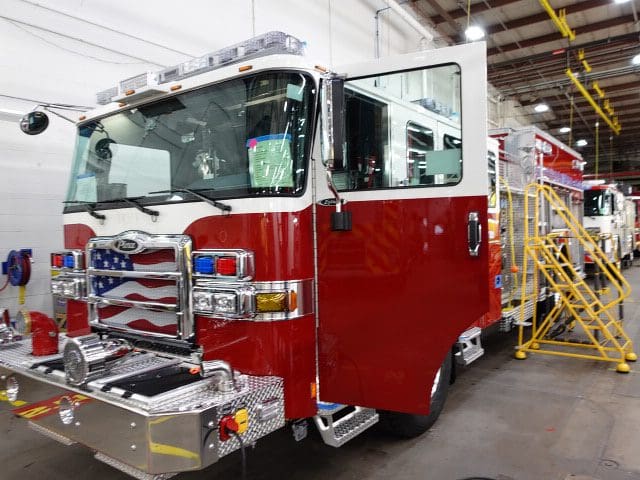

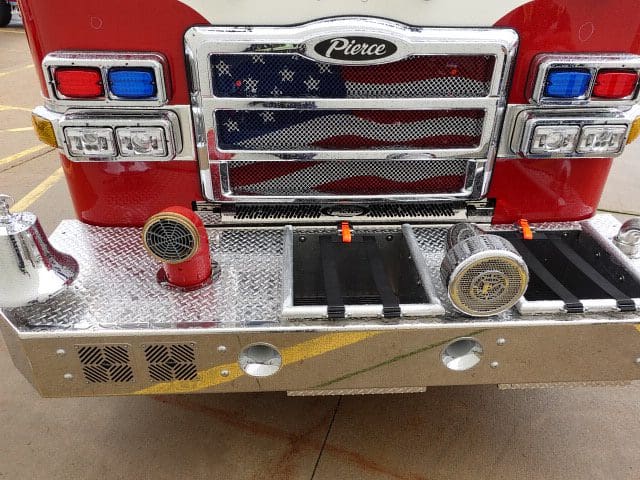

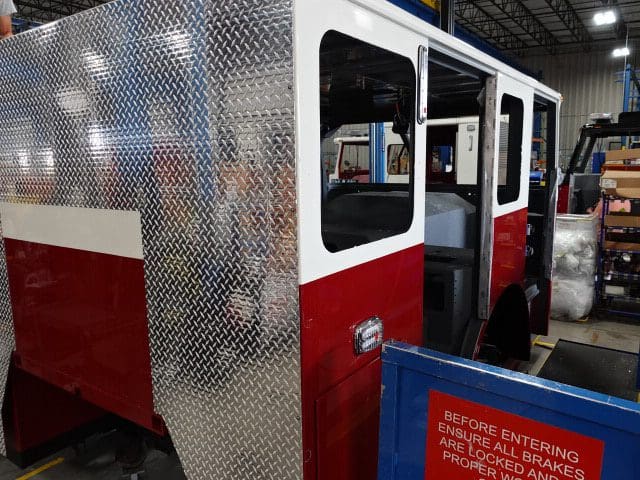

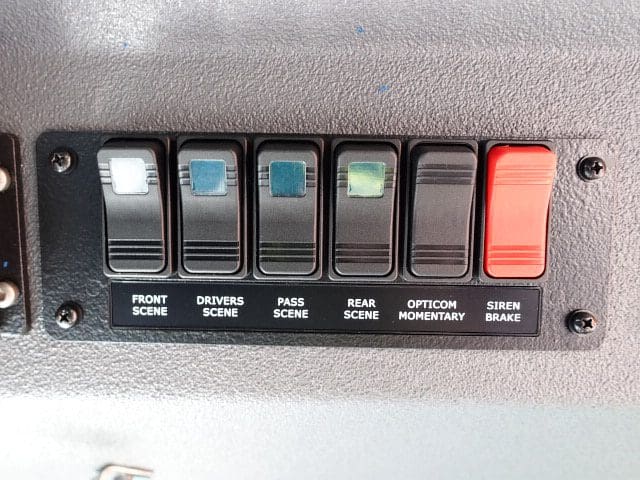

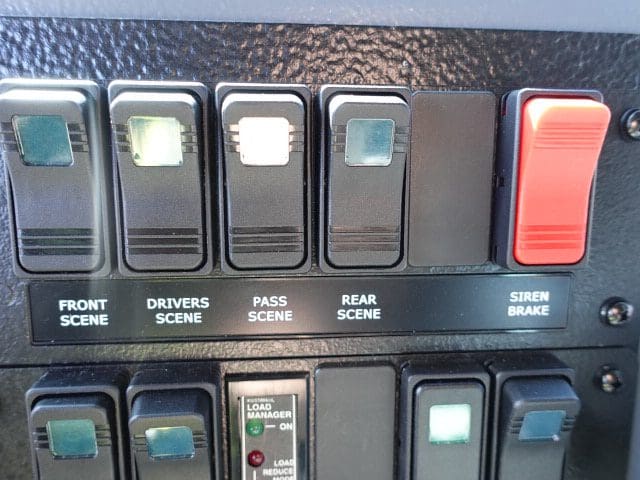

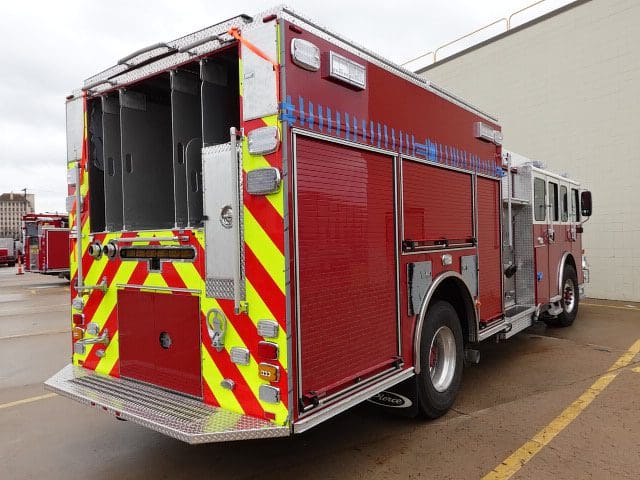

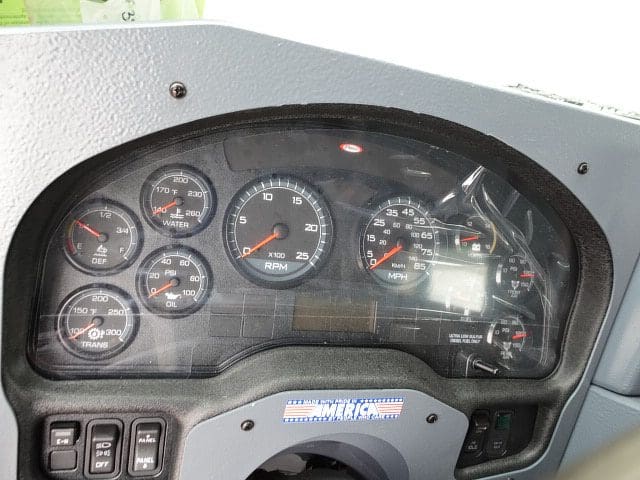

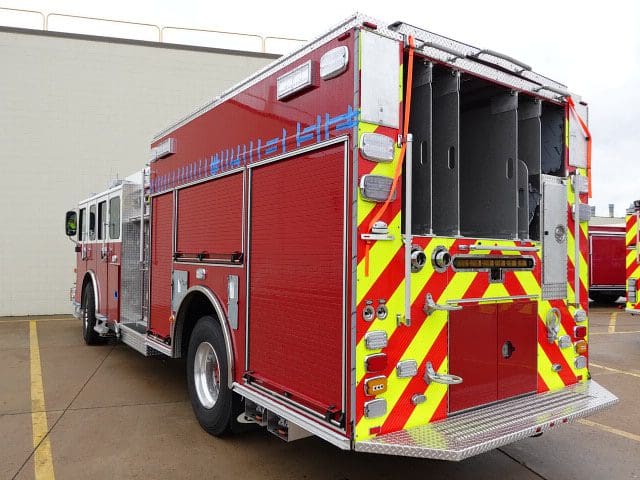

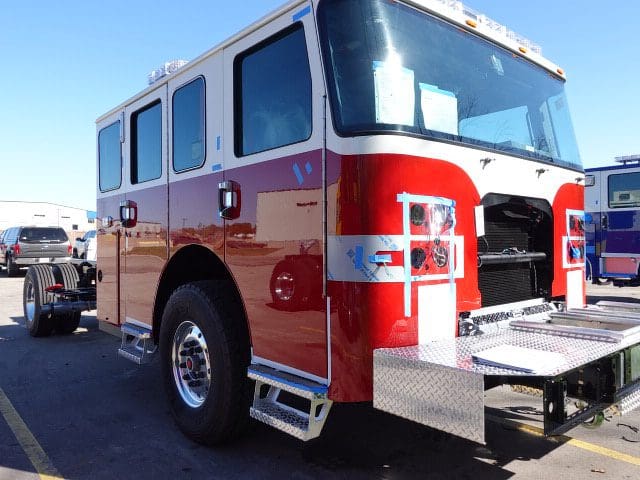

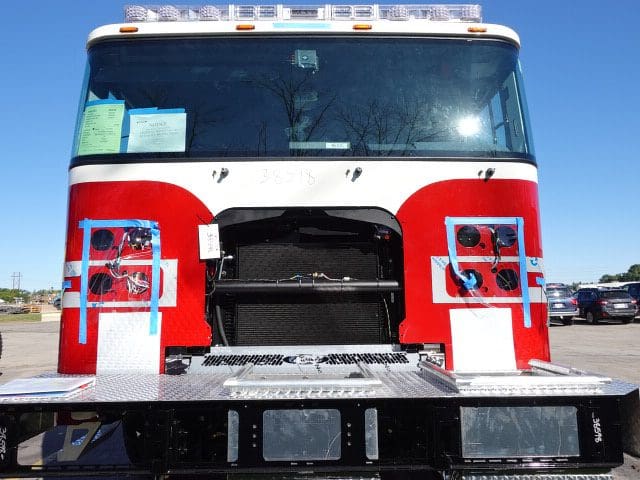

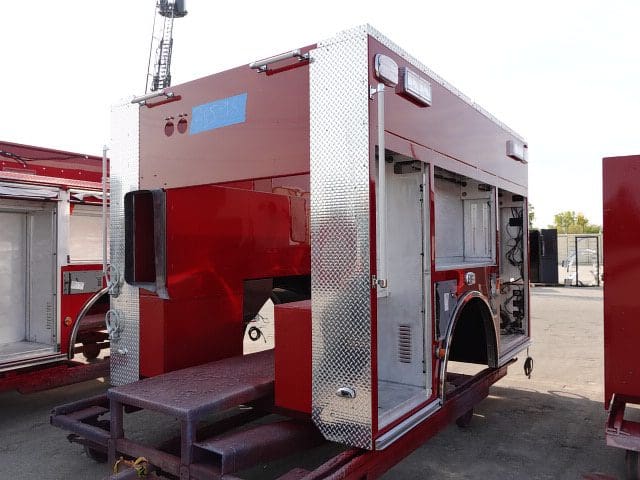

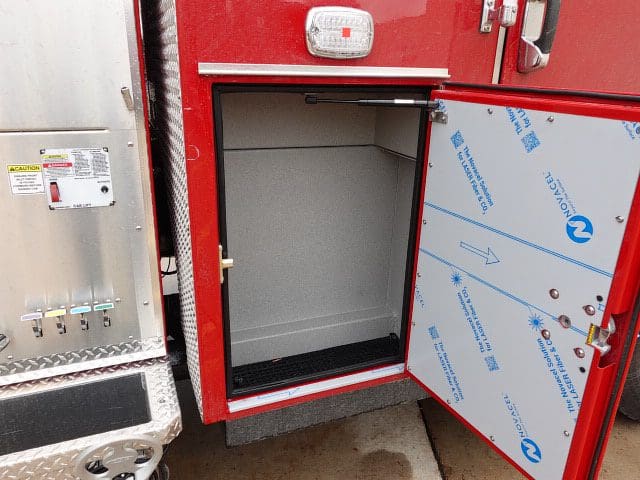

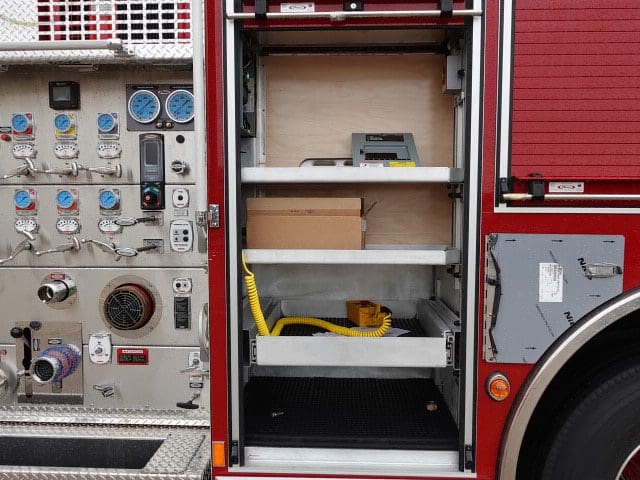

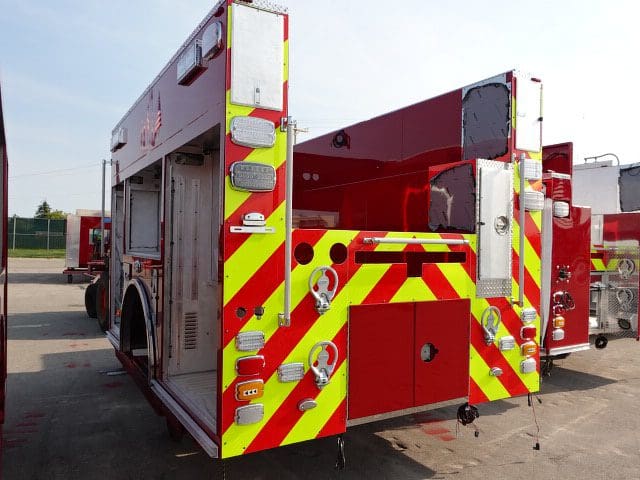

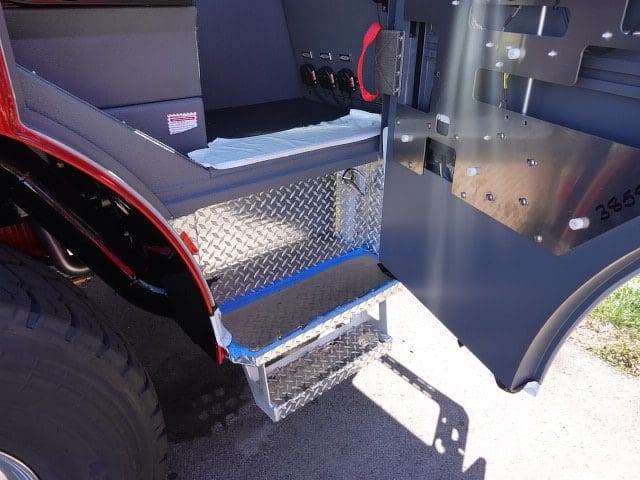

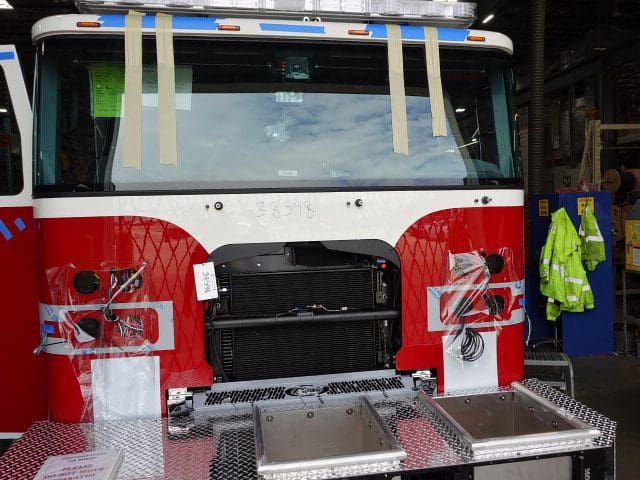

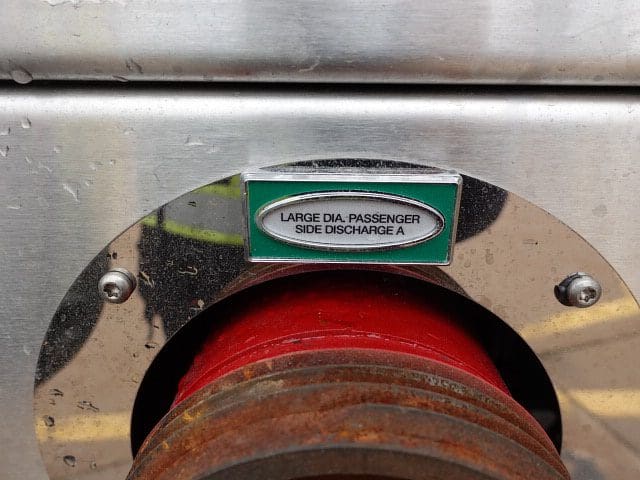

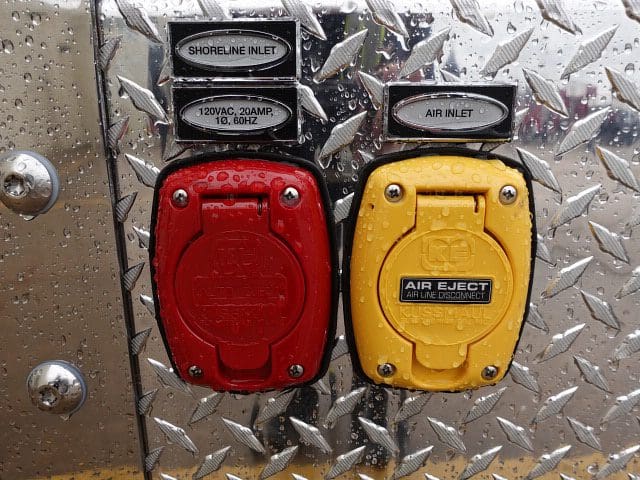

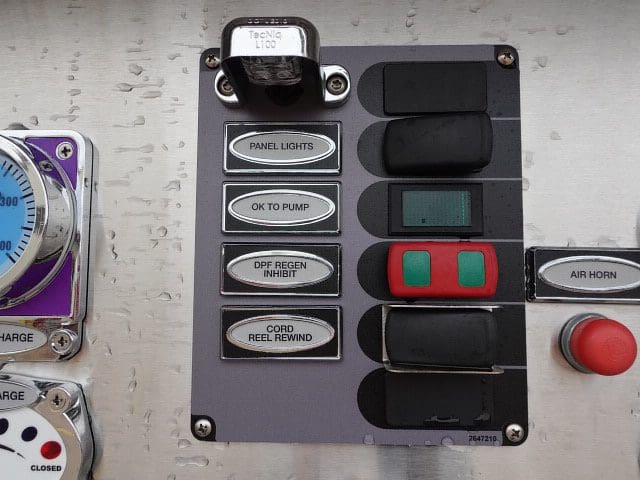

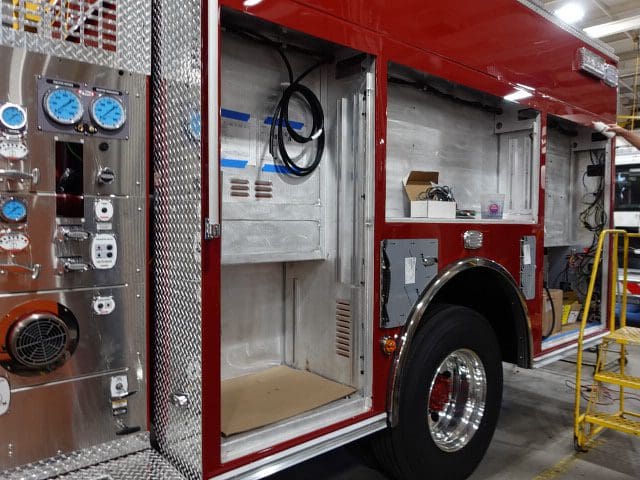

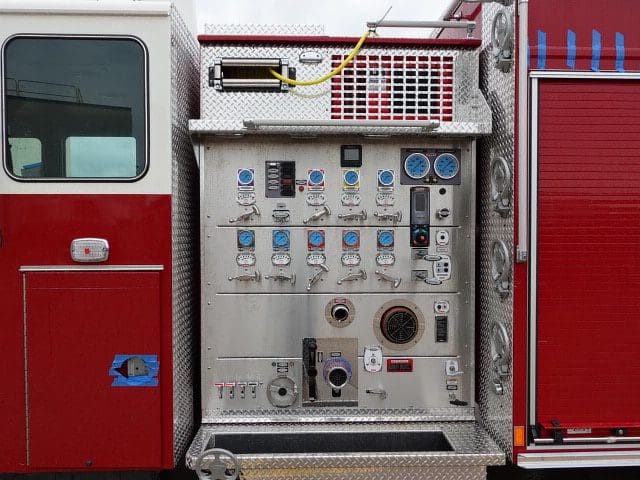

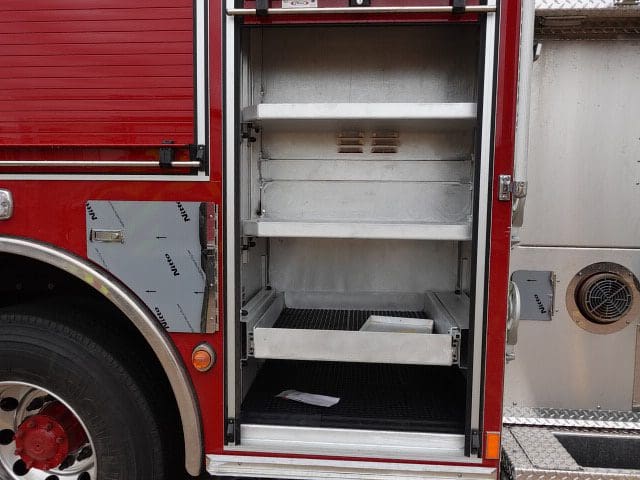

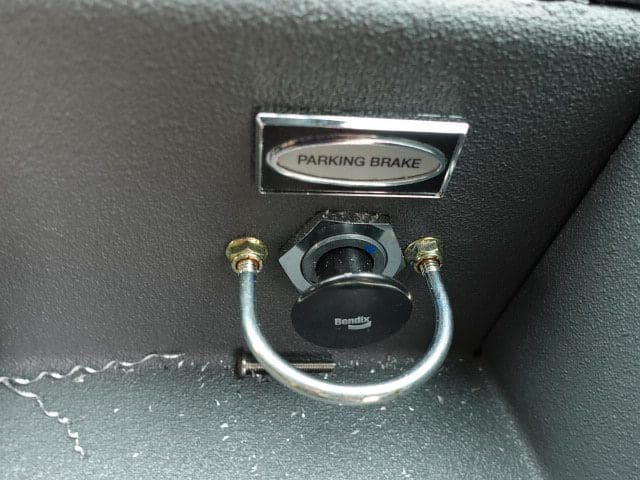

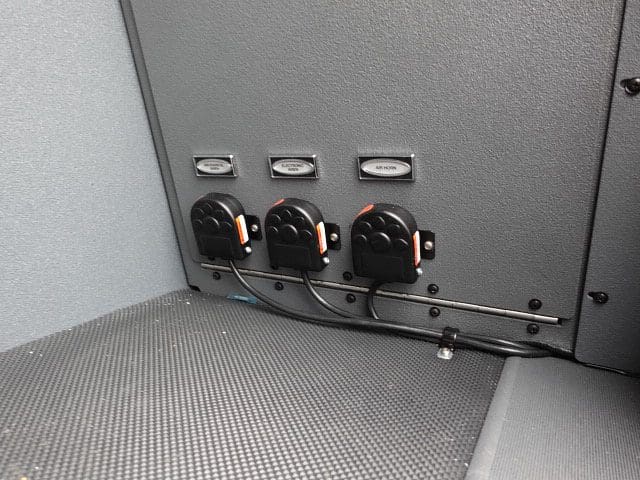

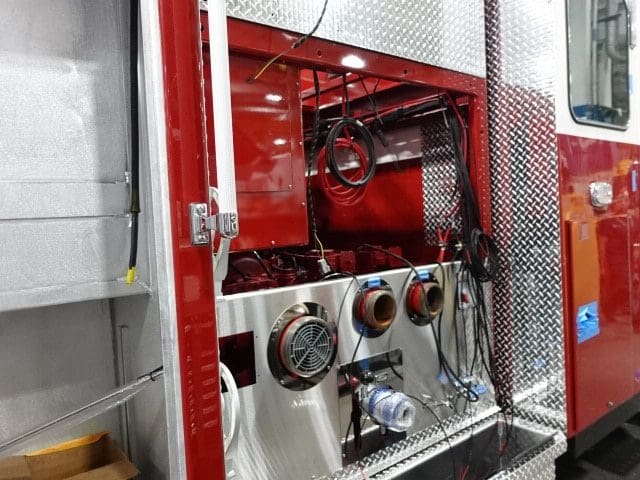

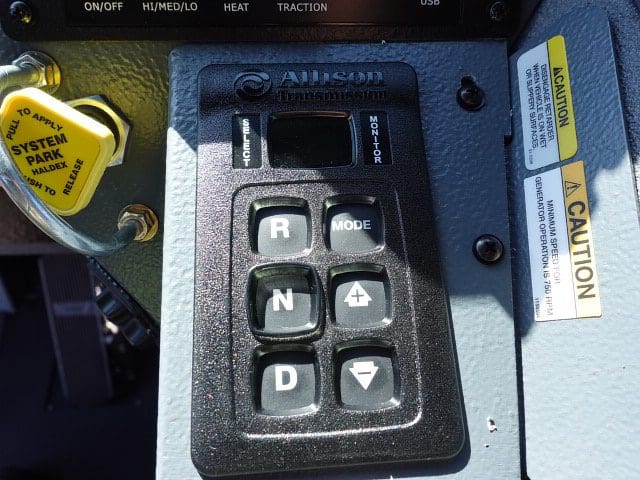

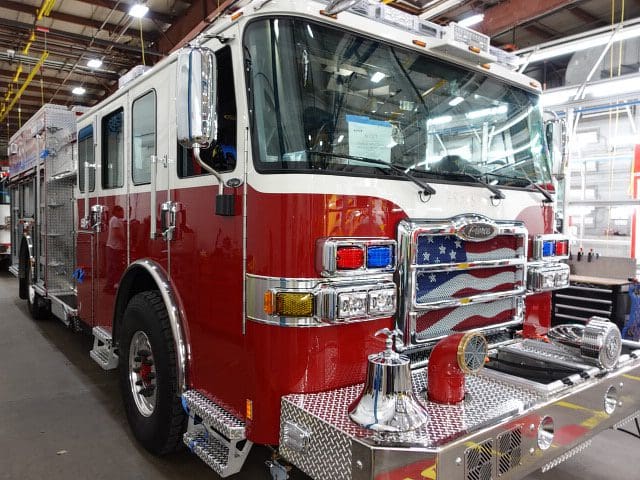

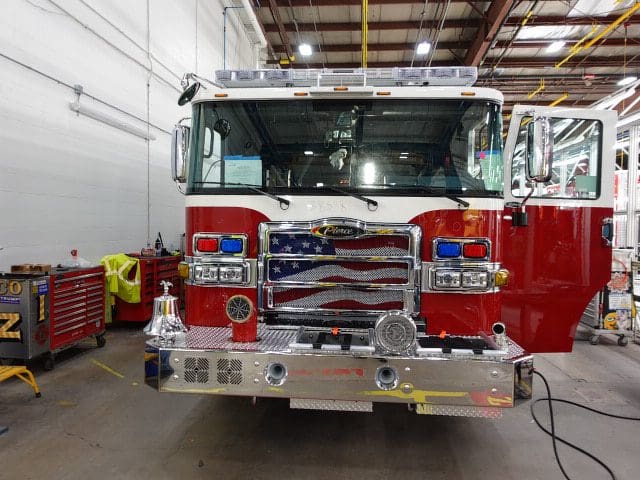

In this report, the apparatus continued the quality and graphics process where any remaining content will be applied. Once finished it will be made ready for the customer acceptance inspection. This is the last scheduled report.
11-01-24

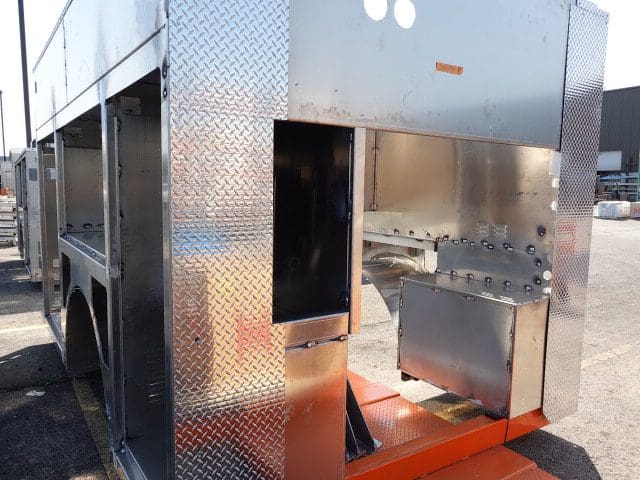

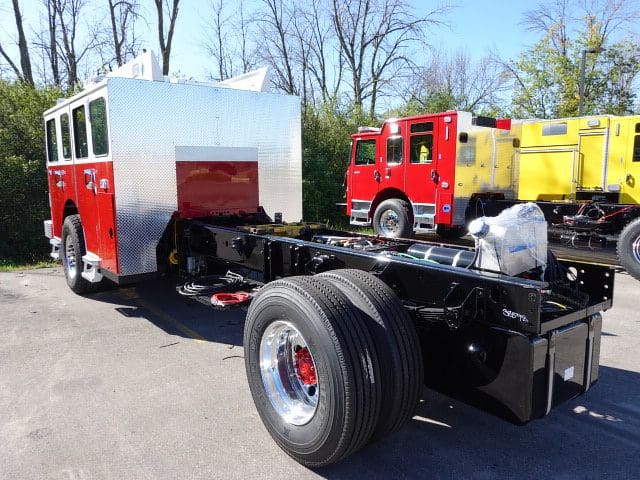

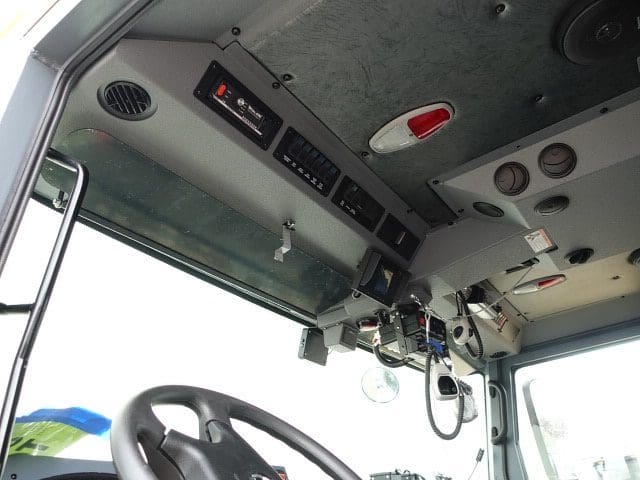

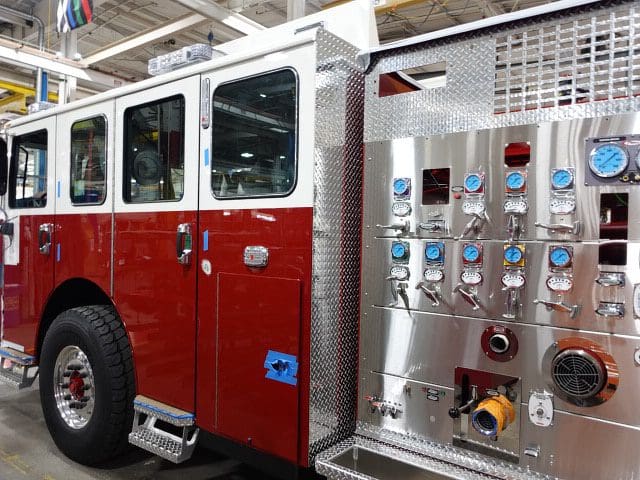

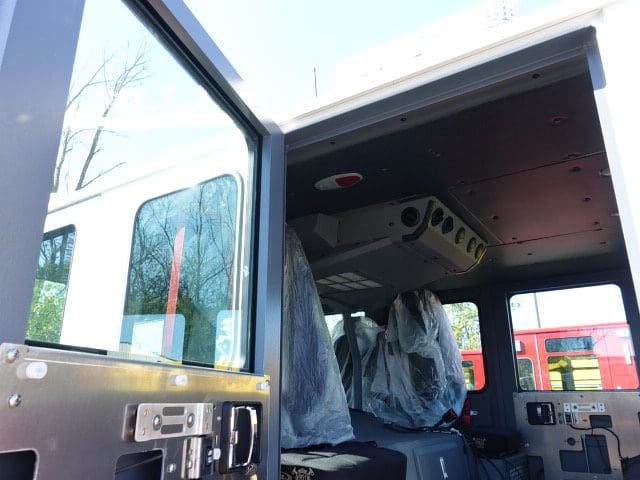

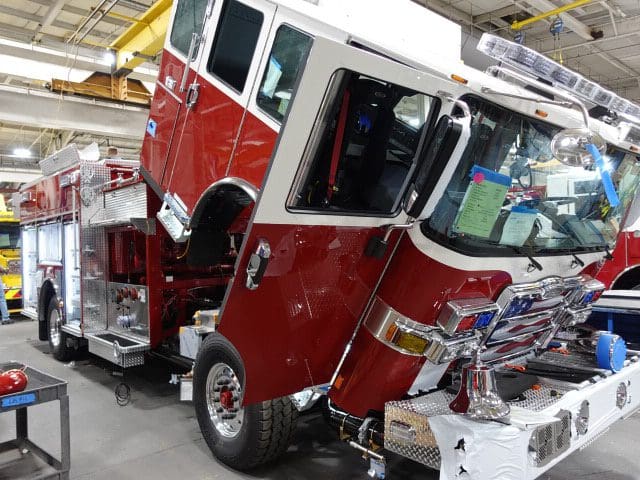

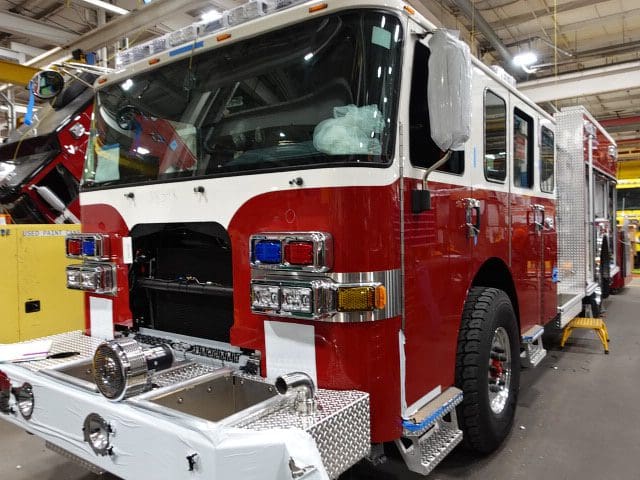

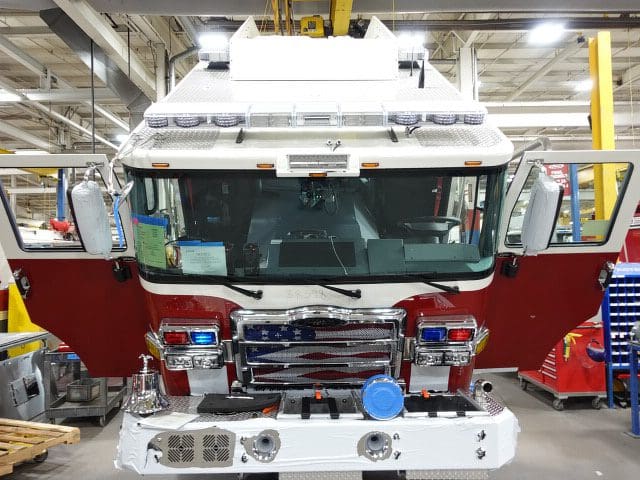

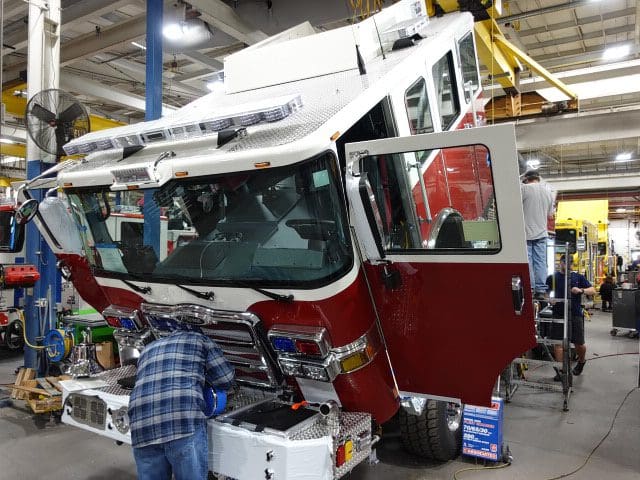

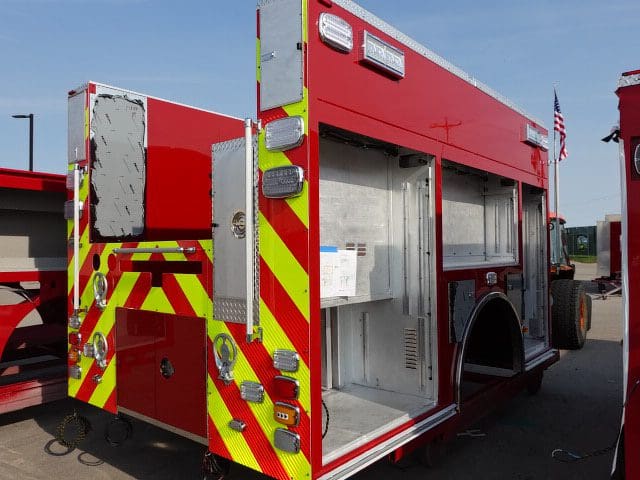

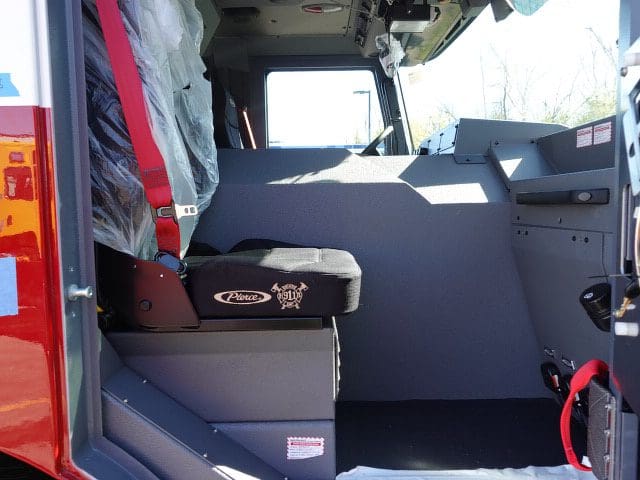

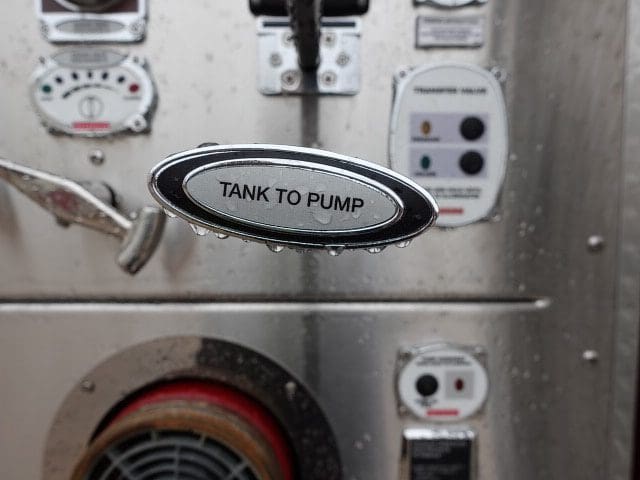

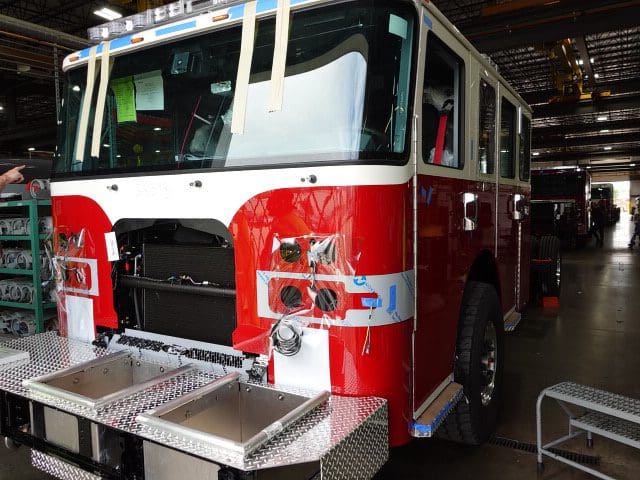

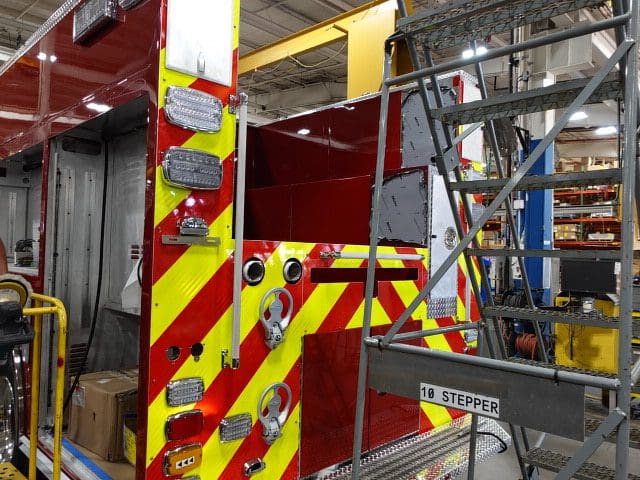

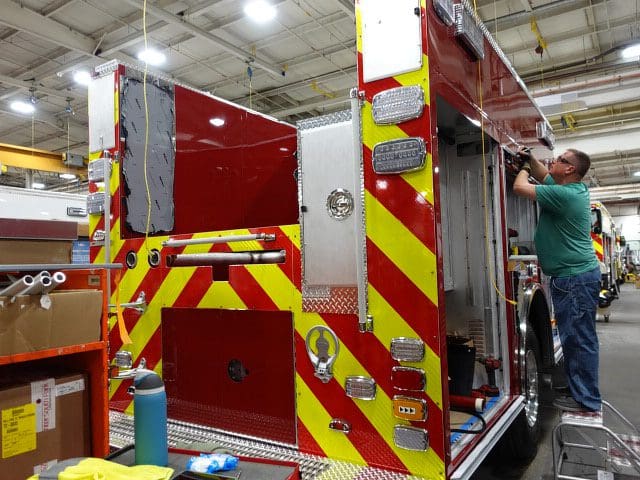

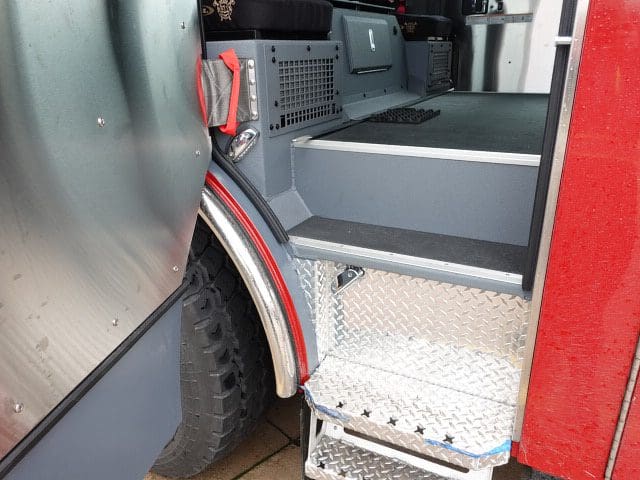

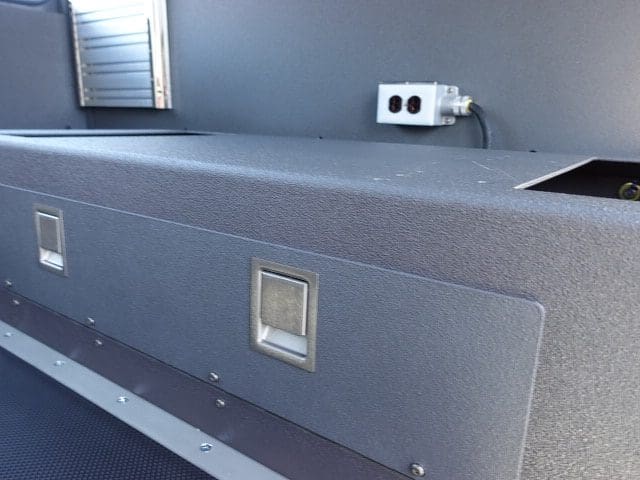

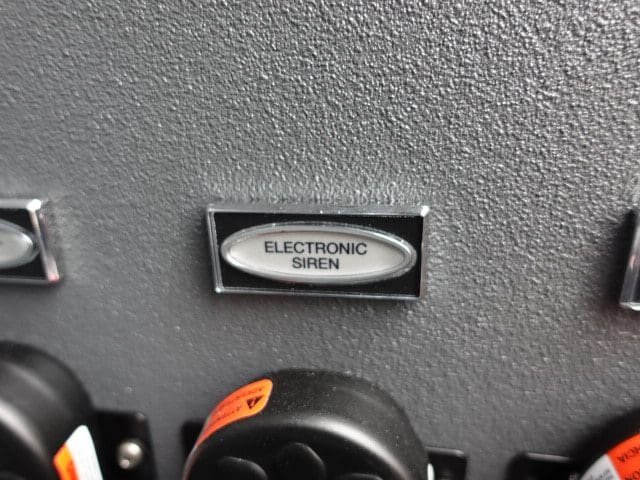

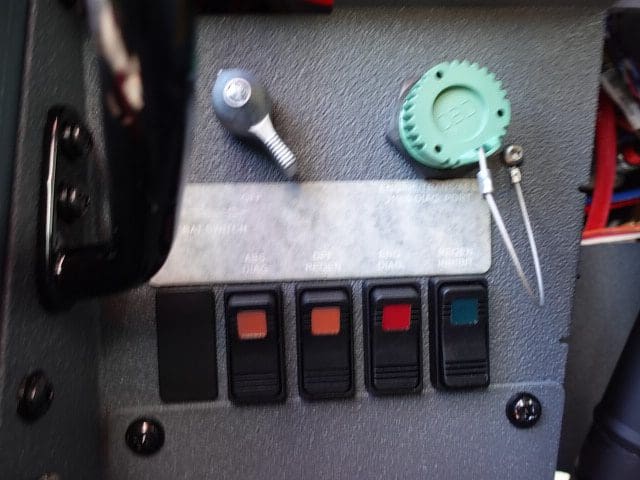

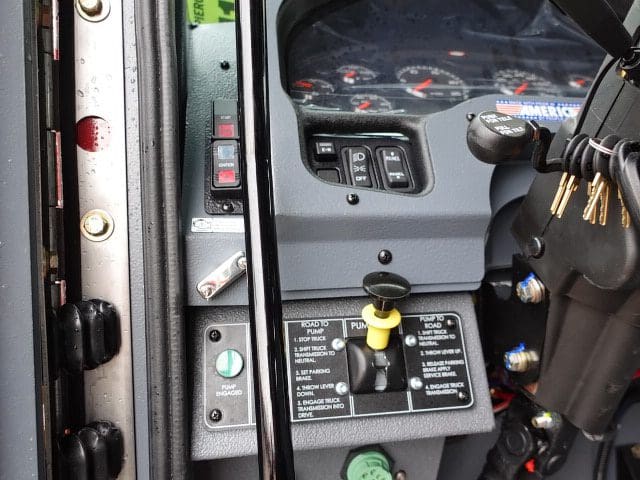

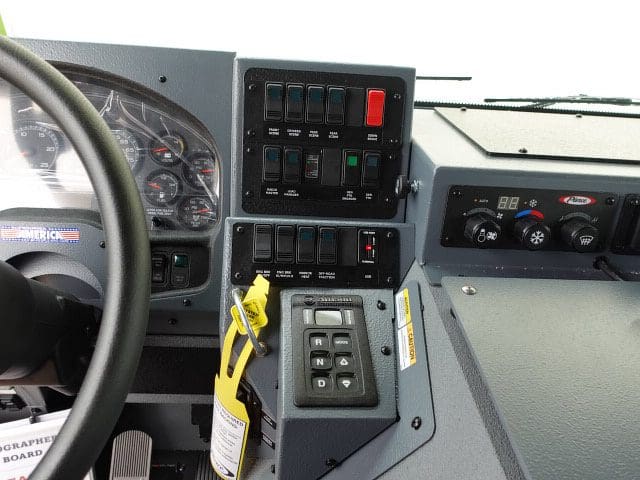

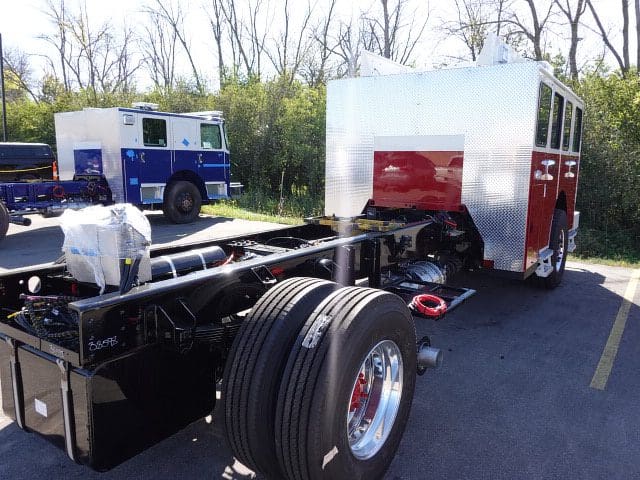

In this report, the apparatus completed final assembly and testing then released to quality and graphics where any remaining content will be applied.

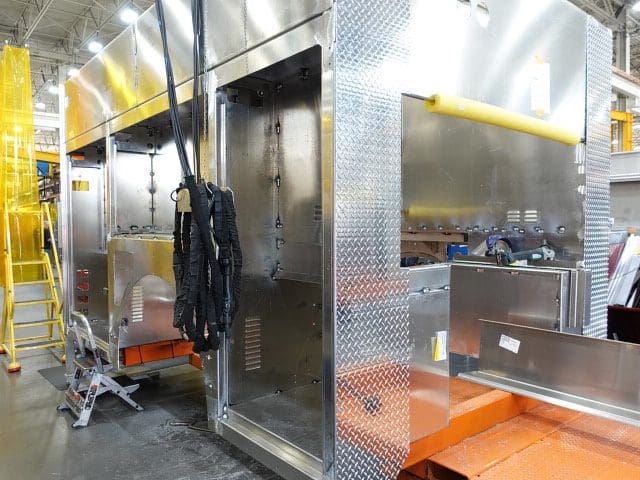

10-11-24

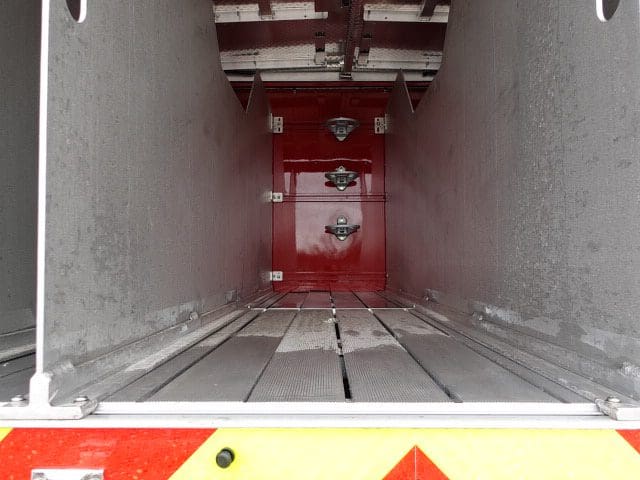

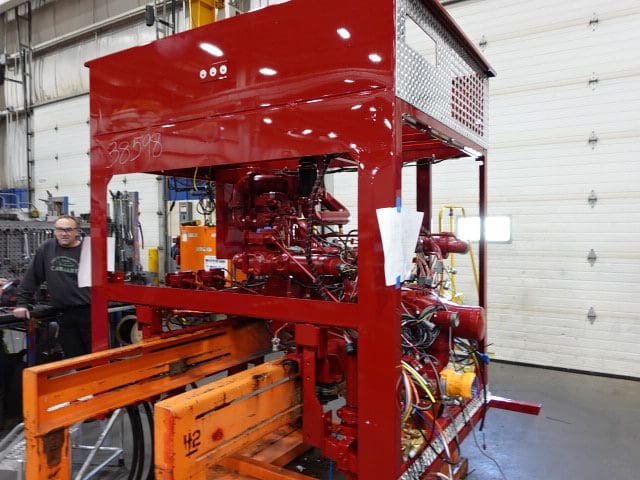

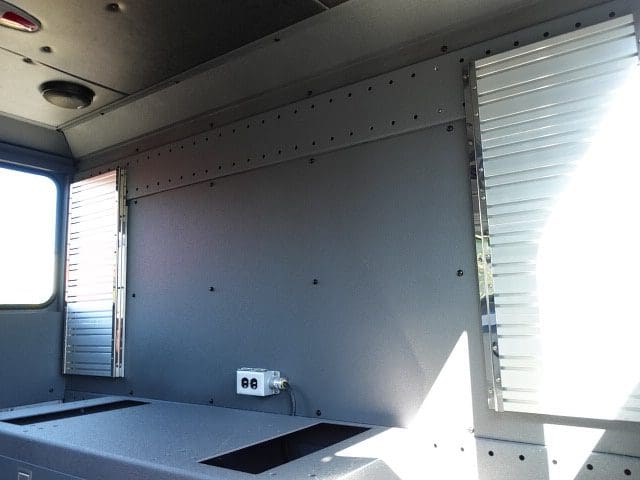

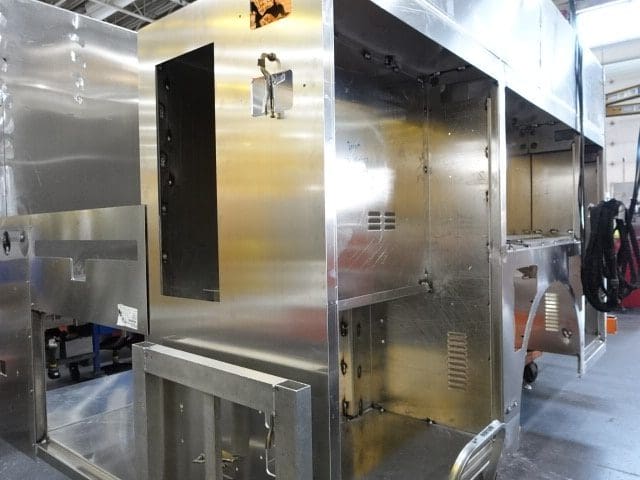

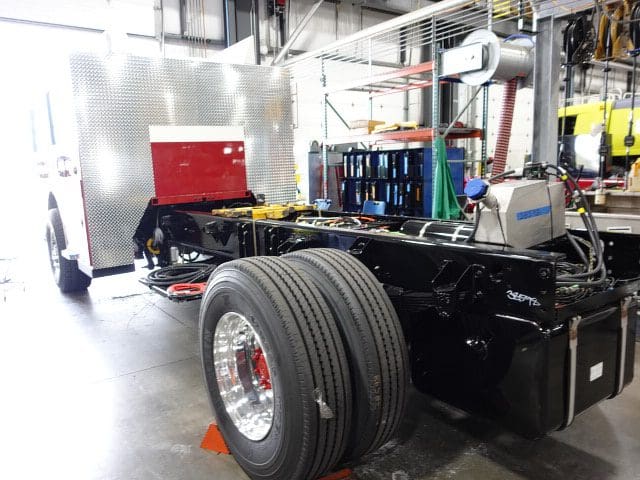

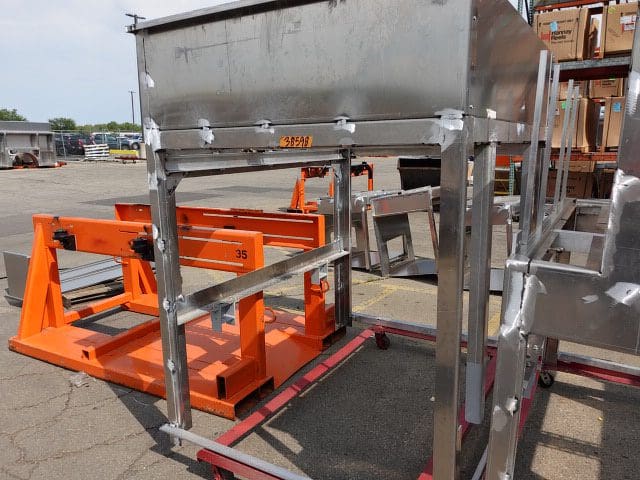

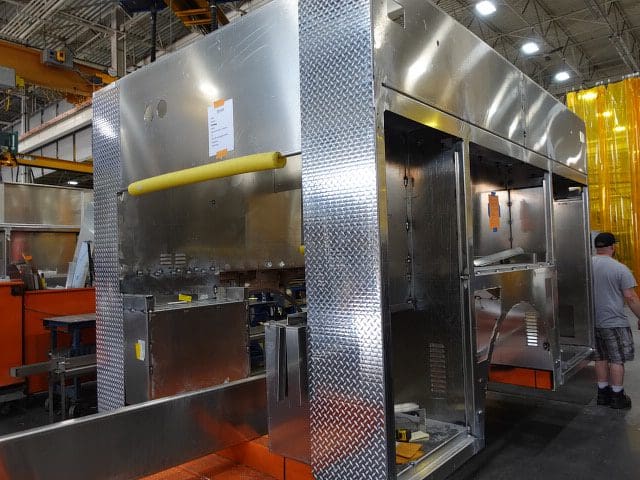

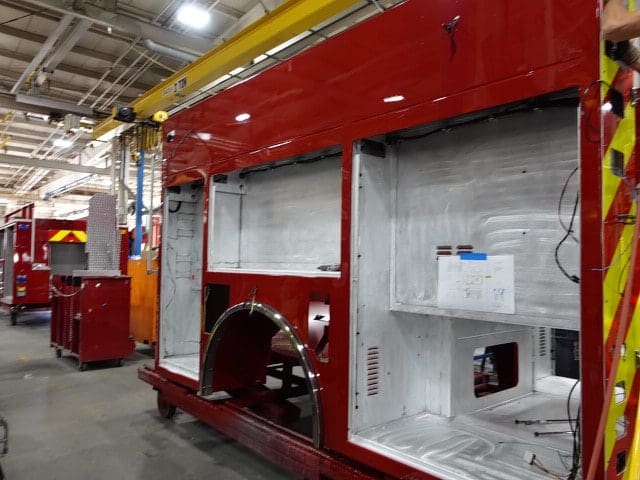

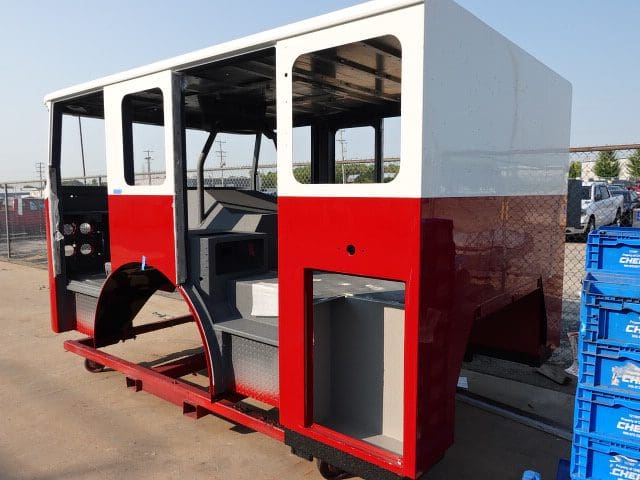

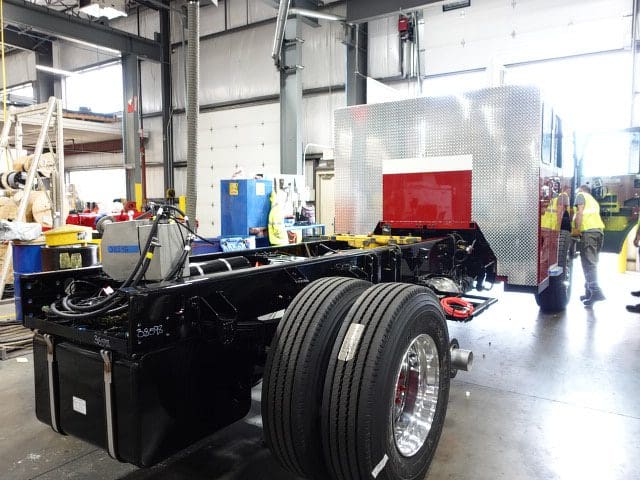

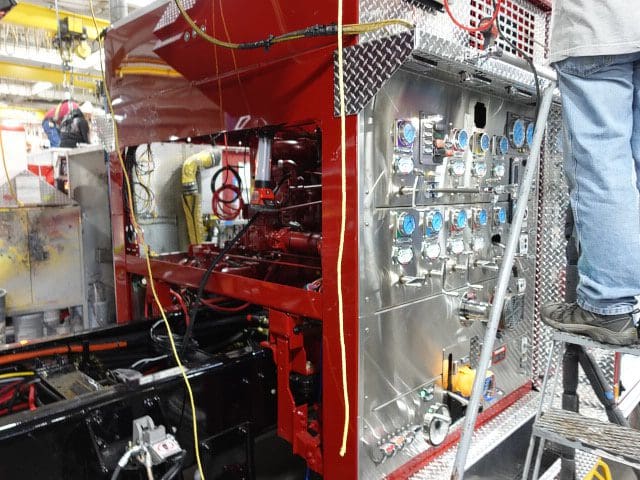

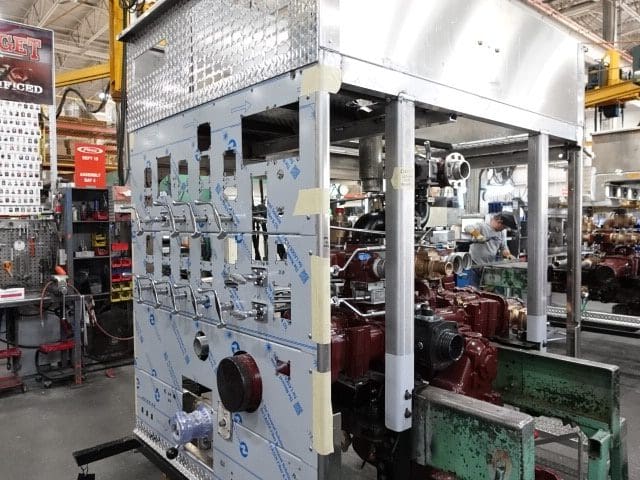

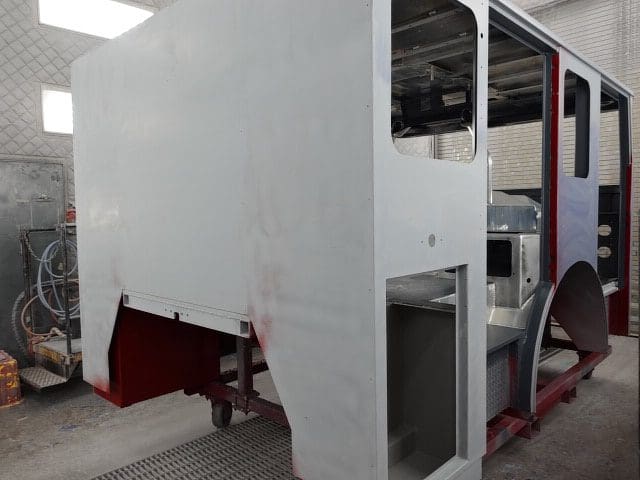

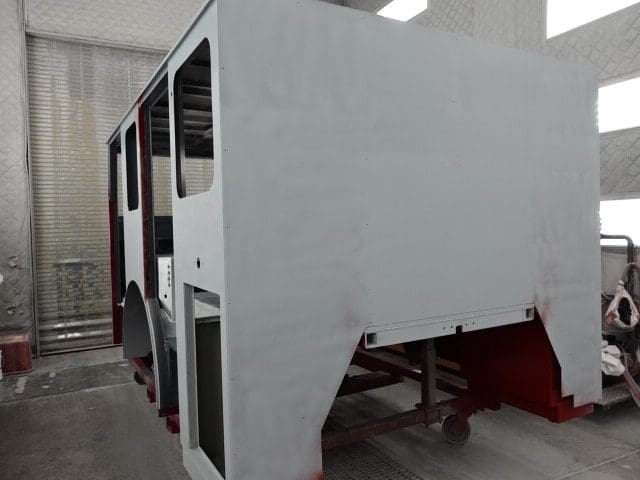

In this report, the pump house and the body completed initial assembly and were merged with the chassis followed by the start of final assembly.

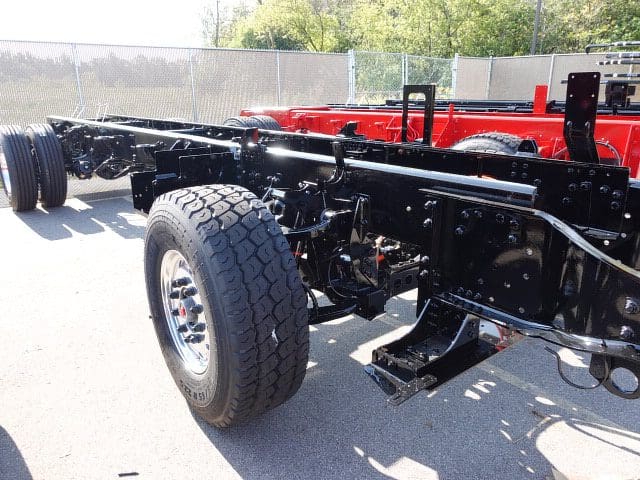

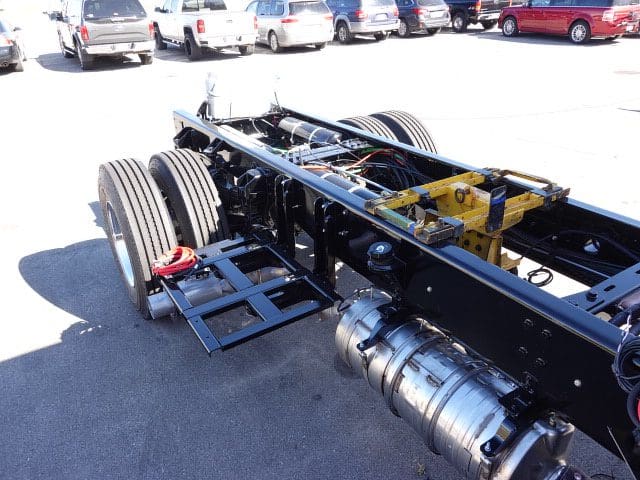

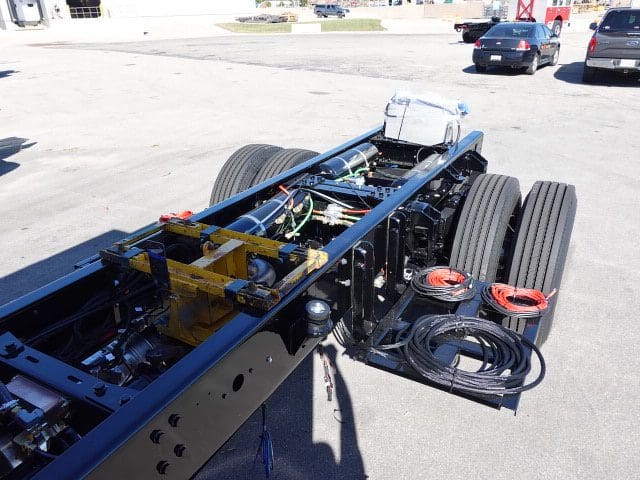

10-04-24

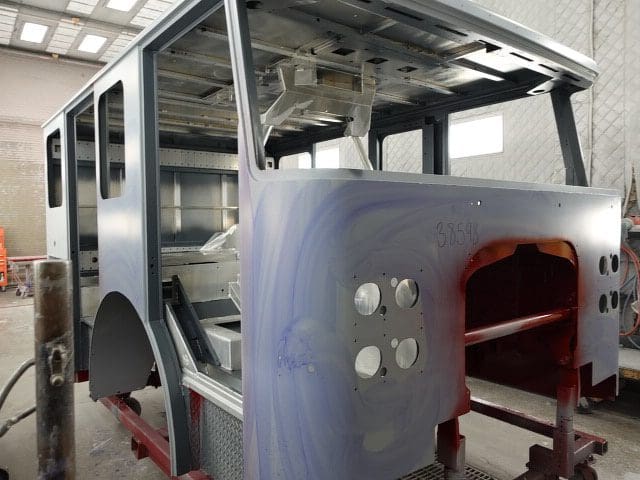

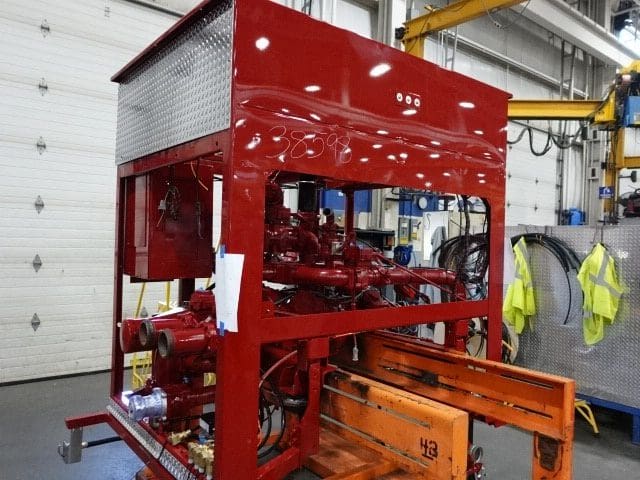

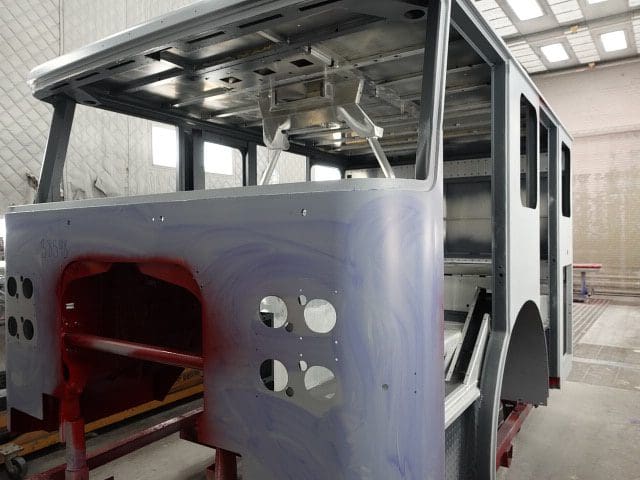

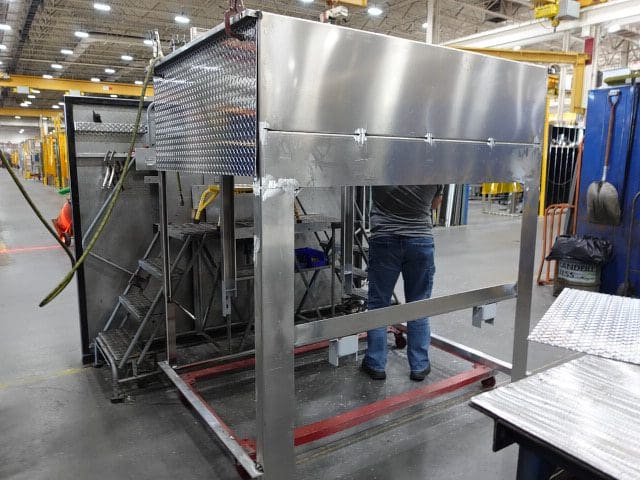

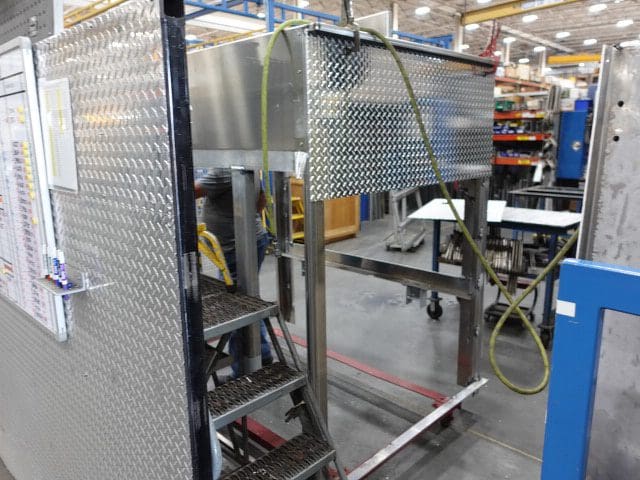

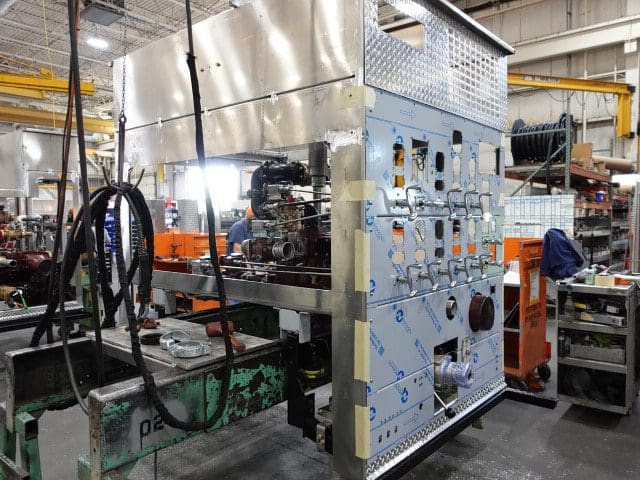

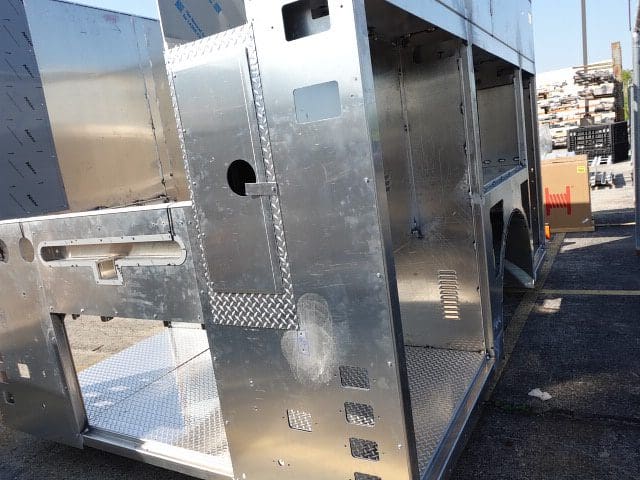

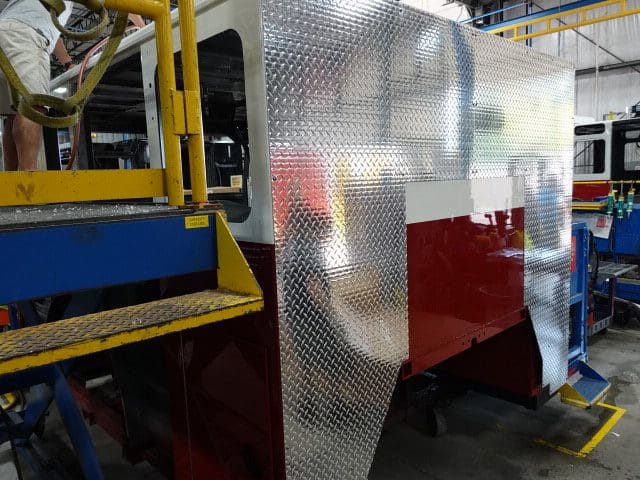

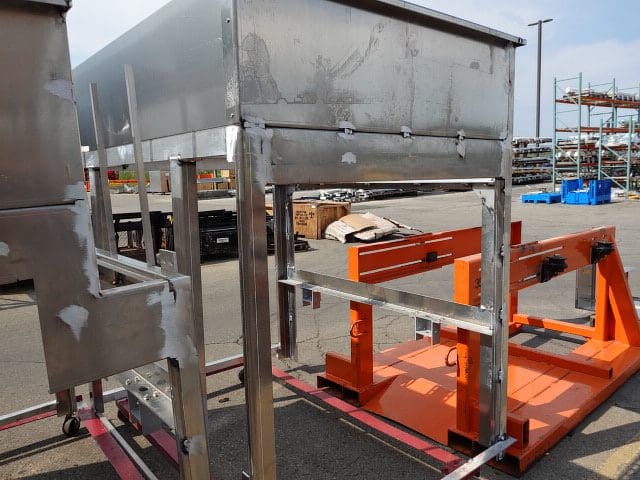

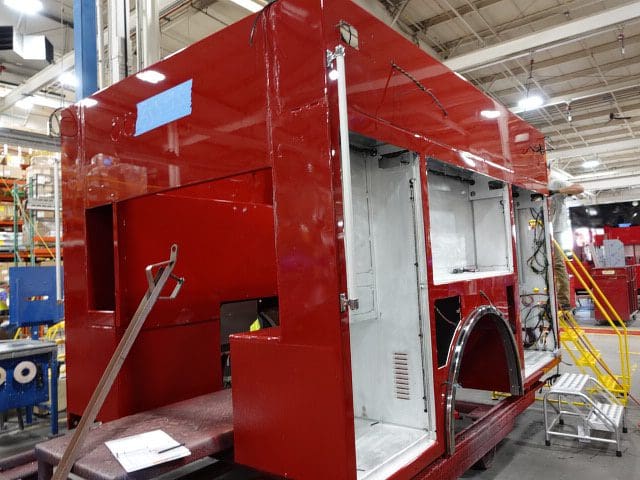

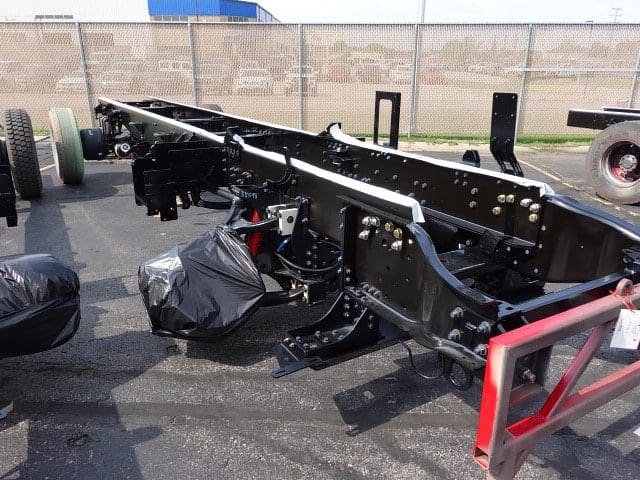

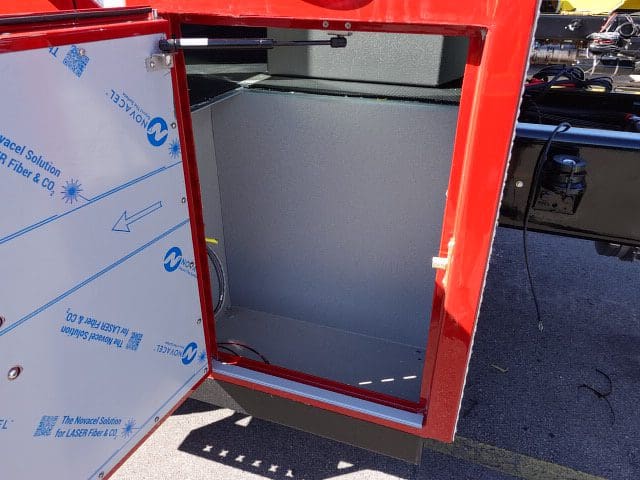

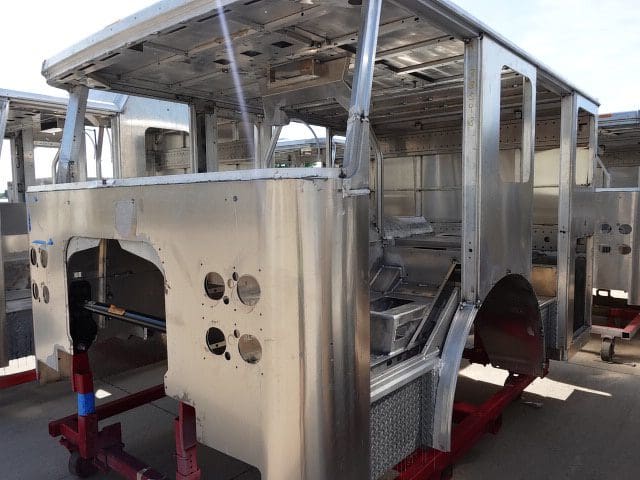

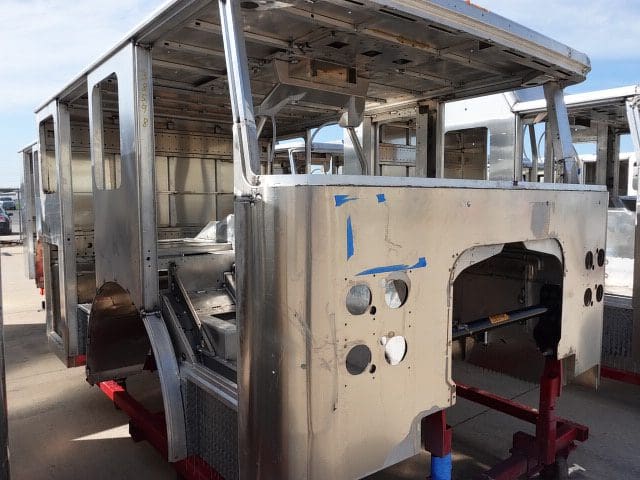

In this report, the chassis was staged to continue assembly, the pump house was painted, and the body completed initial assembly.

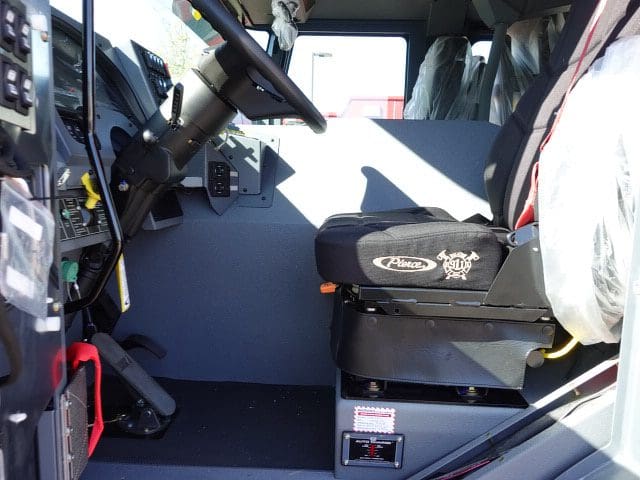

09-27-24

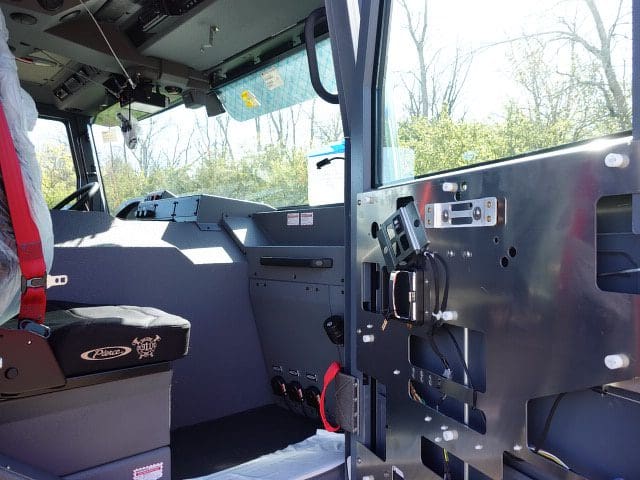

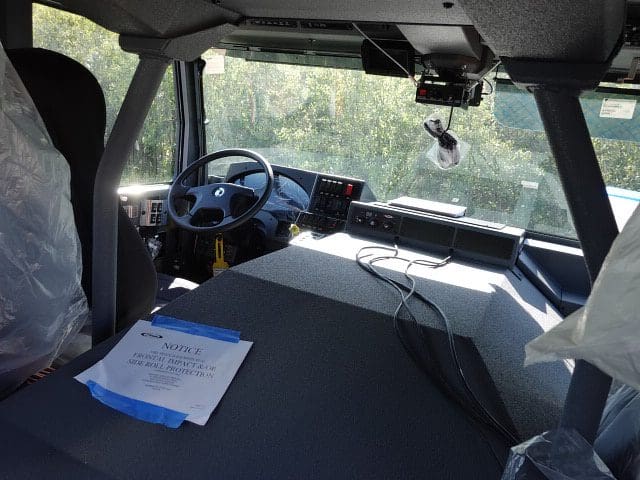

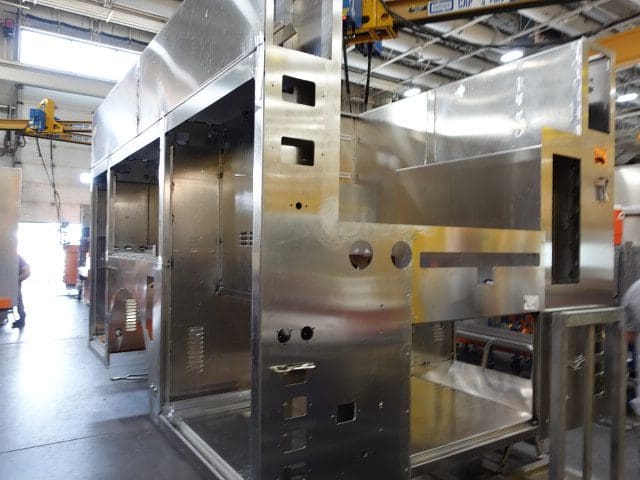

In this report, the cab completed initial assembly and was installed on the frame, the pump house continued initial assembly, and the body completed paint and began initial assembly.
09-20-24

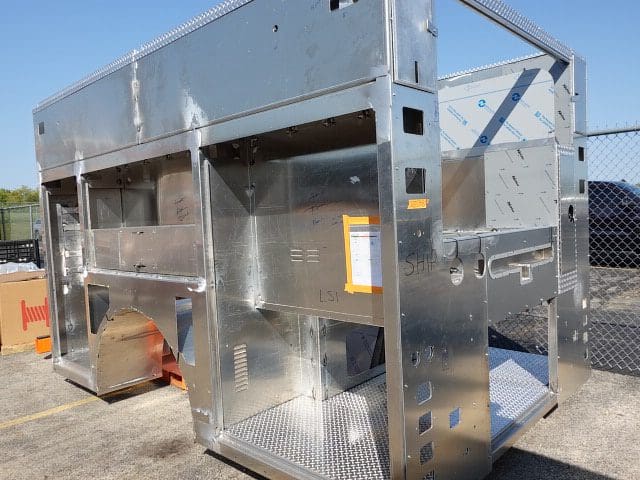

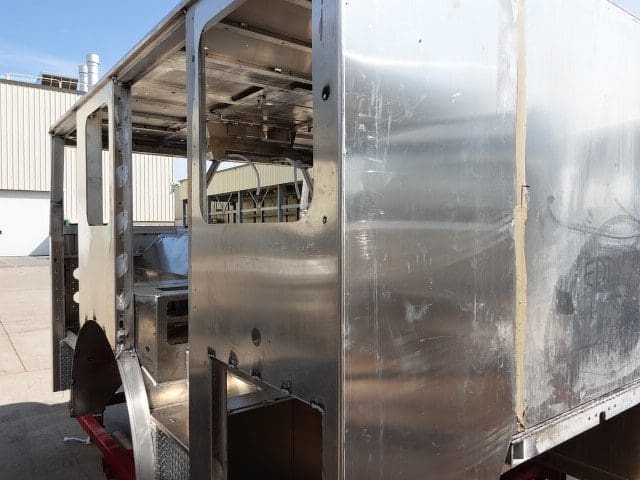

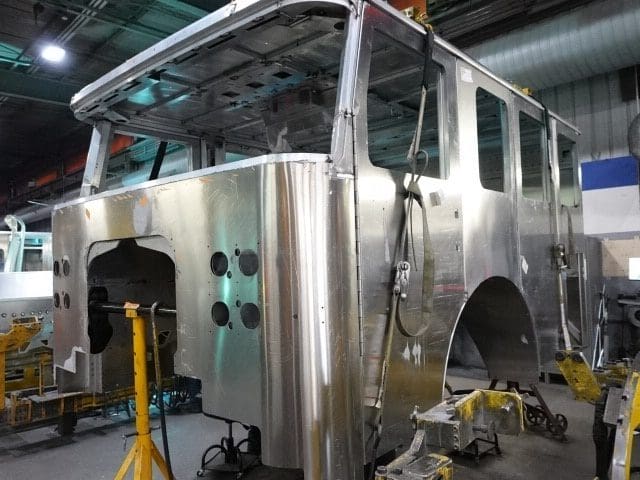

In this report, the cab completed paint and began initial assembly, the frame build continued, the pump house began initial assembly, and the body completed fabrication.

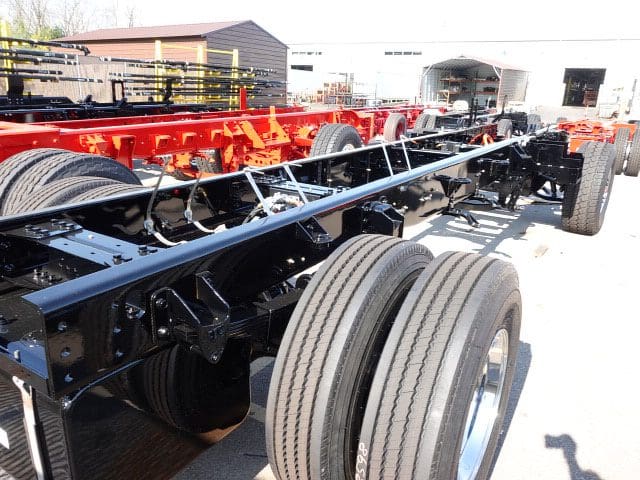

09-13-24

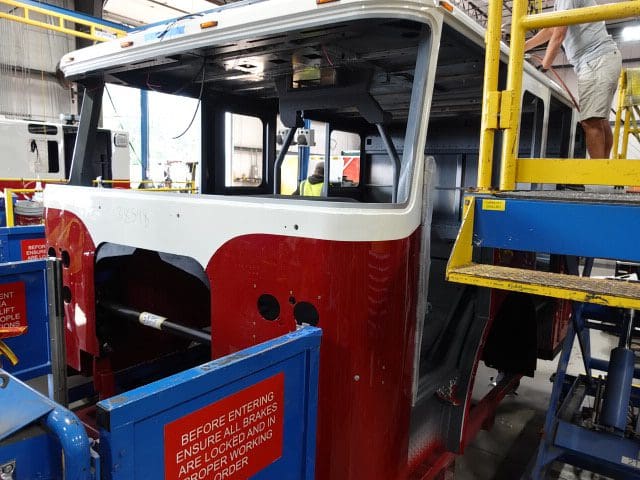

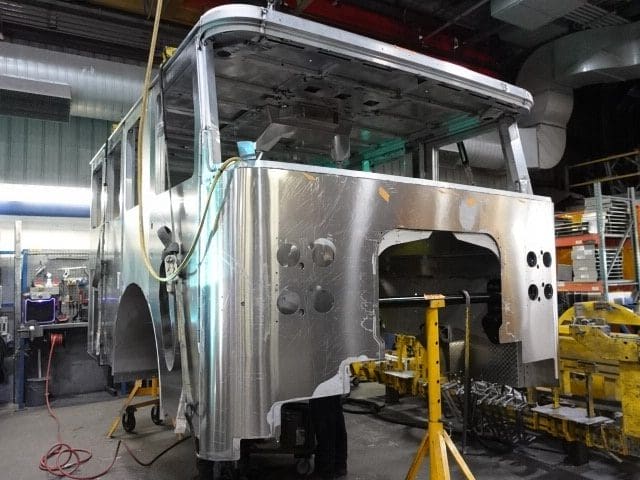

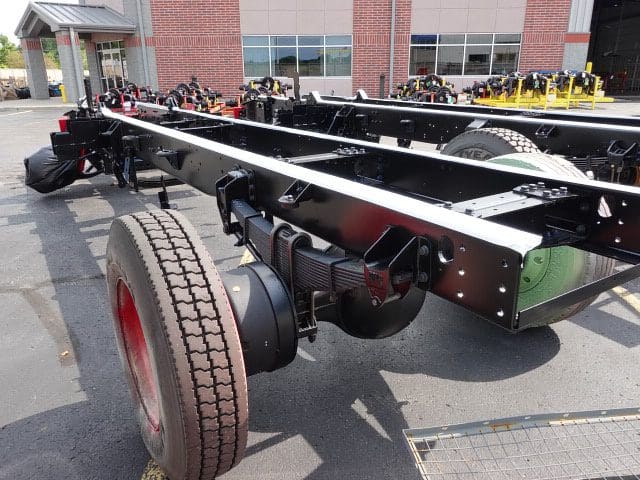

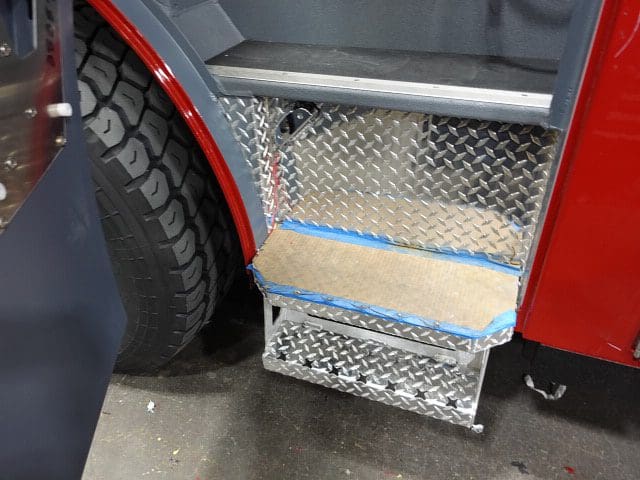

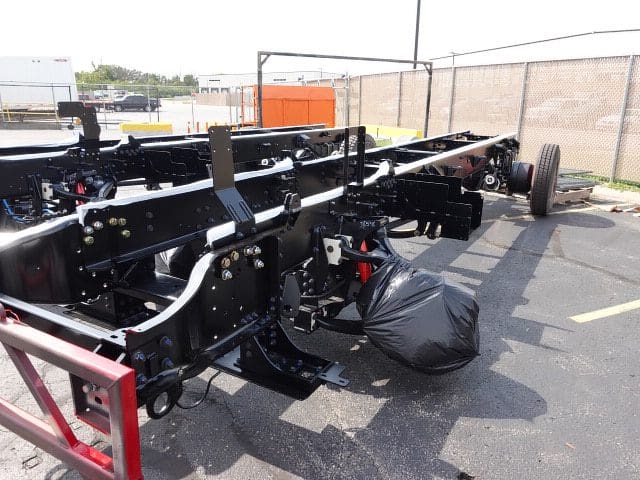

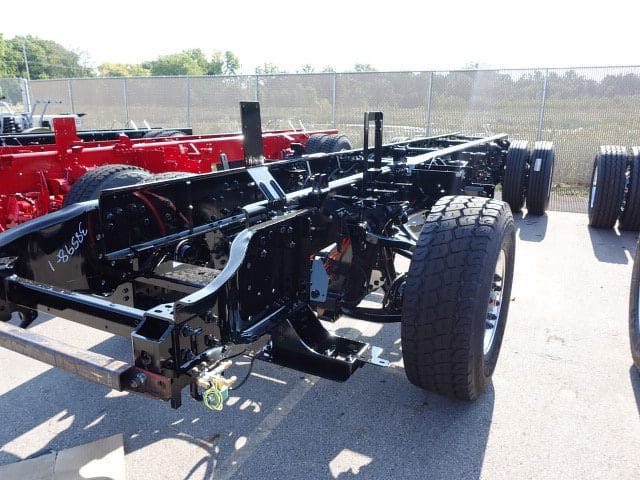

In this report, the cab continued through paint, the frame build began, the pump house structure was fabricated, and the body began fabrication.

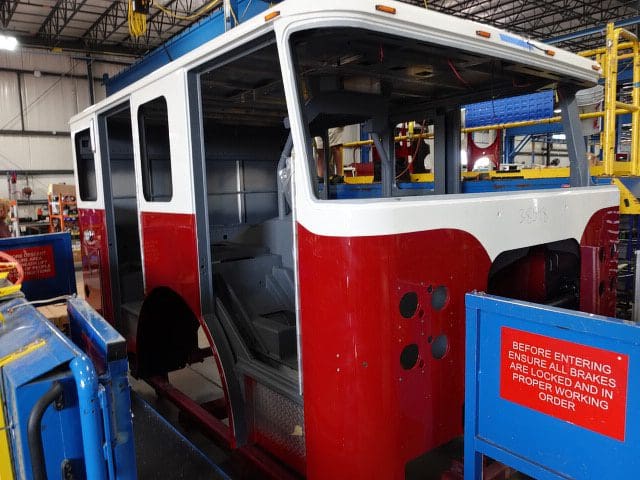

08-16-24

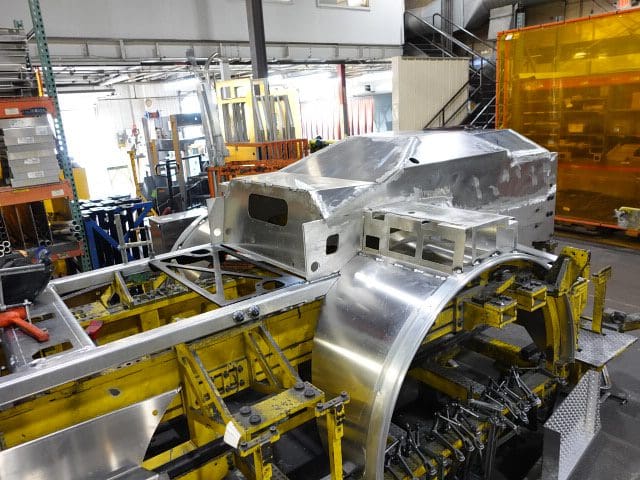

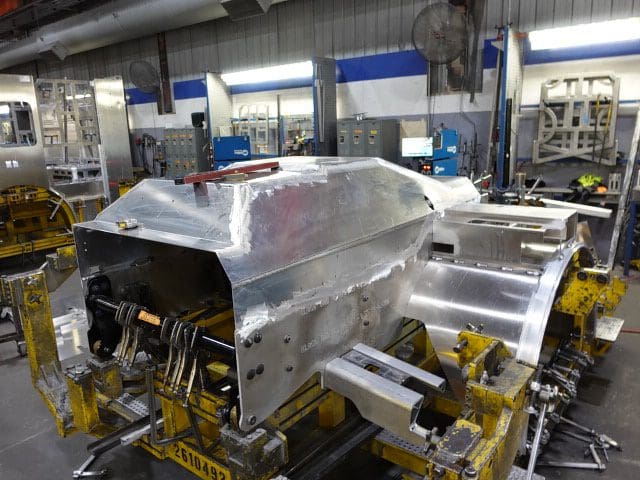

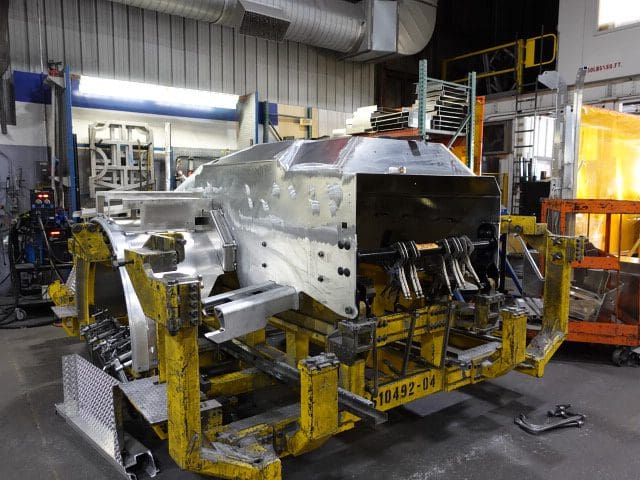

This new Pierce apparatus is now in production! In this report, the cab began fabrication.
