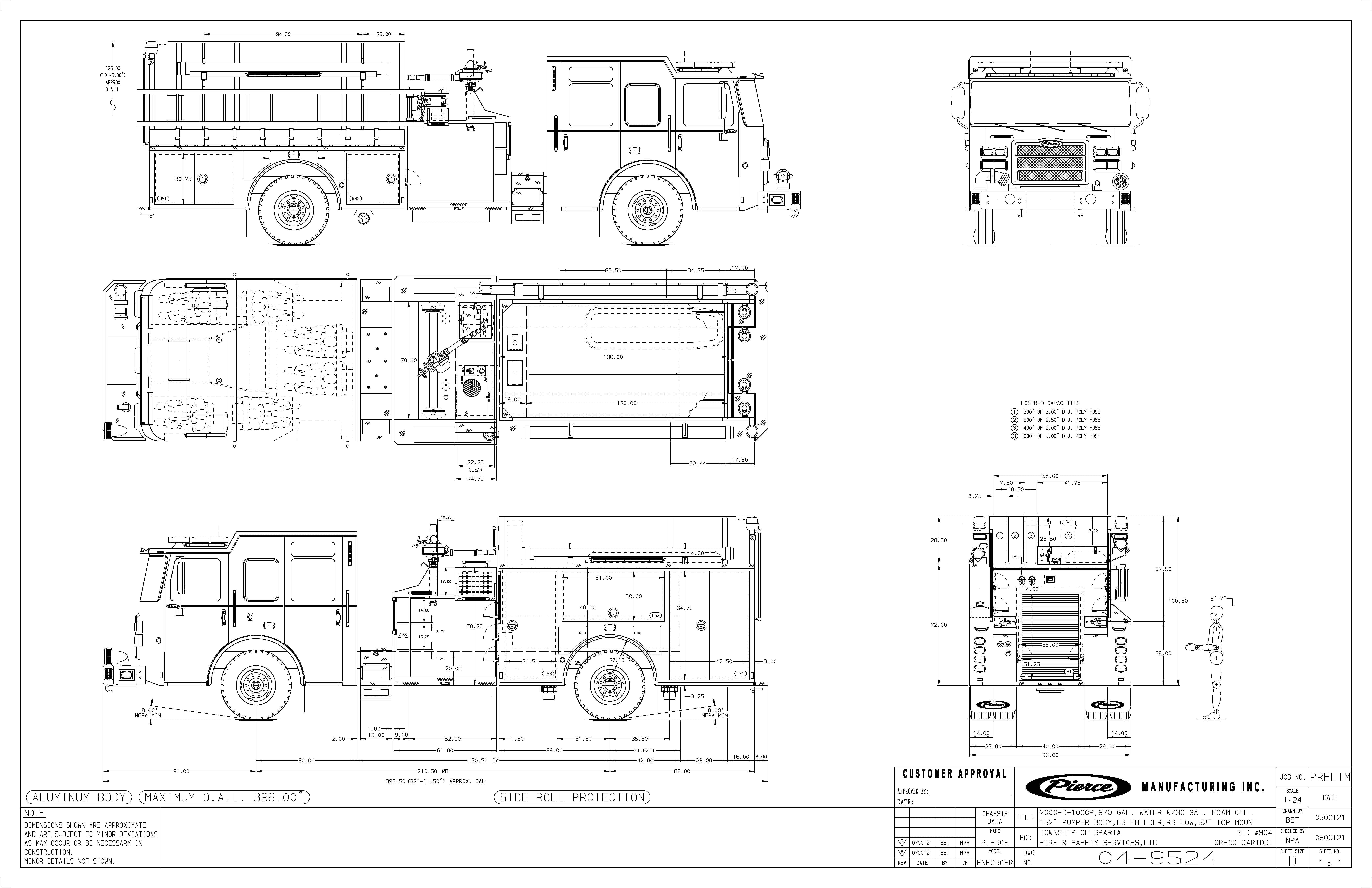

11-15-24

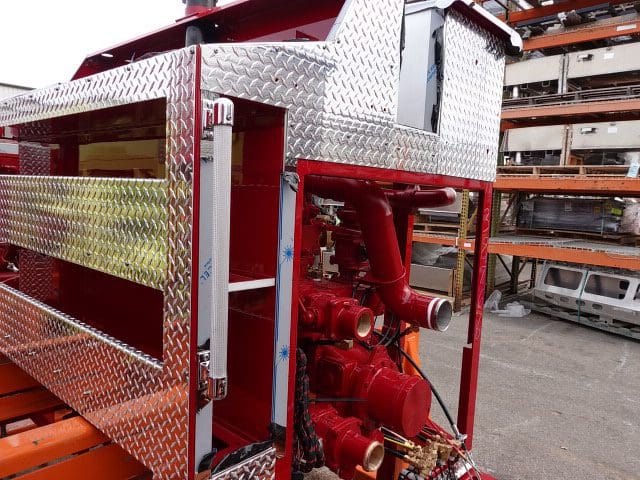

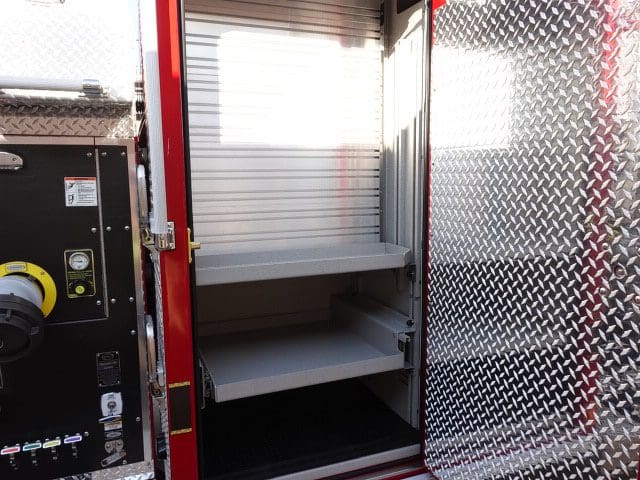

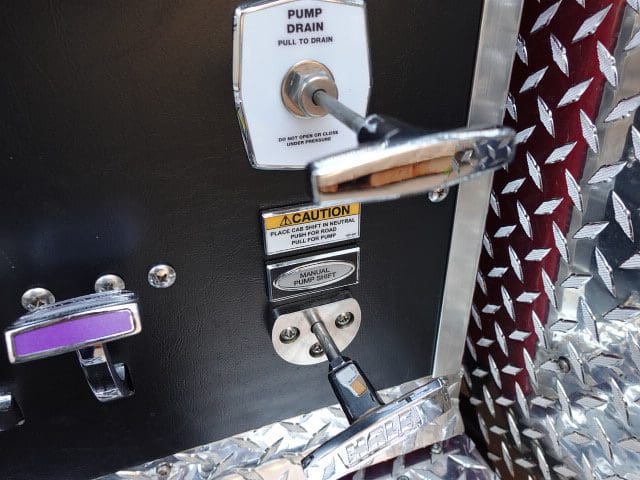

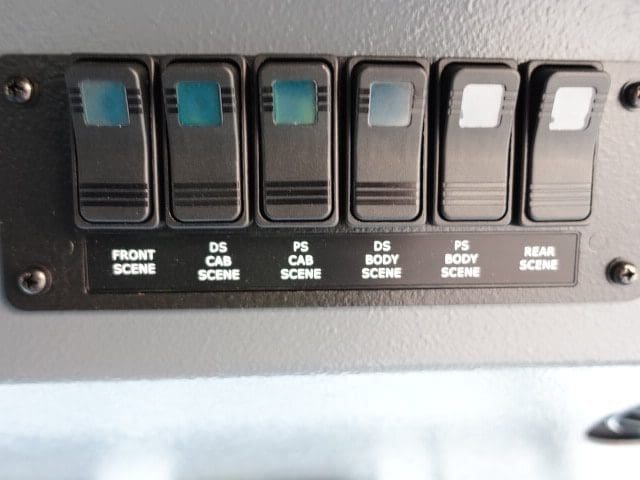

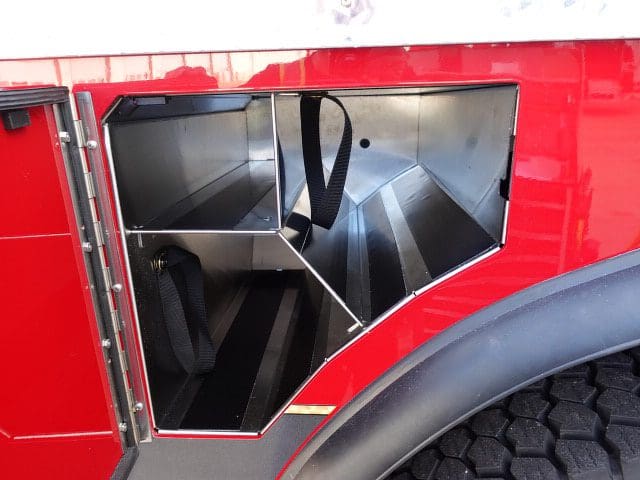

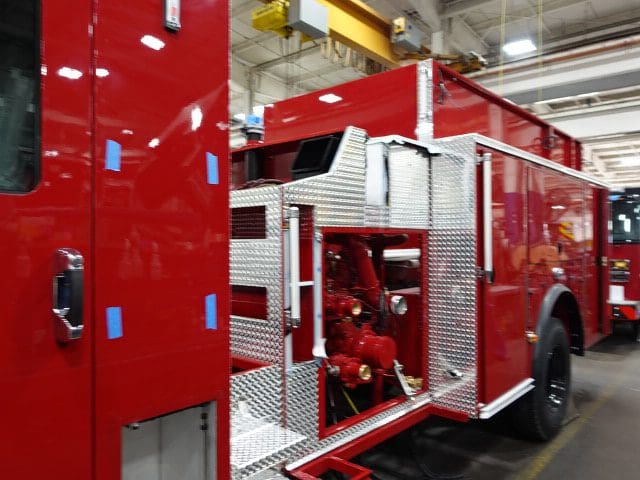

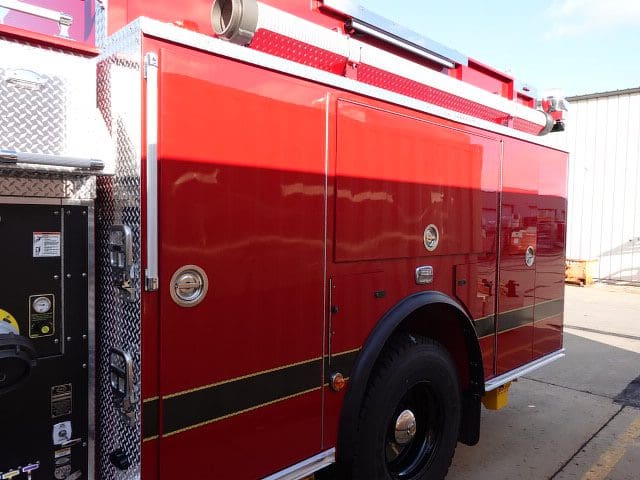

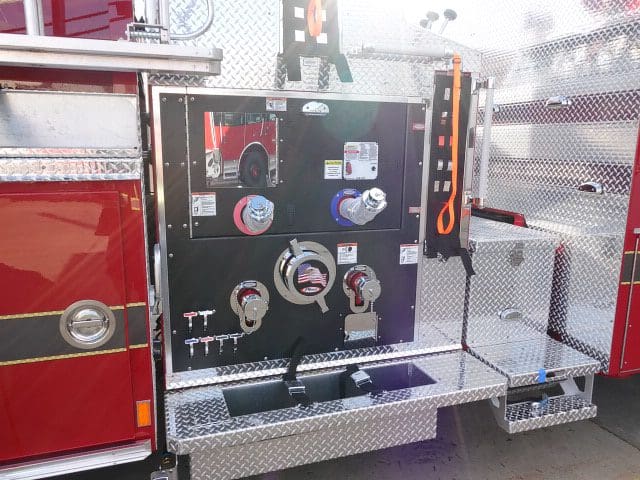

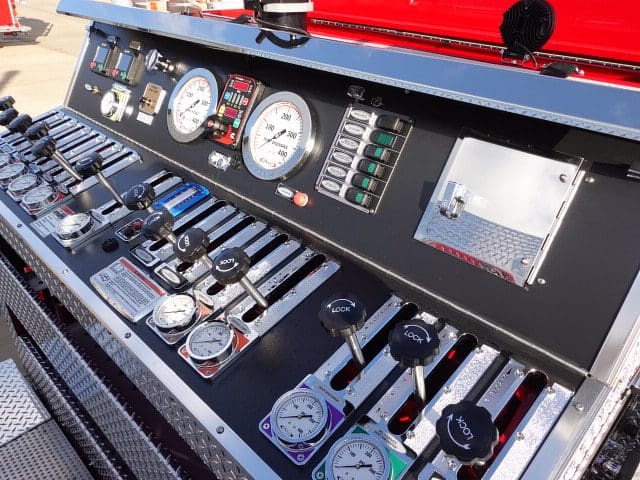

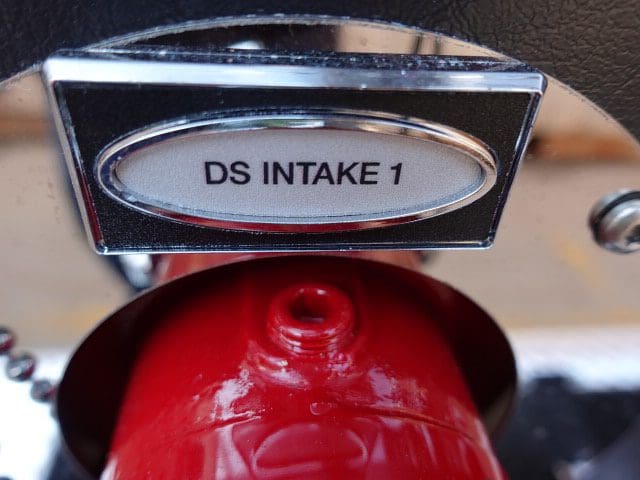

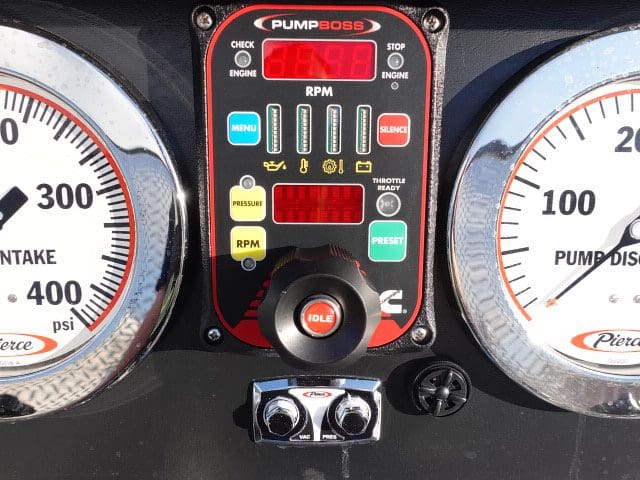

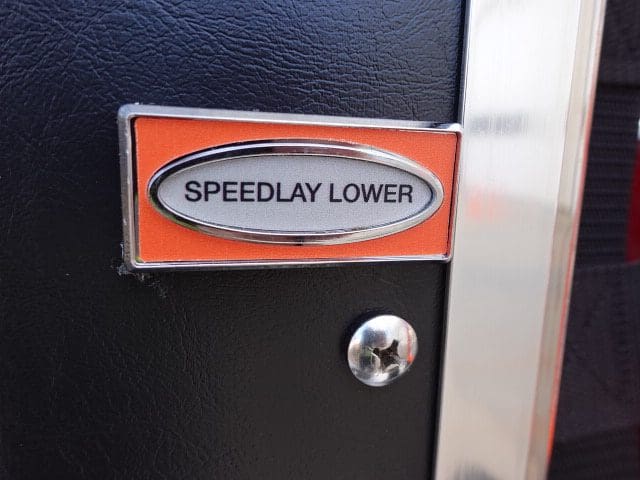

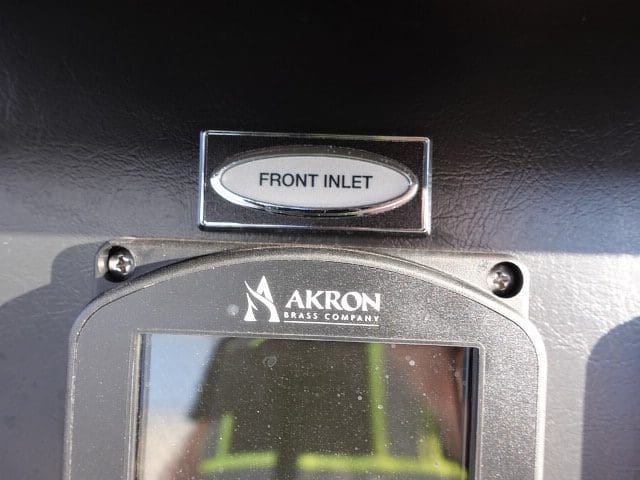

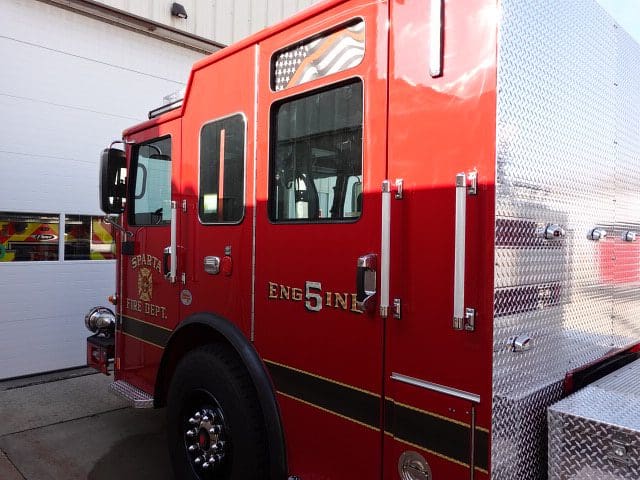

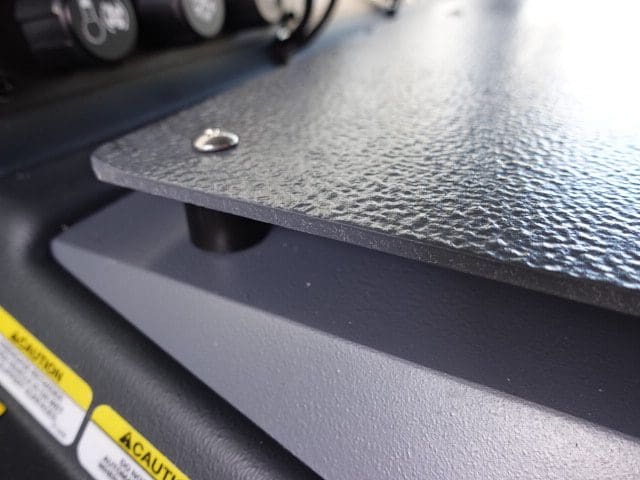

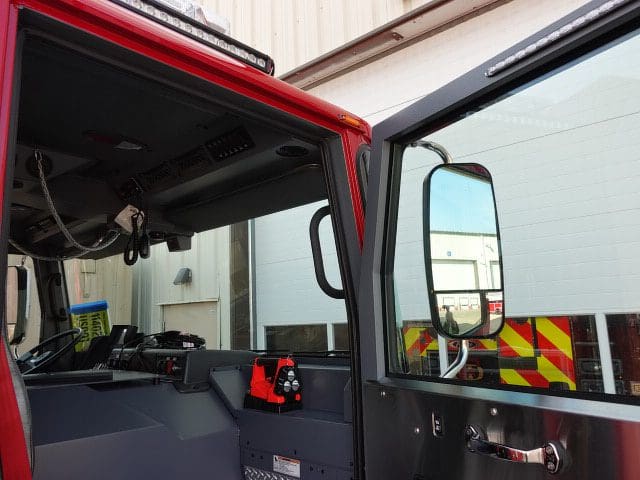

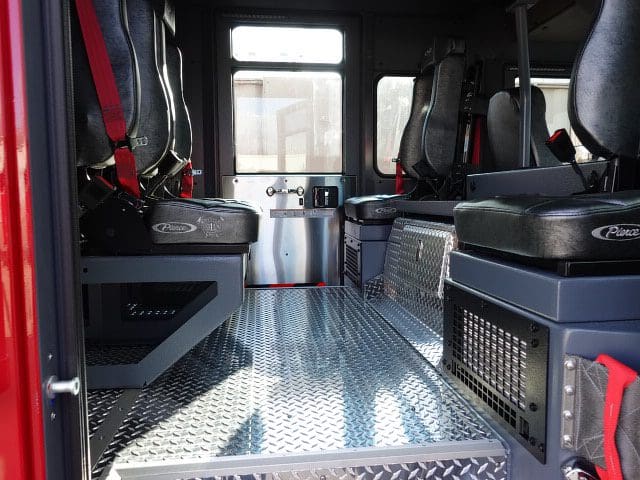

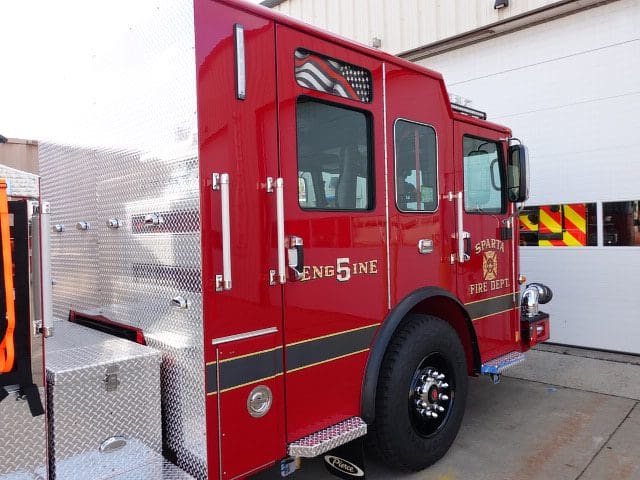

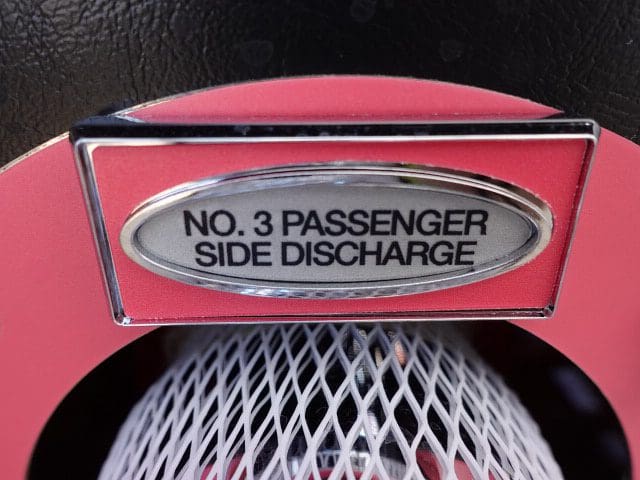

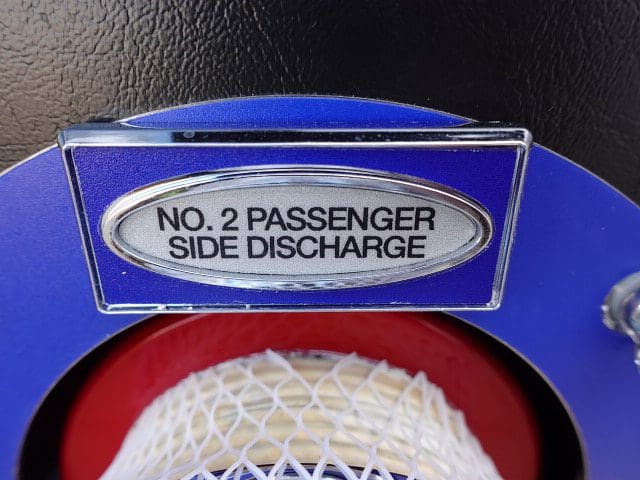

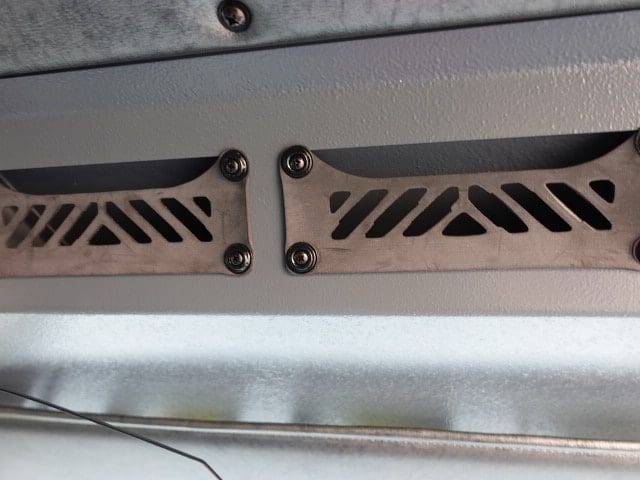

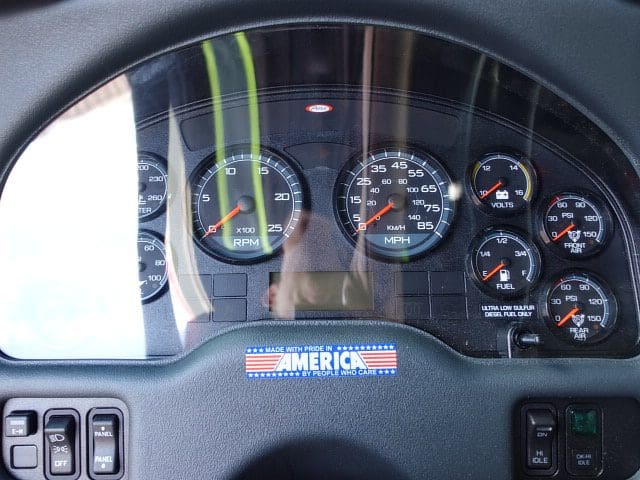

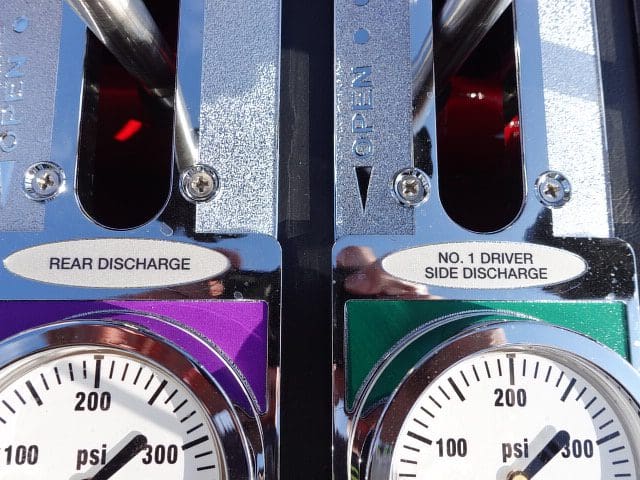

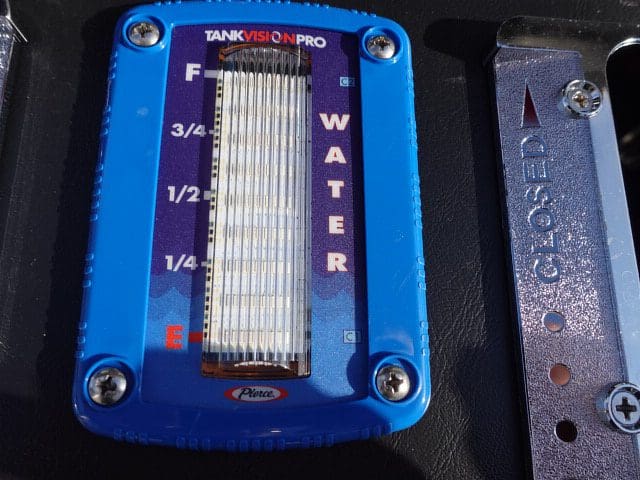

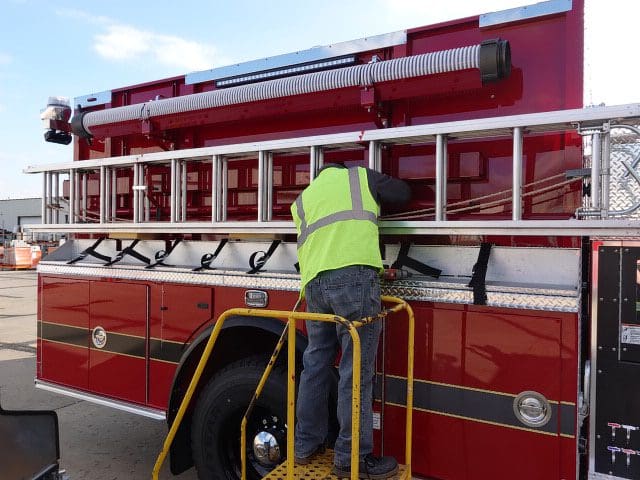

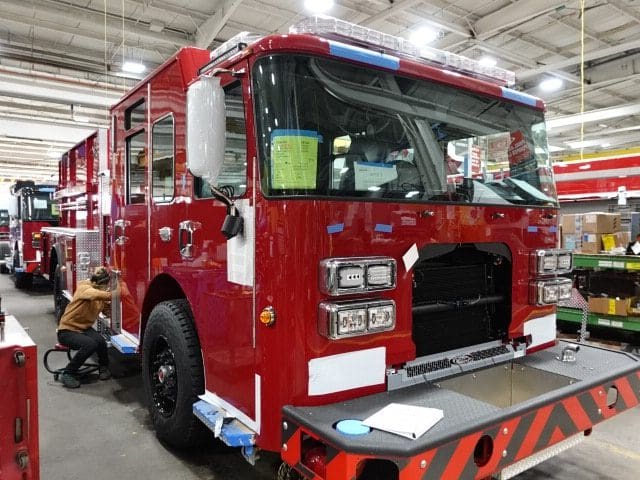

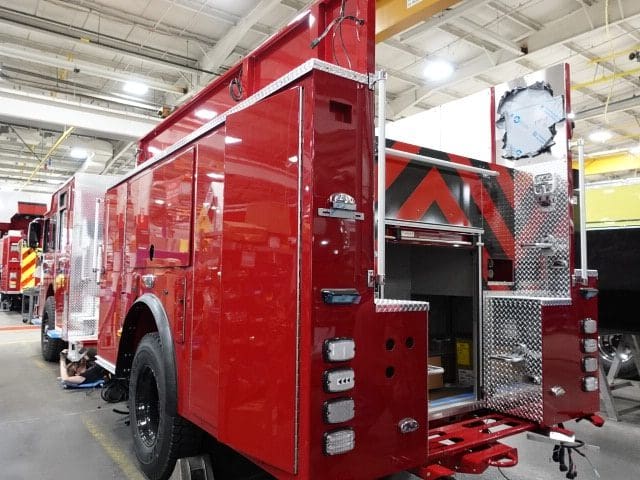

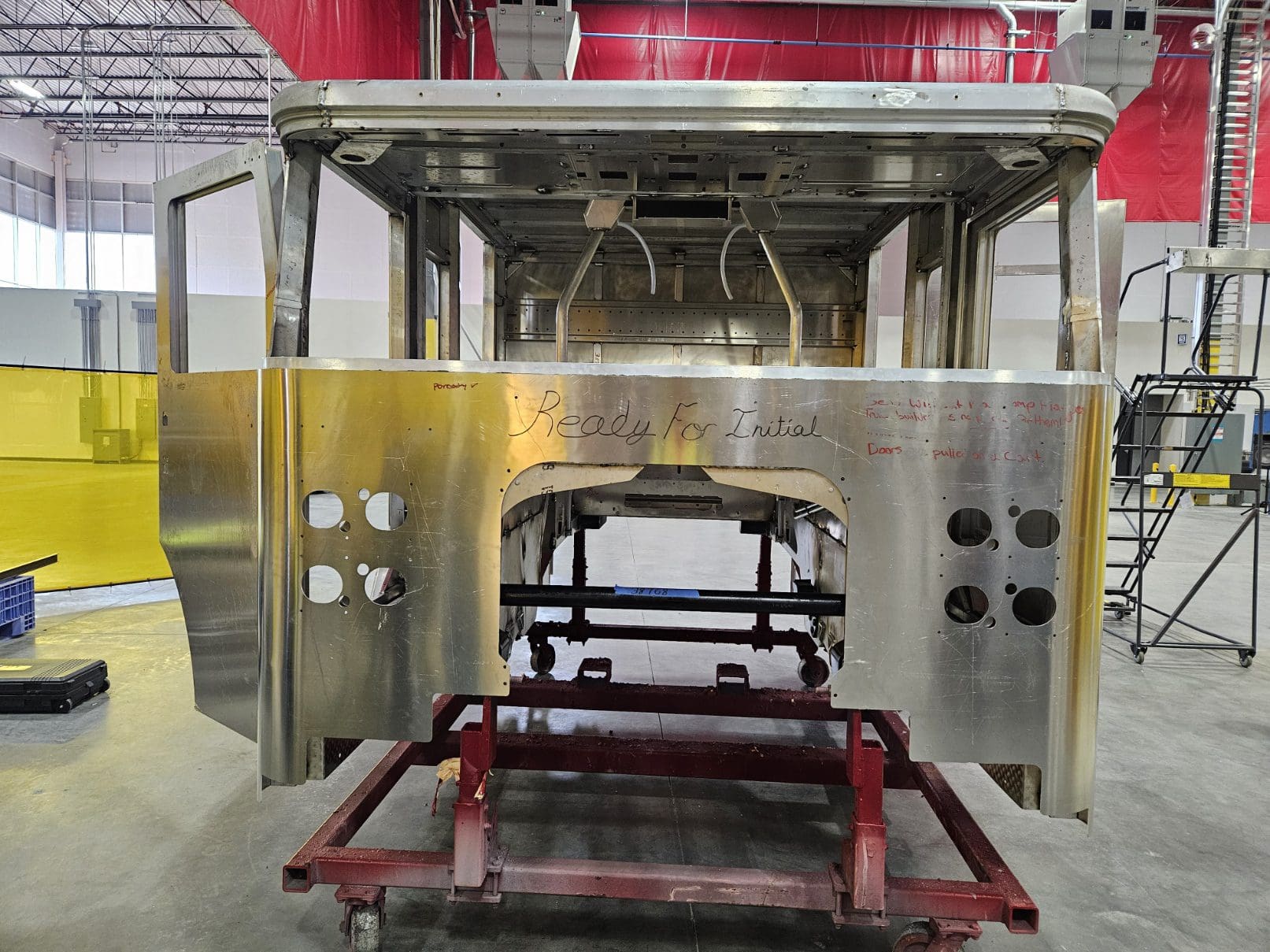

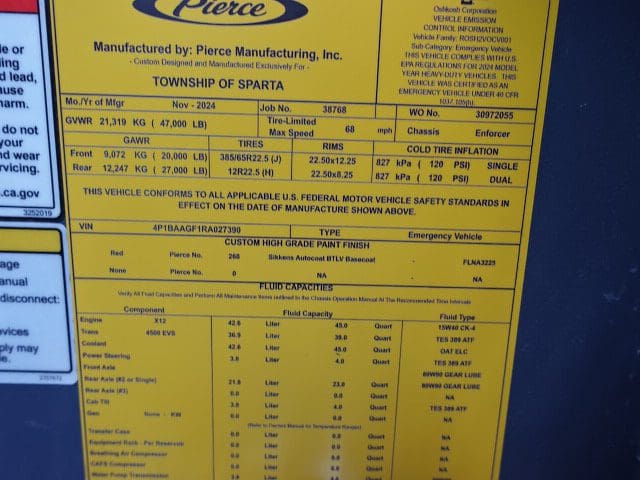

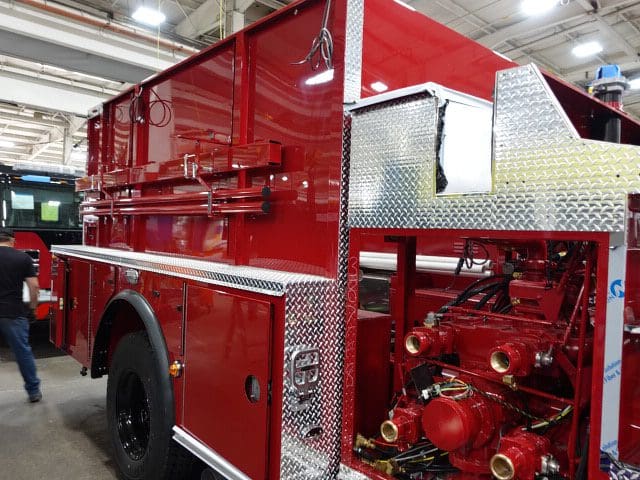

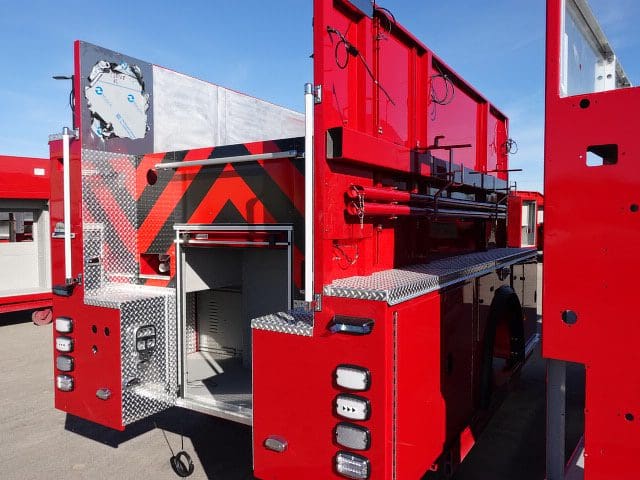

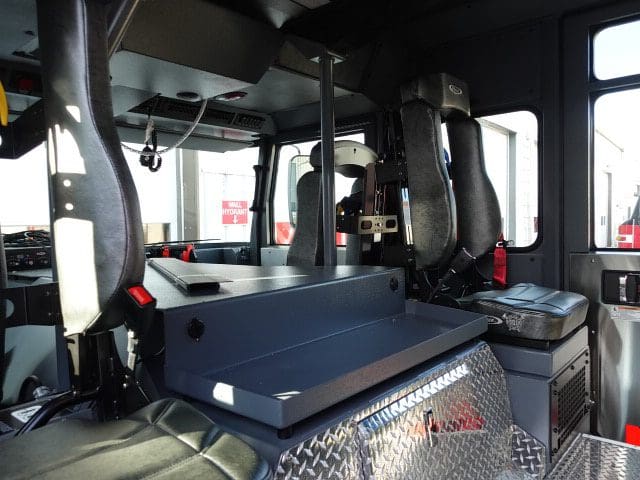

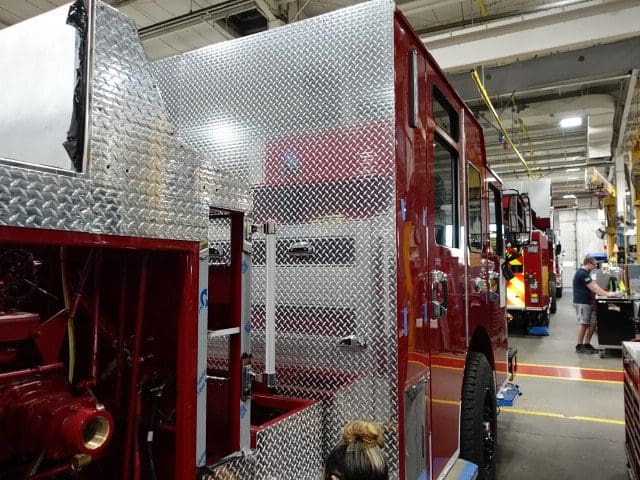

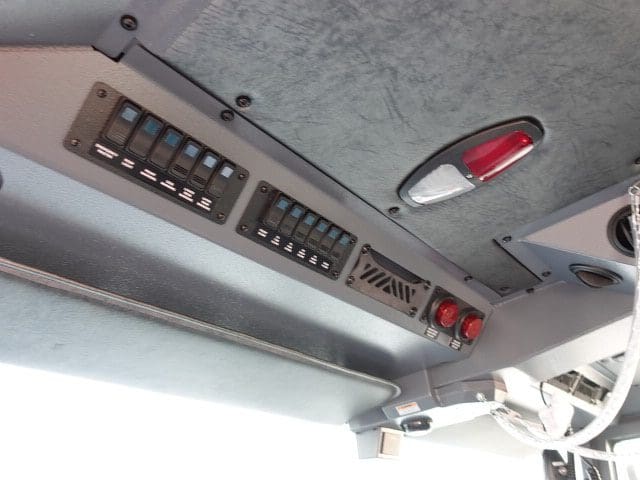

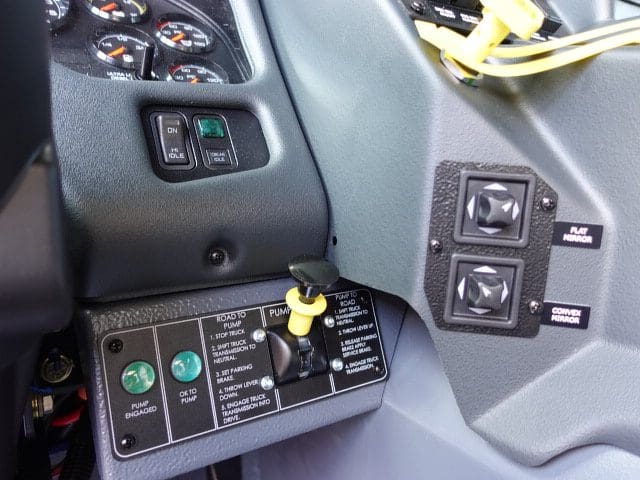

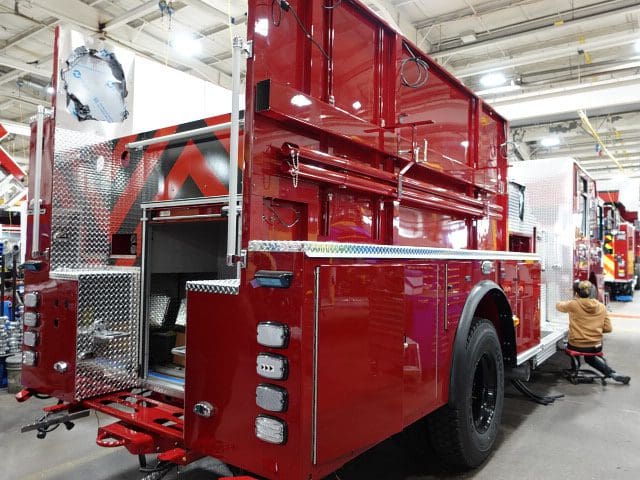

In this report, the apparatus completed final assembly and test followed by release to quality and graphics where any remaining content will be applied. Once finished, it will be made ready for the customer acceptance inspection. This is the last scheduled report.

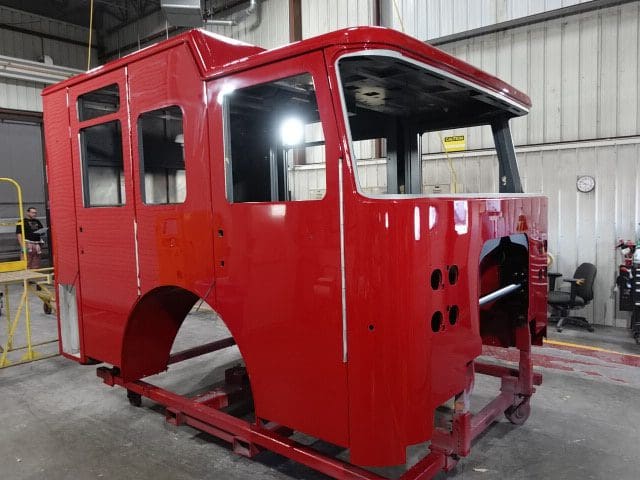

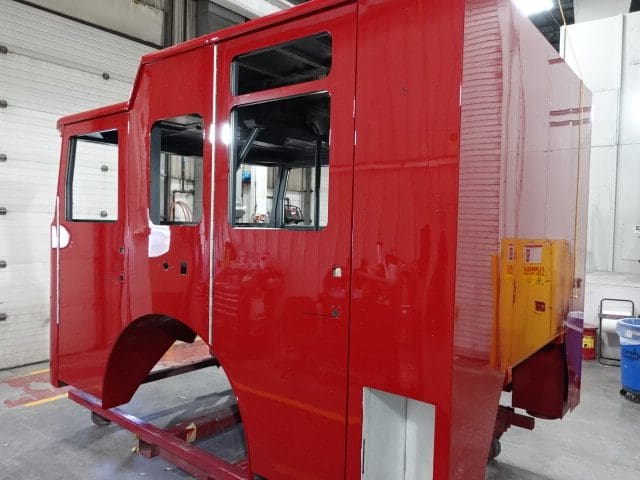

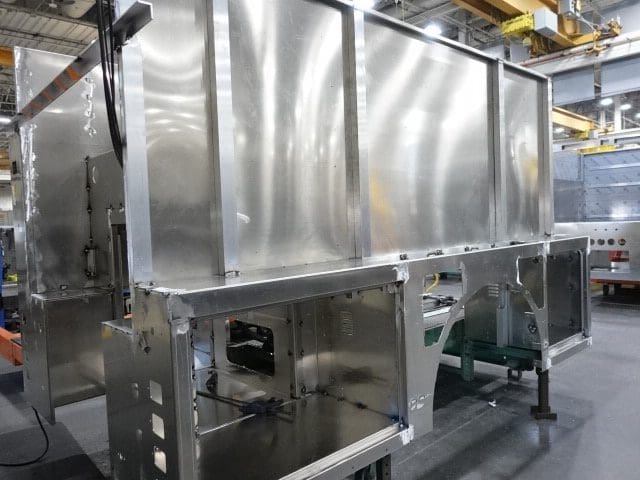

10-25-24

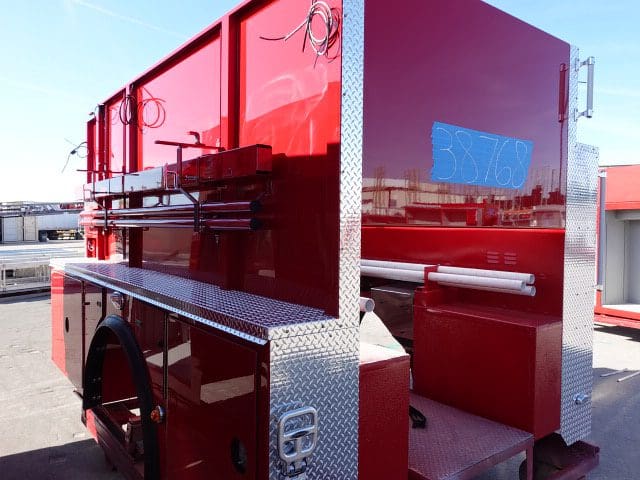

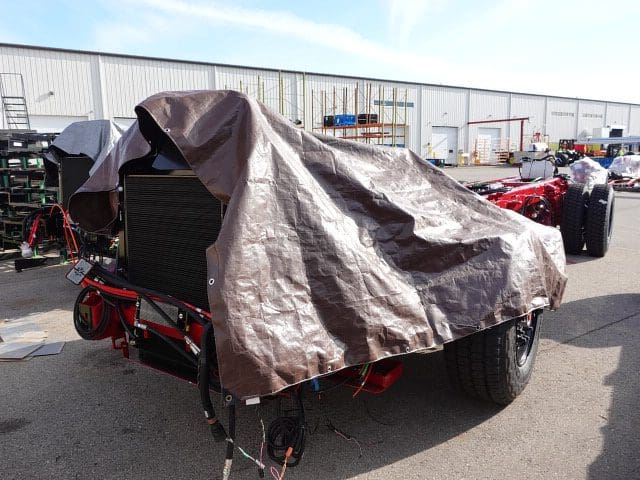

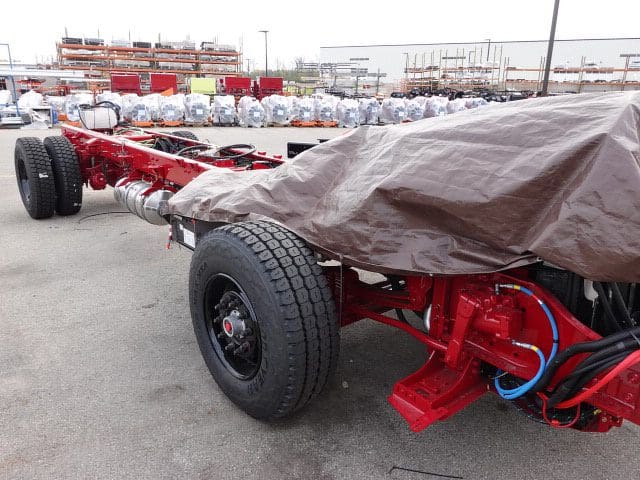

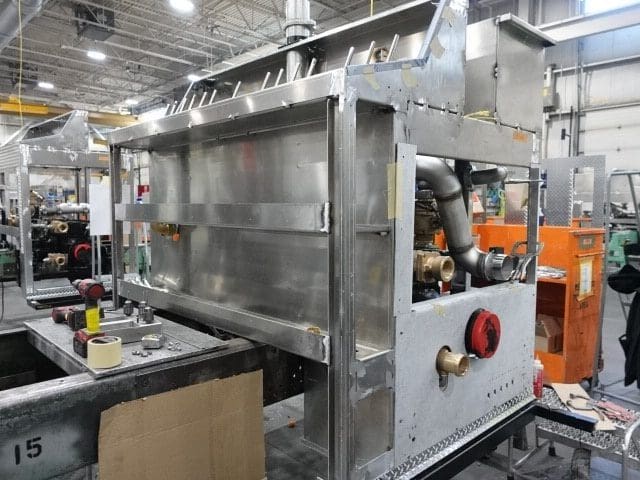

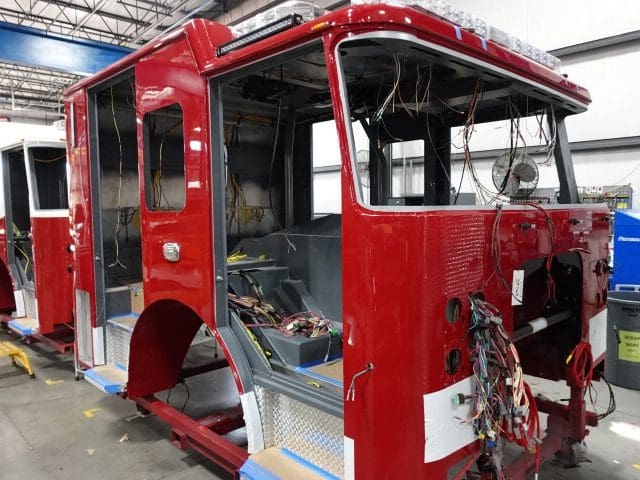

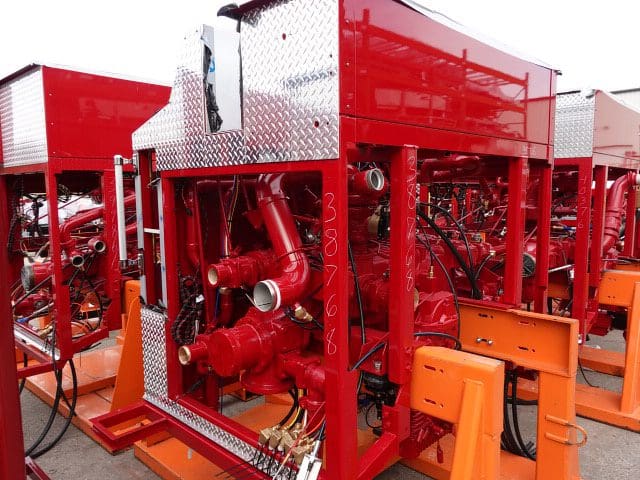

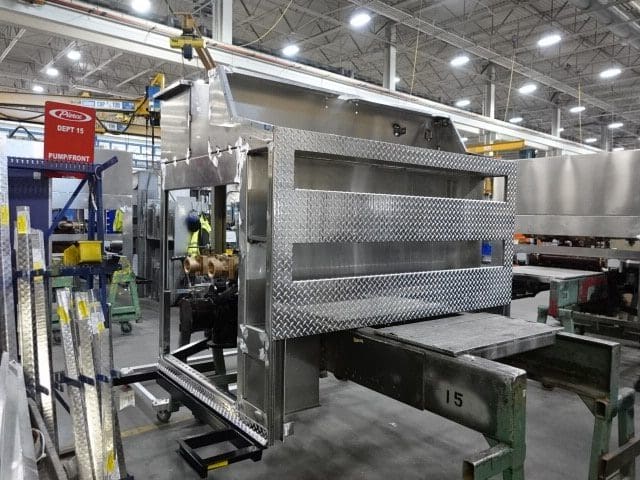

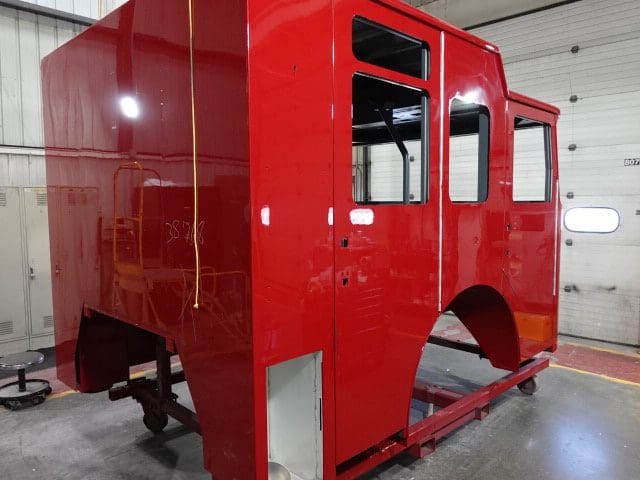

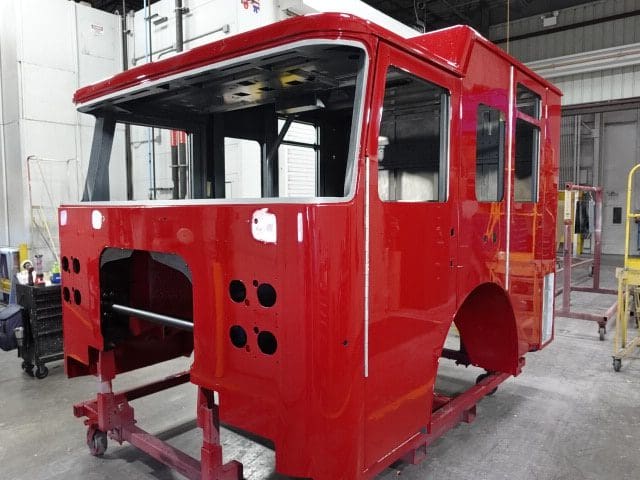

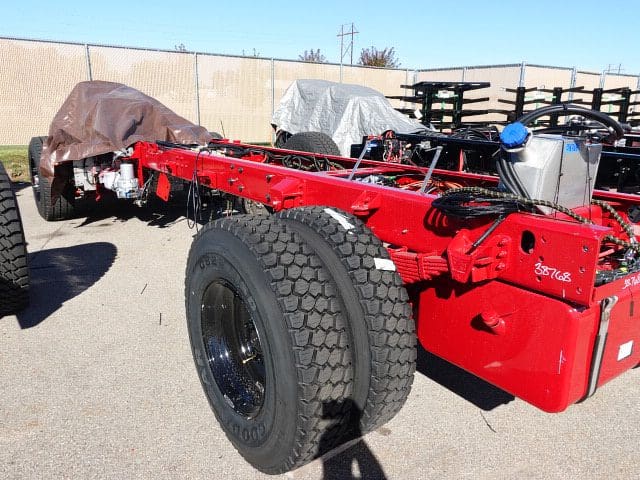

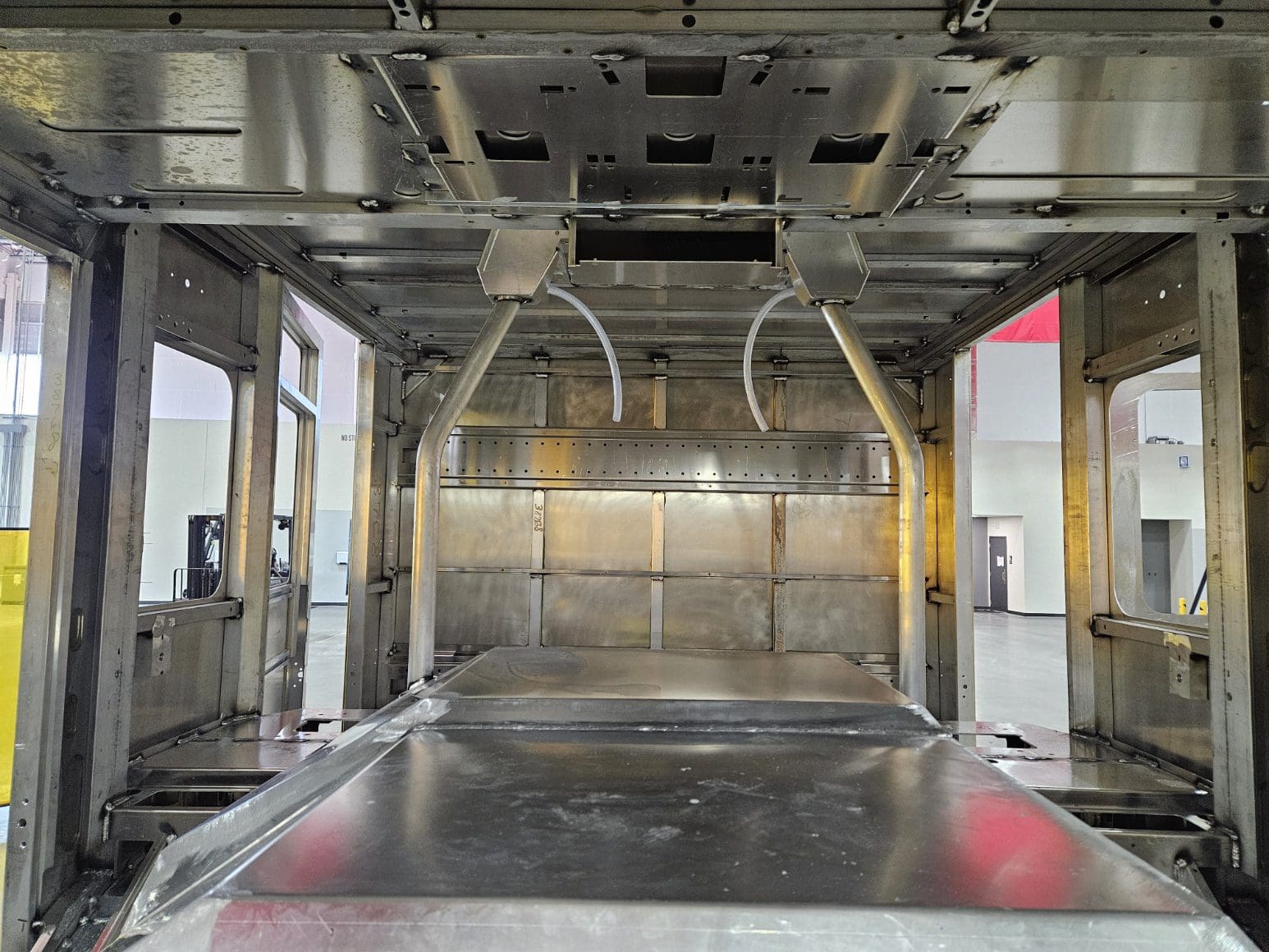

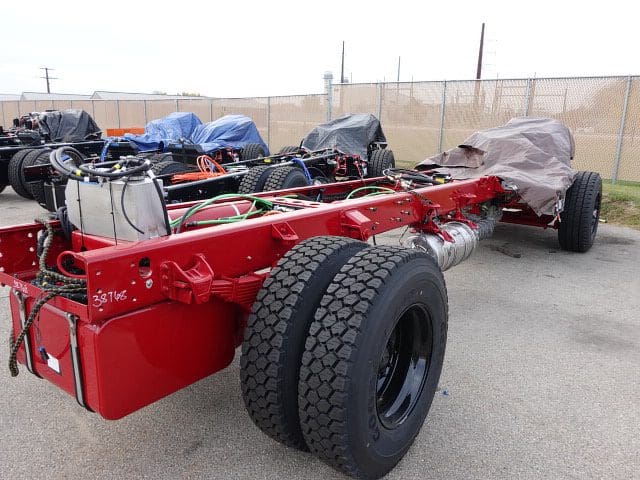

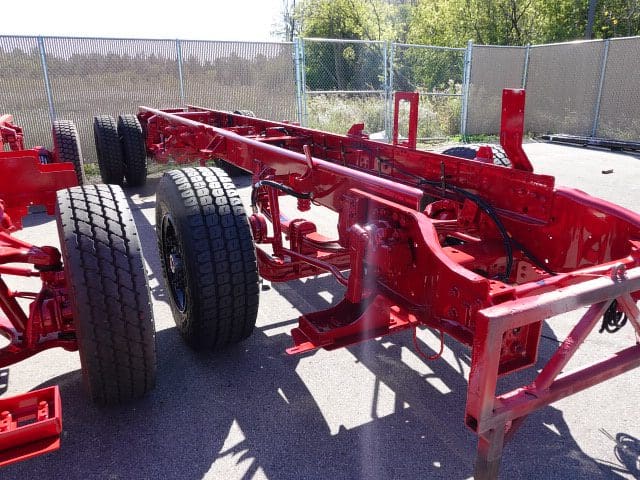

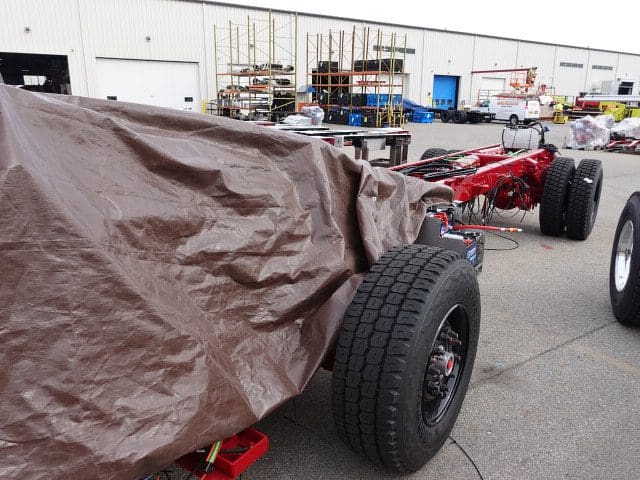

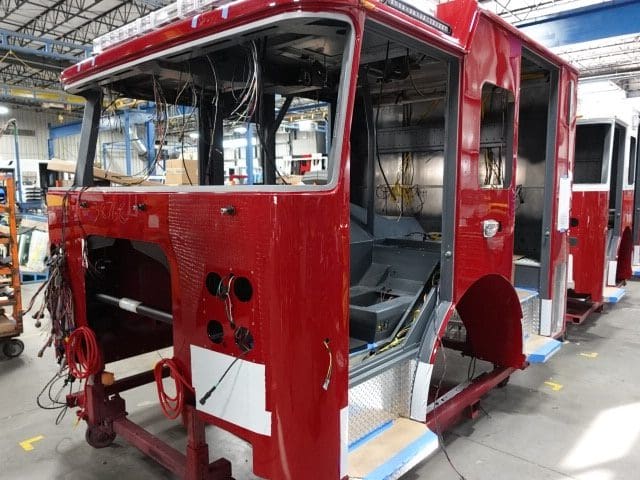

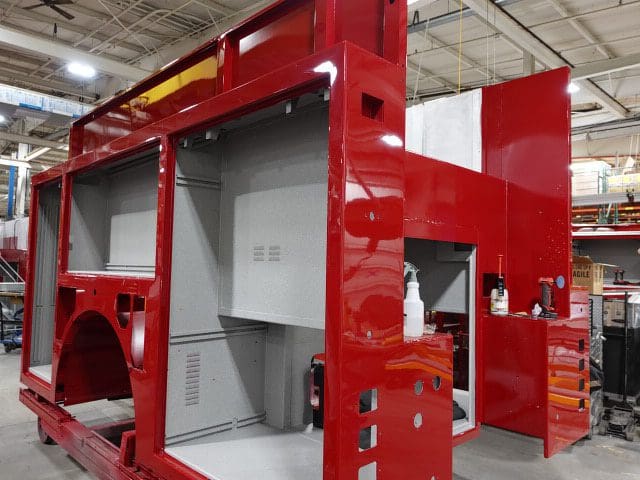

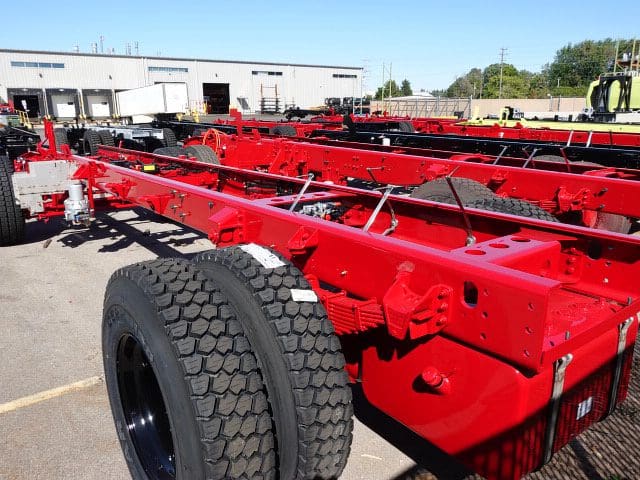

In this report, the cab completed paint and began initial assembly, the frame build continued, and the pump house and body completed initial assembly.

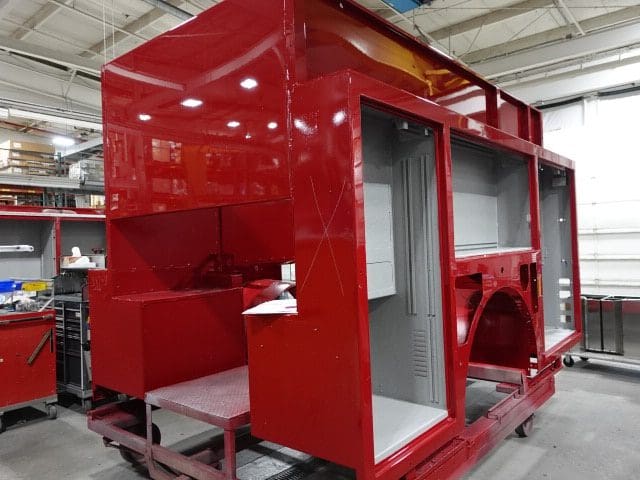

10-18-24

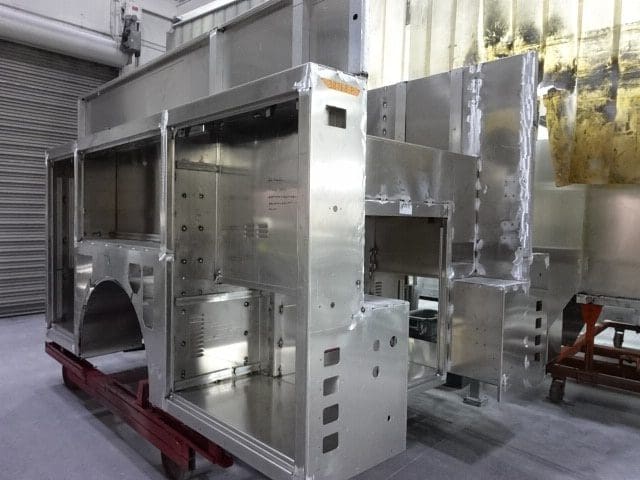

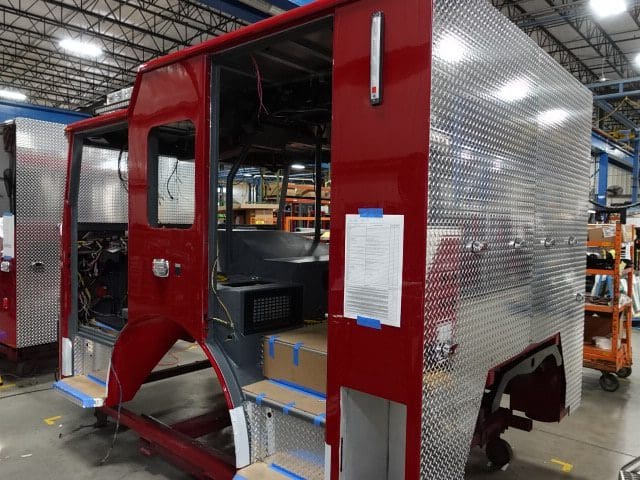

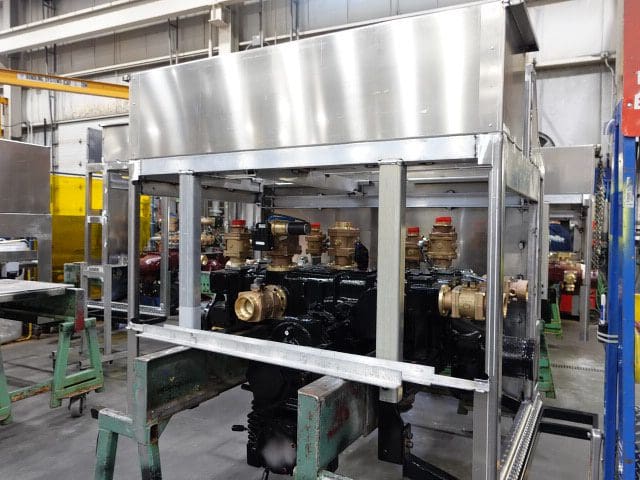

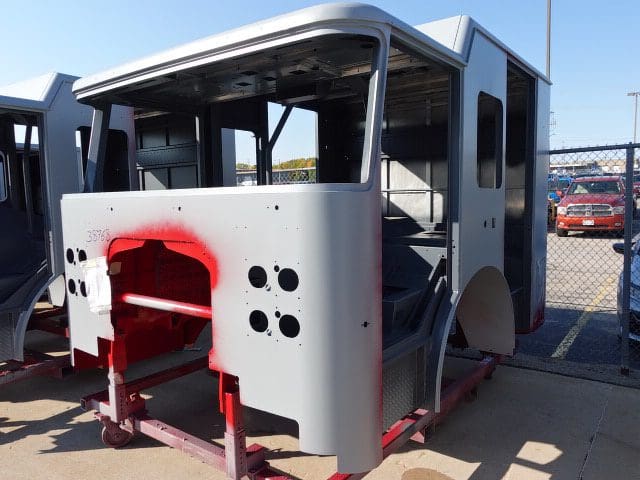

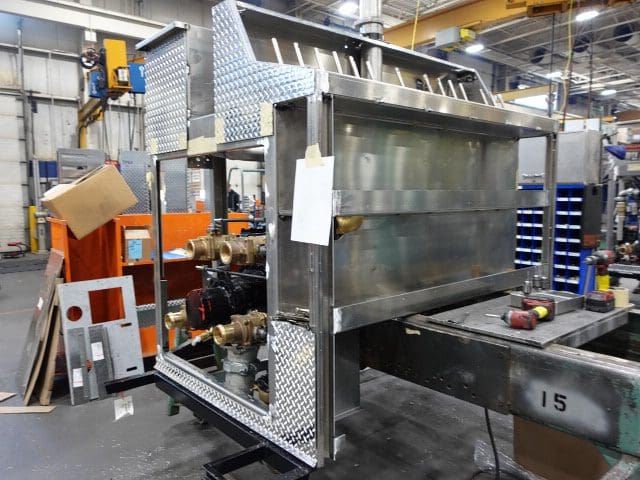

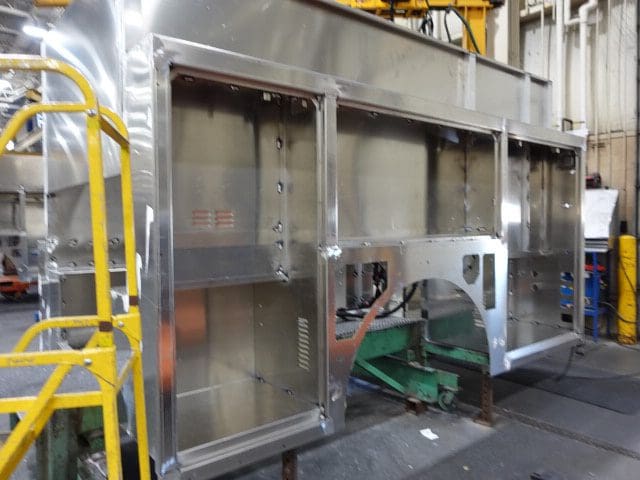

In this report your cab continued through paint, the frame build continued, the pump house was painted, and the body completed paint and began initial assembly.

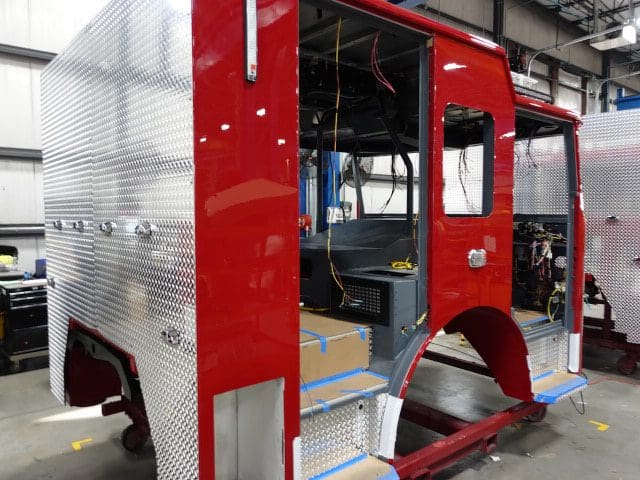

10-11-24

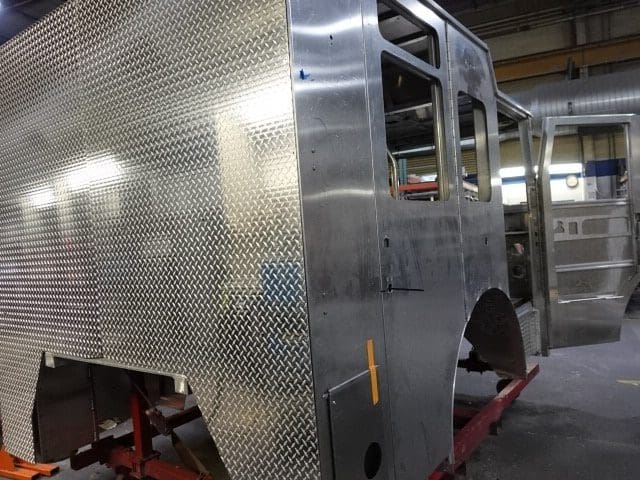

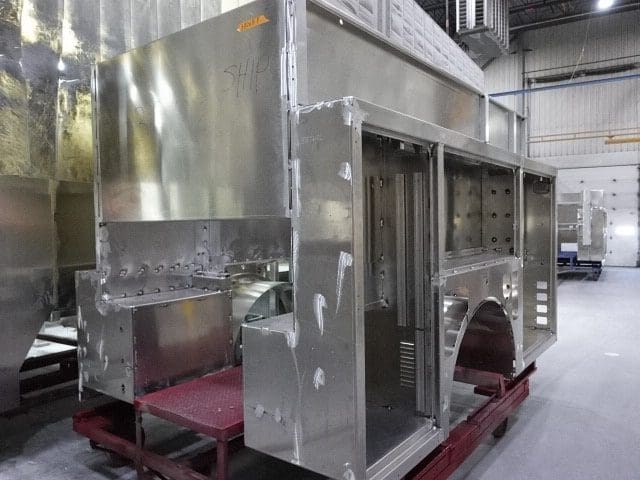

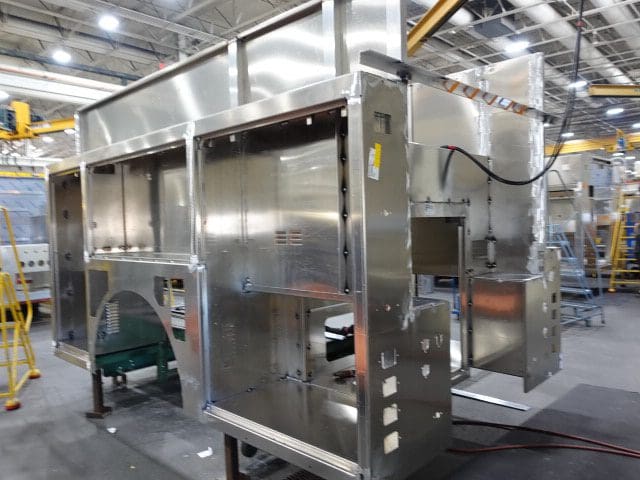

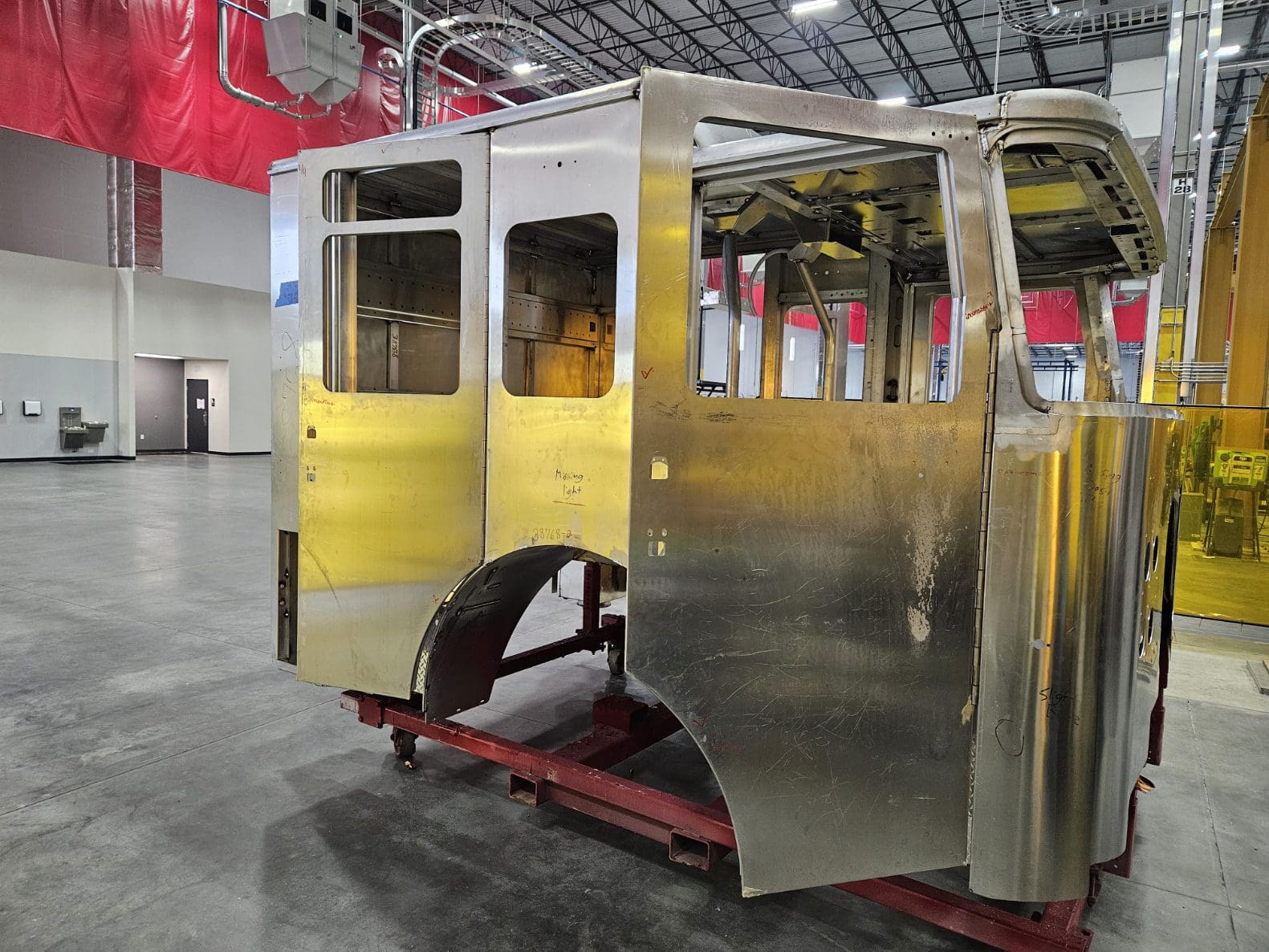

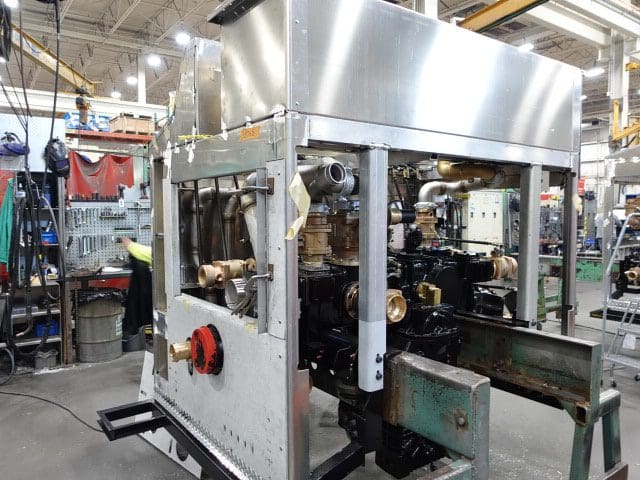

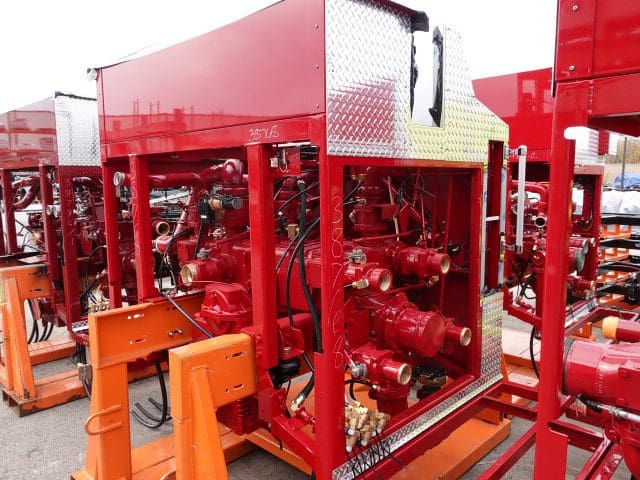

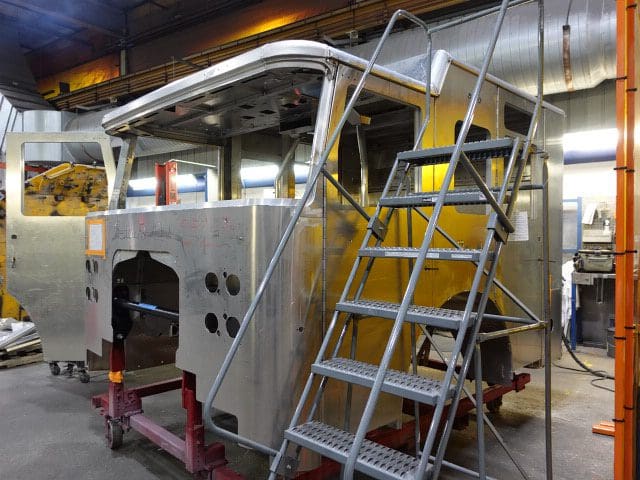

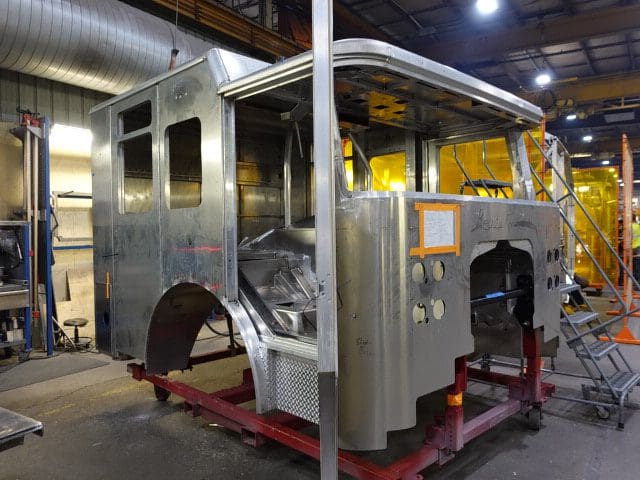

In this report, the cab completed fabrication and began the paint process, the frame build continued, the pump house continued initial assembly, and the body completed fabrication and began the paint process.

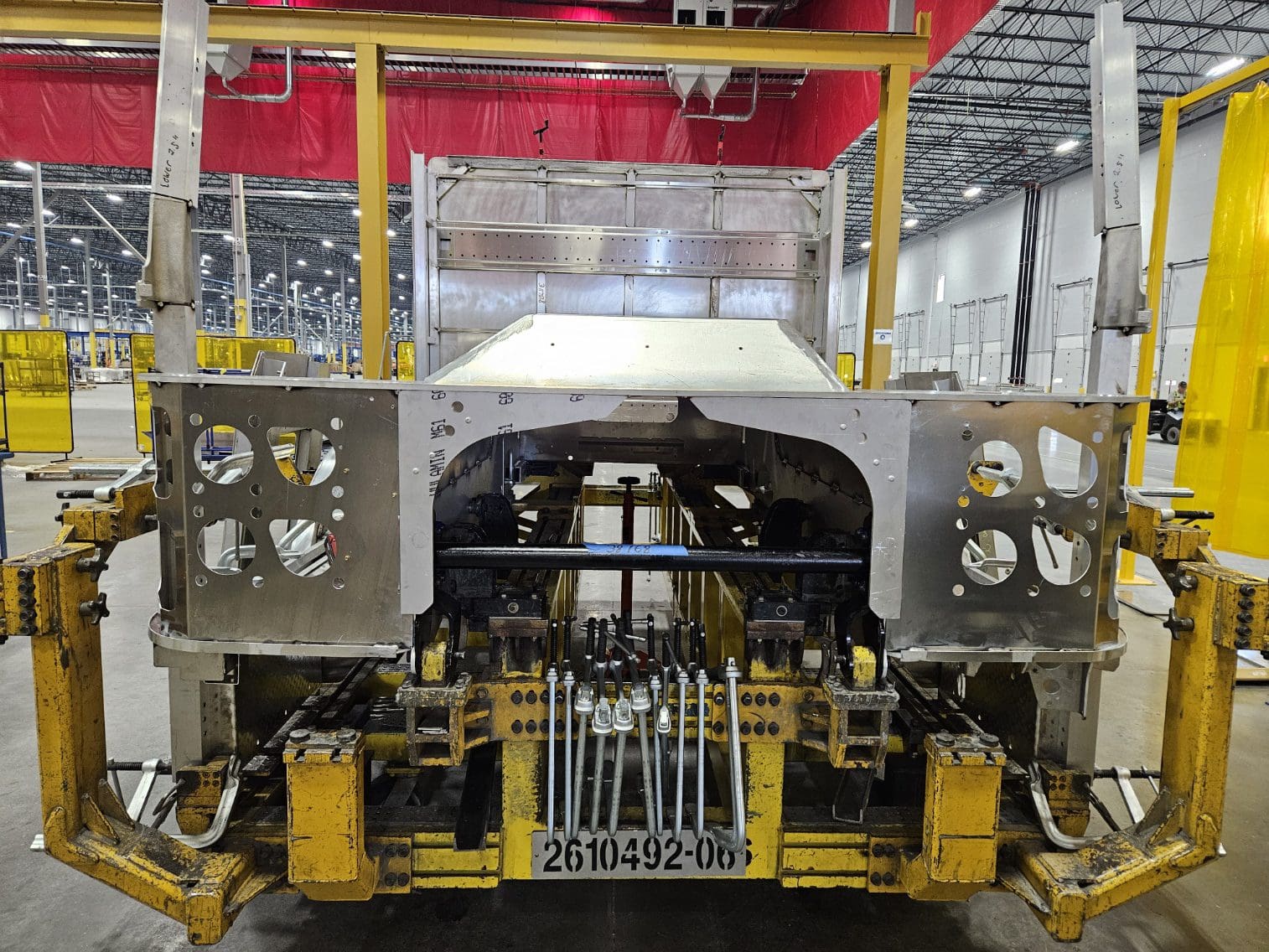

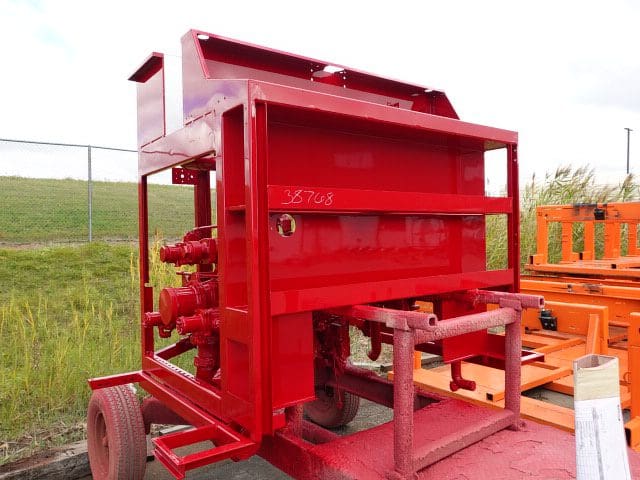

10-04-24

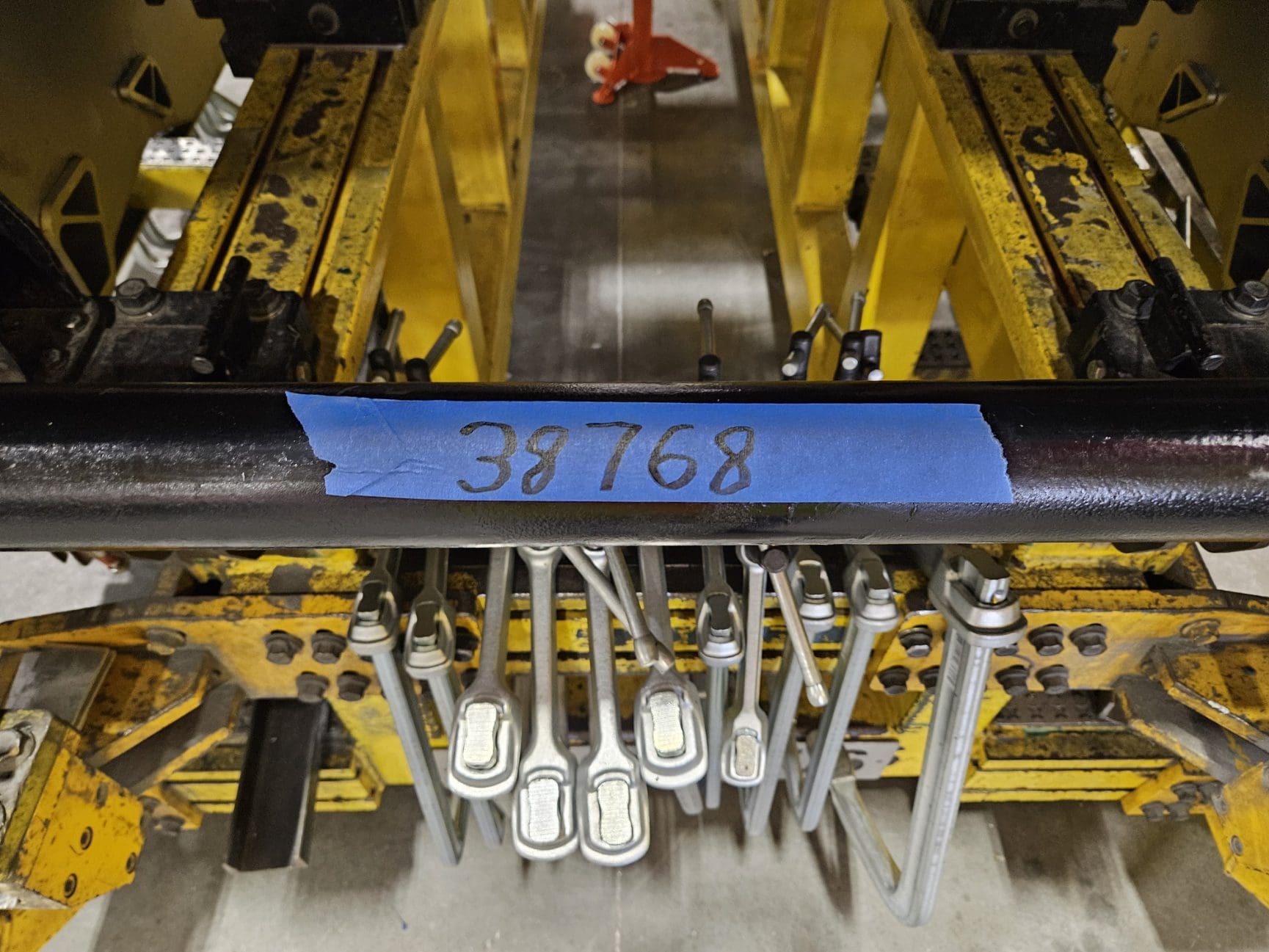

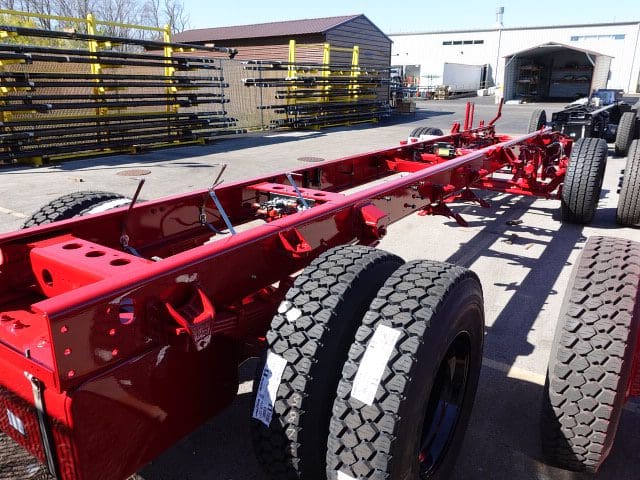

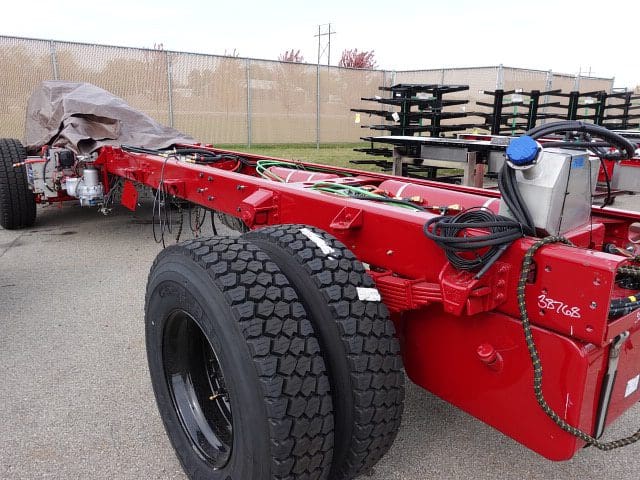

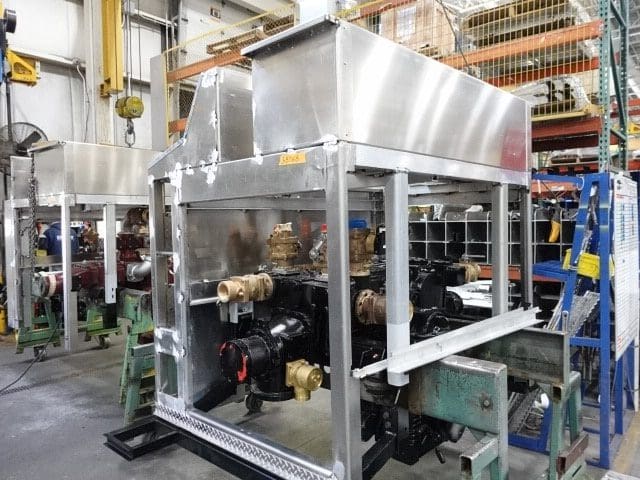

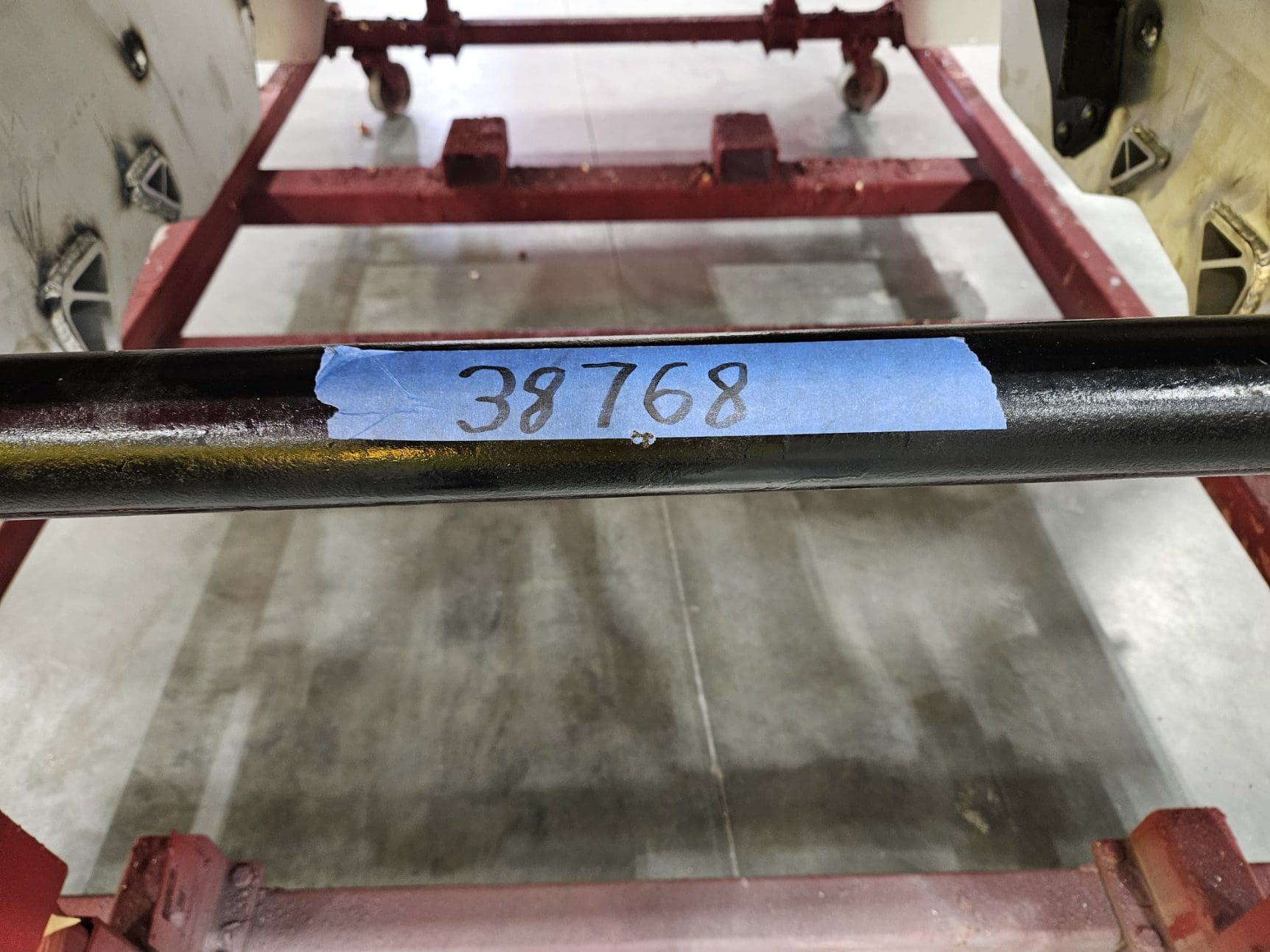

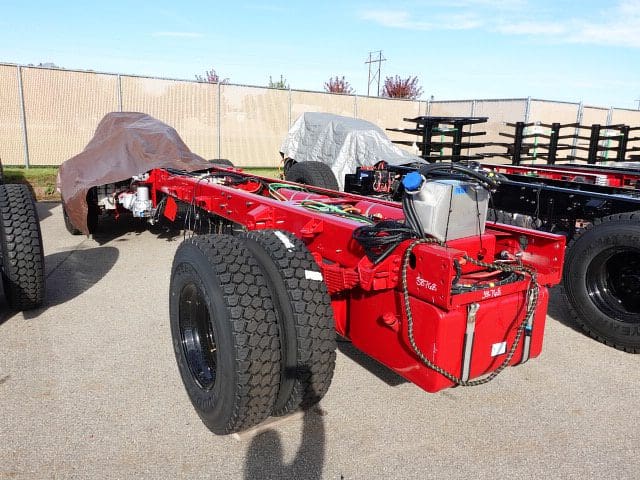

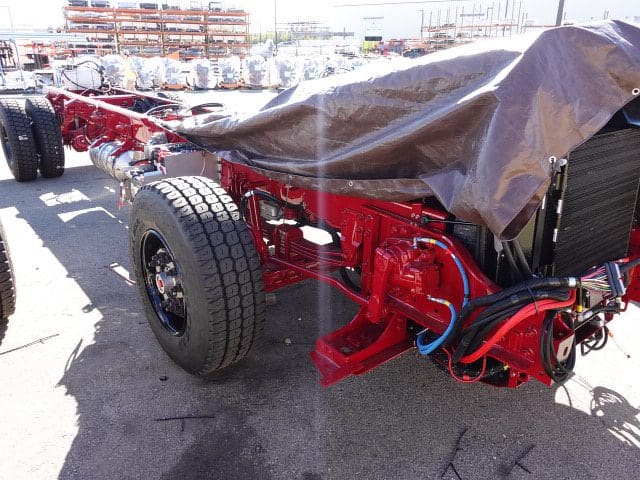

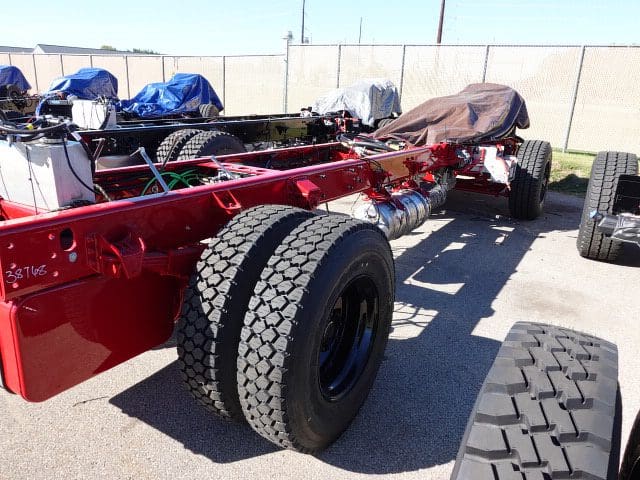

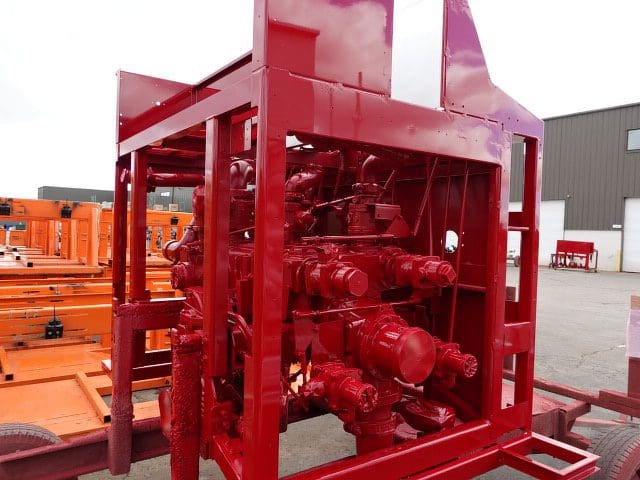

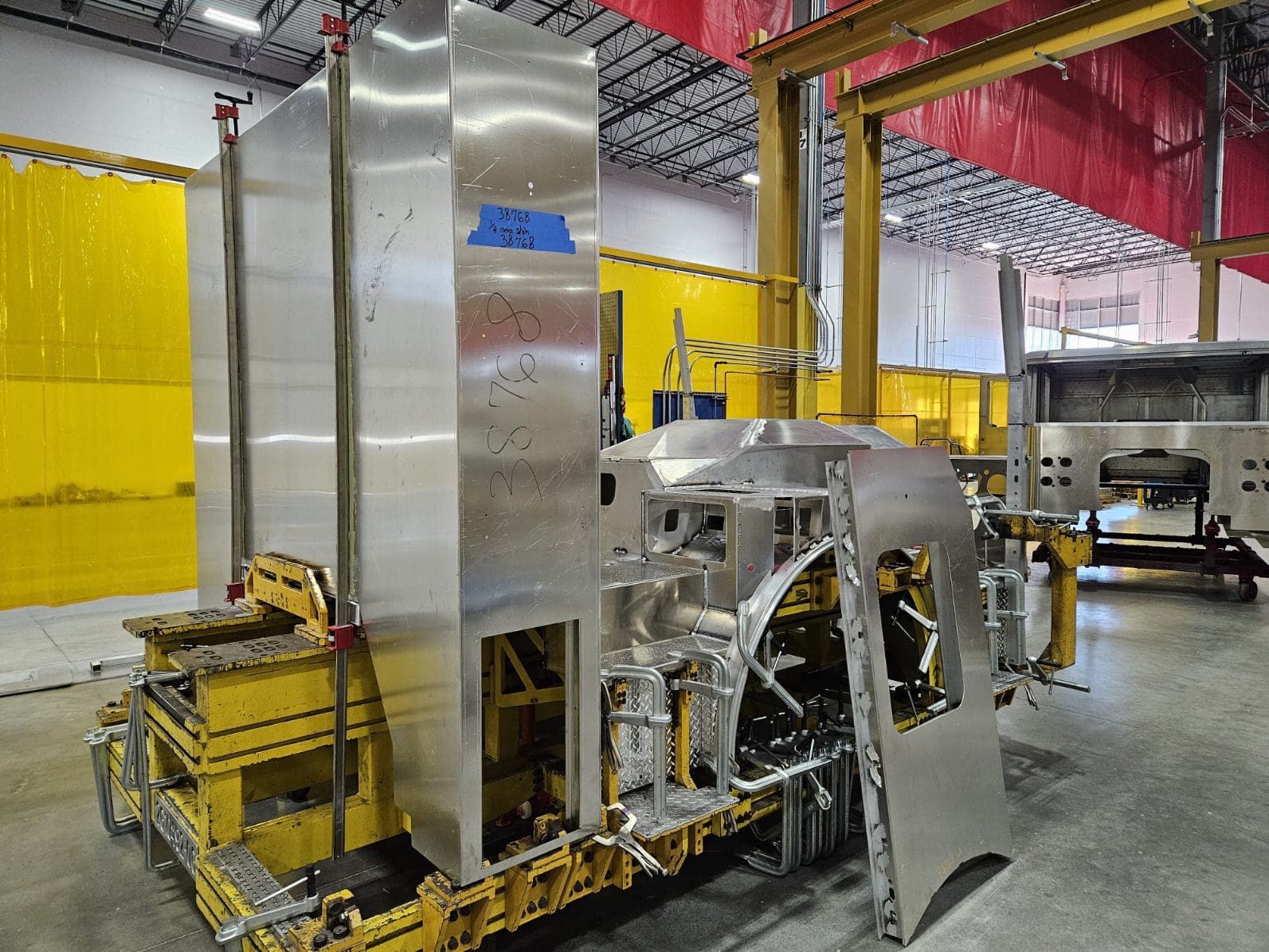

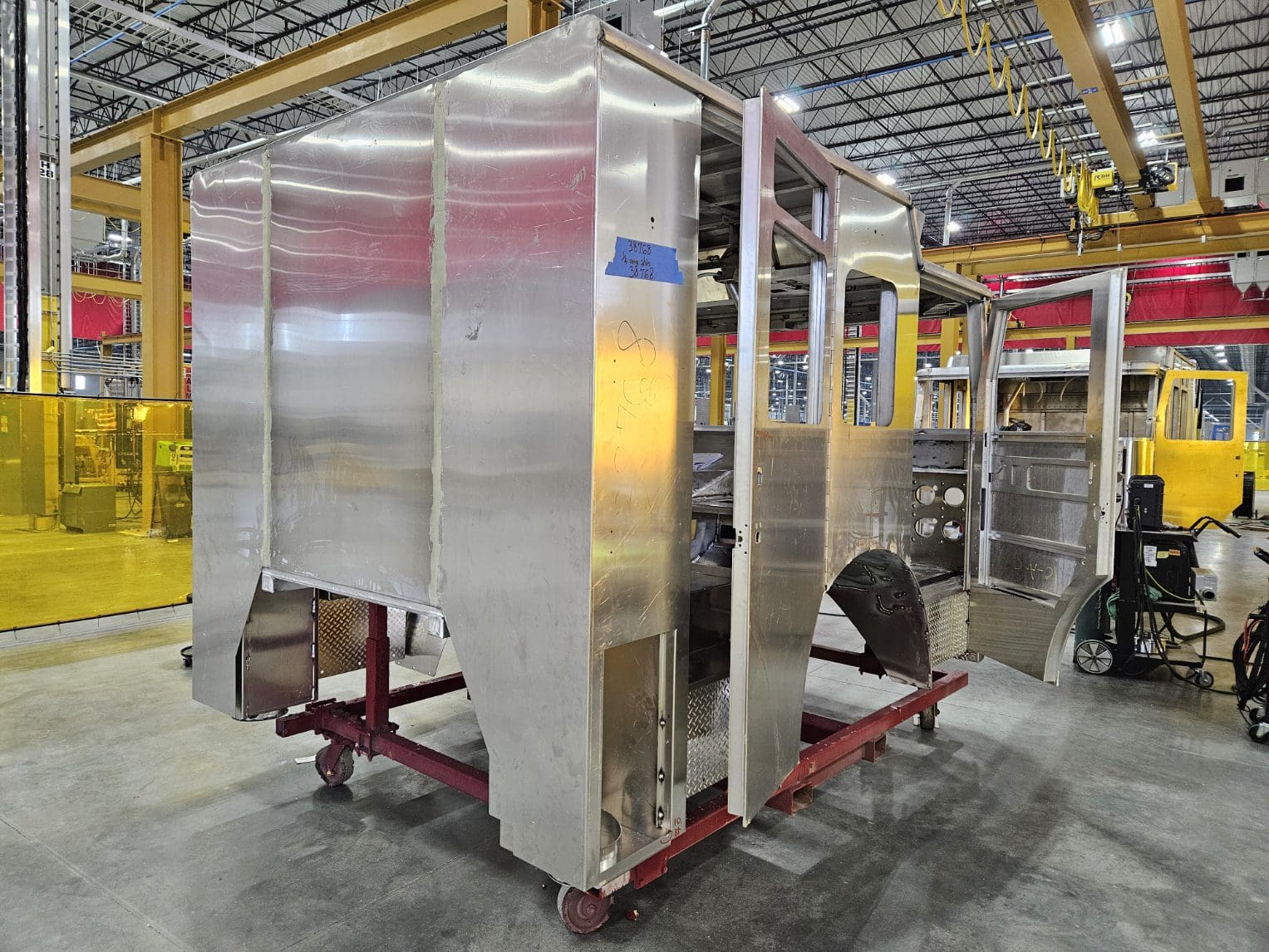

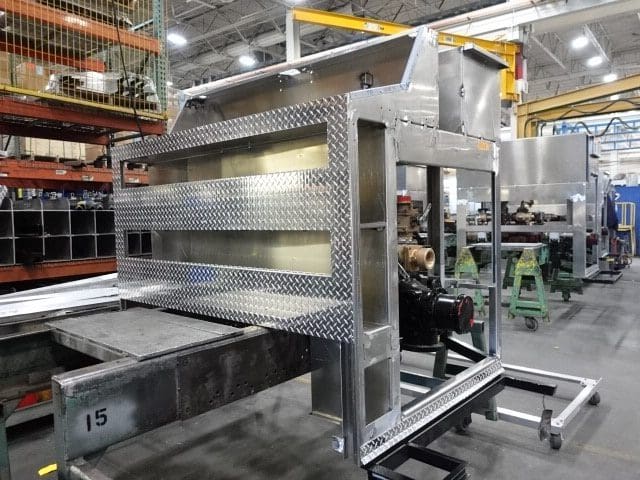

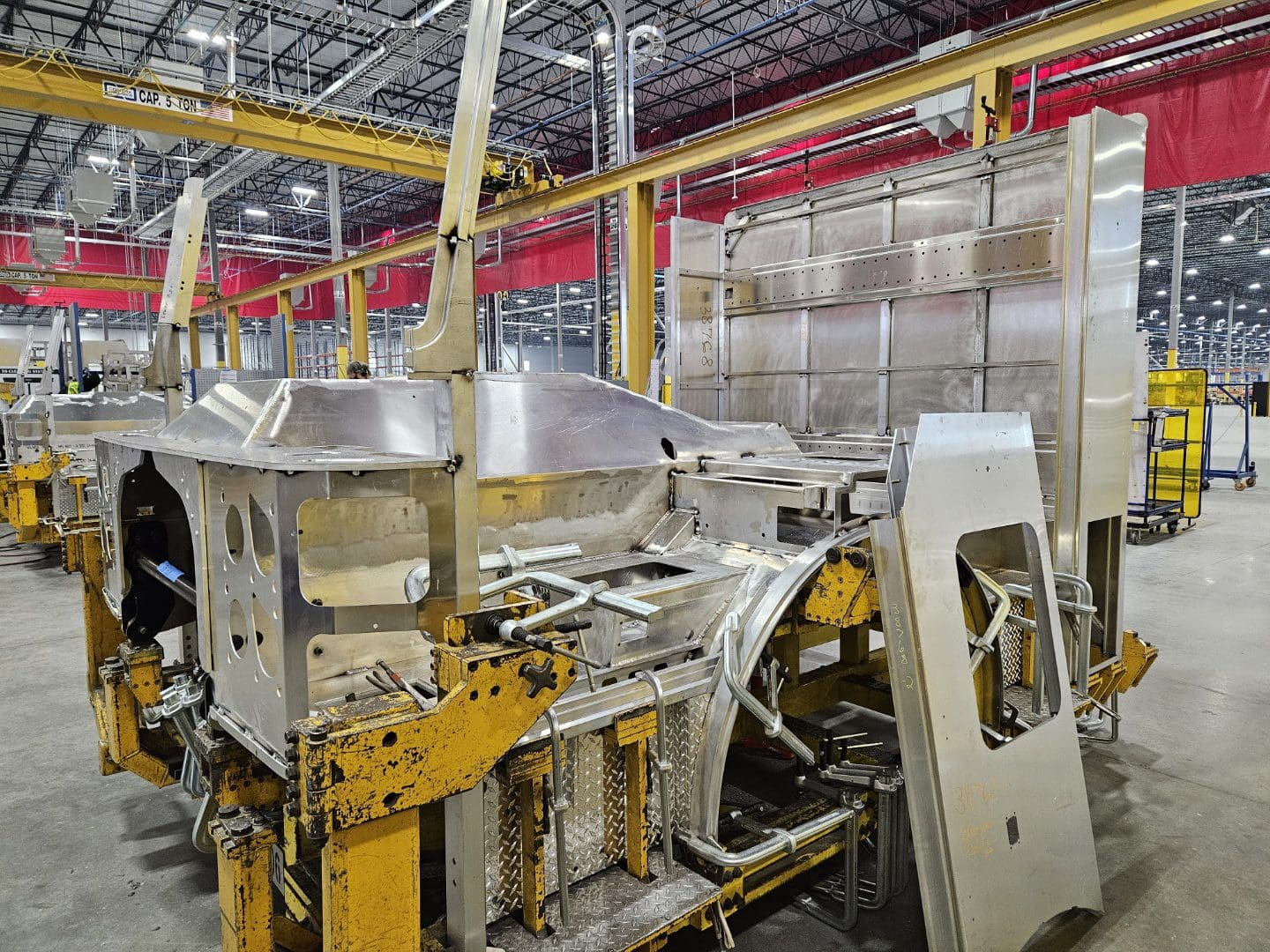

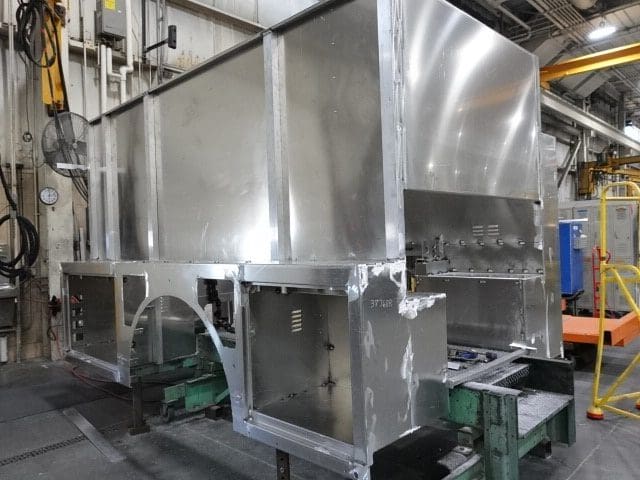

In this report, the cab continued fabrication, the frame build began, the pump house began initial assembly, and the body began fabrication.

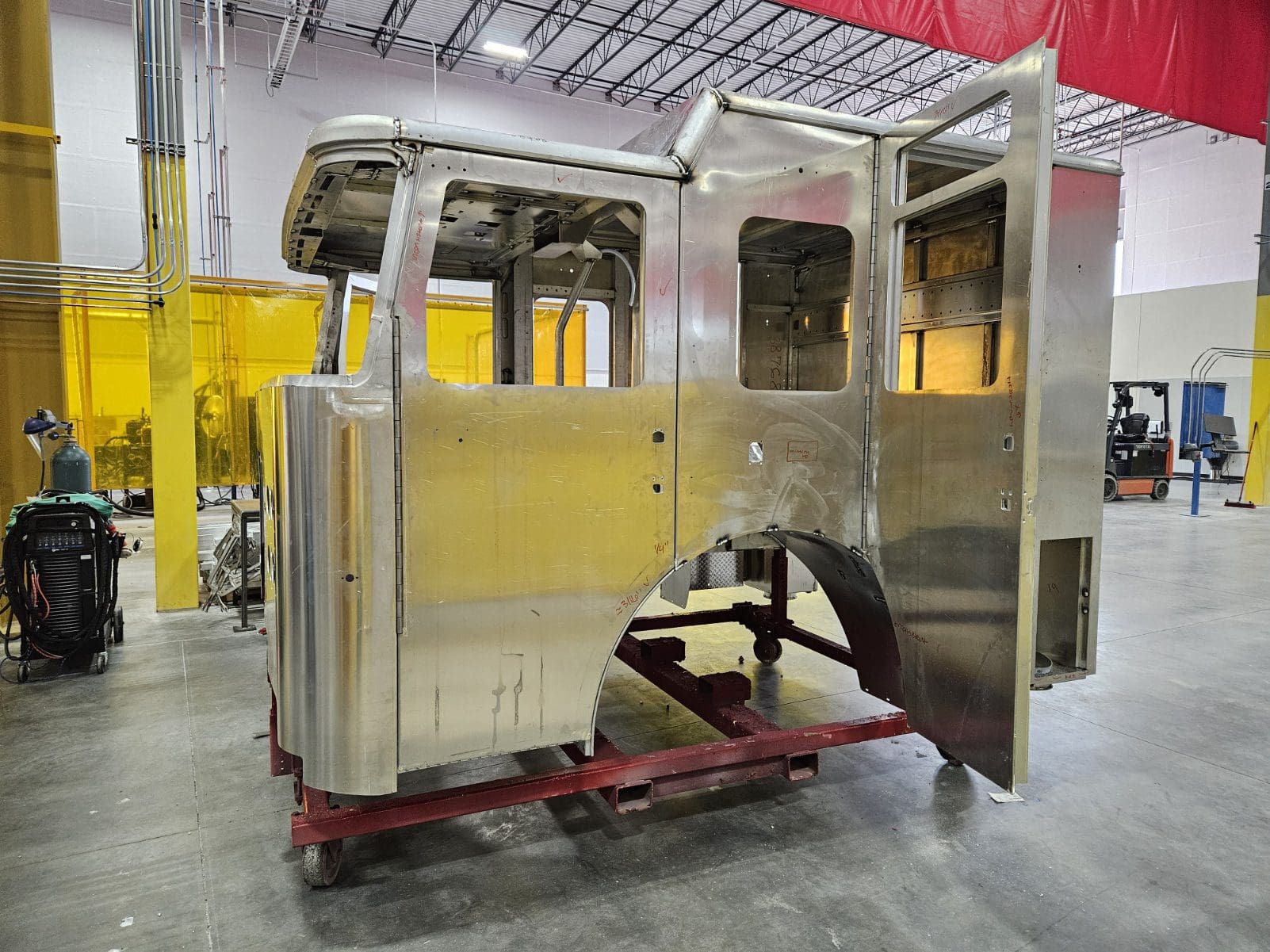

09-20-24

This new Pierce apparatus is now in production! In this report, the cab began fabrication.
