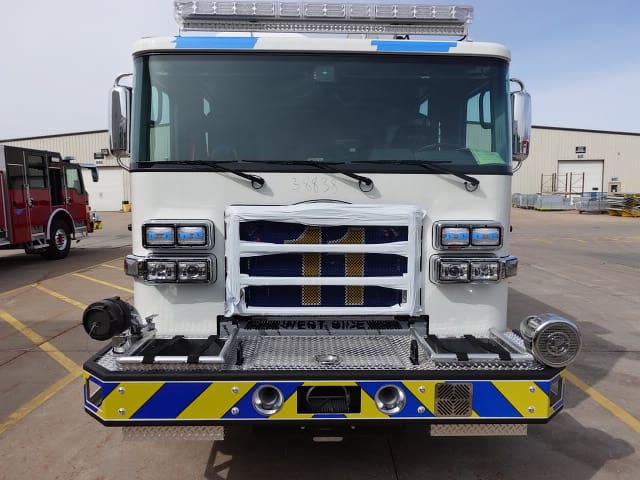

04-04-25

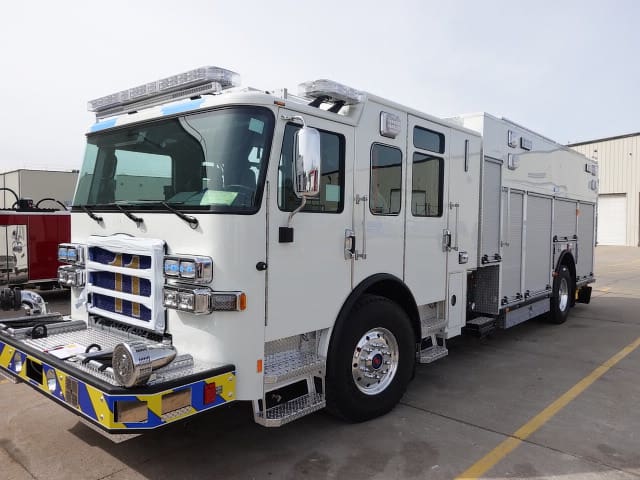

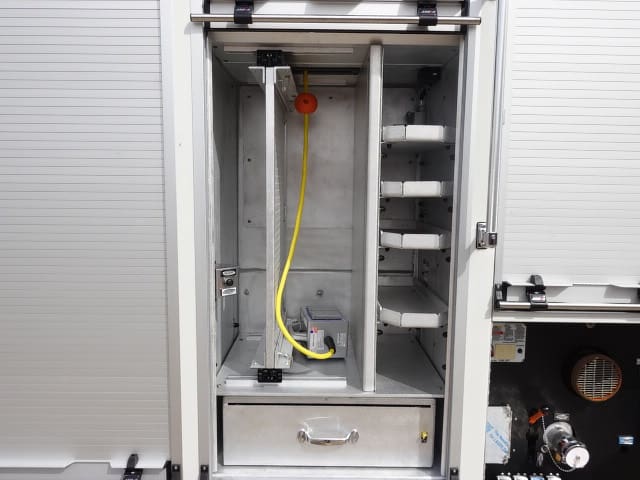

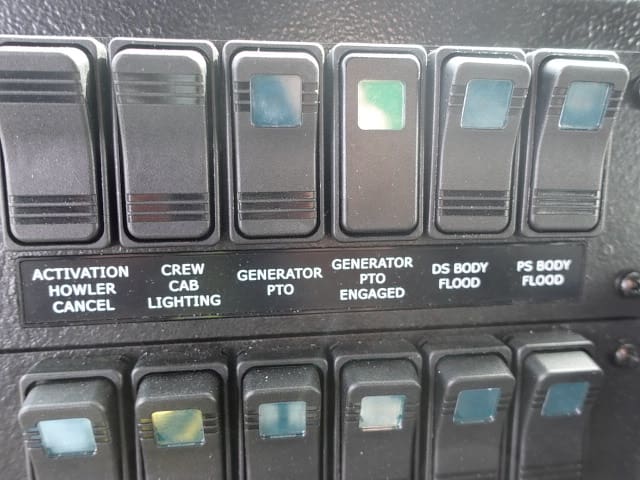

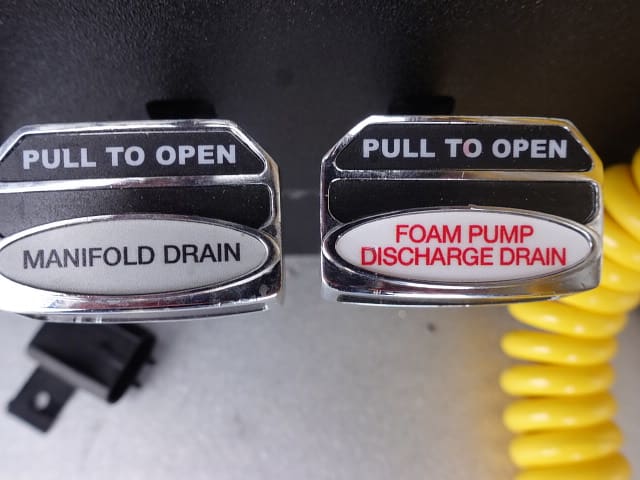

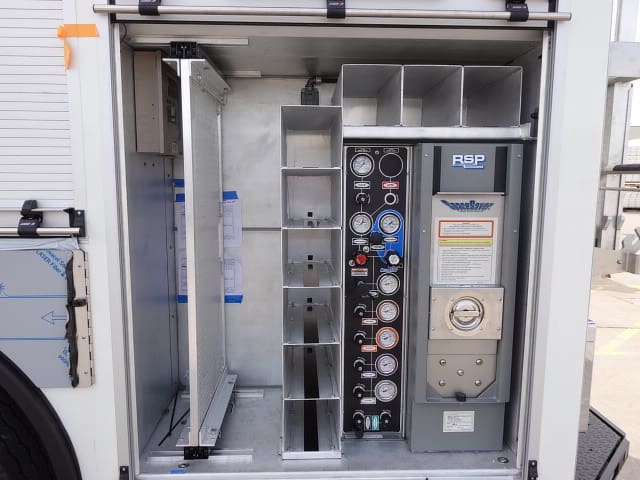

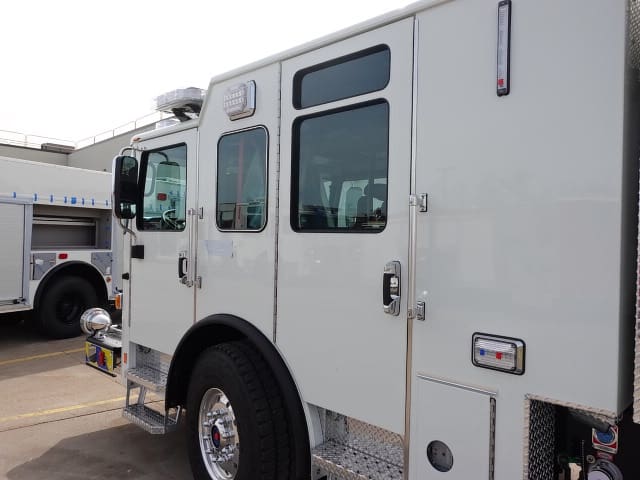

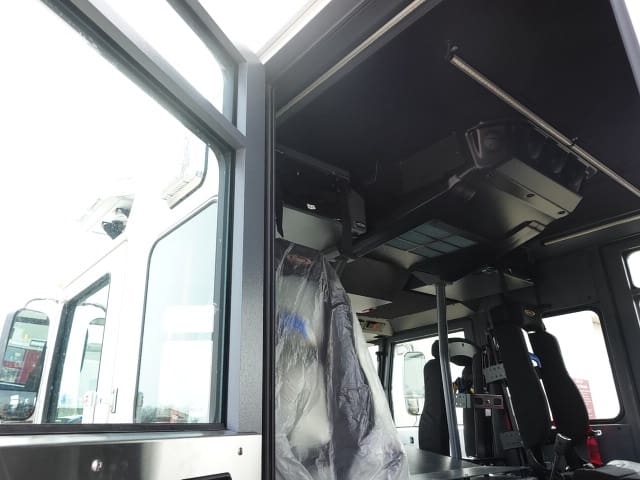

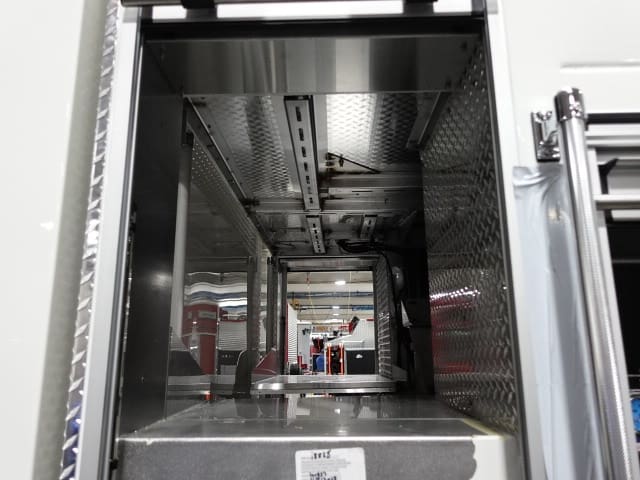

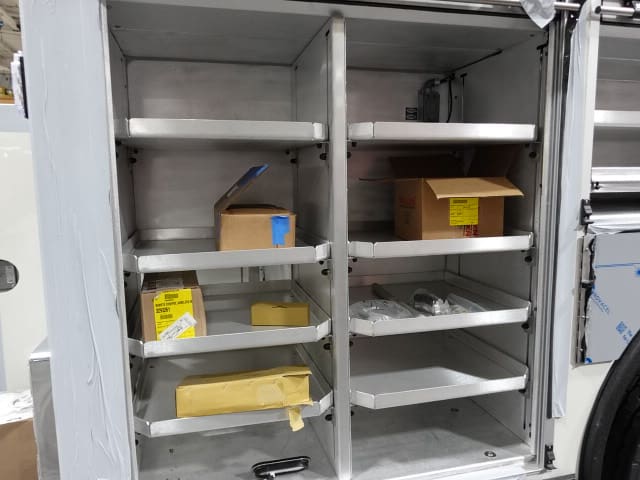

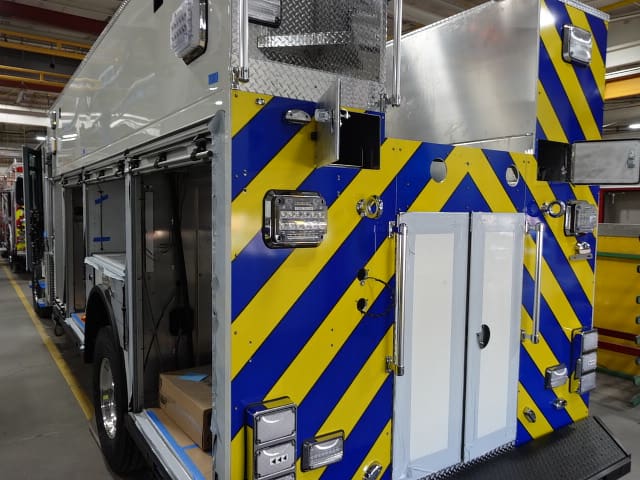

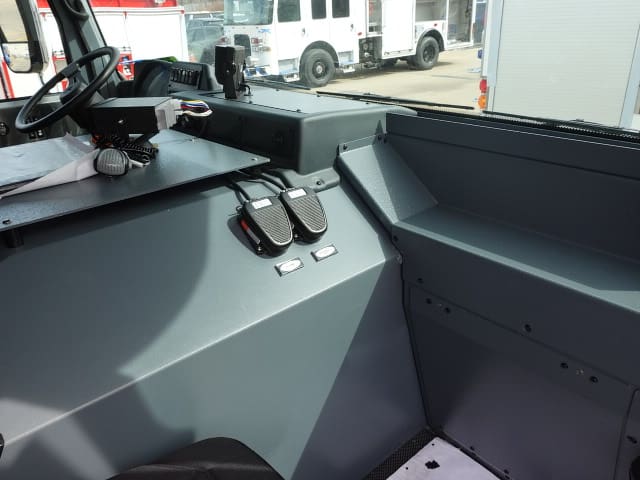

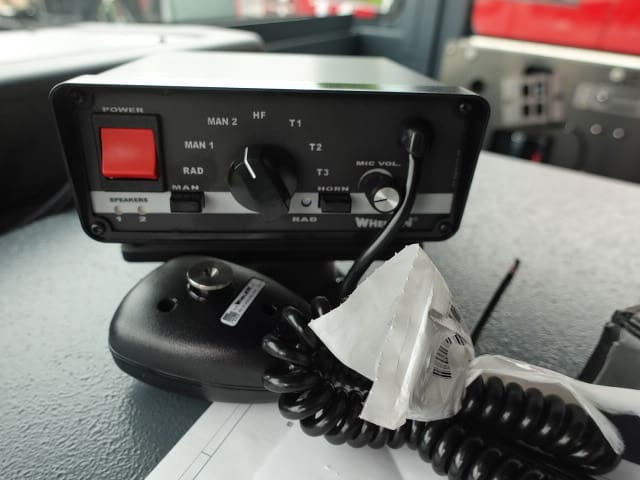

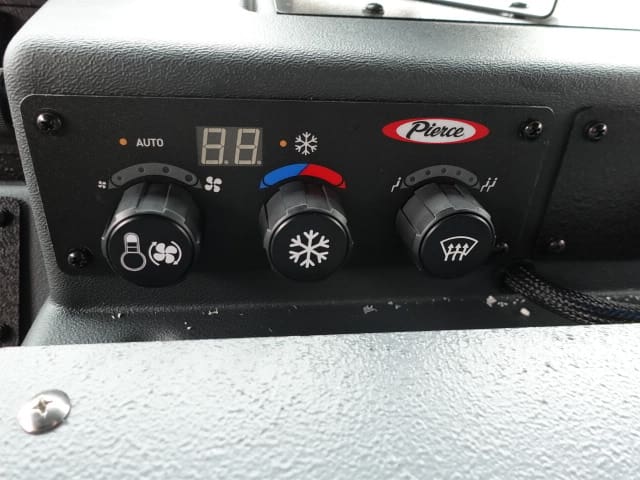

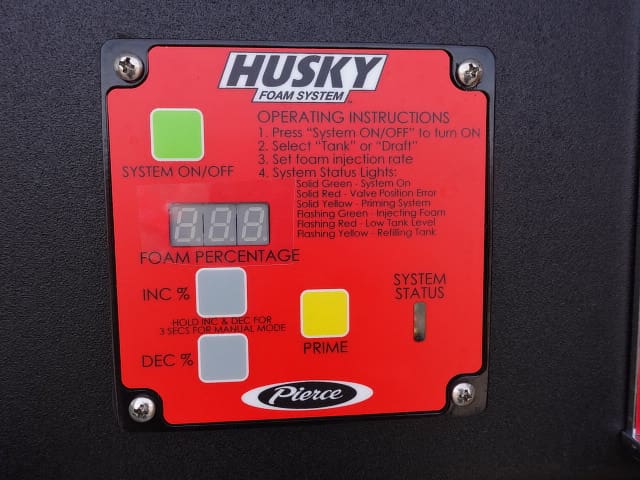

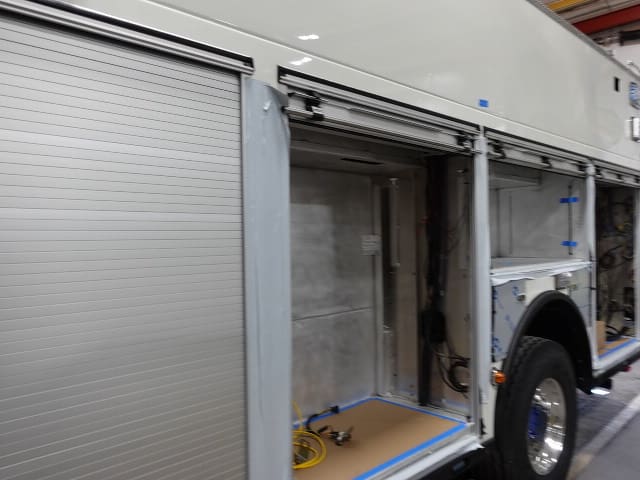

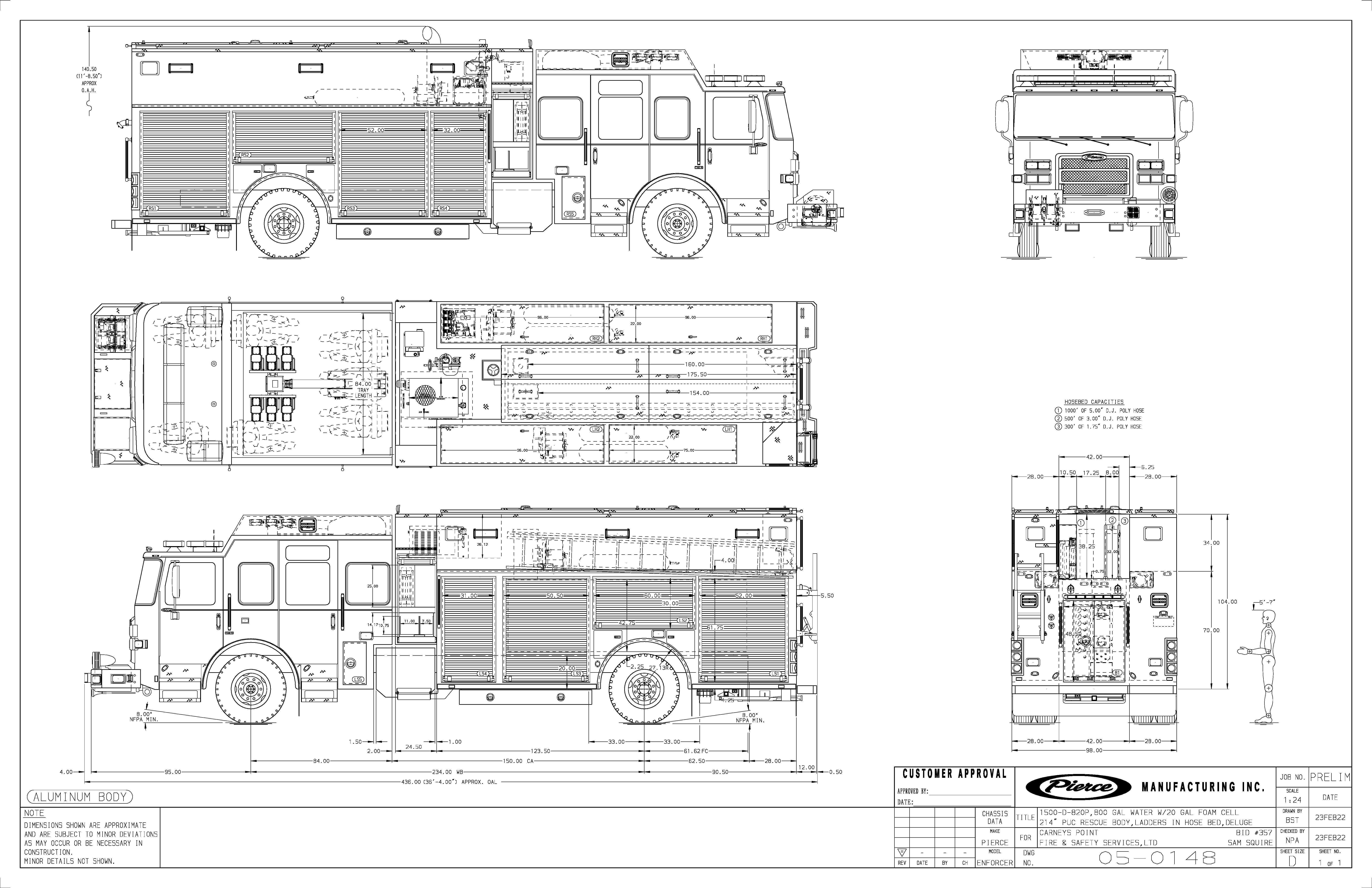

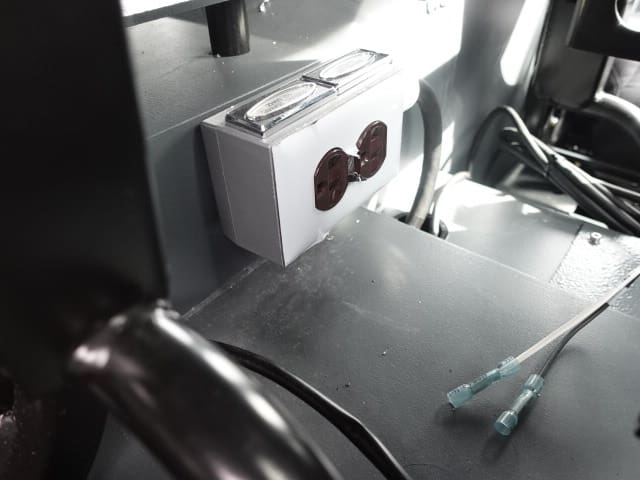

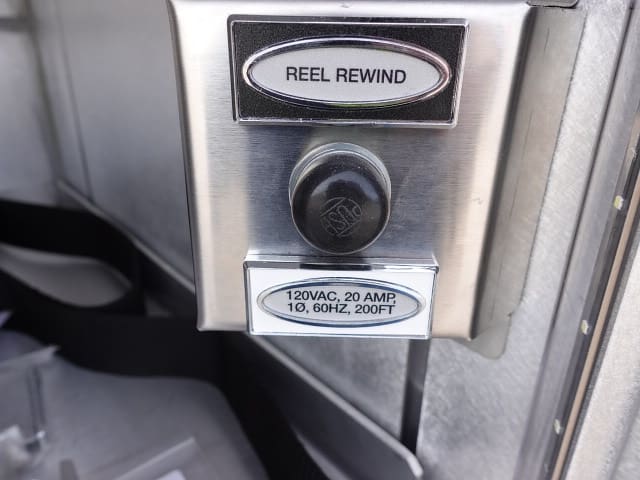

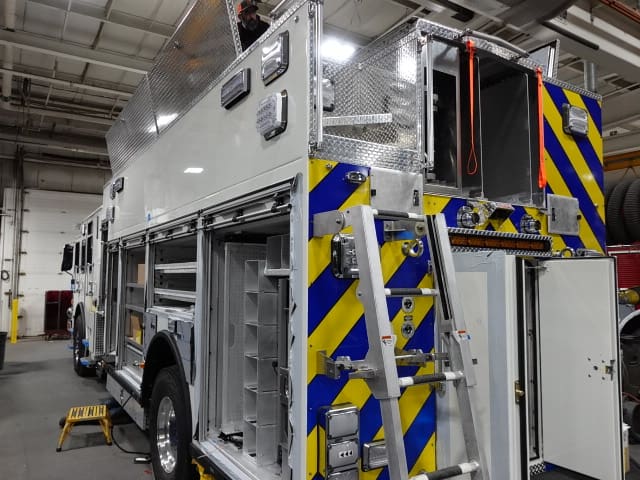

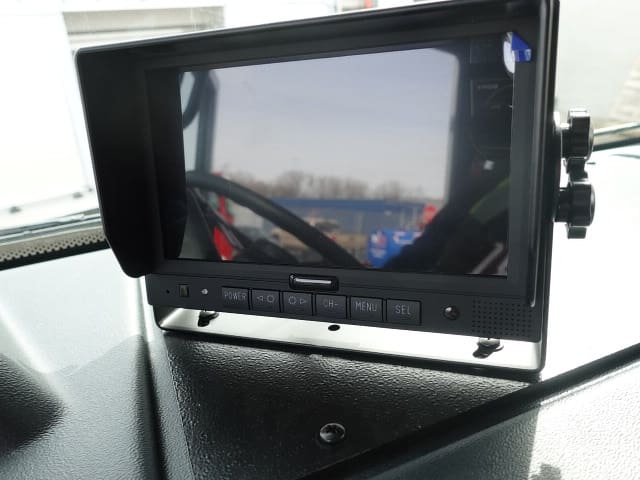

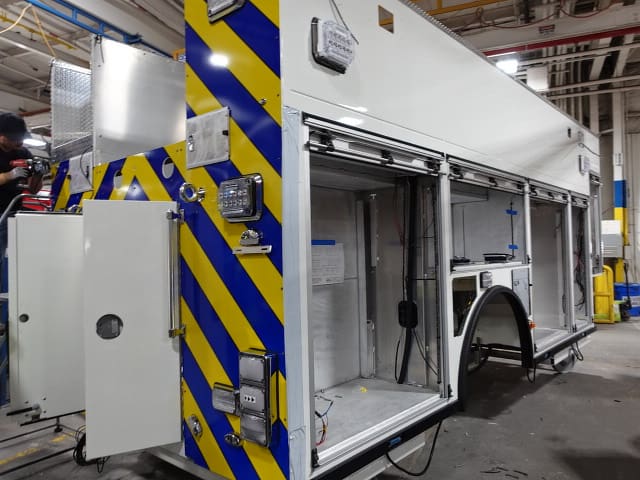

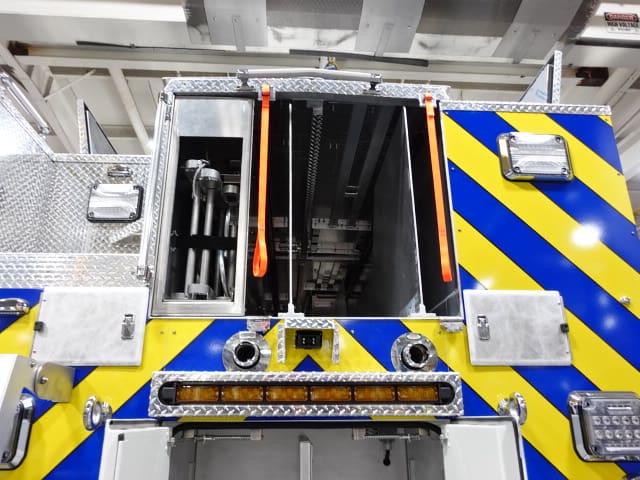

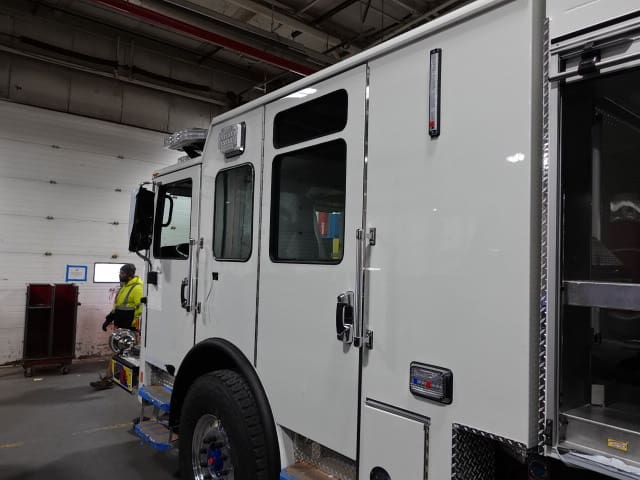

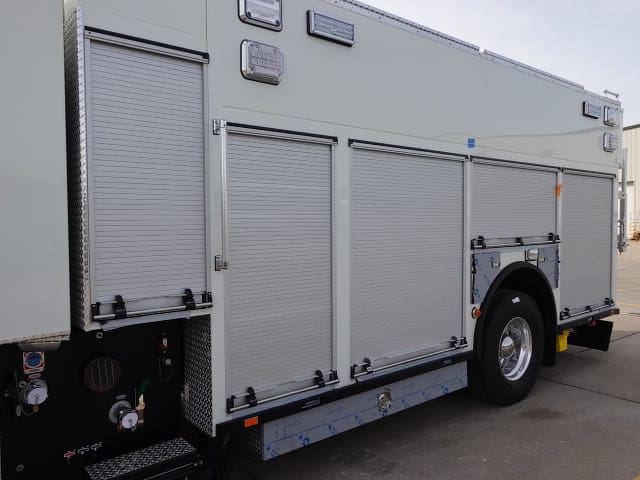

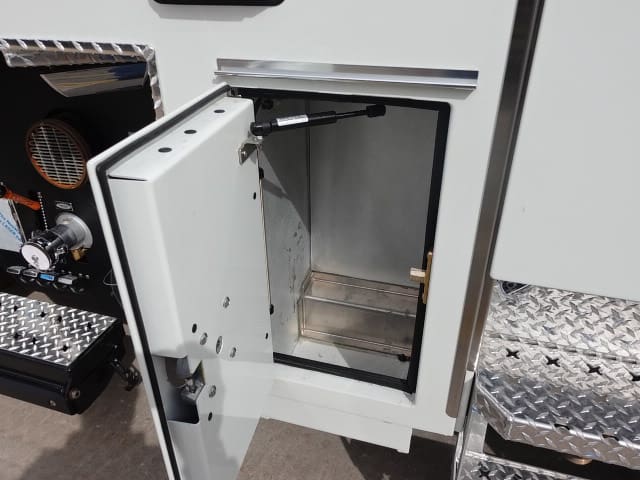

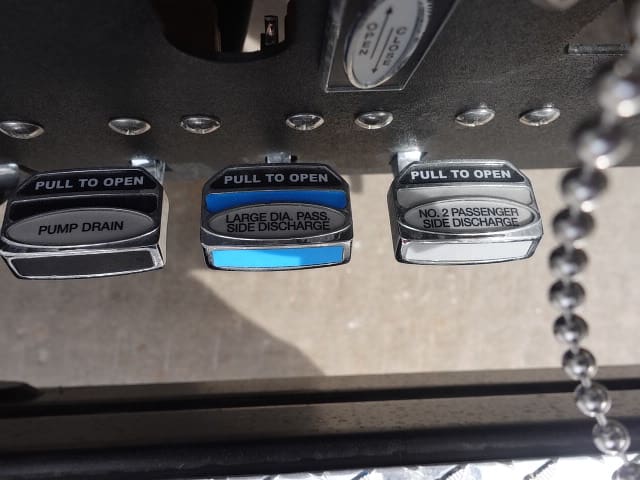

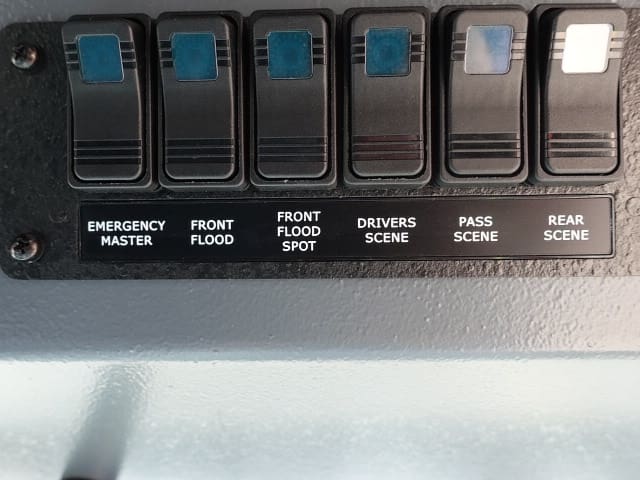

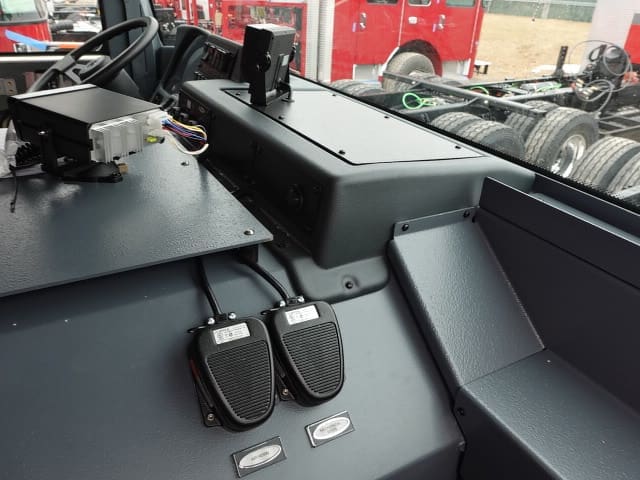

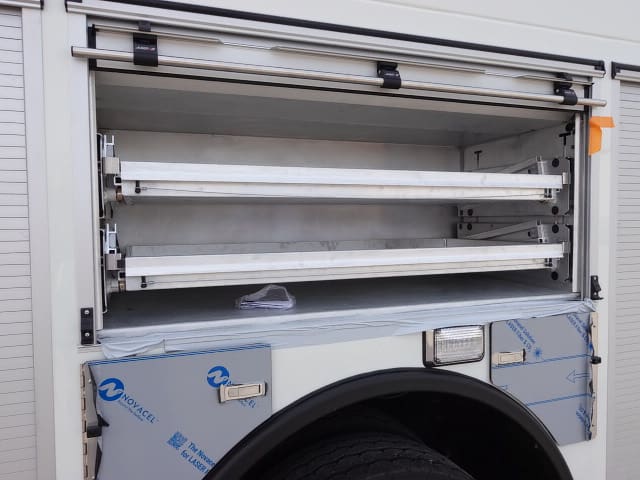

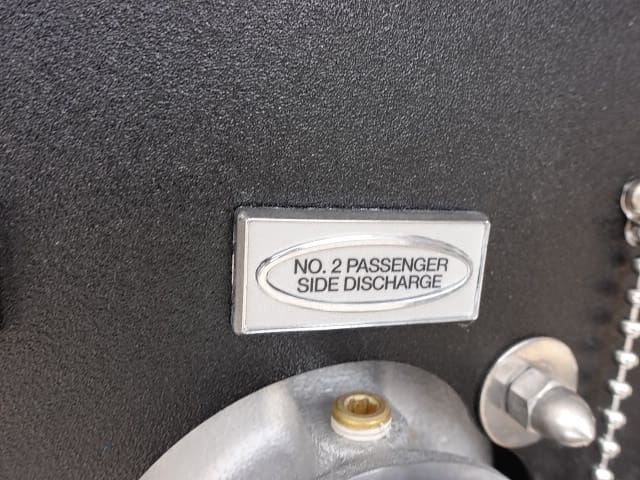

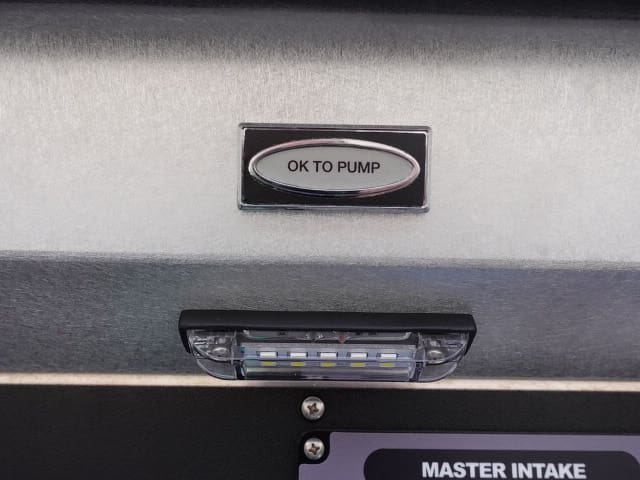

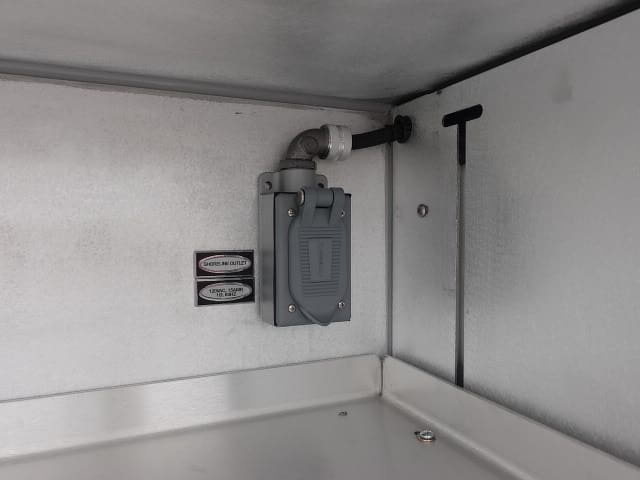

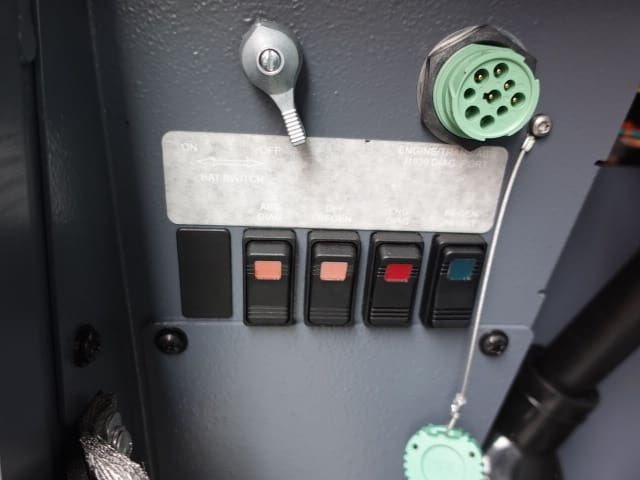

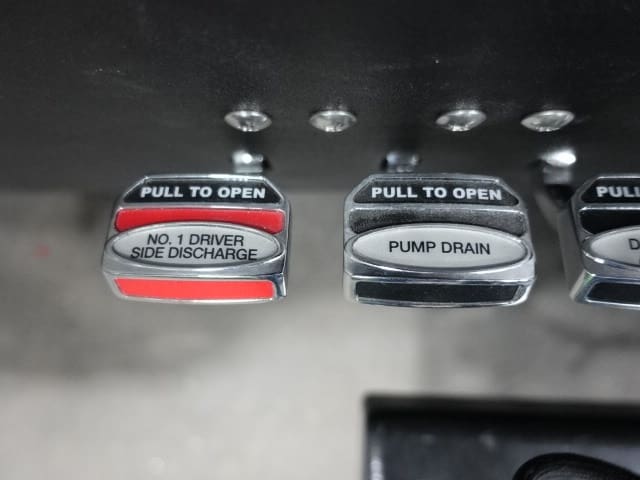

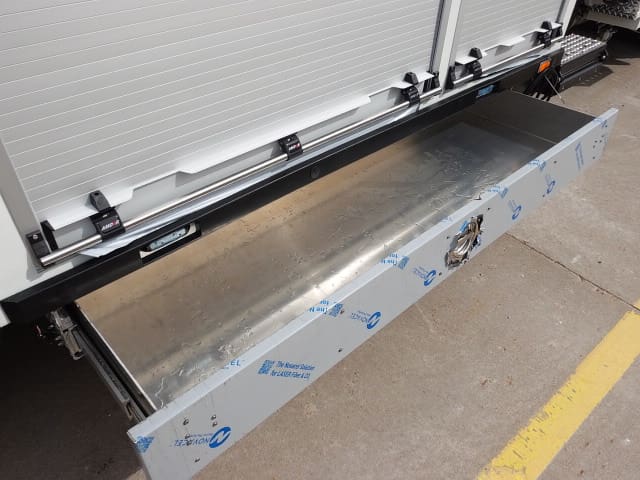

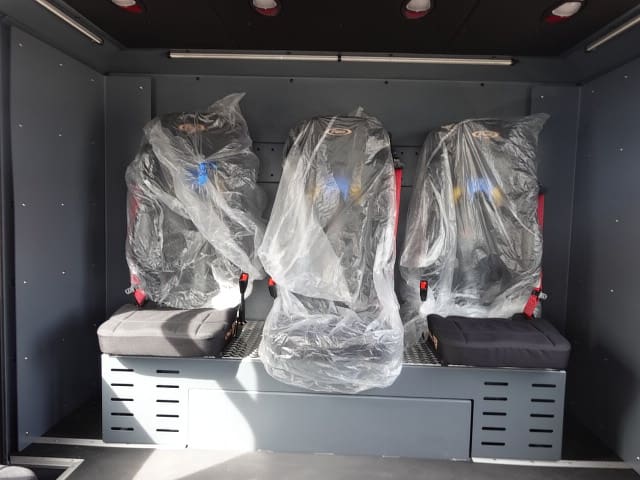

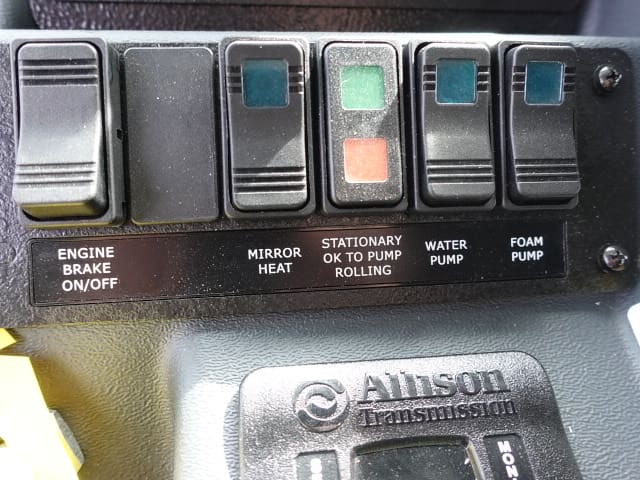

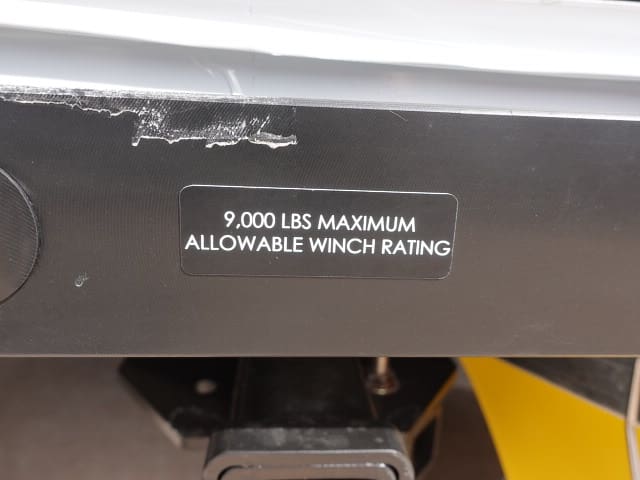

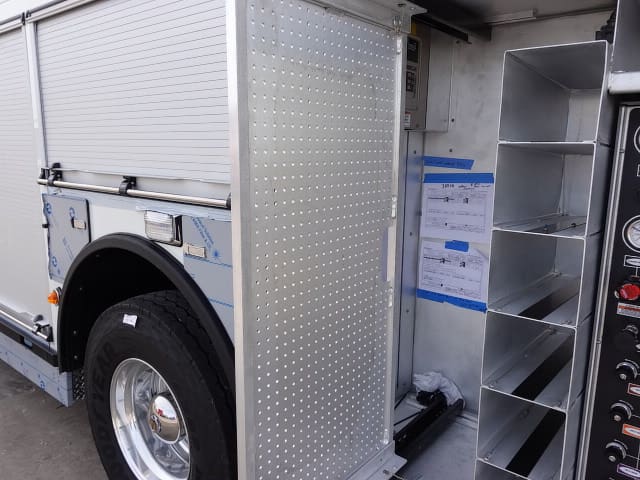

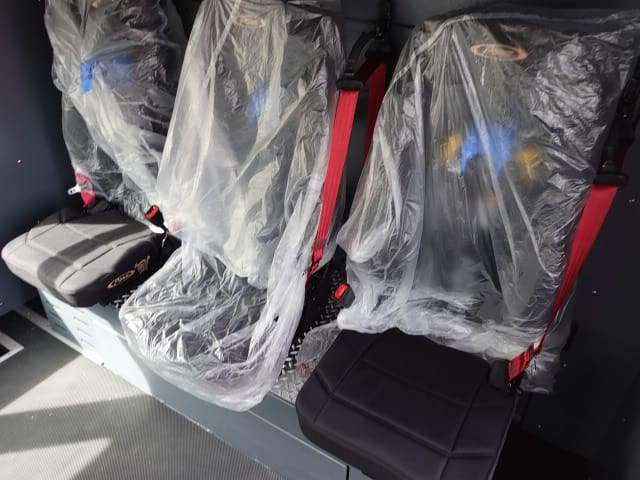

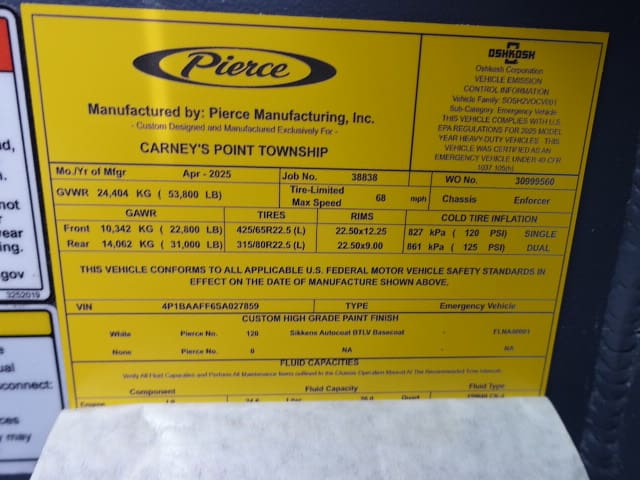

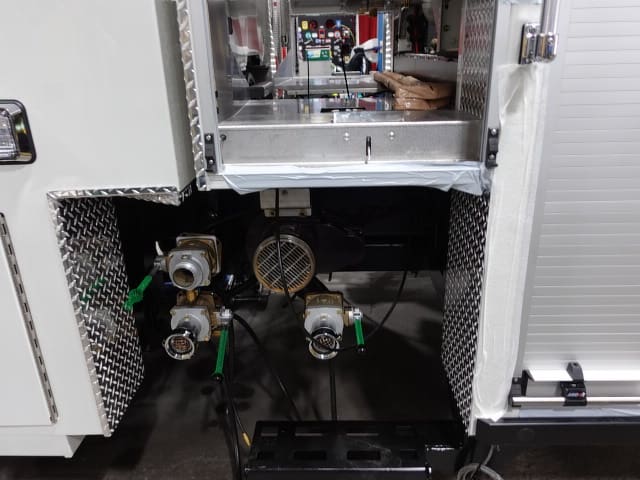

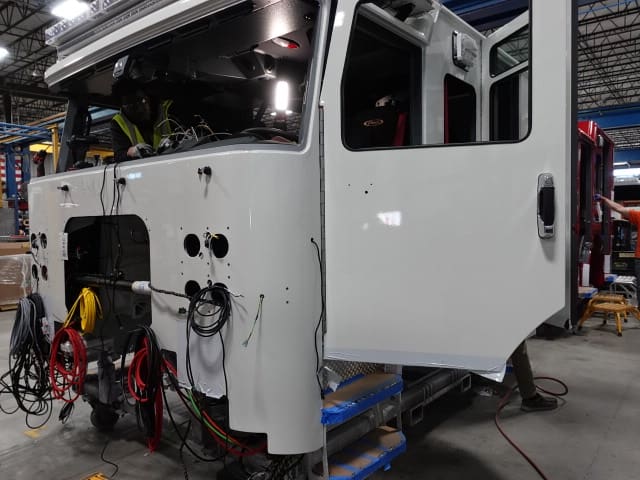

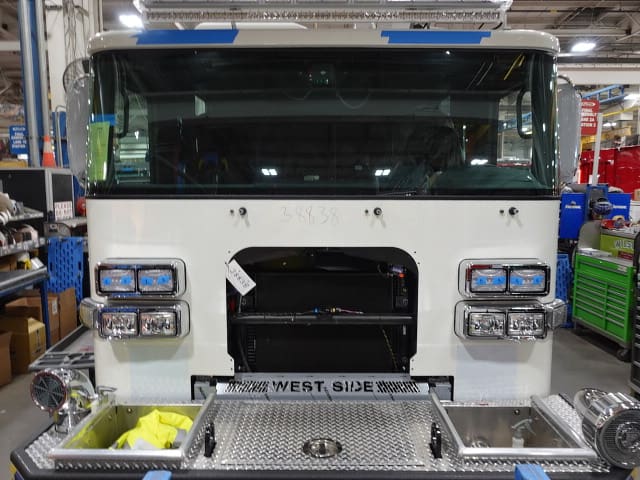

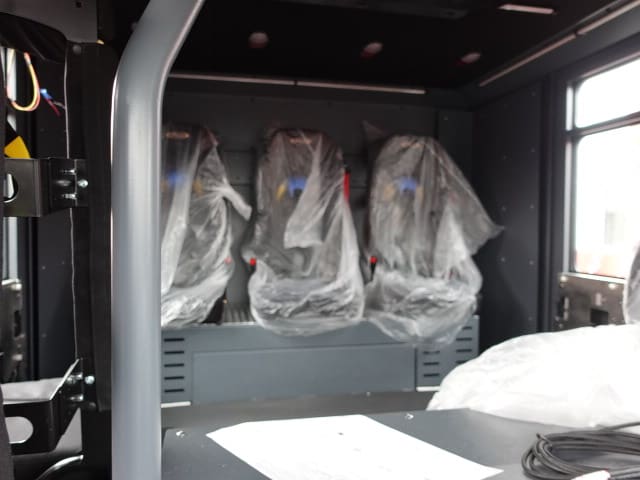

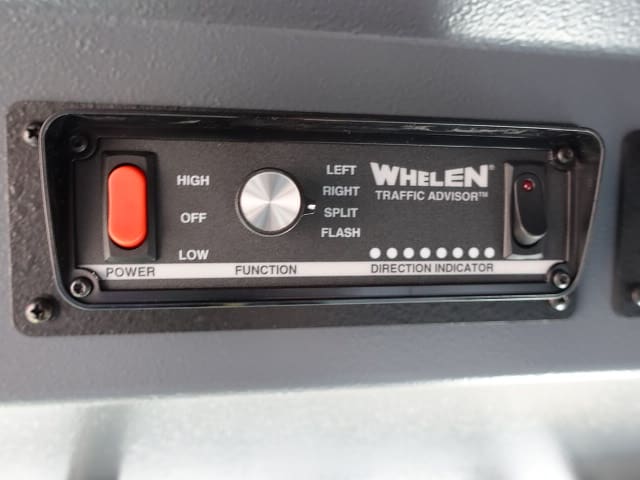

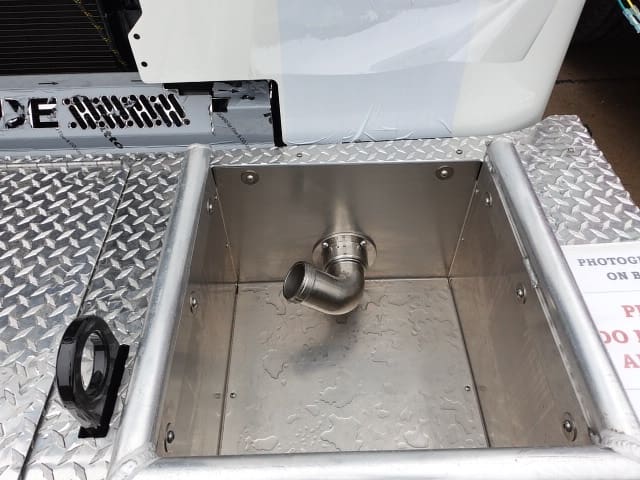

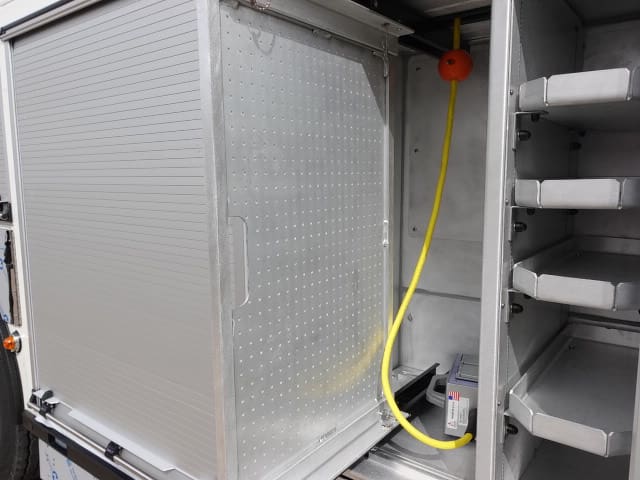

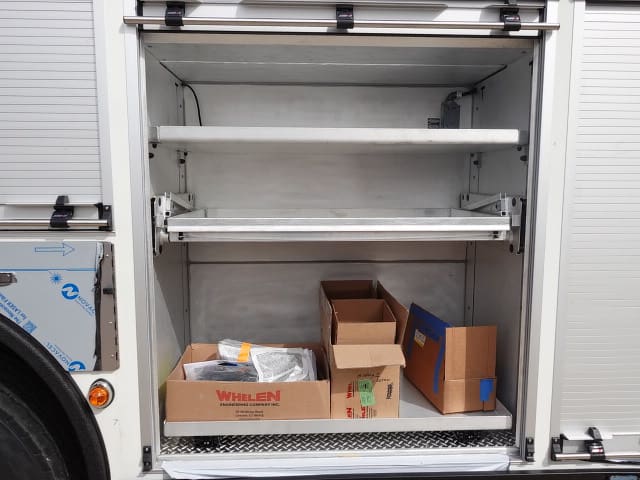

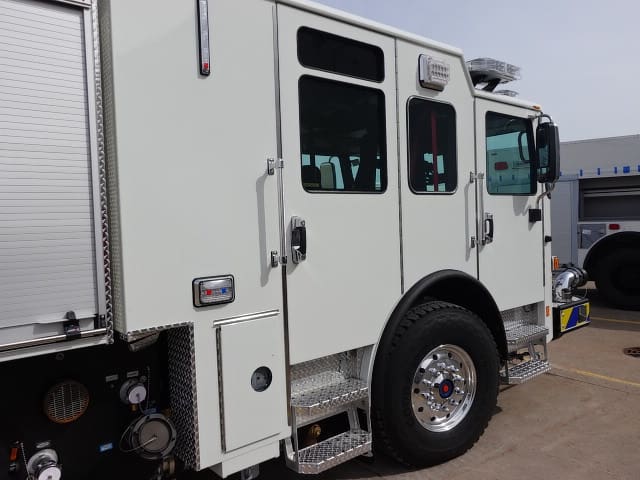

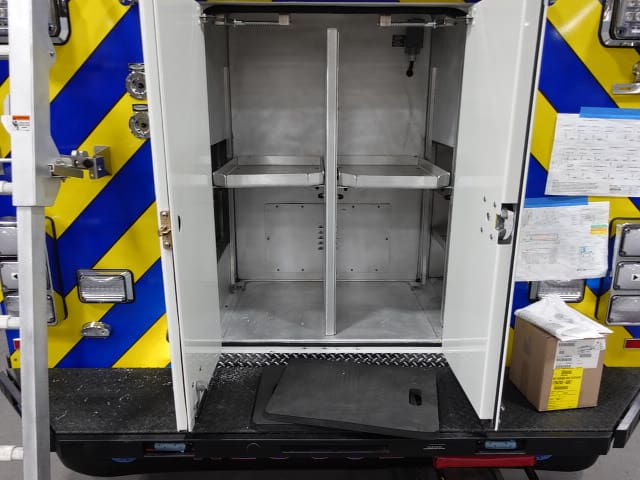

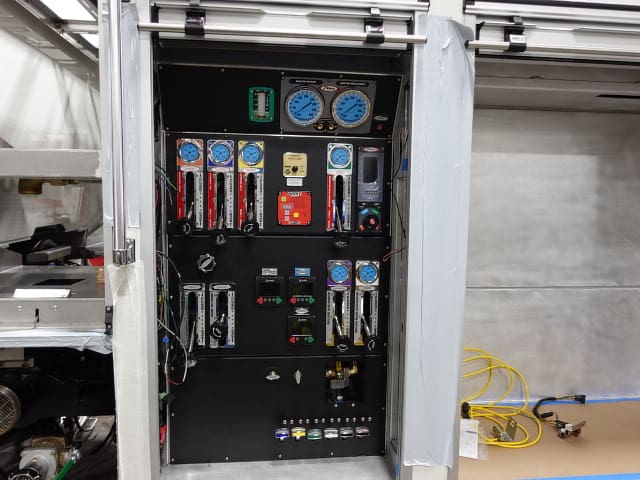

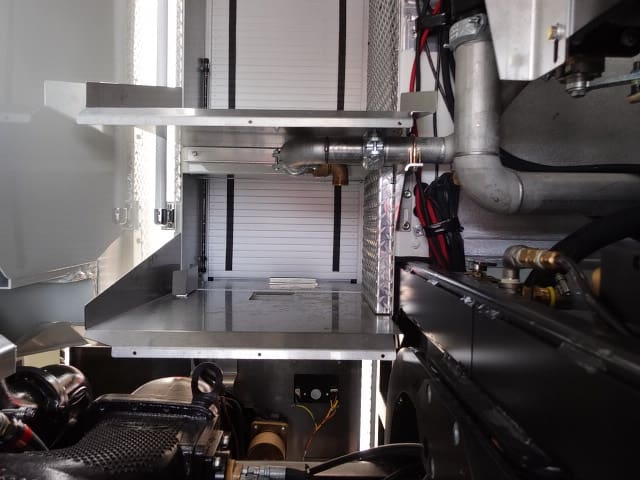

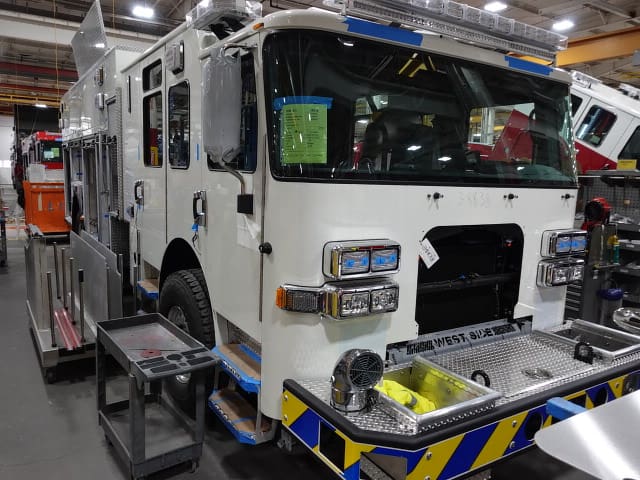

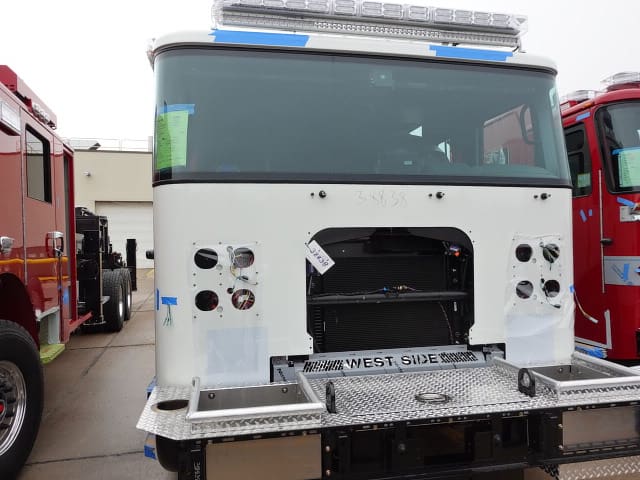

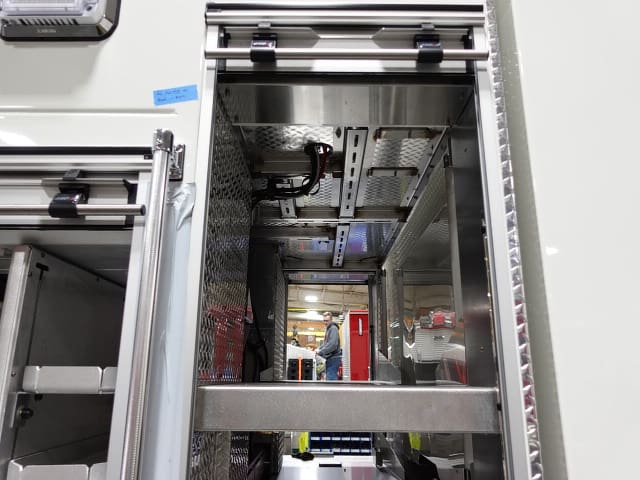

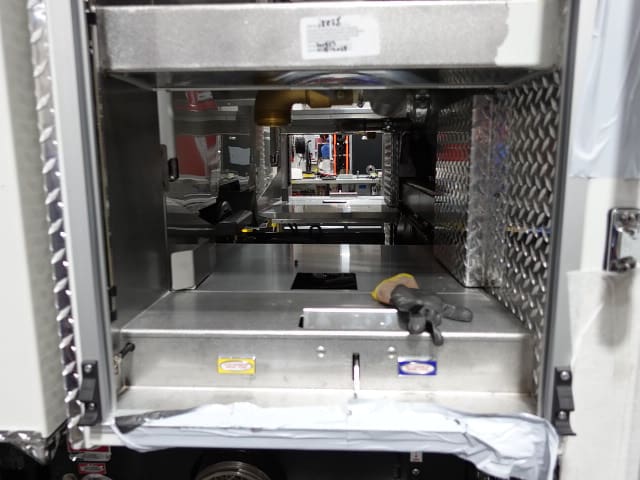

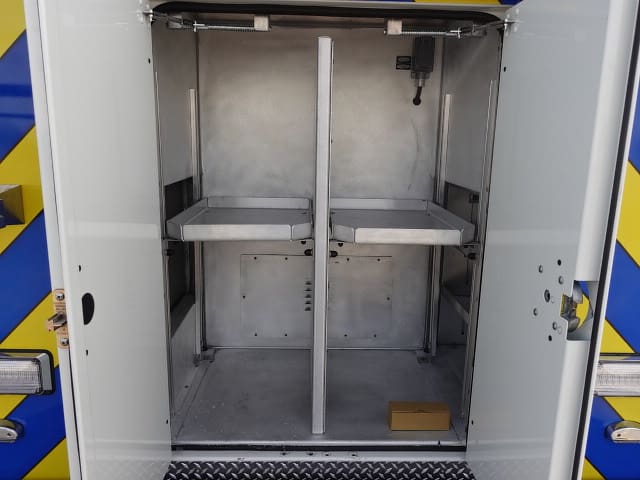

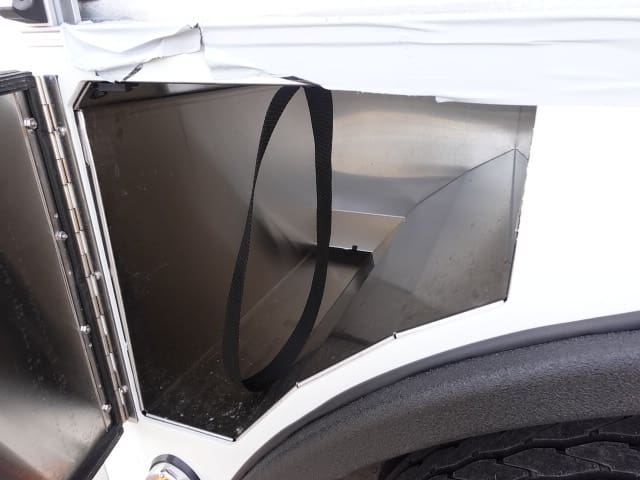

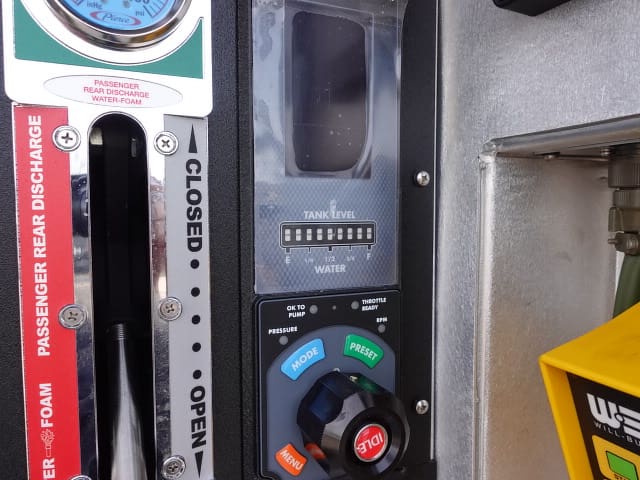

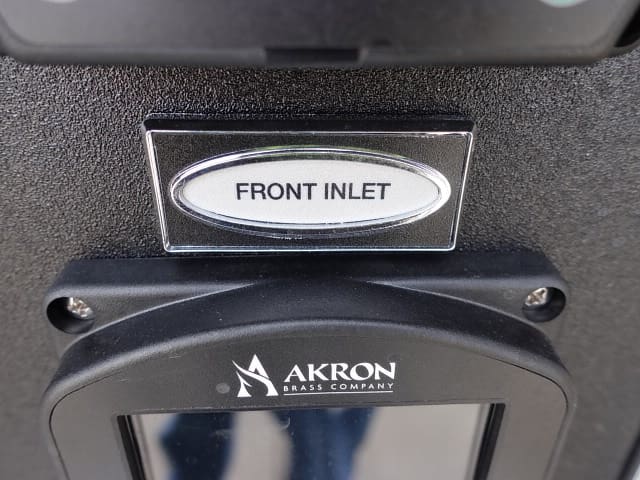

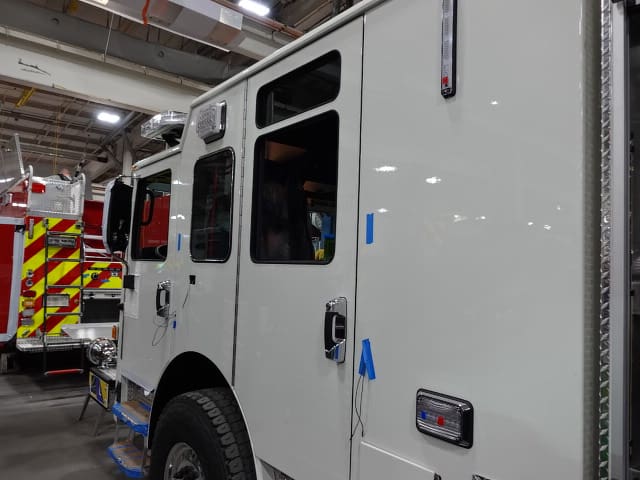

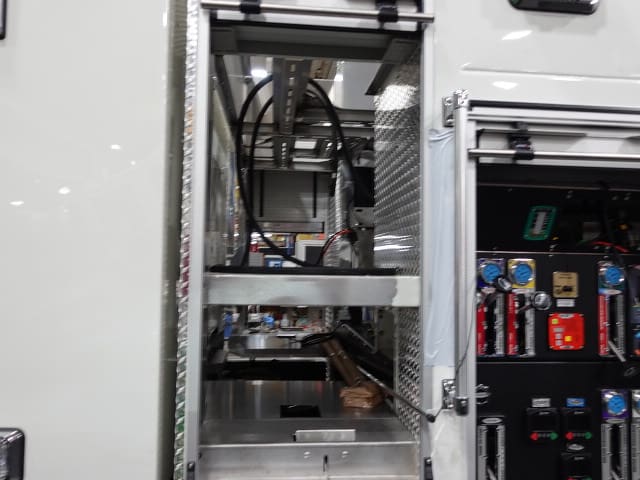

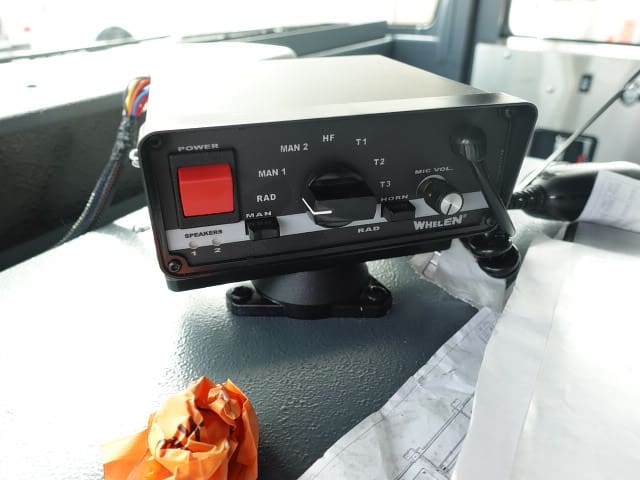

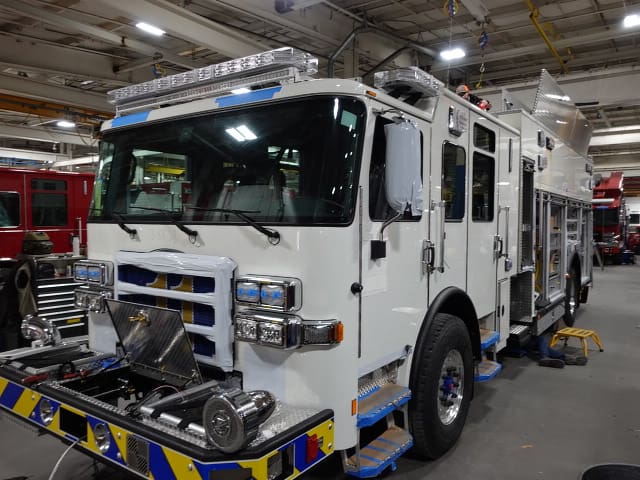

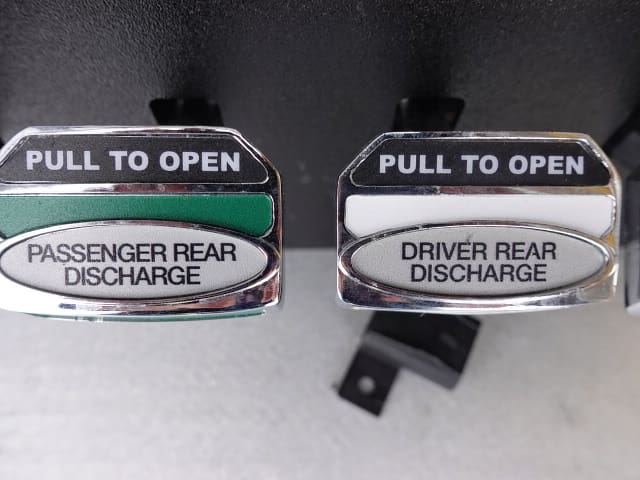

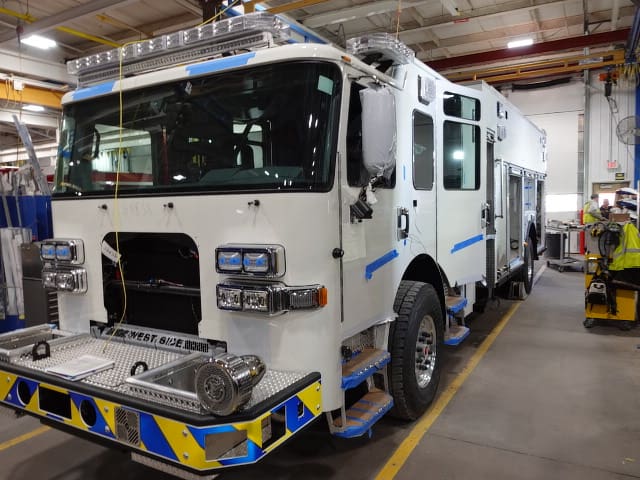

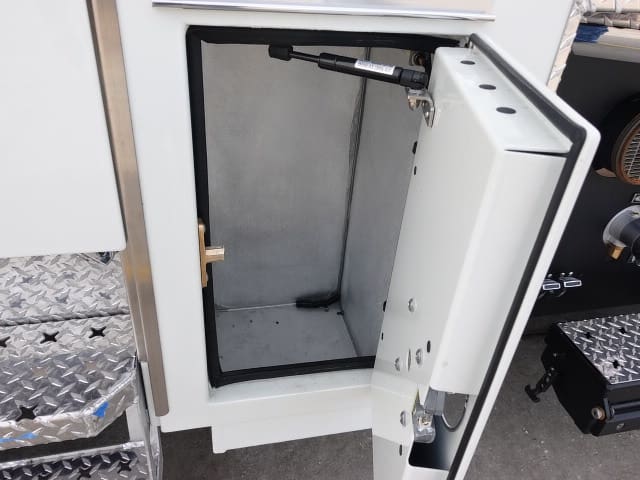

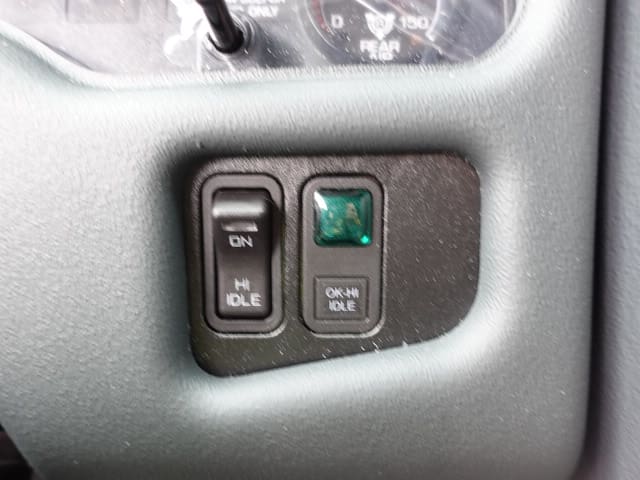

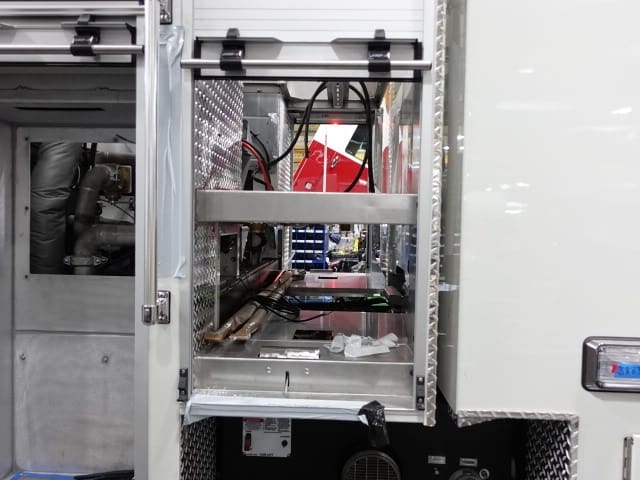

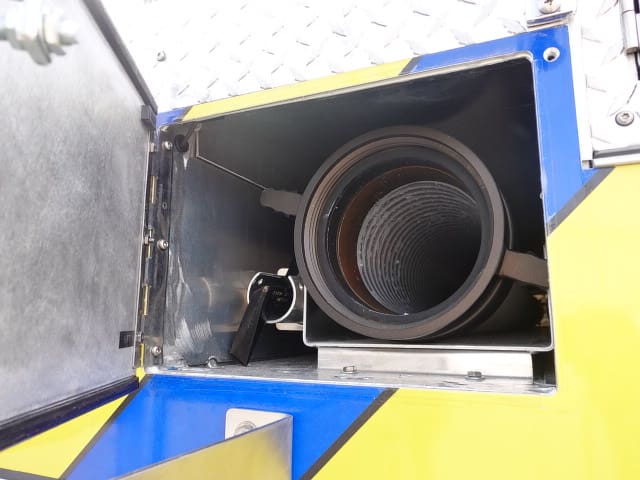

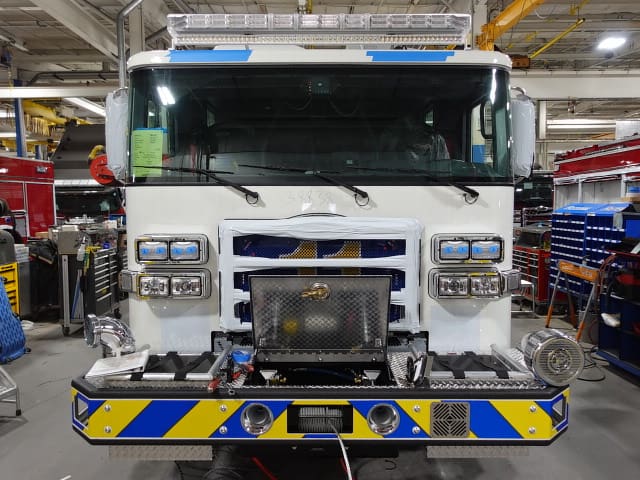

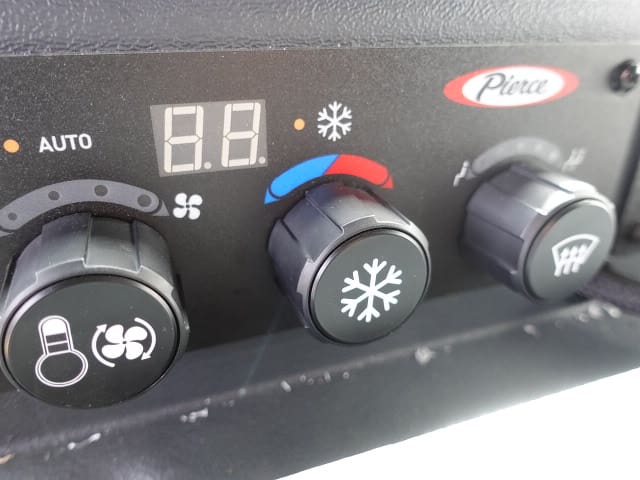

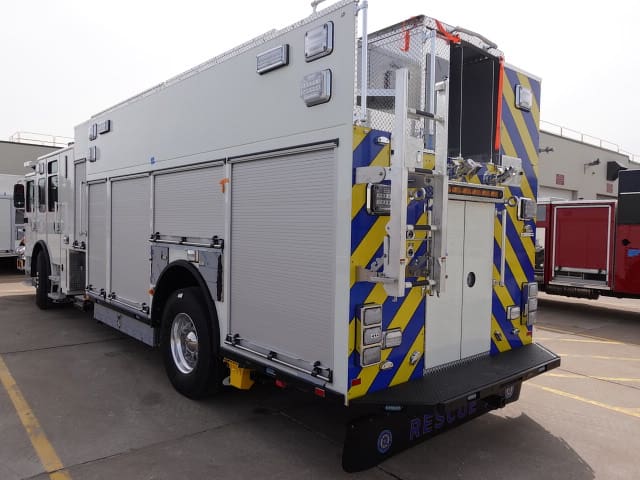

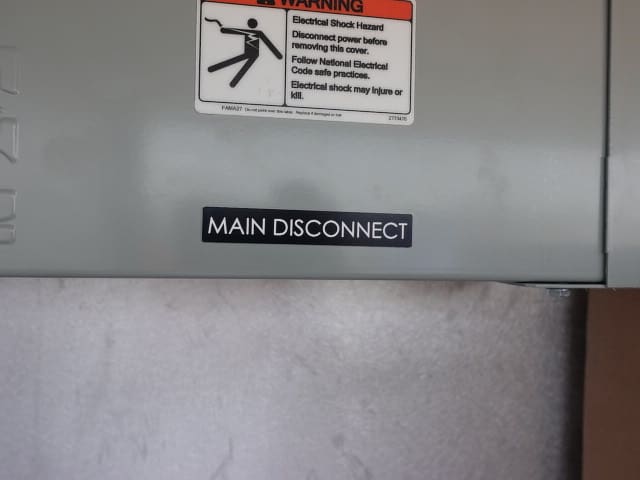

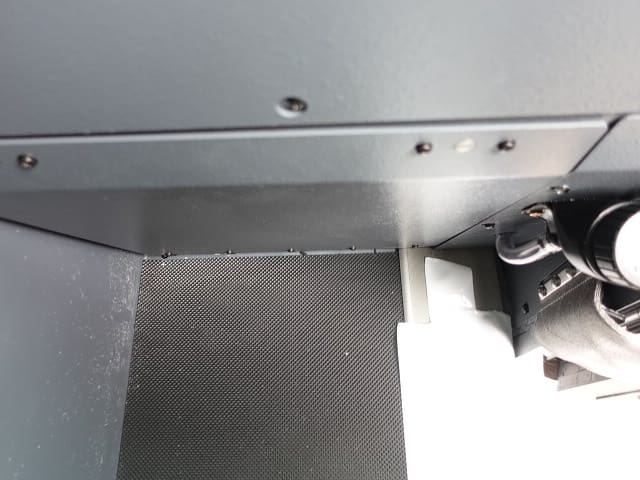

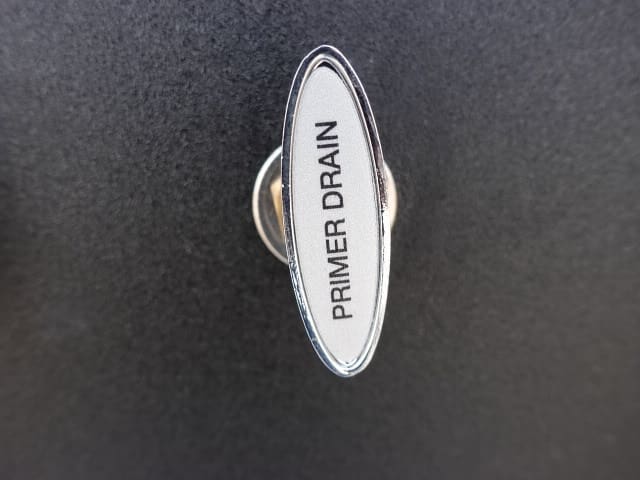

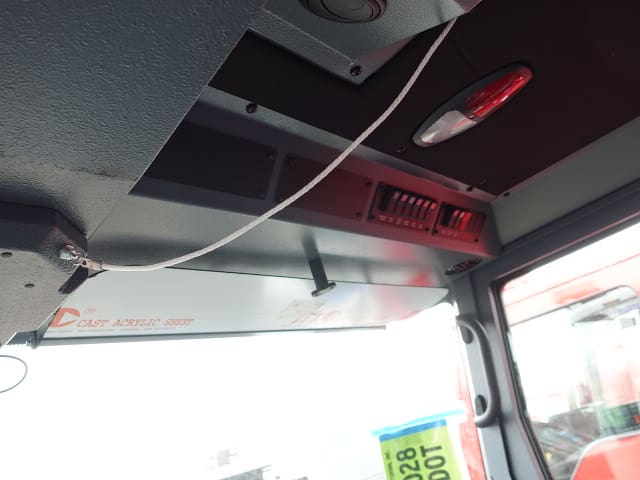

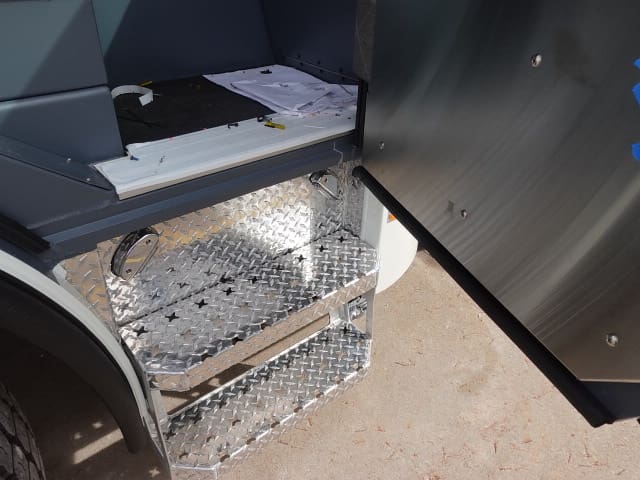

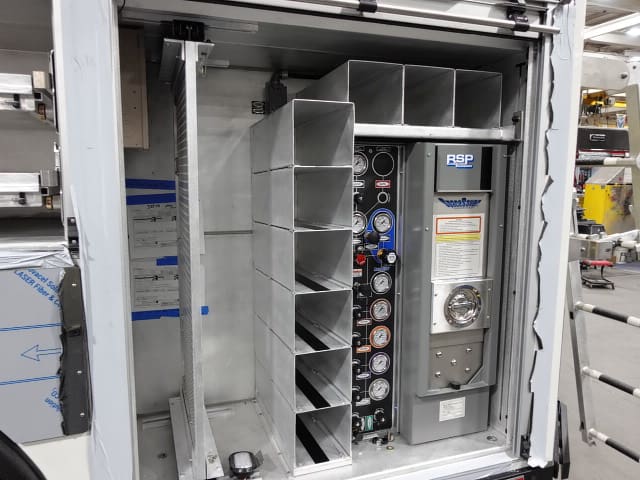

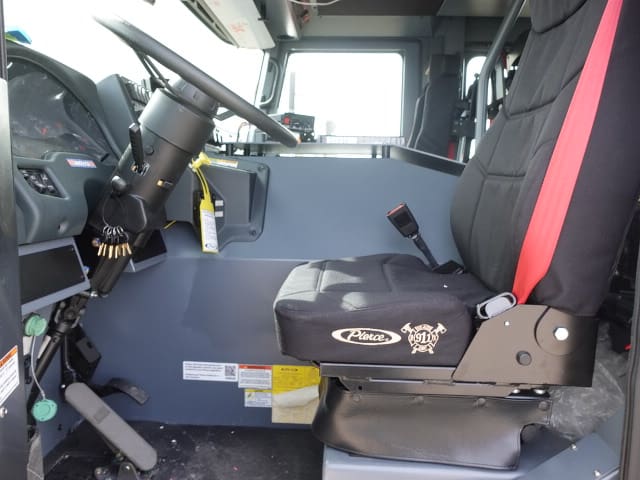

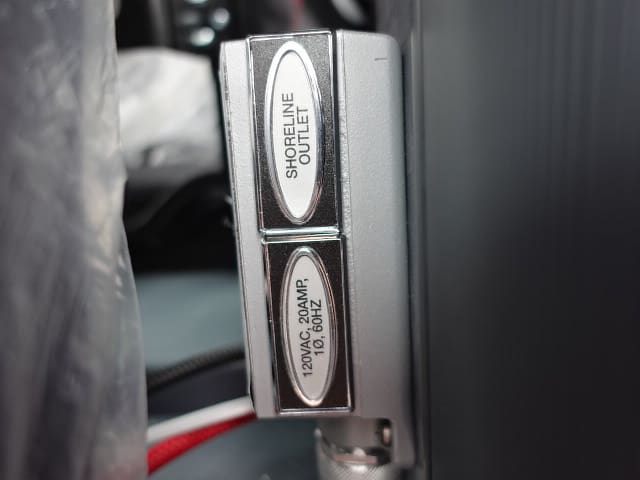

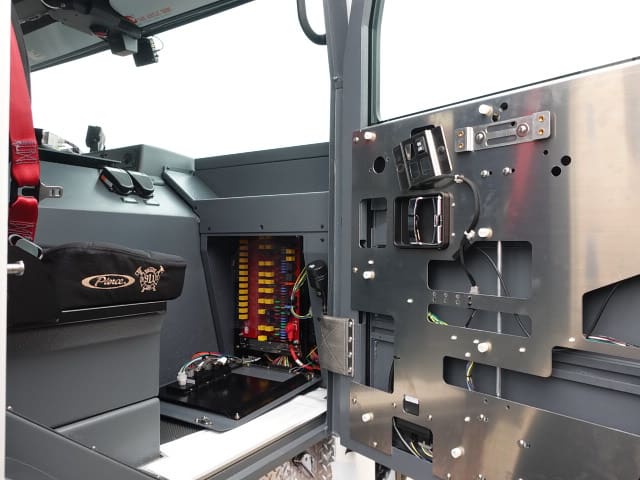

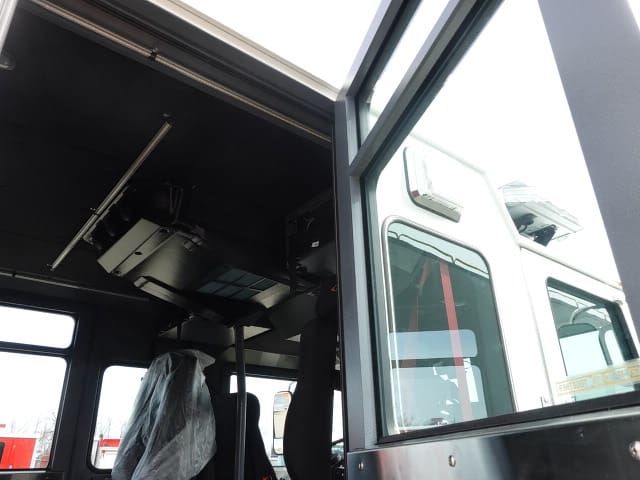

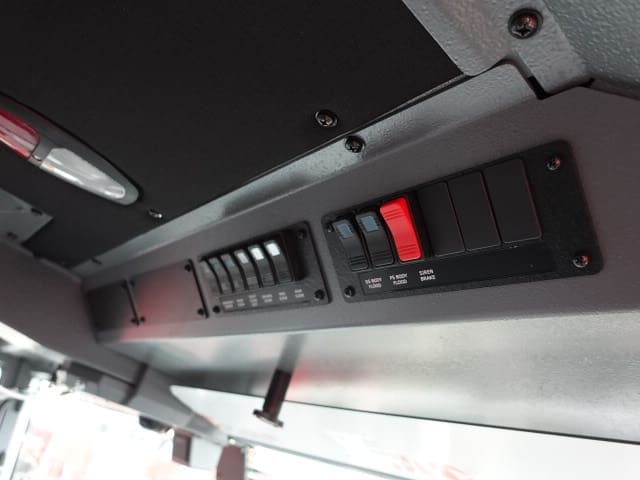

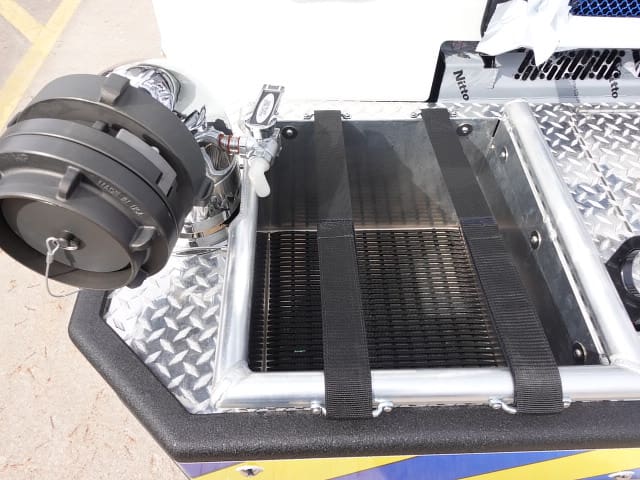

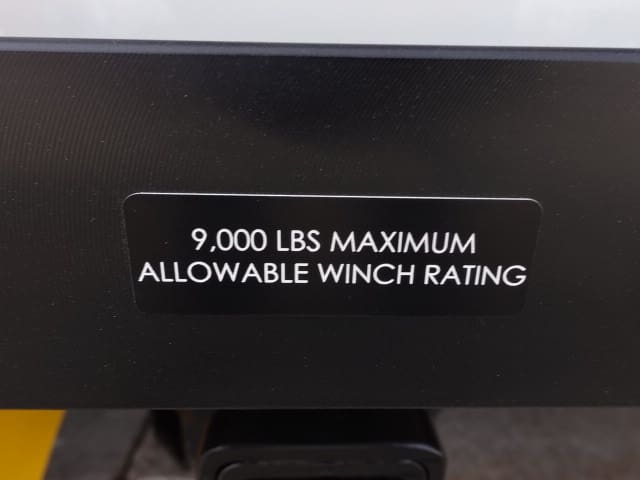

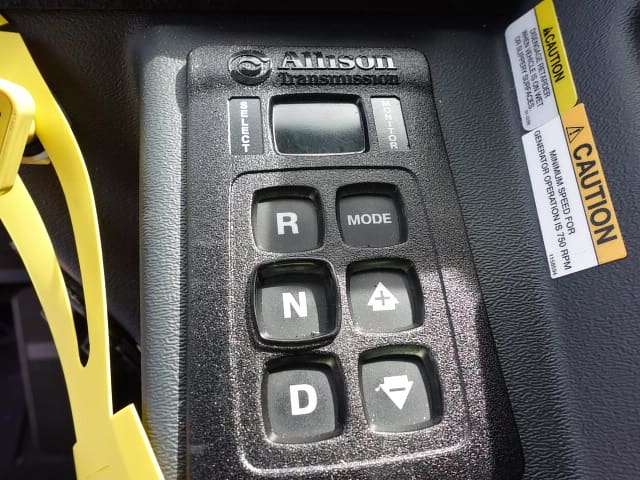

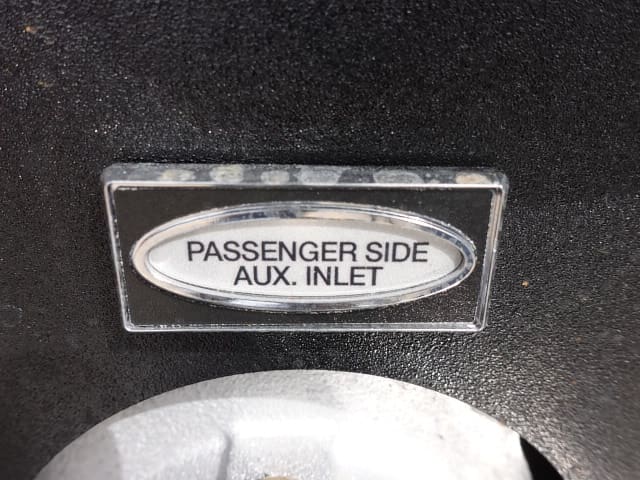

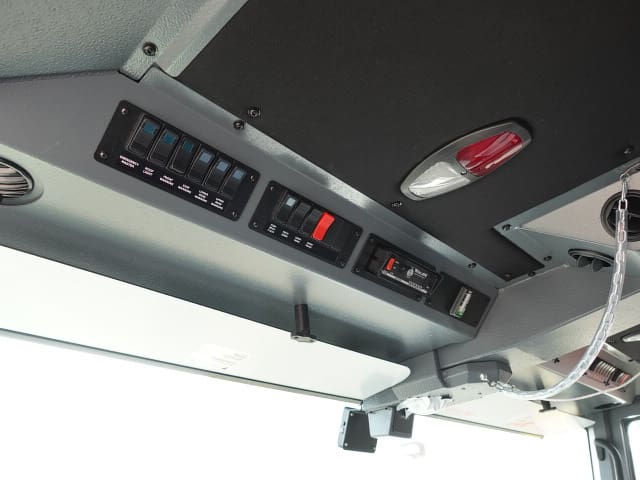

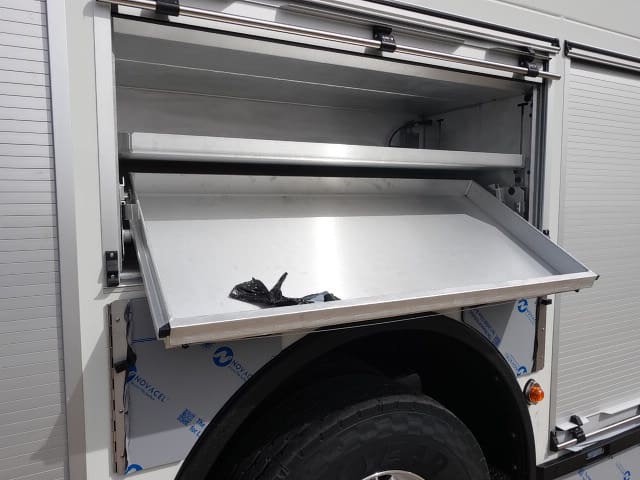

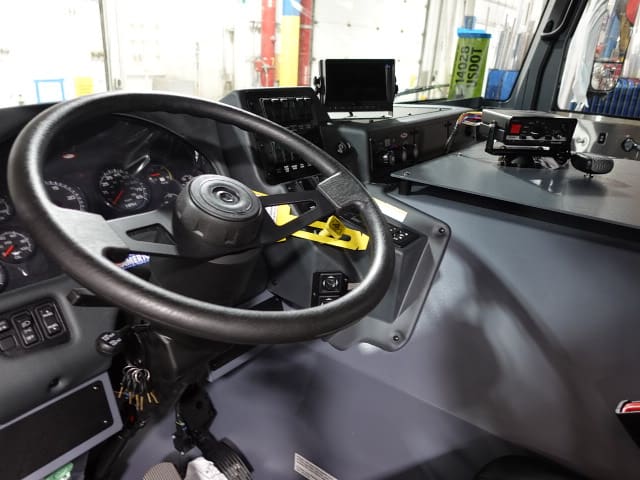

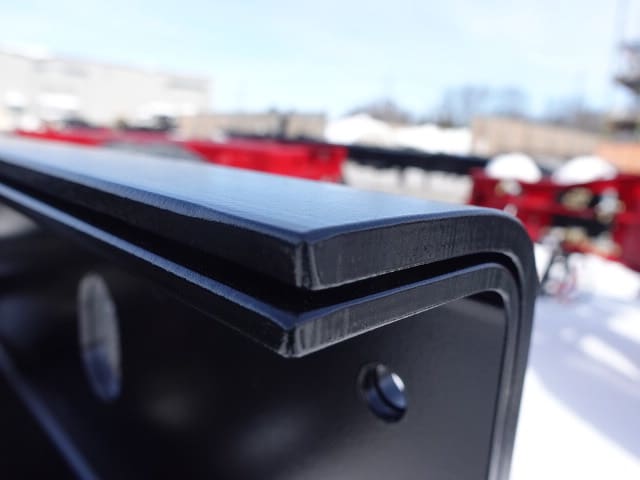

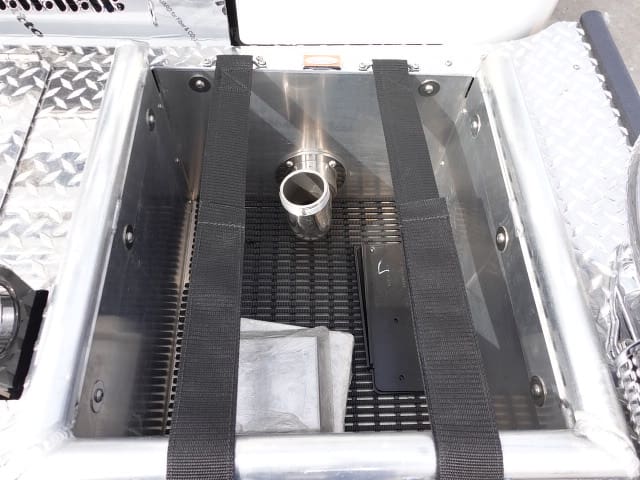

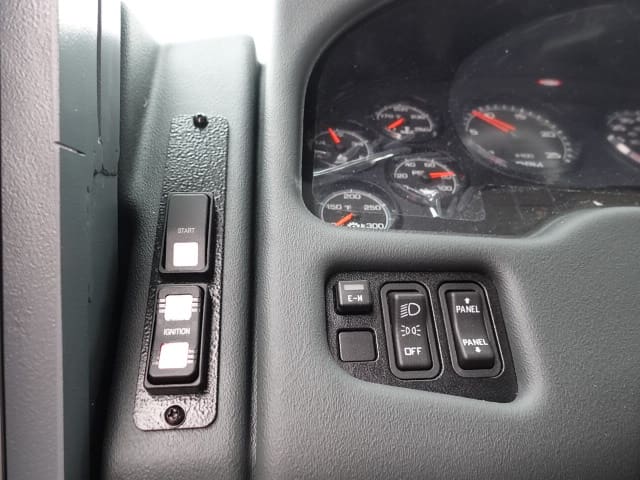

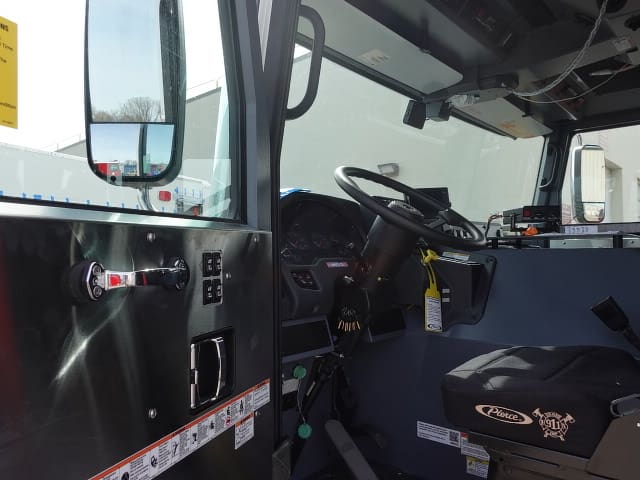

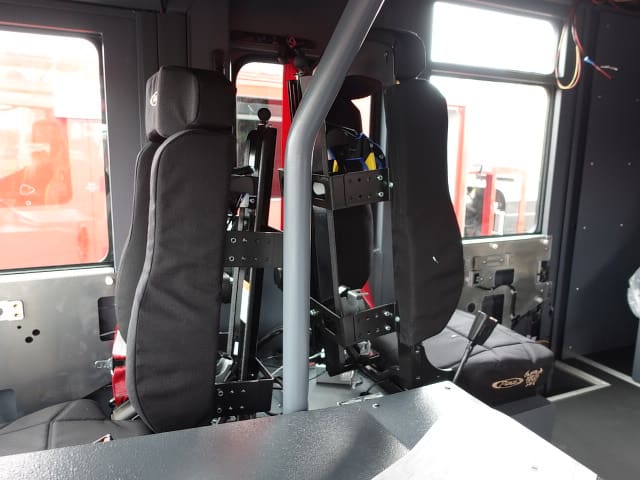

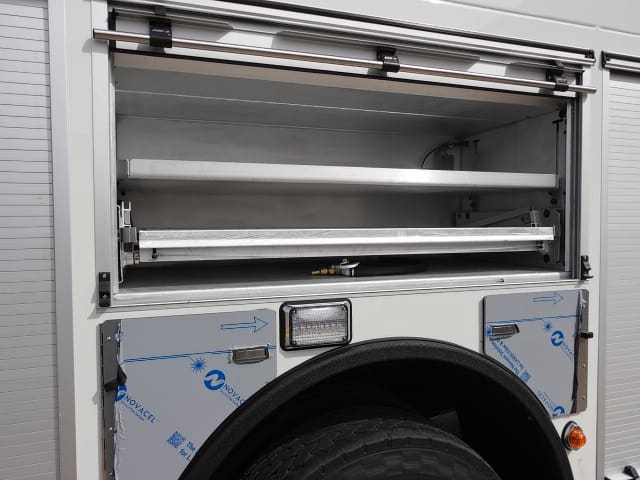

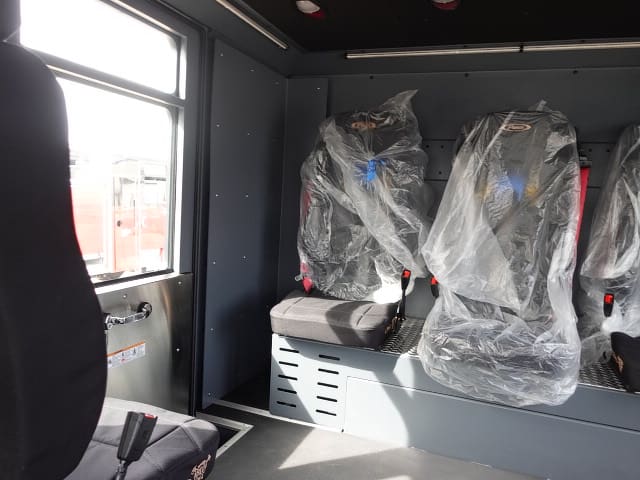

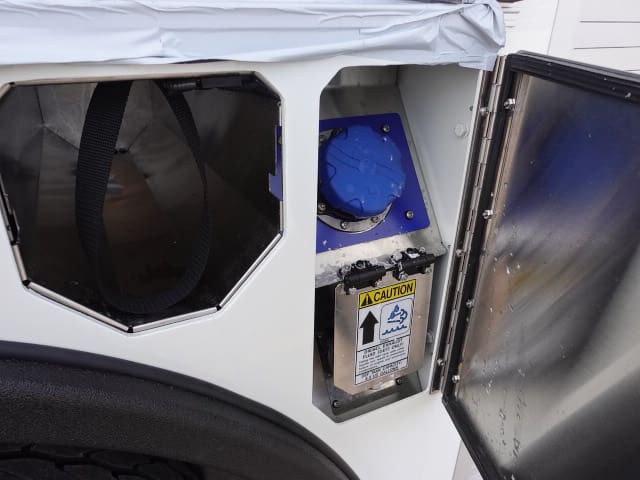

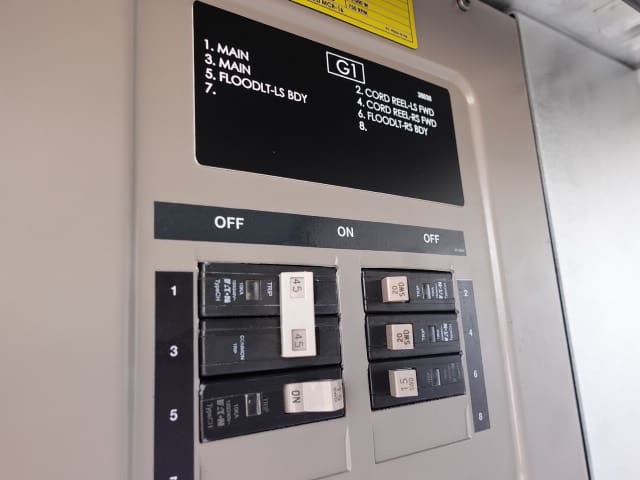

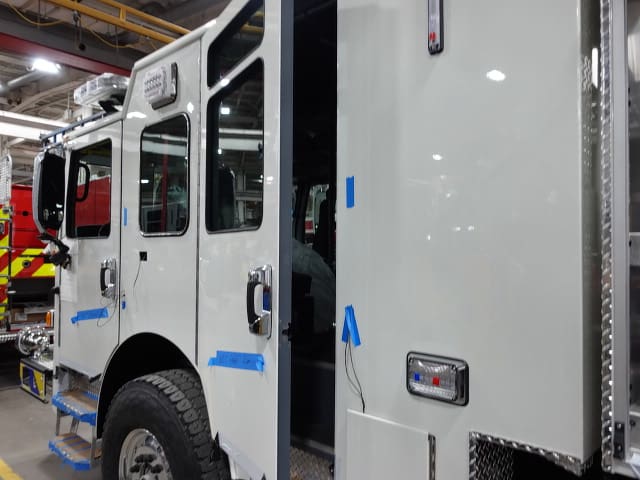

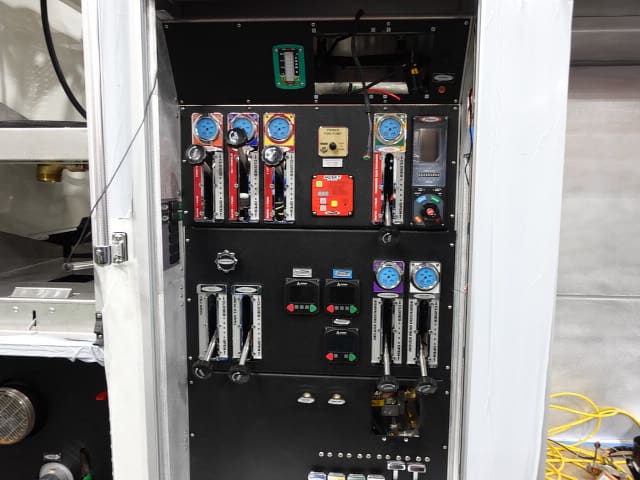

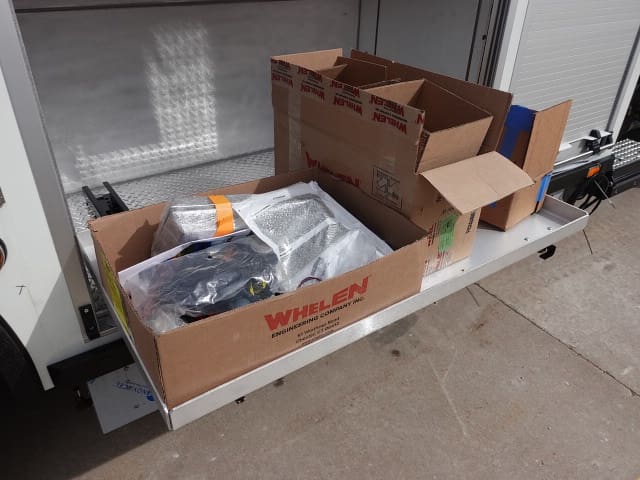

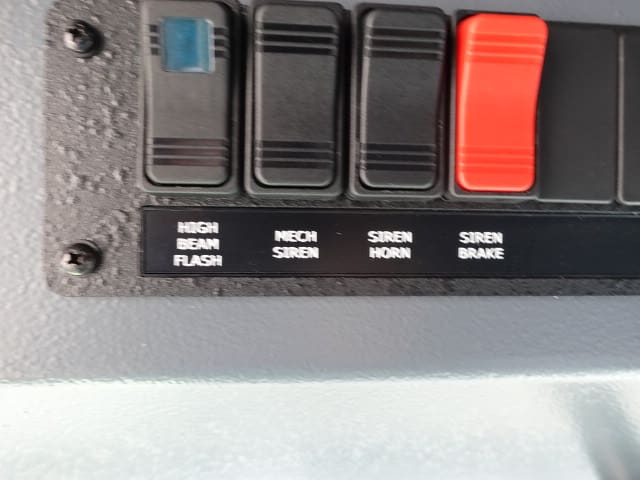

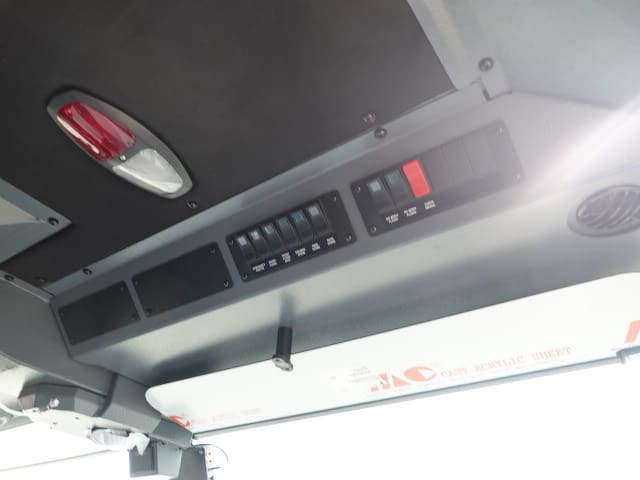

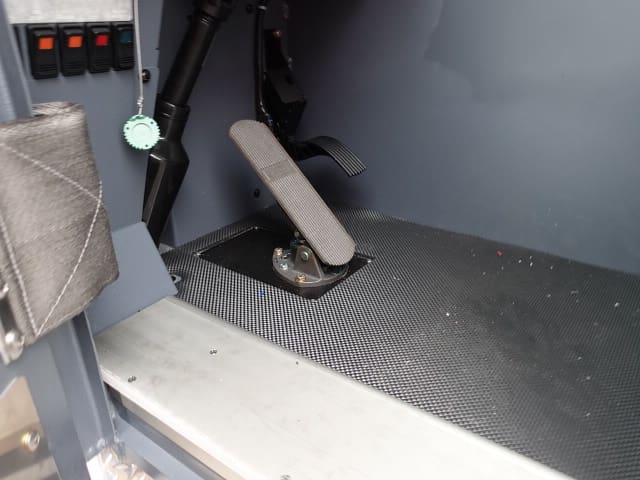

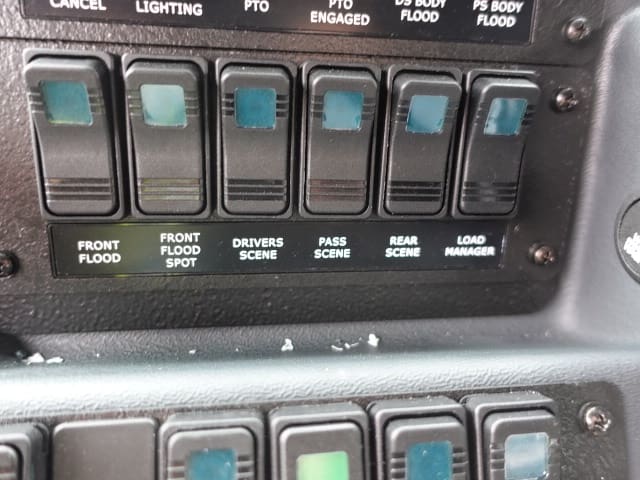

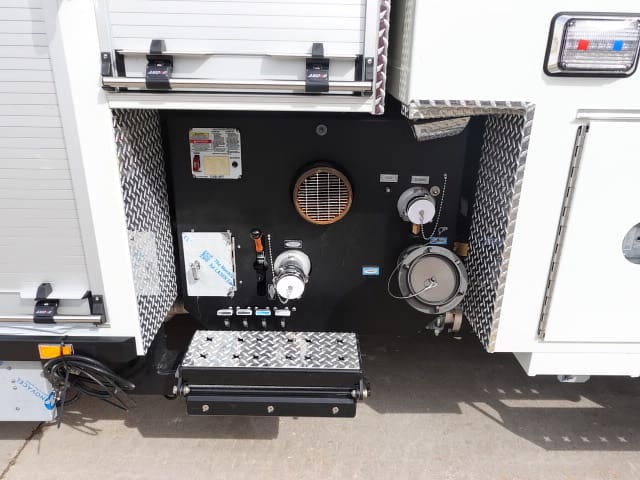

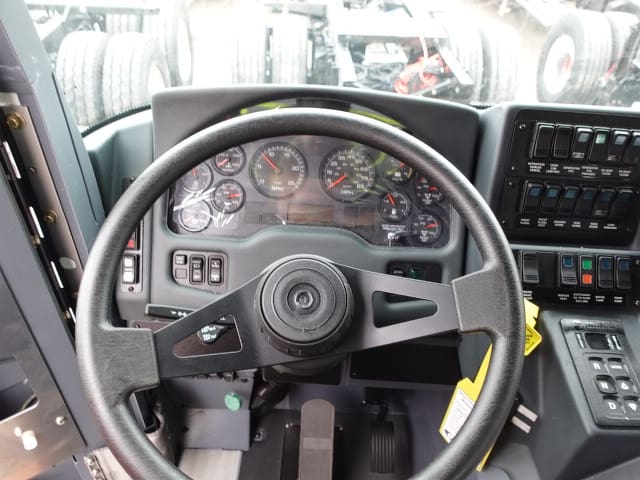

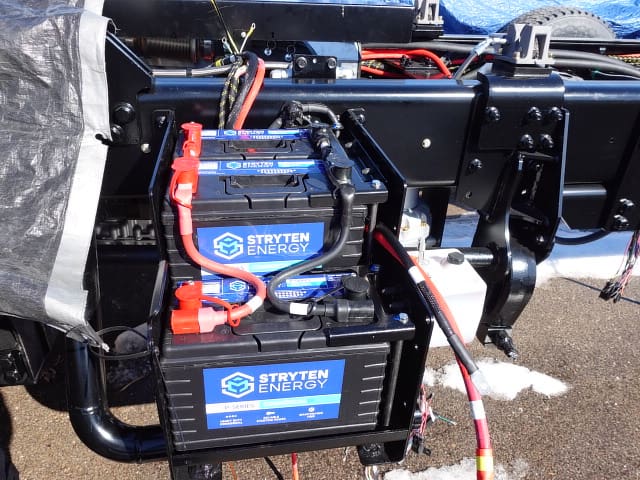

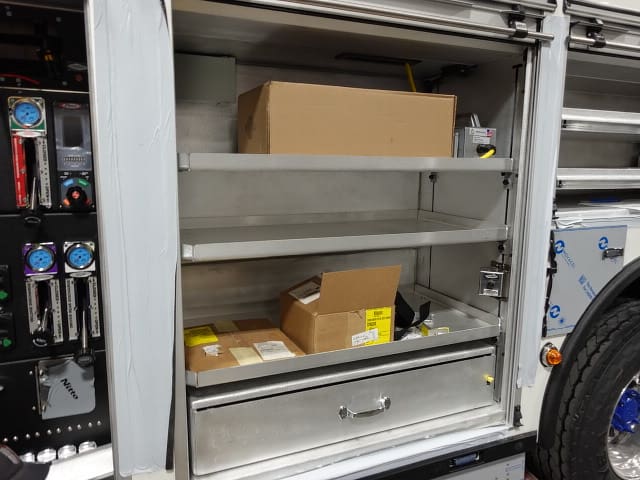

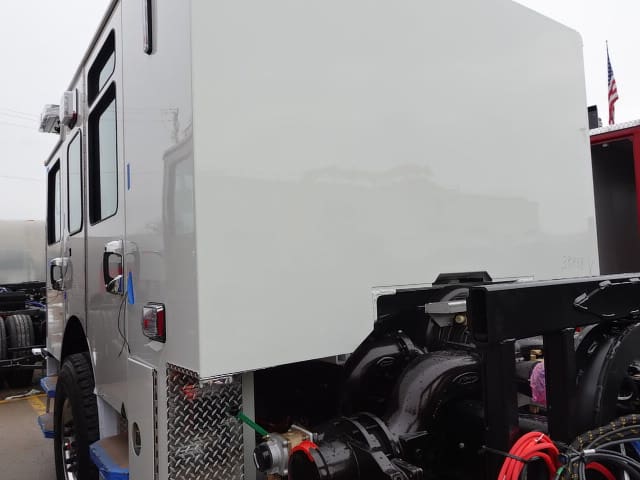

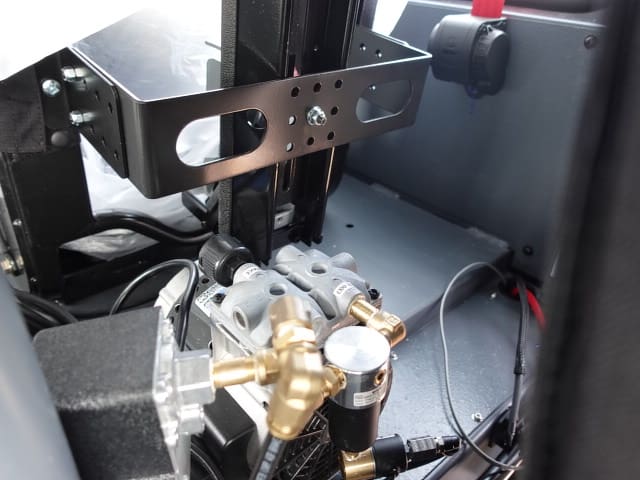

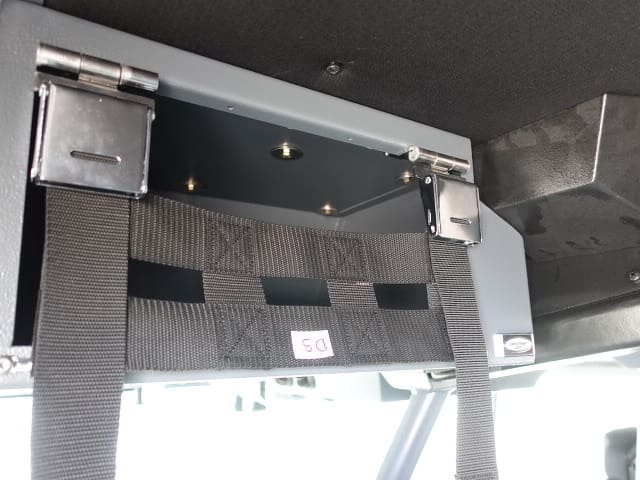

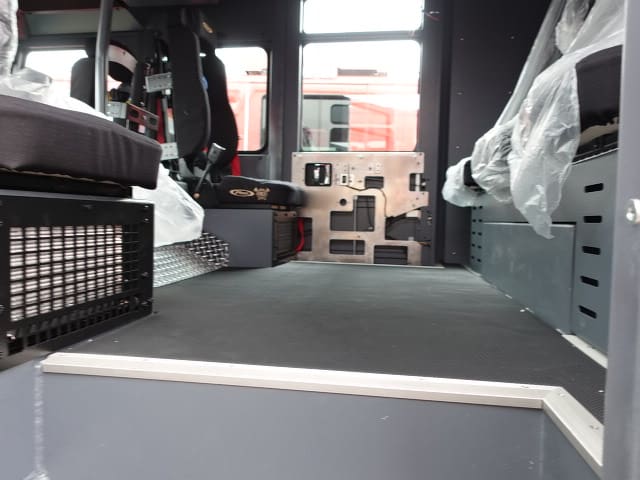

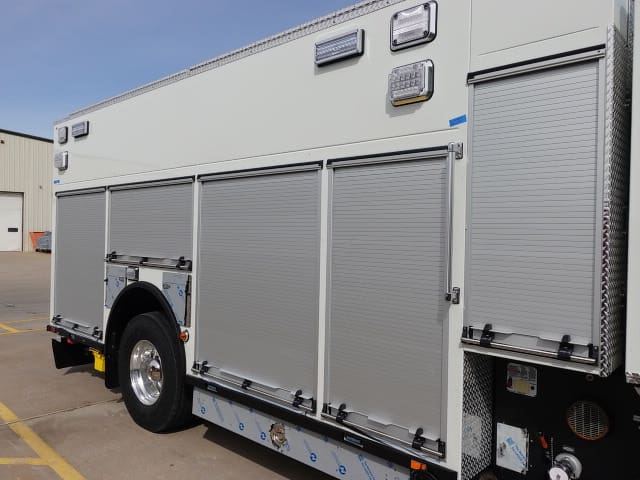

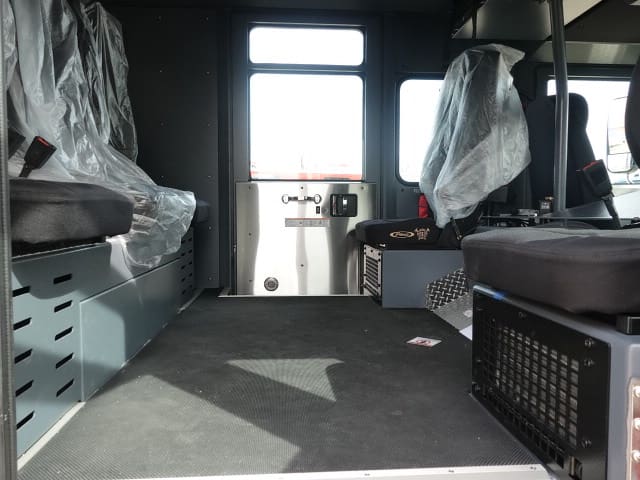

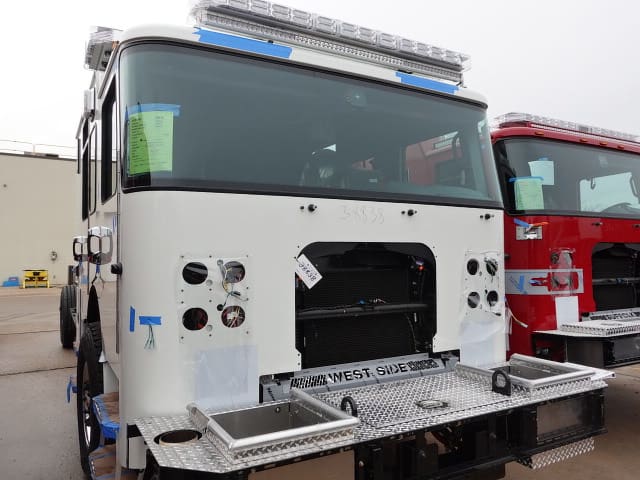

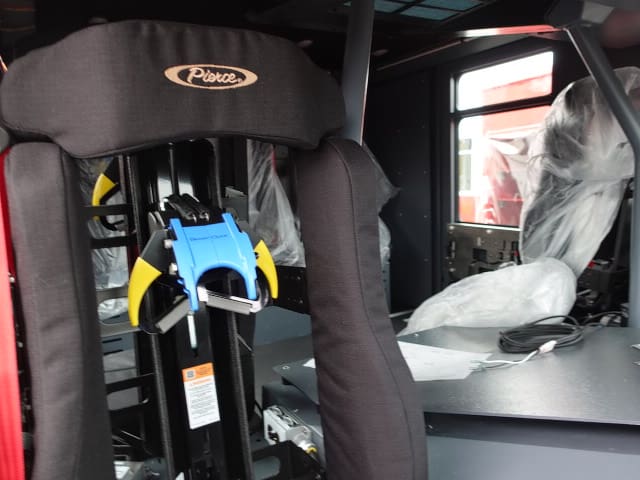

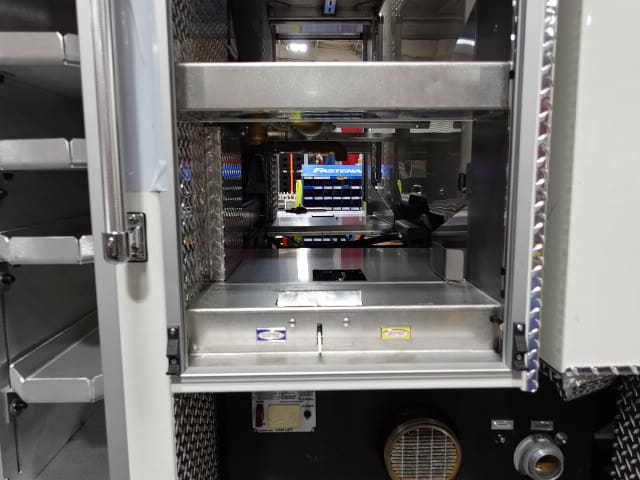

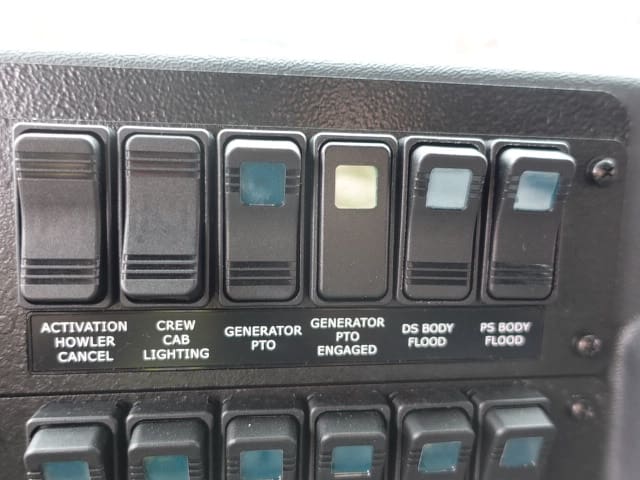

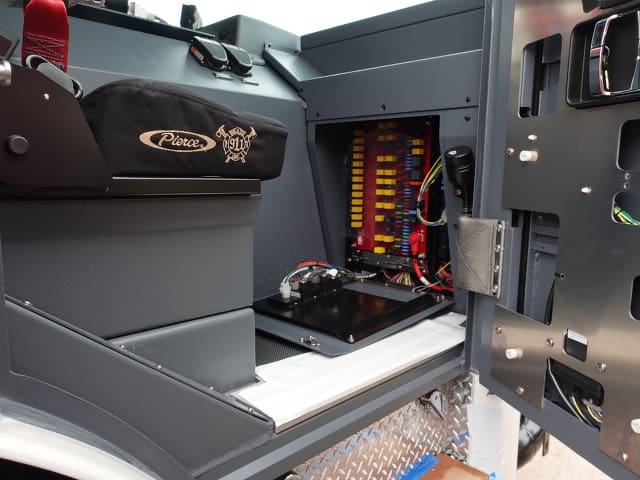

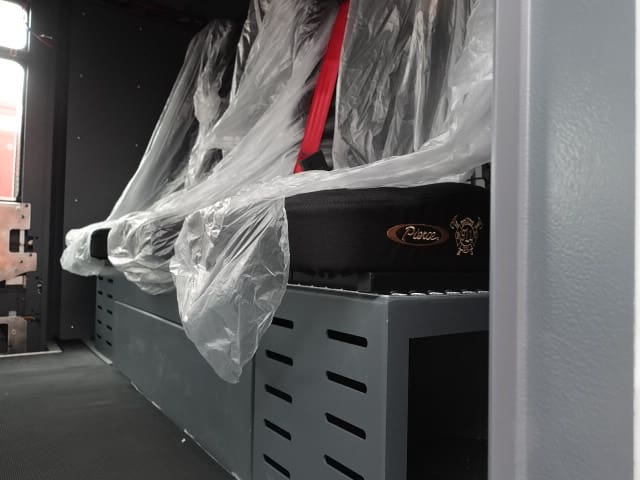

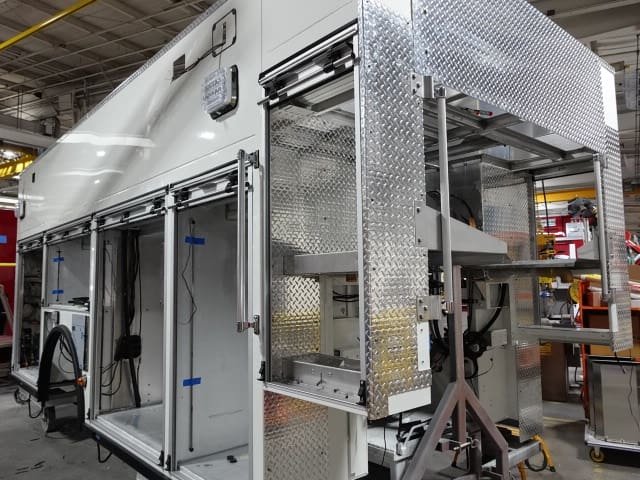

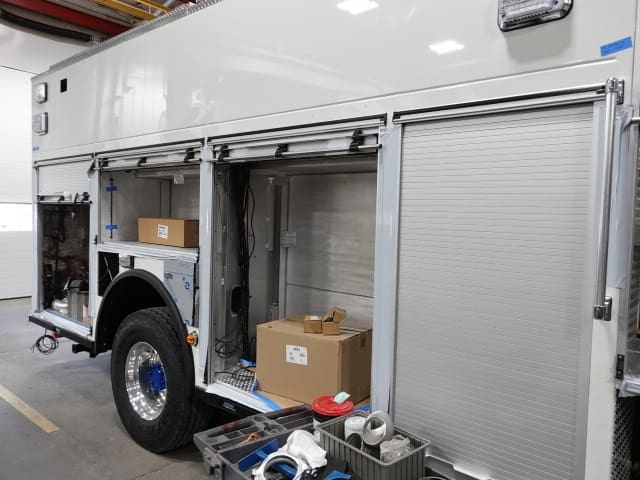

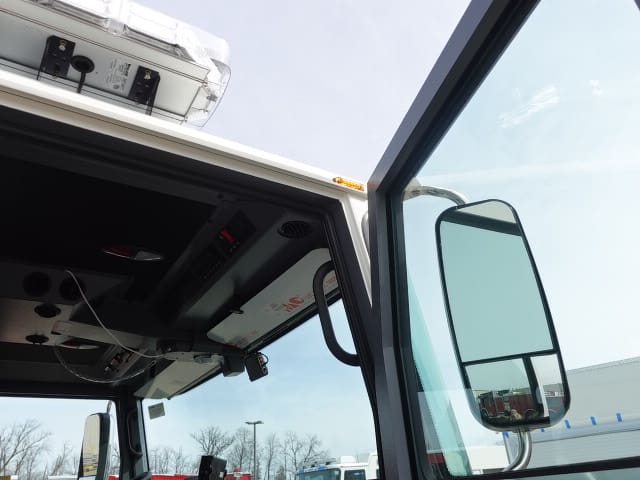

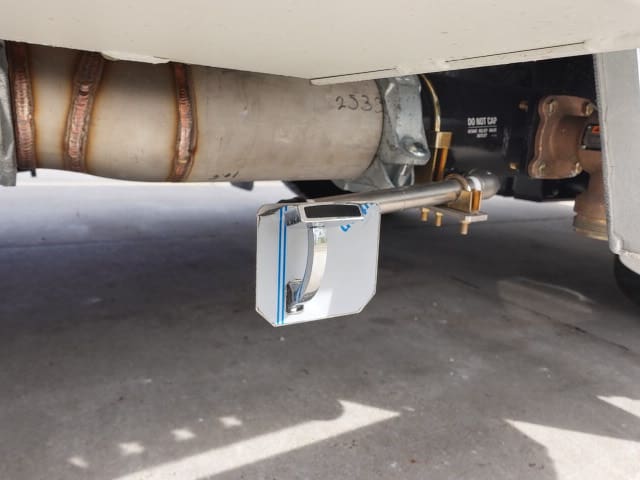

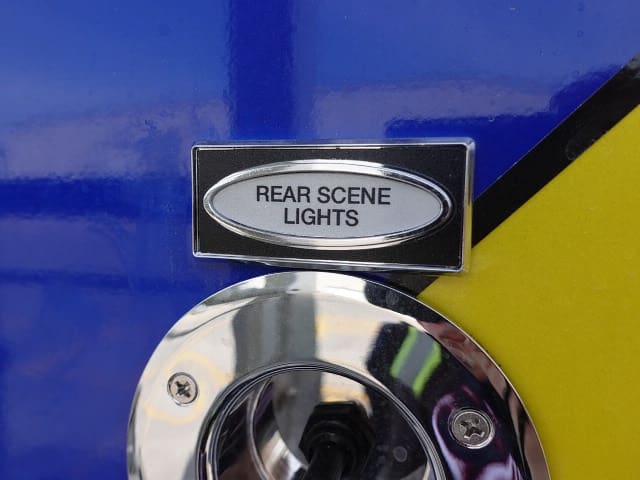

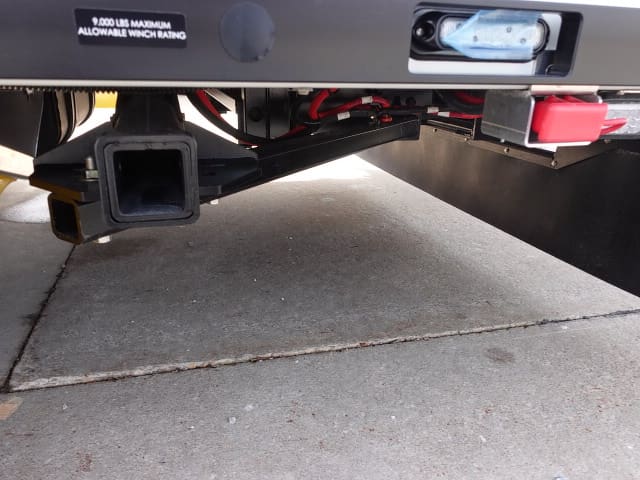

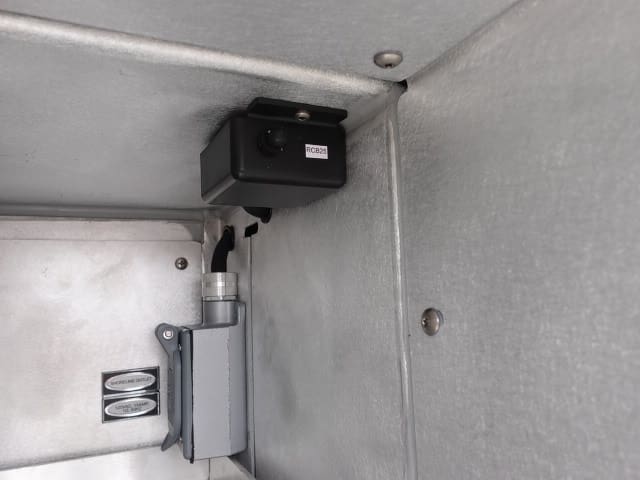

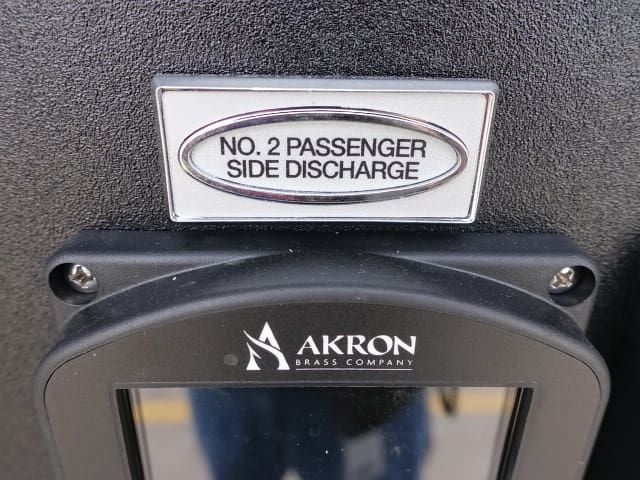

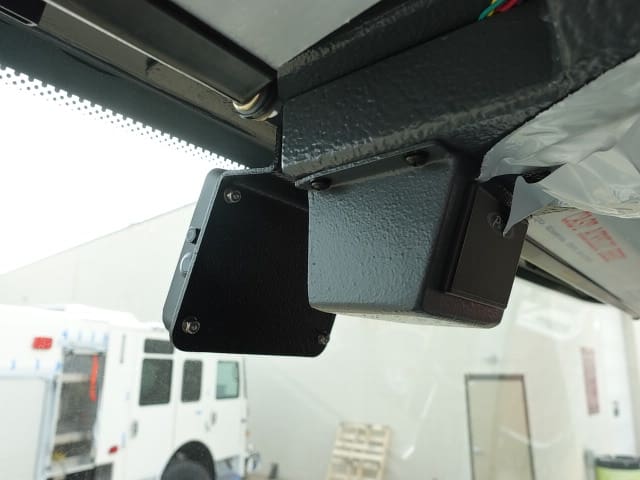

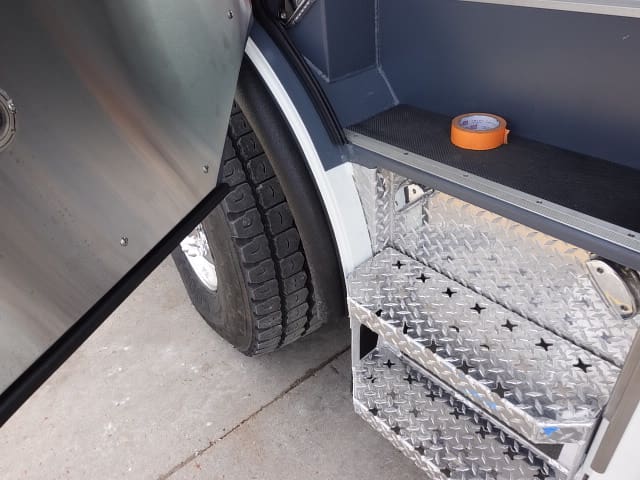

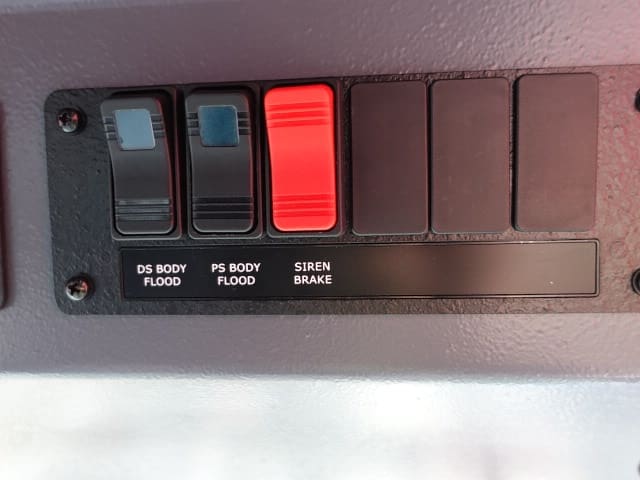

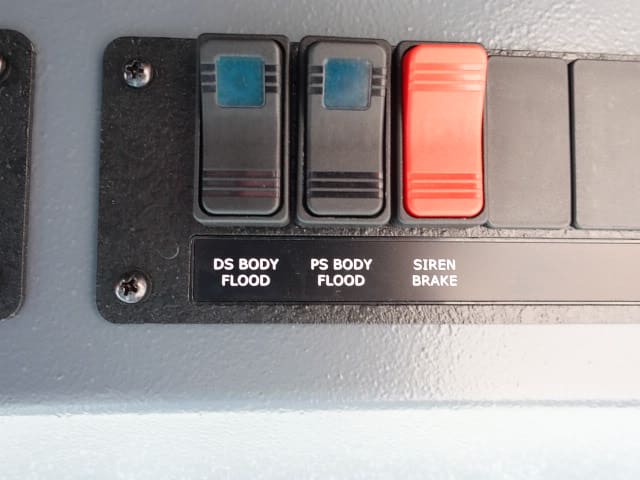

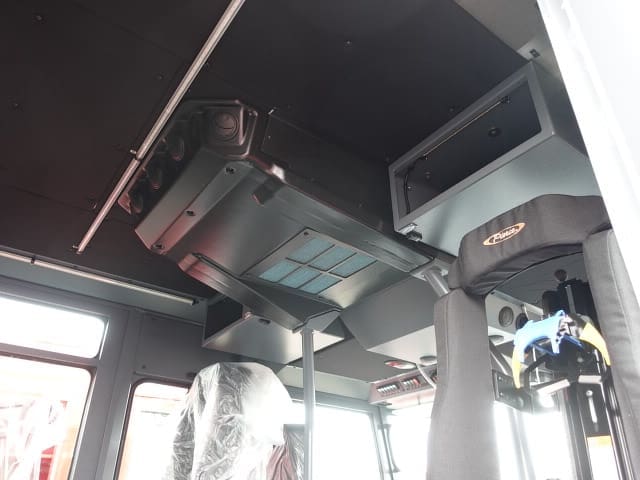

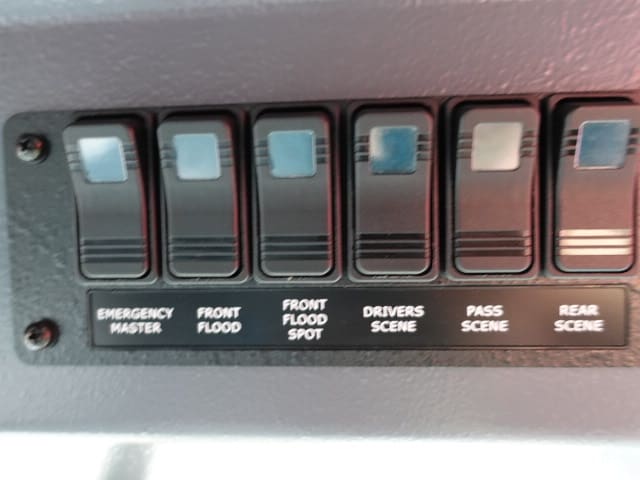

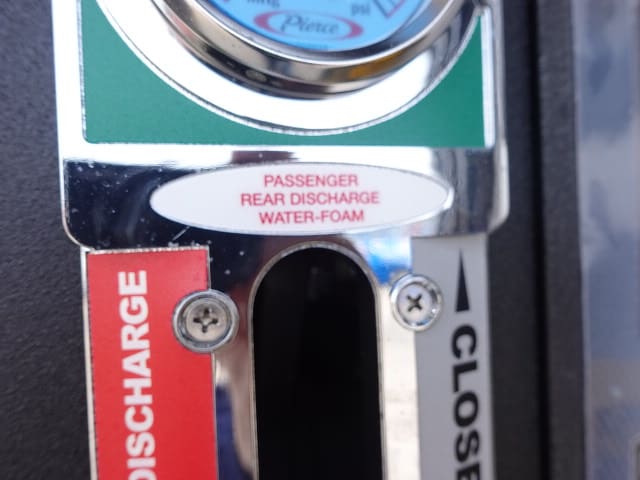

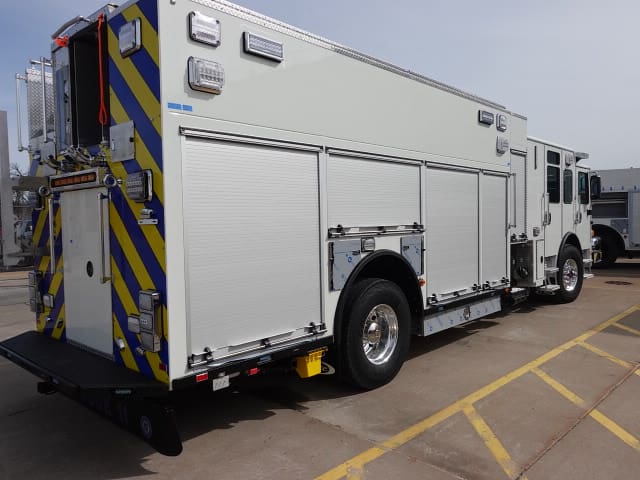

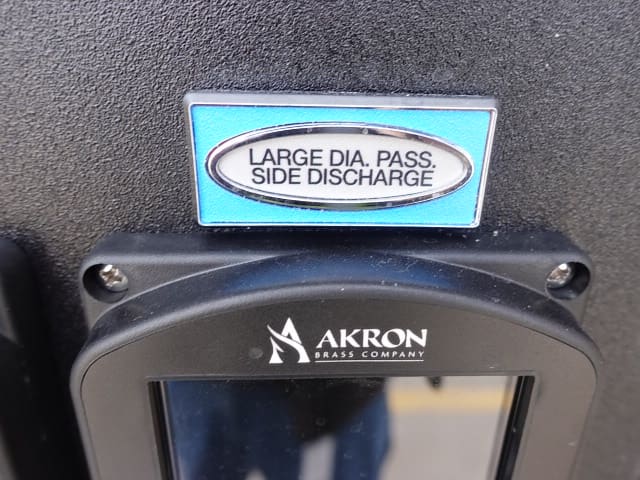

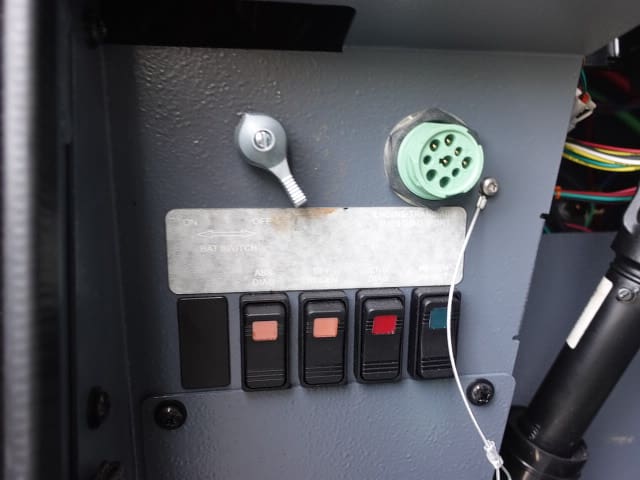

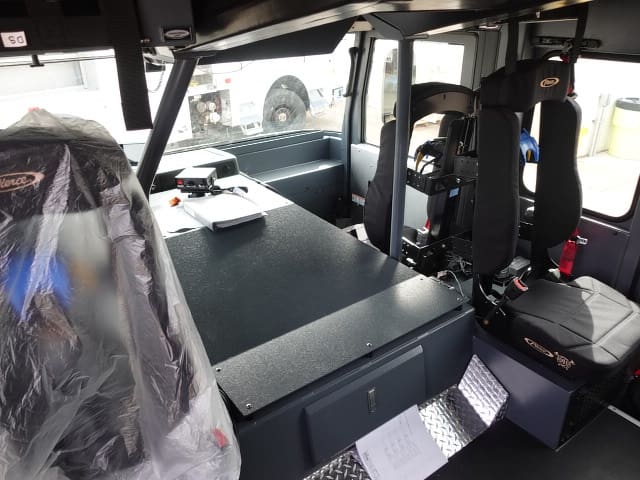

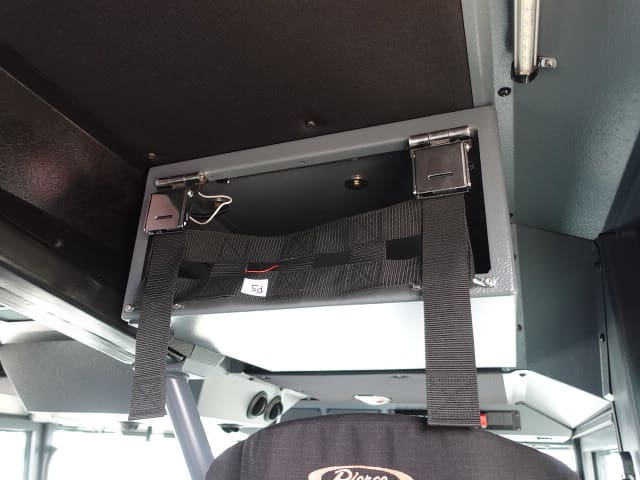

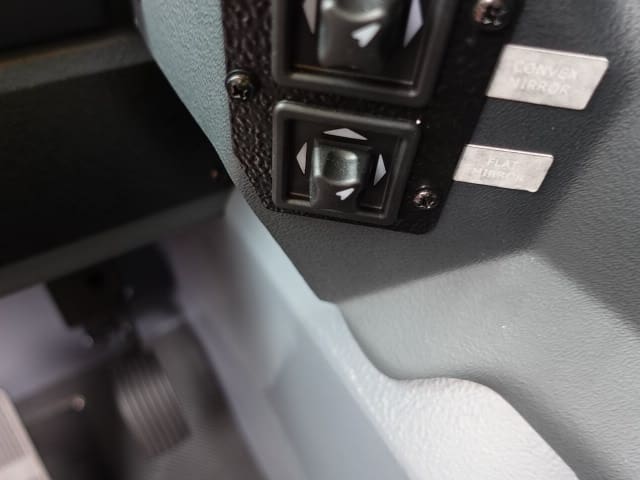

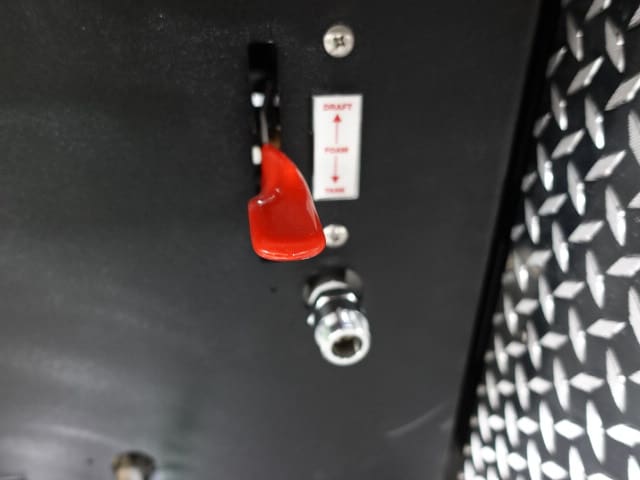

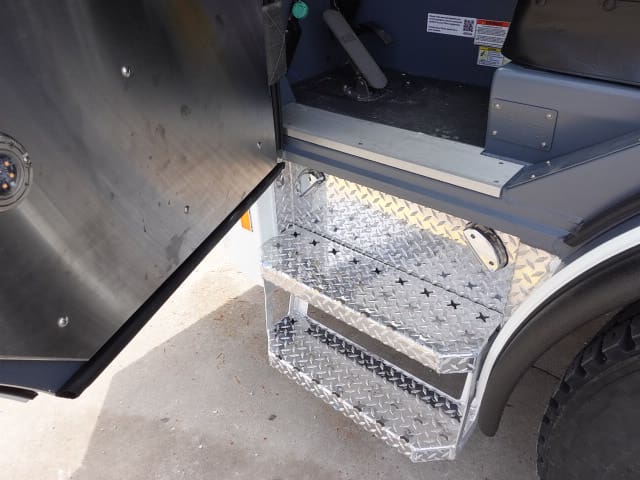

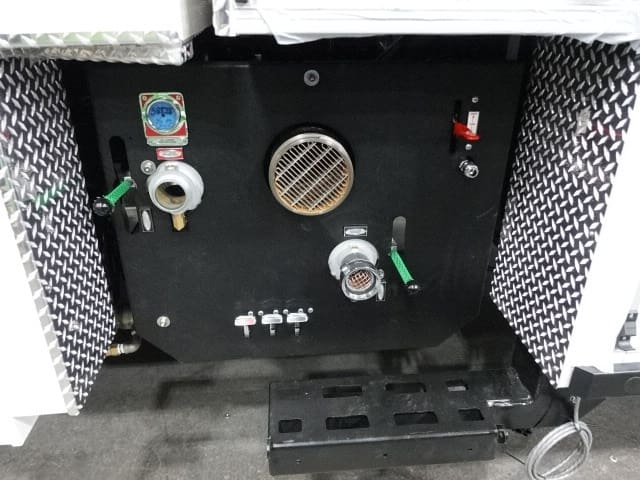

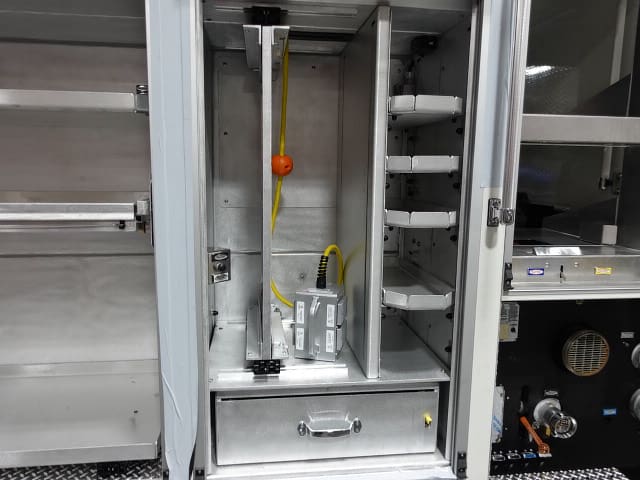

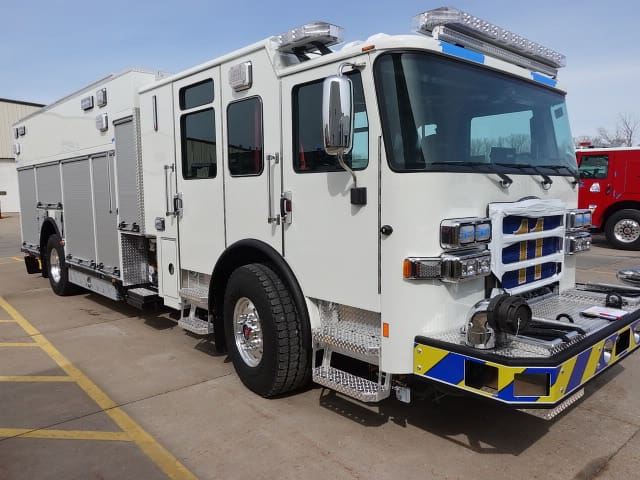

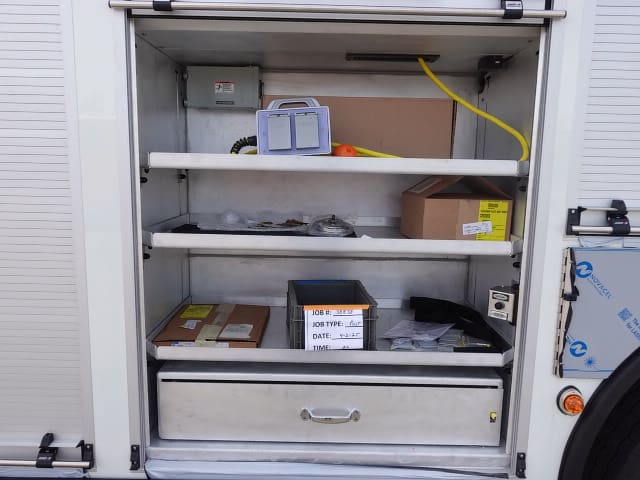

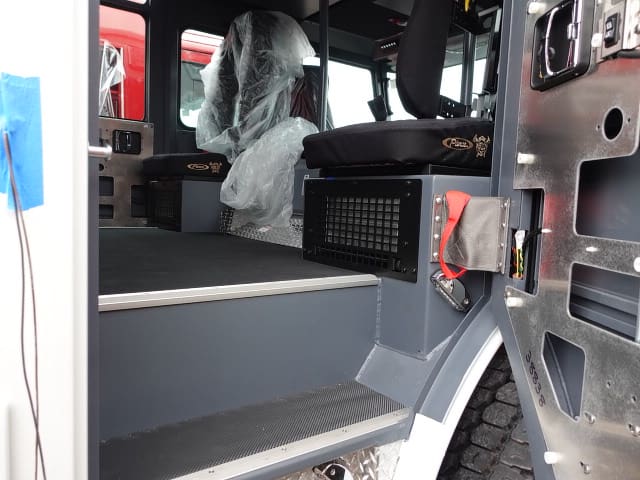

In this report, the apparatus completed final assembly and test followed by release to quality and graphics where any remaining content will be applied. Once finished it will be made ready for the customer acceptance inspection. This is the last scheduled report.
03-14-25

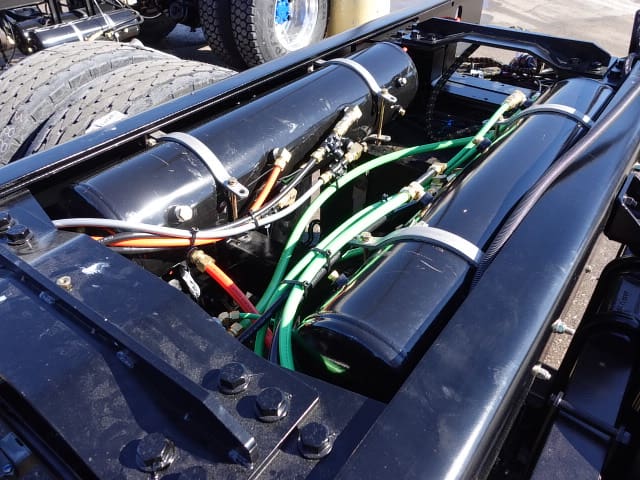

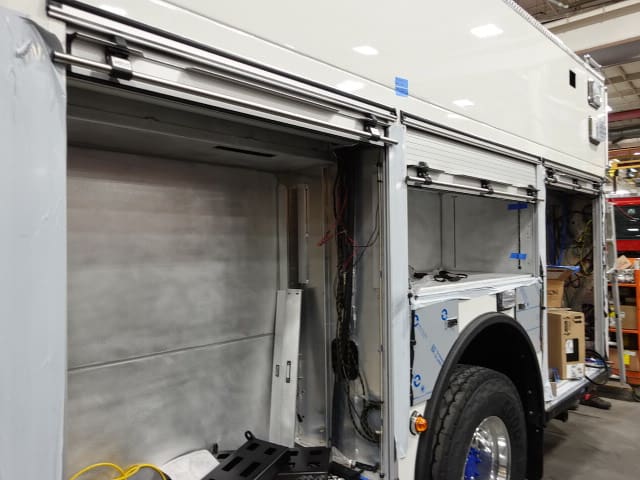

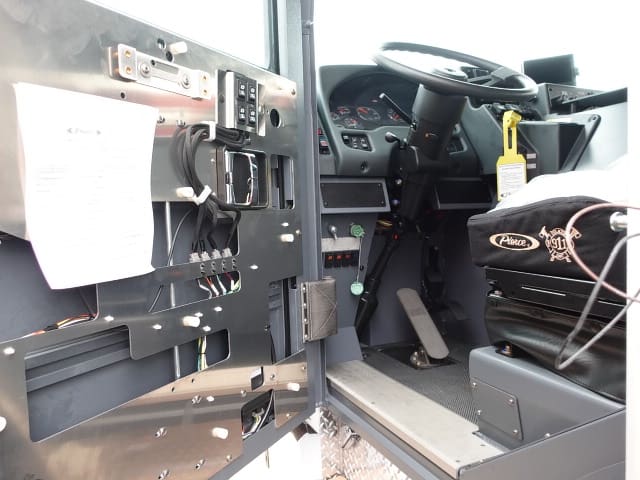

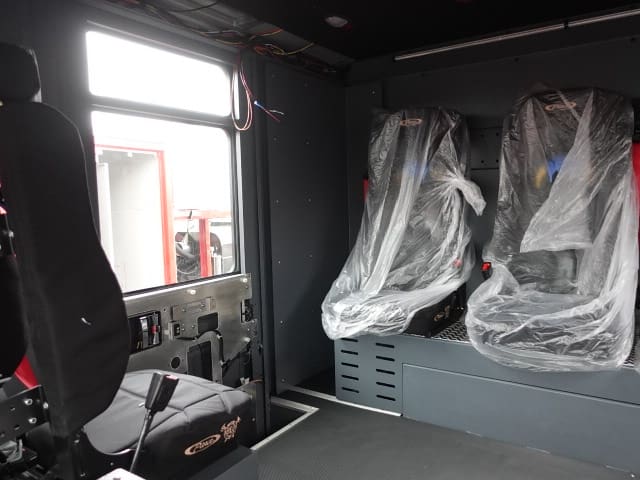

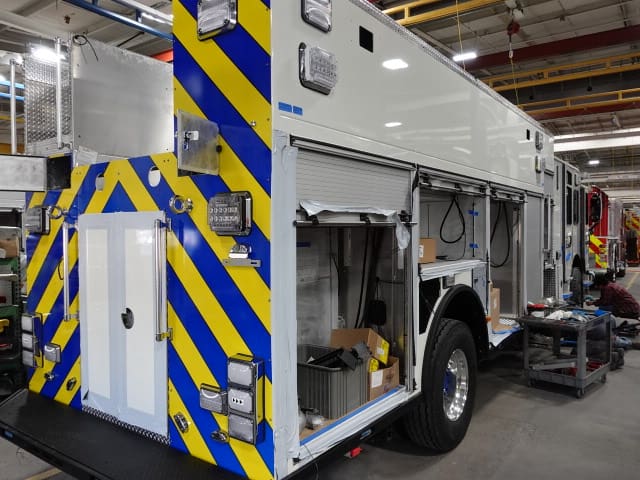

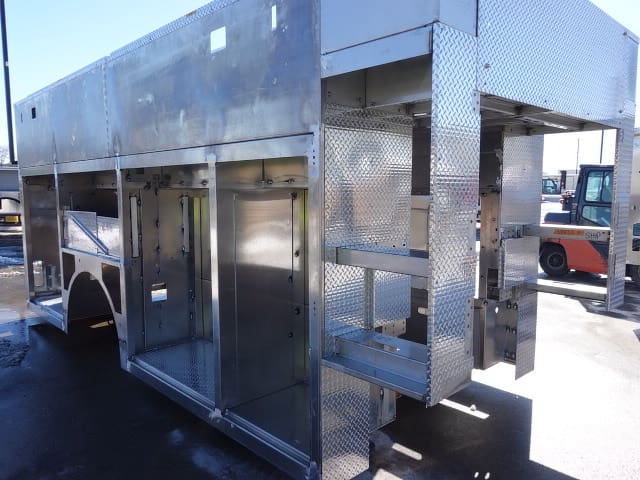

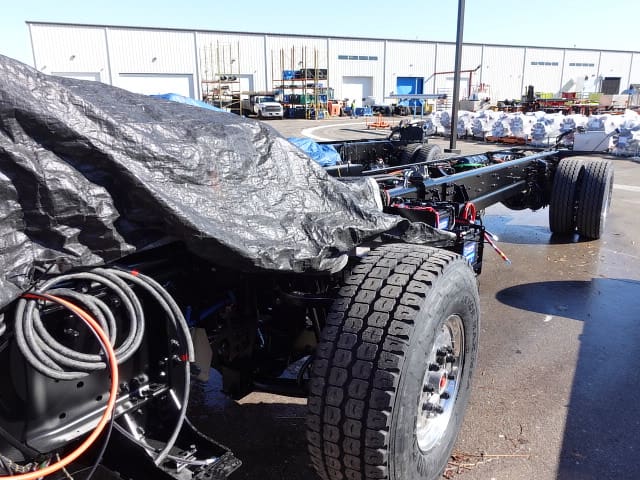

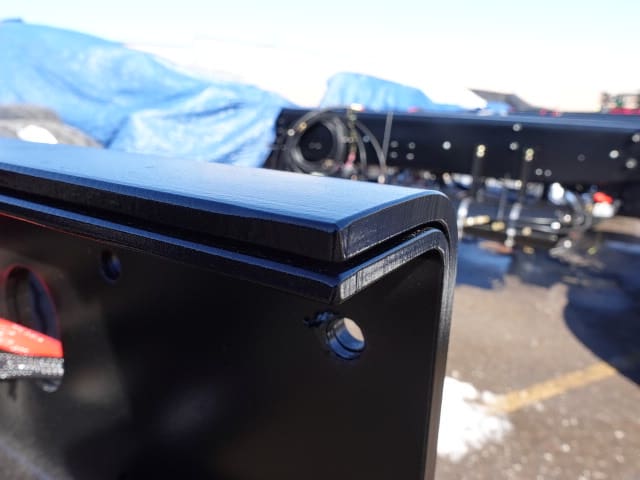

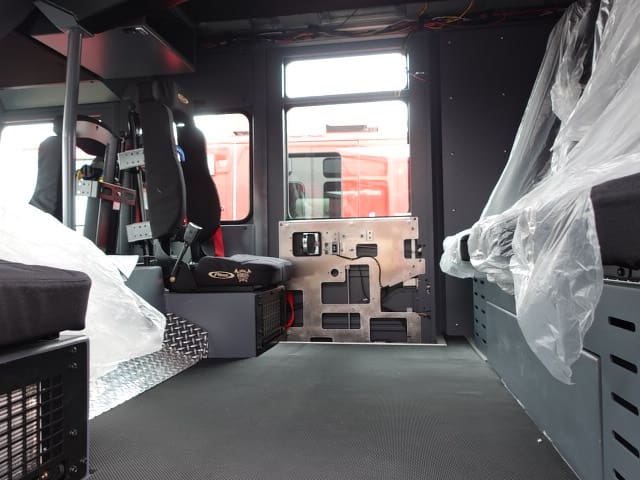

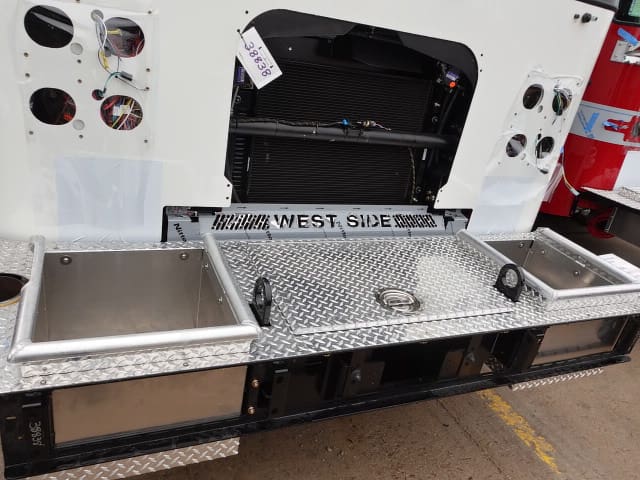

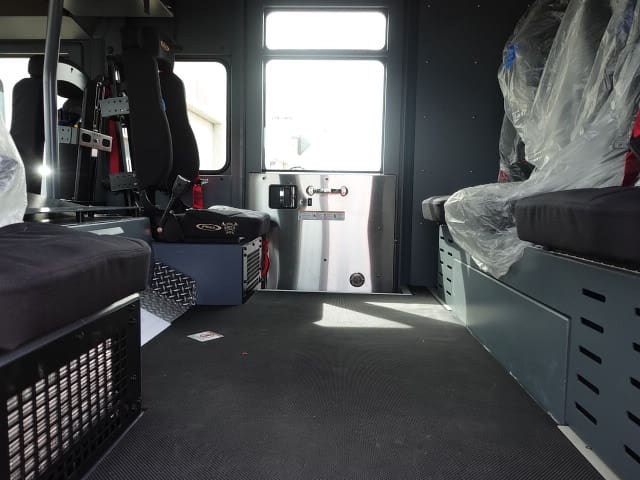

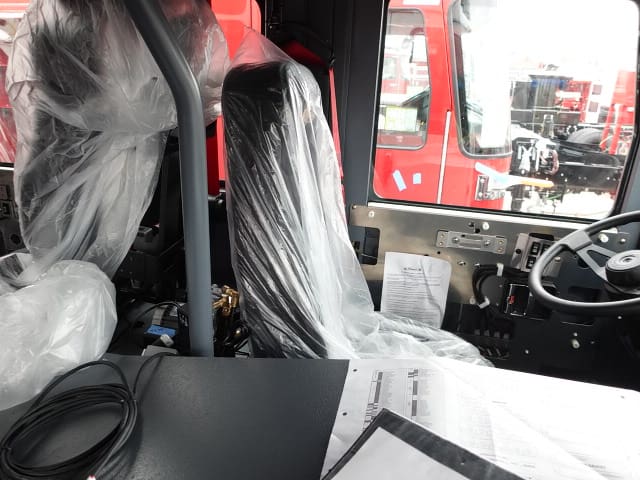

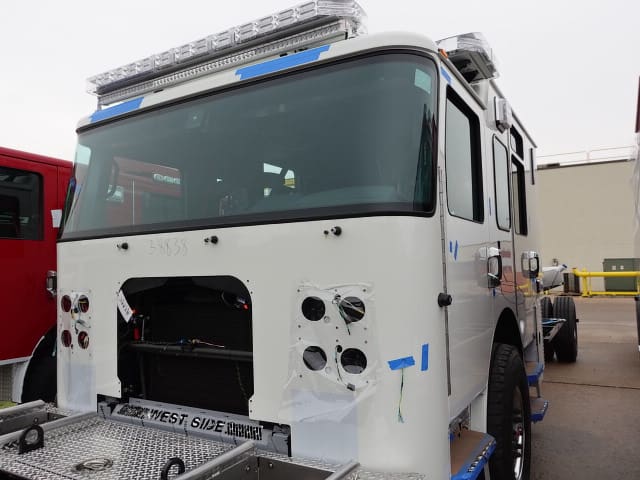

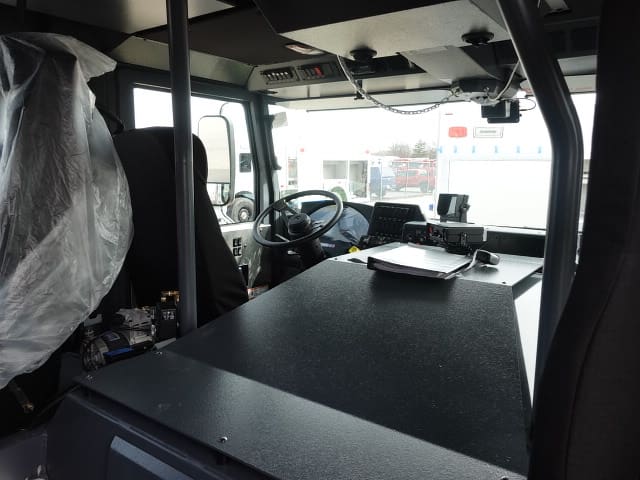

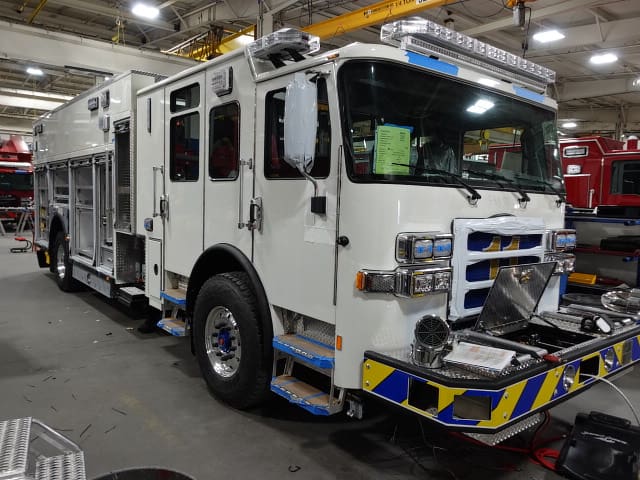

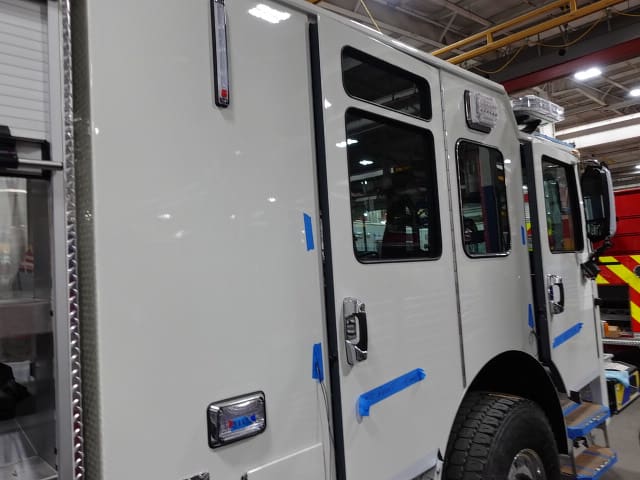

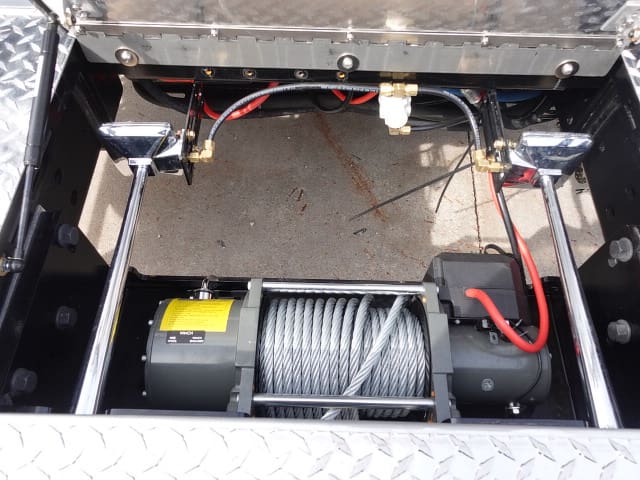

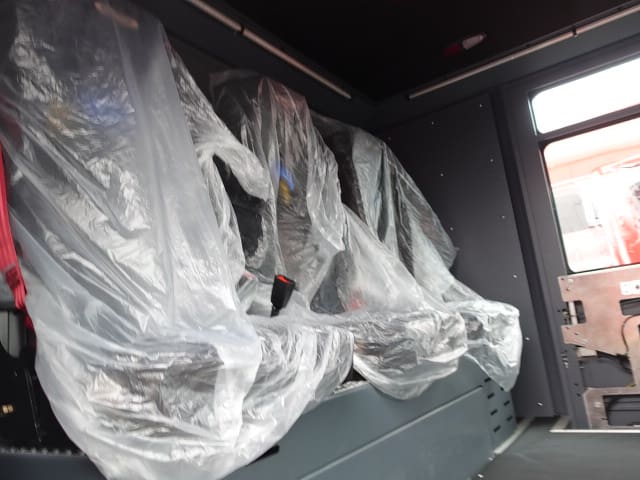

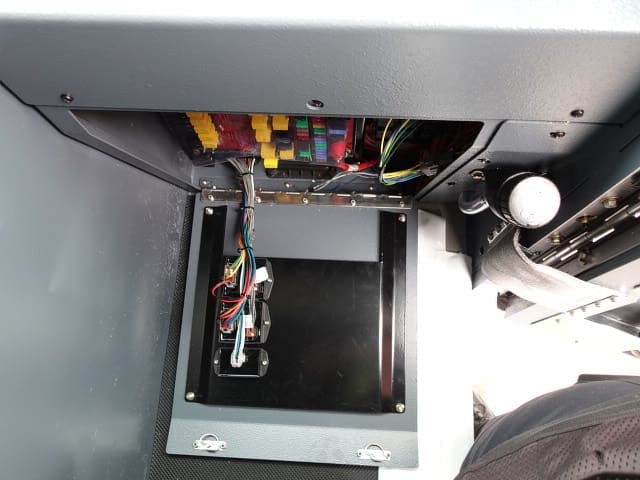

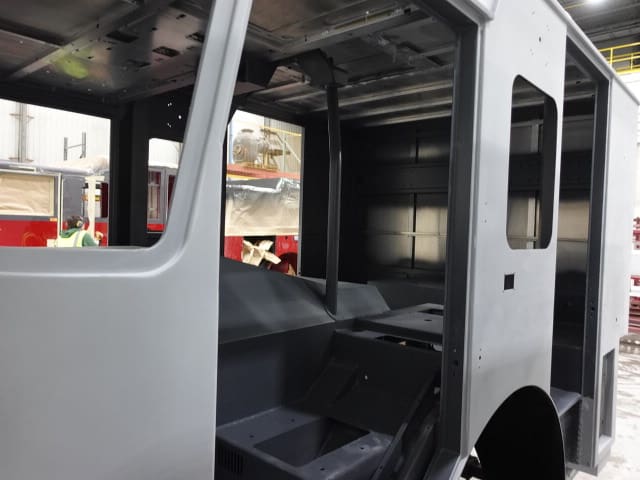

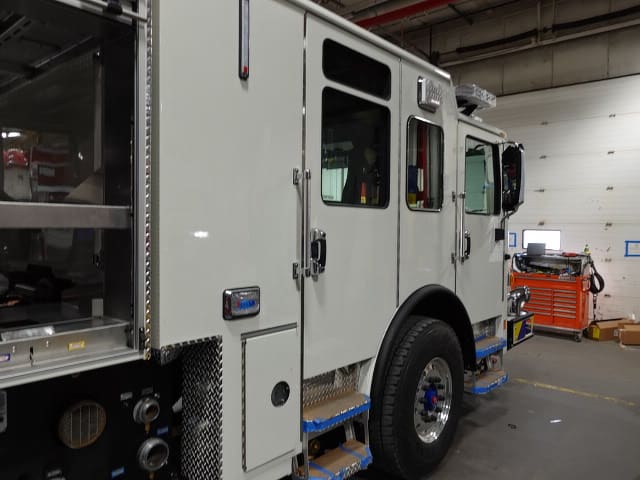

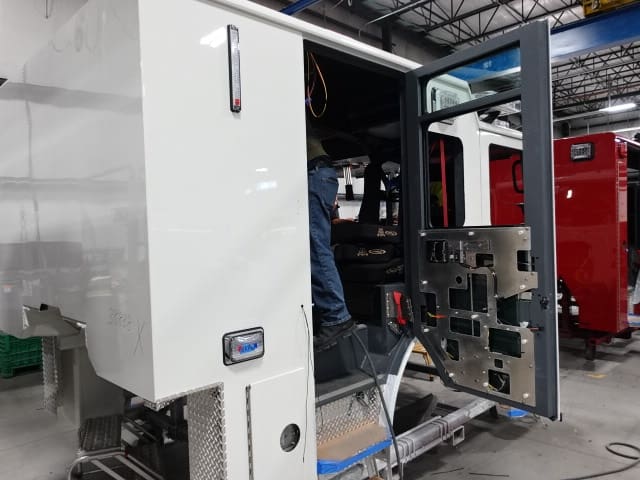

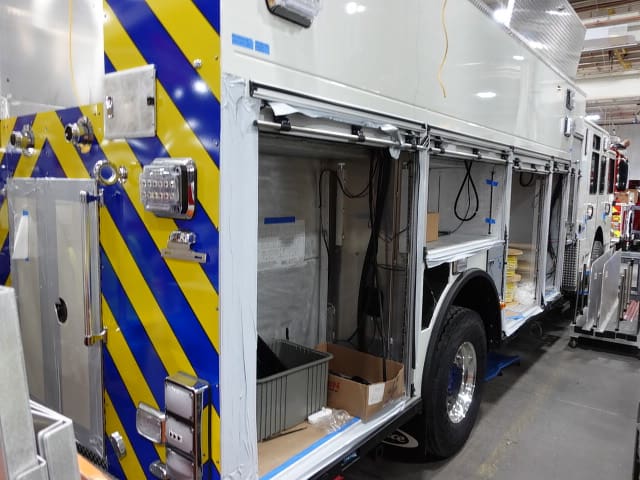

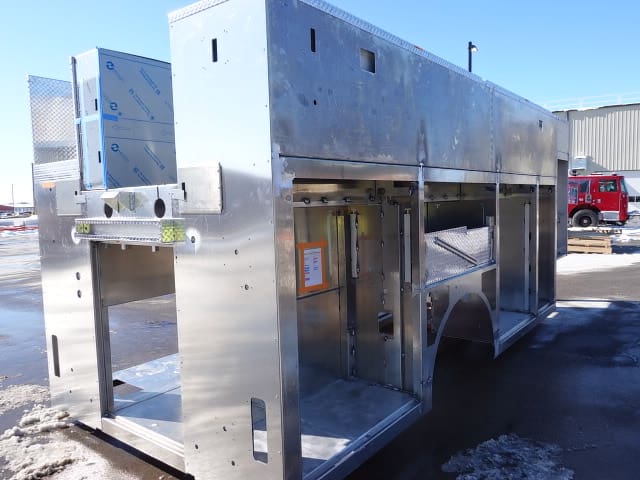

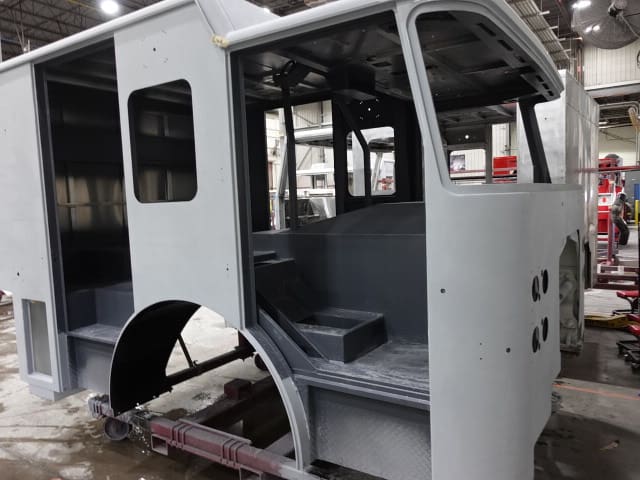

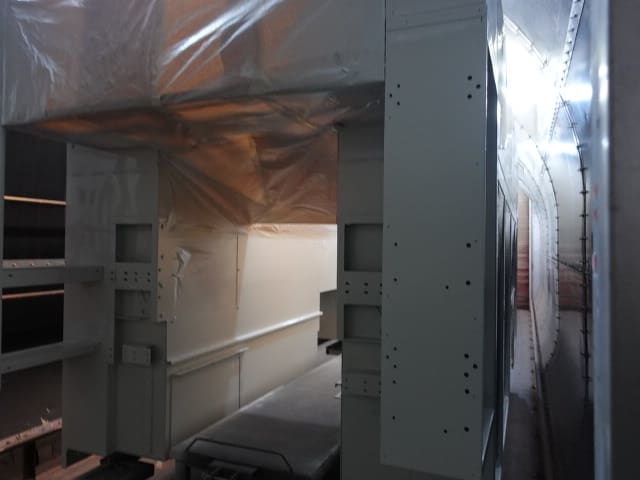

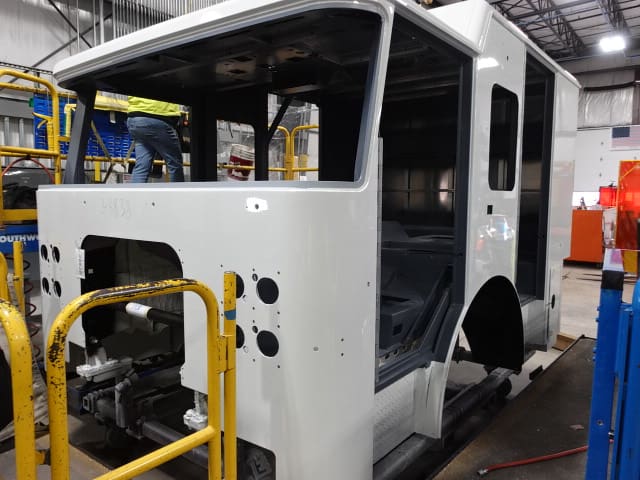

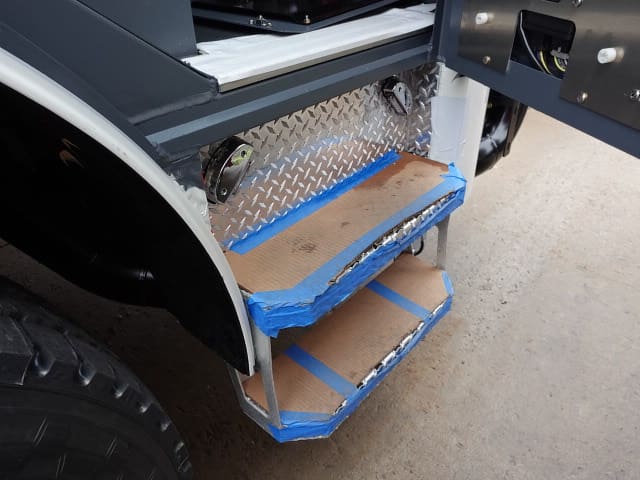

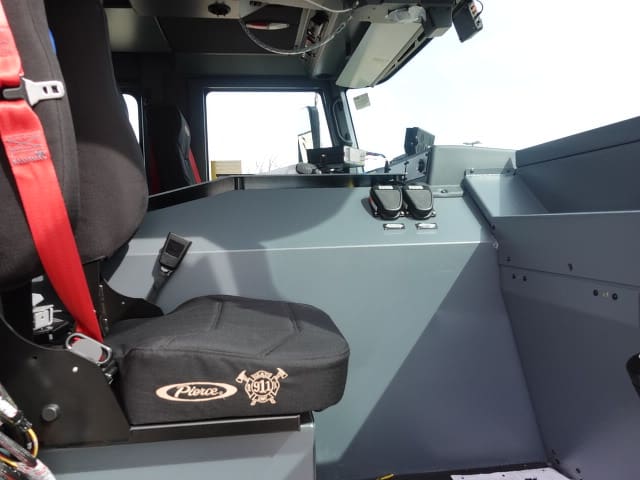

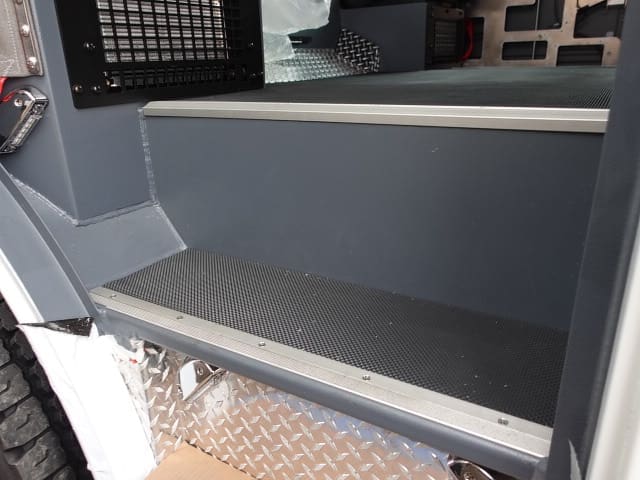

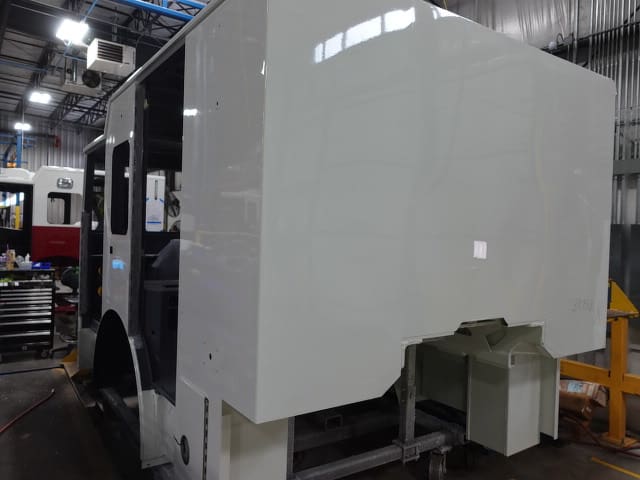

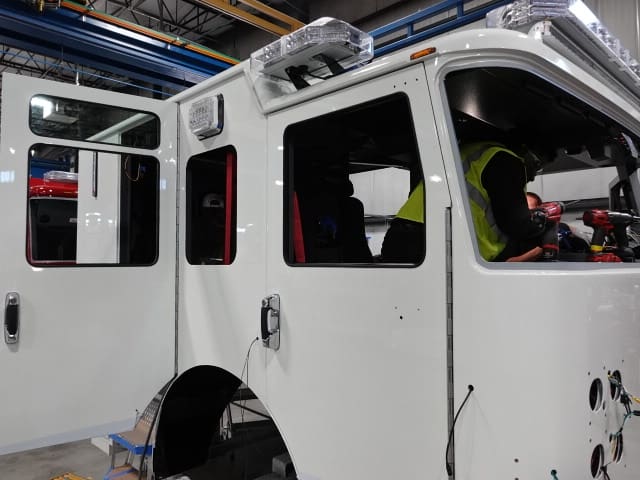

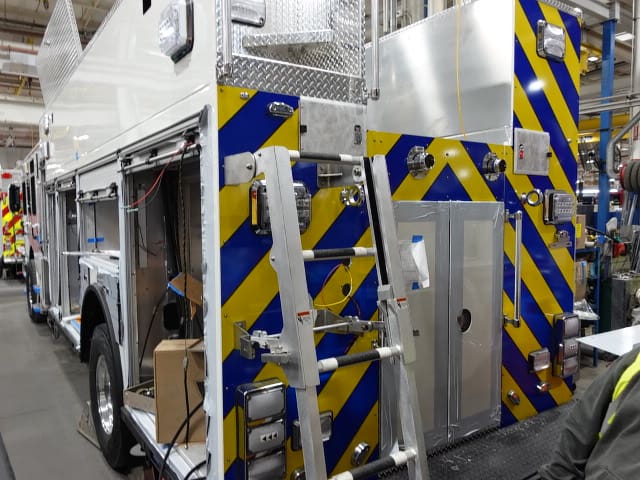

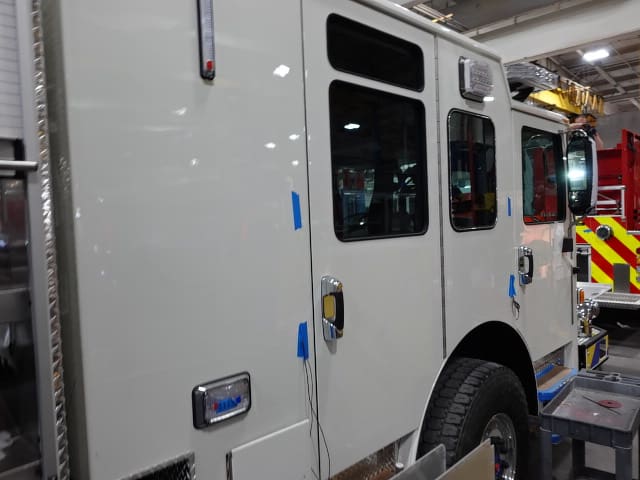

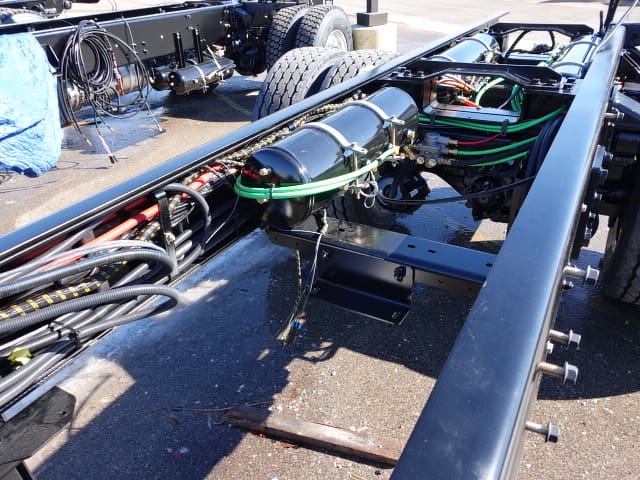

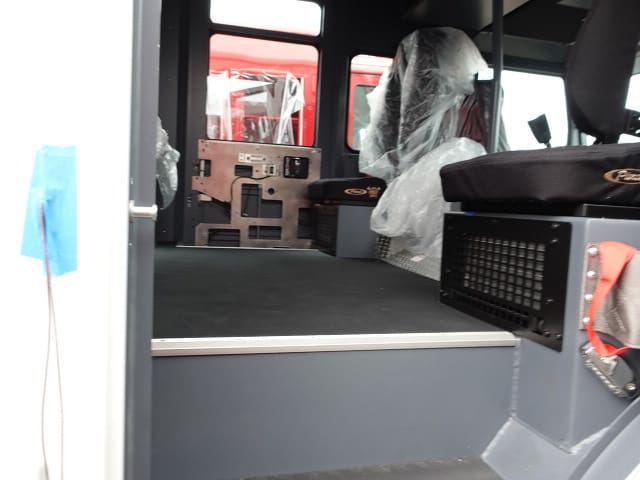

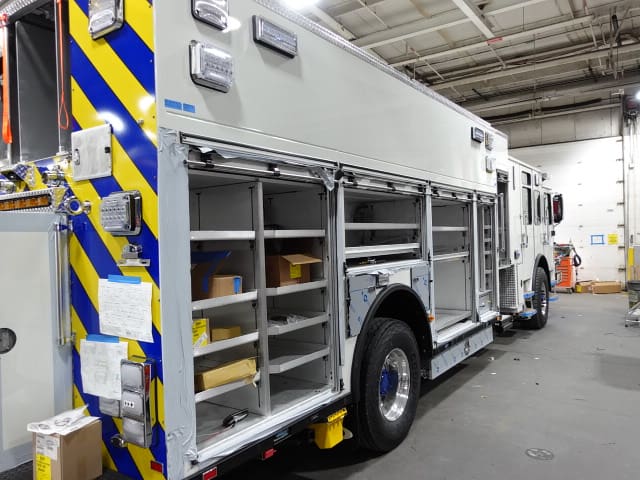

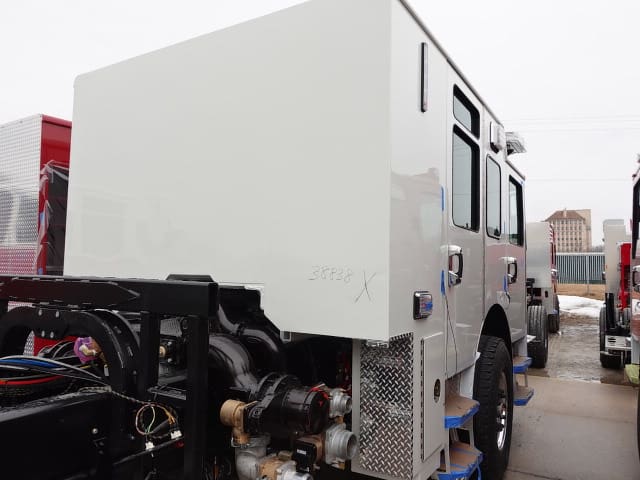

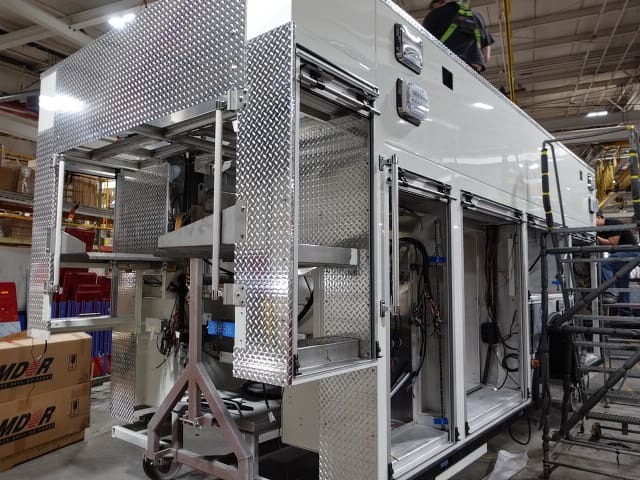

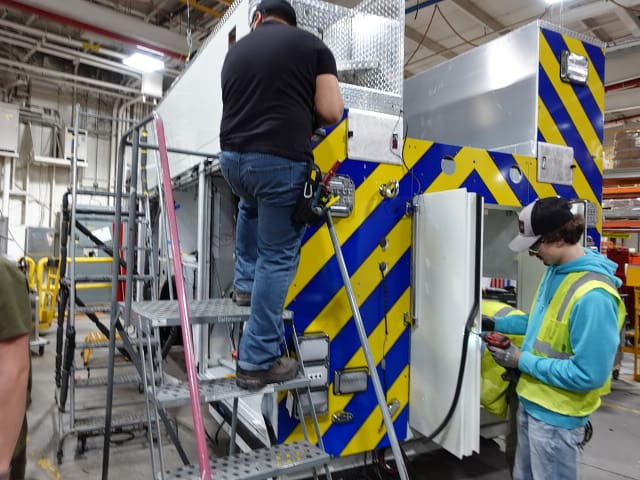

In this report, the body completed initial assembly and was merged with the chassis followed by the start of final assembly.
03-07-25

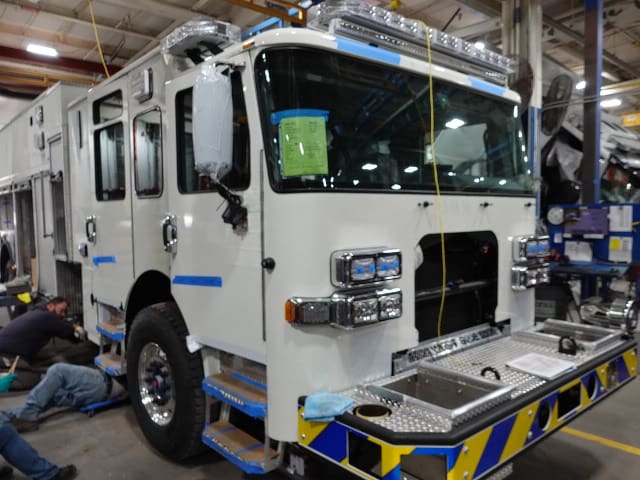

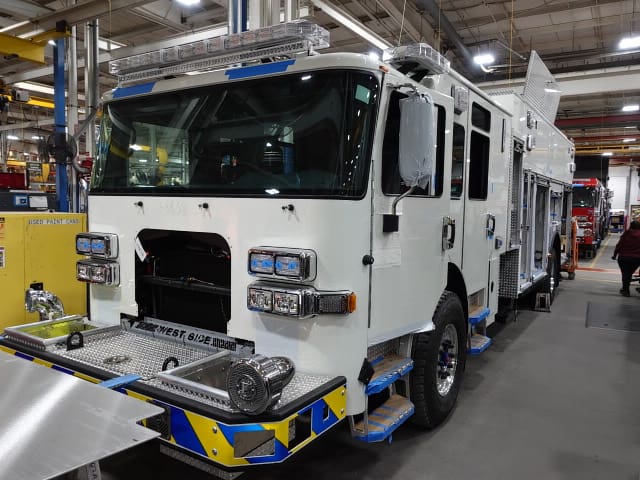

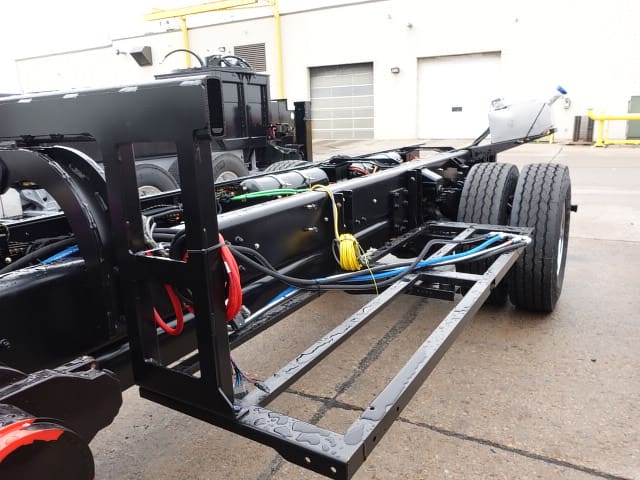

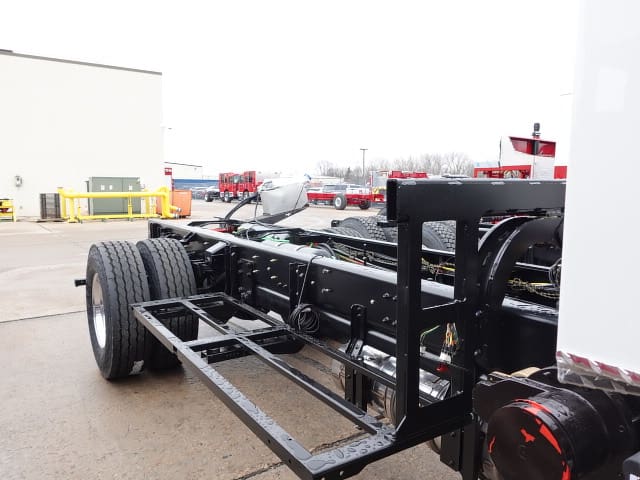

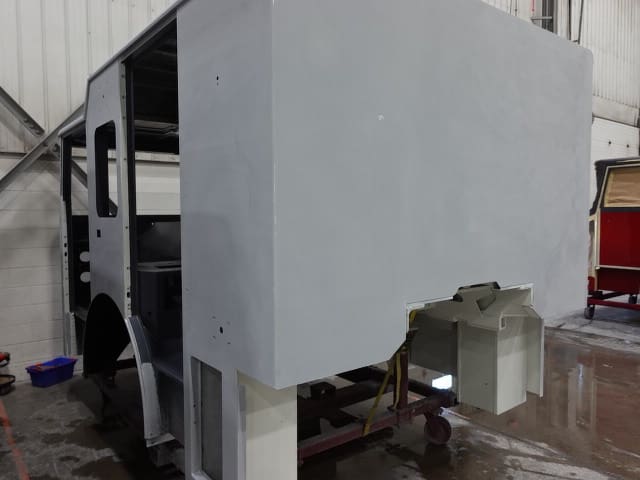

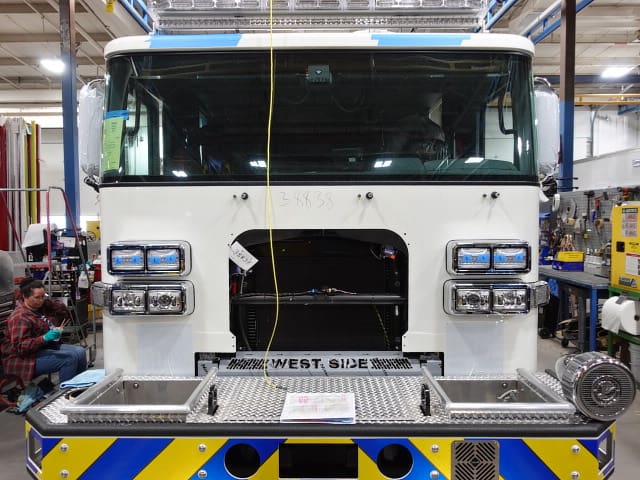

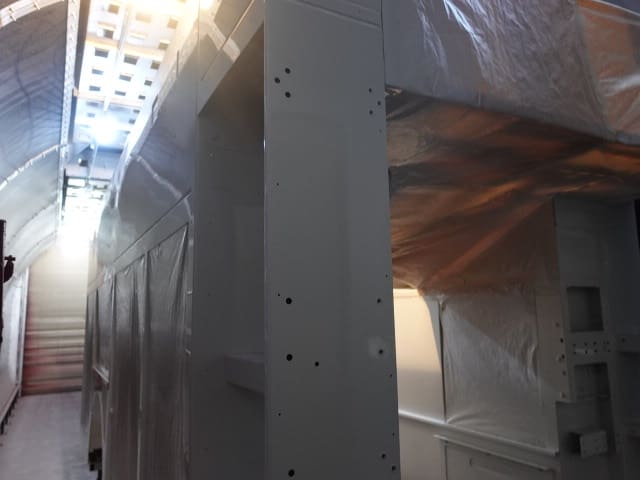

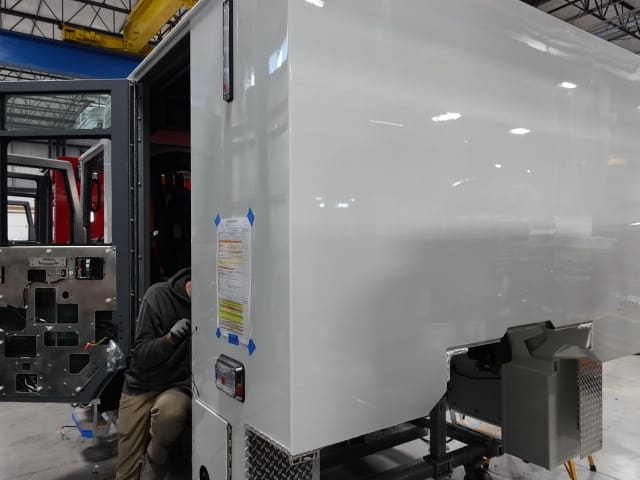

In this report, the cab completed initial assembly and was installed on the frame while the body completed paint and began initial assembly.
02-28-25

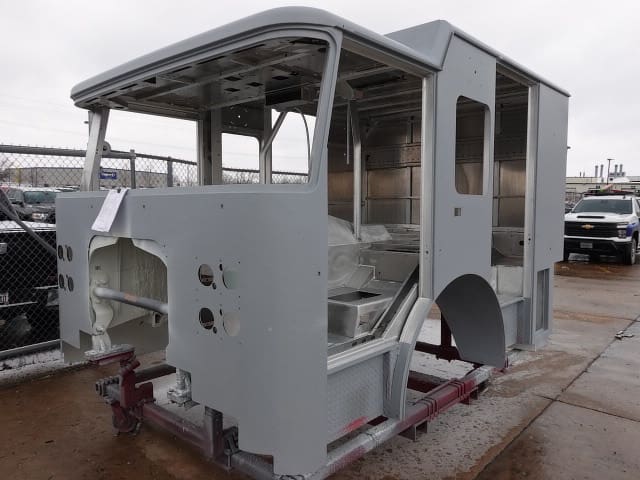

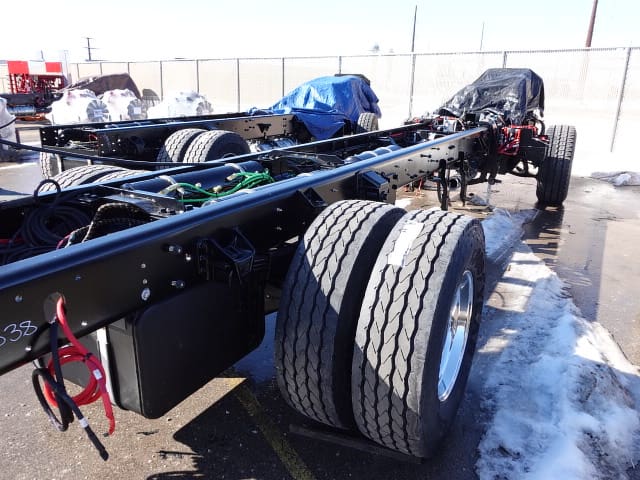

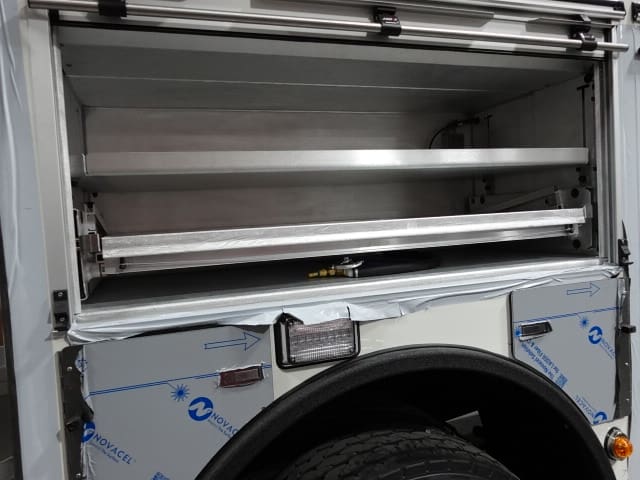

In this report, the cab continued initial assembly, the frame build continued, and the body began the paint process.

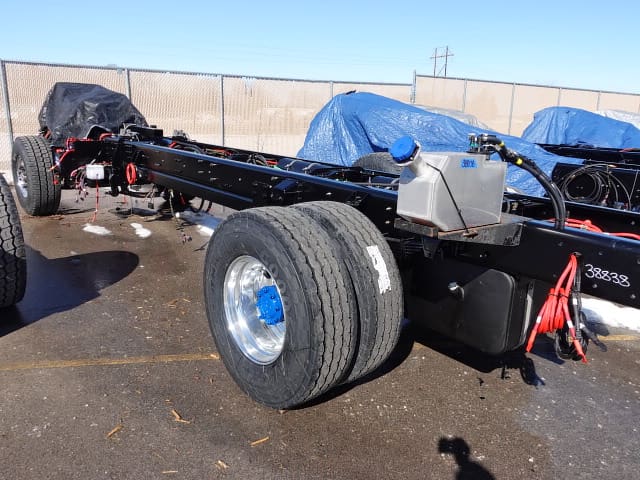

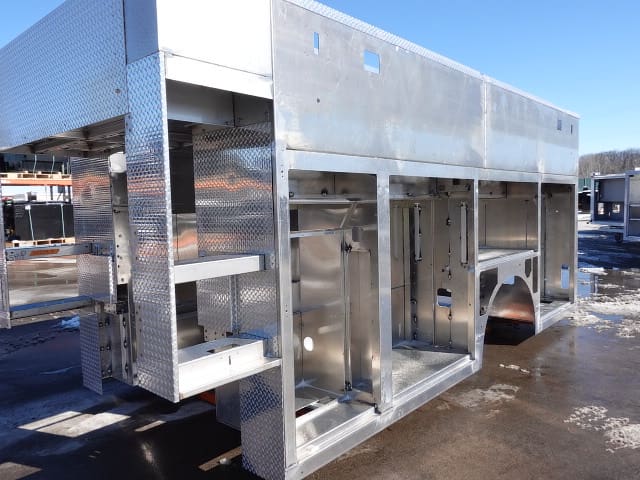

02-21-25

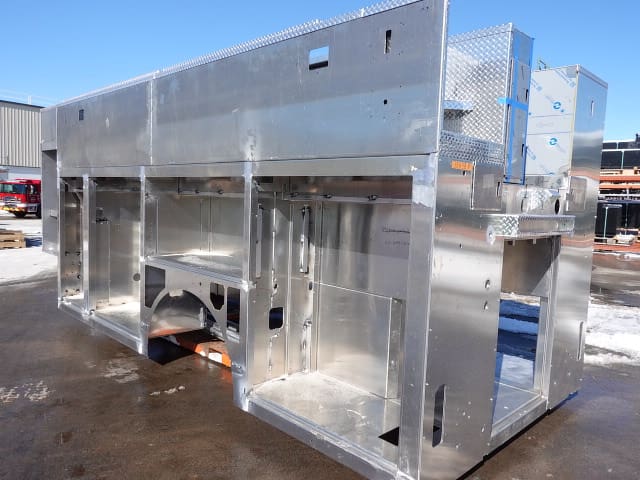

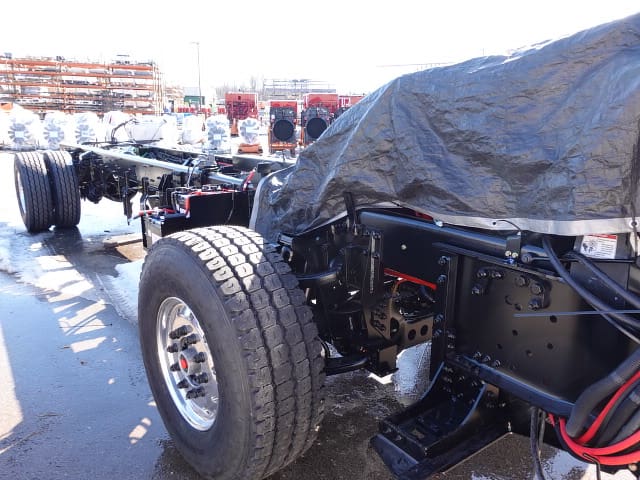

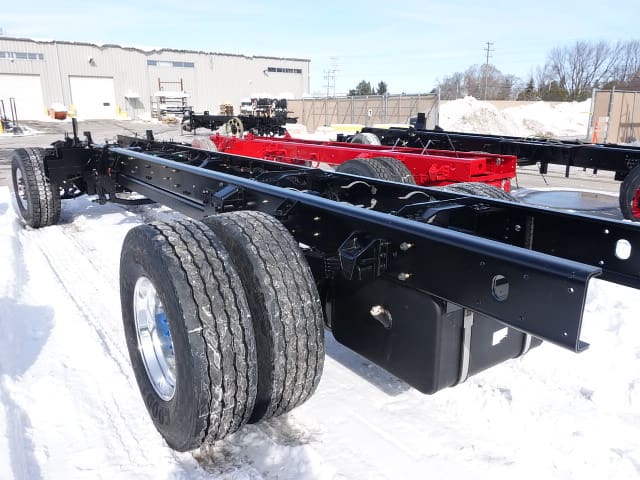

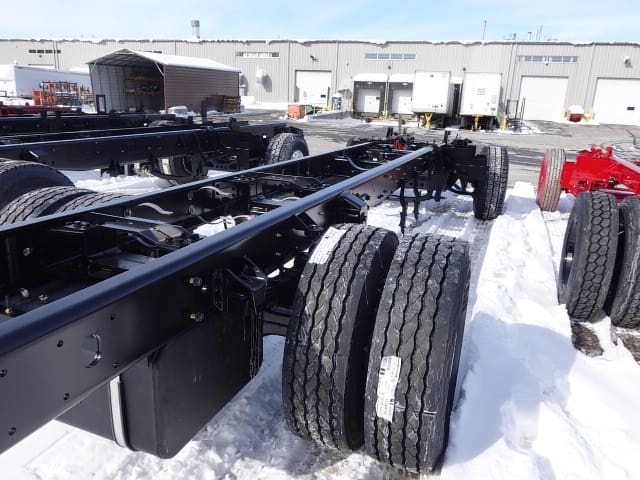

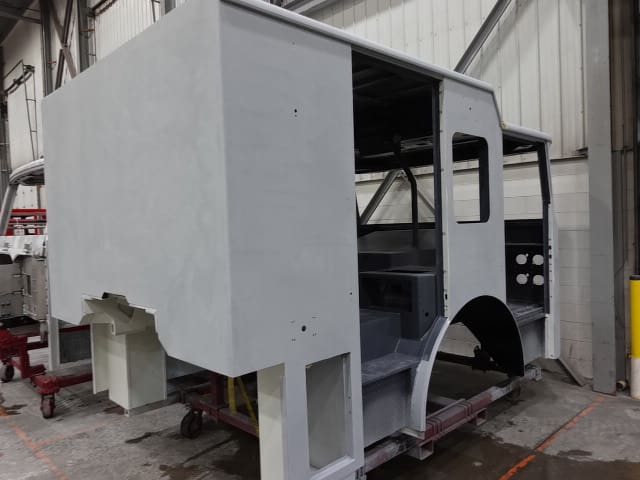

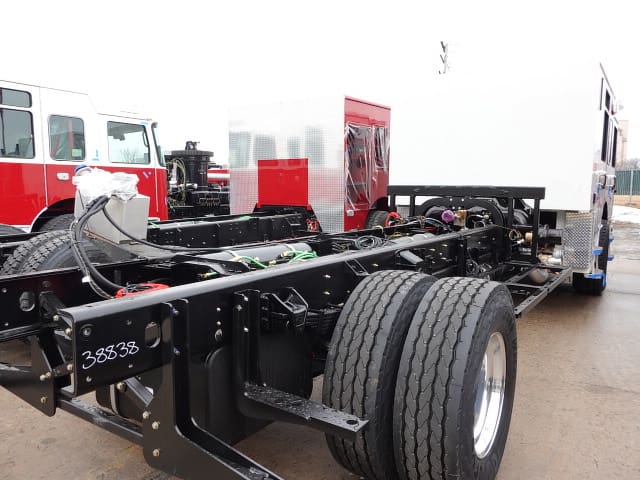

In this report, the cab completed paint and began initial assembly, the frame build began, and the body was fabricated and staged.

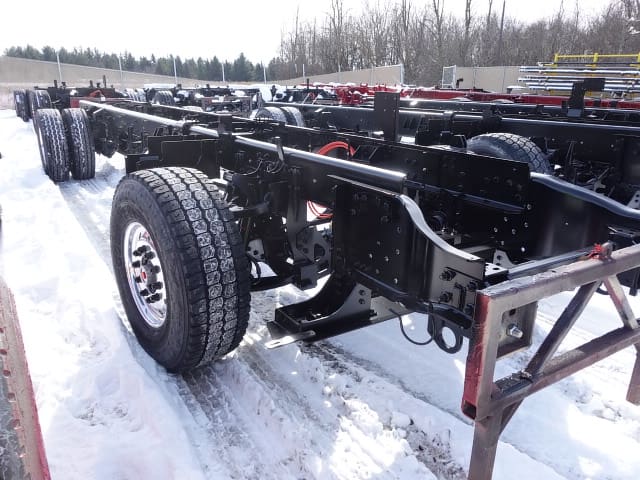

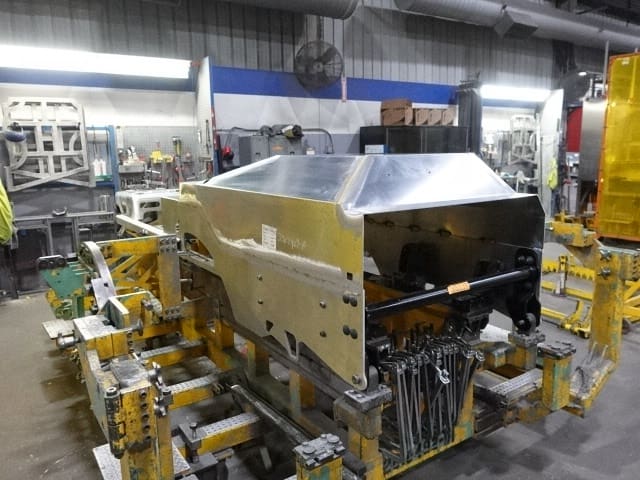

01-10-25

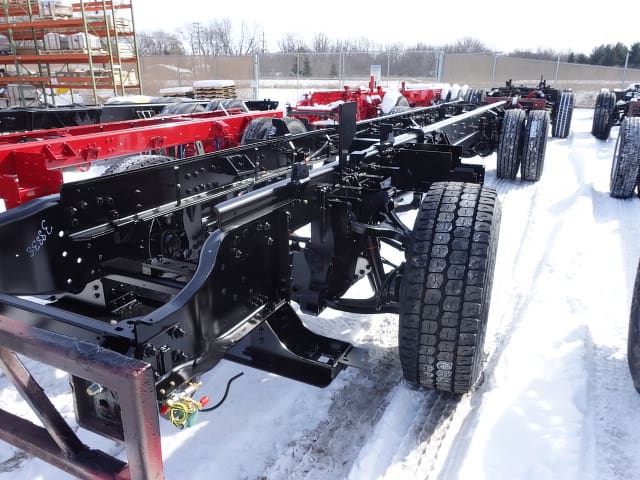

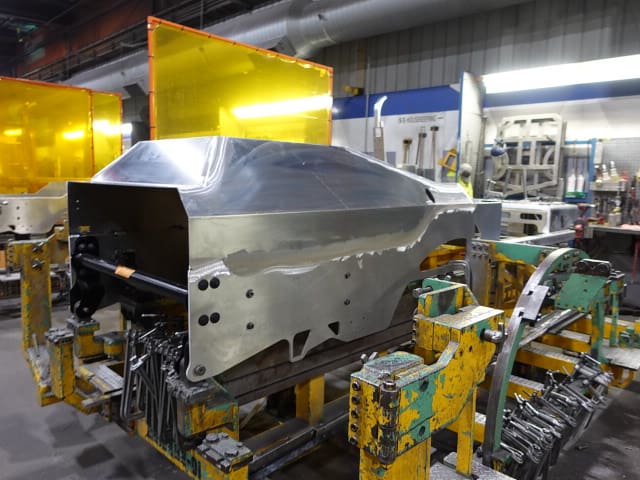

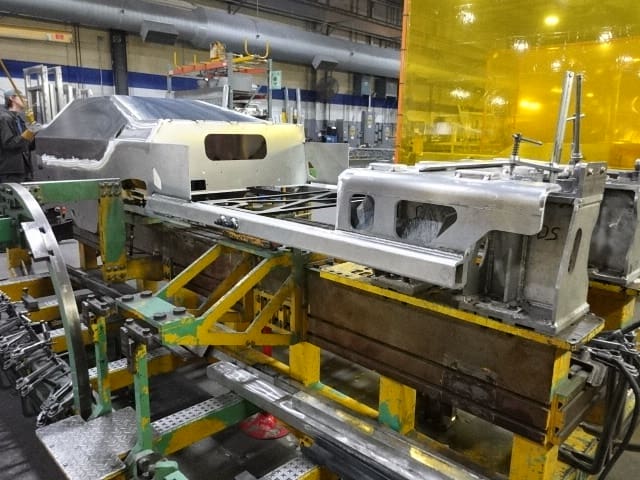

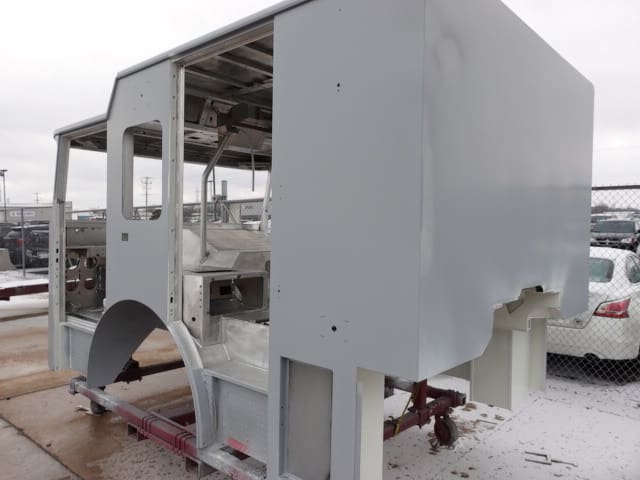

Congratulations! This new Pierce apparatus is now in production! In this report, the cab began fabrication.
