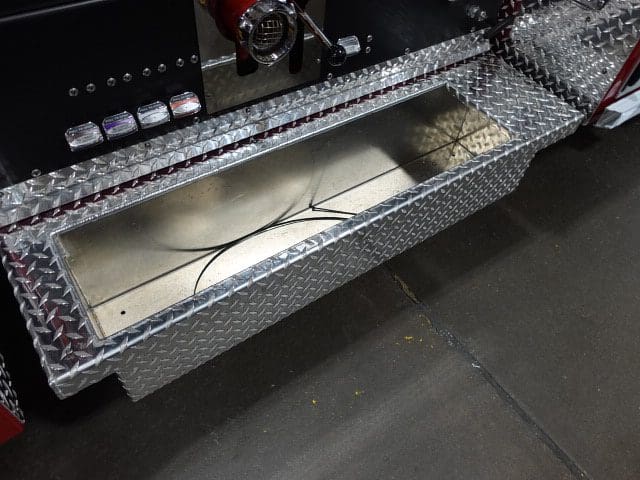

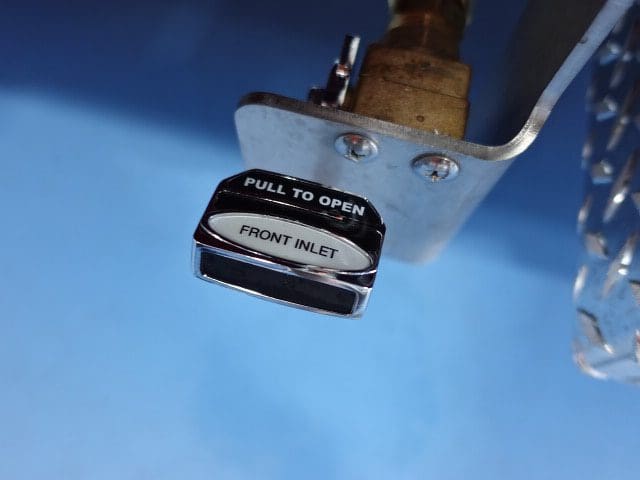

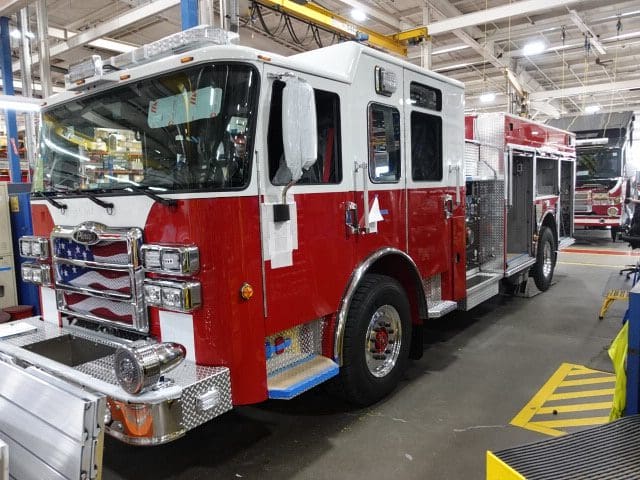

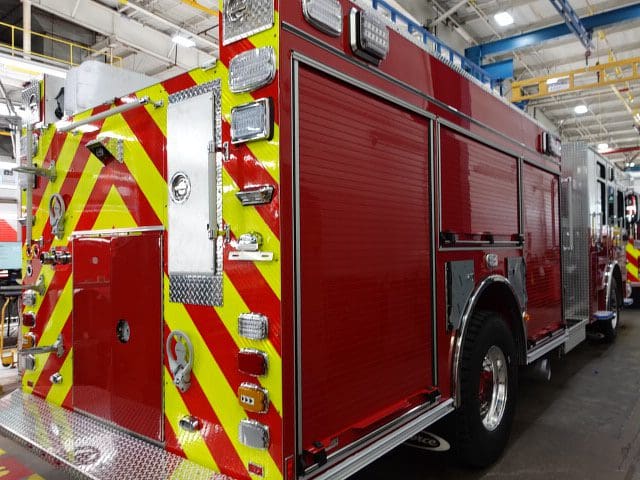

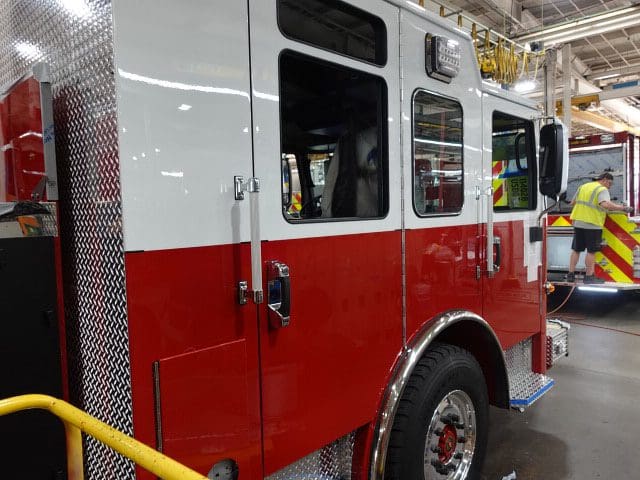

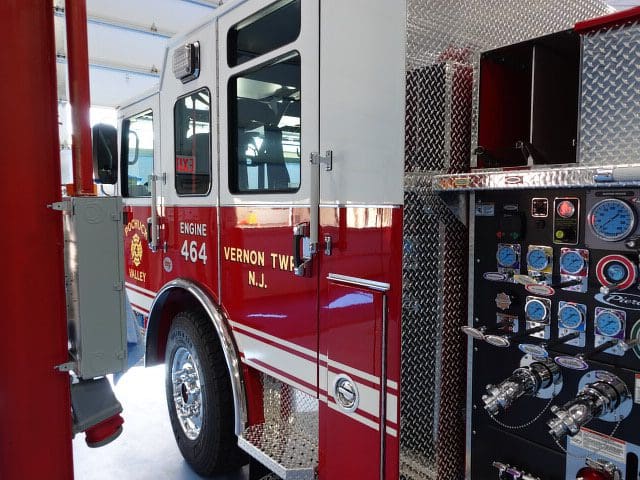

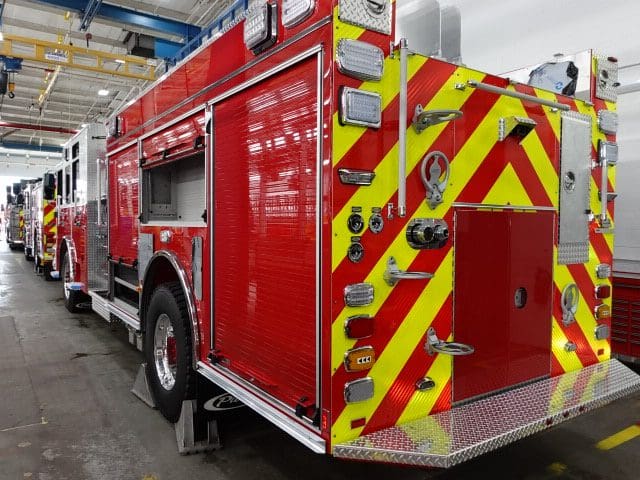

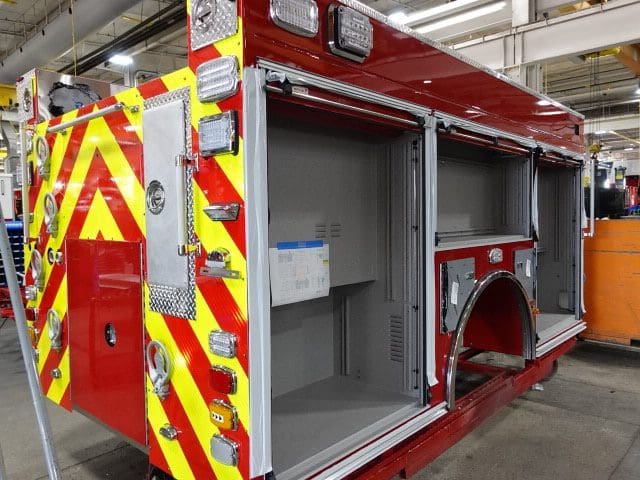

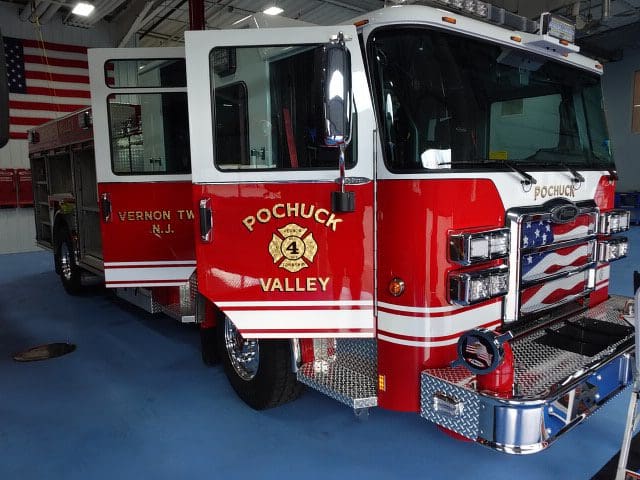

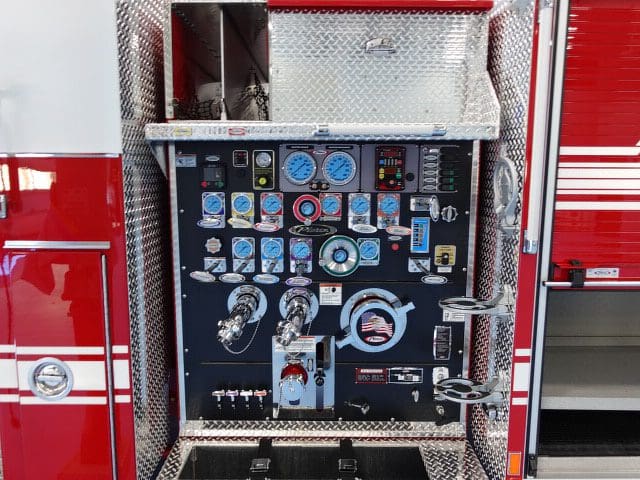

09-06-24

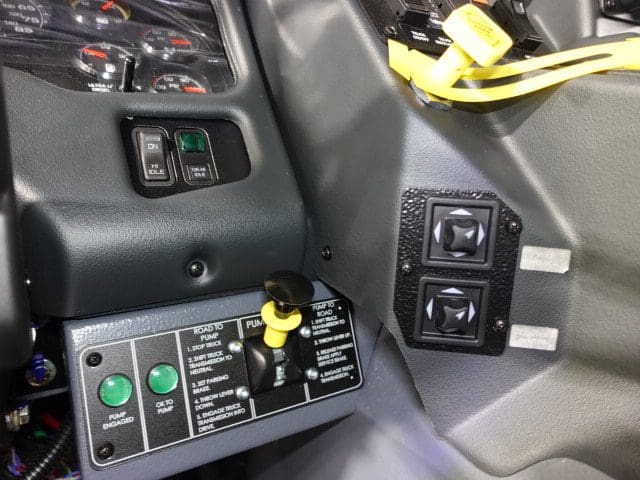

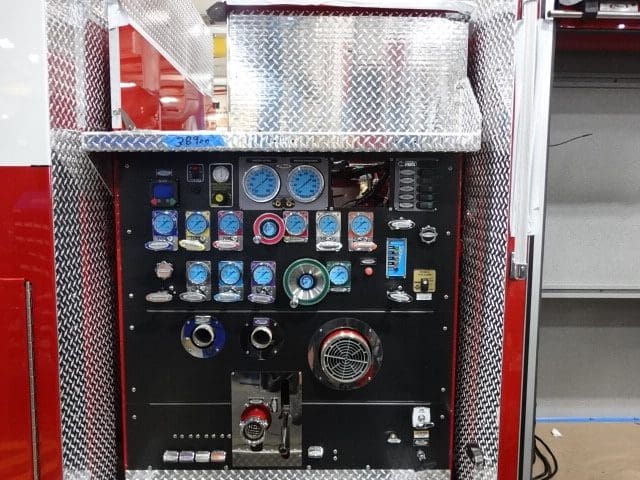

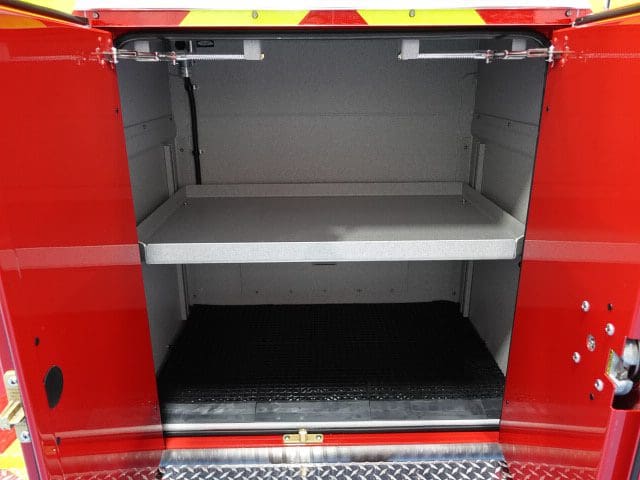

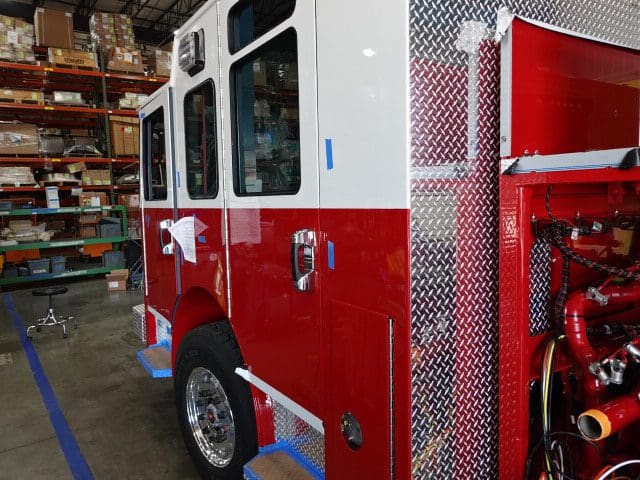

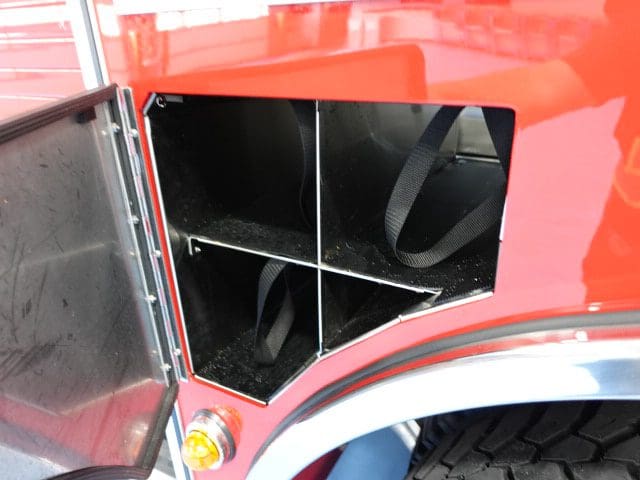

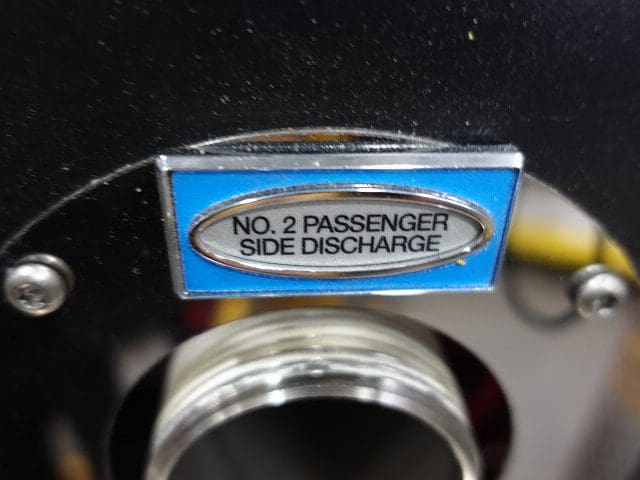

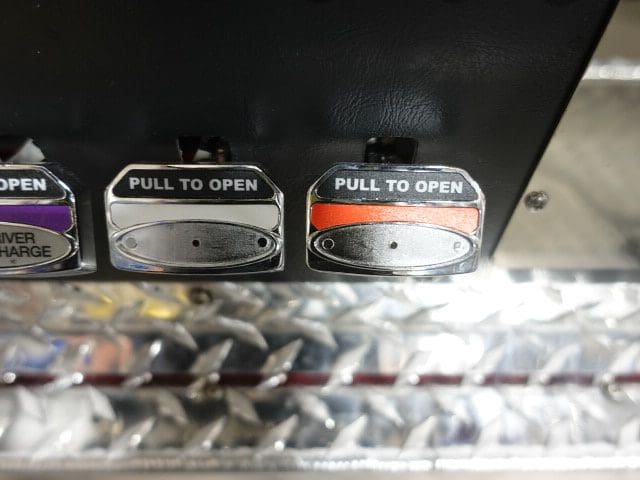

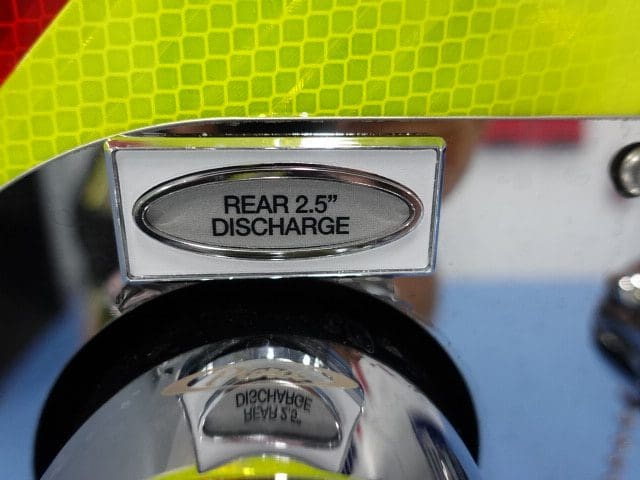

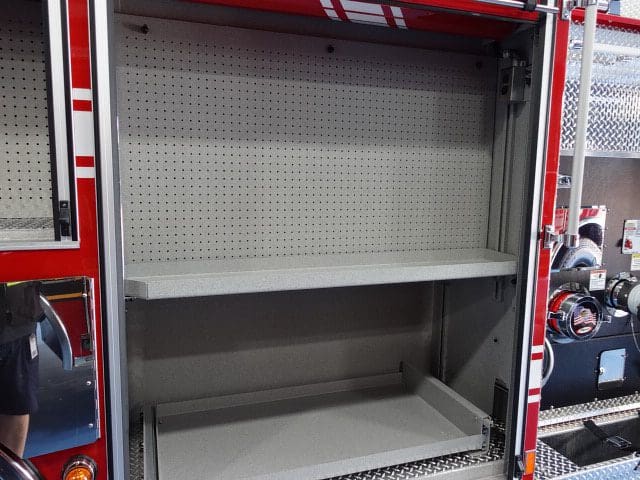

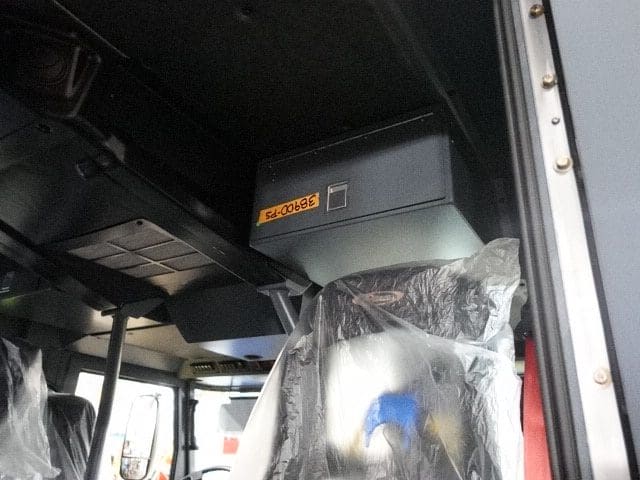

In this report, the apparatus completed quality and

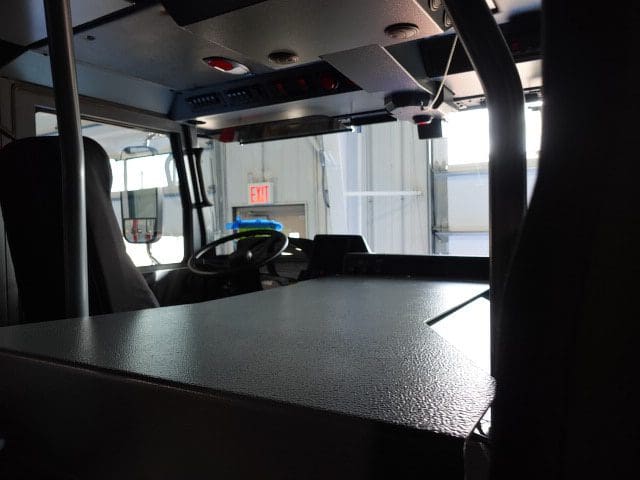

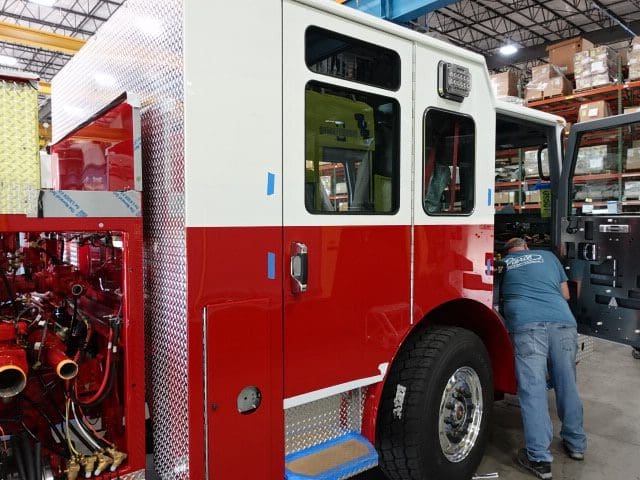

graphics where any remaining content is applied. It

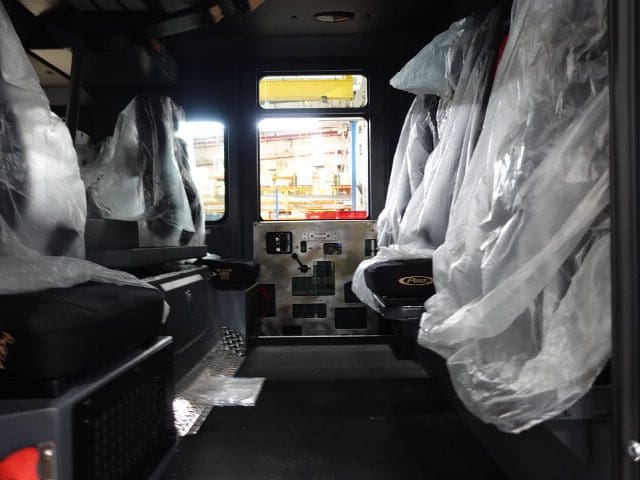

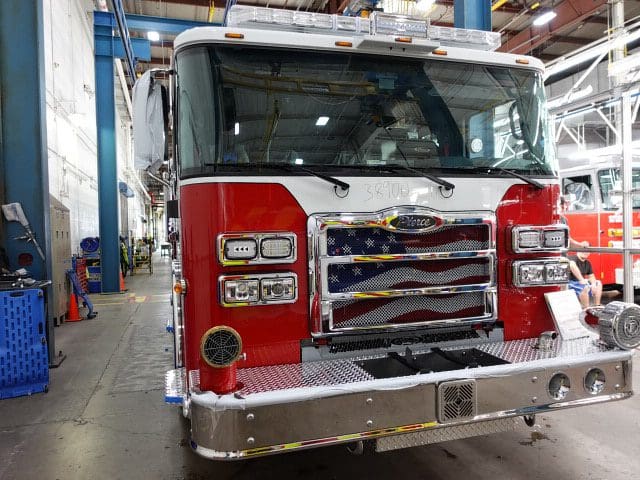

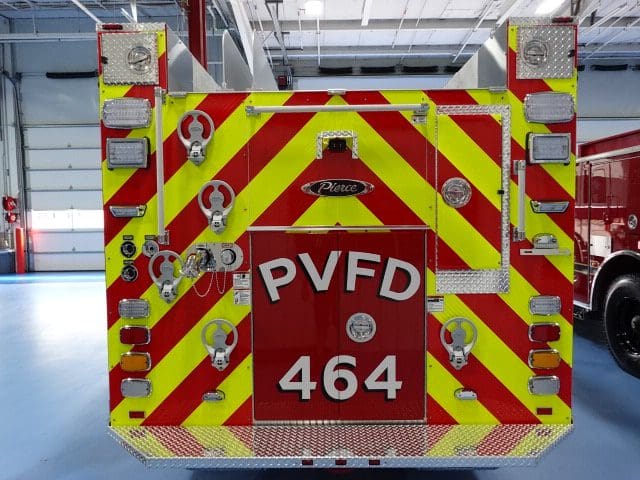

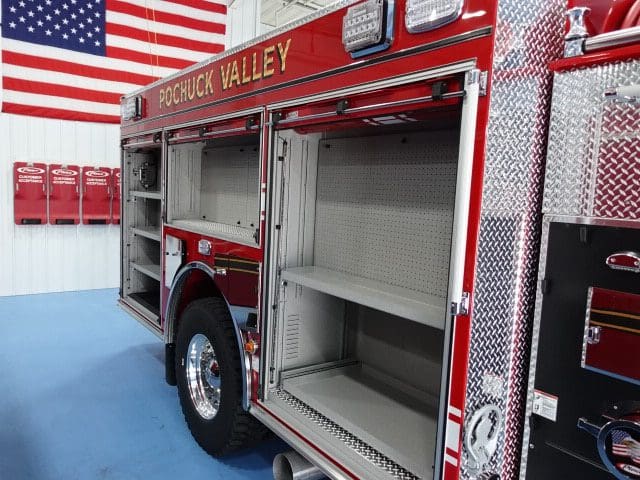

will then be made ready for the customer acceptance

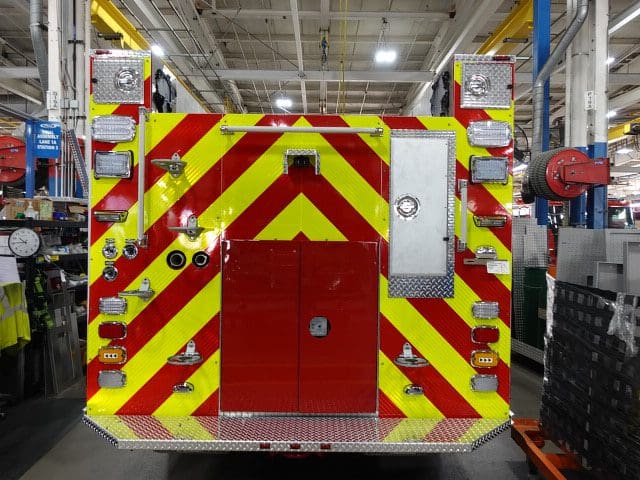

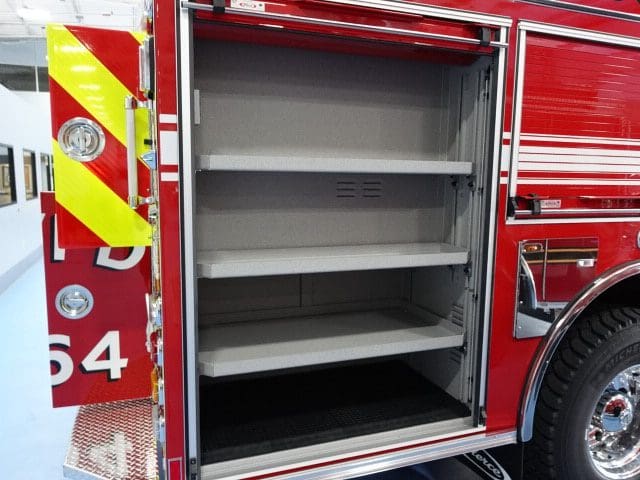

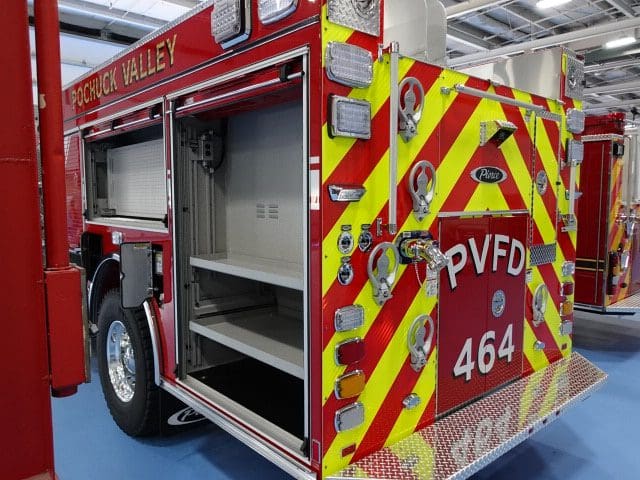

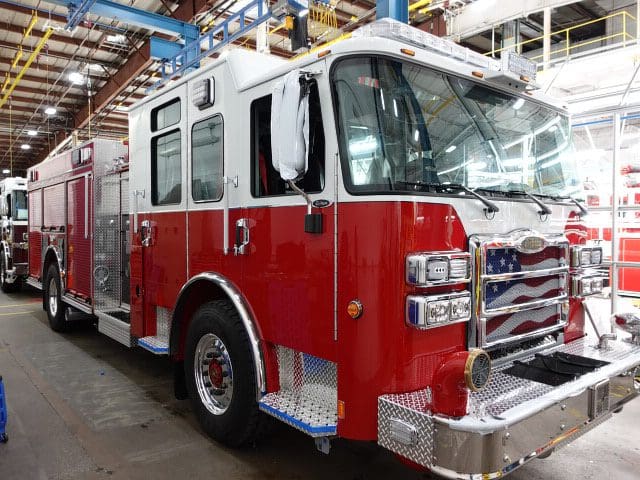

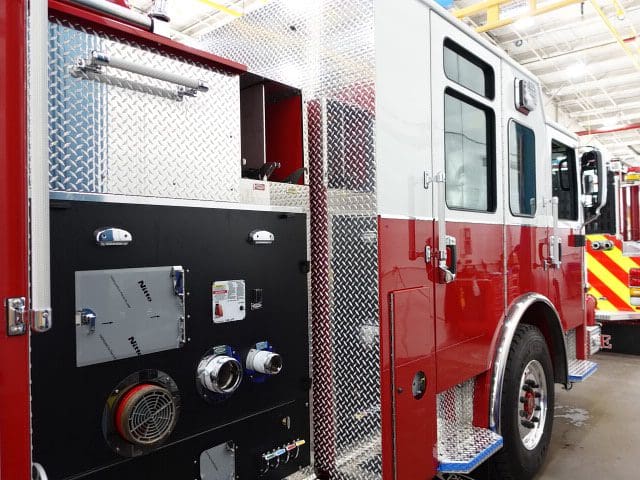

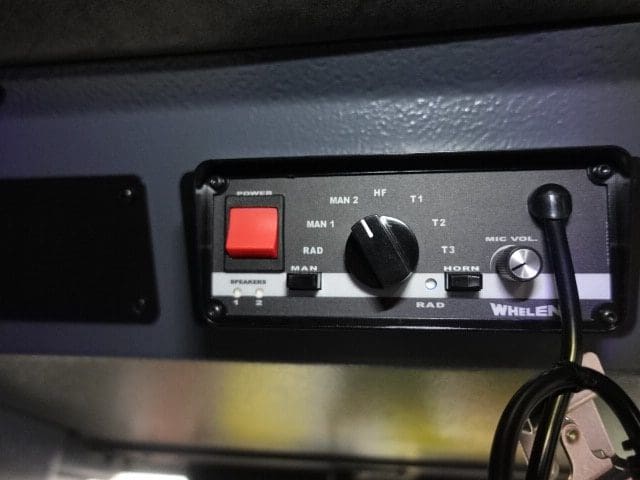

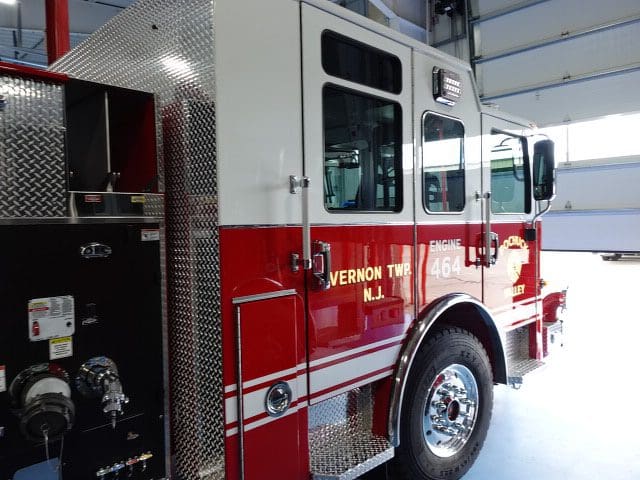

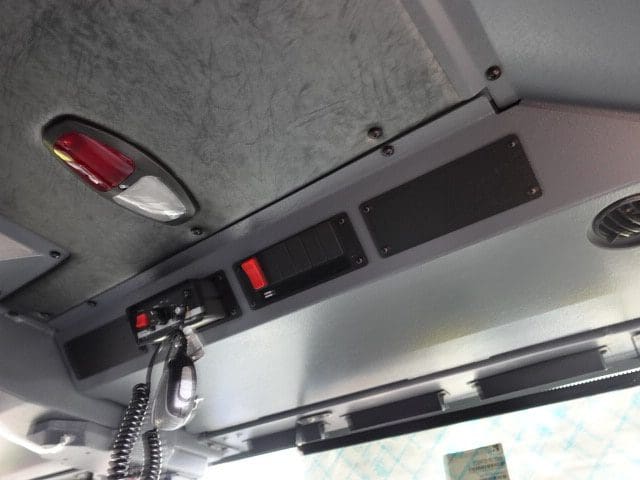

inspection. This is the last scheduled report.
08-31-24

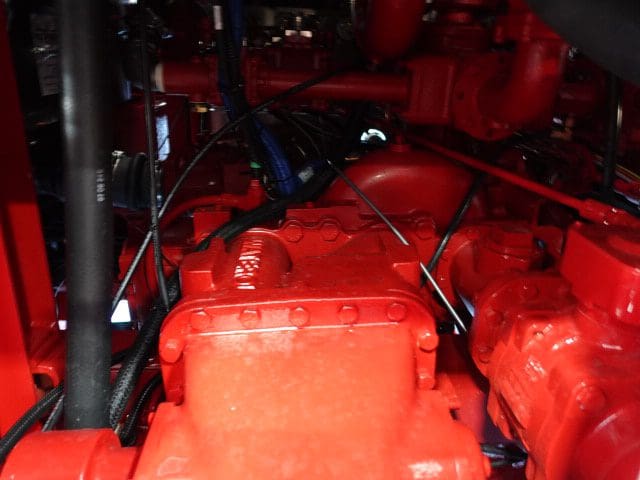

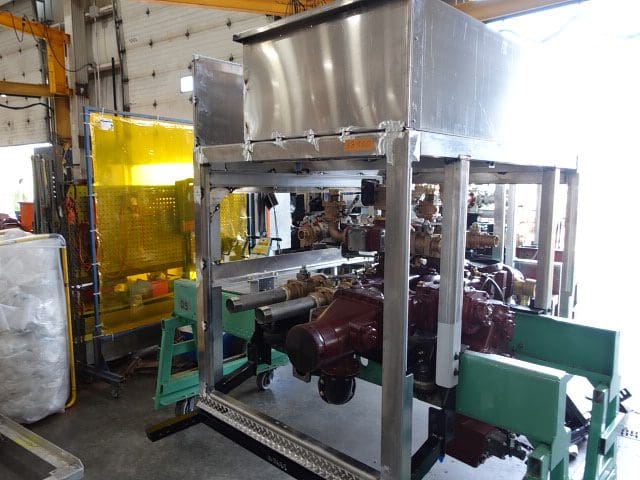

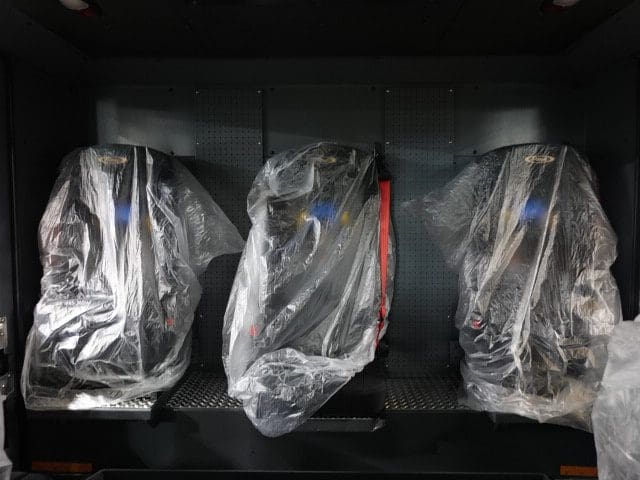

In this report, the apparatus completed final assembly and test followed by release to quality and graphics where any remaining content will be applied.
08-23-24

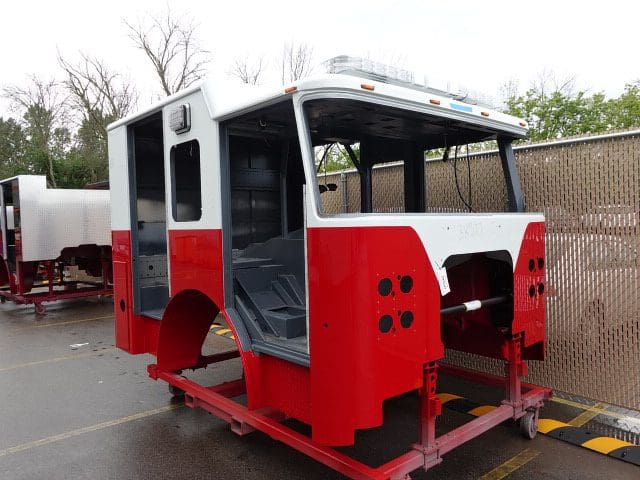

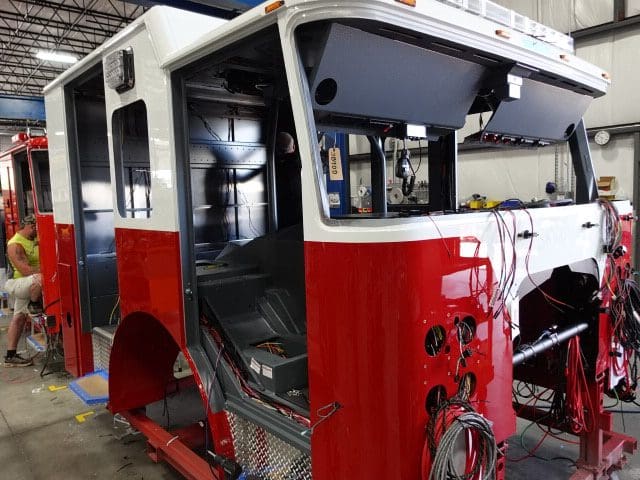

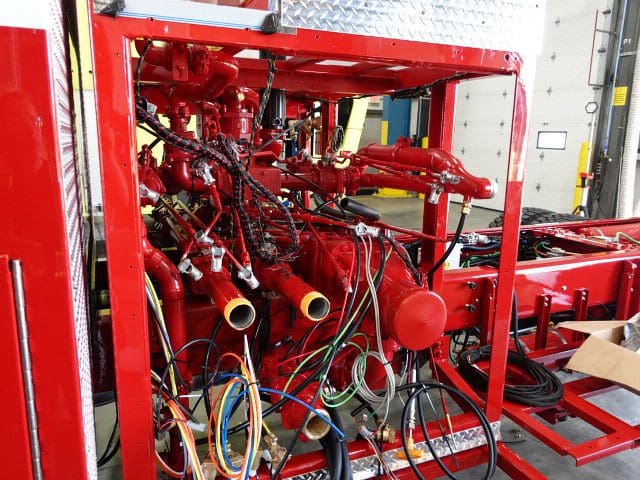

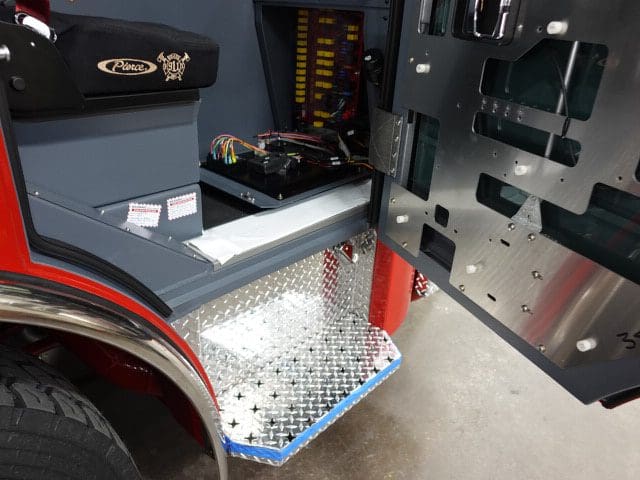

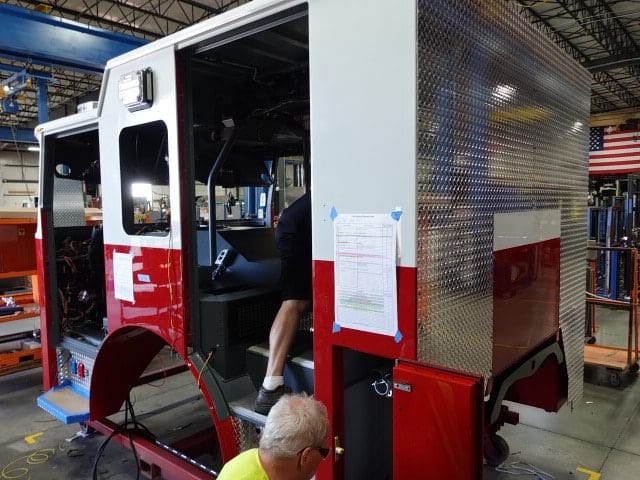

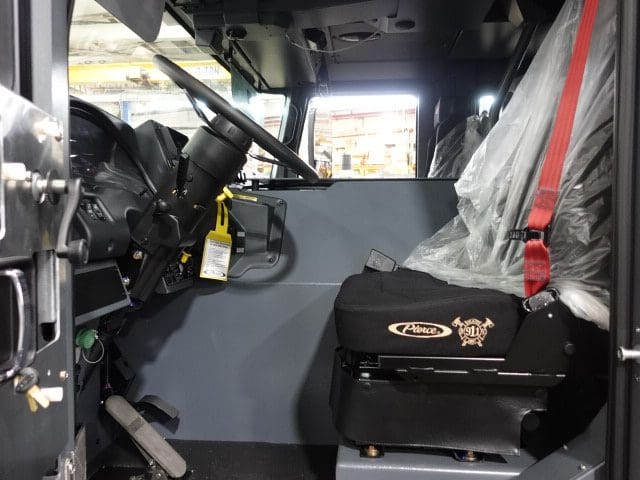

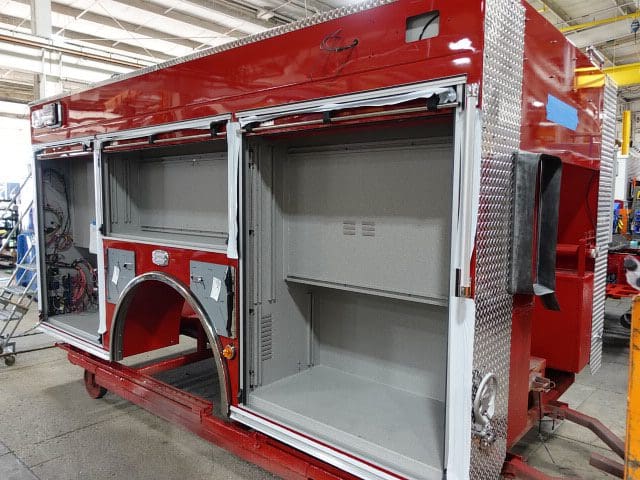

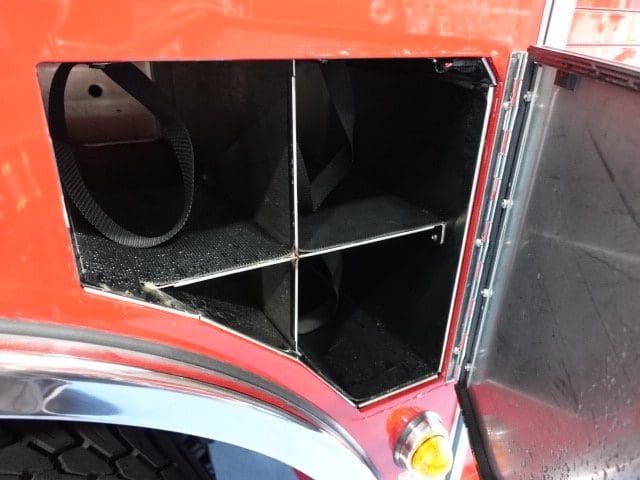

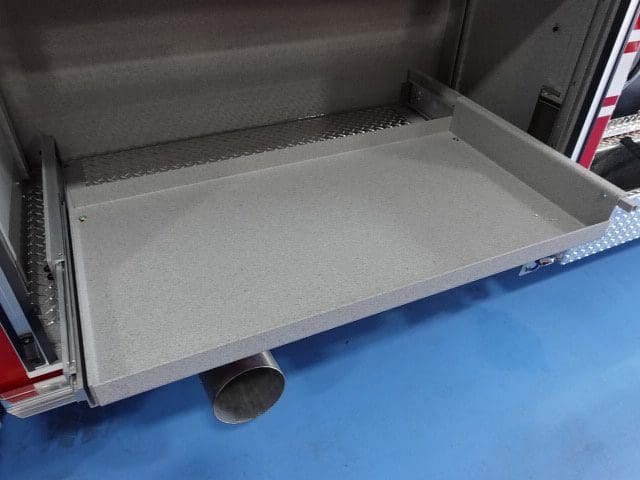

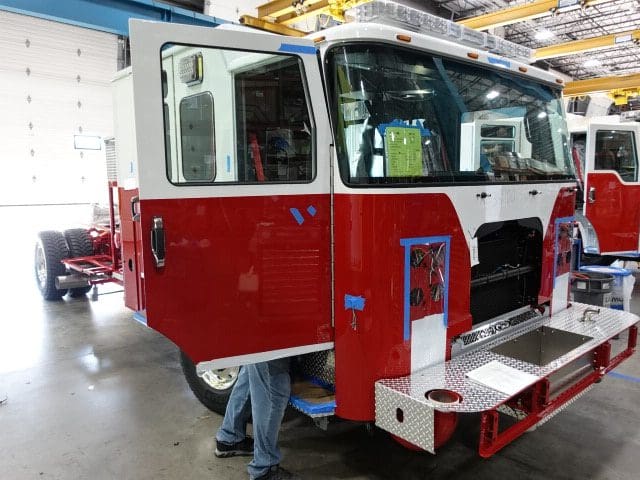

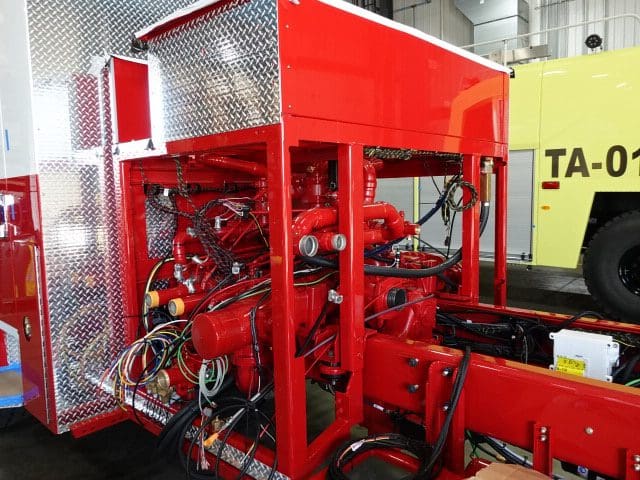

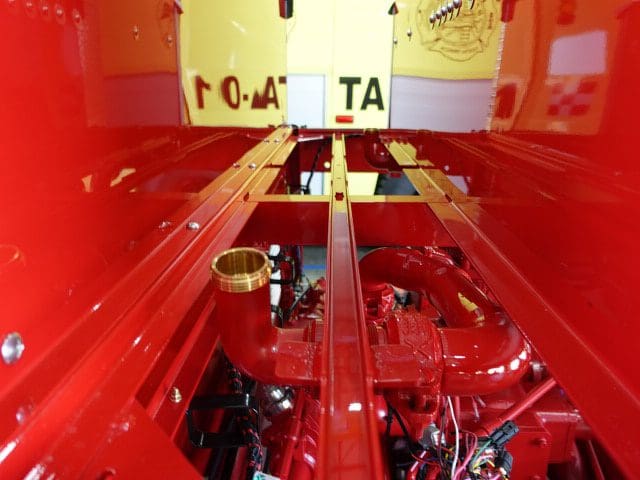

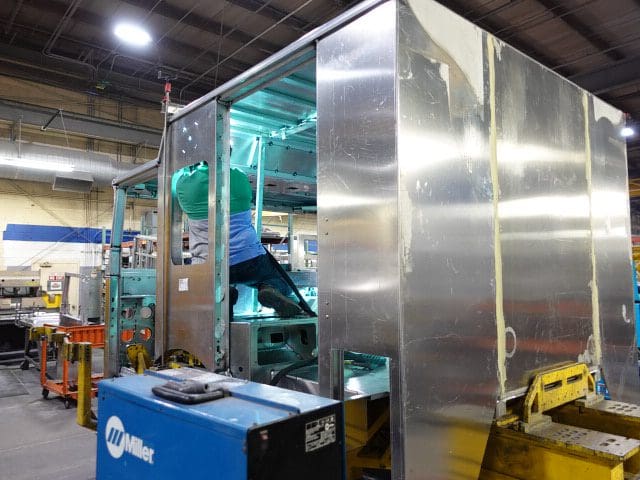

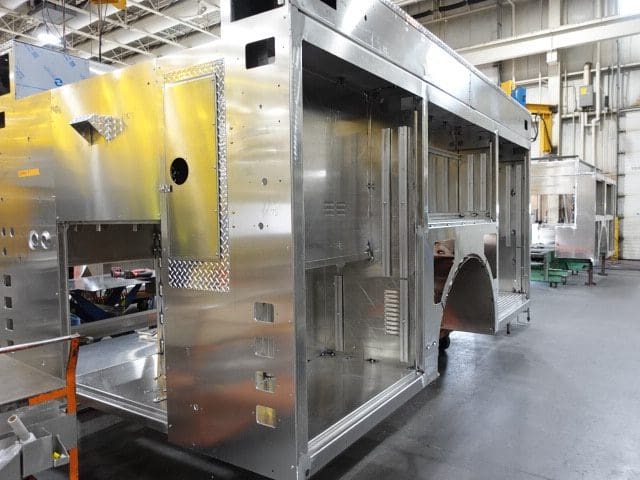

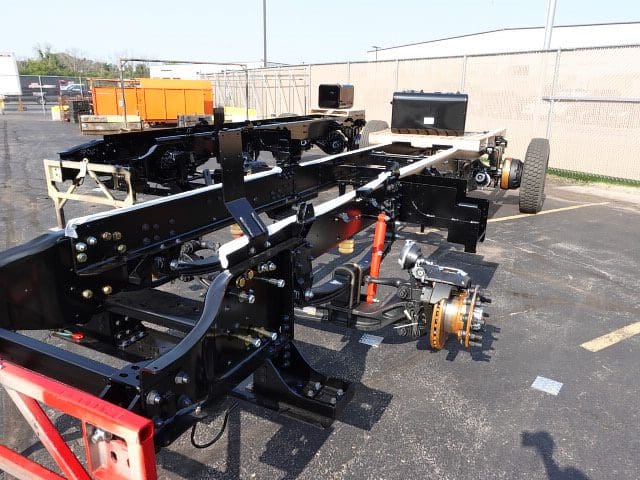

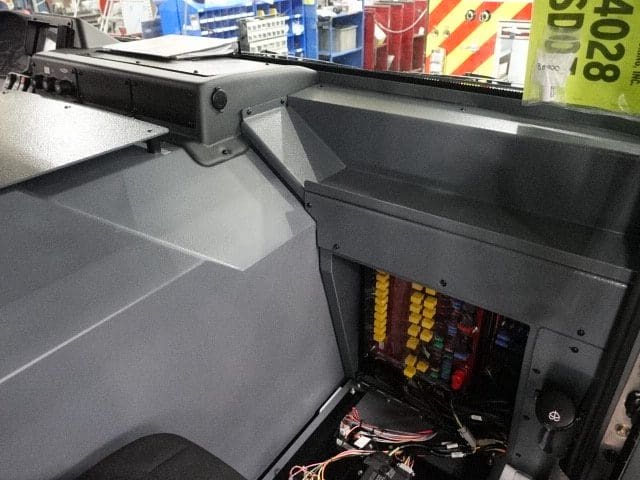

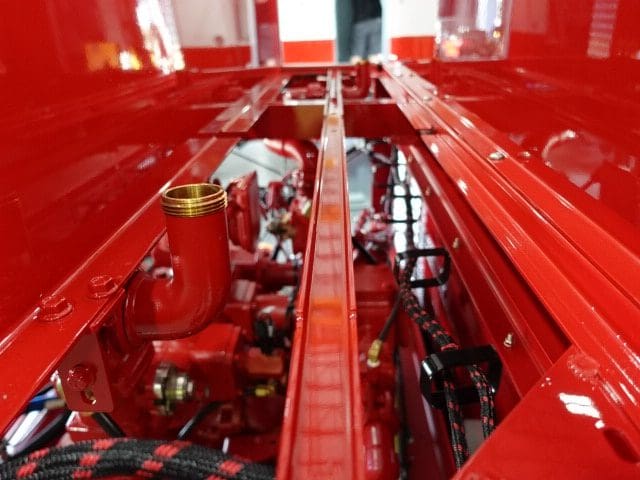

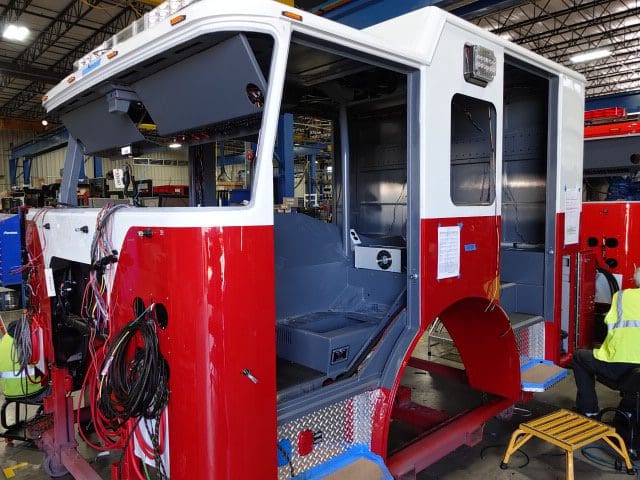

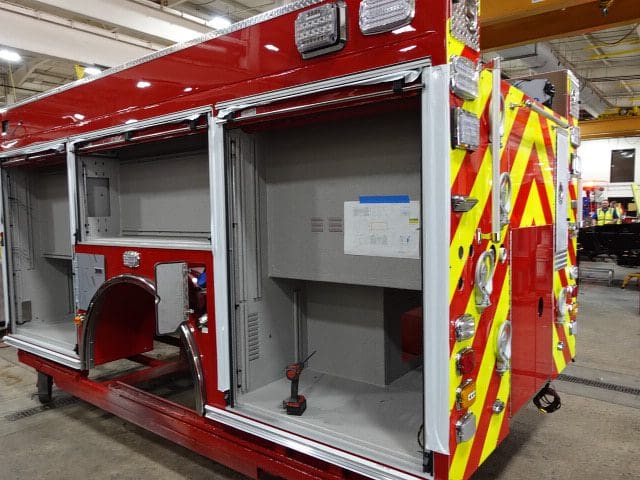

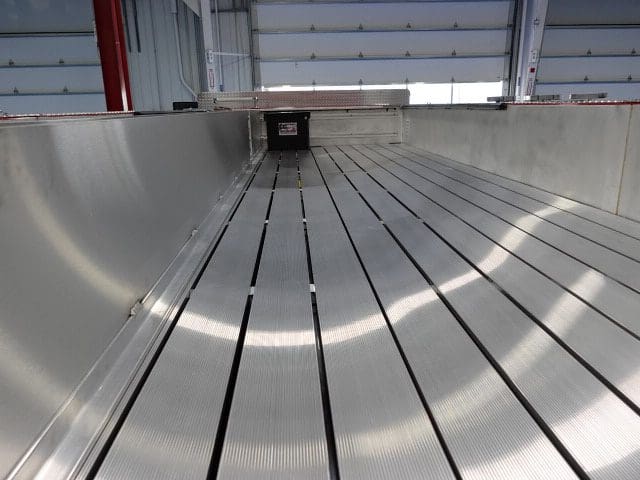

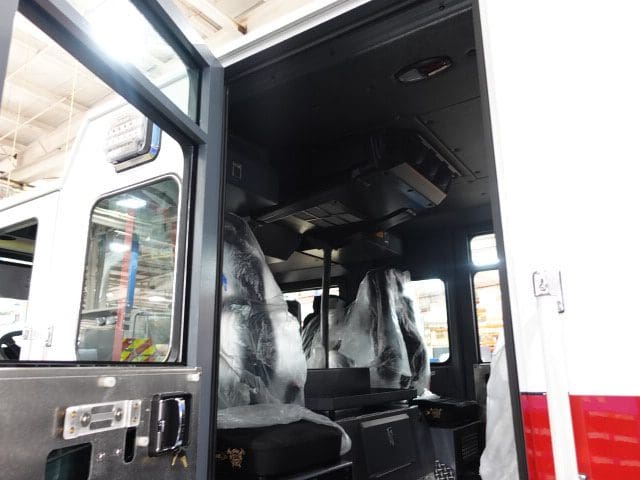

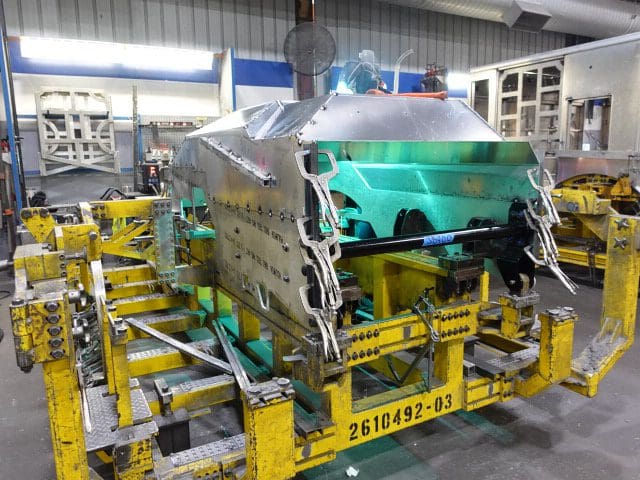

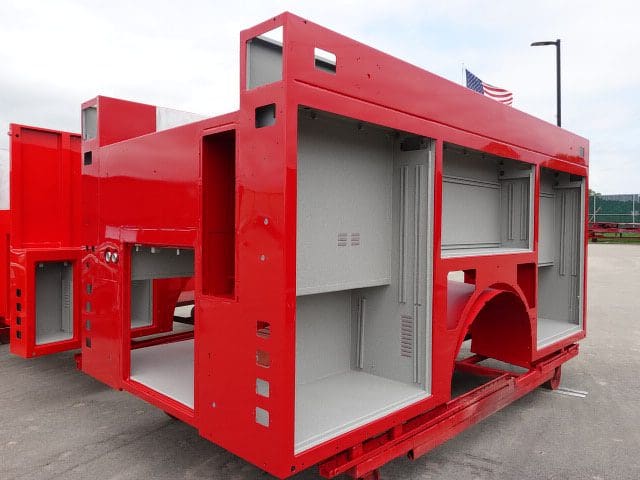

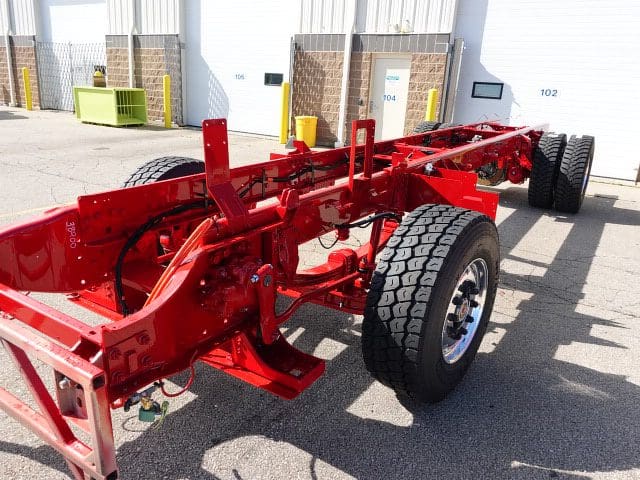

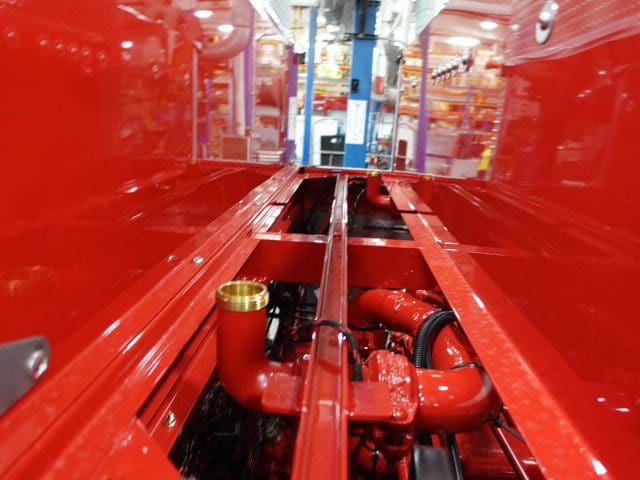

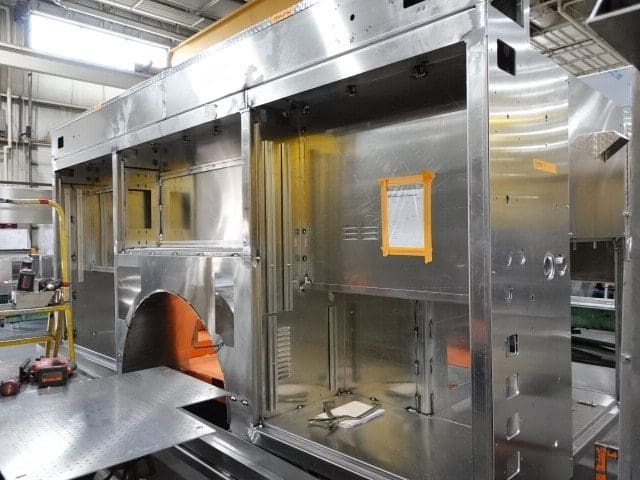

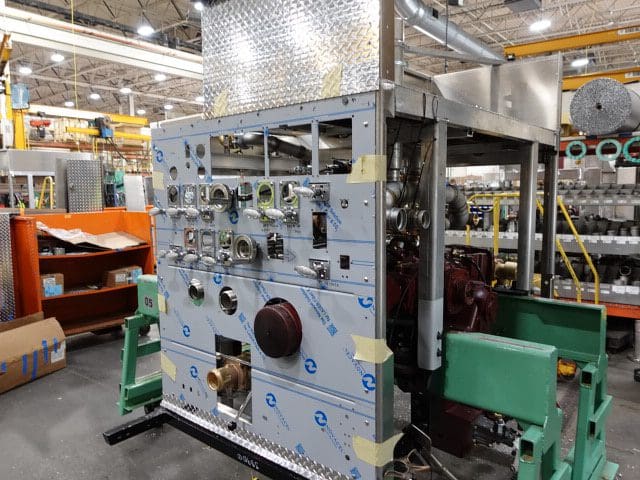

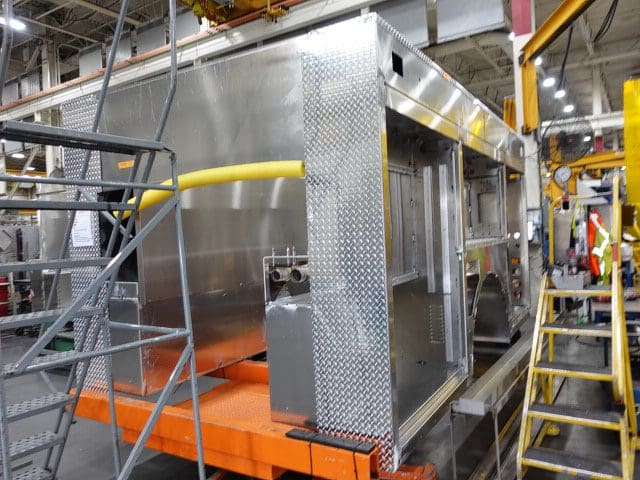

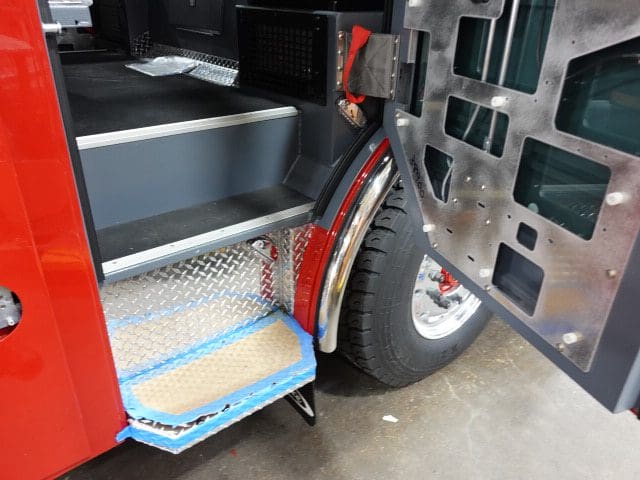

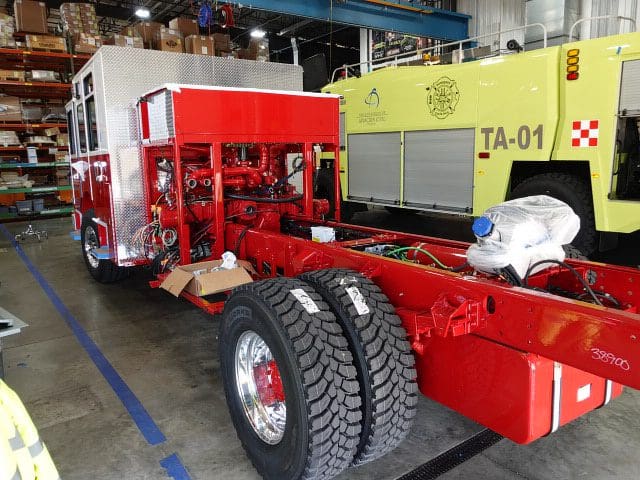

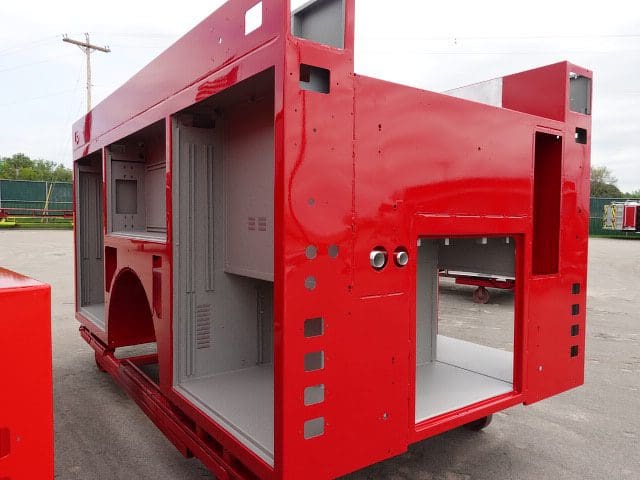

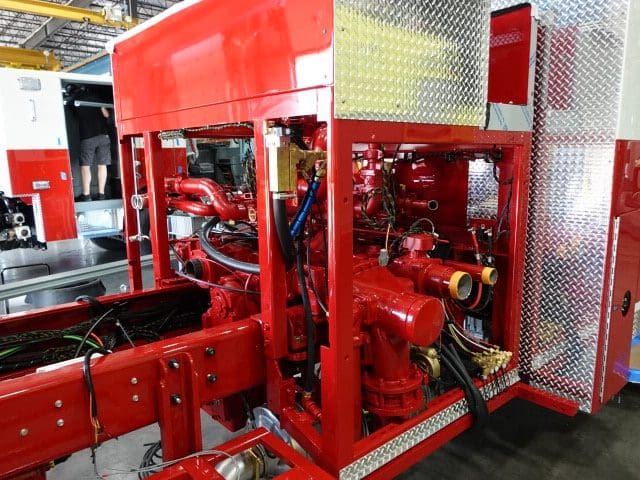

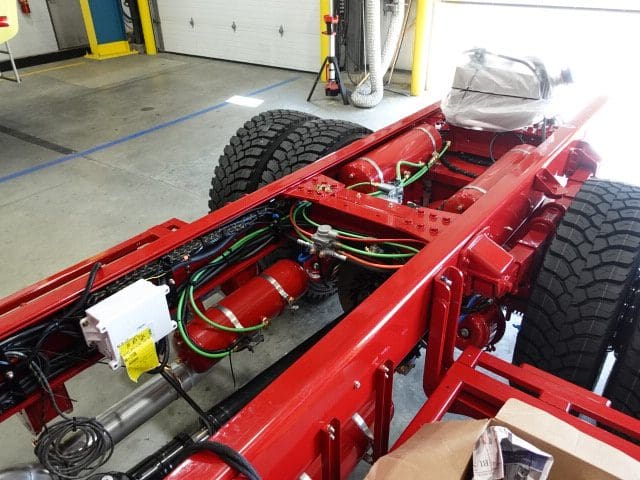

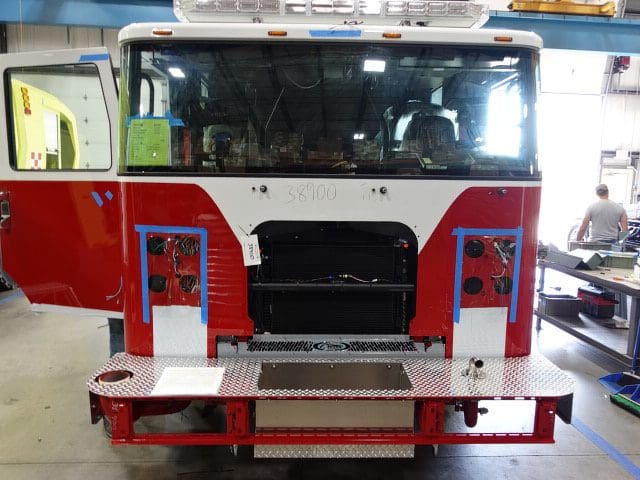

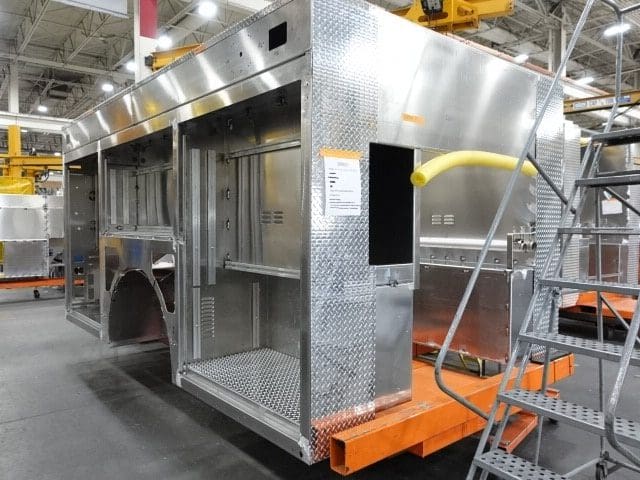

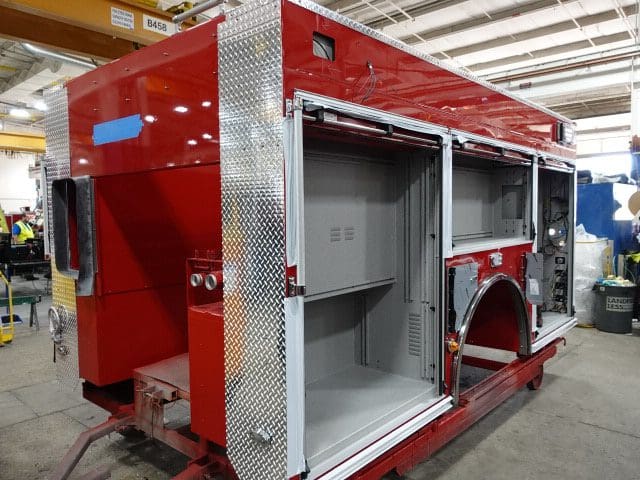

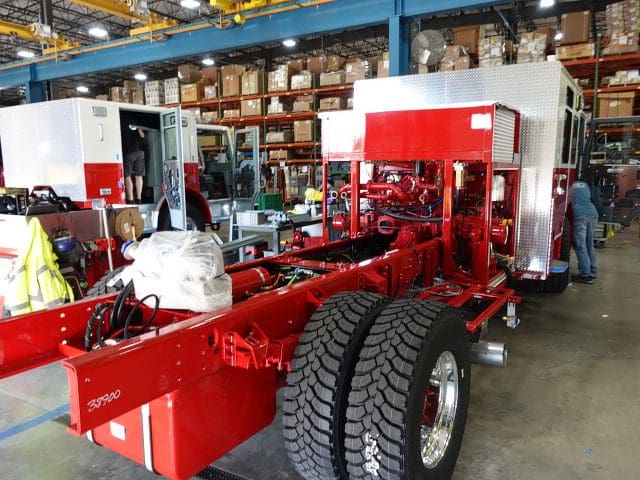

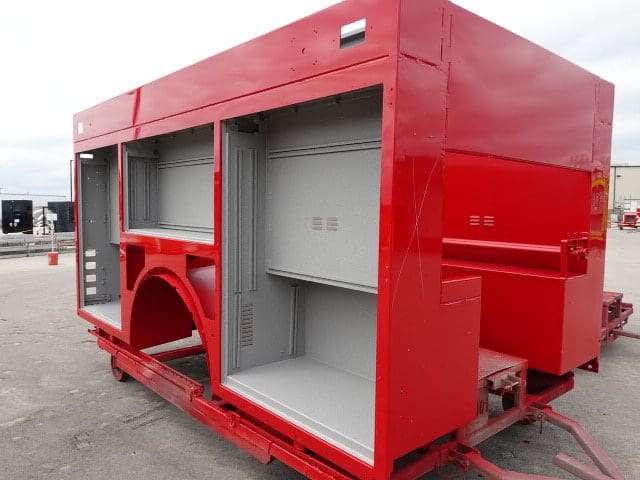

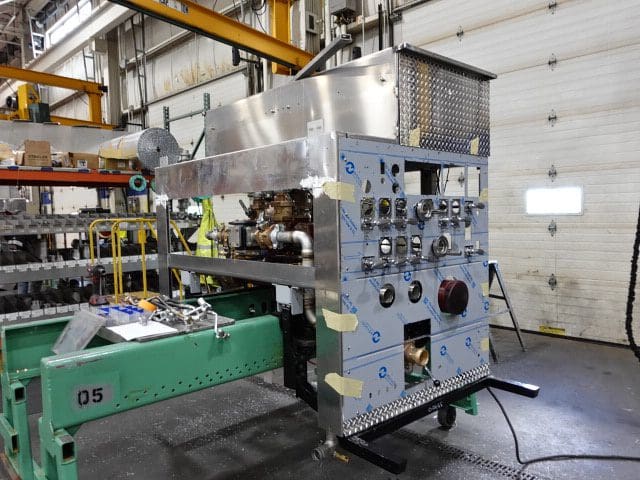

In this report, the body was merged with the chassis followed by the start of final assembly.

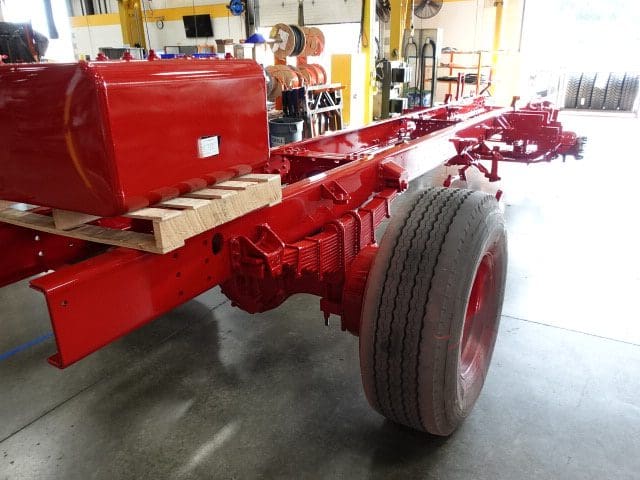

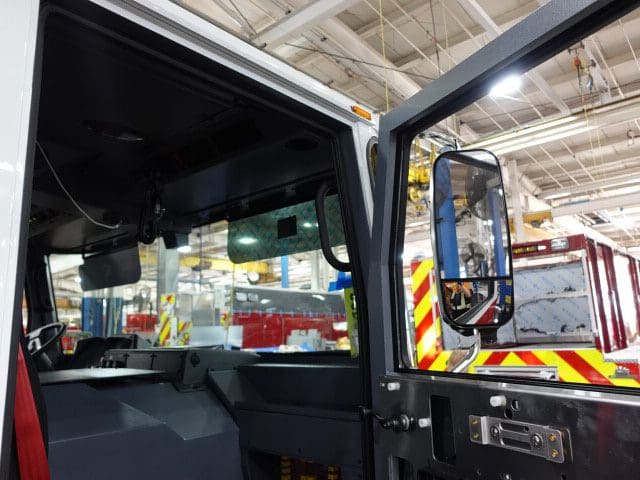

08-16-24

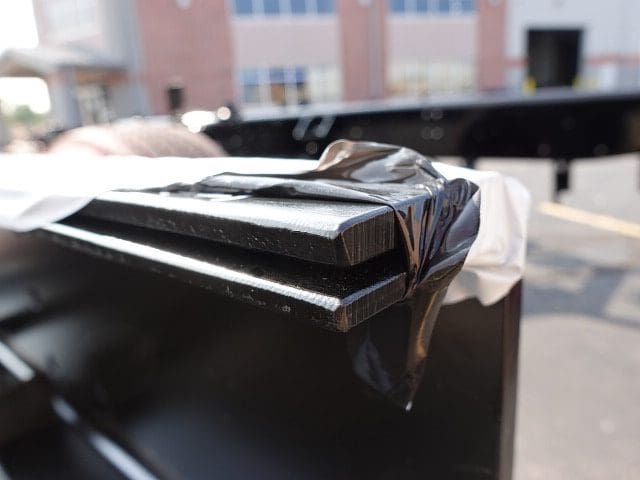

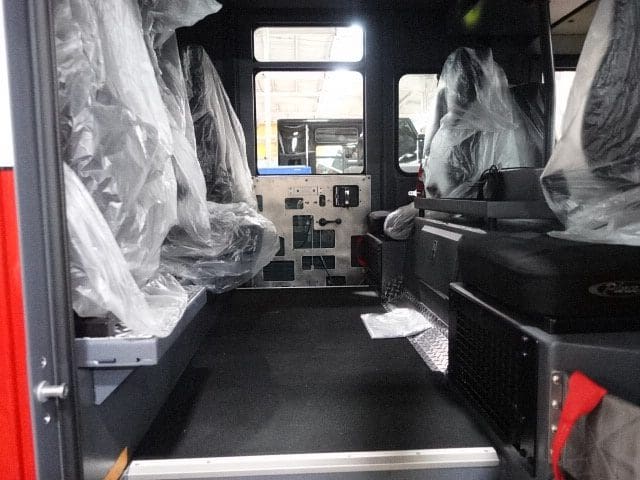

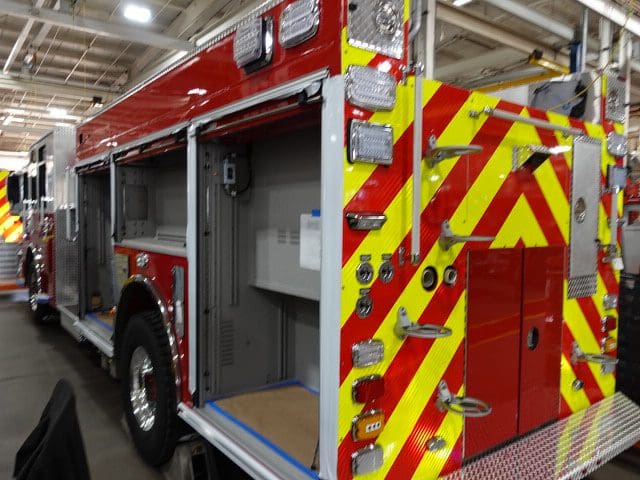

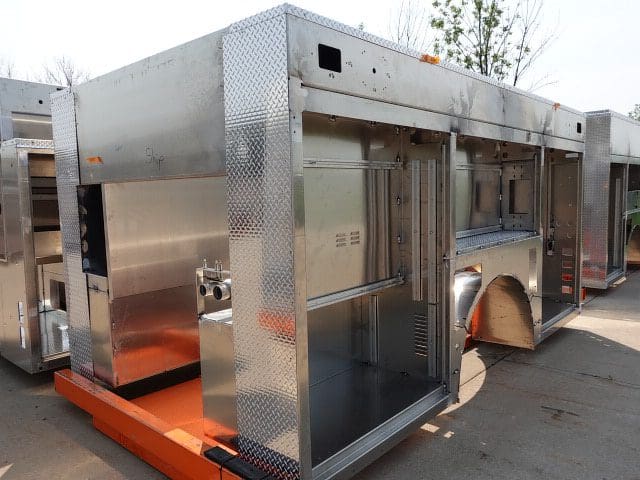

In this report, the cab and pump house completed initial assembly and were installed on the frame while the body completed initial assembly and was staged.
08-09-24

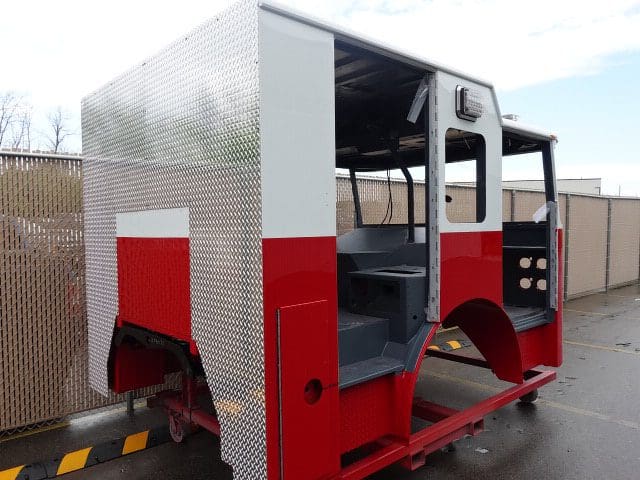

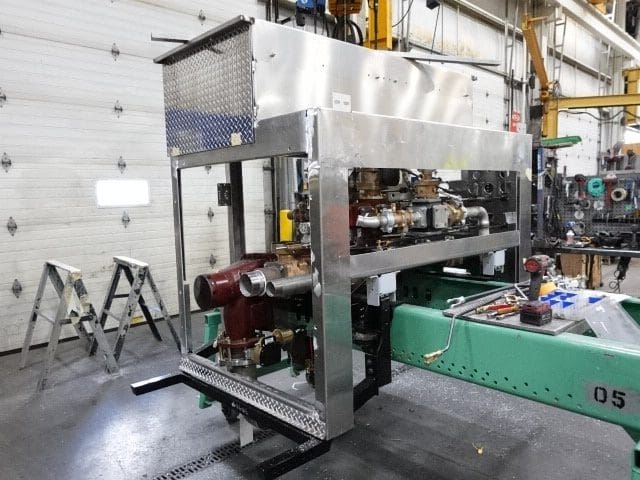

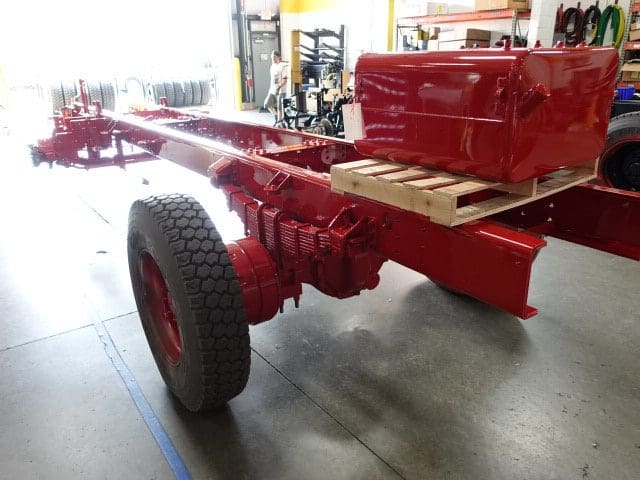

In this report, the cab continued initial assembly, the frame build continued, the pump house continued initial assembly, and the body completed the paint process and was staged.
08-02-24

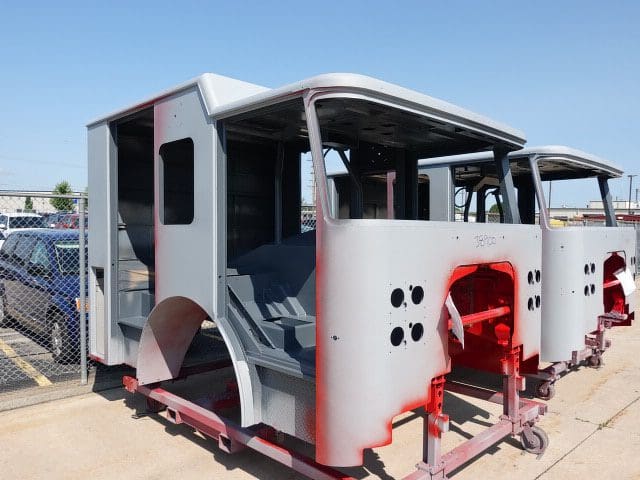

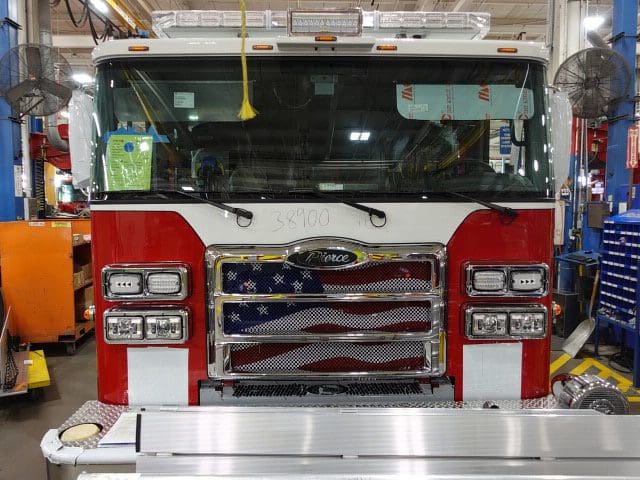

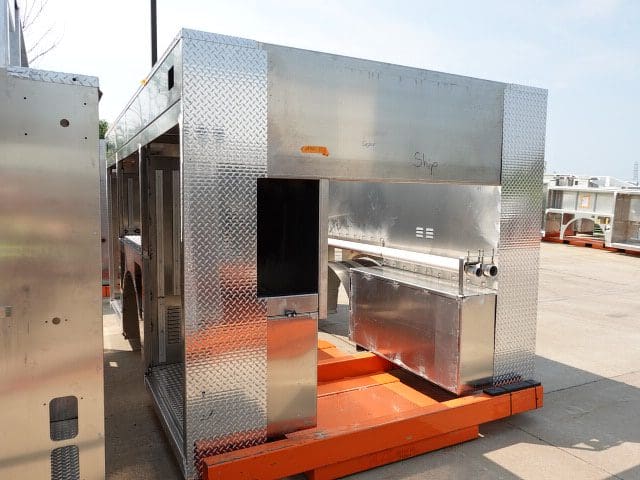

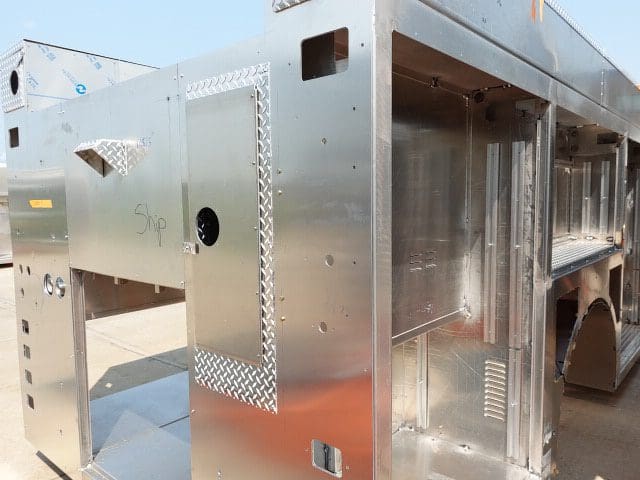

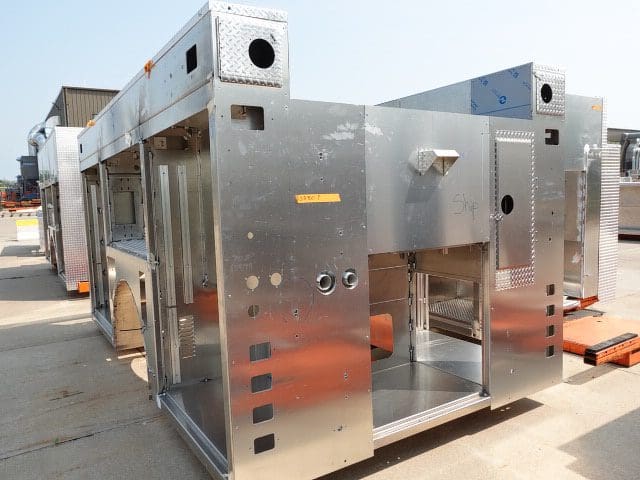

In this report, the cab completed paint and began initial assembly, the frame build continued, the pump house began initial assembly, and the body completed fabrication.
07-26-24

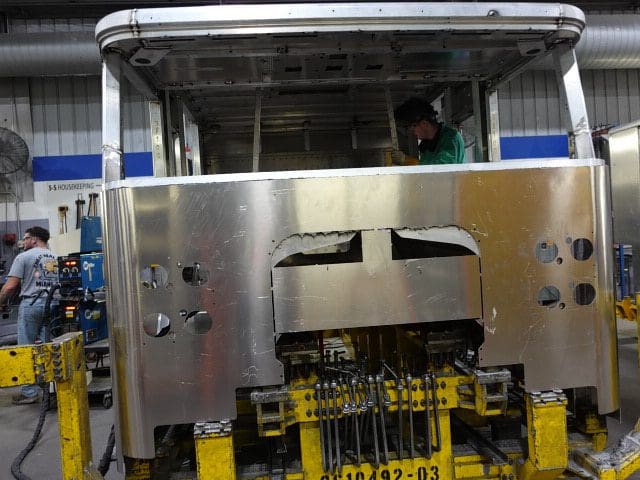

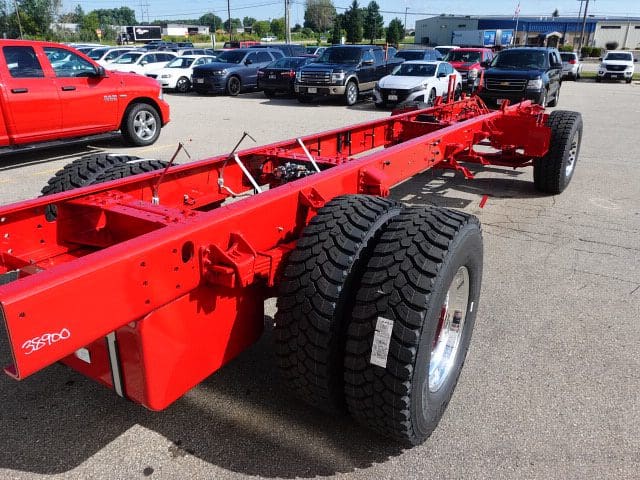

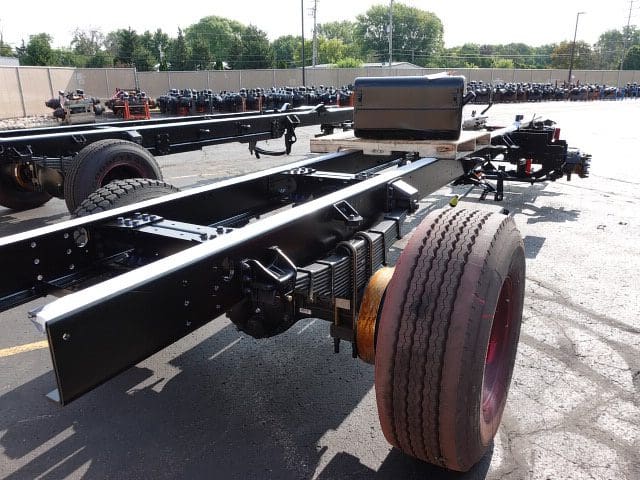

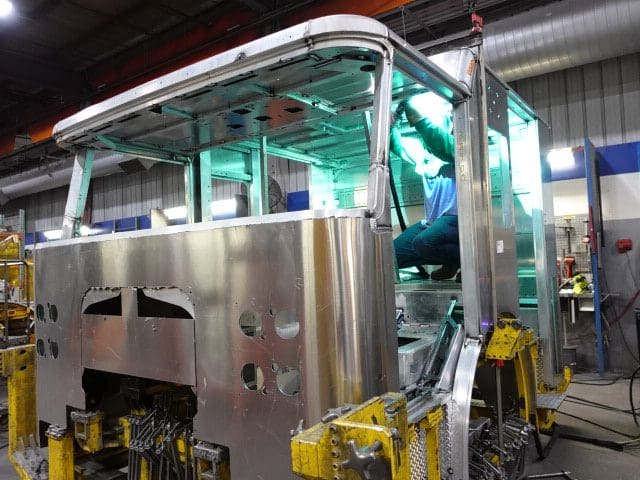

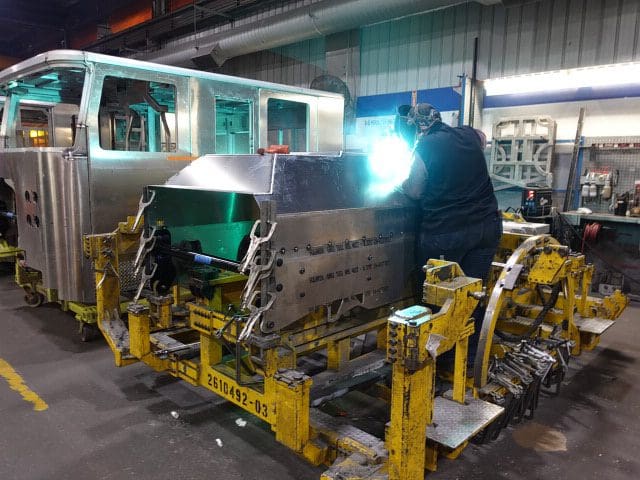

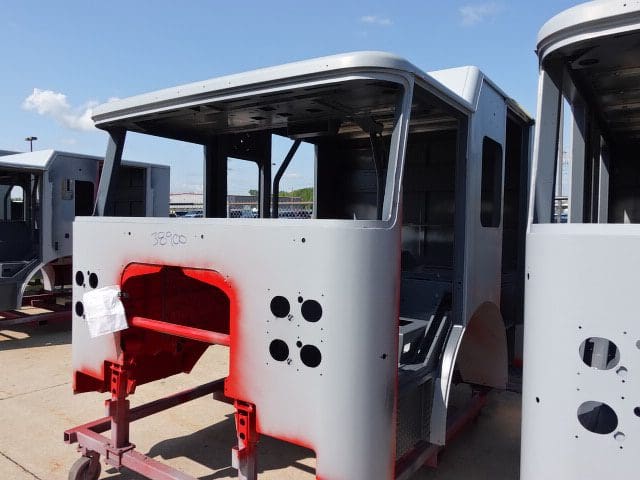

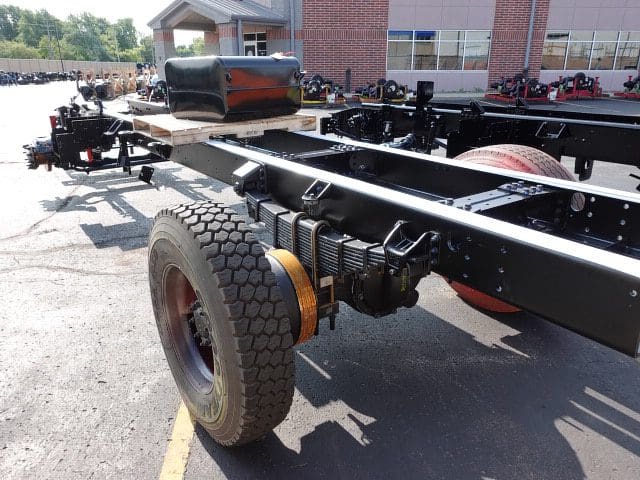

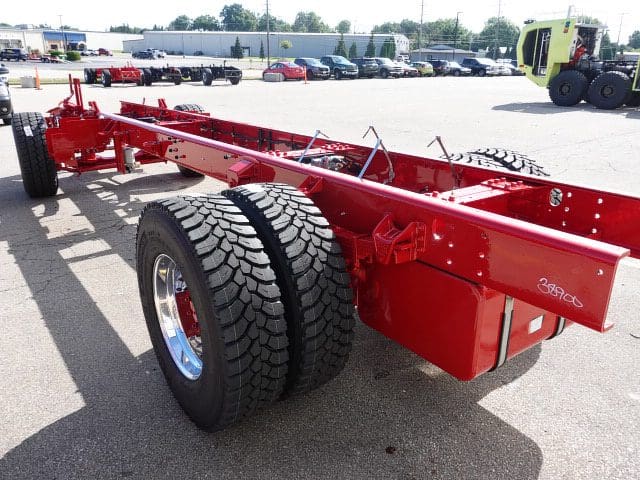

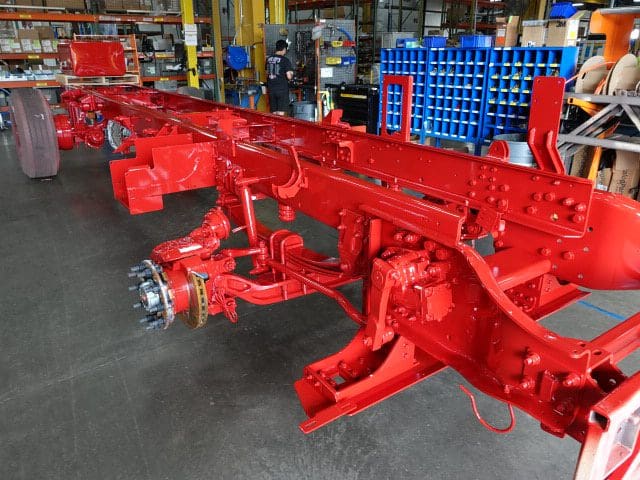

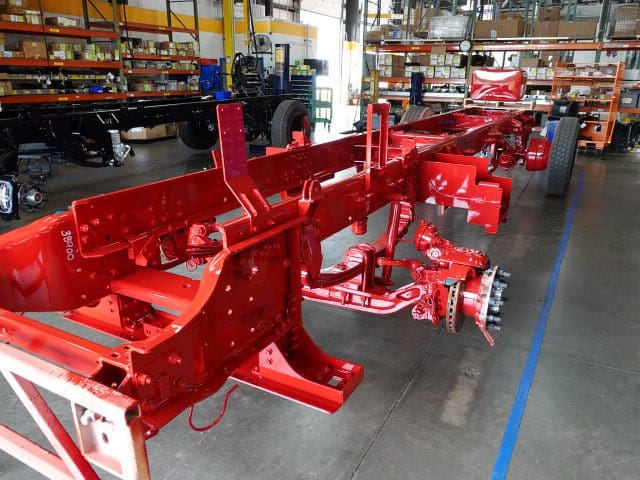

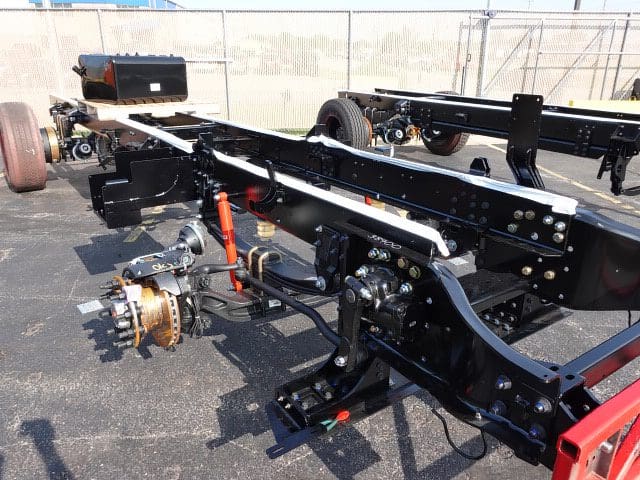

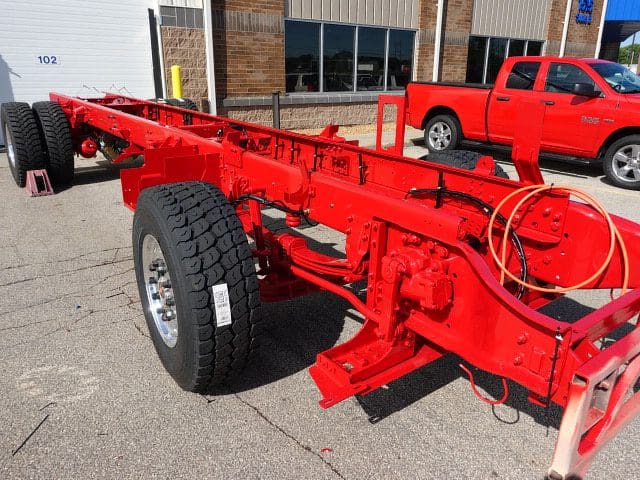

In this report, the cab began the paint process, the frame build began, the pump house structure was fabricated, and the body began fabrication.

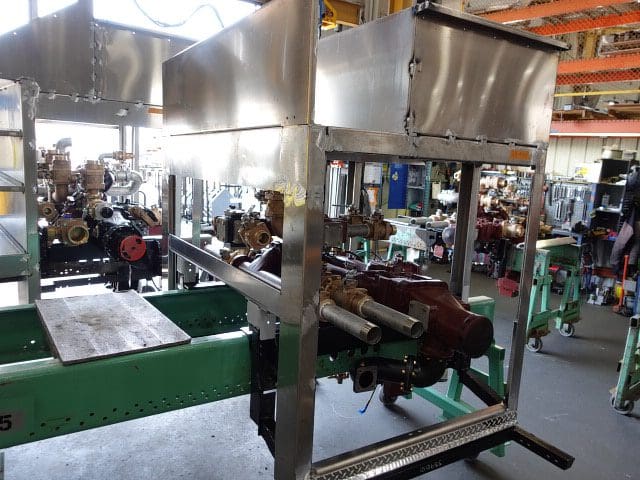

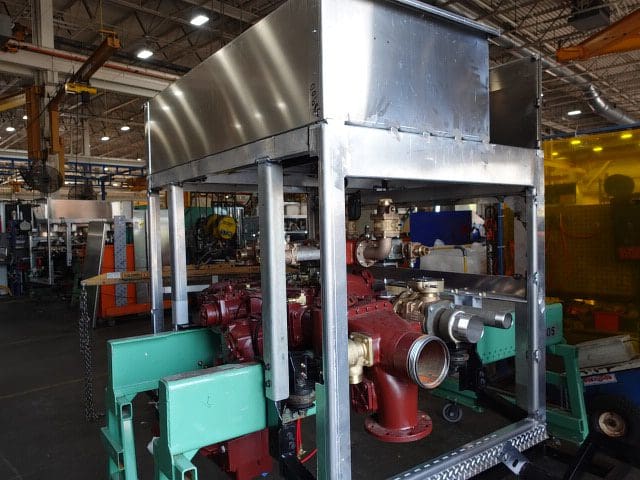

07-12-24

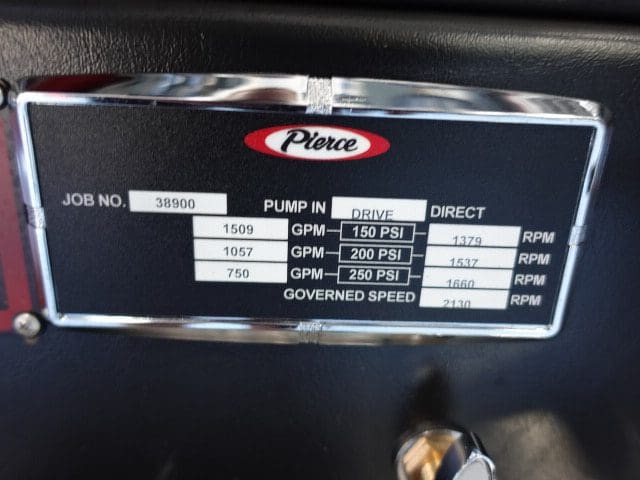

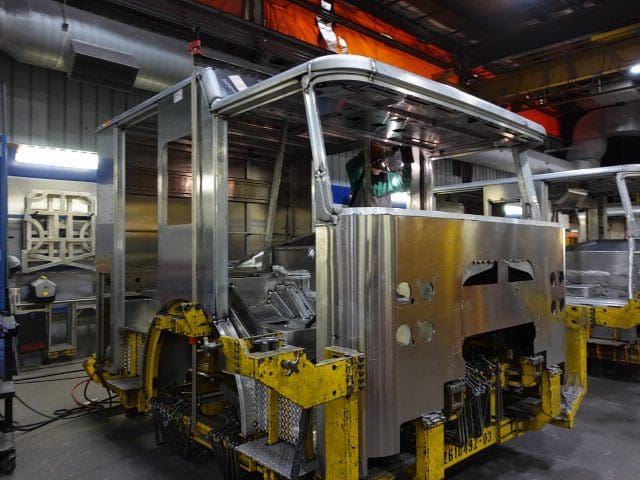

This new Pierce apparatus is now in production! In this report, the cab began fabrication.
