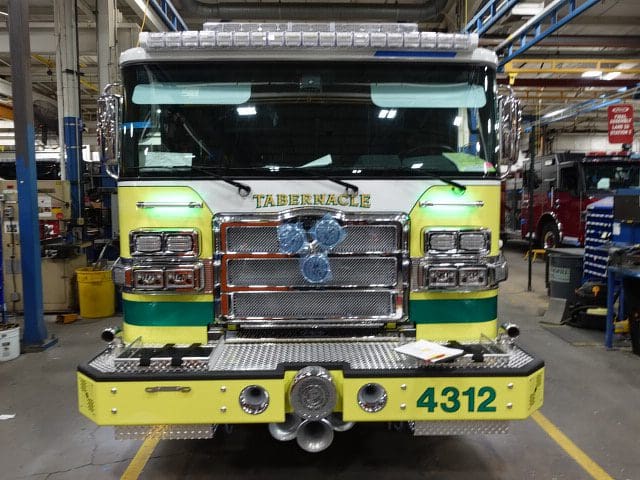

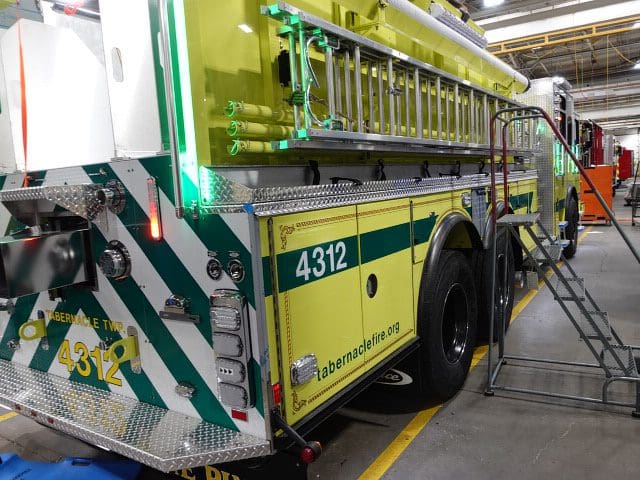

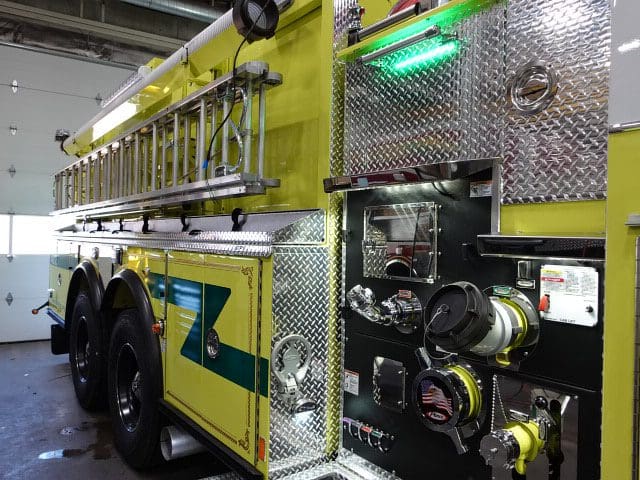

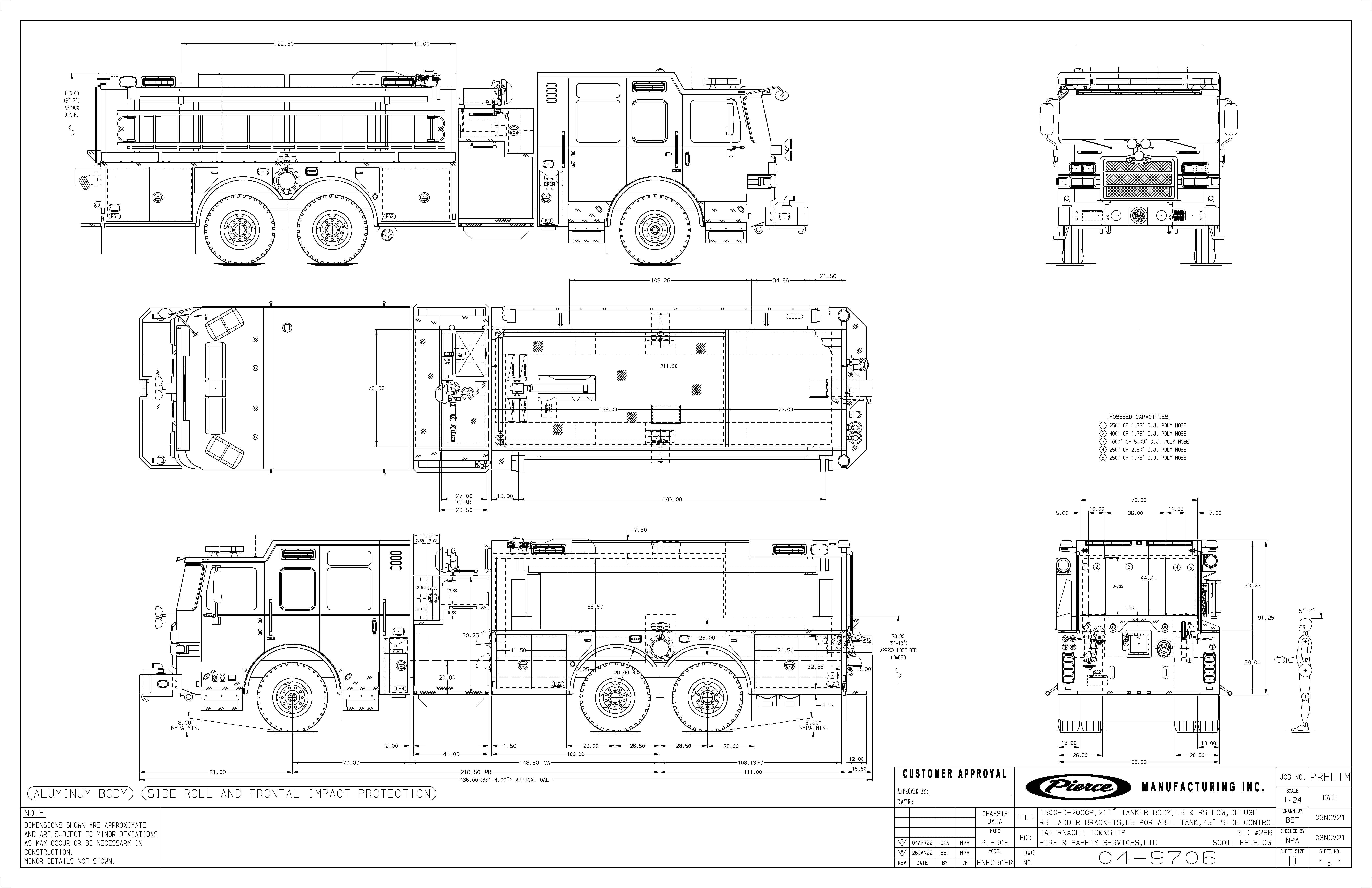

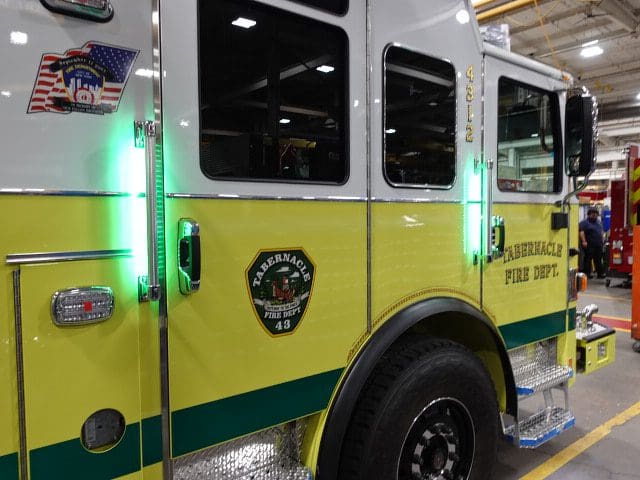

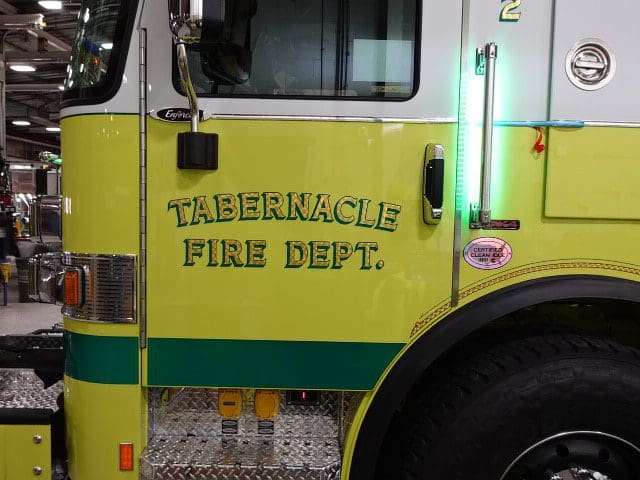

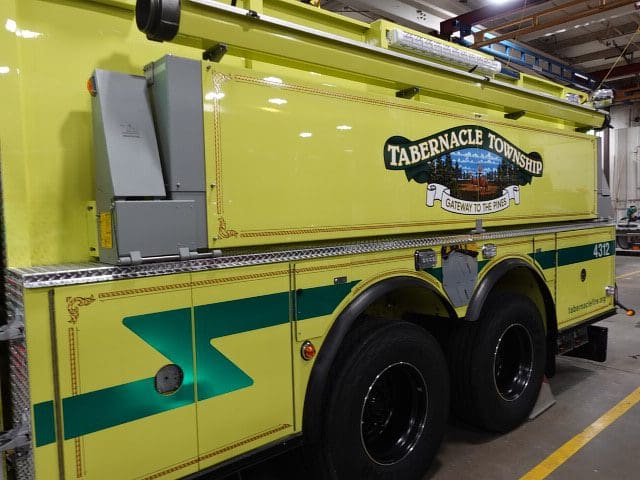

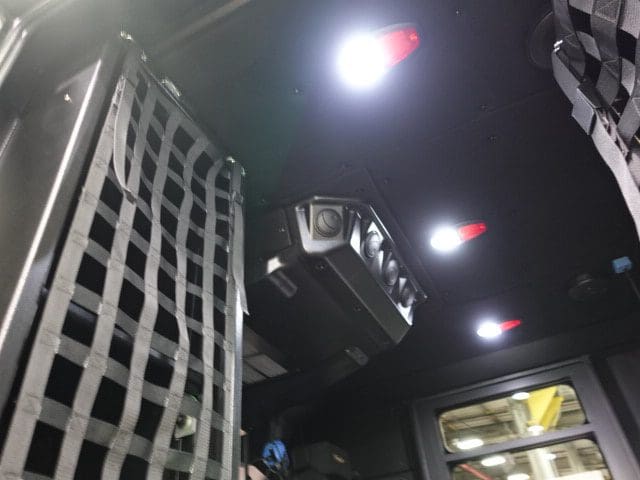

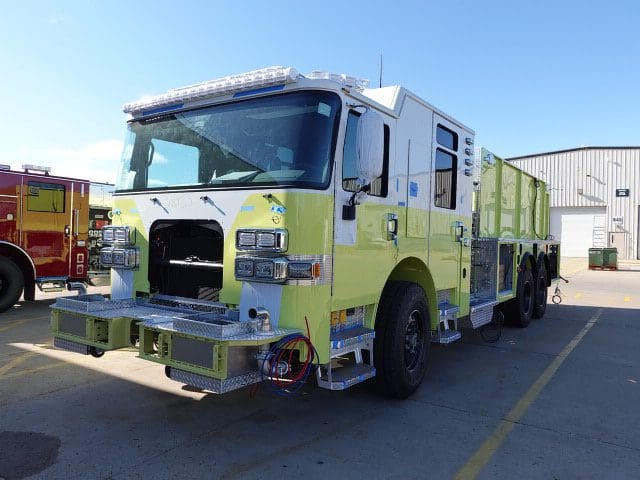

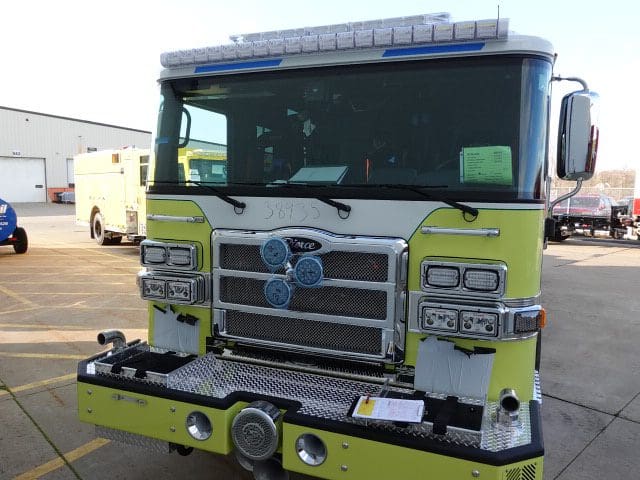

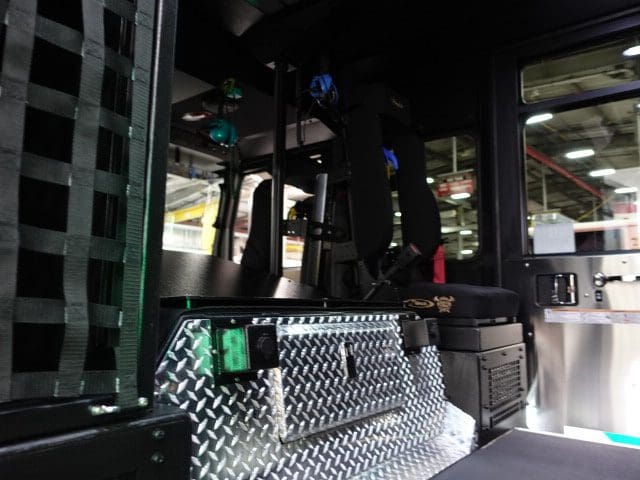

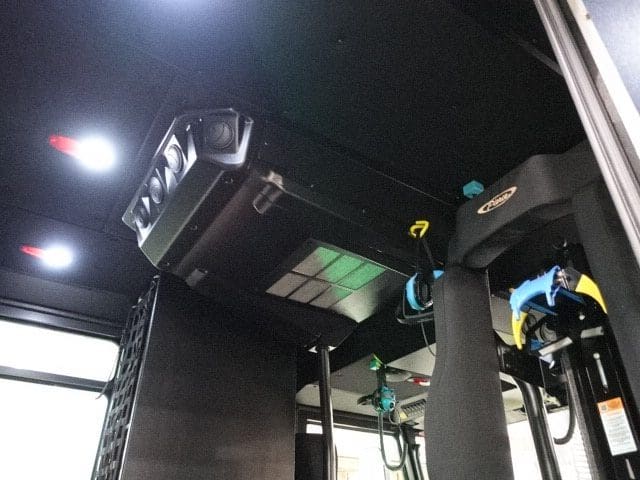

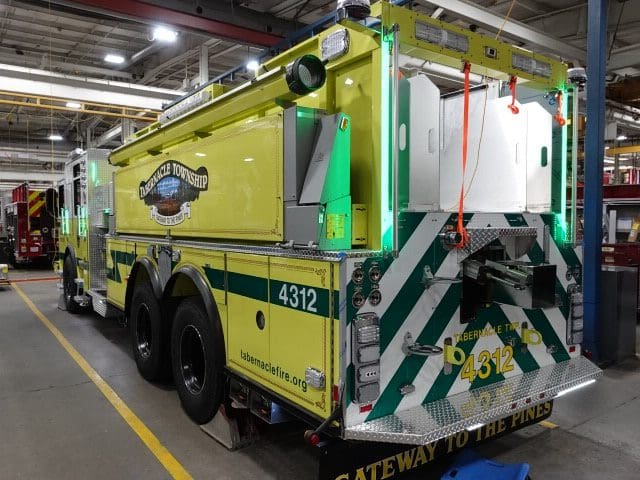

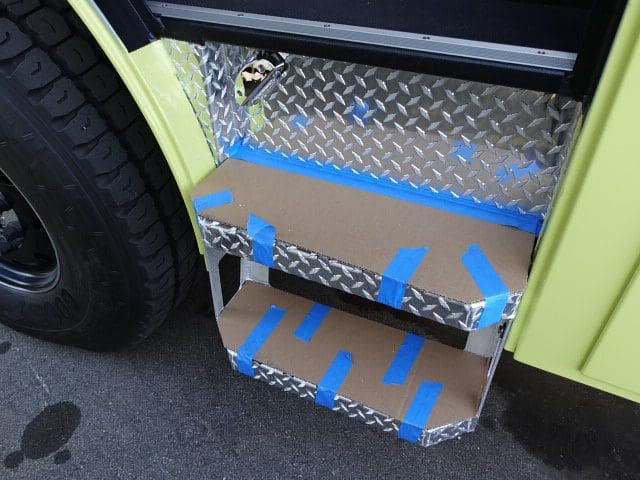

11-29-24

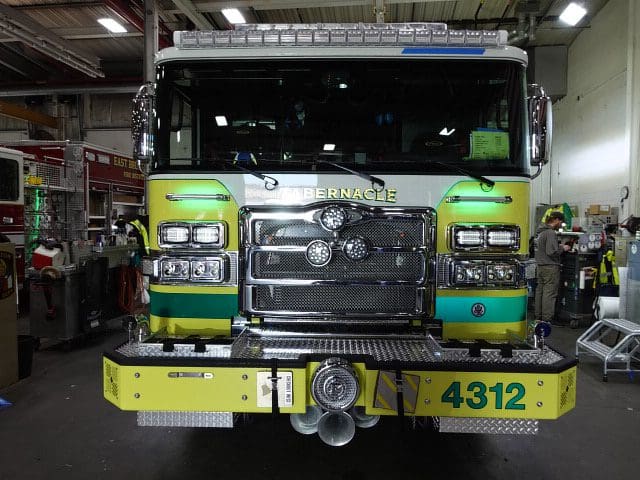

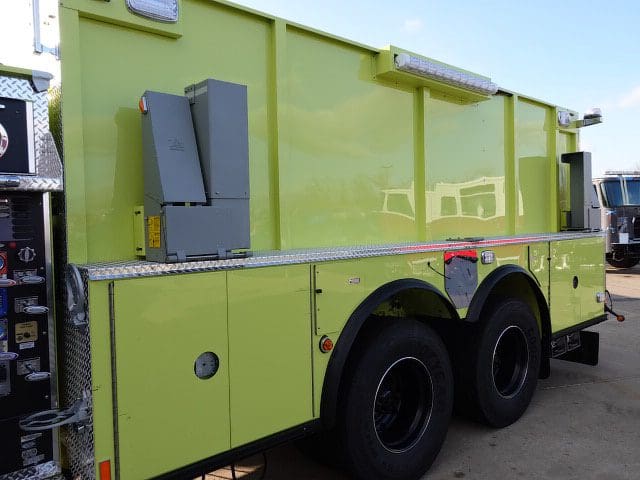

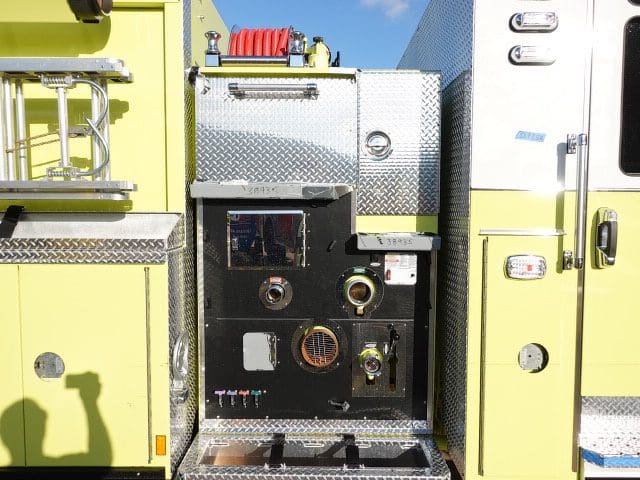

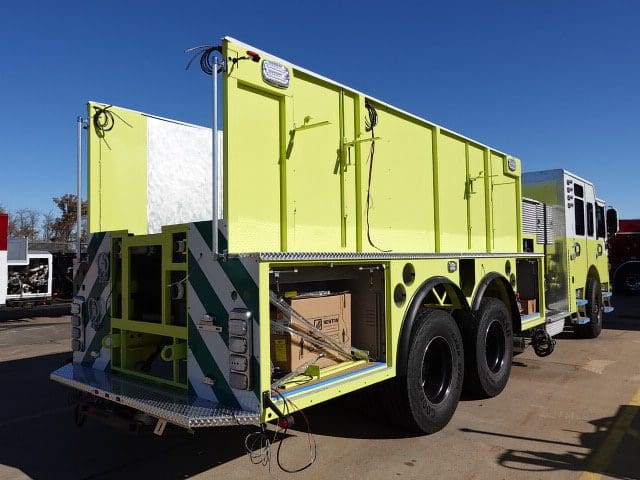

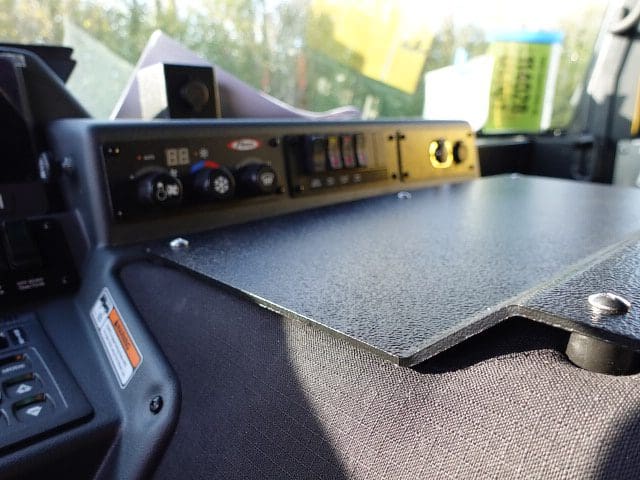

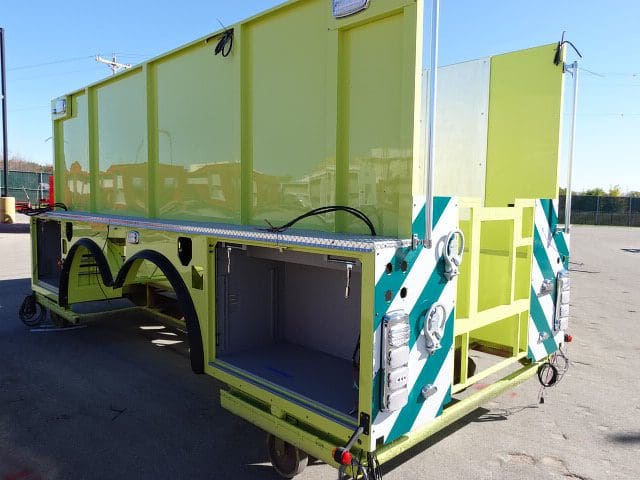

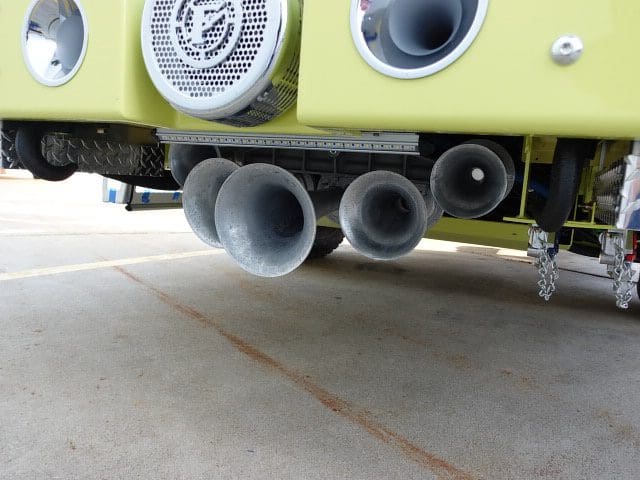

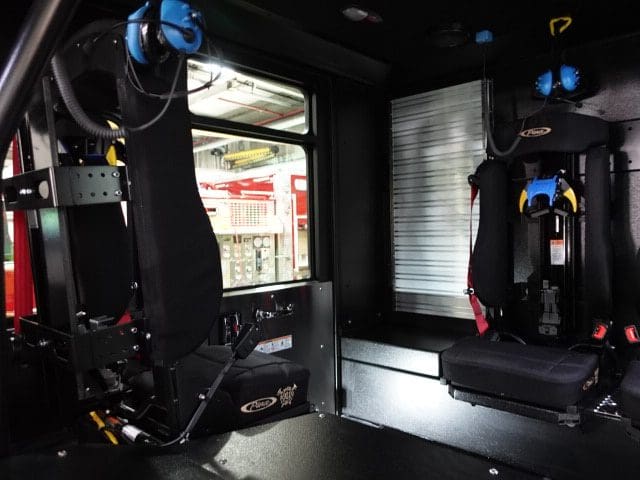

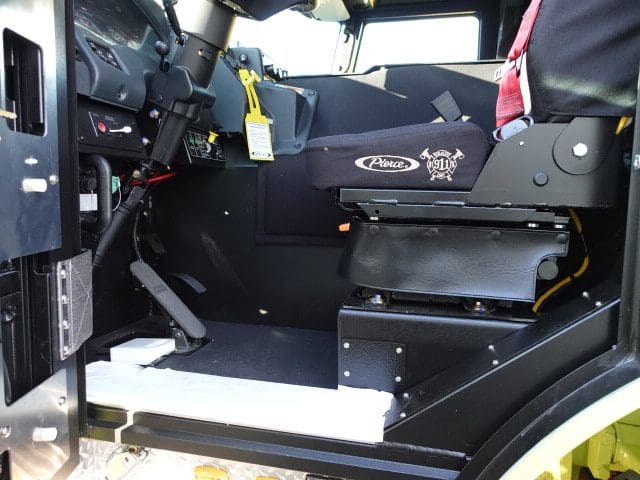

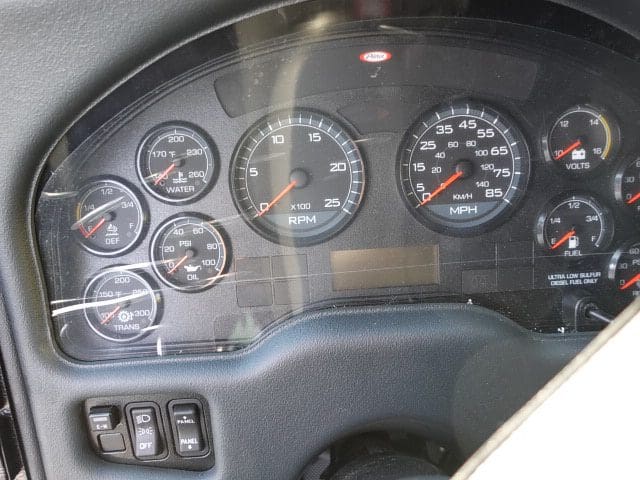

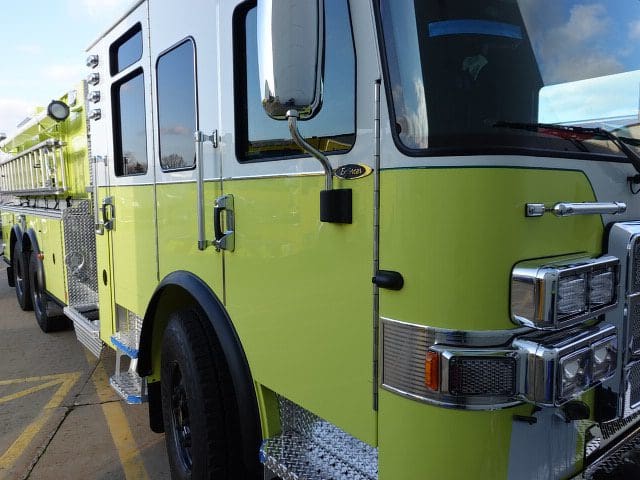

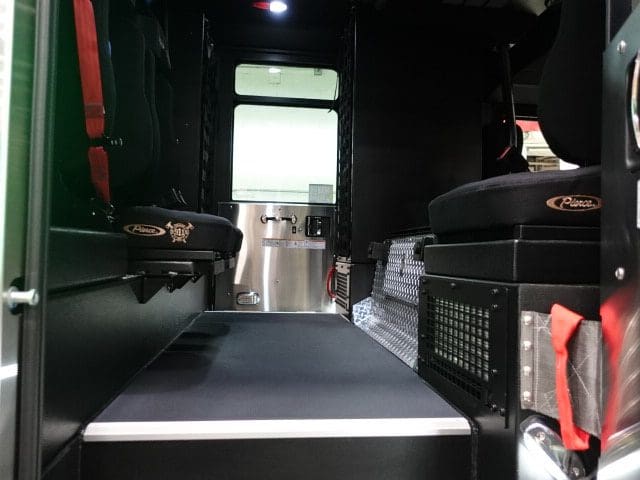

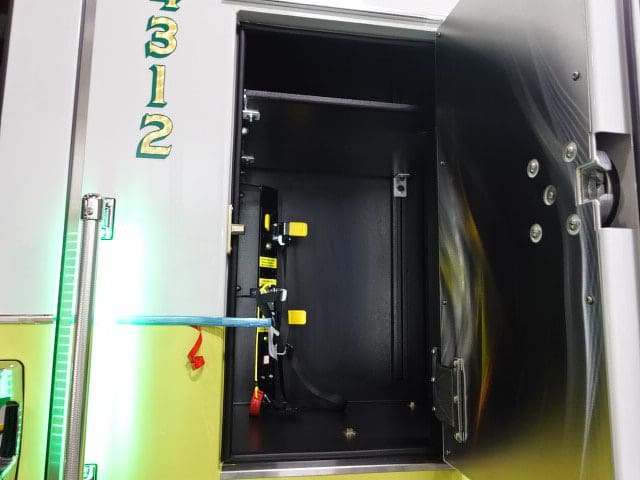

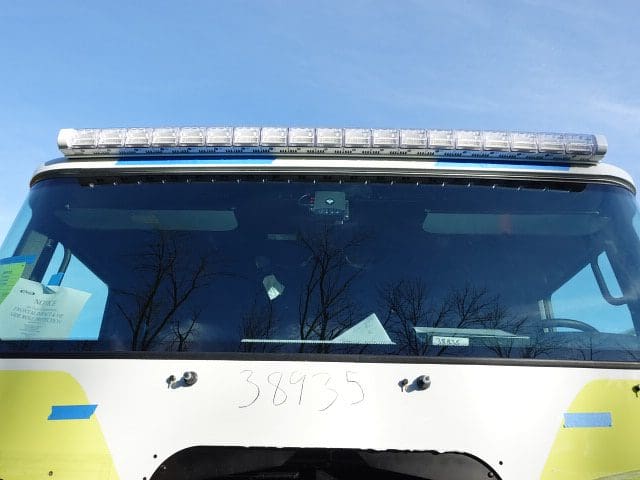

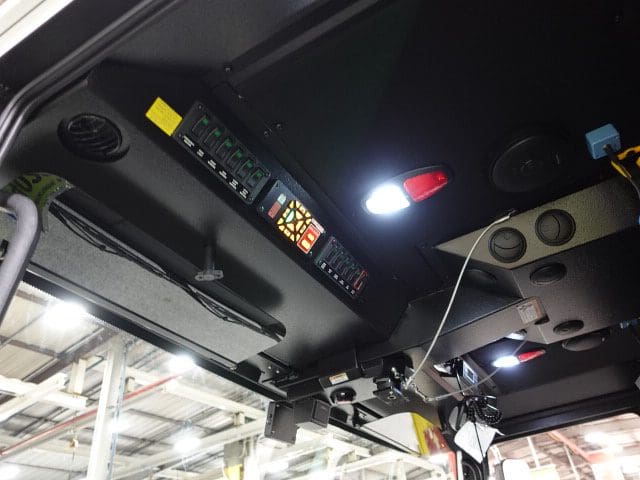

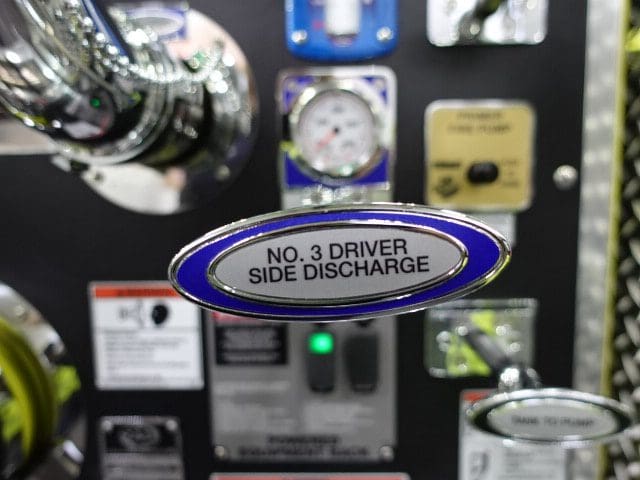

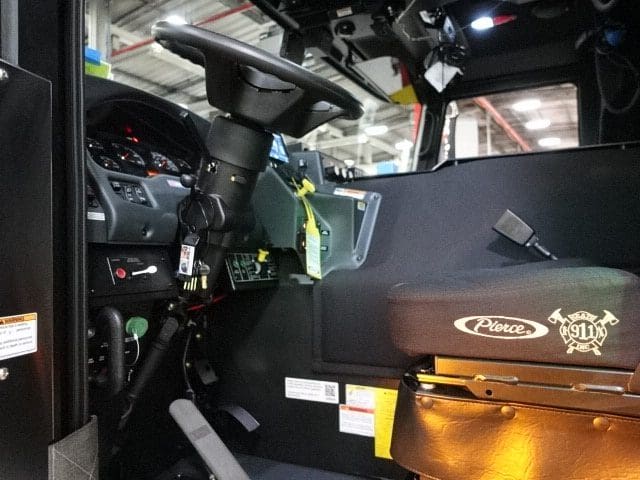

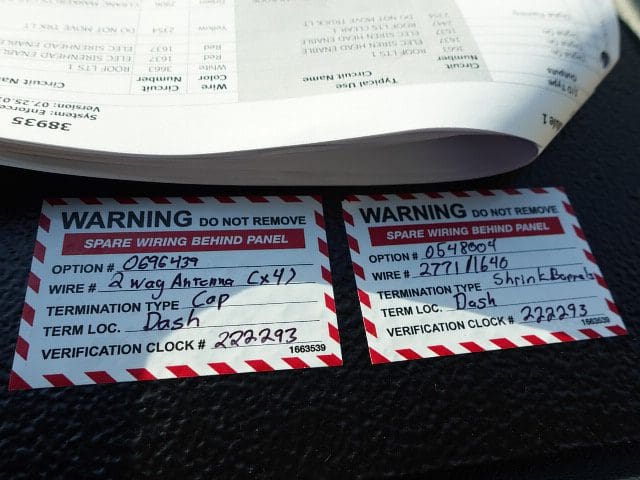

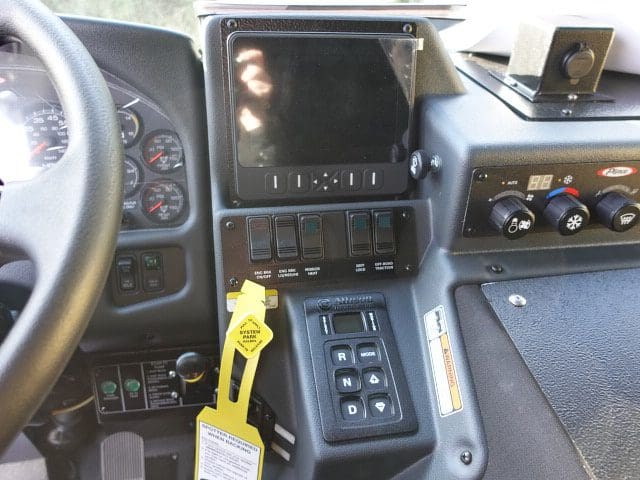

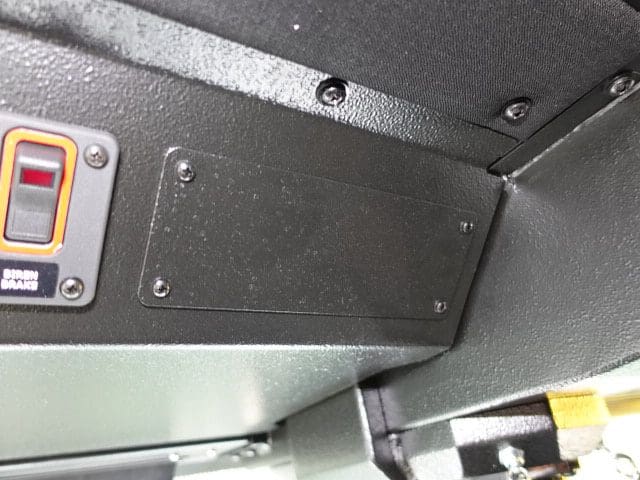

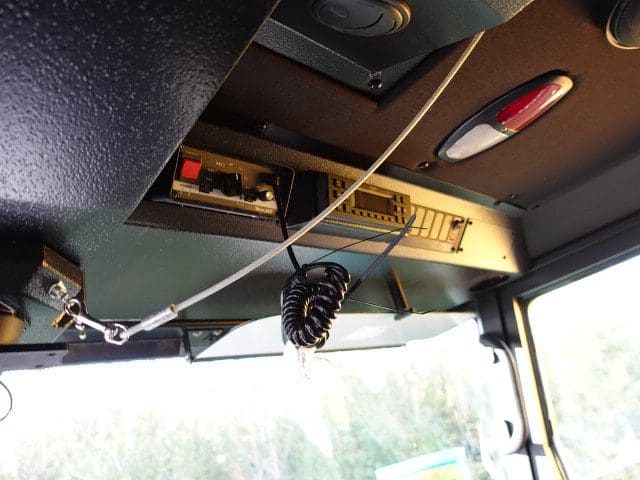

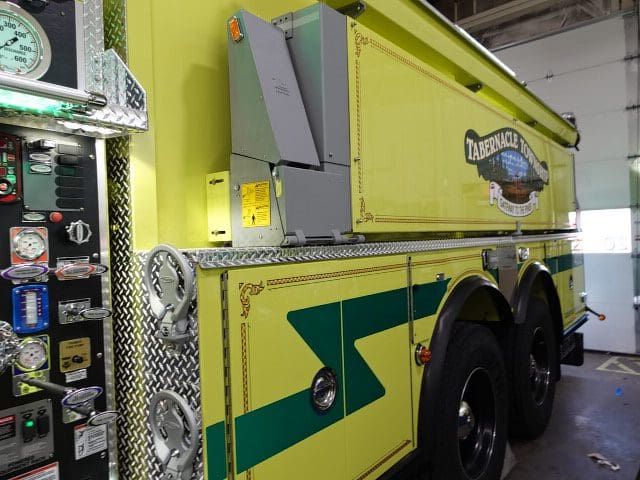

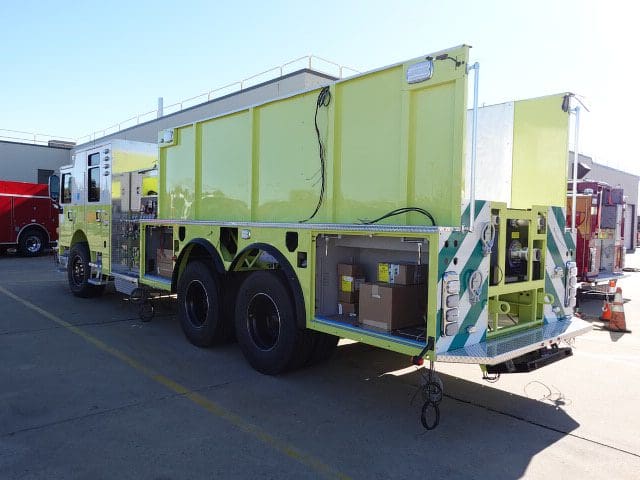

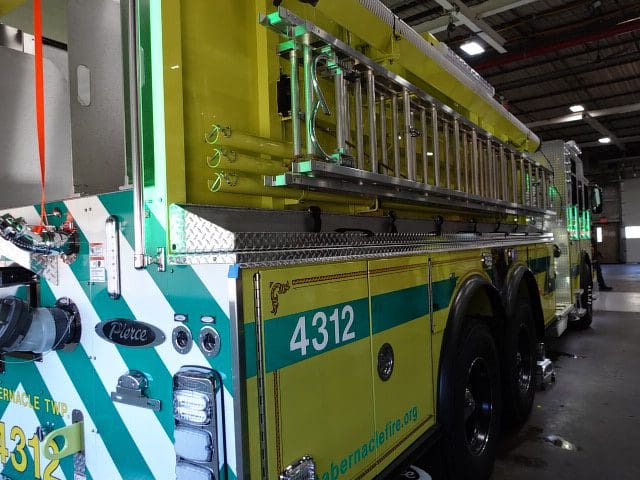

In this report, the apparatus continued quality and graphics where any remaining content will be applied. Once finished, it will be made ready for the customer acceptance inspection. This is the last scheduled report.
11-22-24

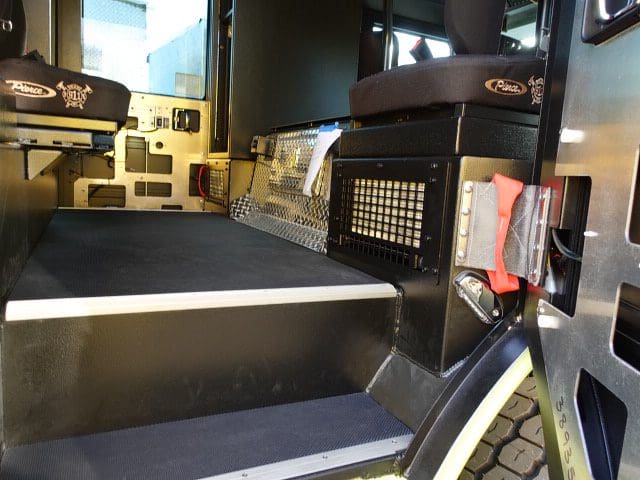

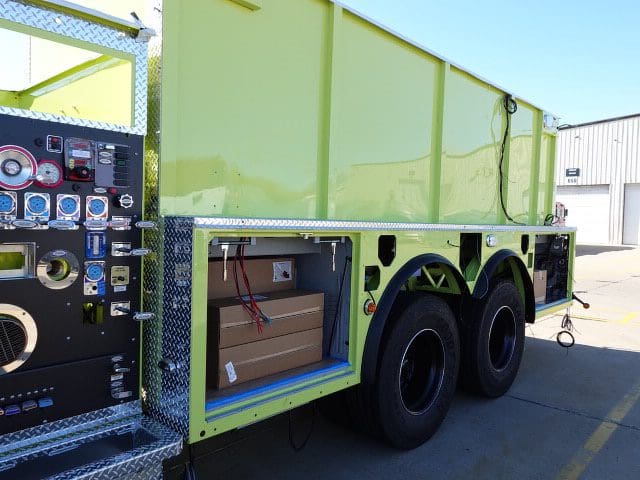

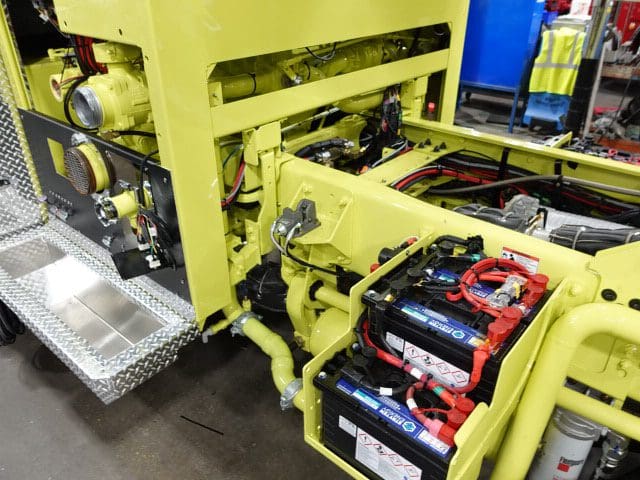

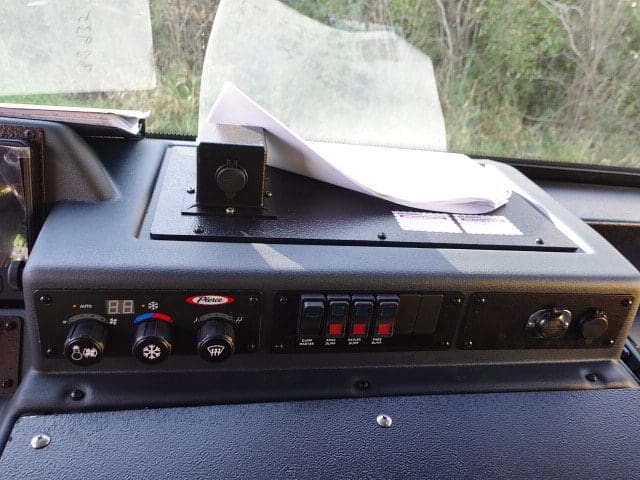

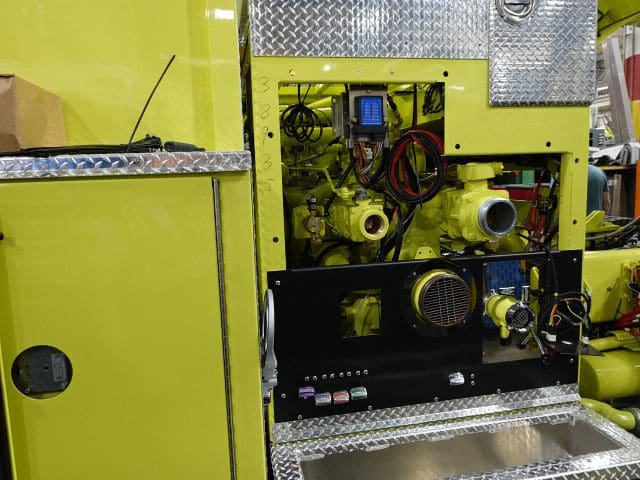

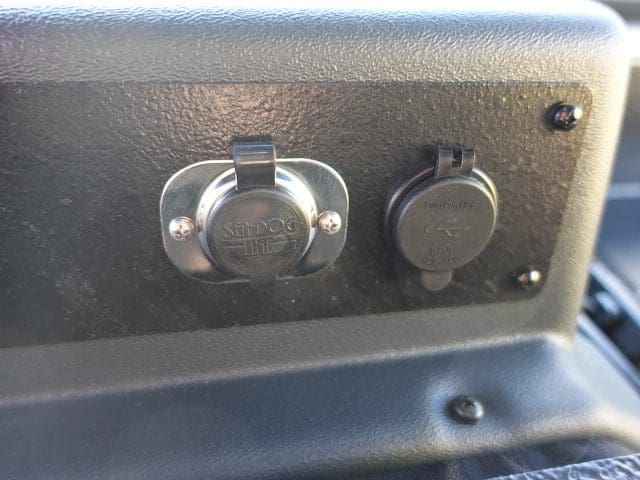

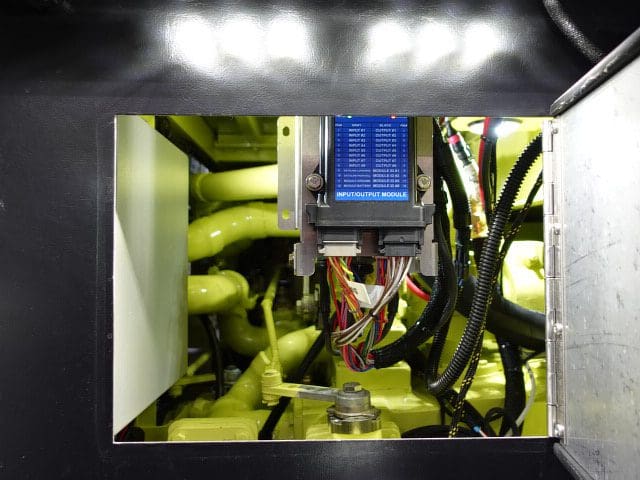

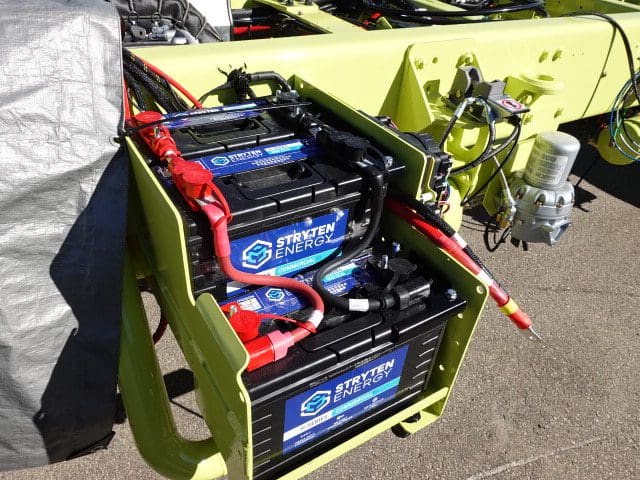

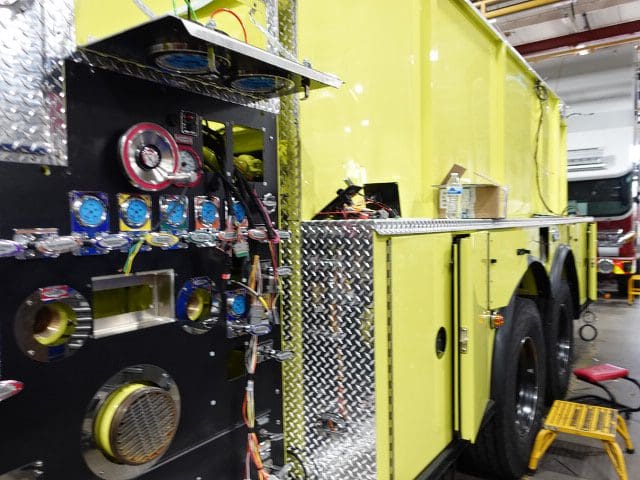

In this report, the apparatus completed testing and was released to quality and graphics where any remaining content will be applied.
11-15-24

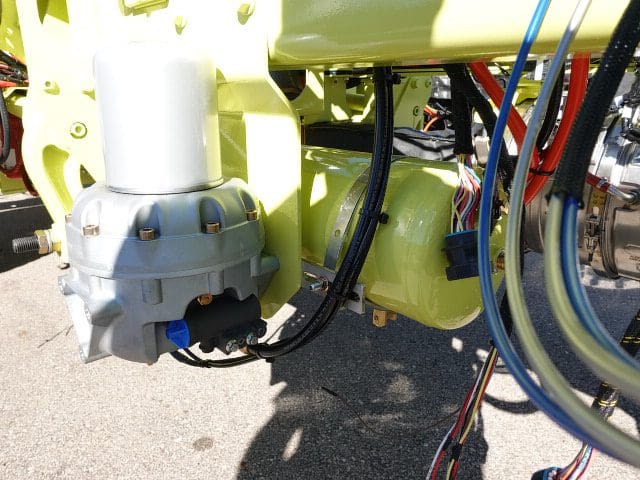

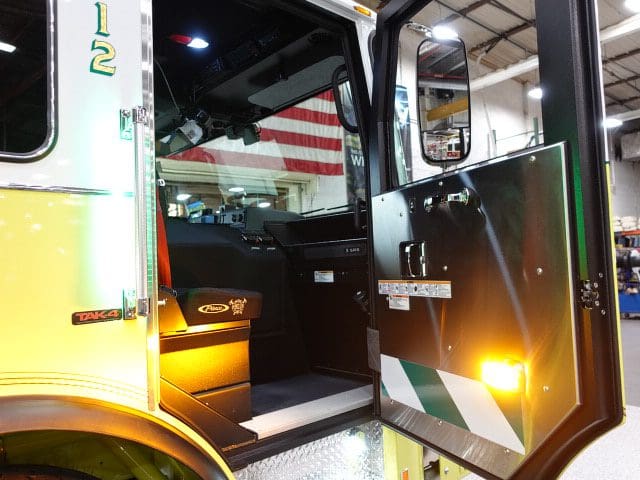

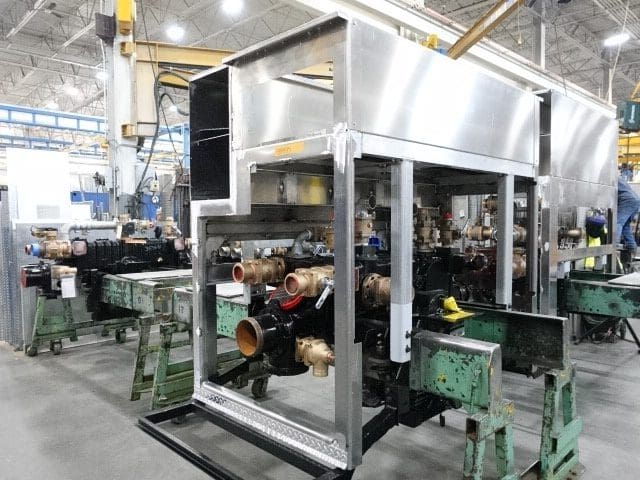

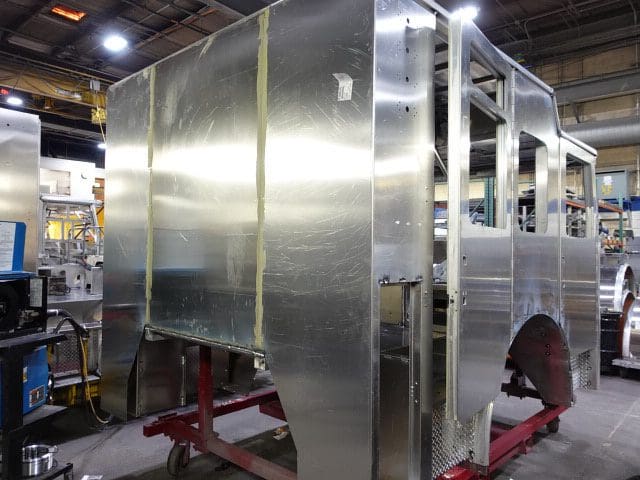

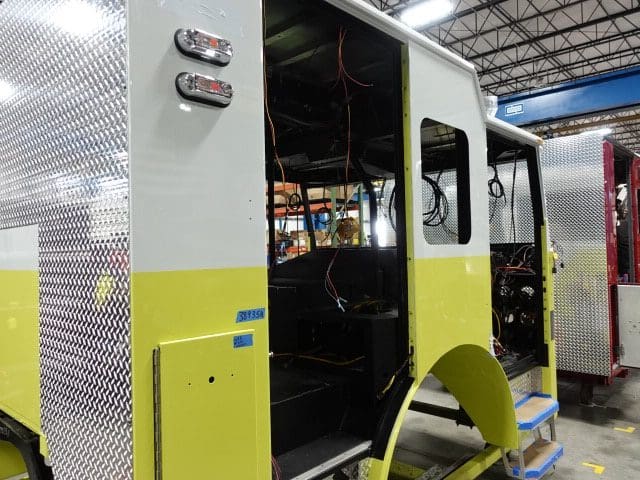

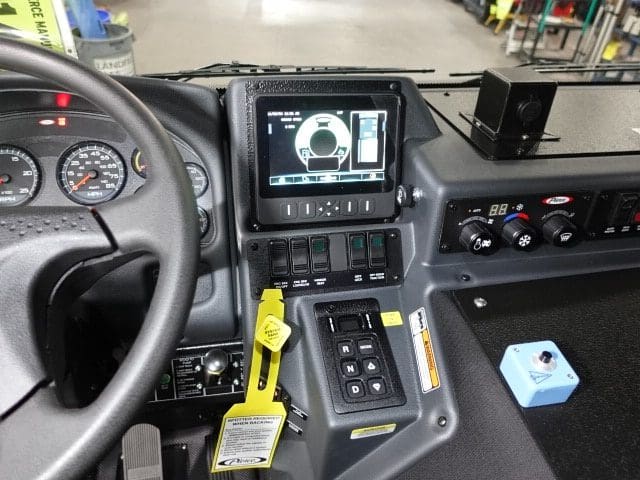

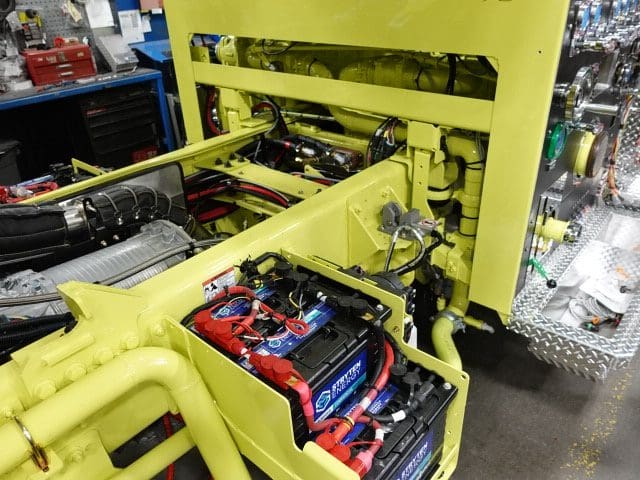

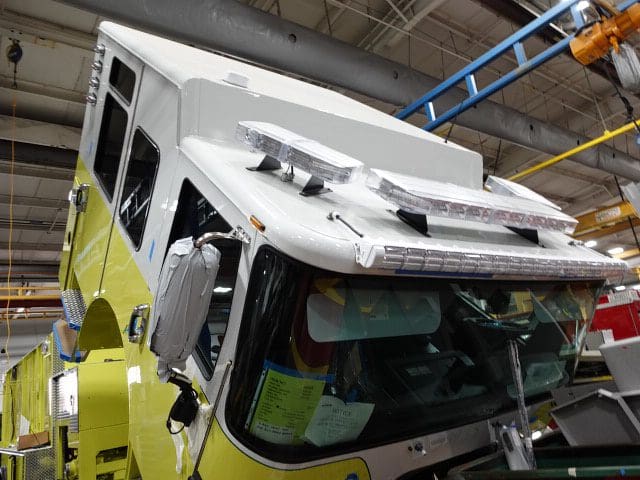

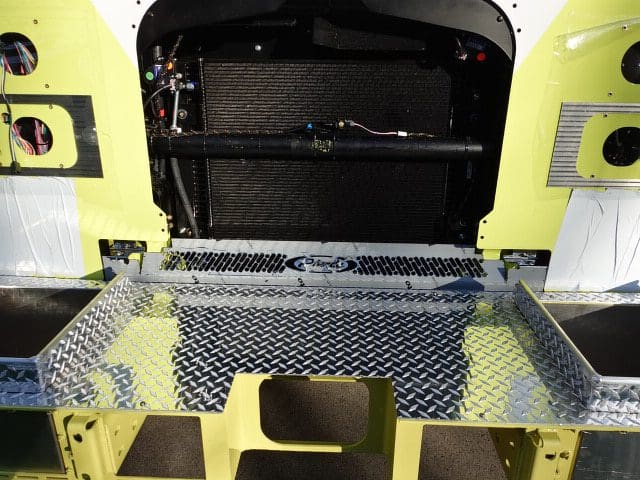

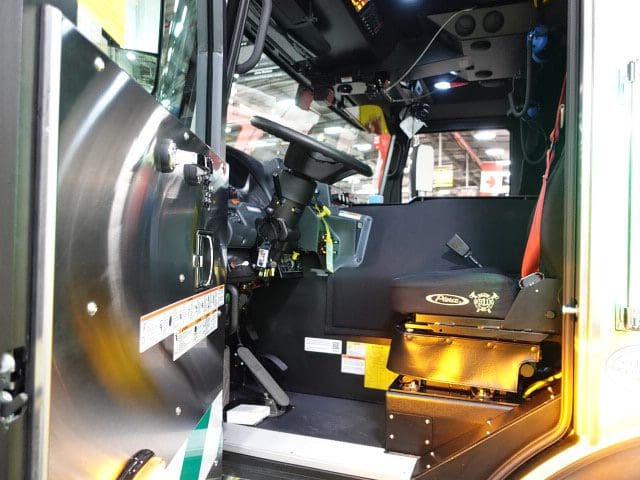

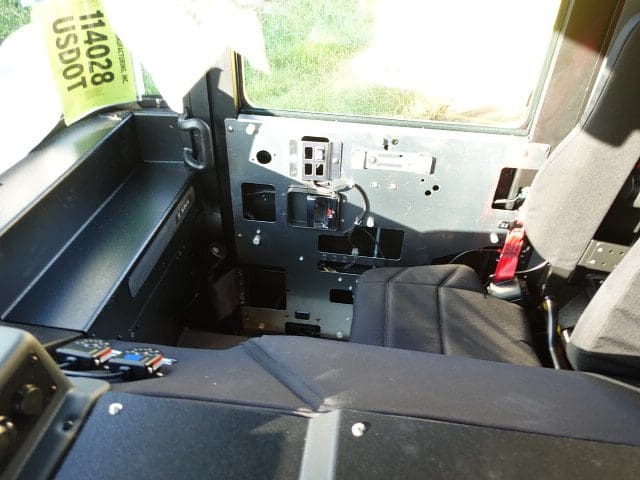

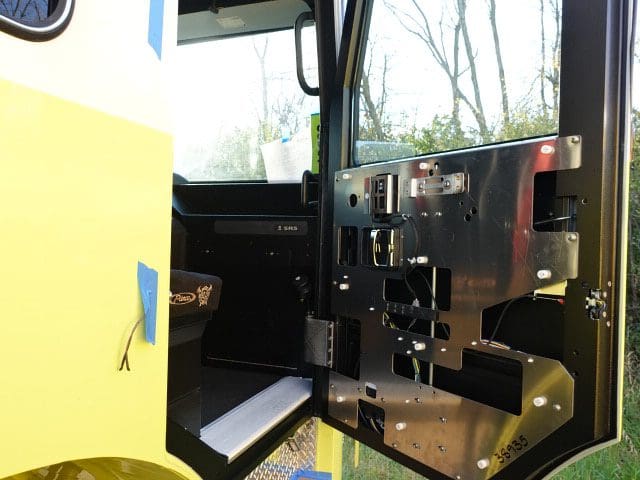

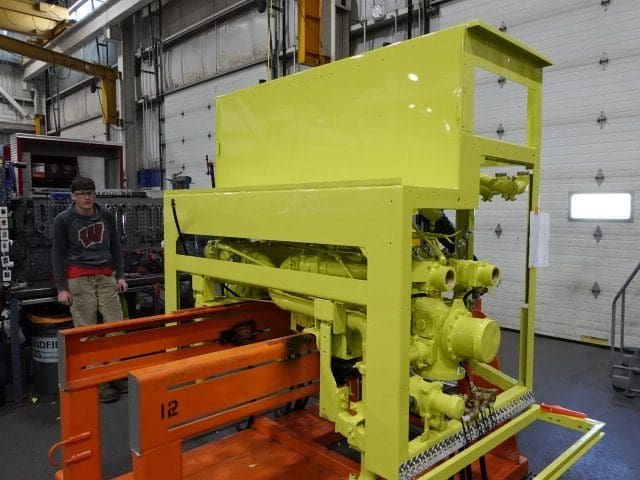

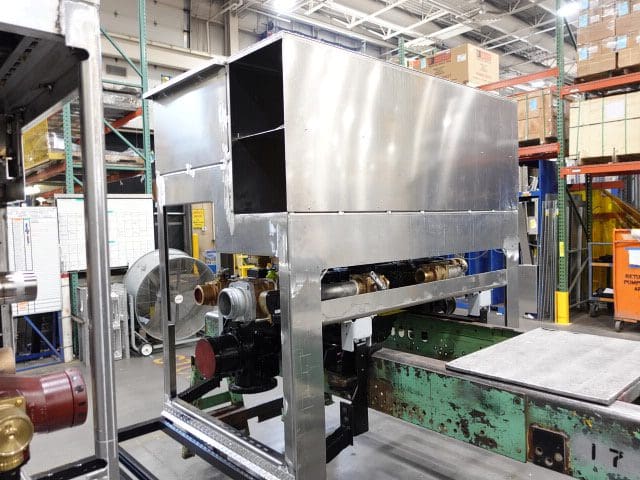

In this report, the apparatus completed final assembly and released to initial test.
10-11-24

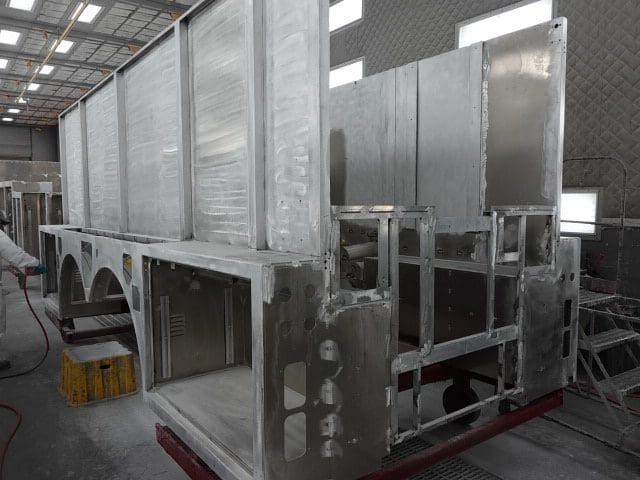

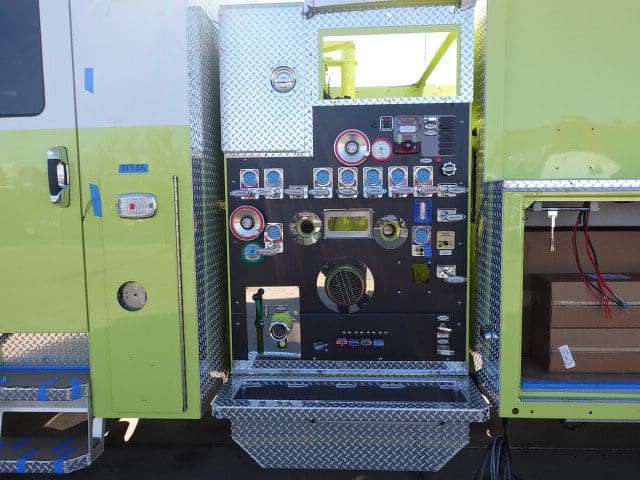

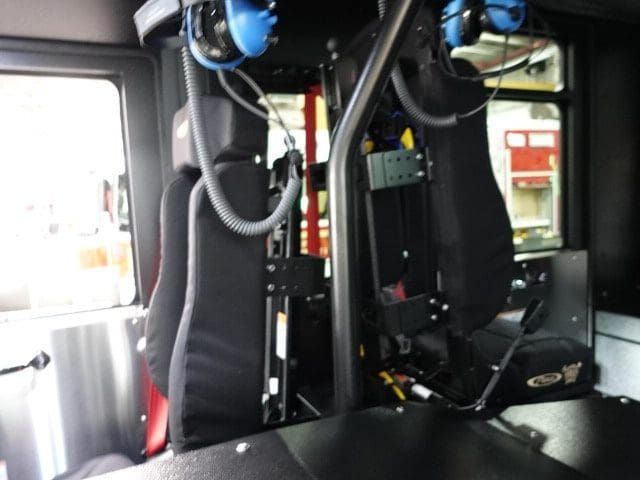

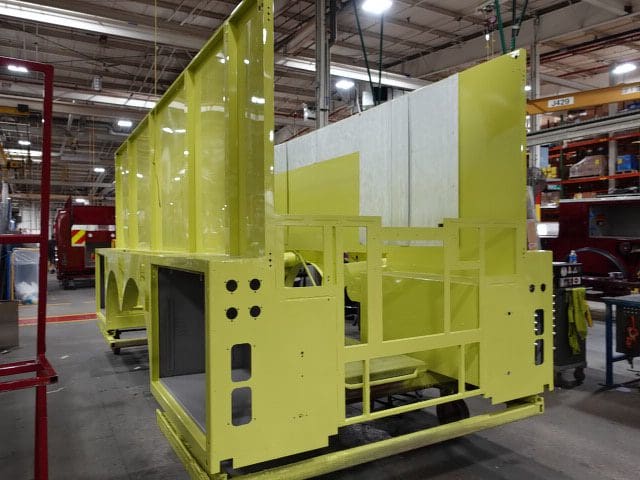

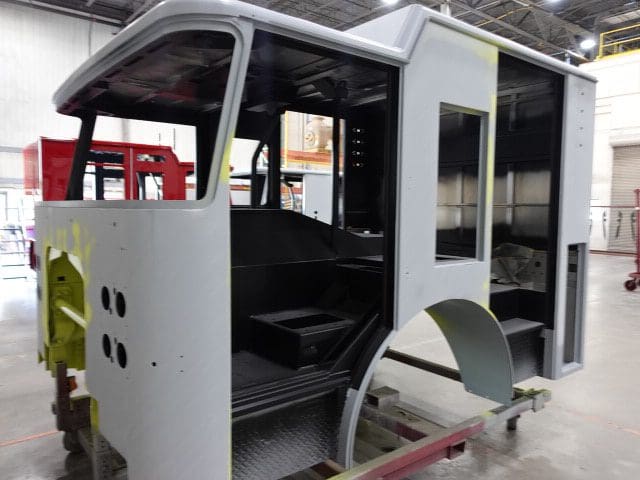

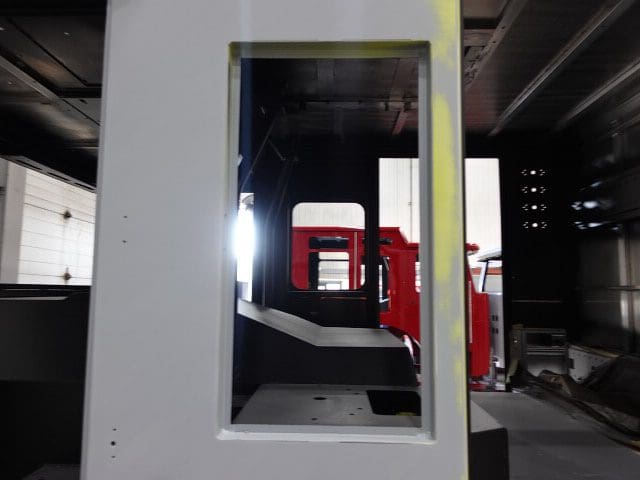

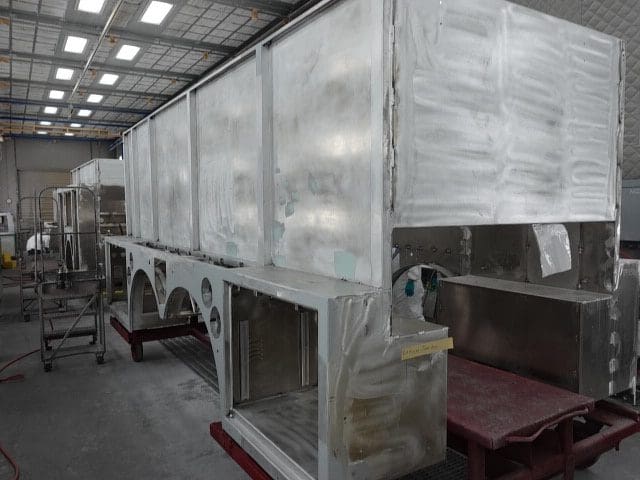

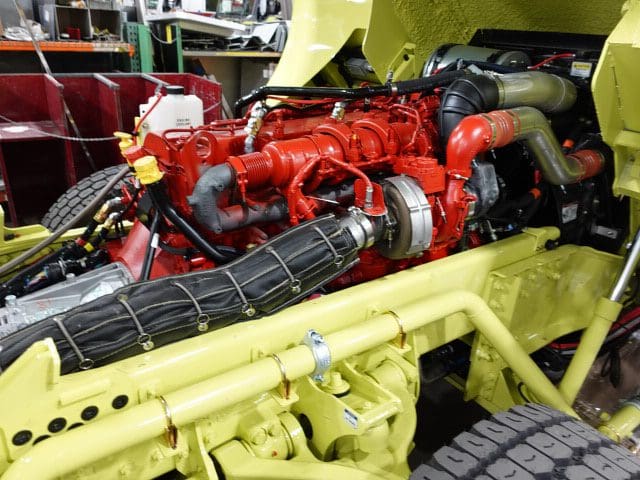

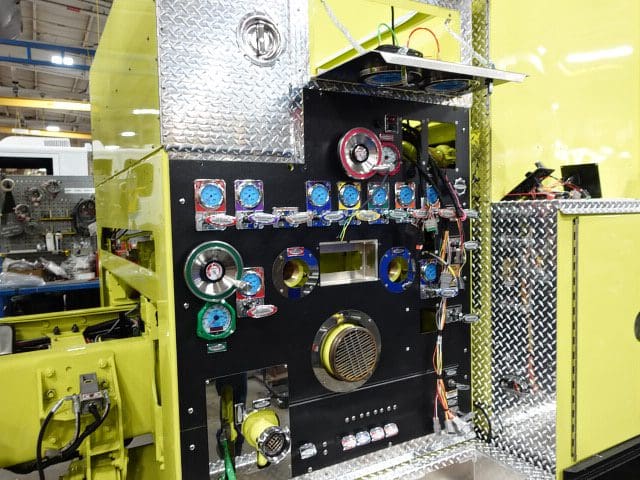

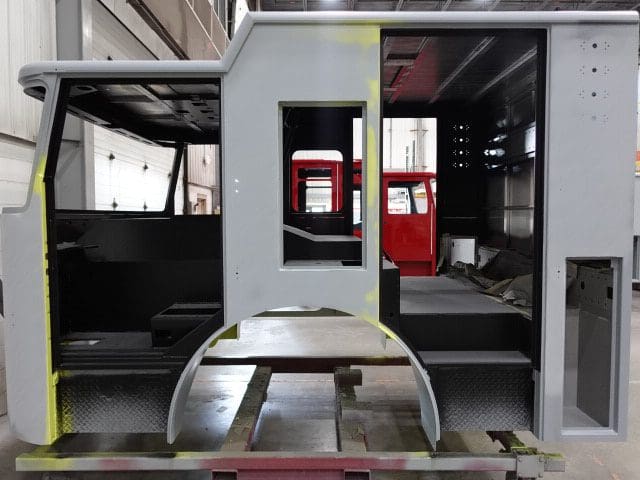

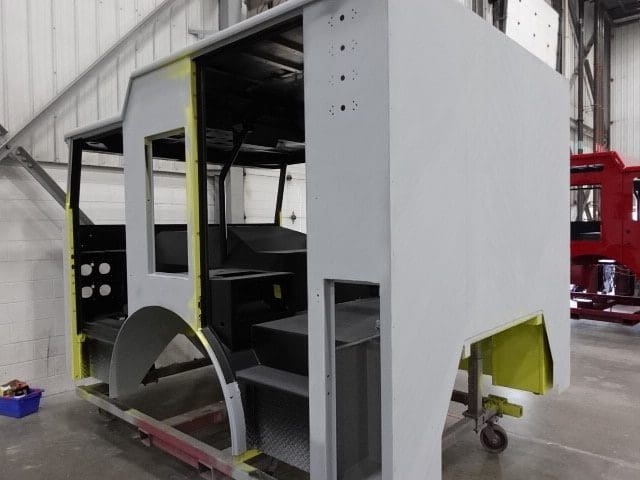

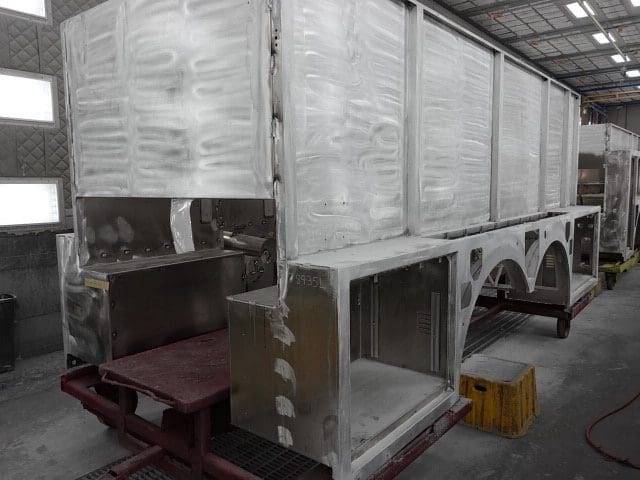

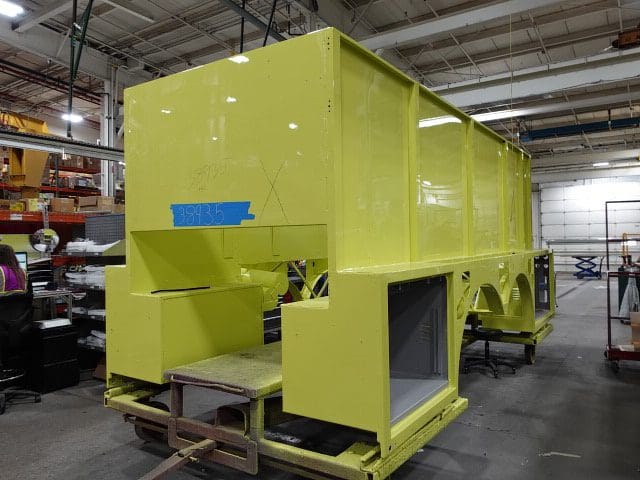

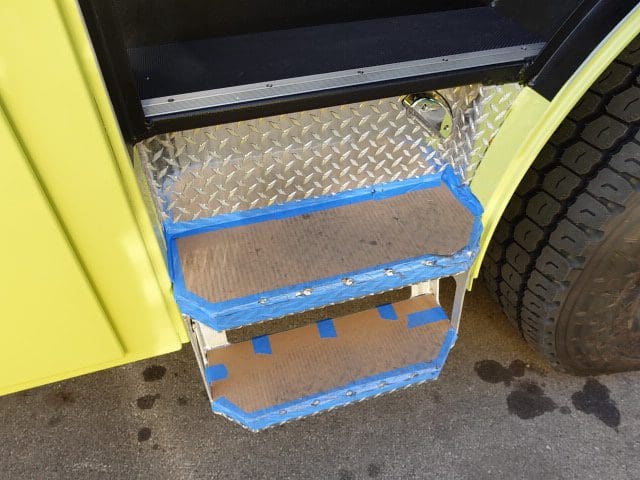

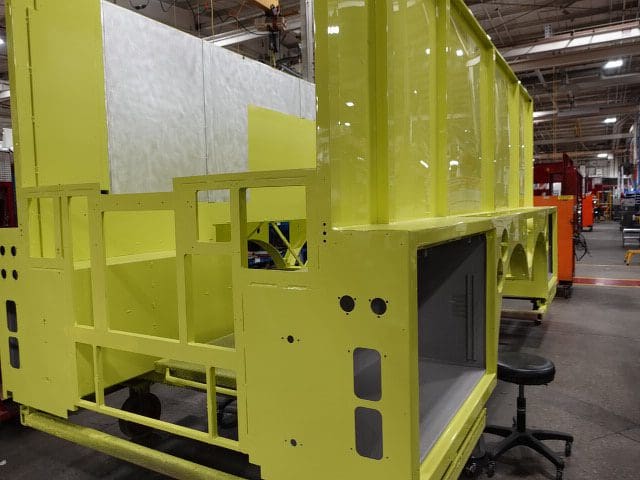

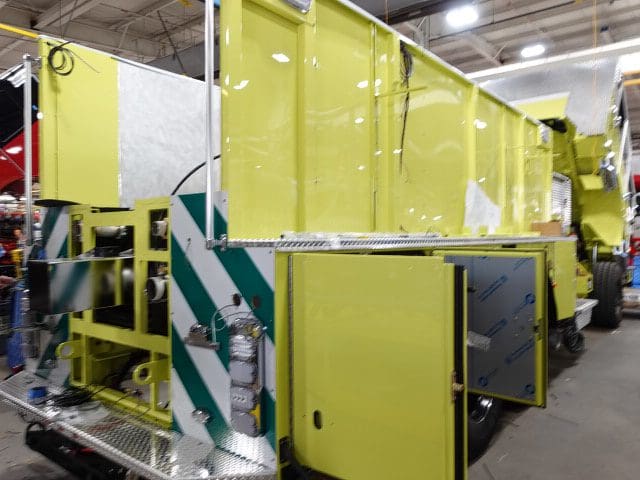

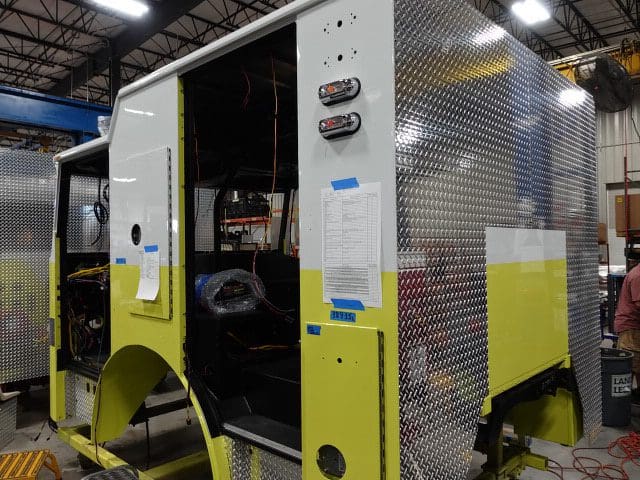

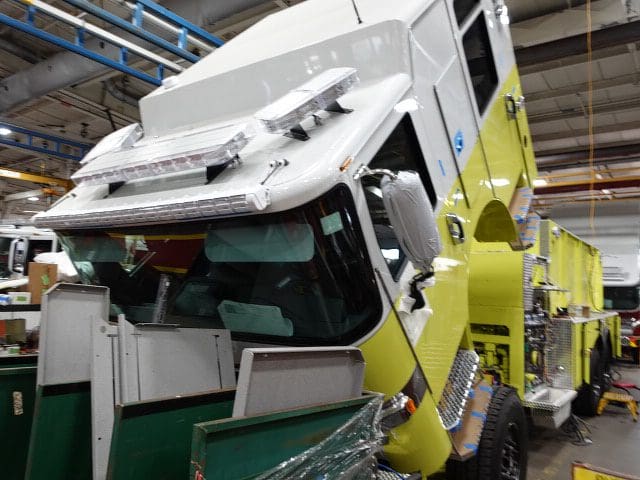

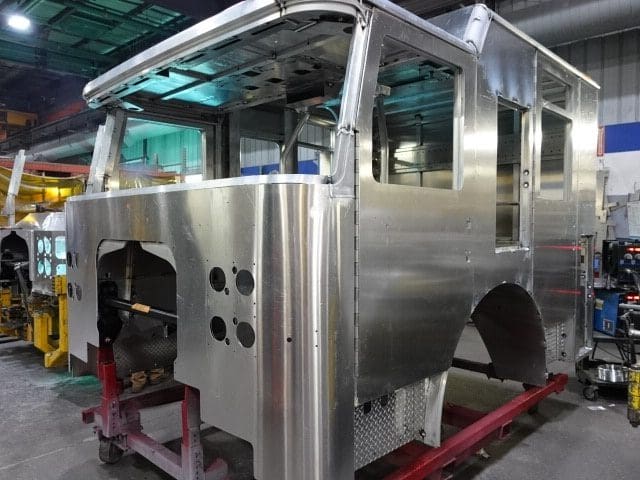

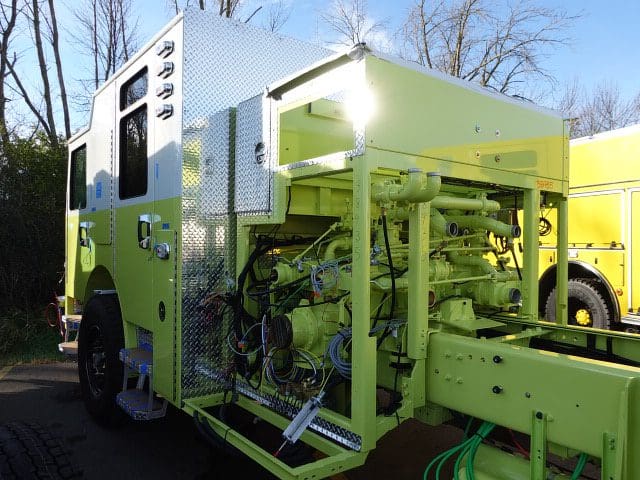

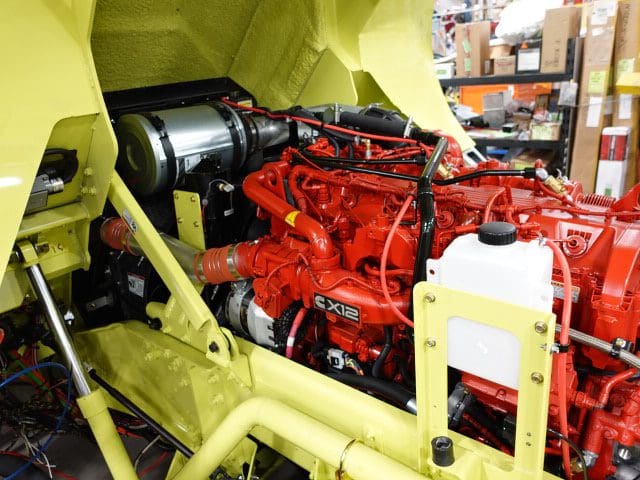

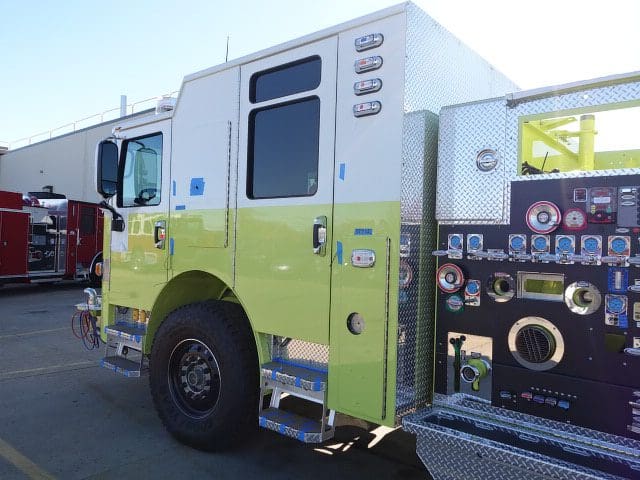

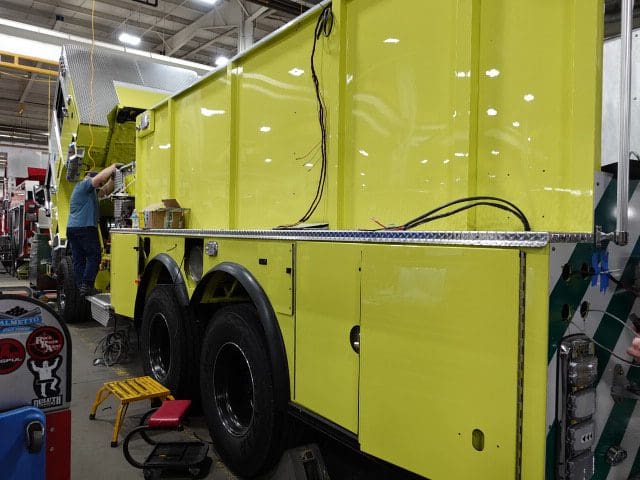

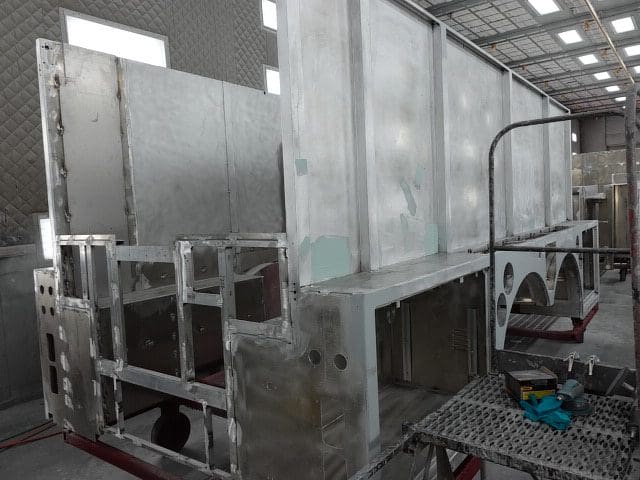

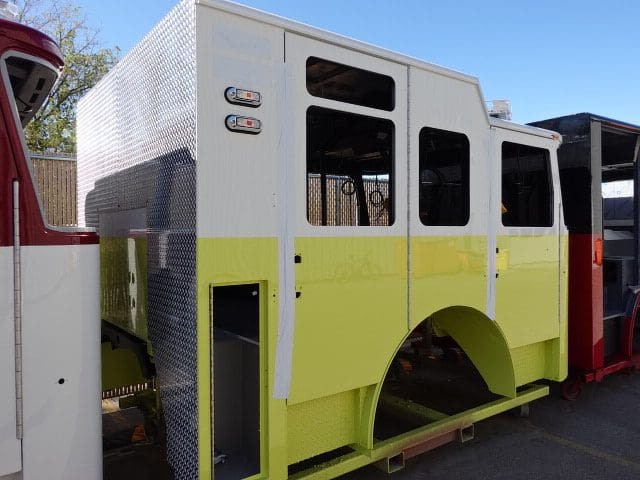

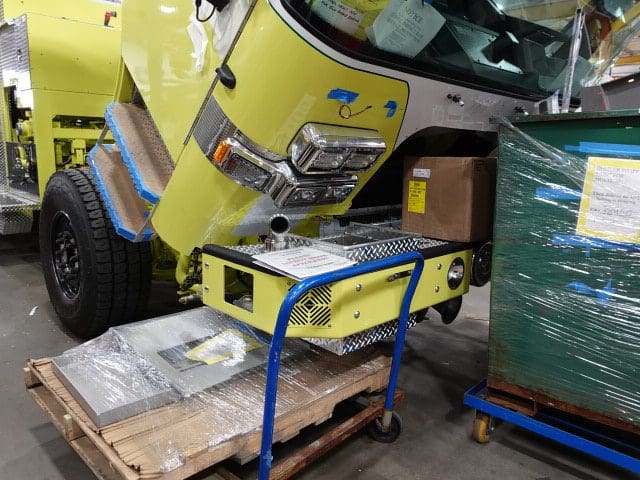

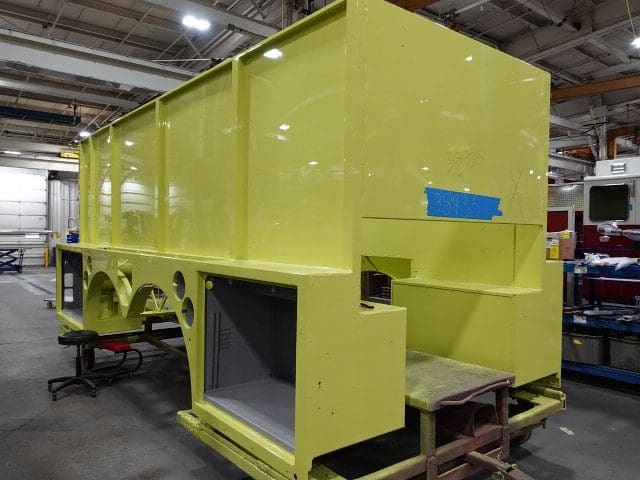

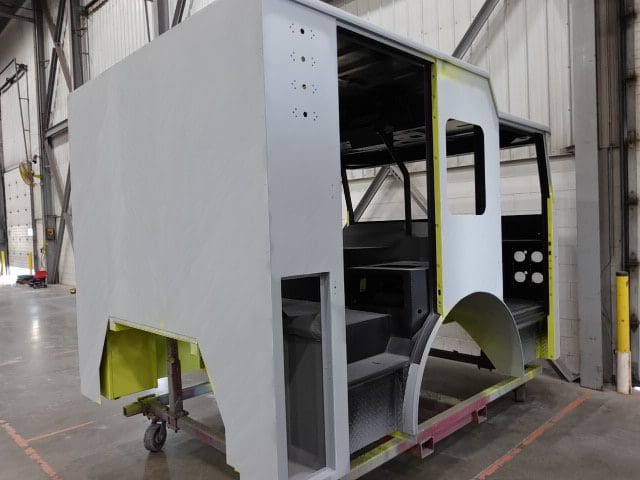

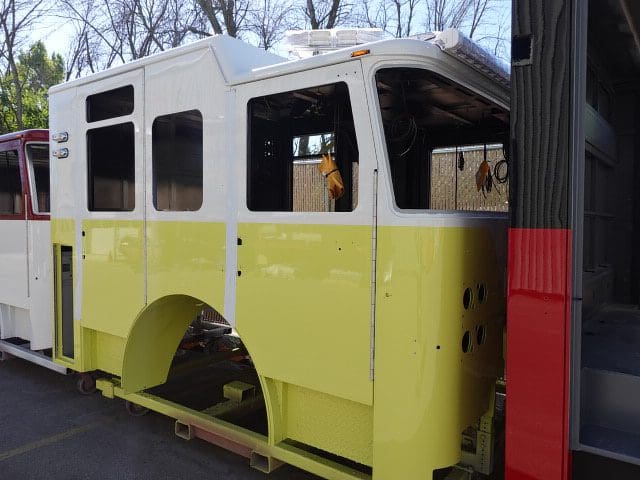

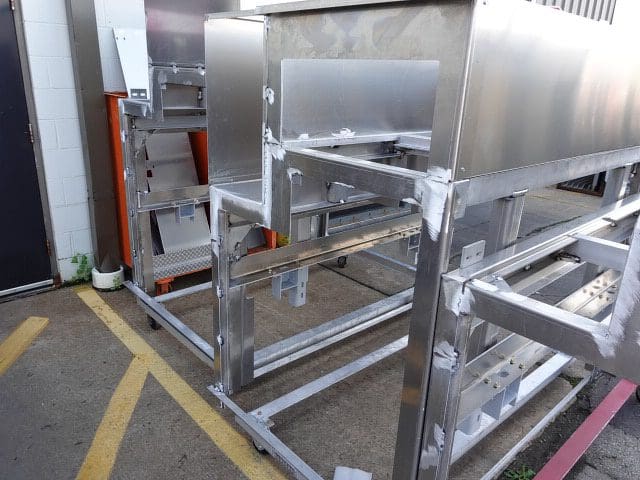

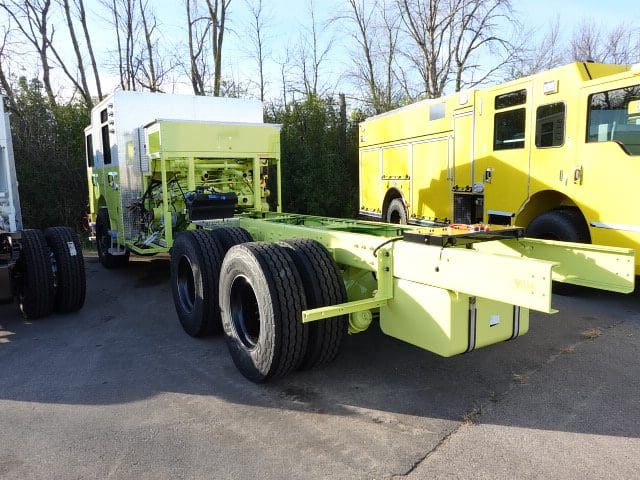

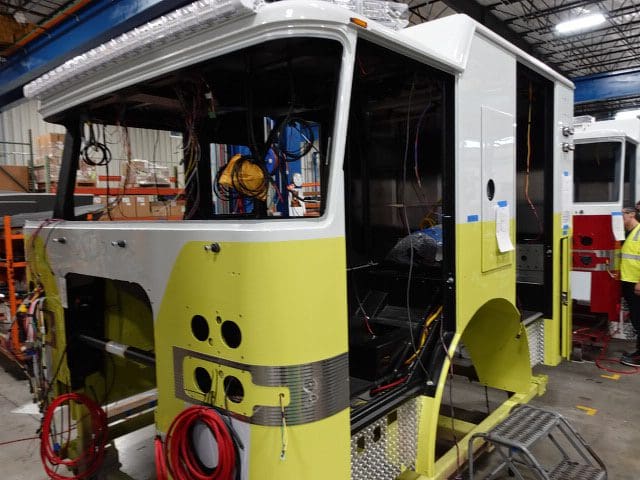

In this report, the cab continued initial assembly, the frame build continued, the pump house was painted then continued initial assembly, and the body completed paint and began initial assembly.
10-04-24

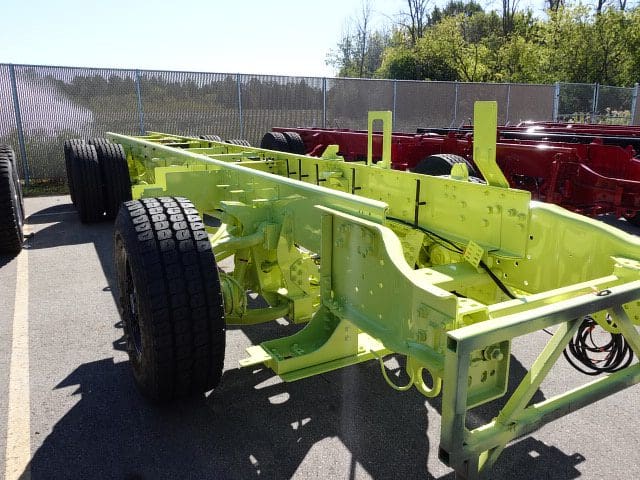

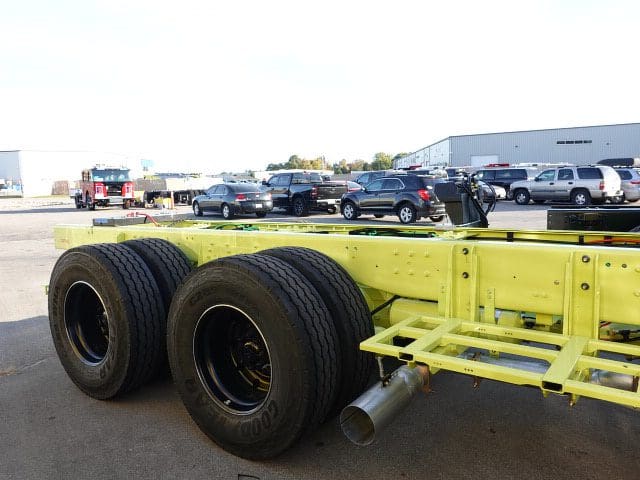

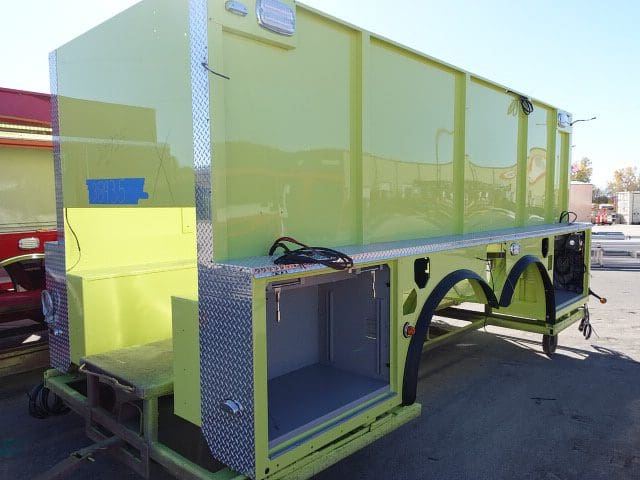

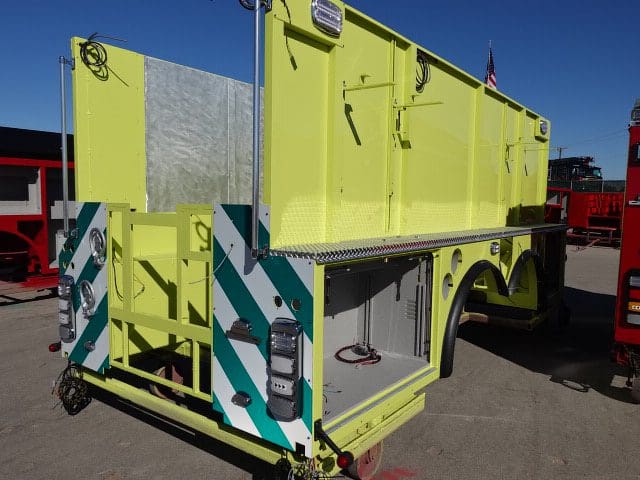

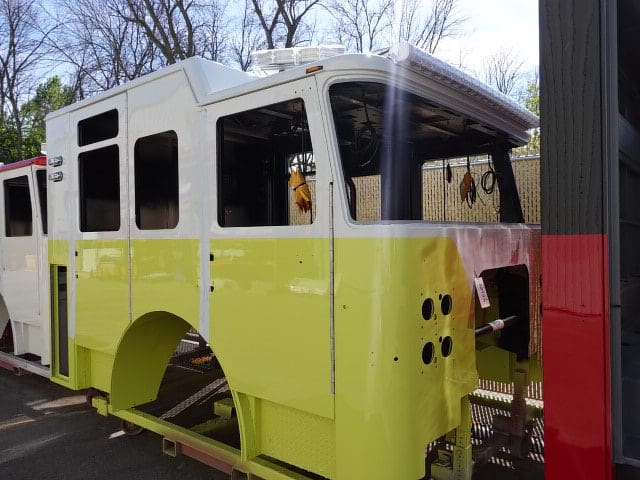

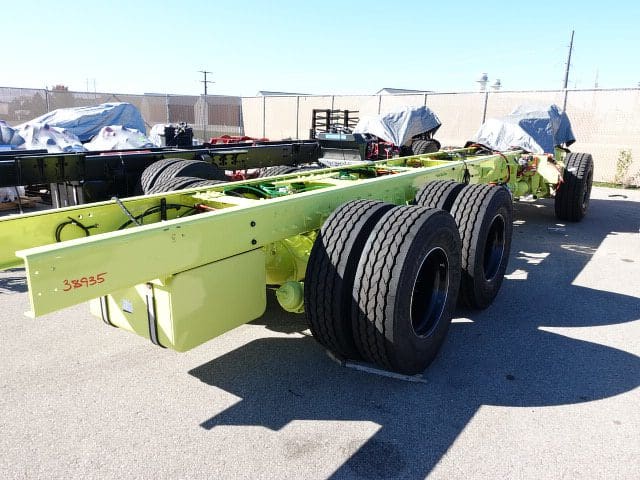

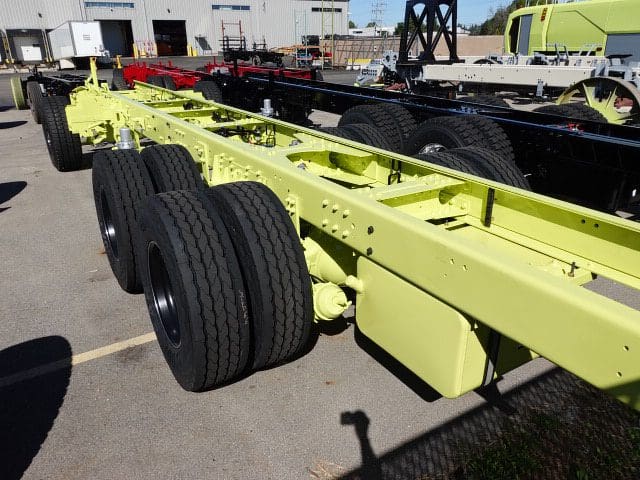

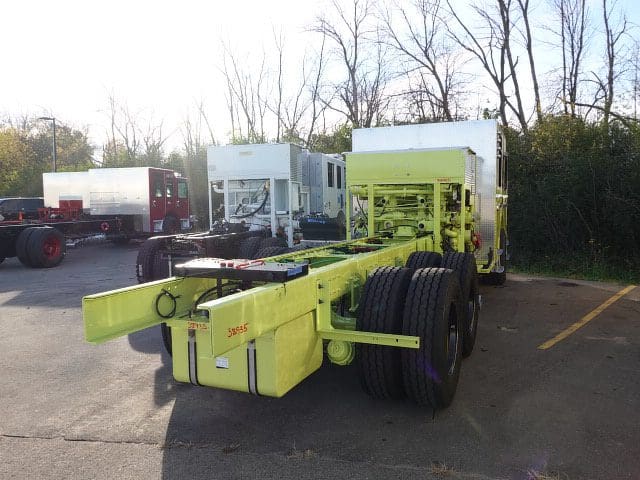

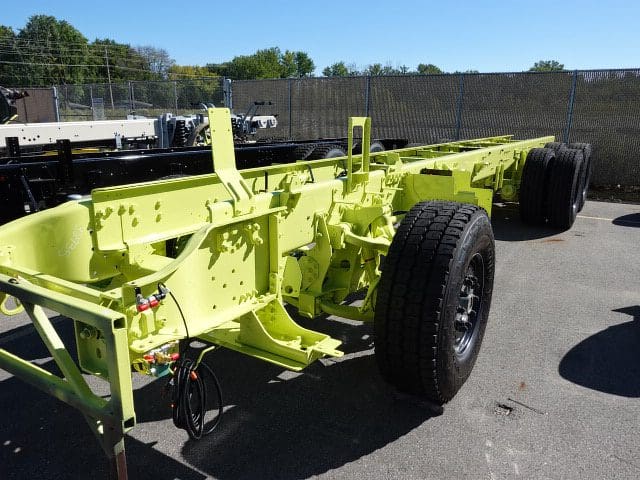

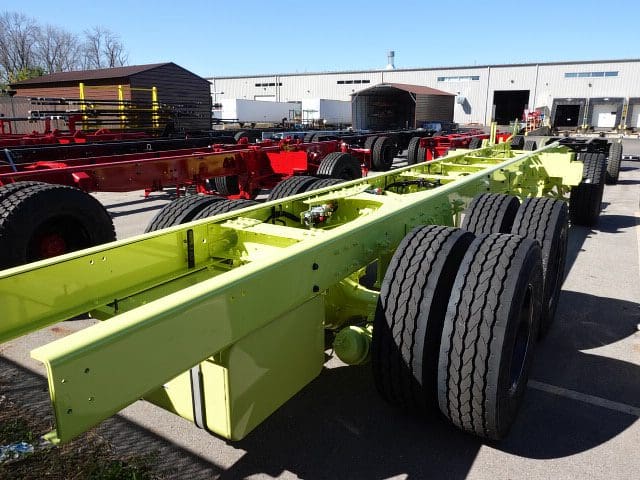

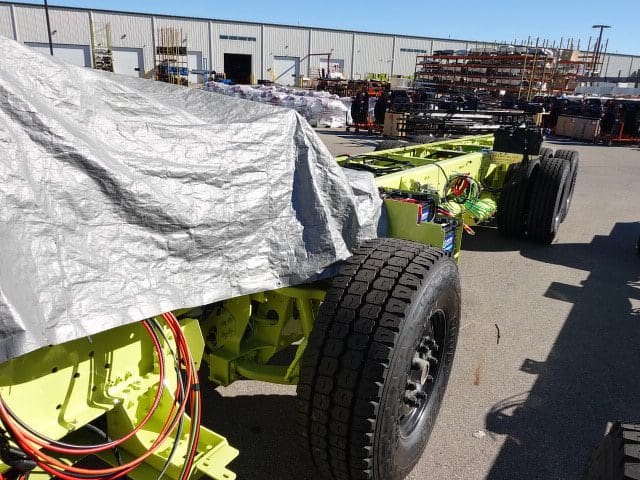

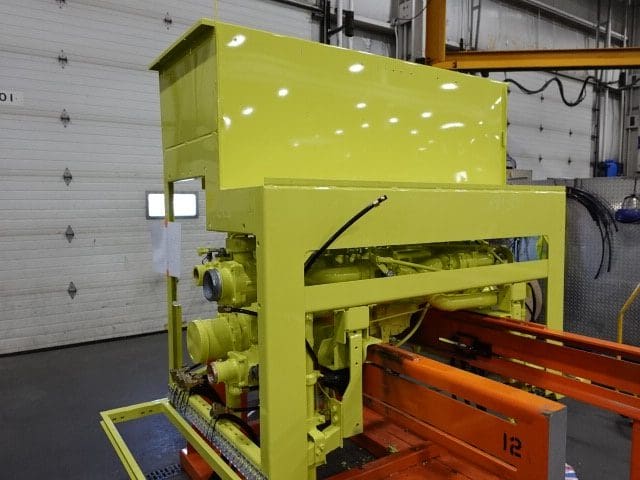

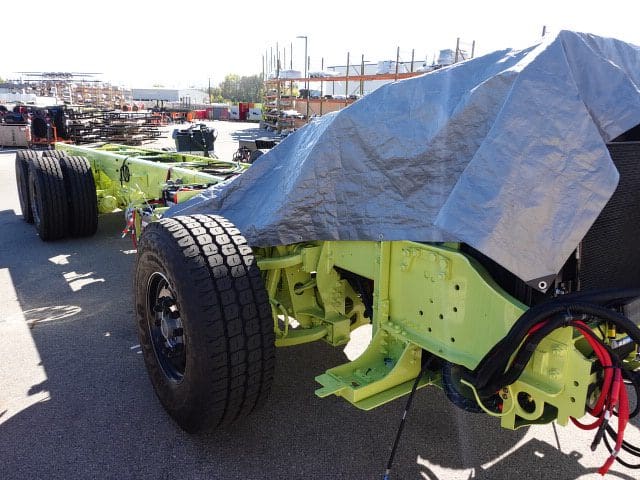

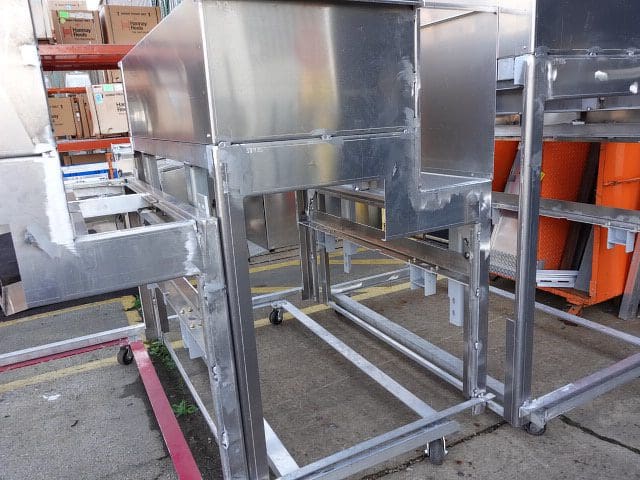

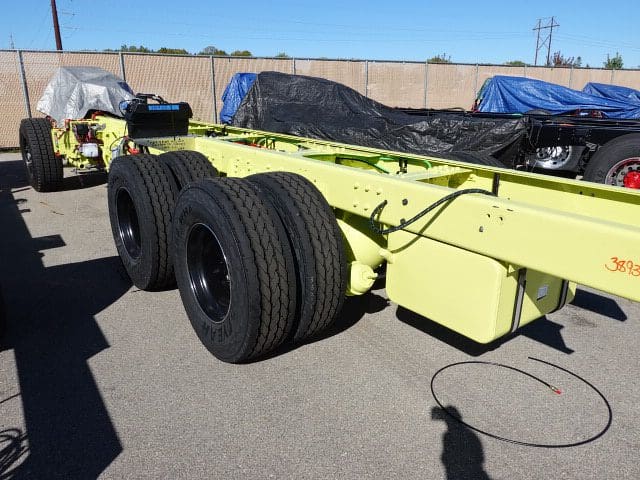

In this report, the cab was staged to continue initial assembly, the frame build began, the pump house began initial assembly, and the body was fabricated and began the paint process.

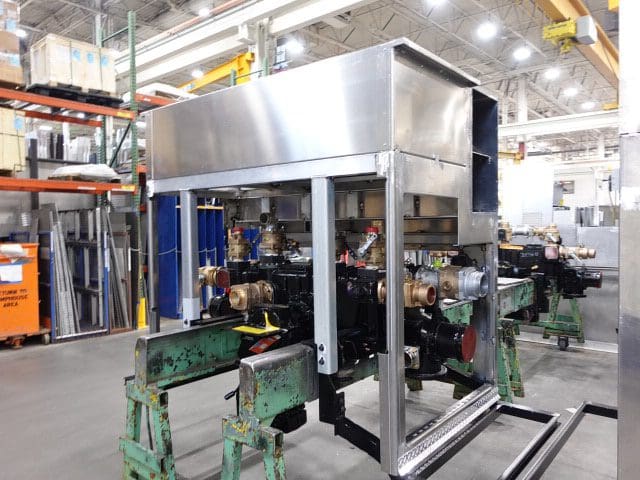

09-27-24

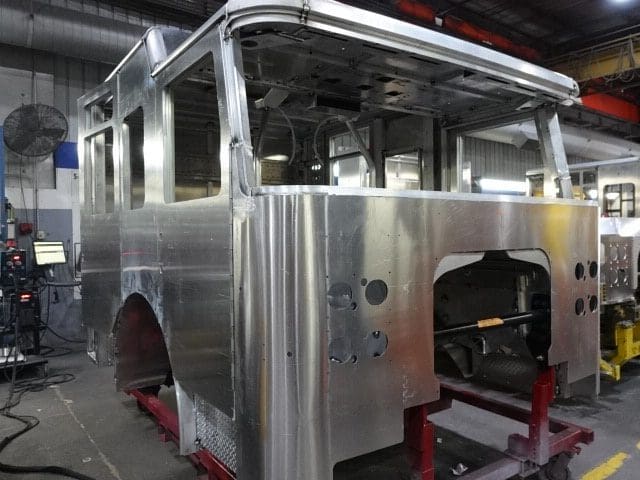

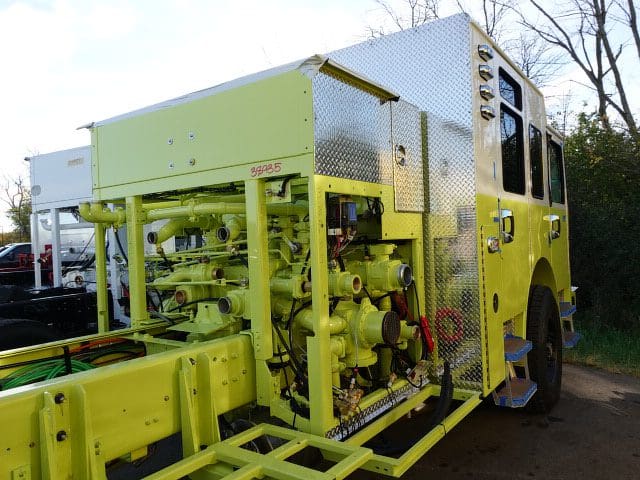

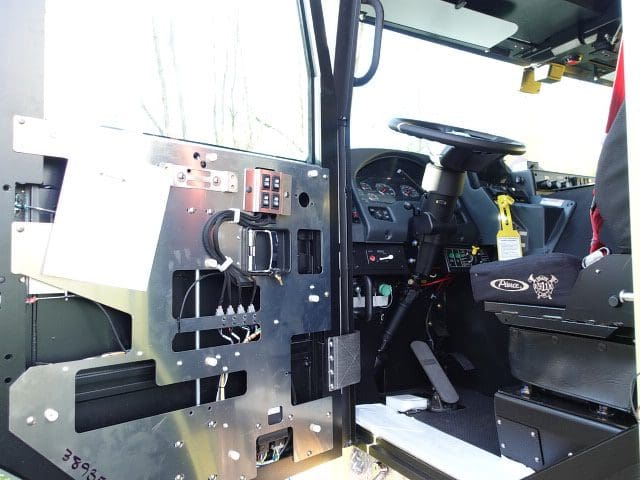

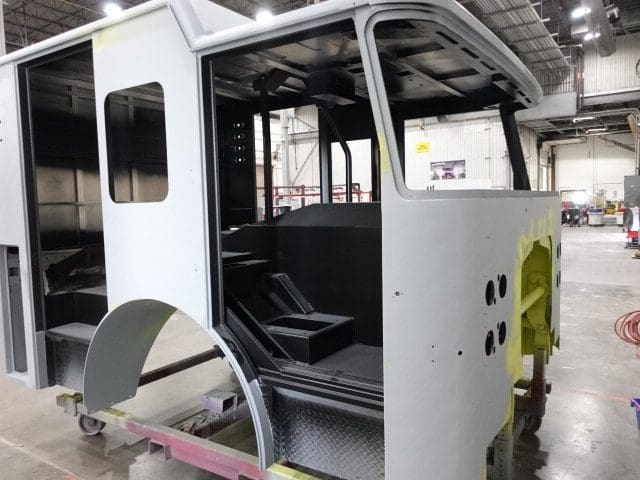

In this report, the cab completed paint and began initial assembly while the pump house structure was fabricated.
