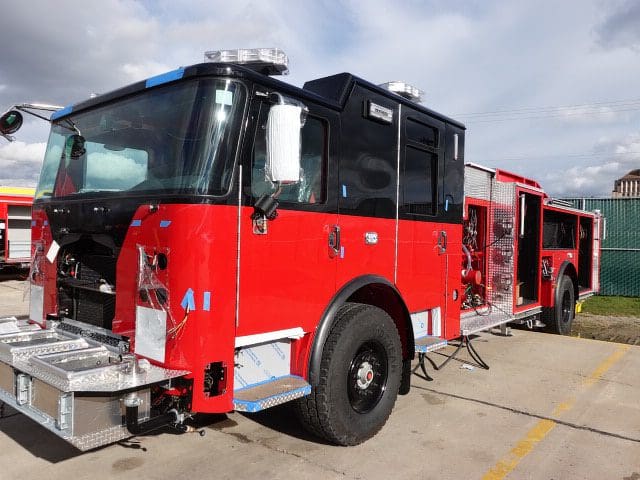

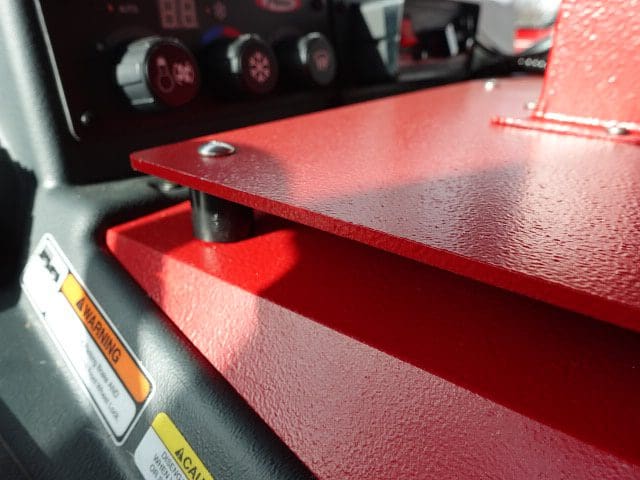

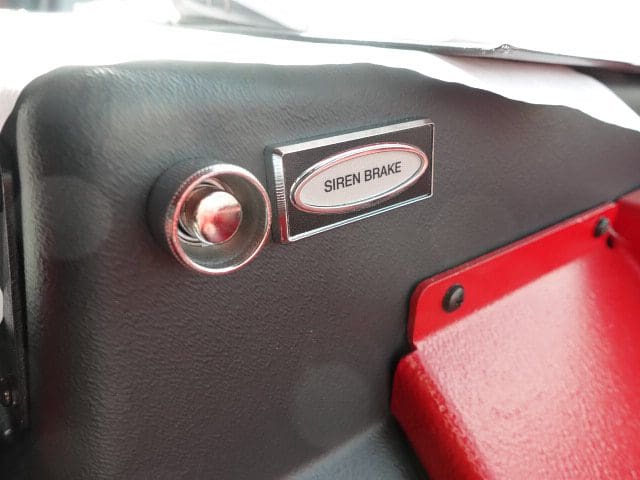

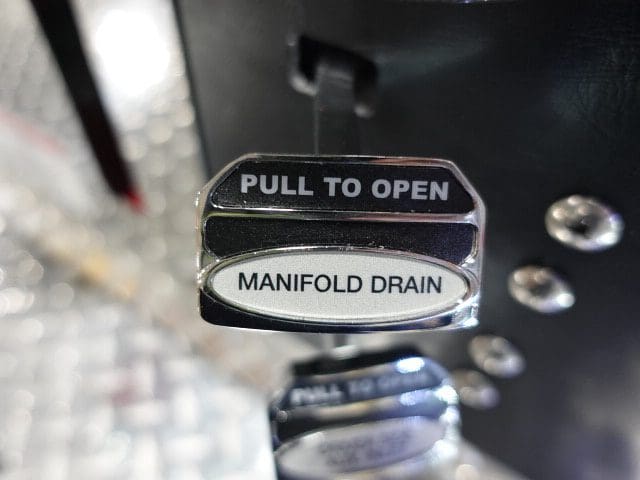

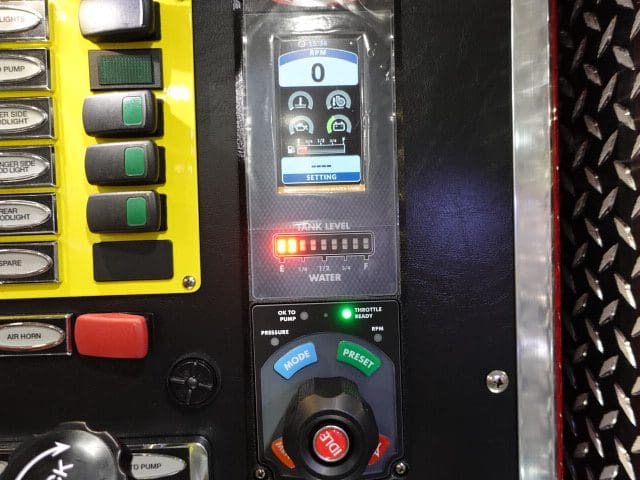

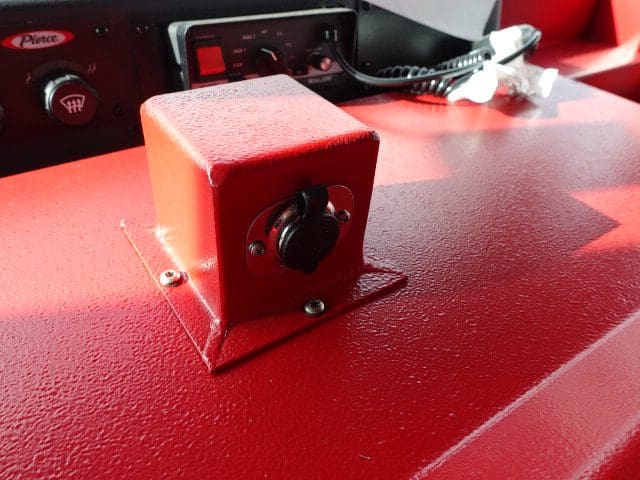

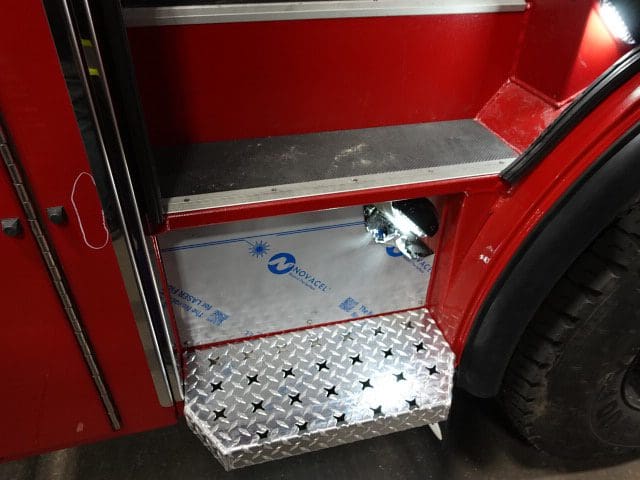

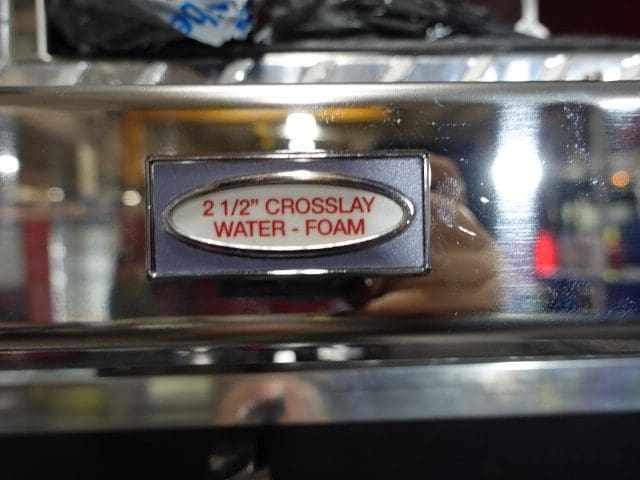

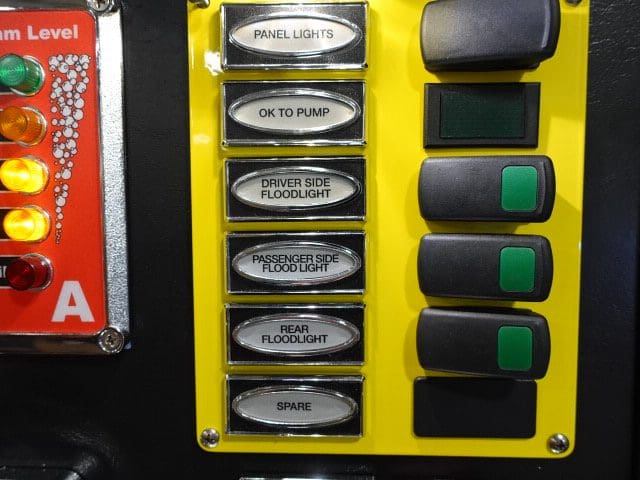

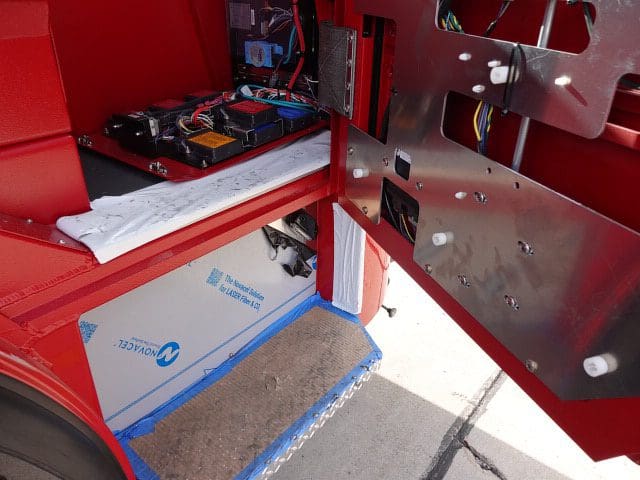

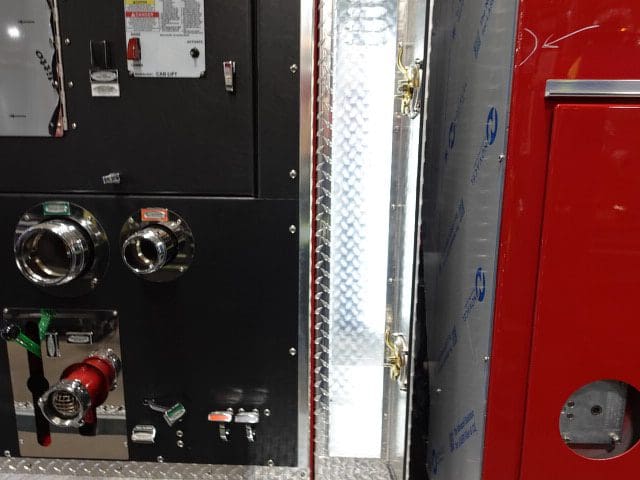

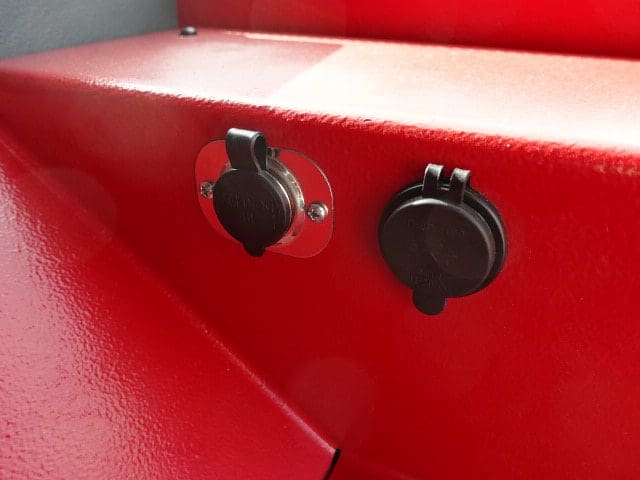

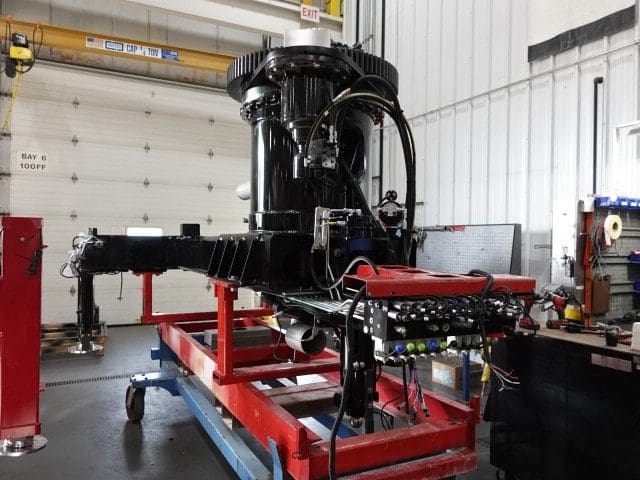

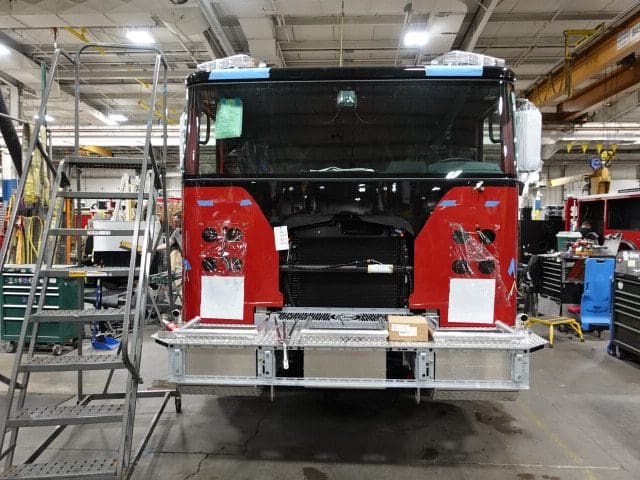

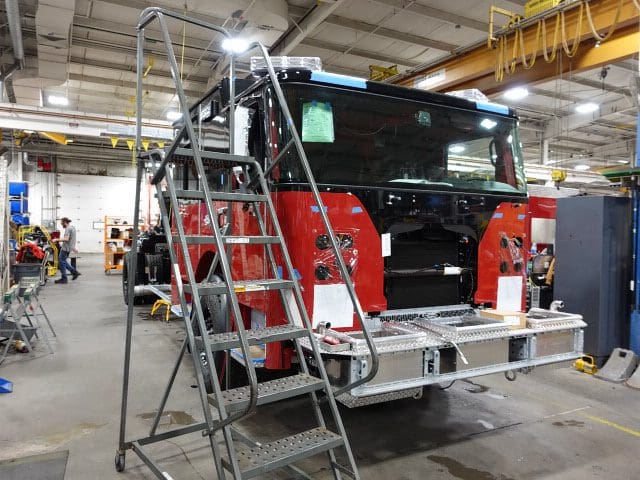

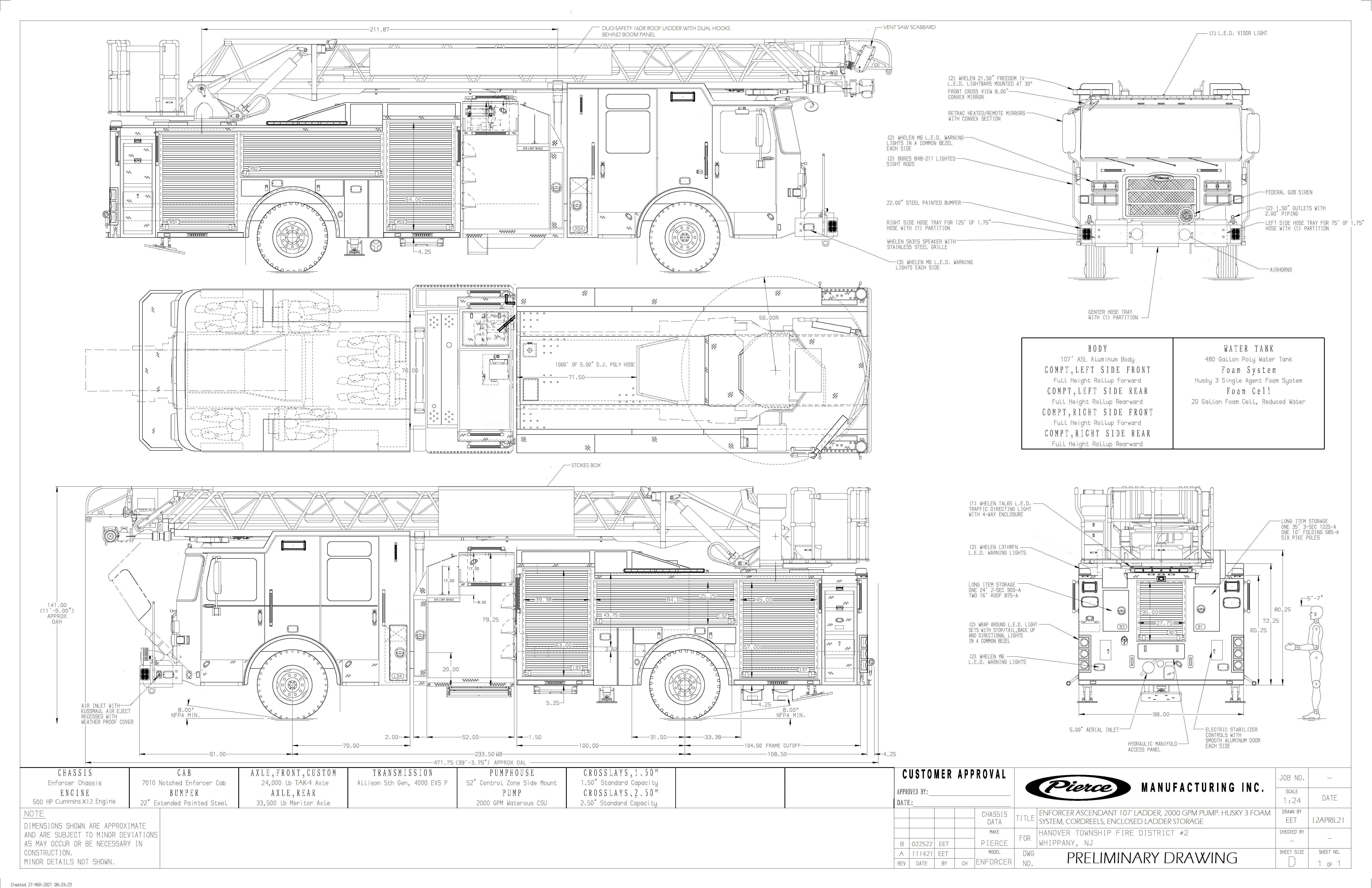

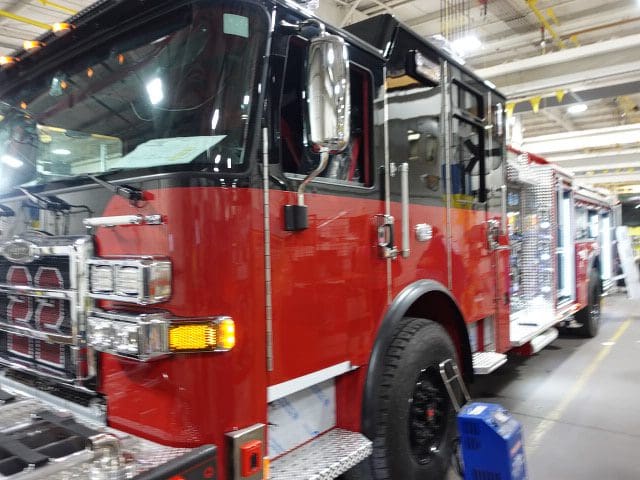

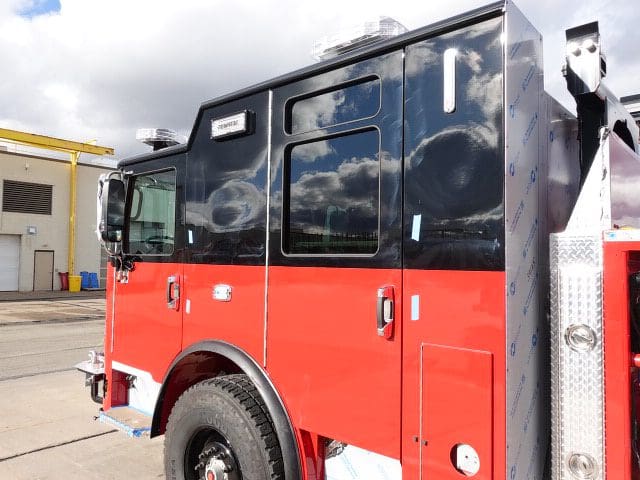

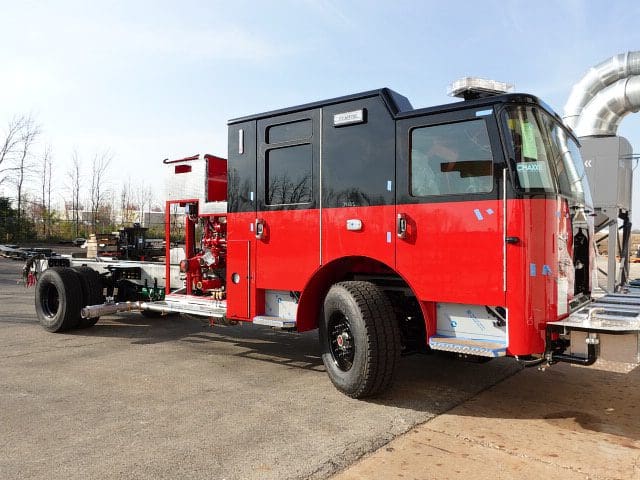

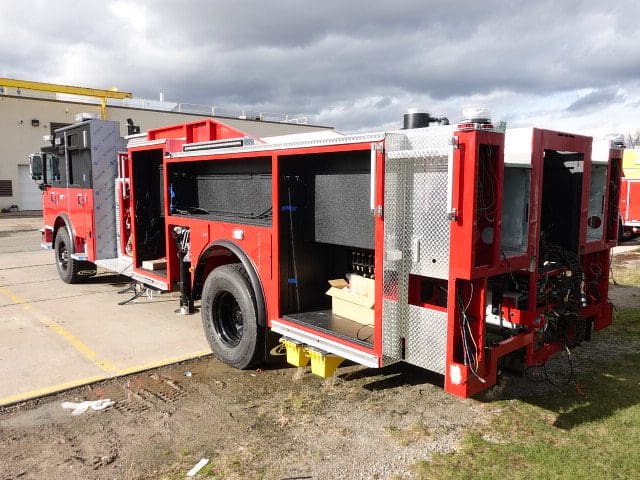

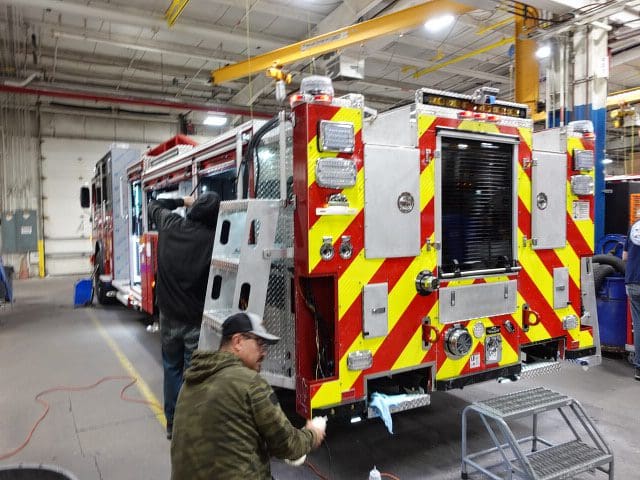

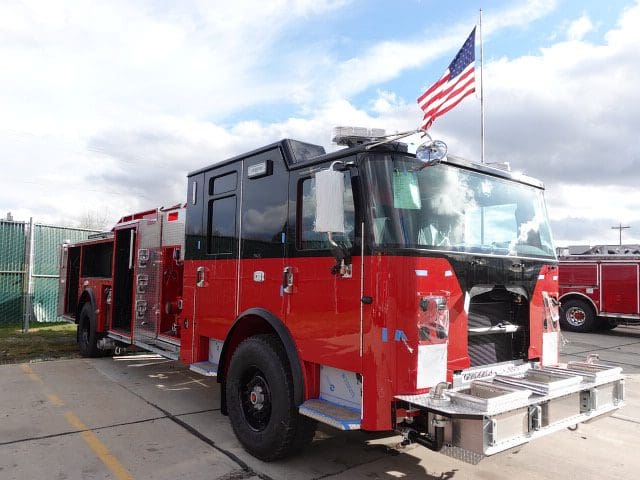

01-10-25

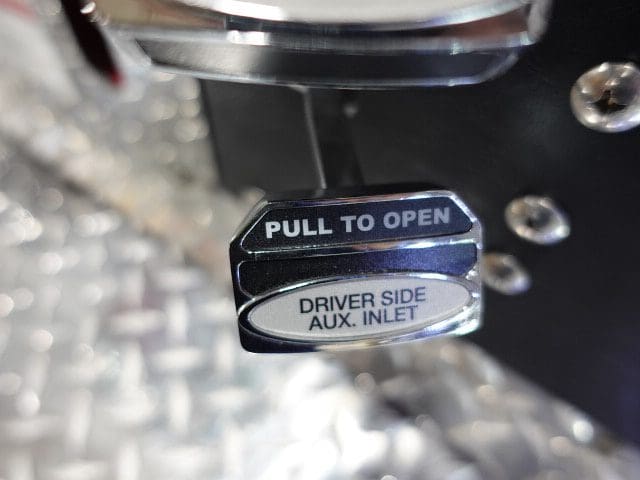

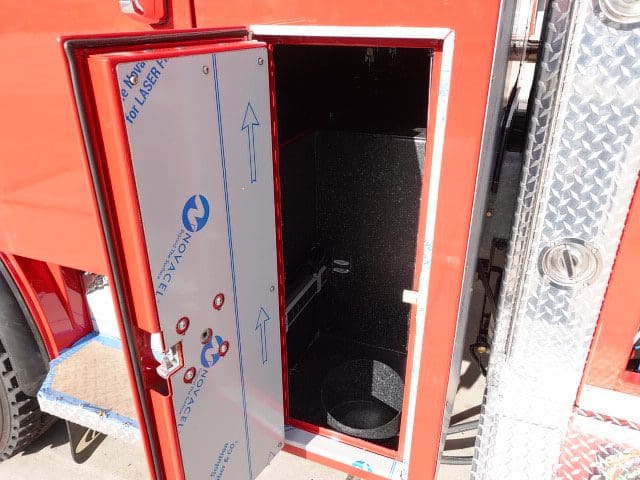

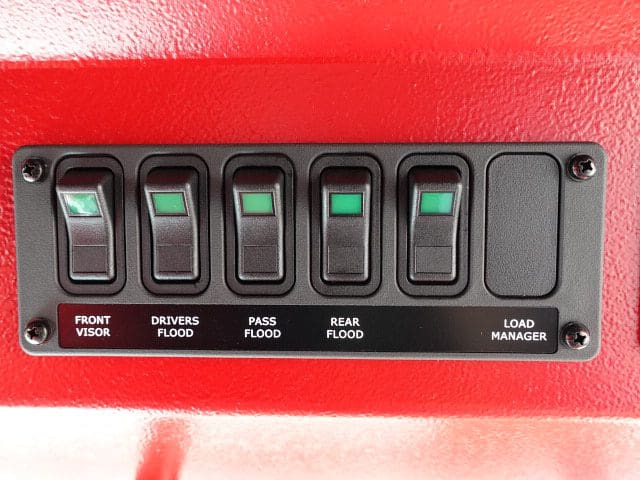

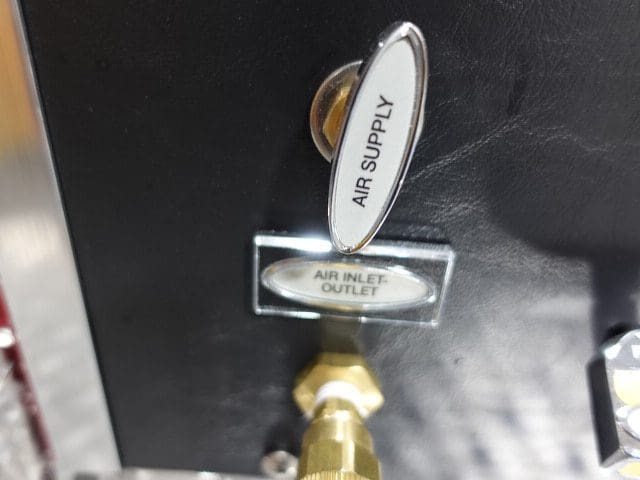

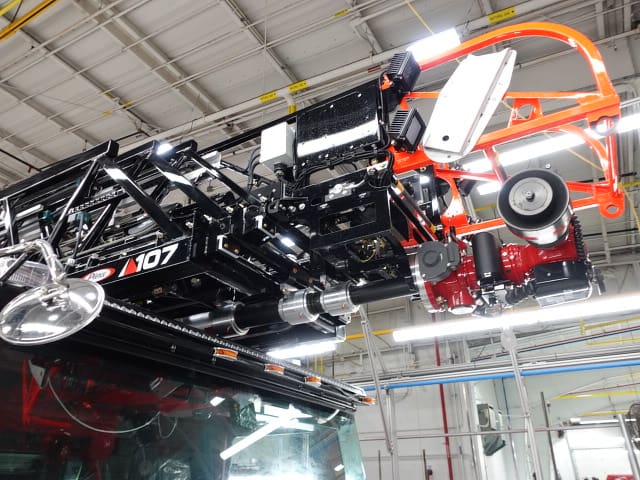

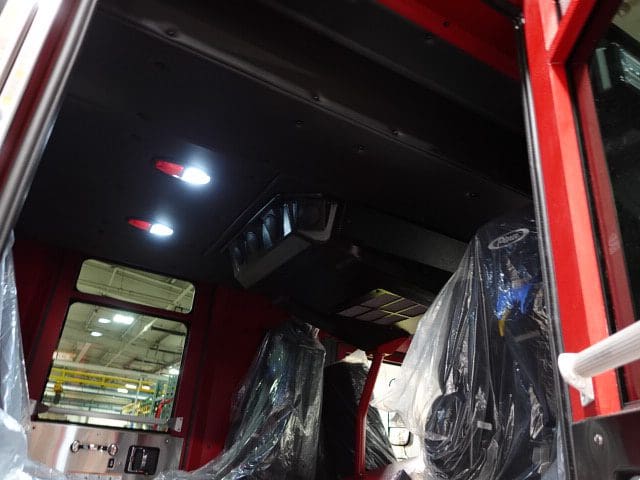

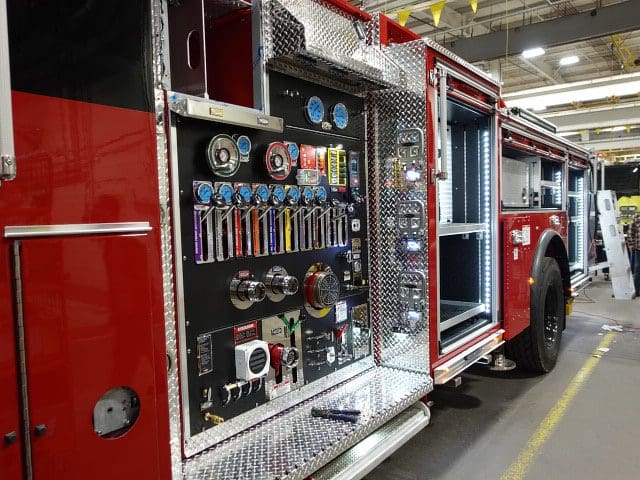

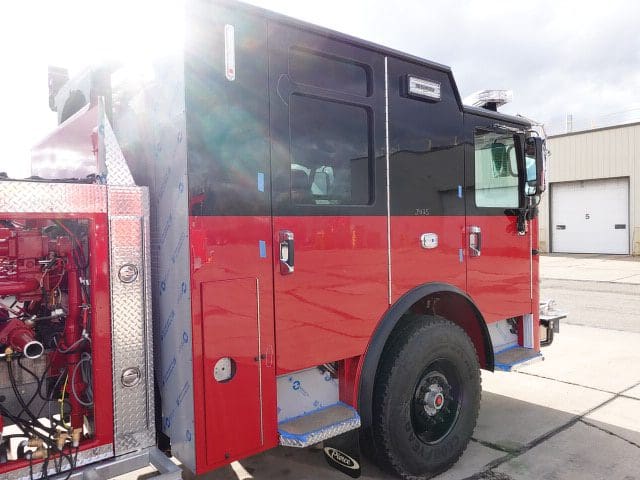

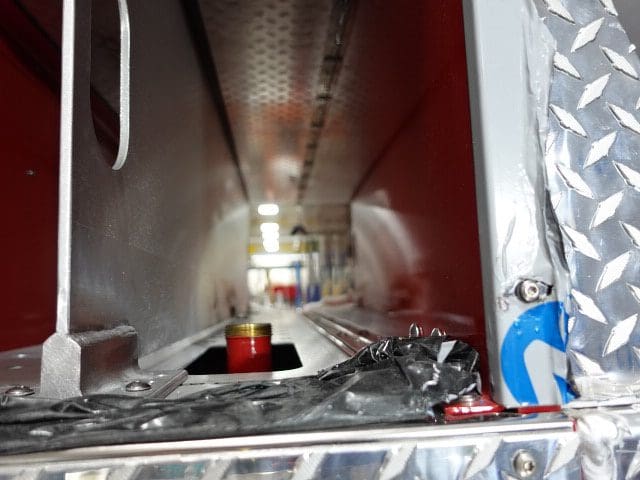

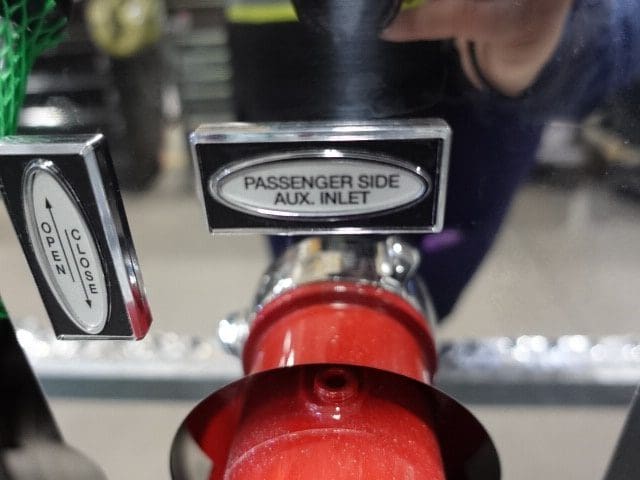

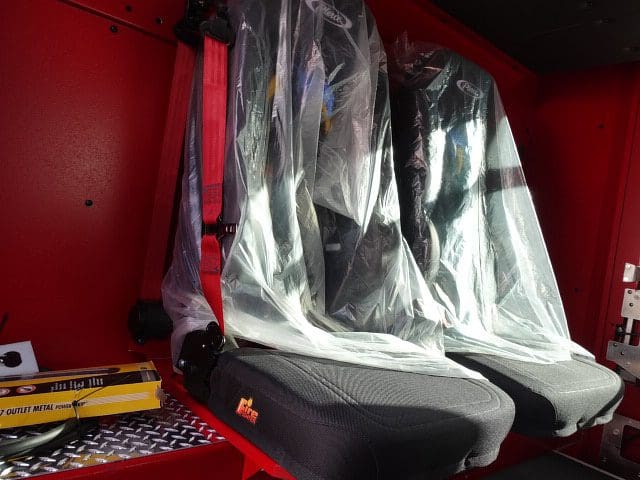

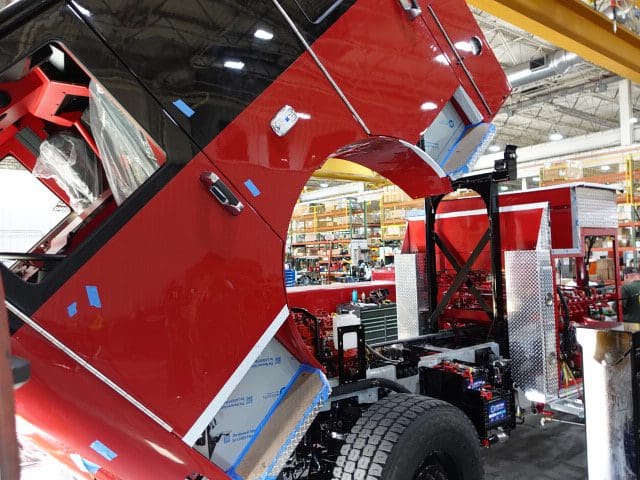

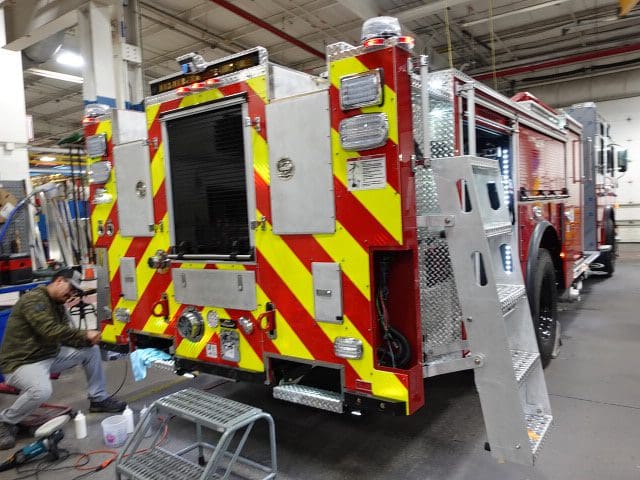

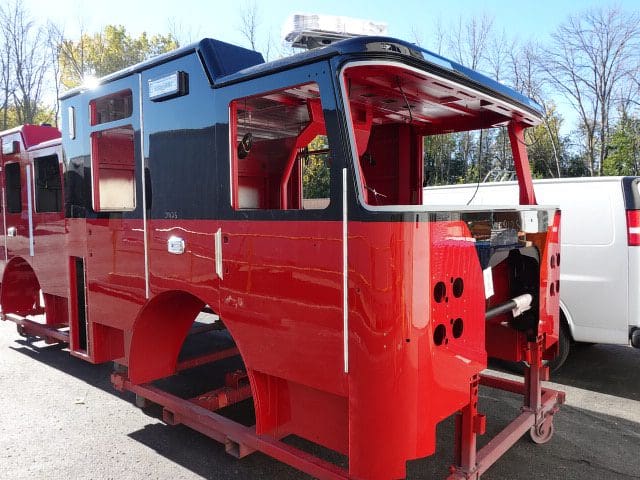

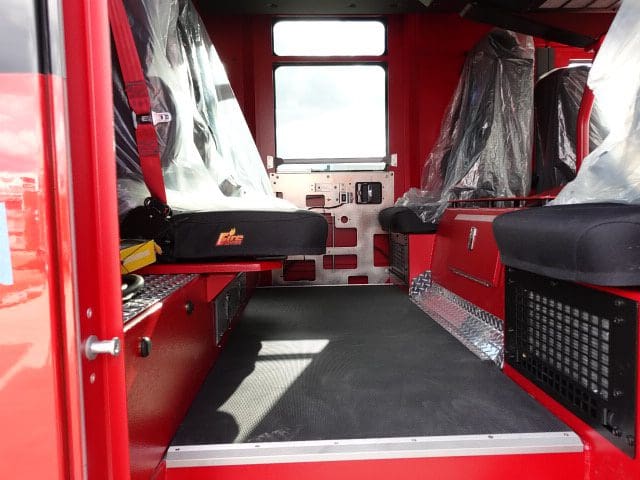

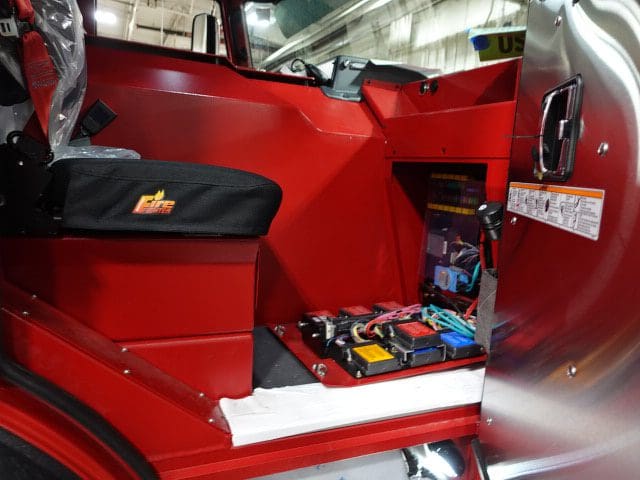

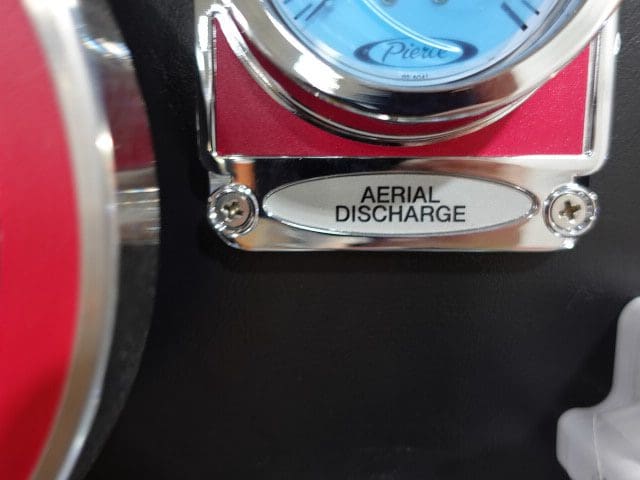

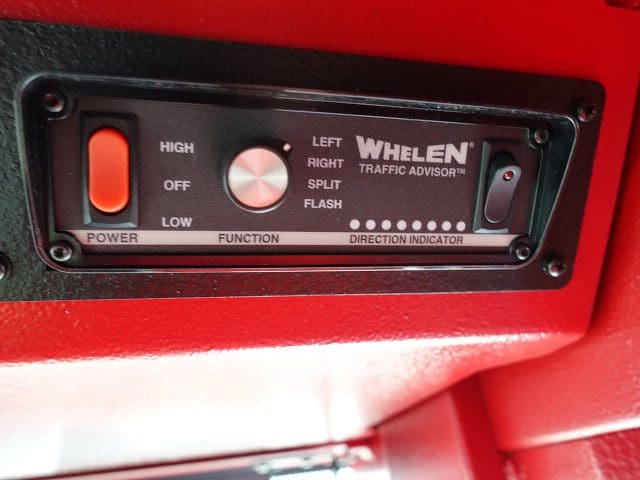

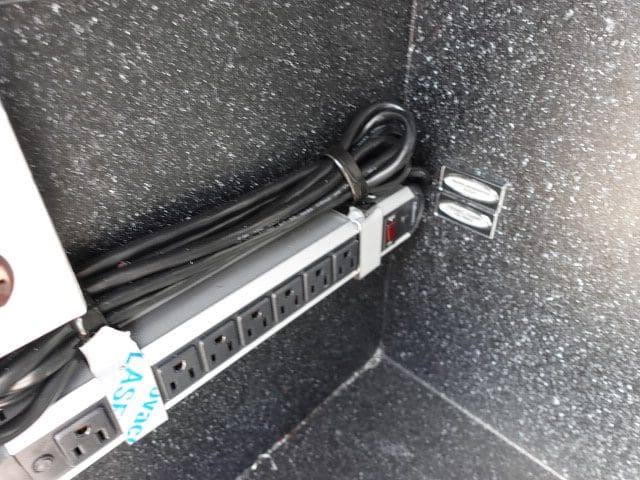

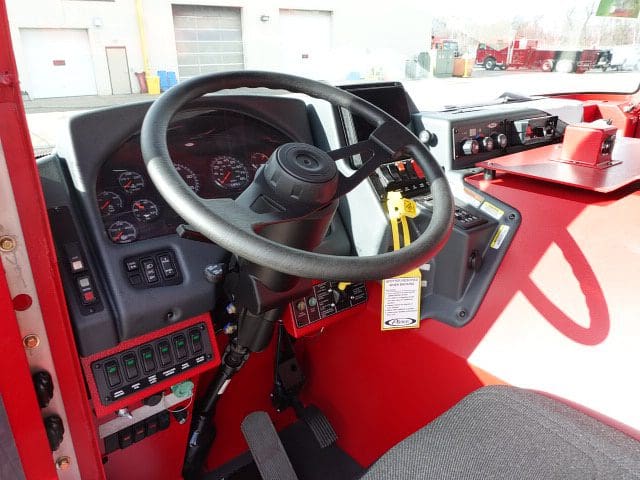

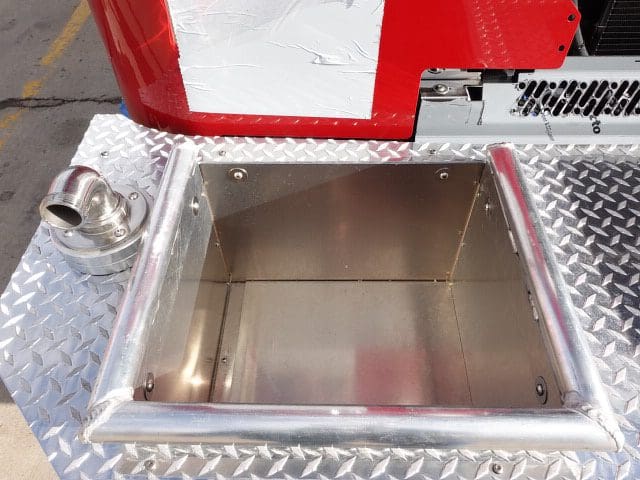

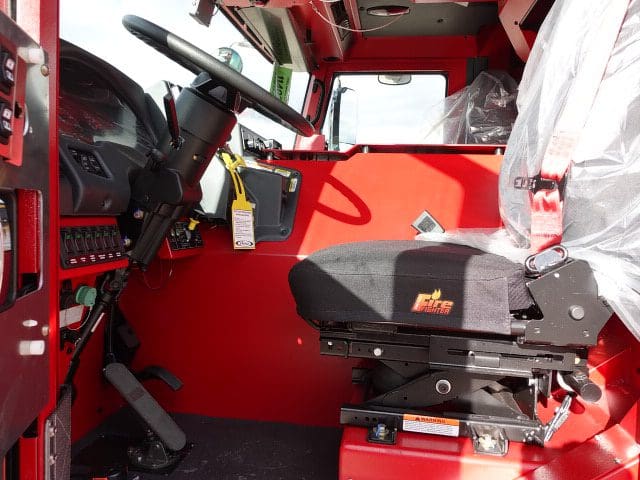

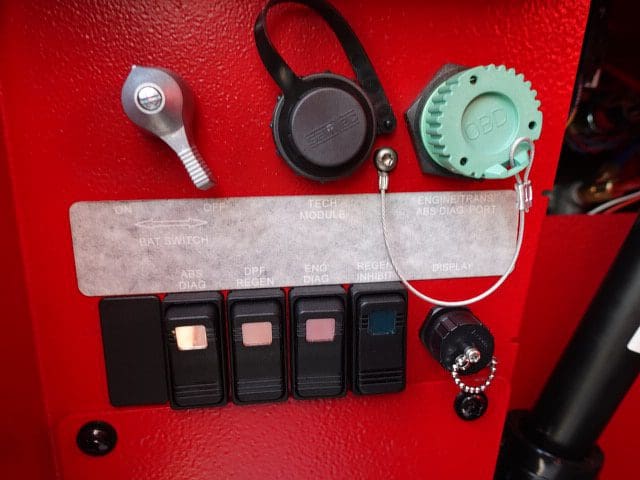

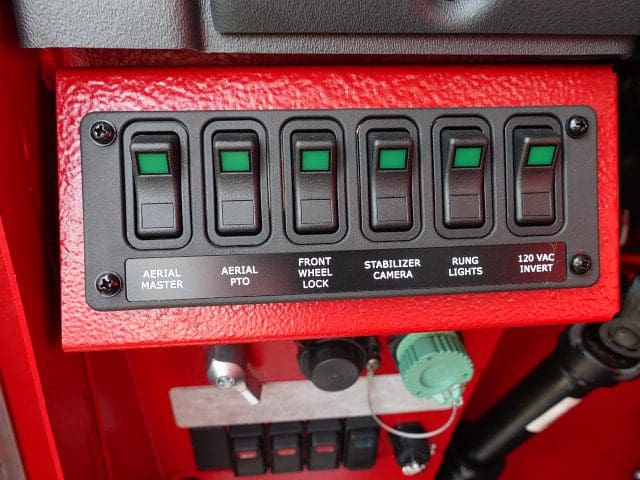

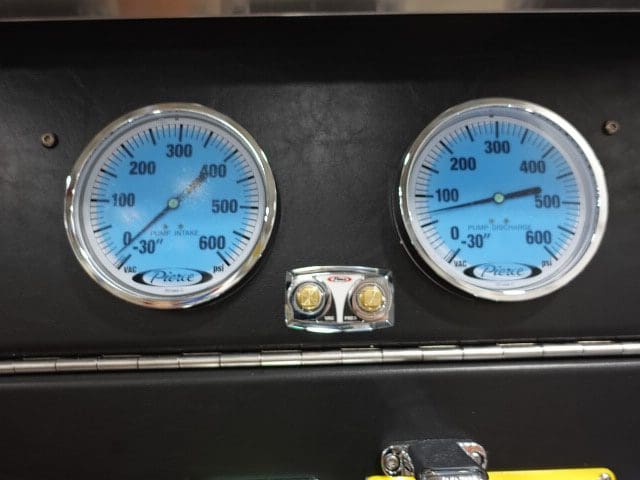

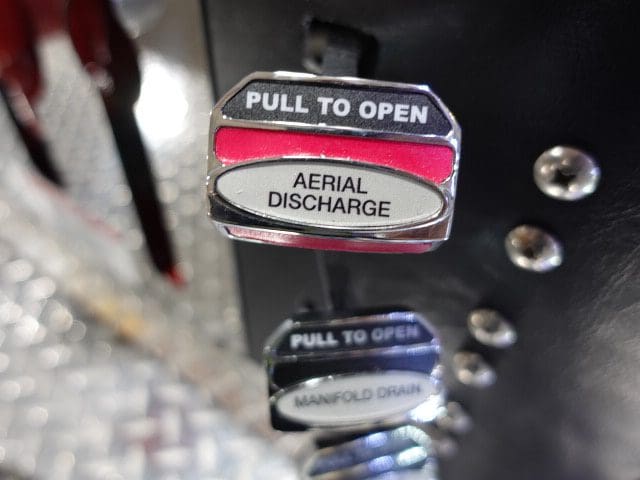

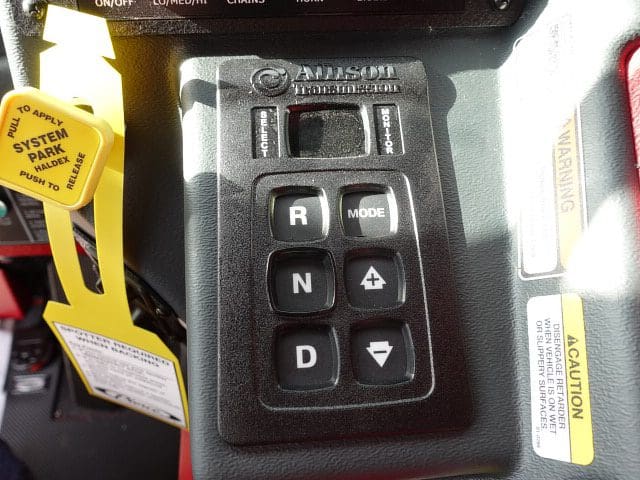

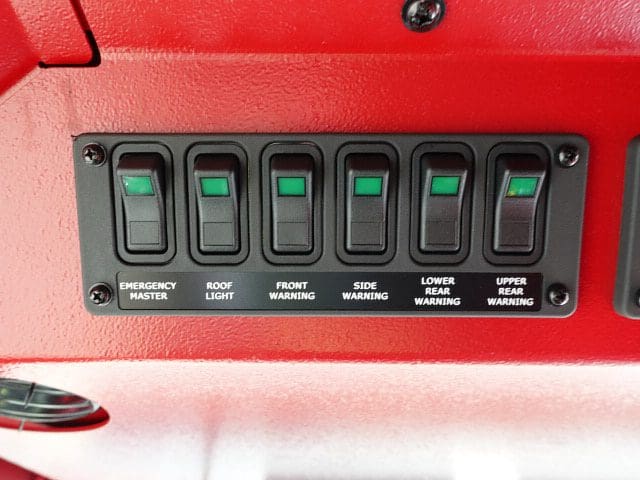

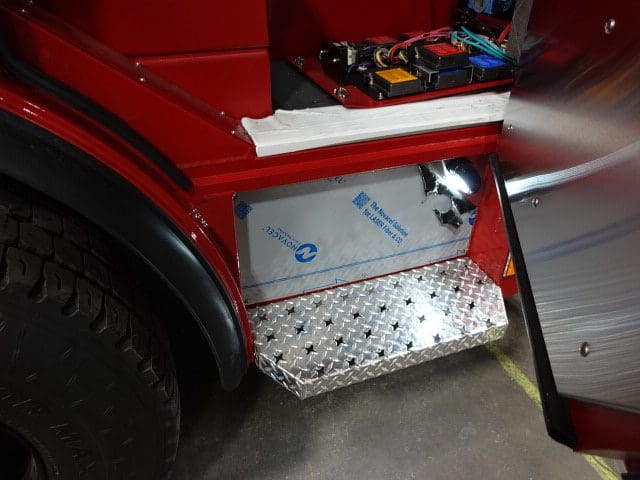

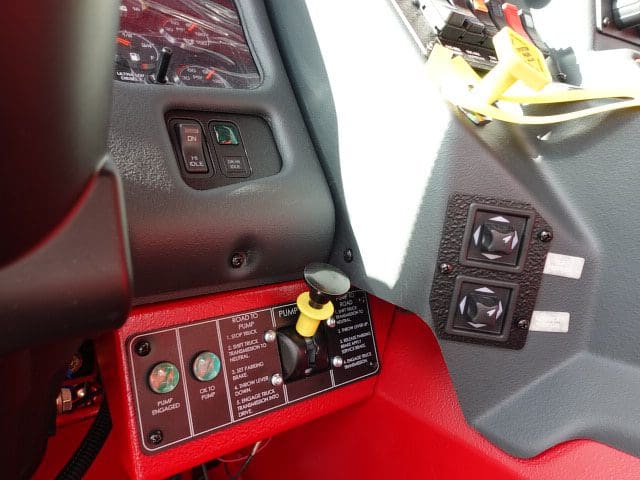

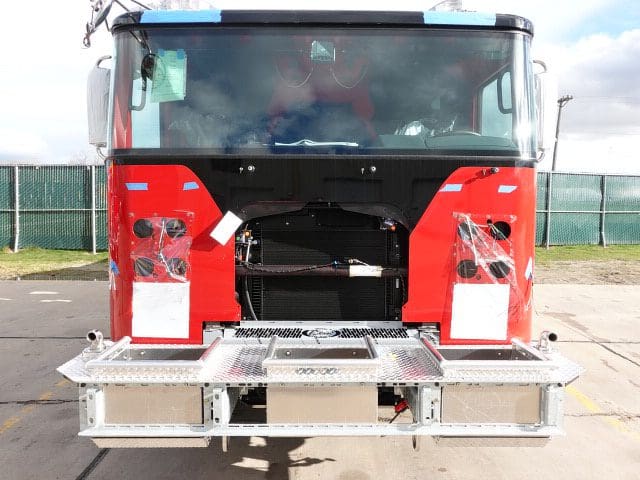

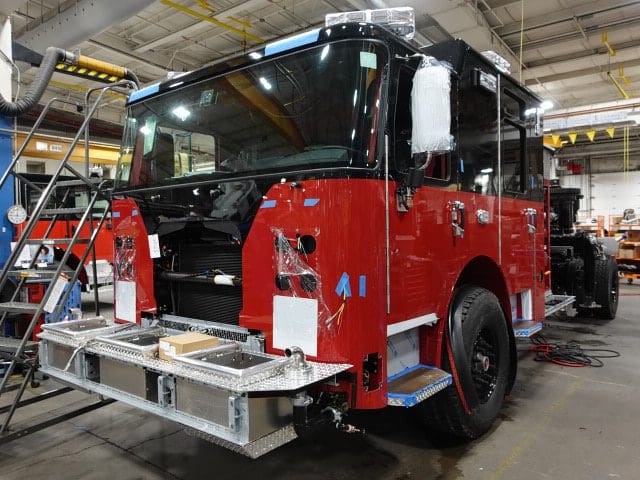

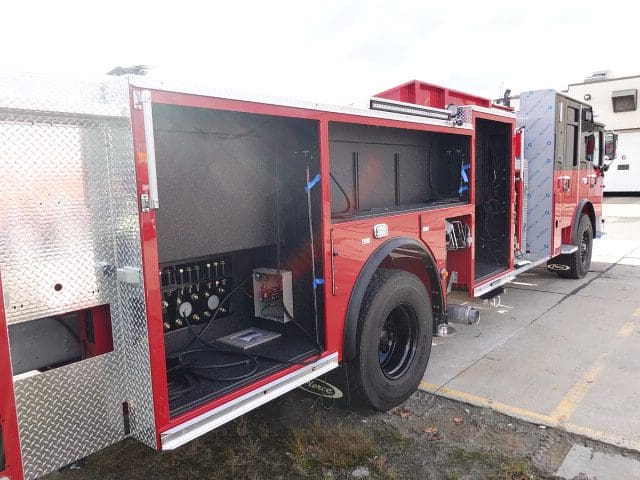

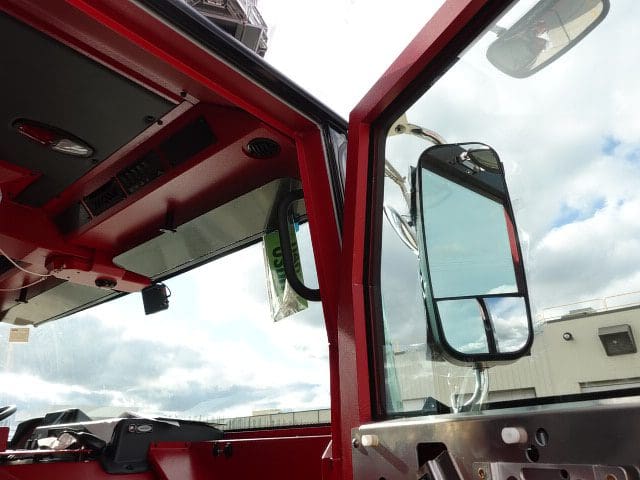

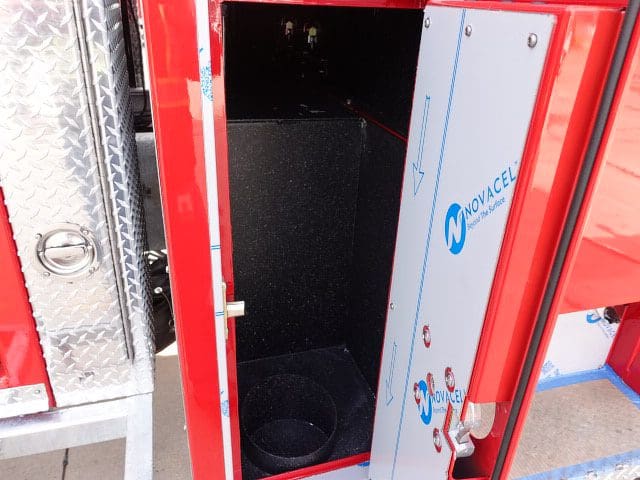

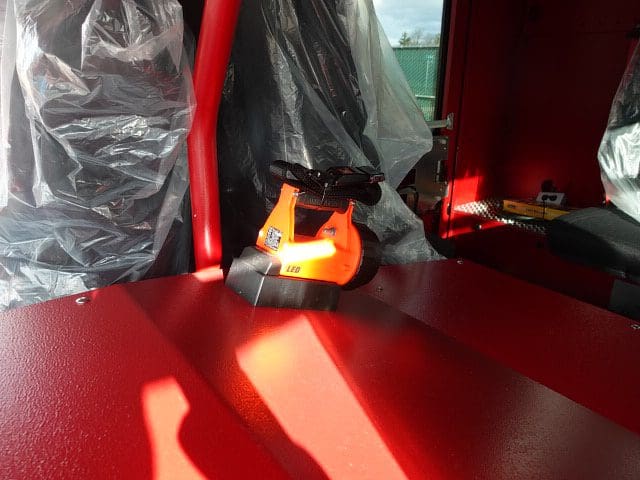

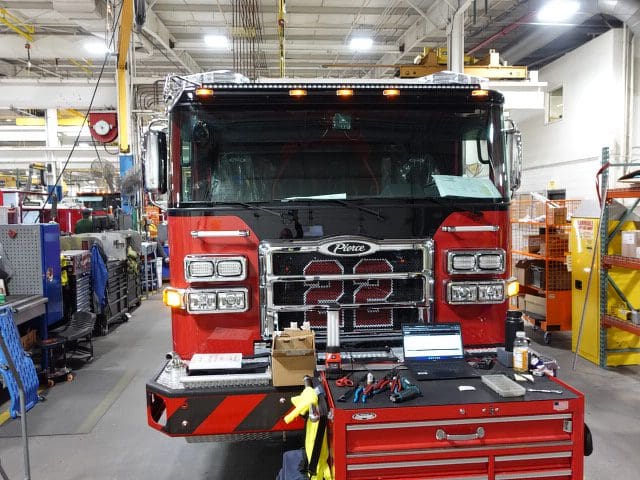

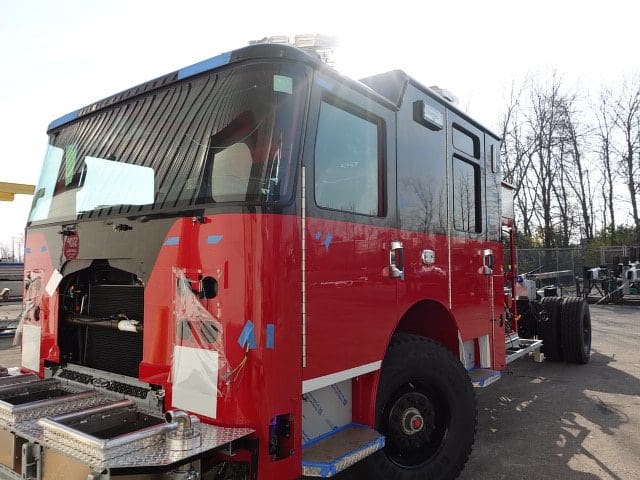

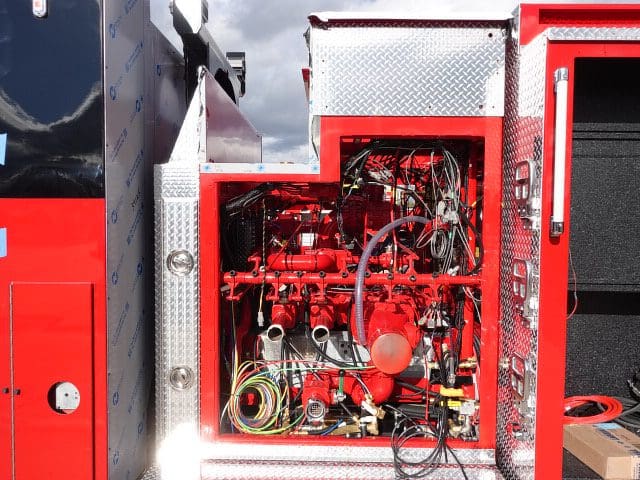

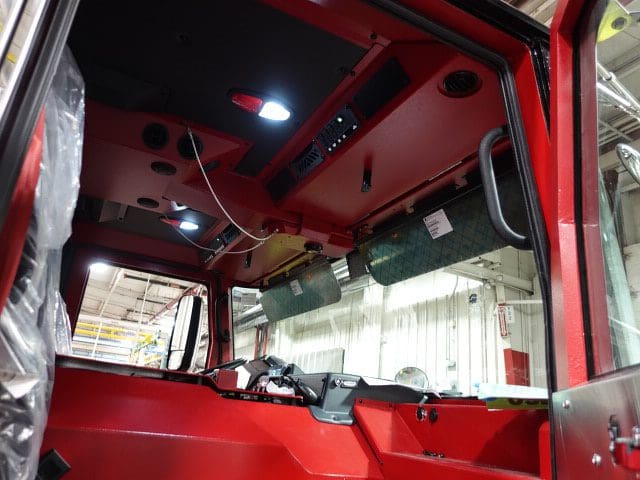

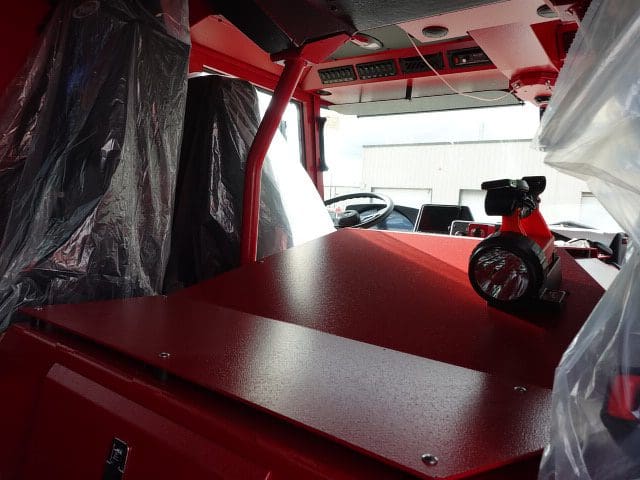

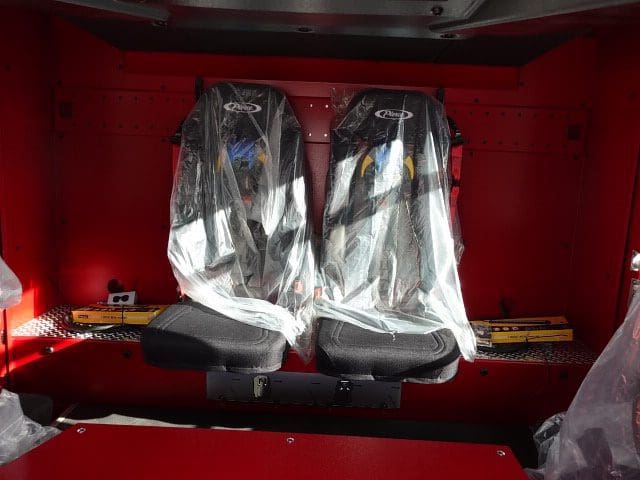

In this report, the aerial device completed initial assembly and was pinned to the apparatus followed by the completion of the aerial test. The apparatus was then released to quality and graphics where any remaining content will be applied. Once finished it will be made ready for the customer acceptance inspection. This is the last scheduled report.
12-20-24

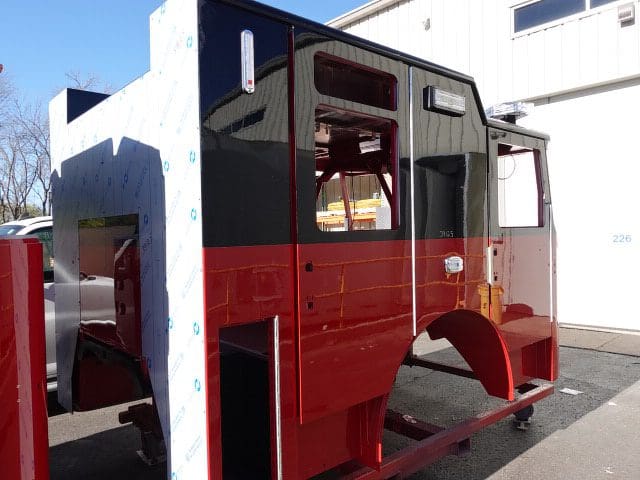

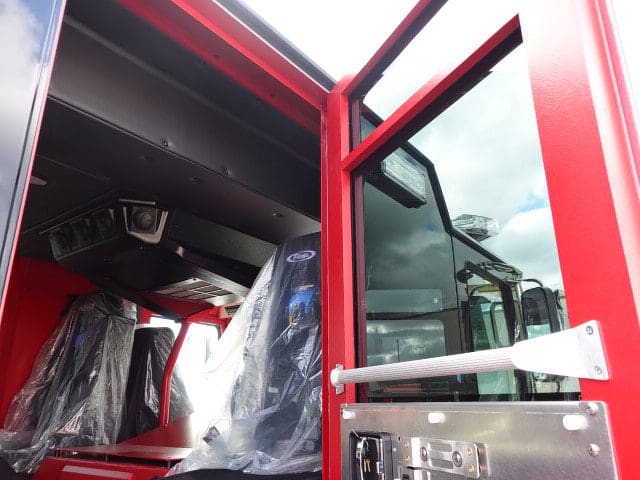

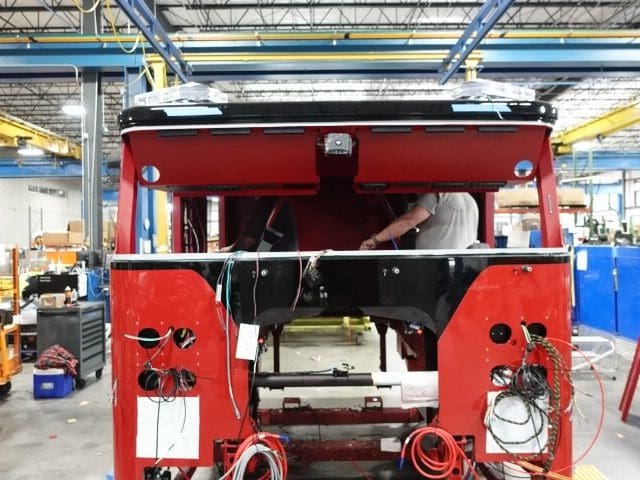

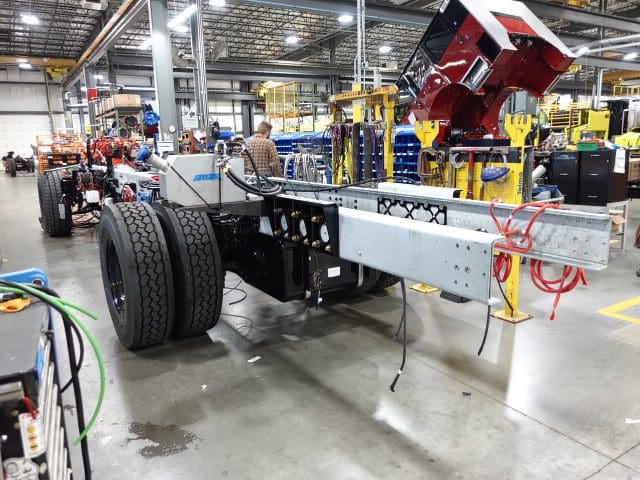

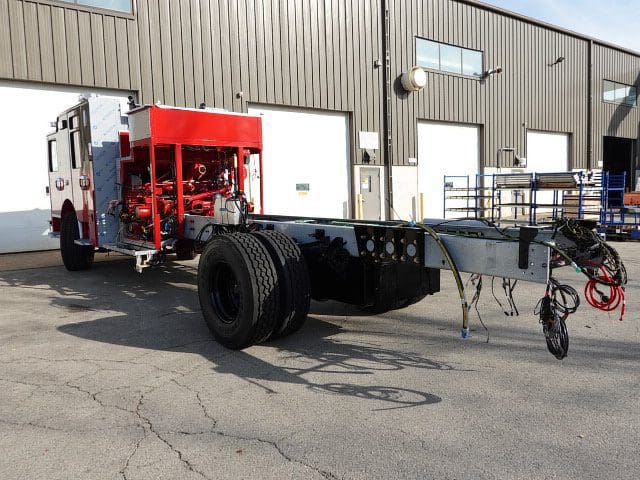

In this report, the apparatus completed final assembly while the aerial device arrived and began initial assembly.
11-22-24

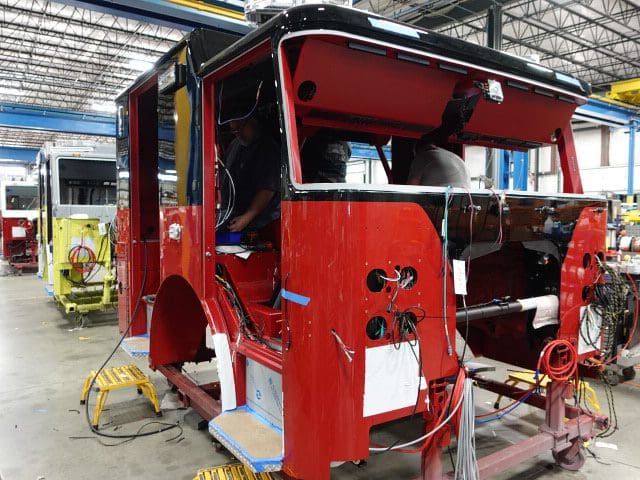

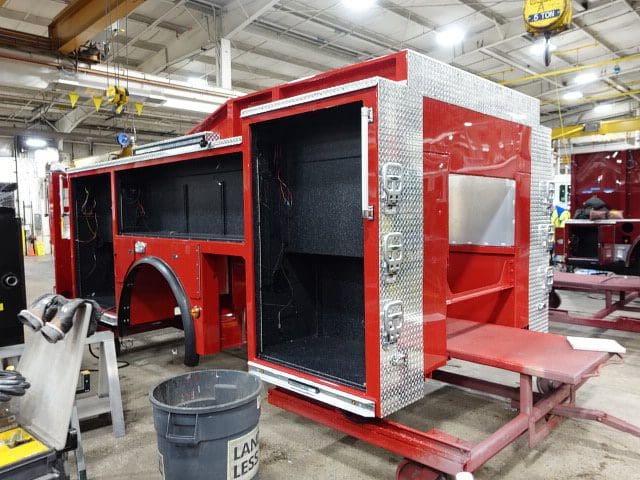

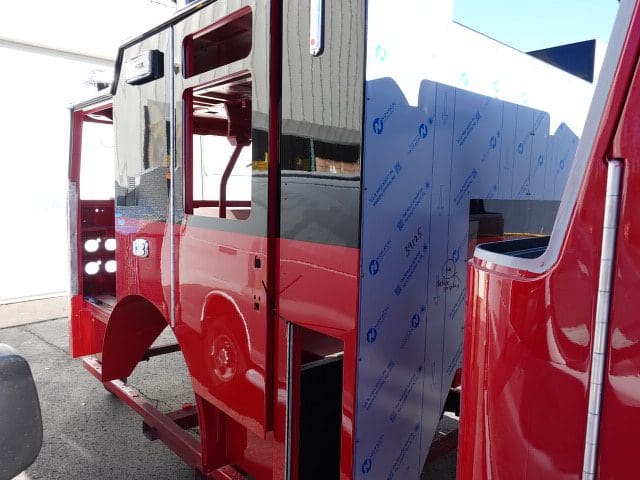

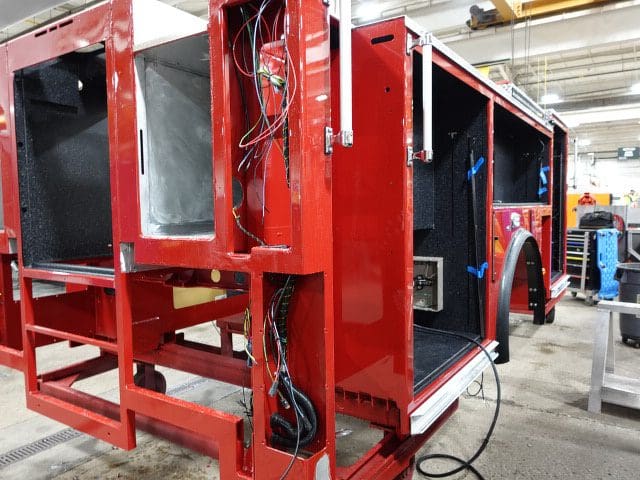

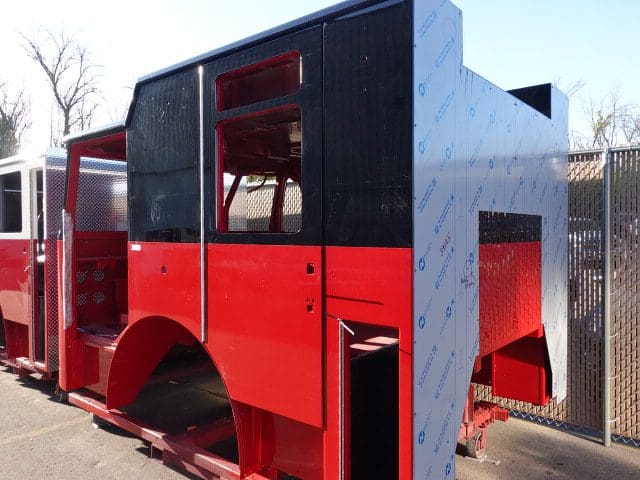

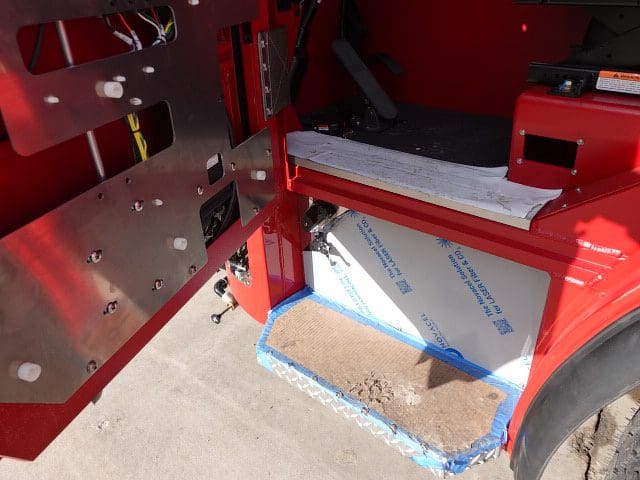

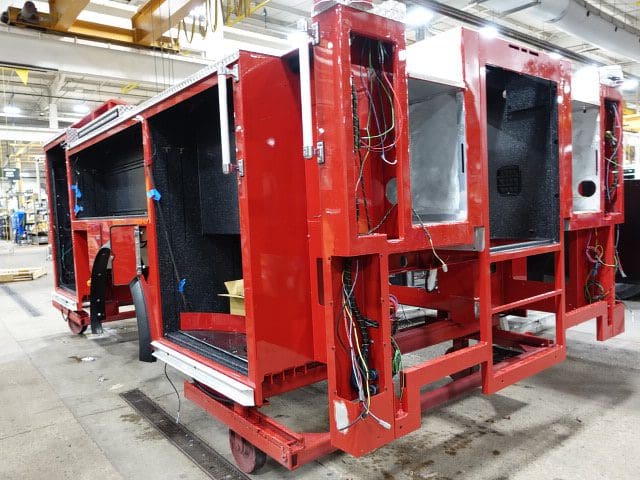

In this report, the body was installed on the chassis while the apparatus completed initial assembly.

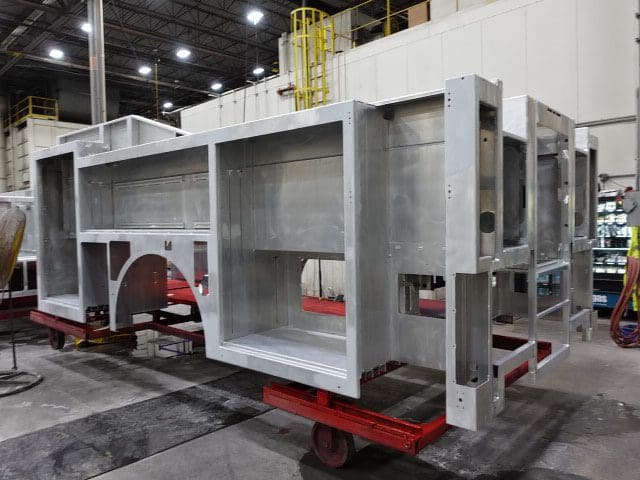

11-15-24

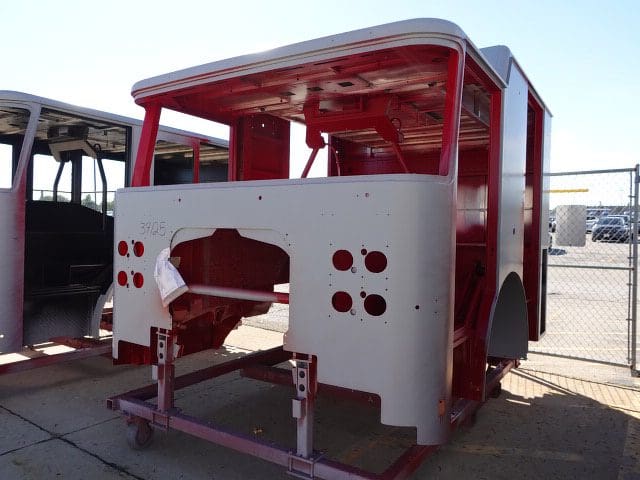

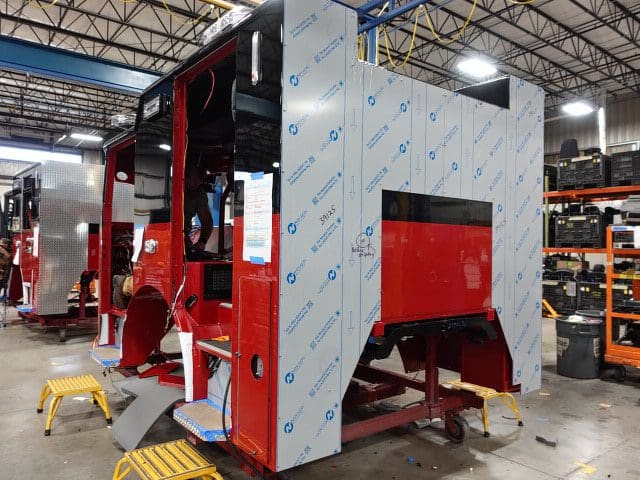

In this report, the pedestal completed initial assembly and was merged with the chassis while the body completed initial assembly and was staged to be installed.

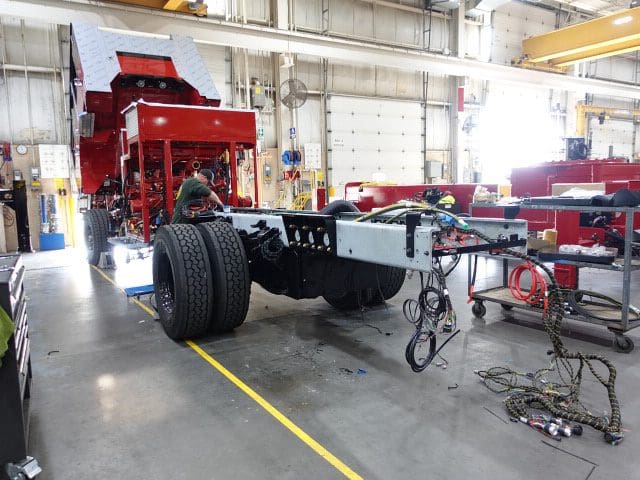

11-01-24

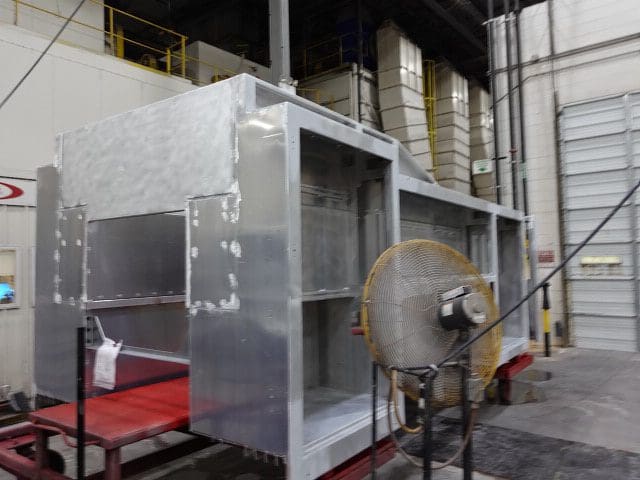

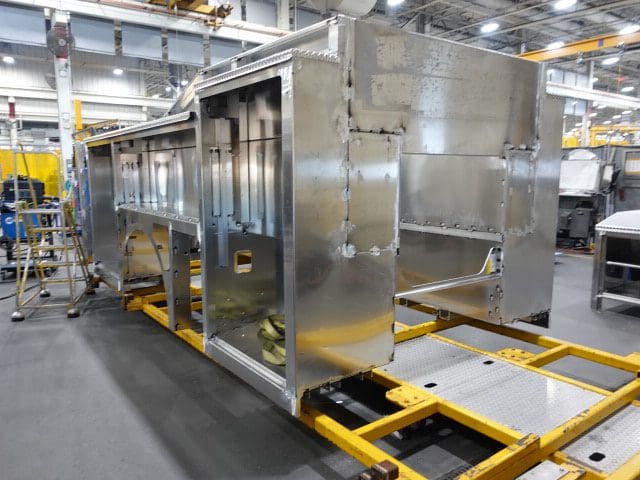

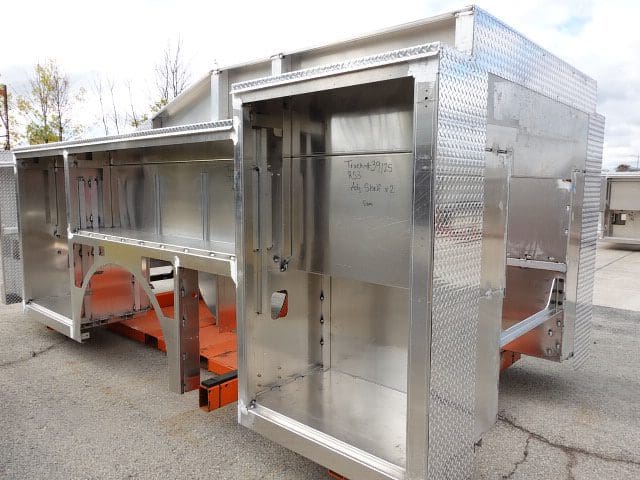

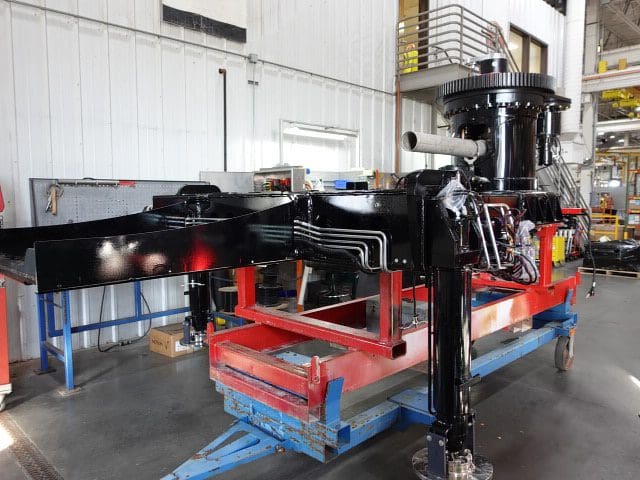

In this report, the chassis was staged, the pedestal began initial assembly, and the body began the paint process.
10-25-24

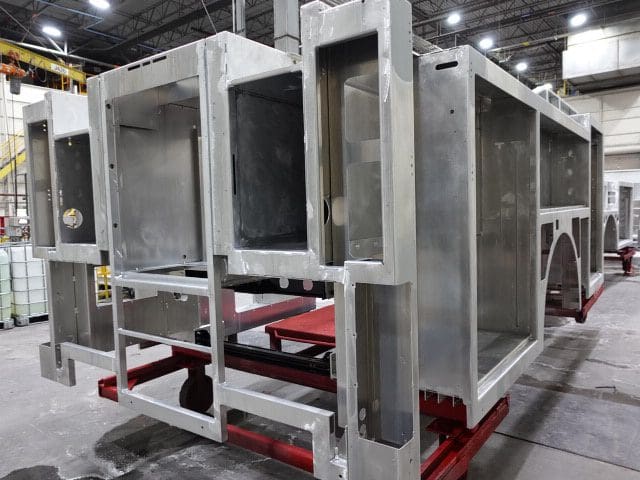

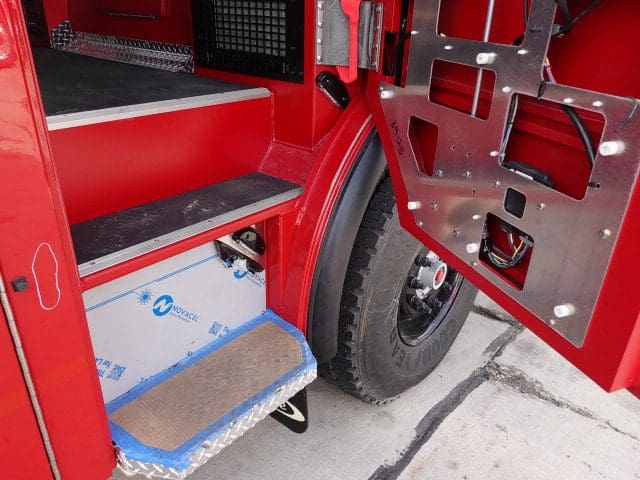

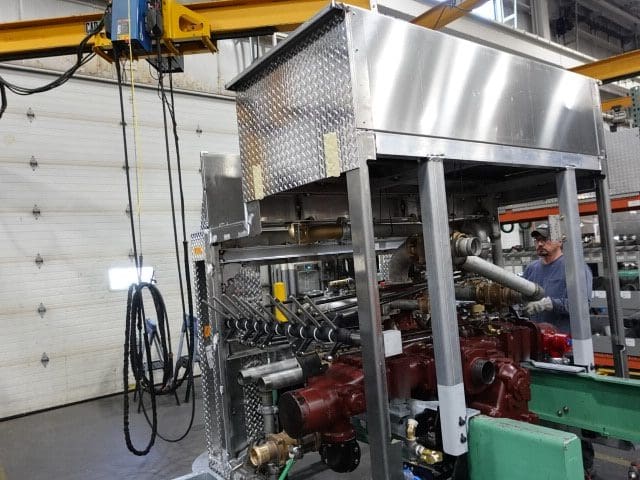

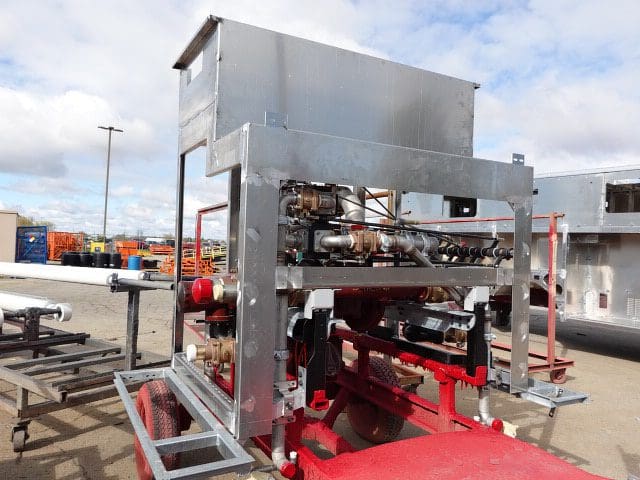

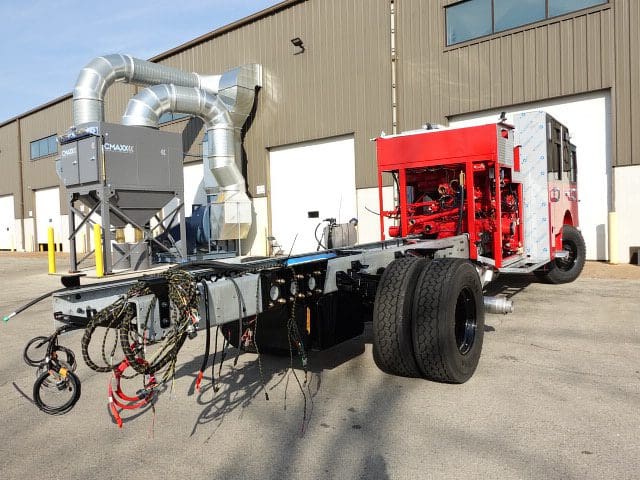

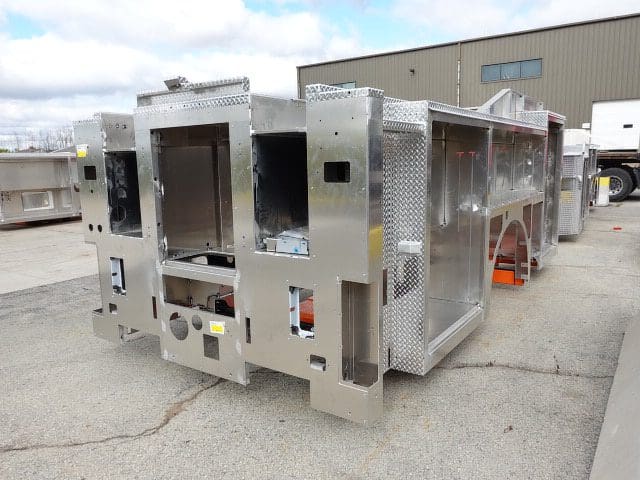

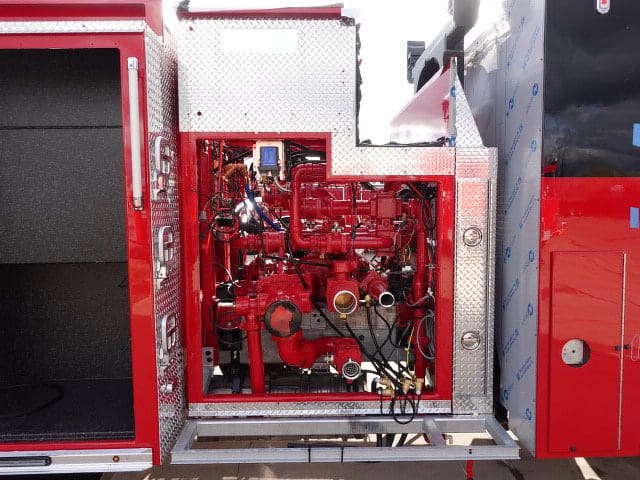

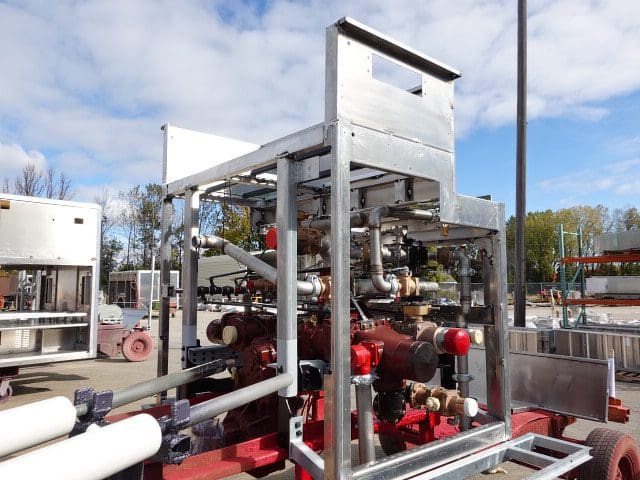

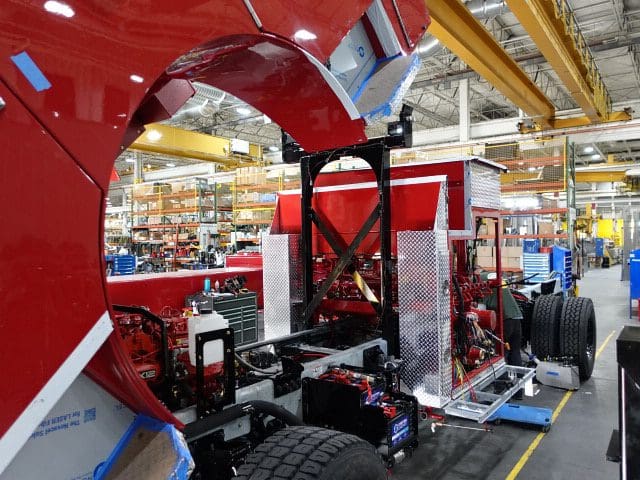

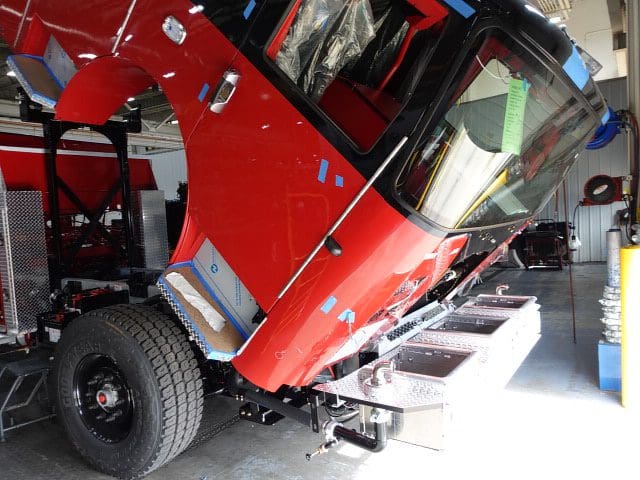

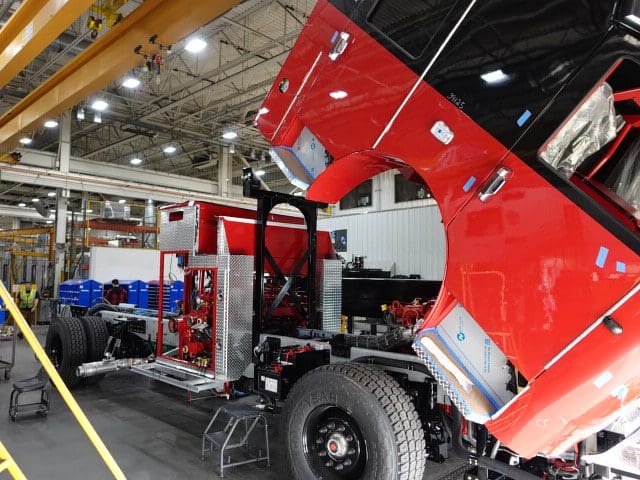

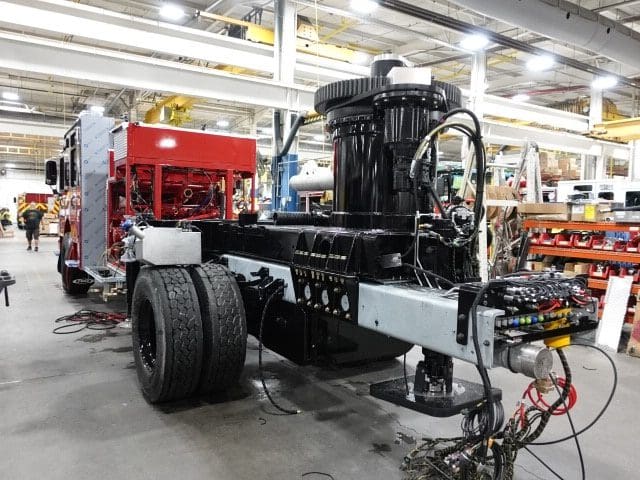

In this report, the cab and pump house completed initial assembly and were installed on the frame while the body was unavailable for photos.

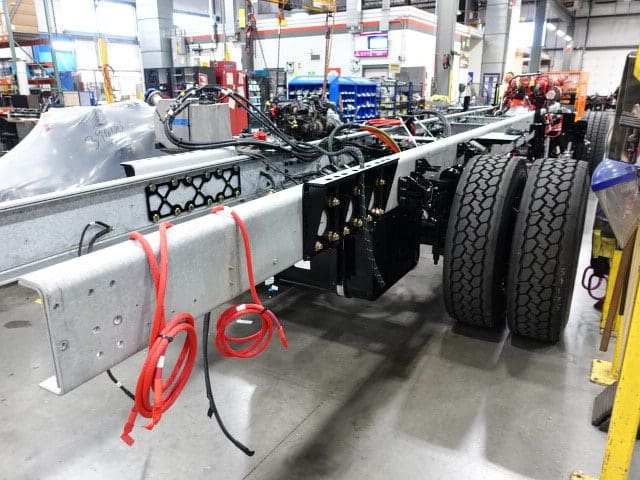

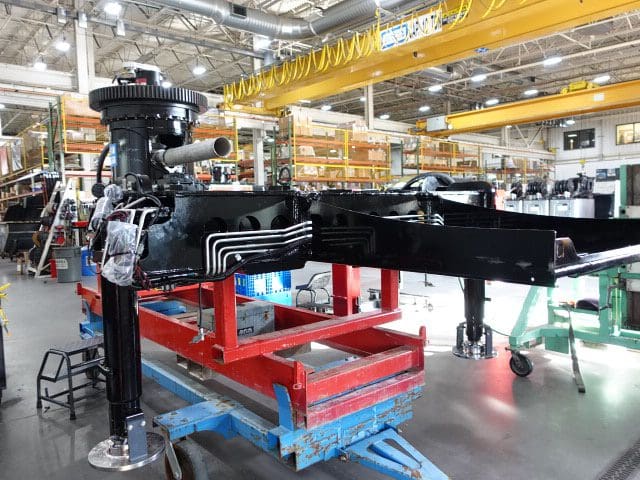

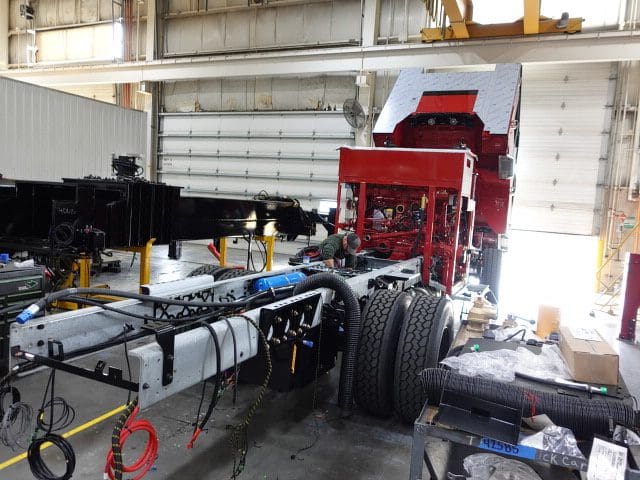

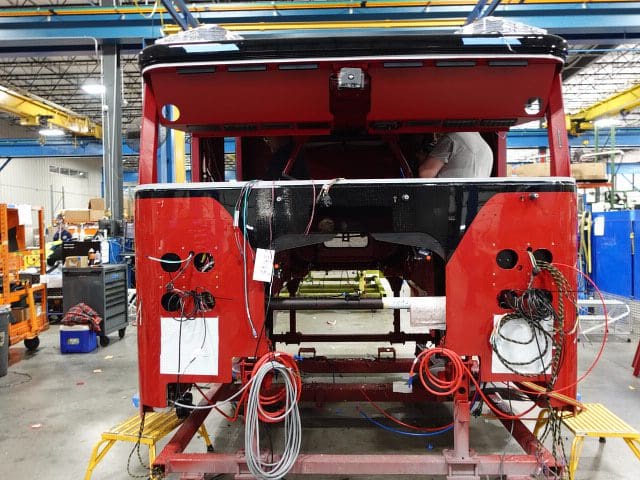

10-18-24

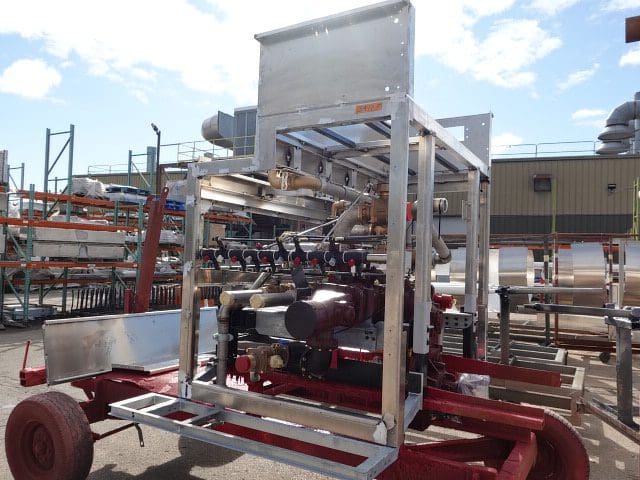

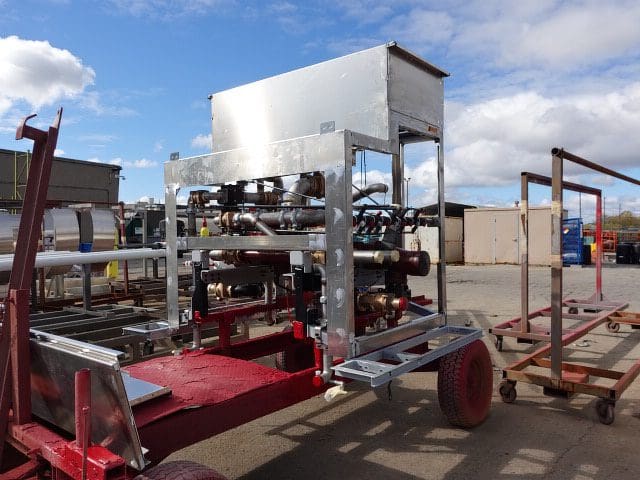

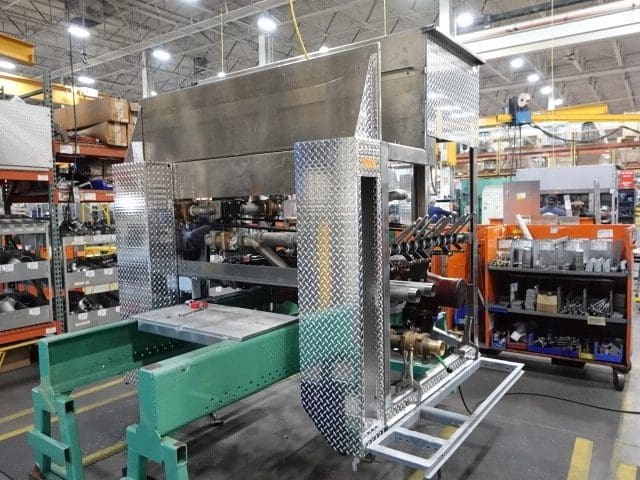

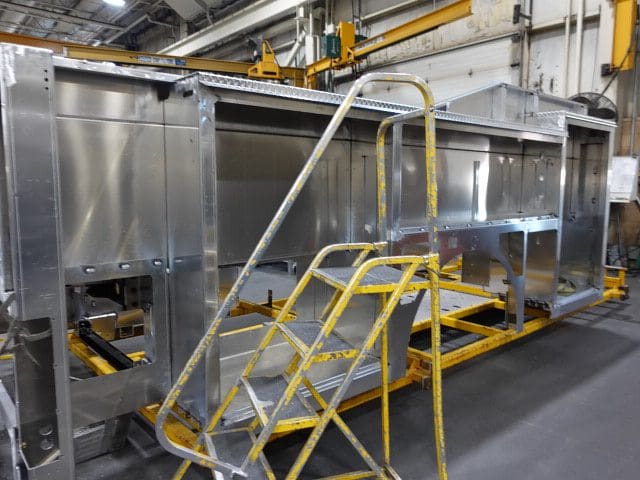

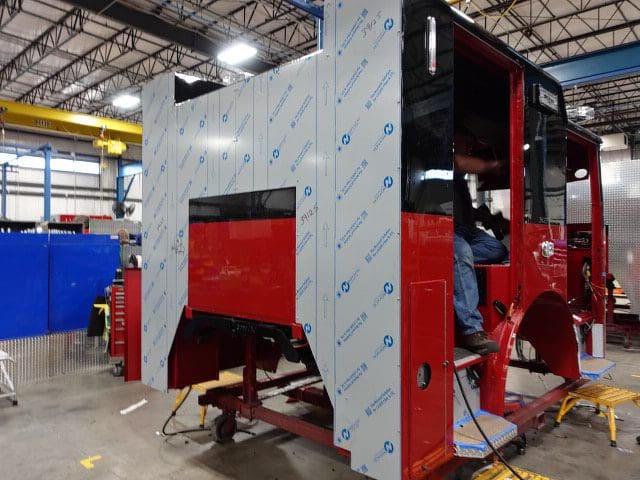

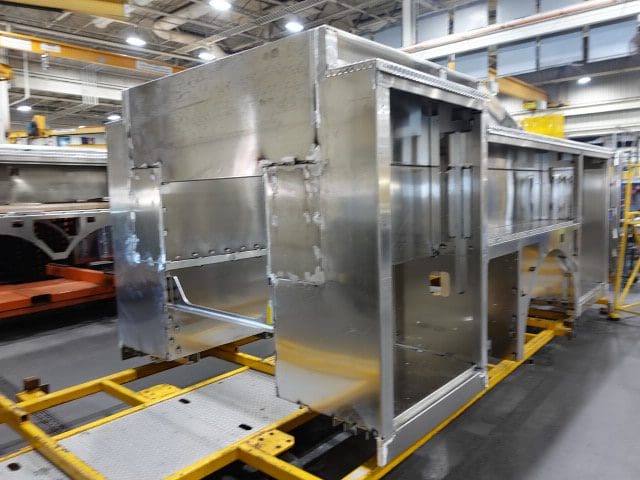

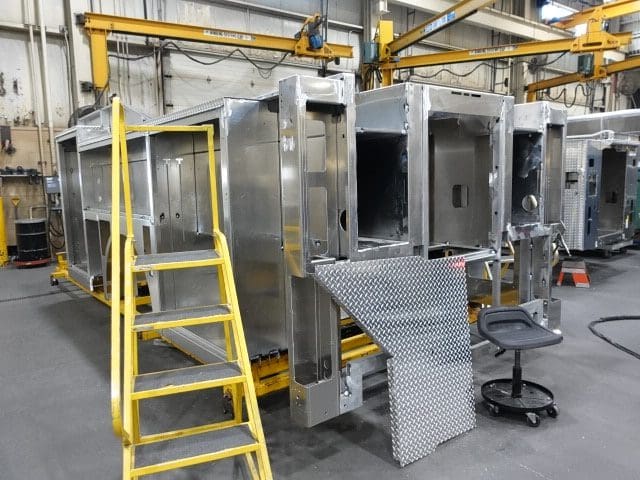

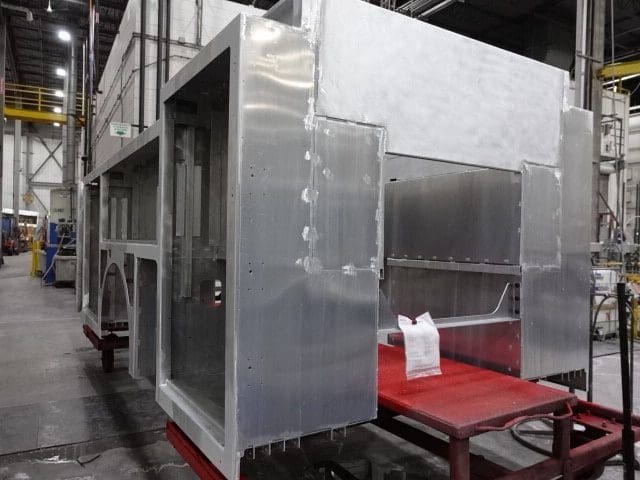

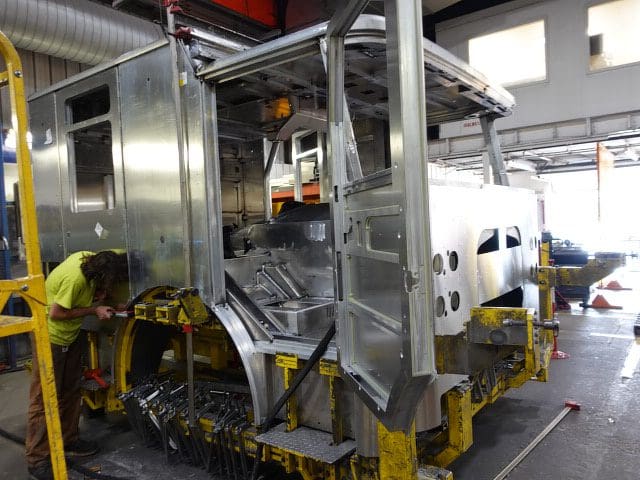

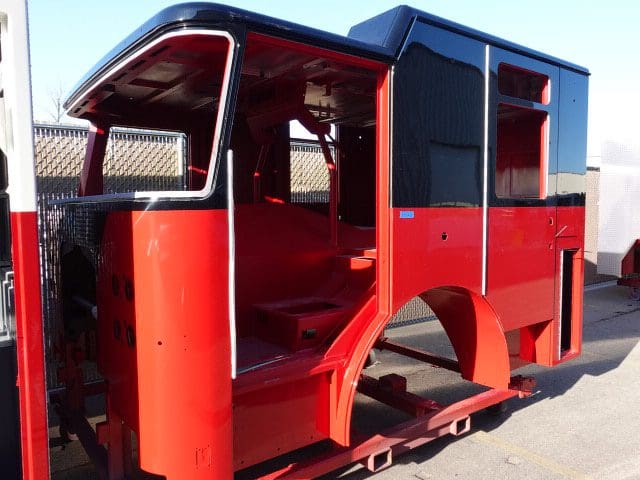

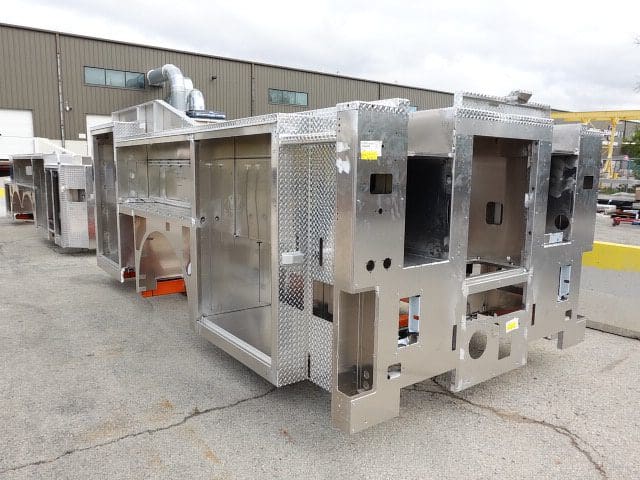

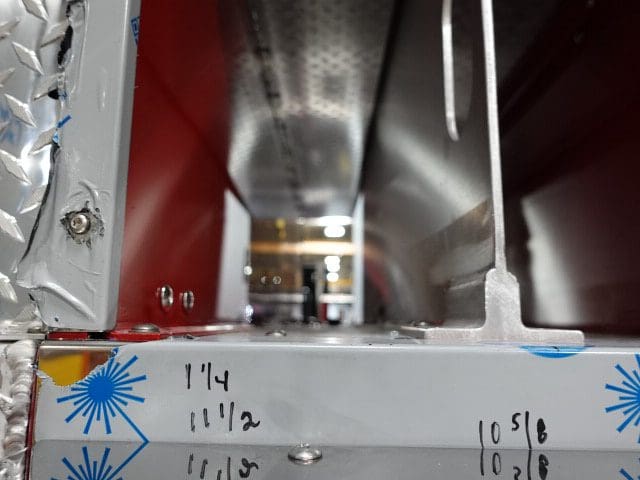

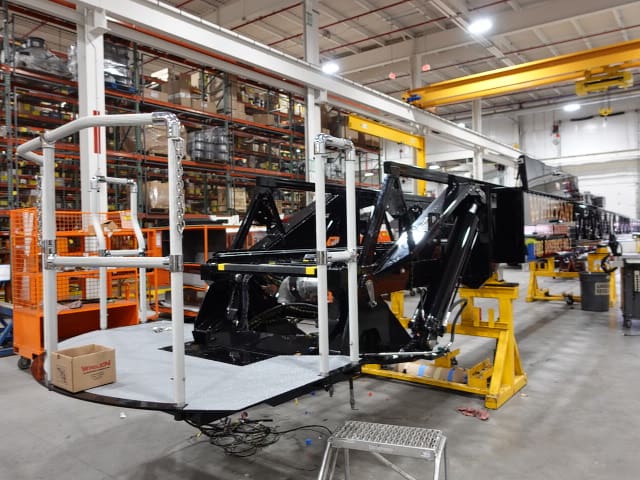

In this report, the cab continued initial assembly, the frame build began, the pump house continued initial assembly, and the body completed fabrication.

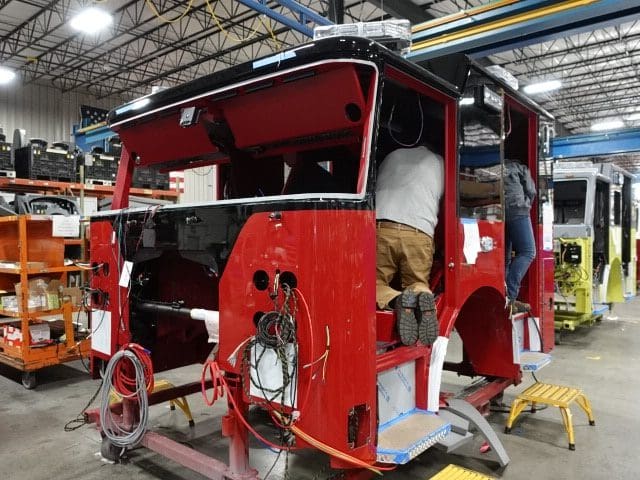

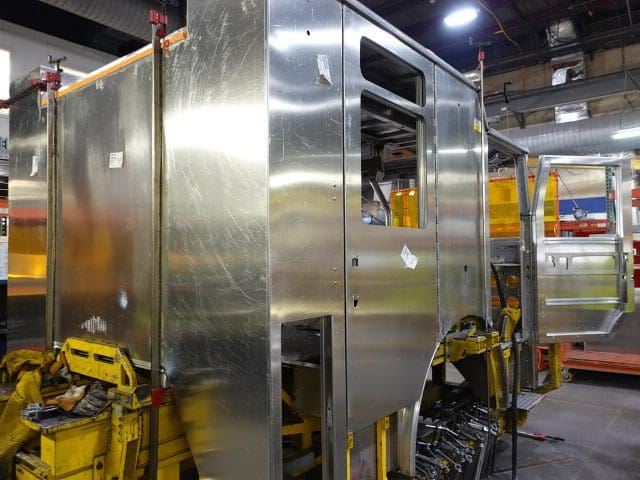

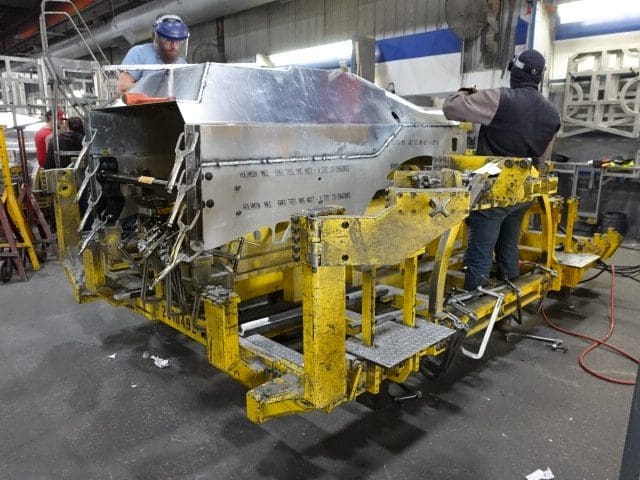

10-11-24

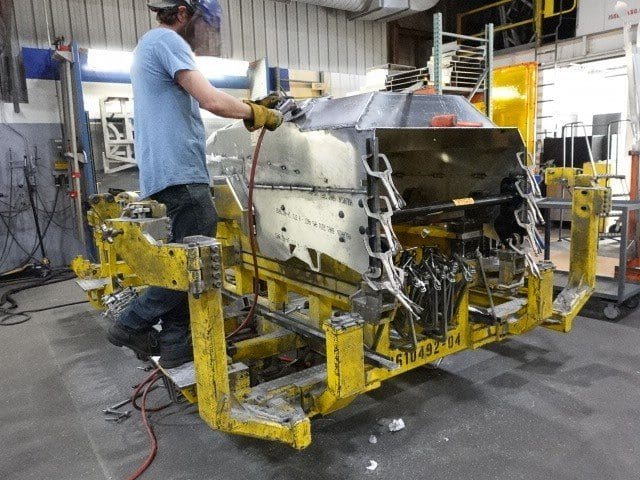

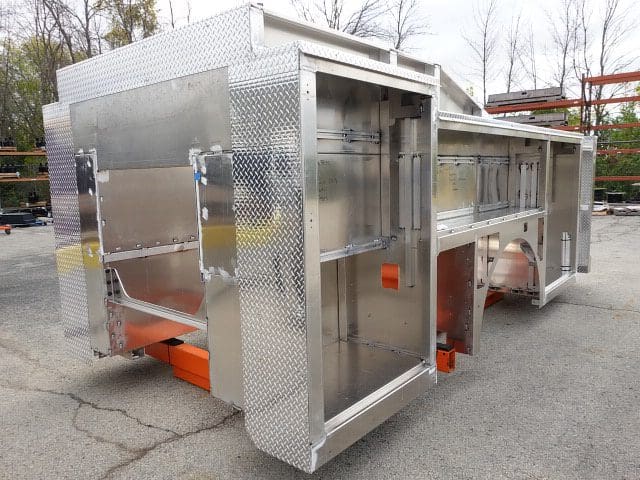

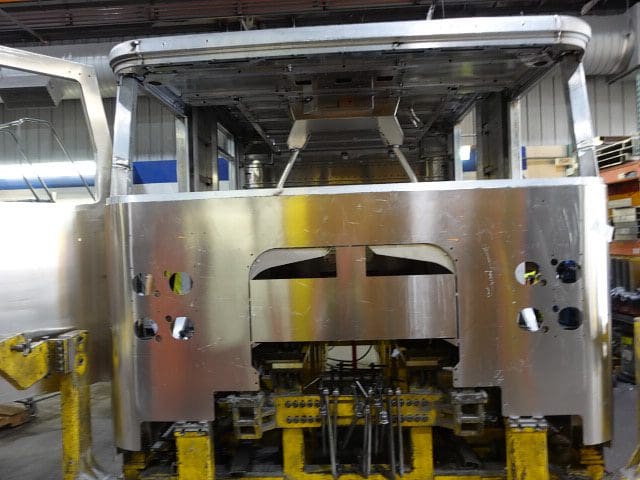

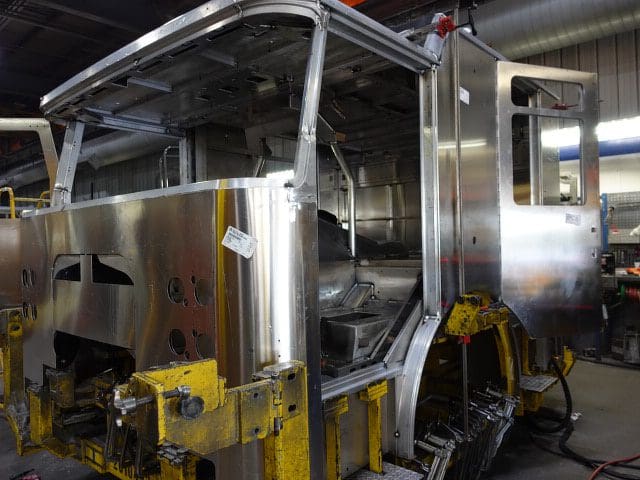

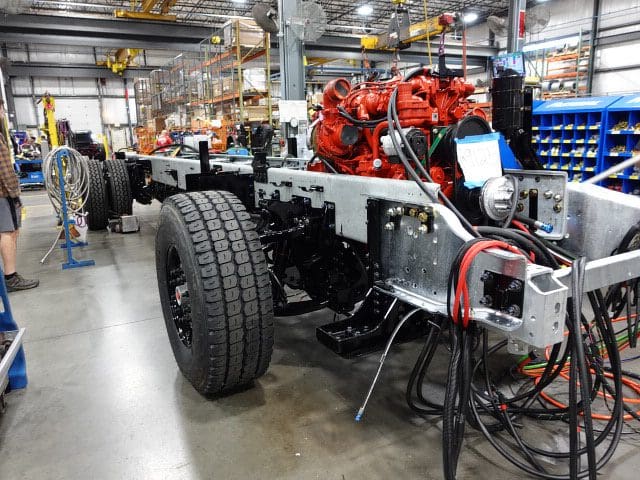

In this report, the cab began initial assembly, the pump house began initial assembly, and the body began fabrication.
09-13-24

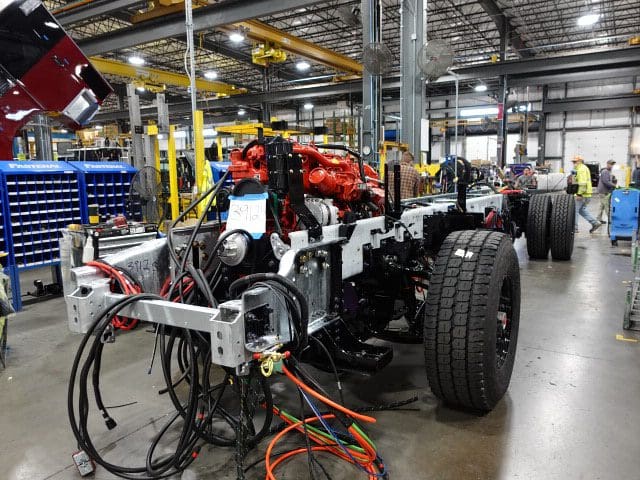

This new Pierce apparatus is now in production! In this report, the cab began fabrication.
