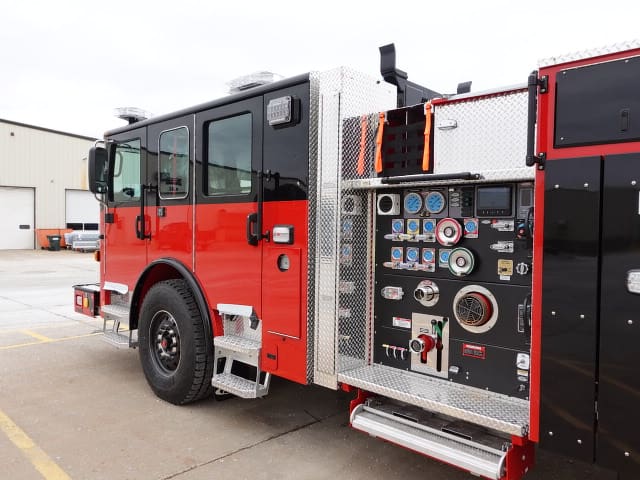

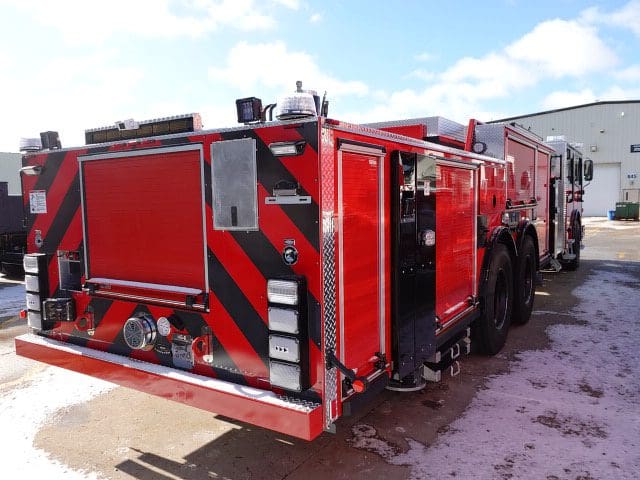

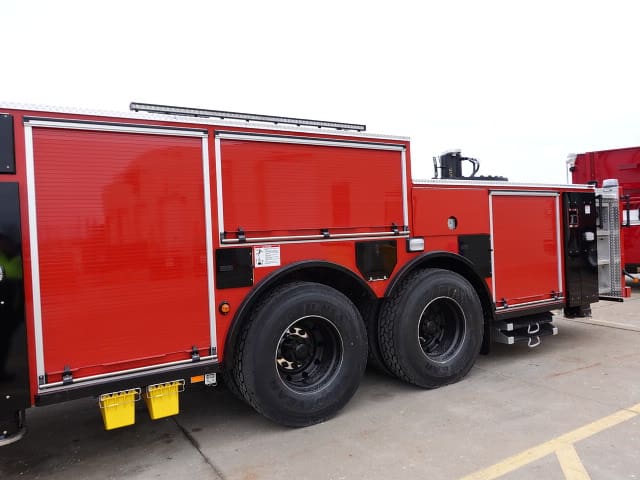

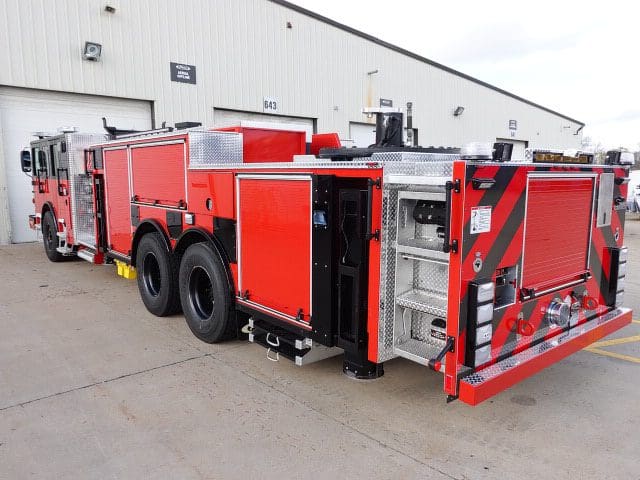

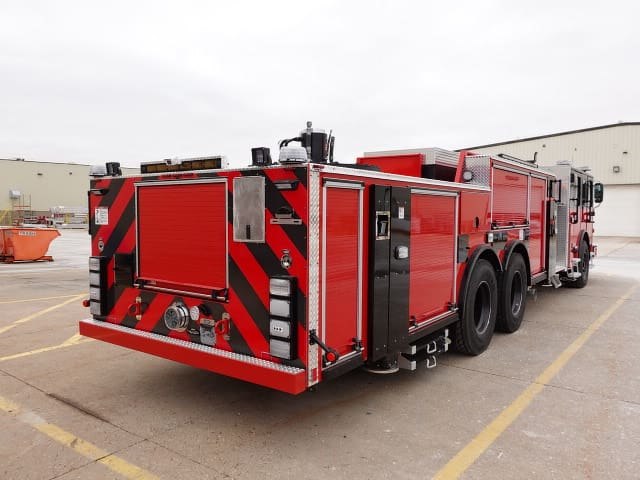

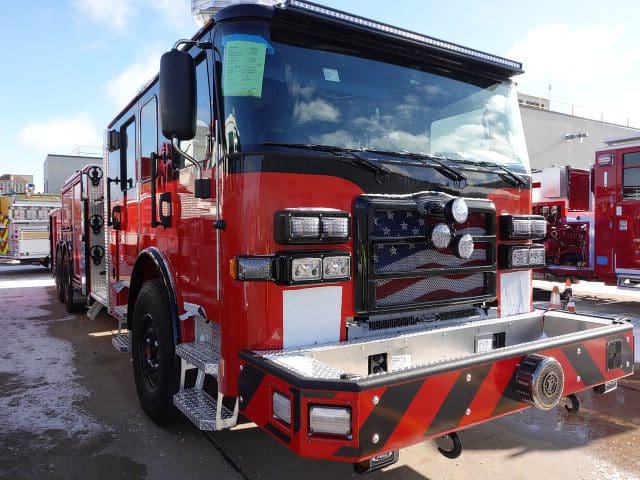

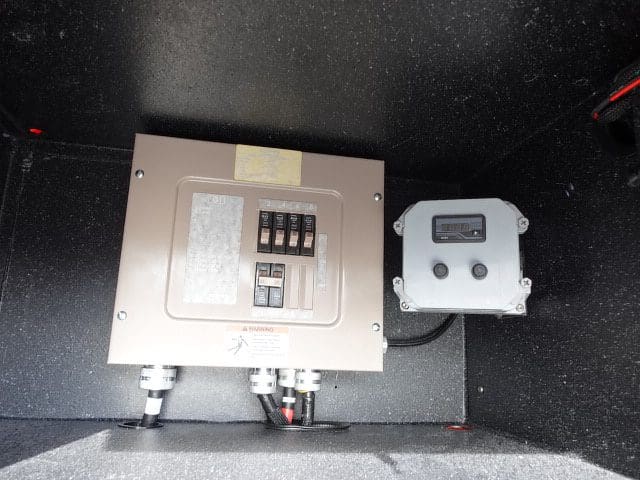

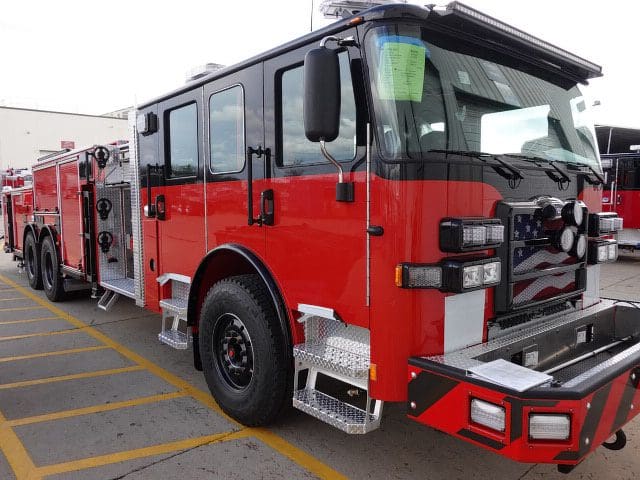

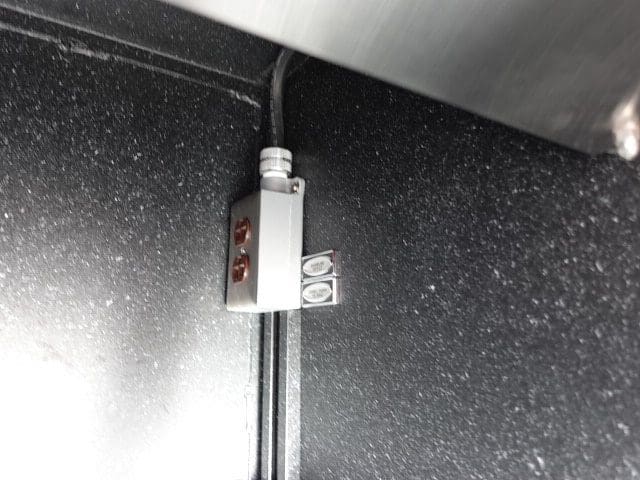

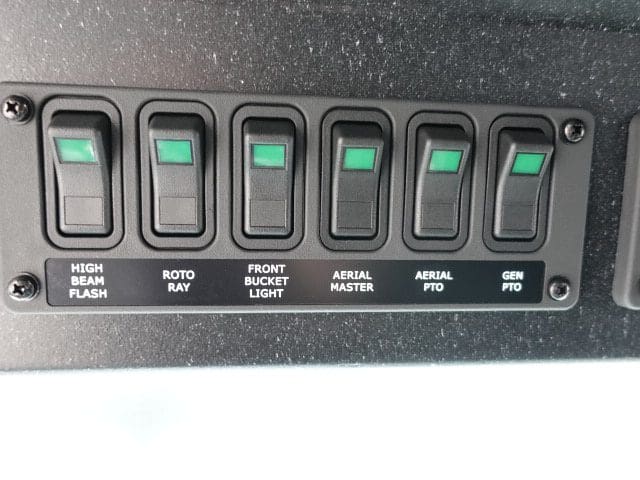

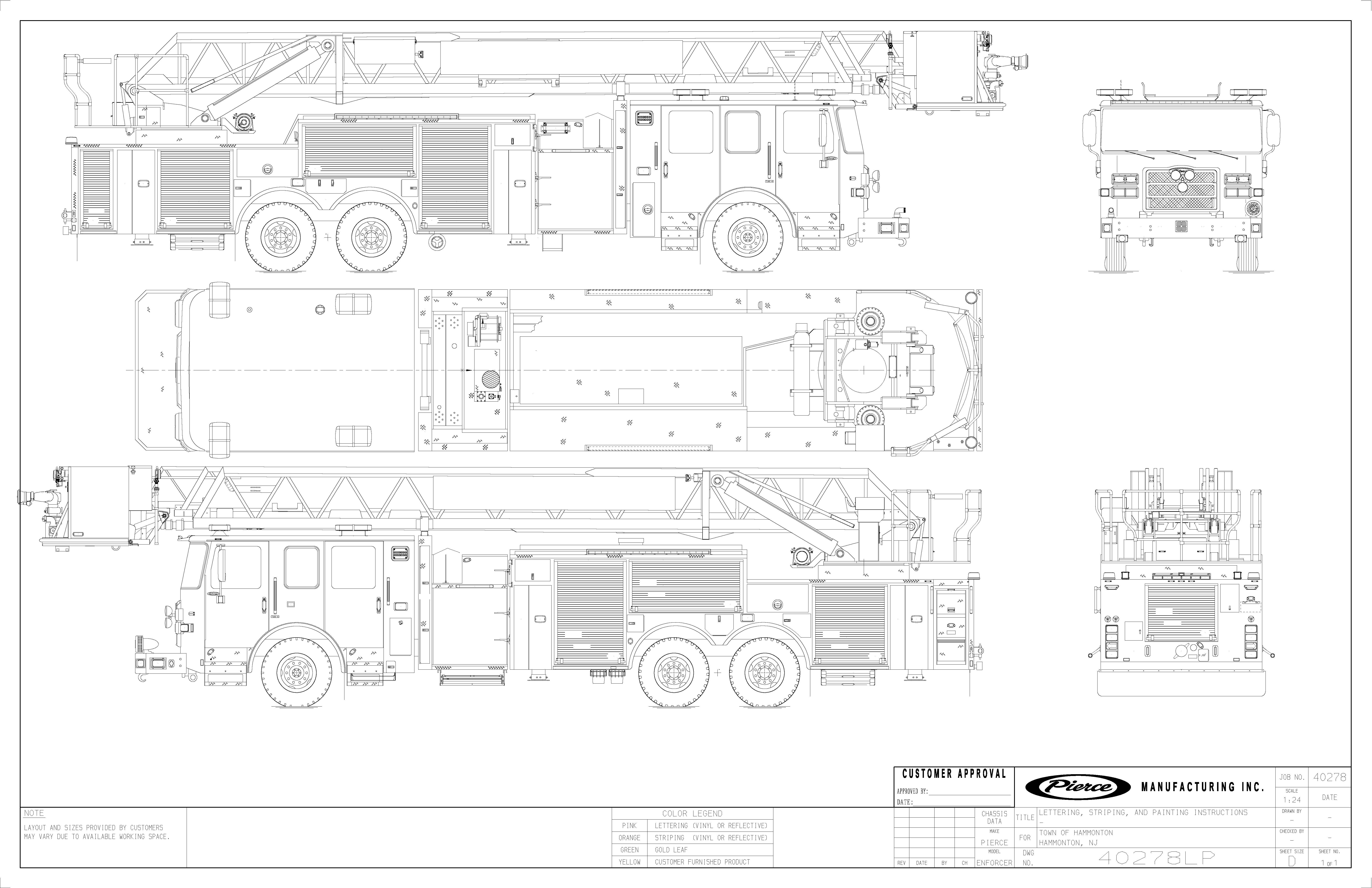

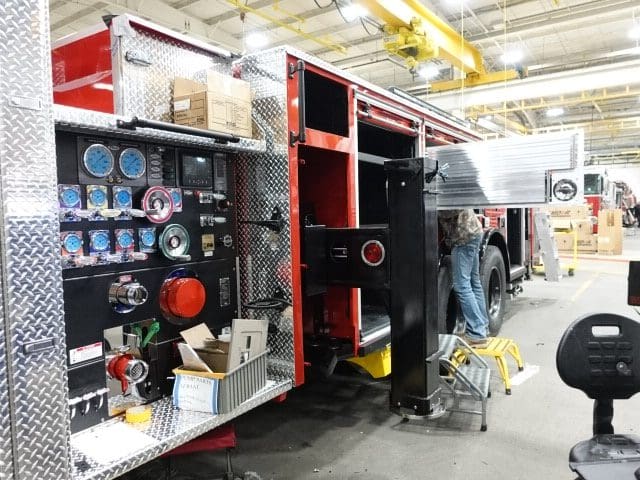

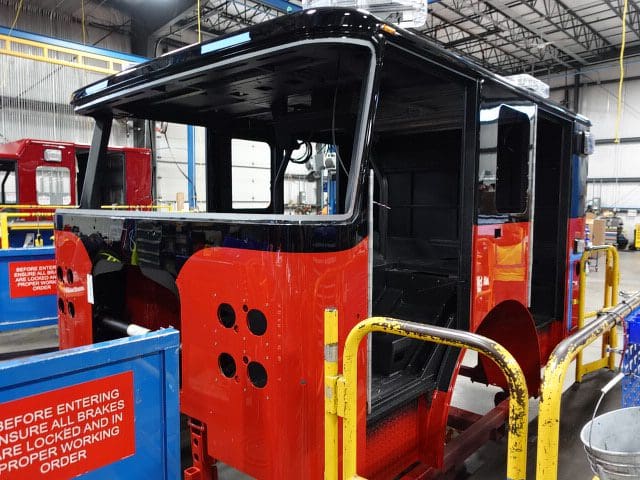

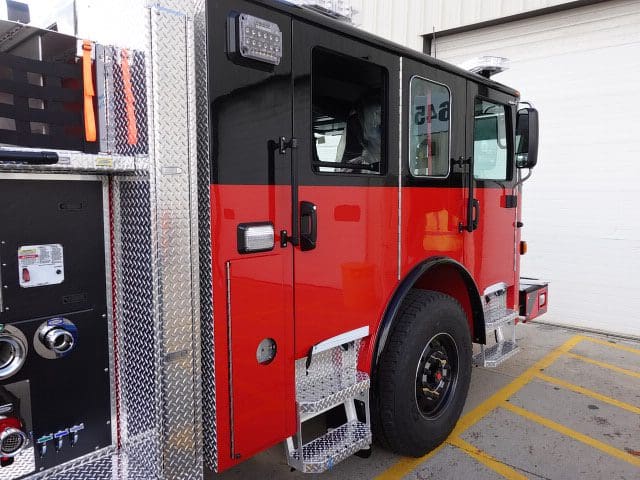

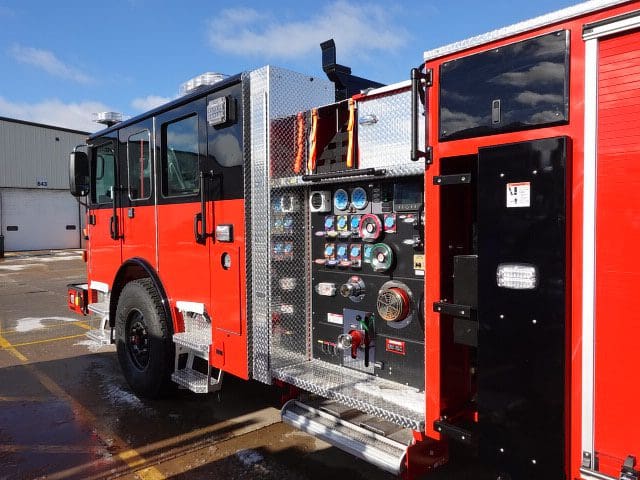

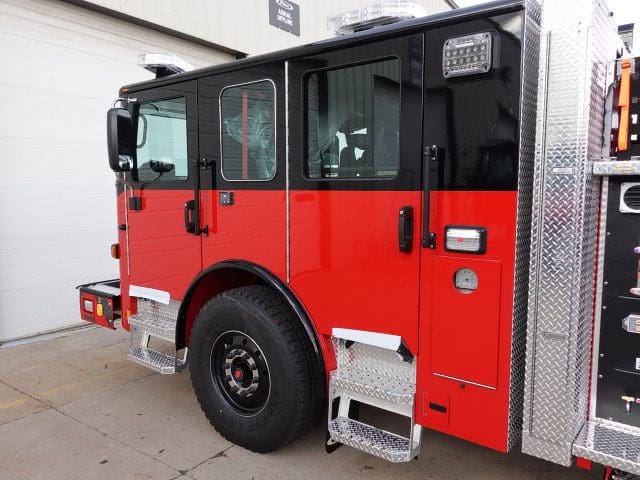

01-17-25

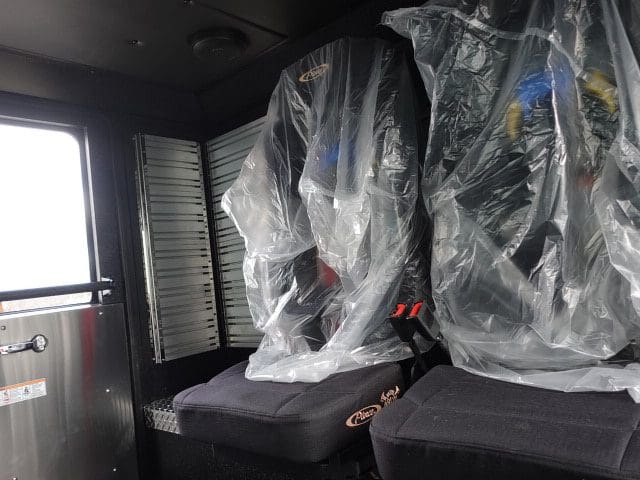

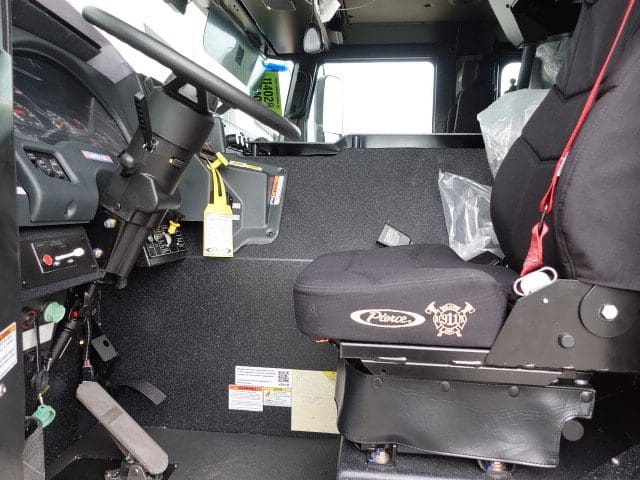

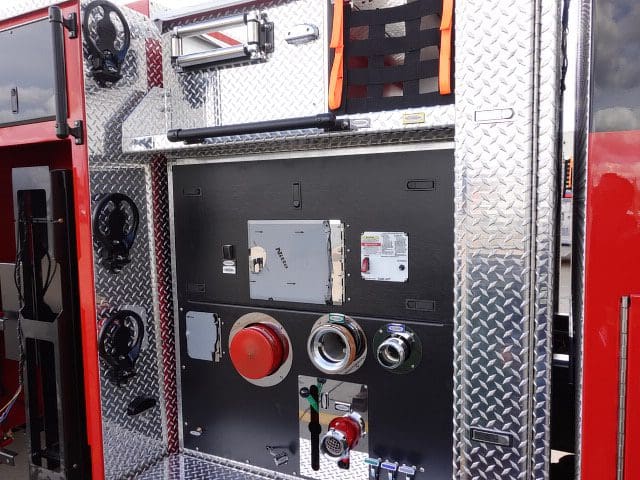

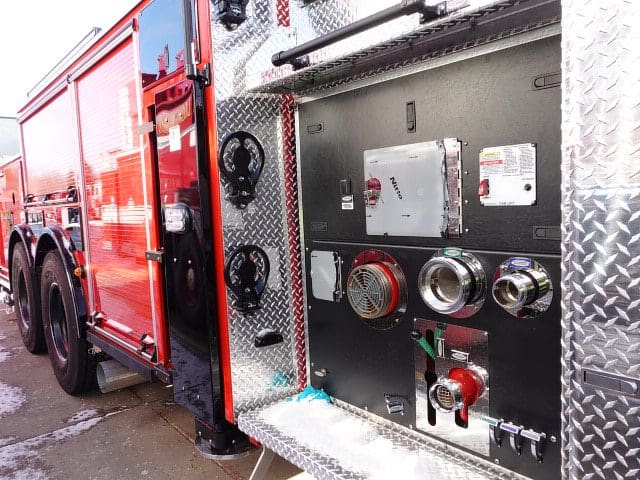

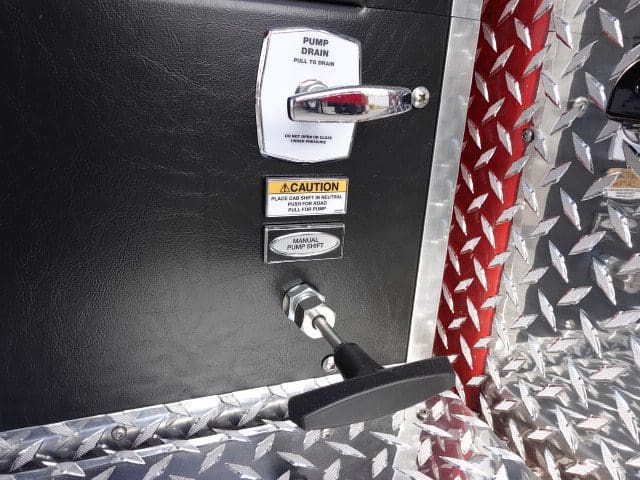

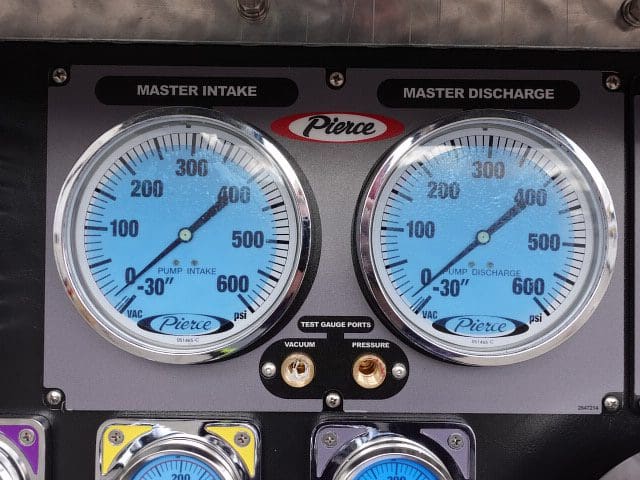

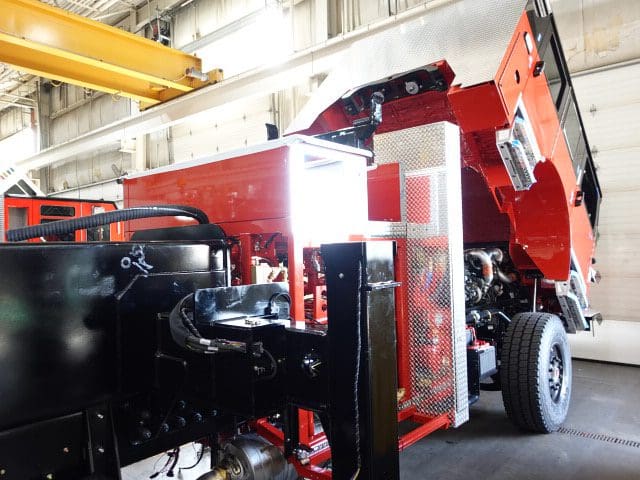

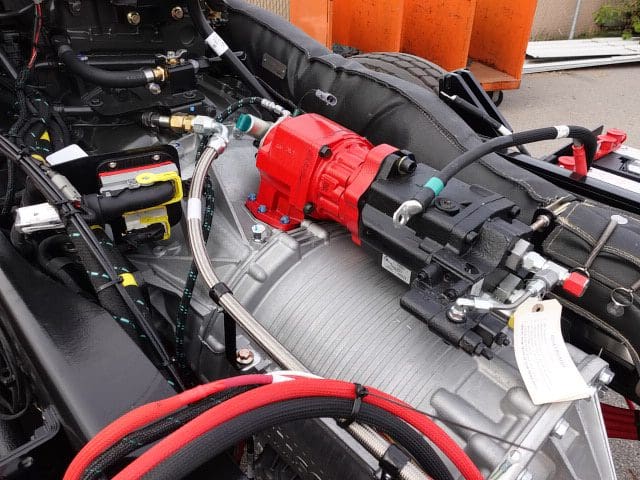

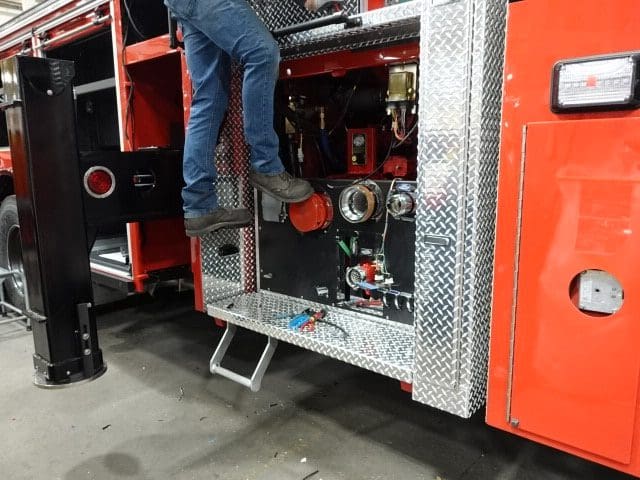

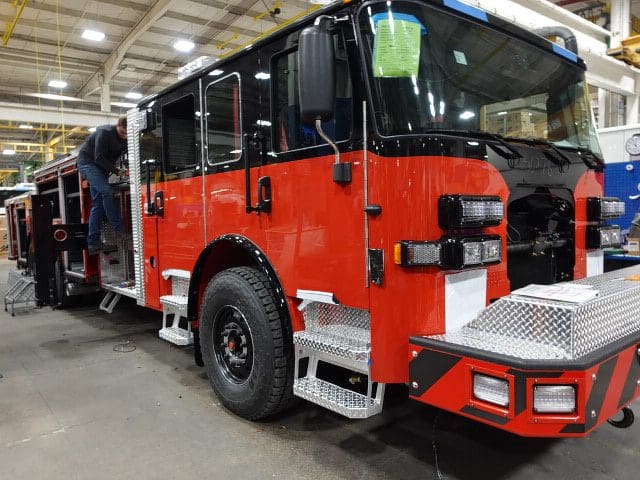

In this report, the apparatus continued the quality process.

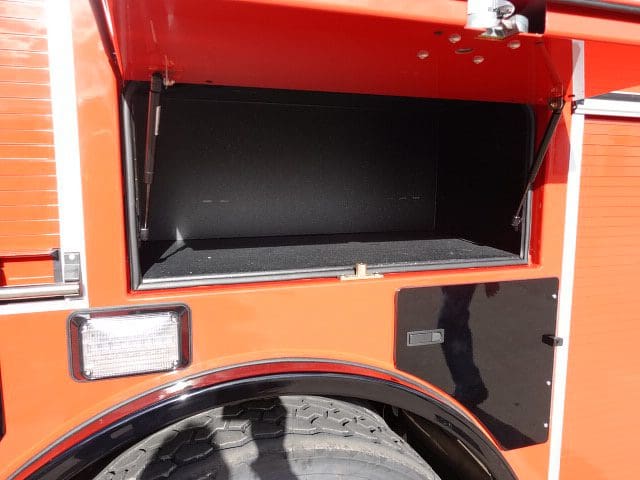

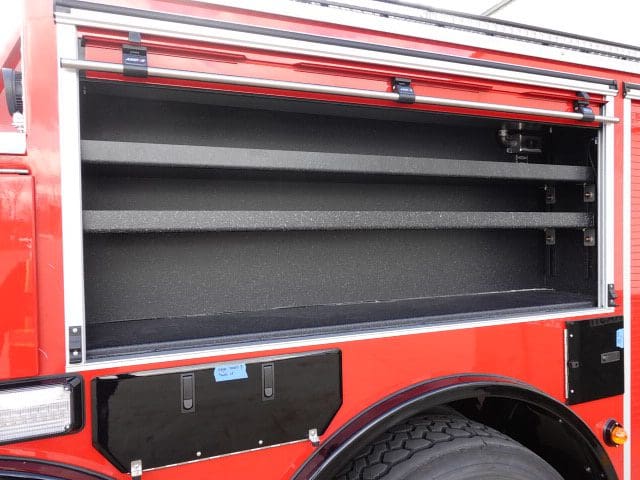

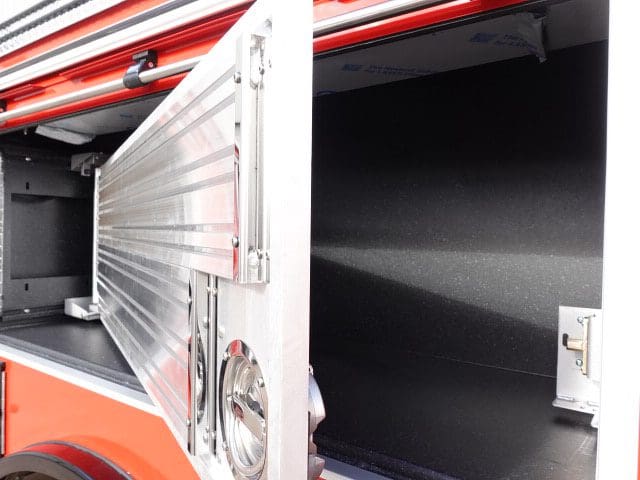

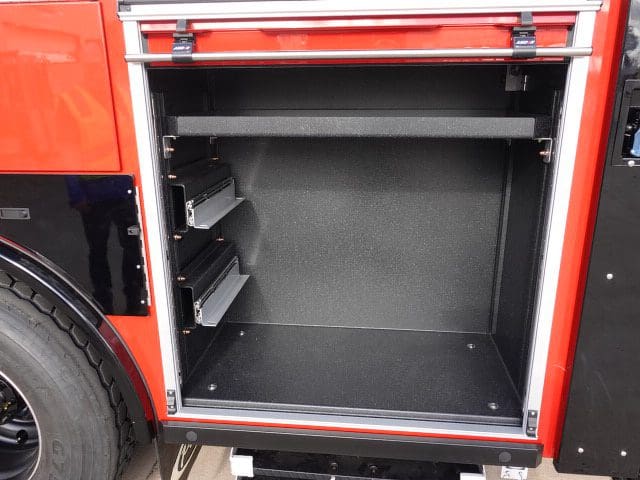

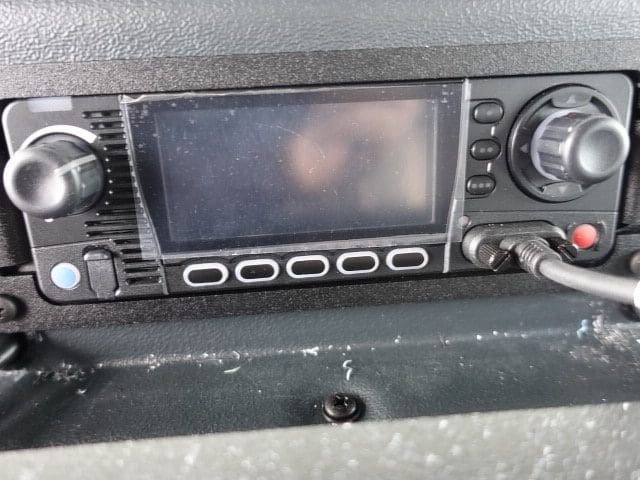

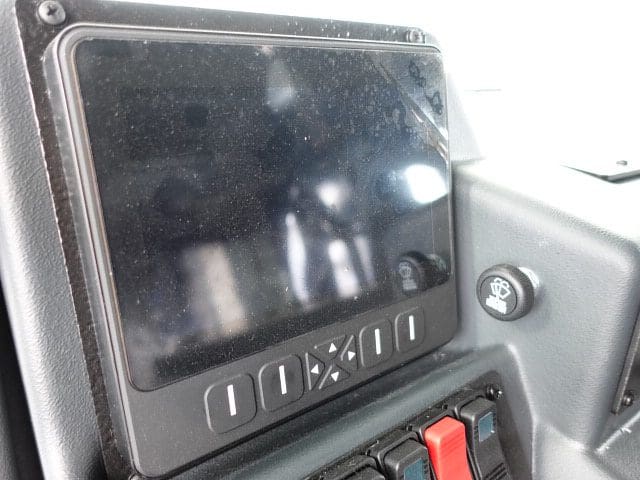

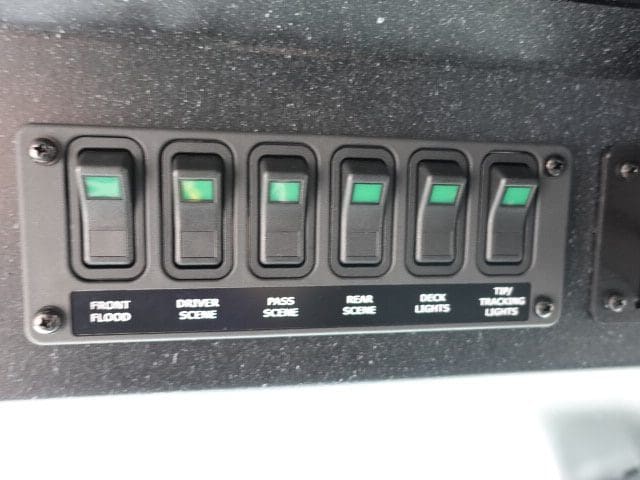

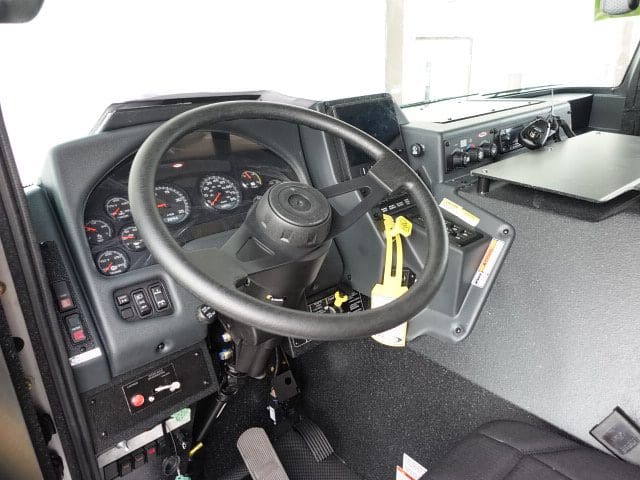

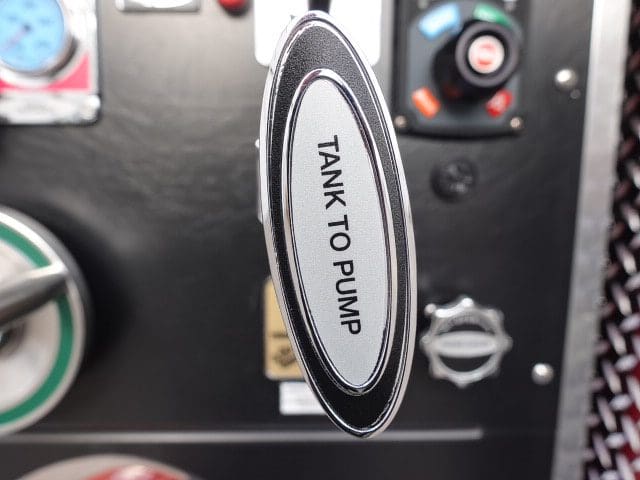

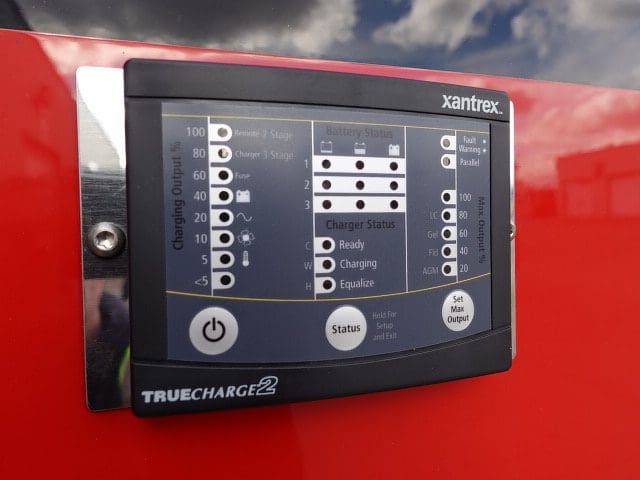

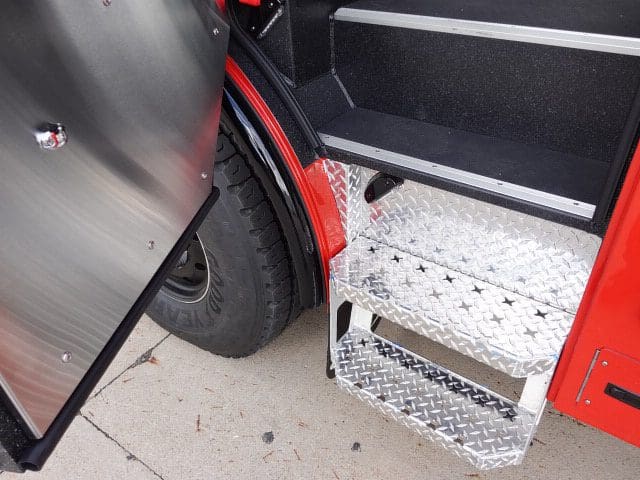

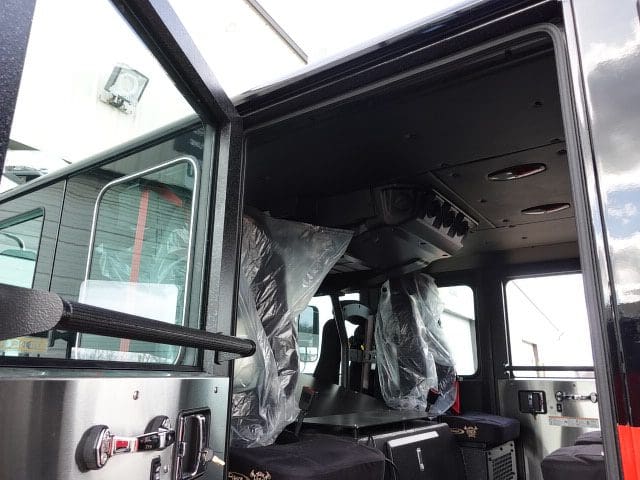

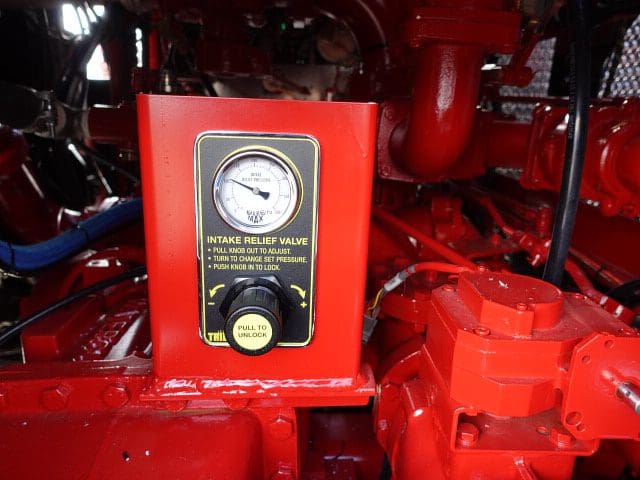

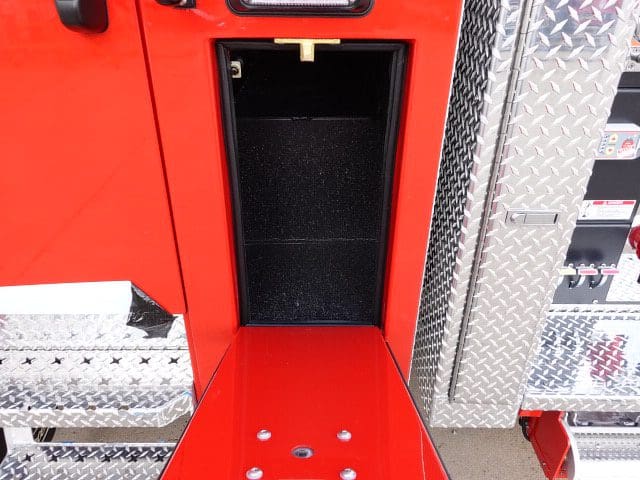

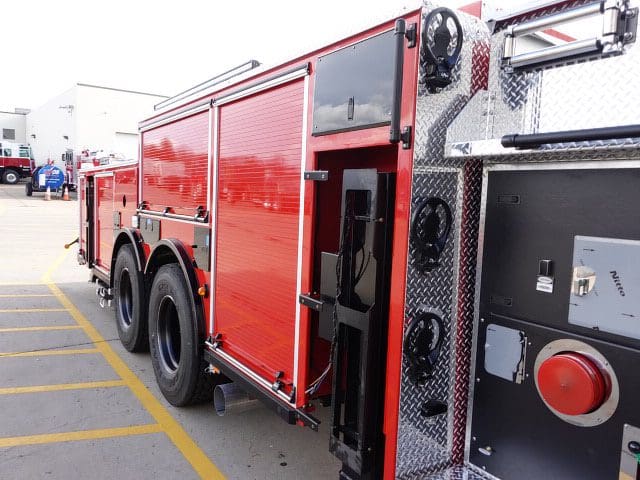

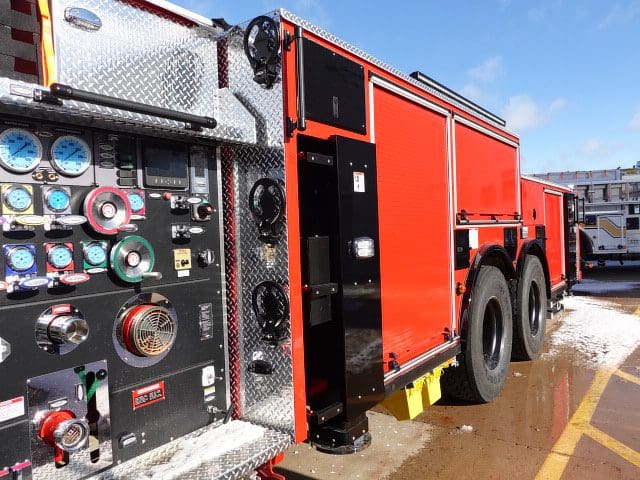

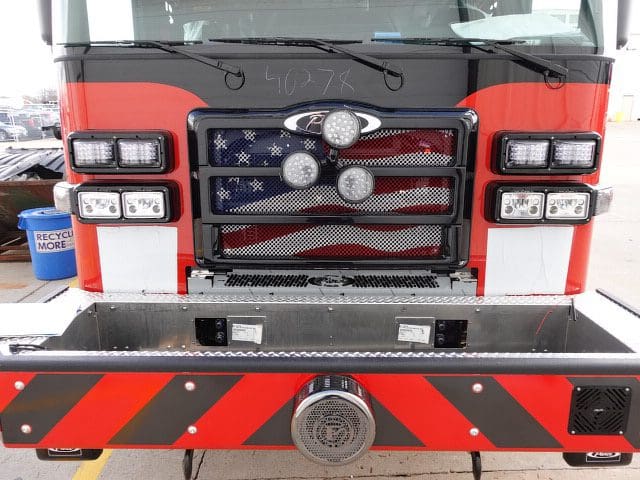

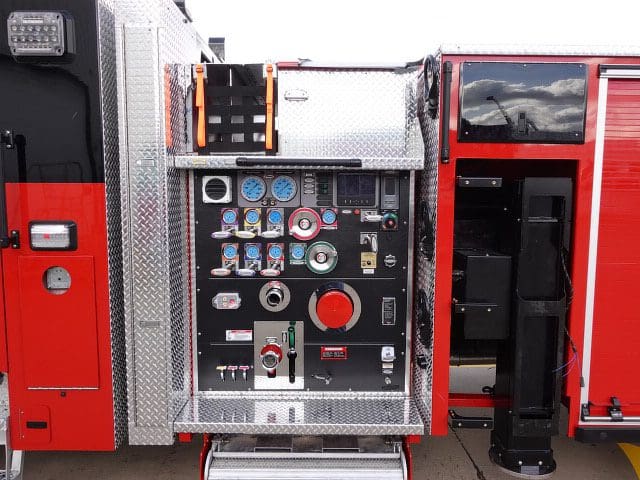

Once finished it will be made ready for the customer

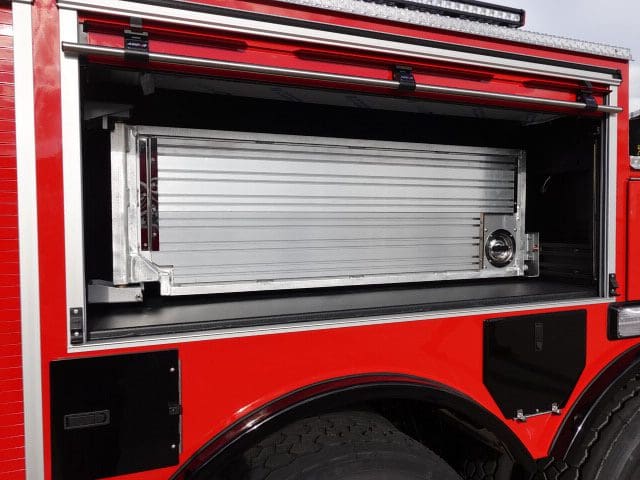

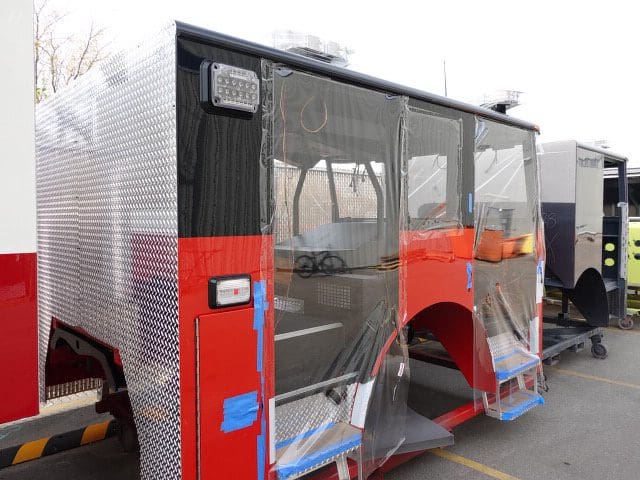

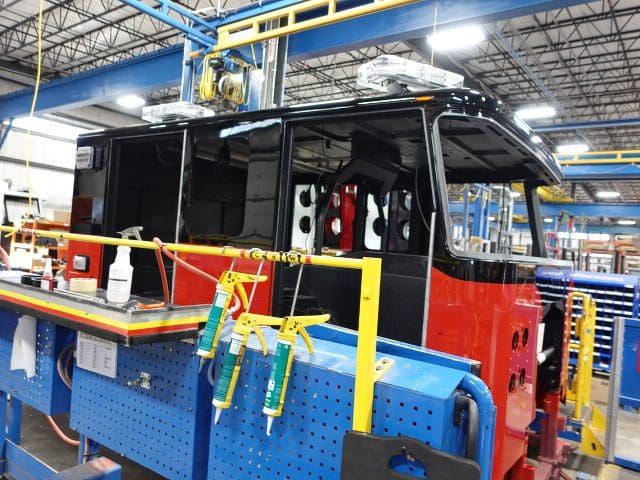

acceptance inspection. This is the last scheduled report.

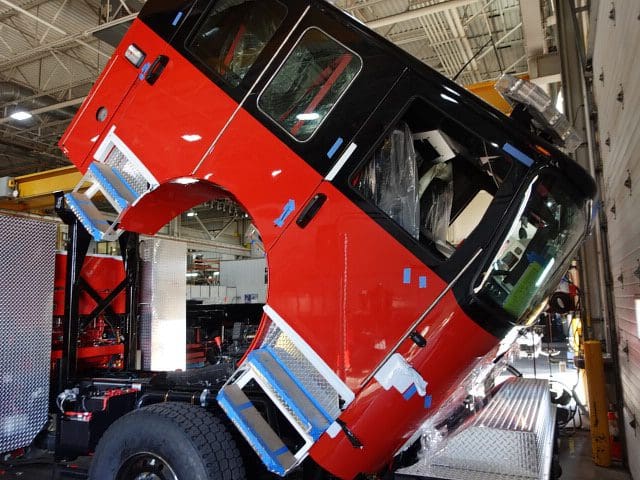

01-10-25

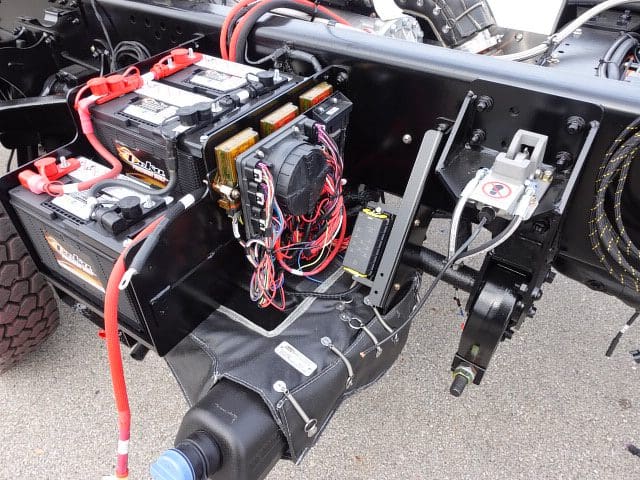

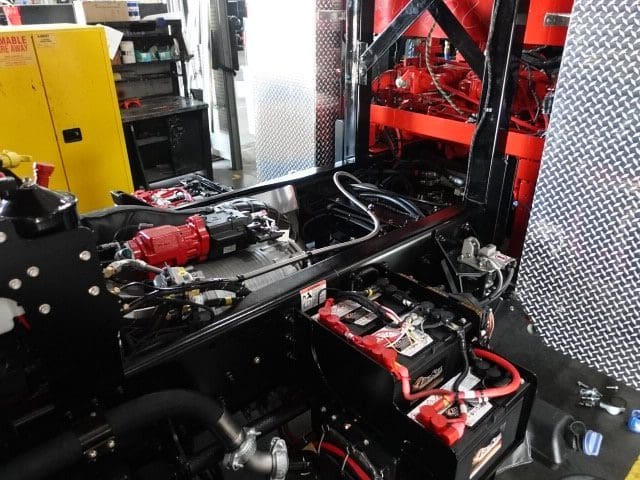

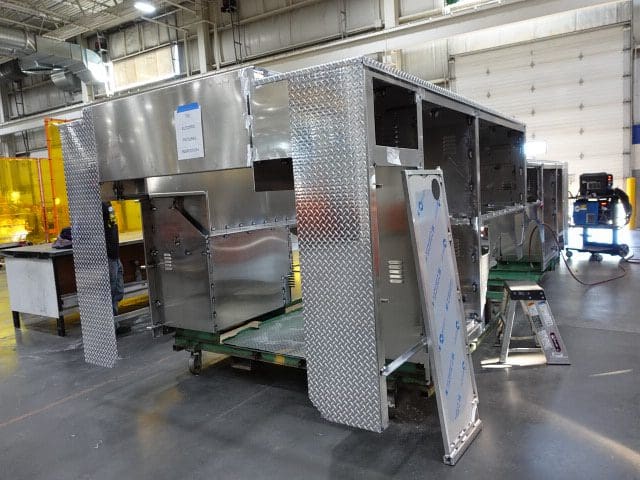

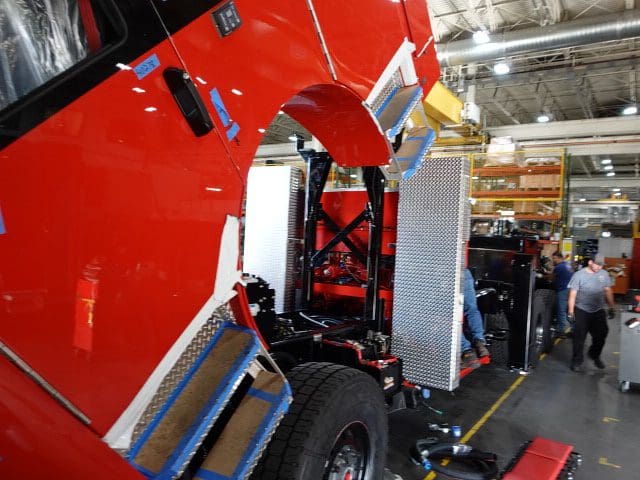

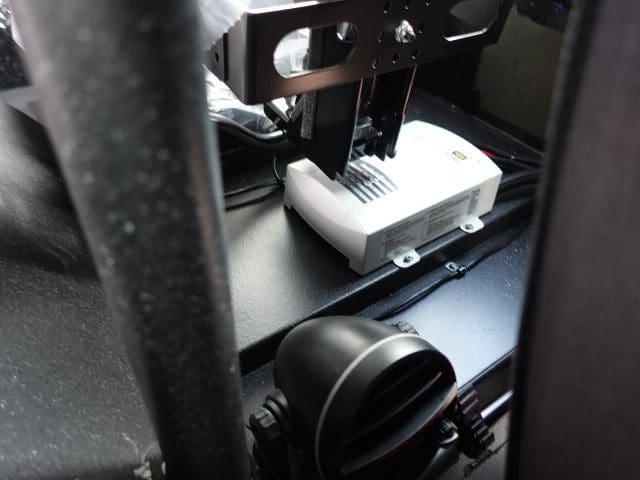

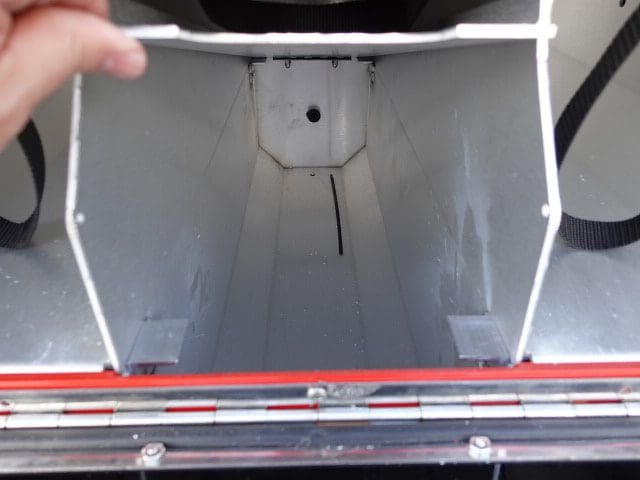

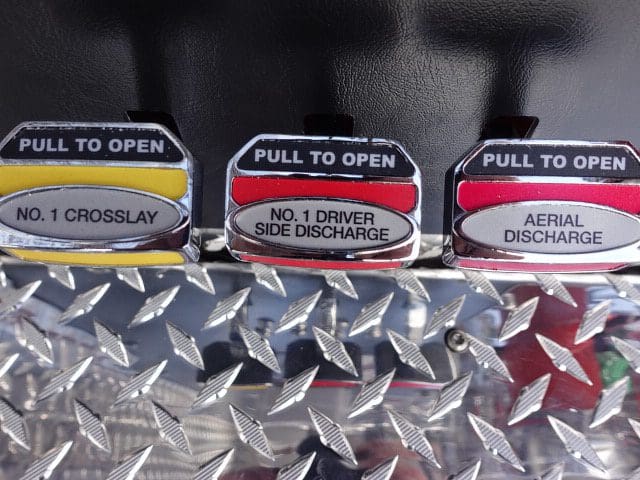

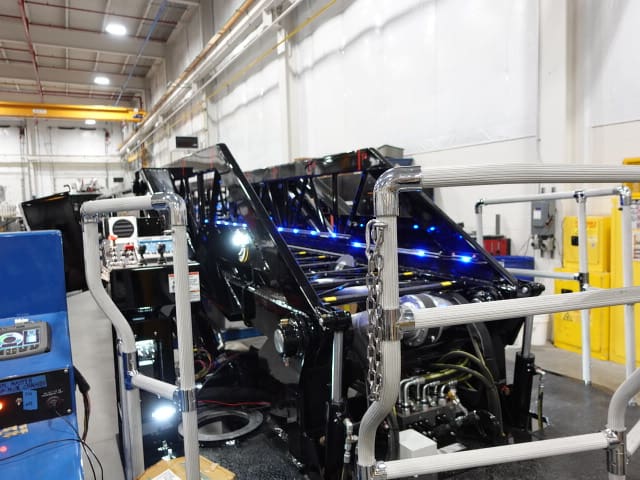

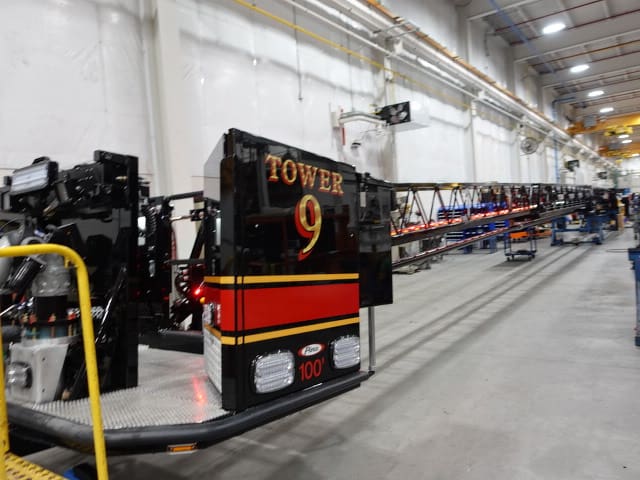

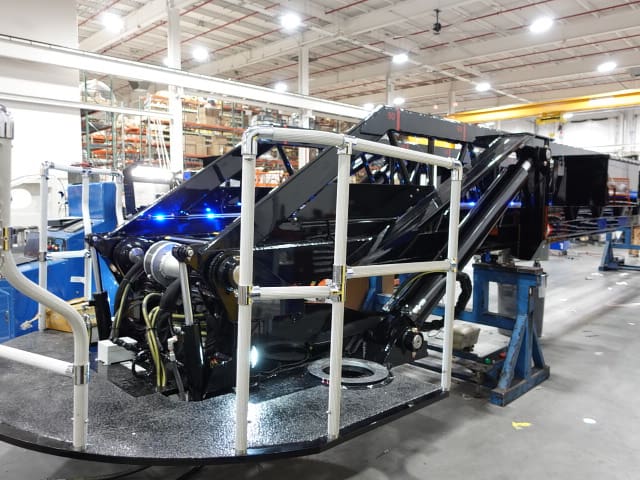

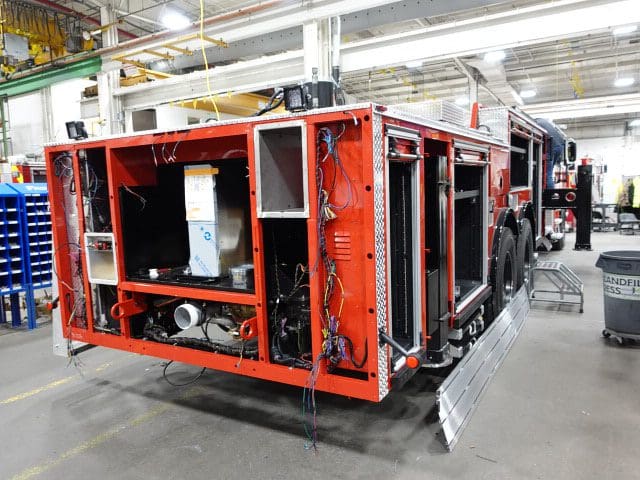

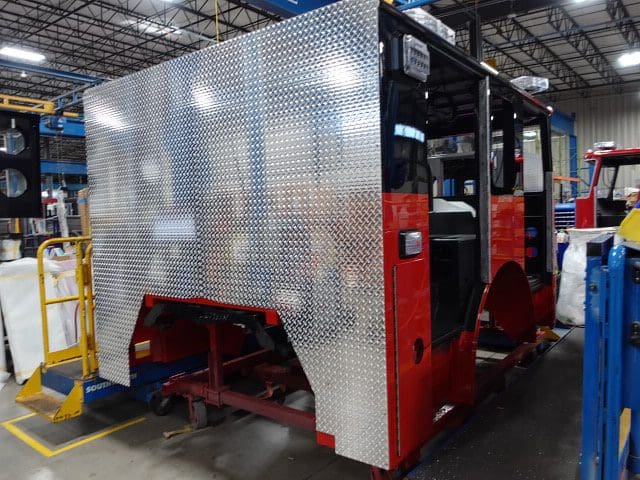

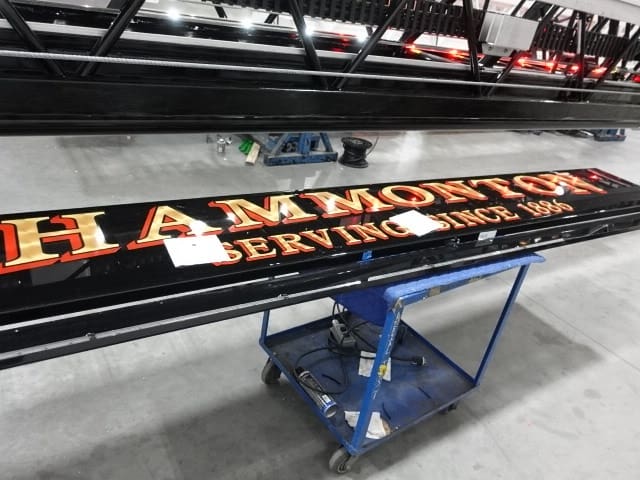

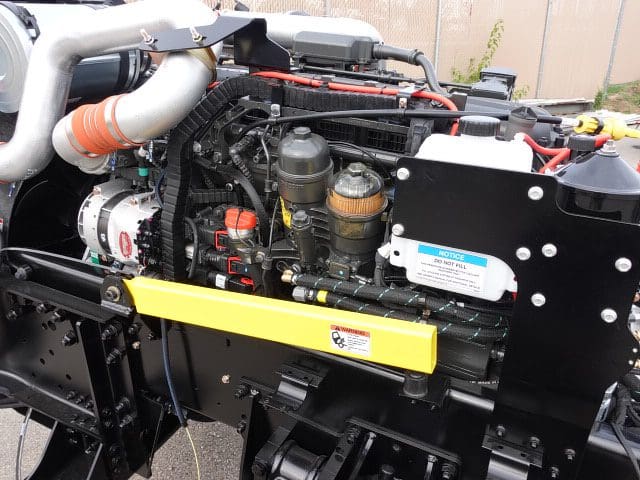

In this report, the aerial device completed initial assembly and was pinned to the apparatus followed by the completion of the aerial test. It was then released to quality and graphics where any remaining content will be applied.
12-20-24

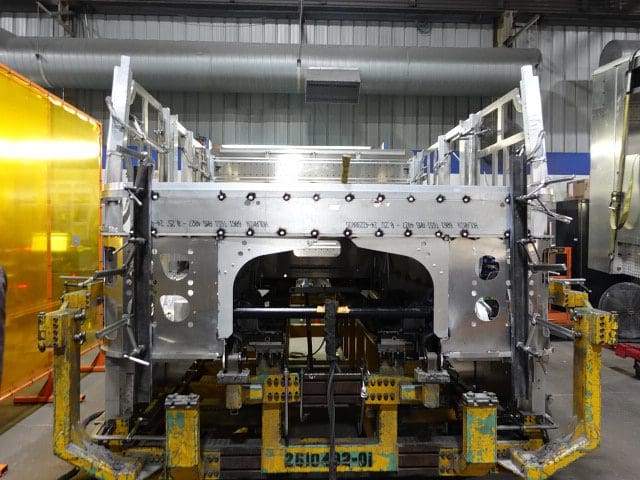

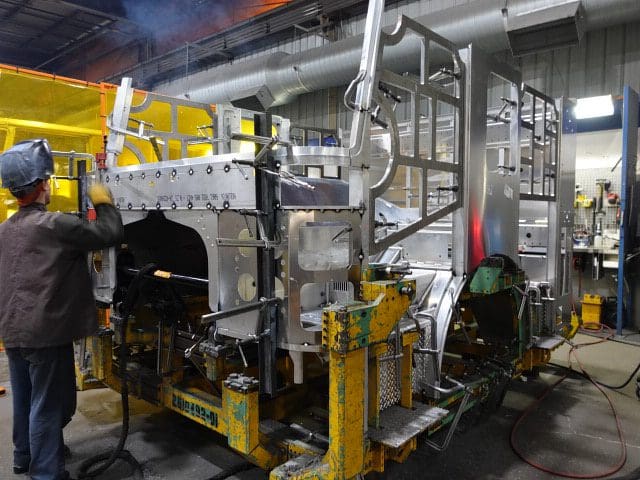

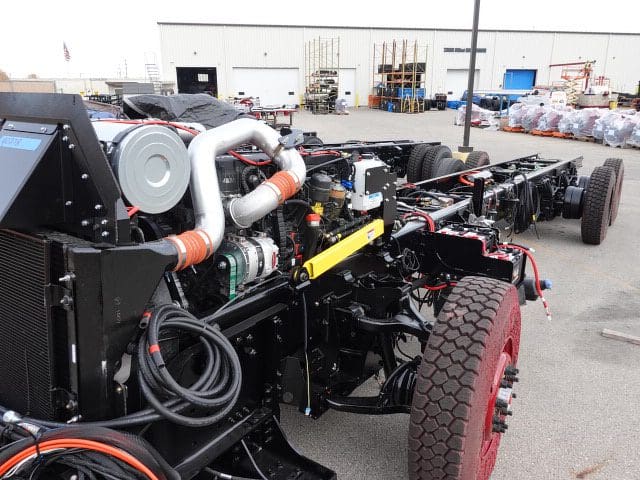

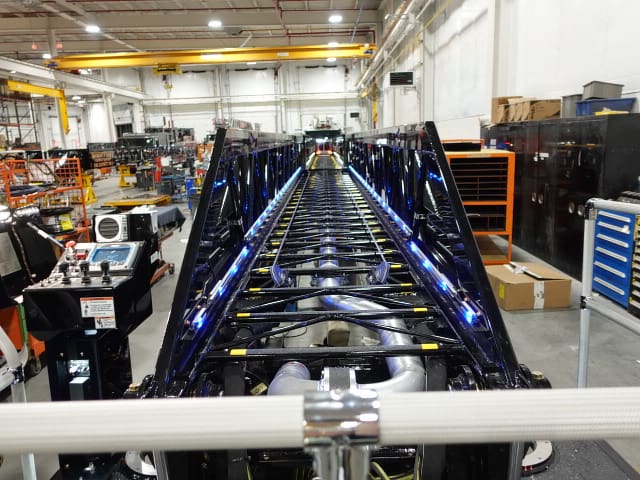

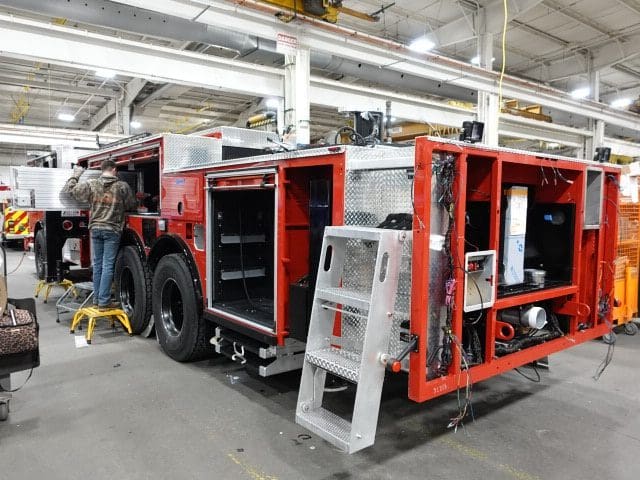

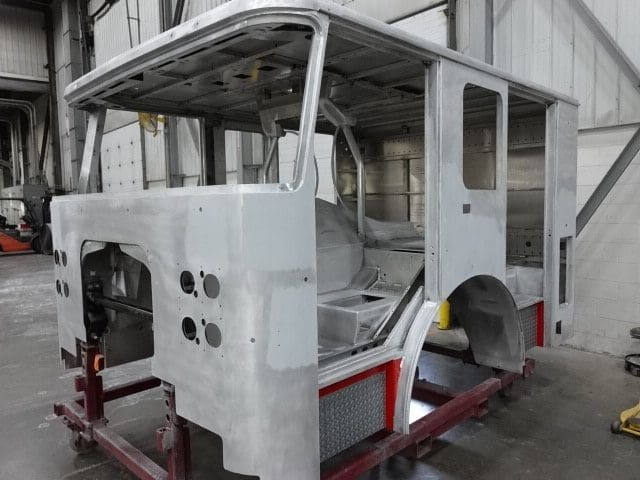

In this report, the apparatus remained staged while the aerial device began initial assembly.

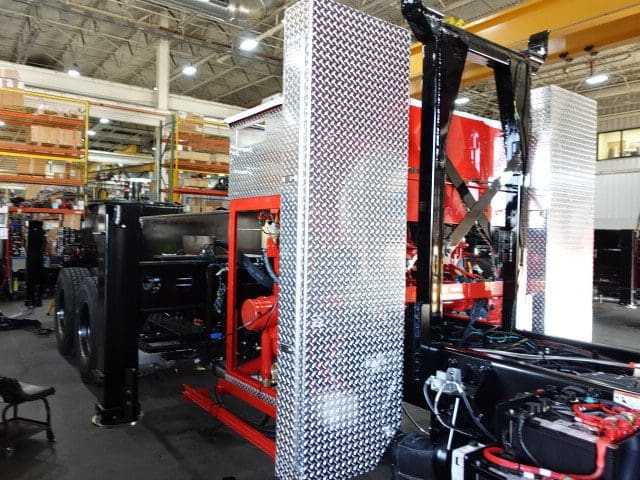

11-15-24

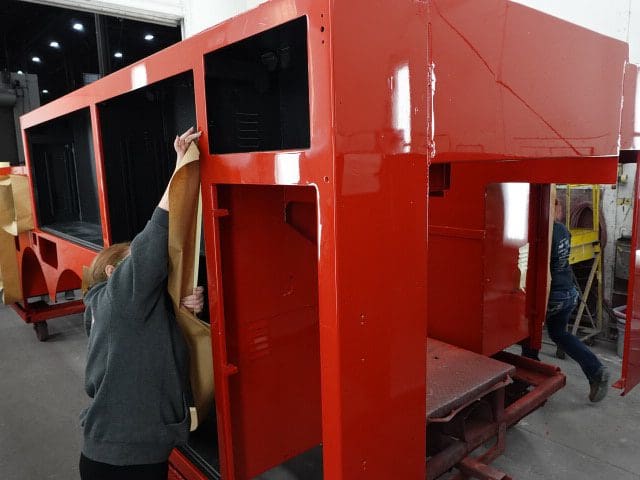

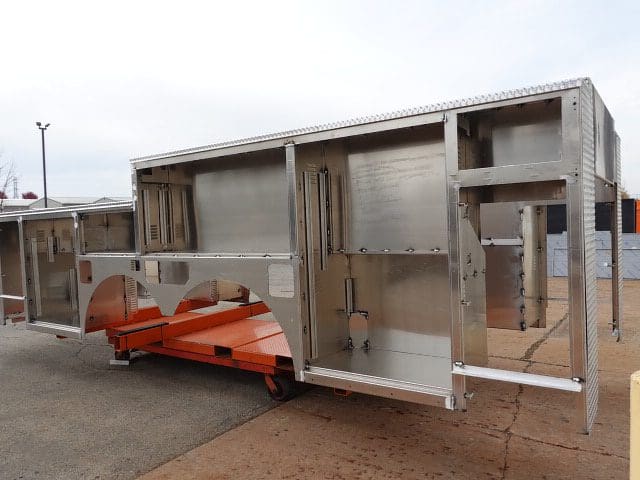

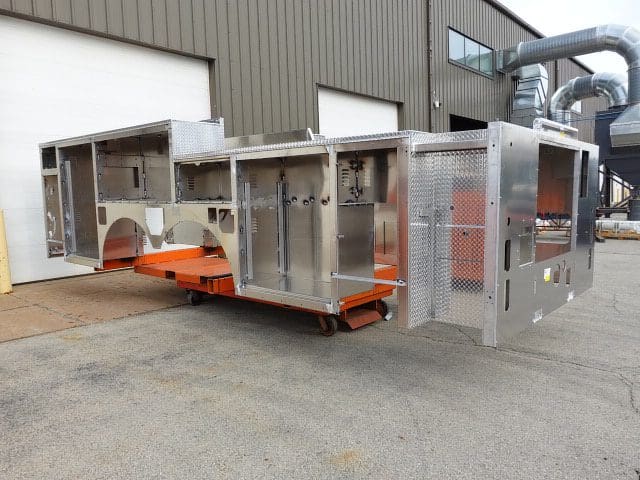

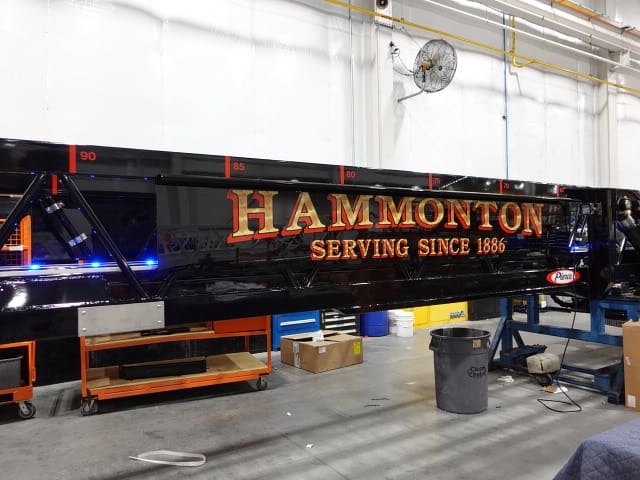

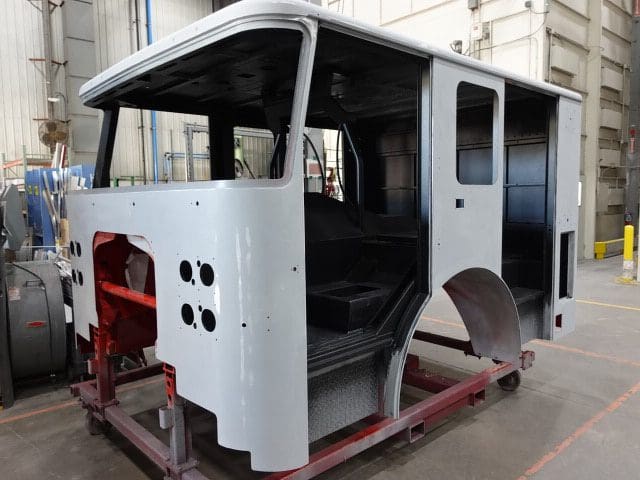

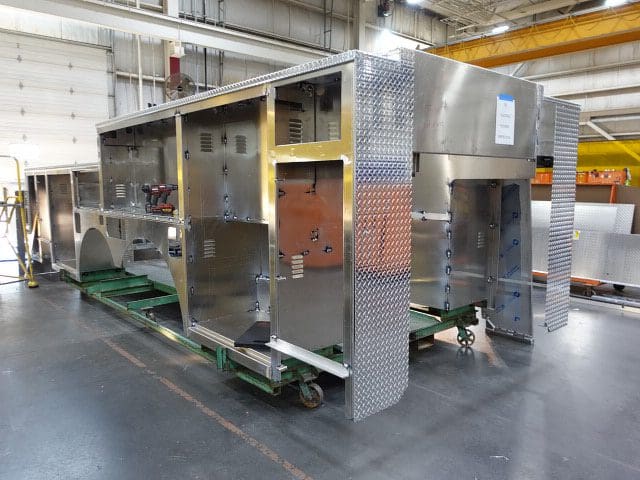

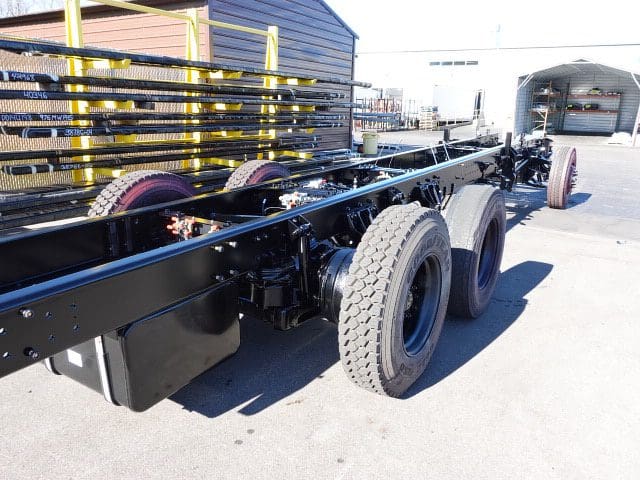

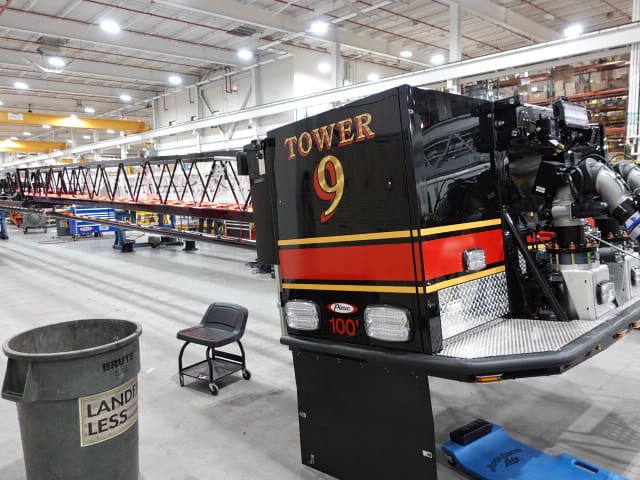

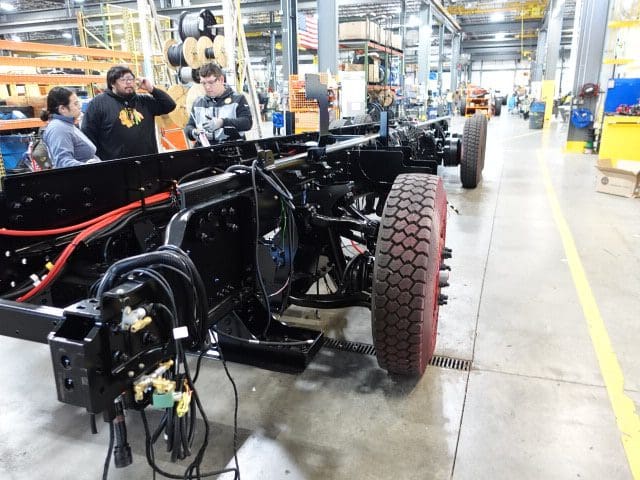

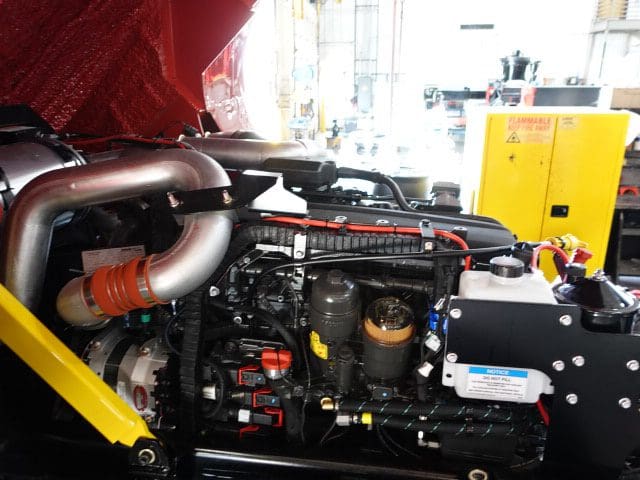

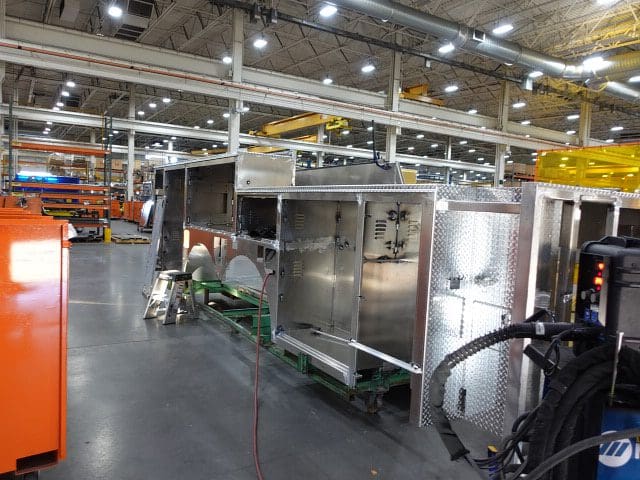

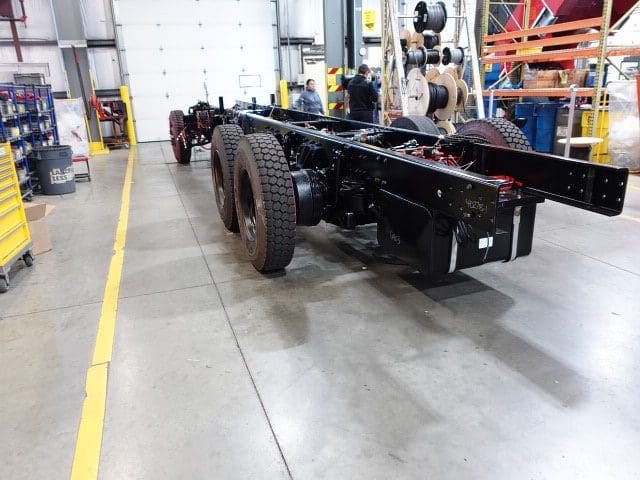

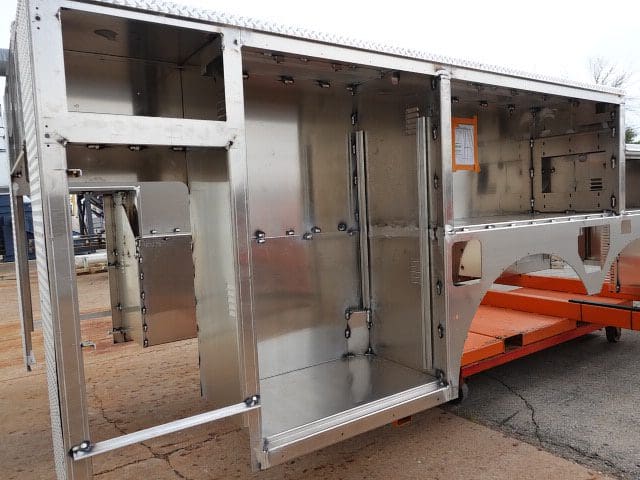

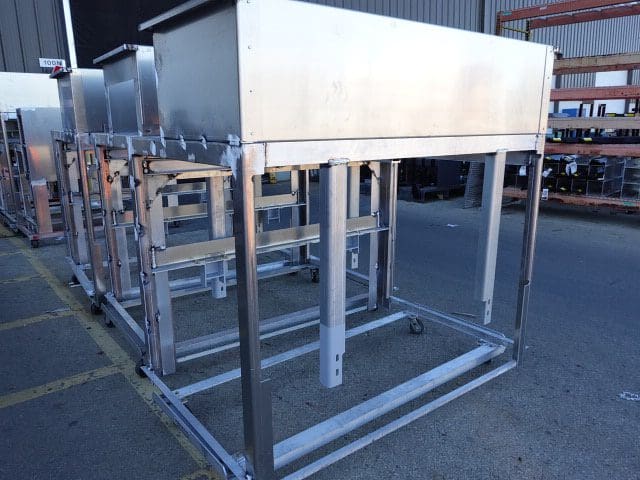

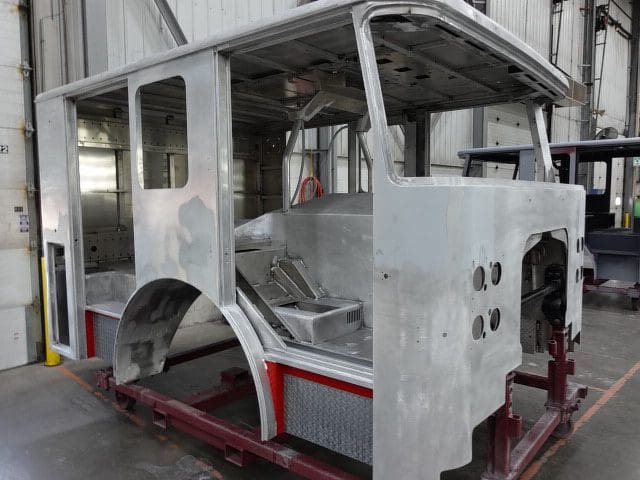

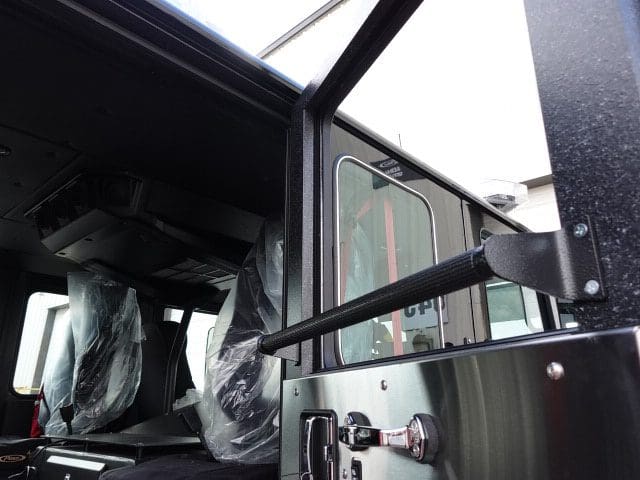

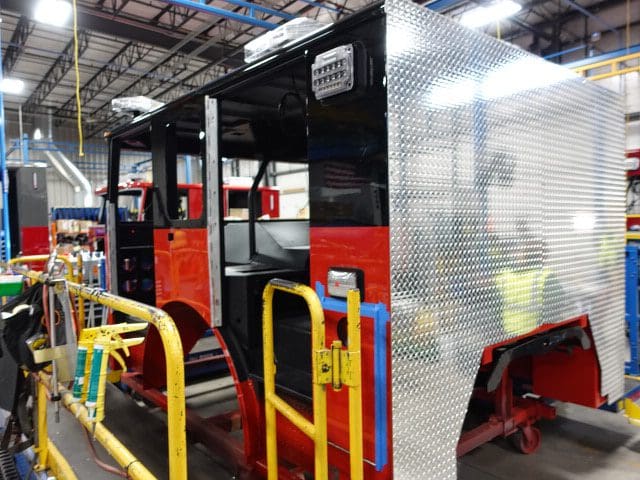

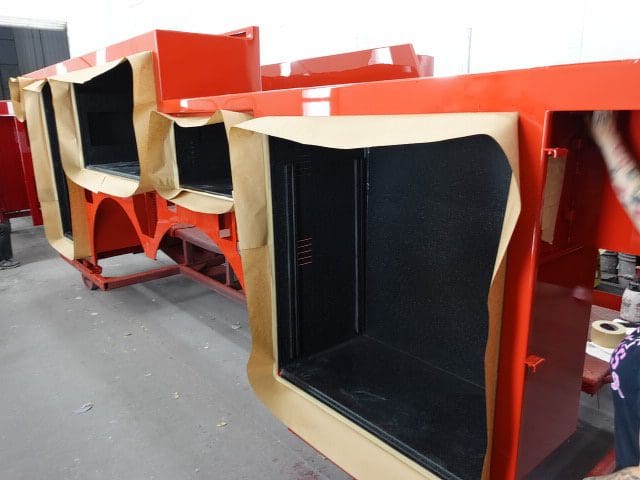

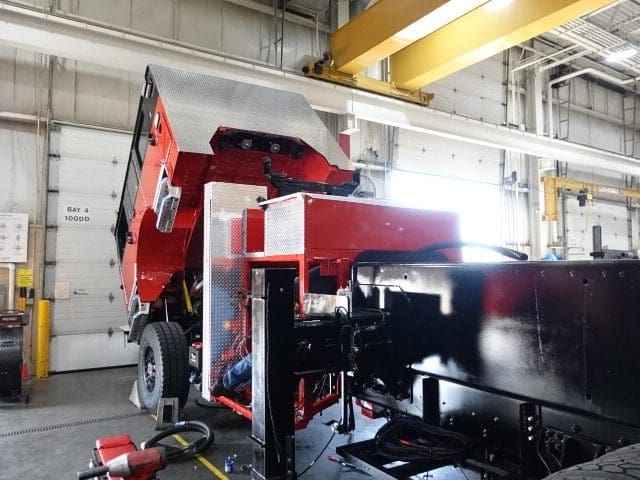

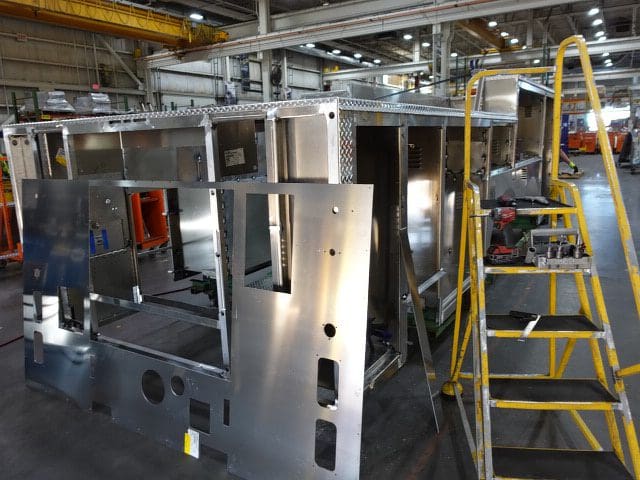

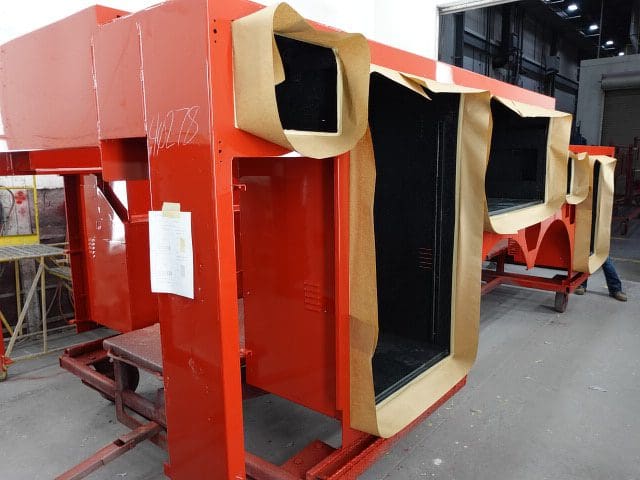

In this report, the body completed paint and initial assembly and was merged with the chassis followed by the start of final assembly.

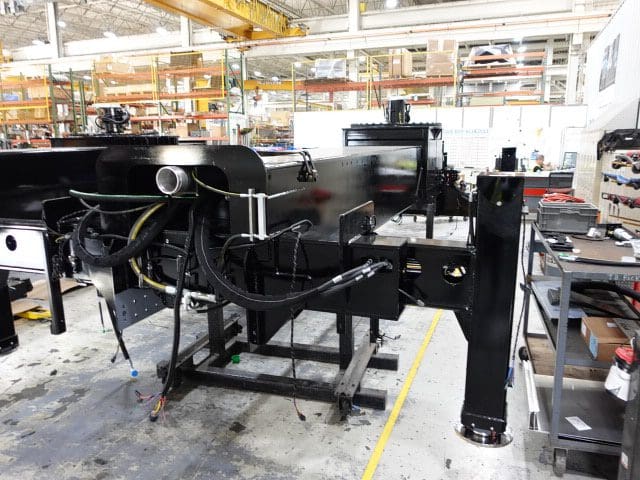

11-01-24

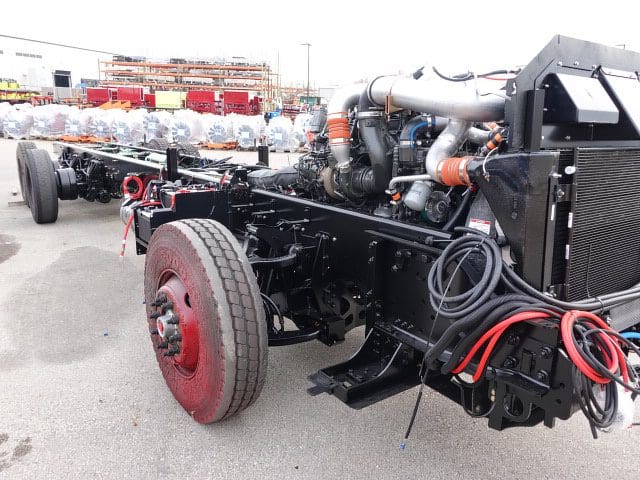

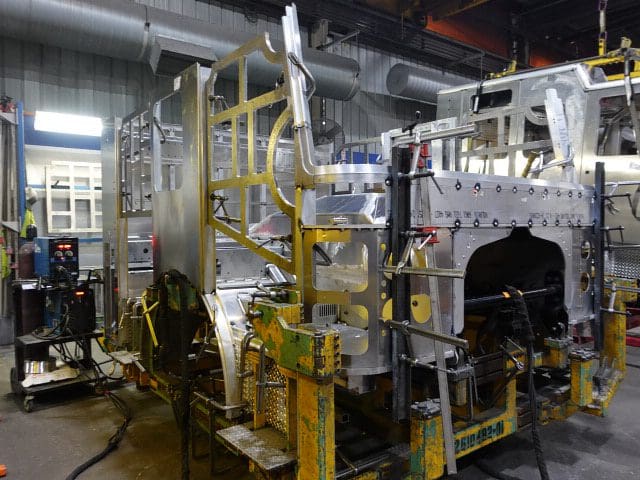

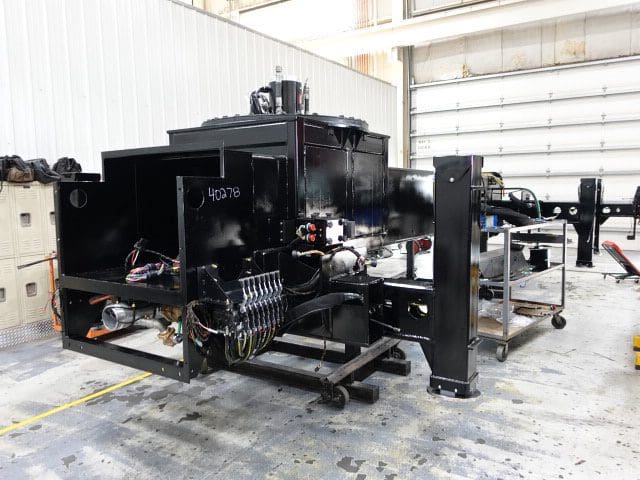

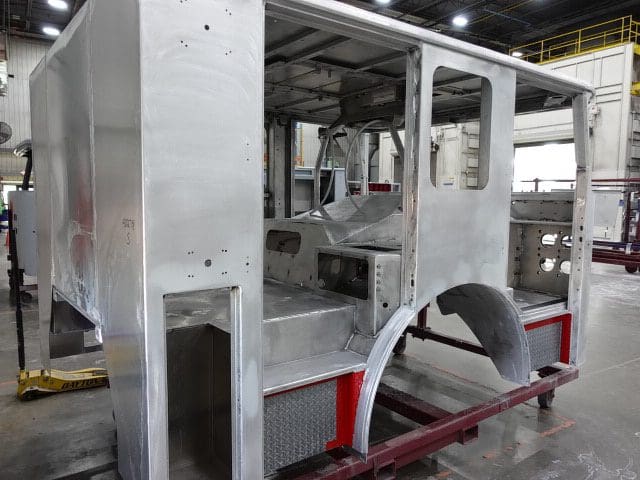

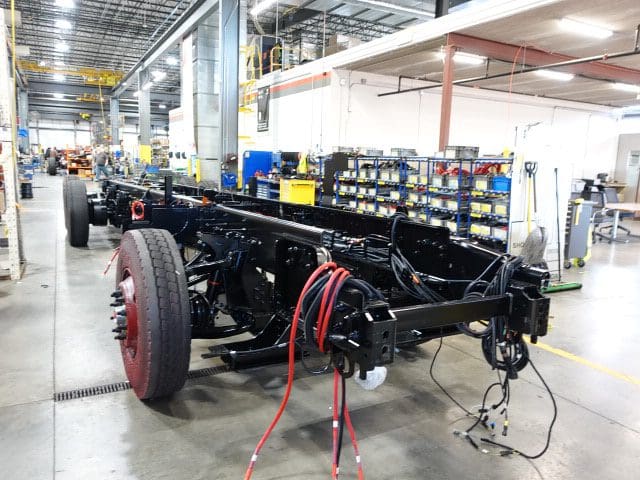

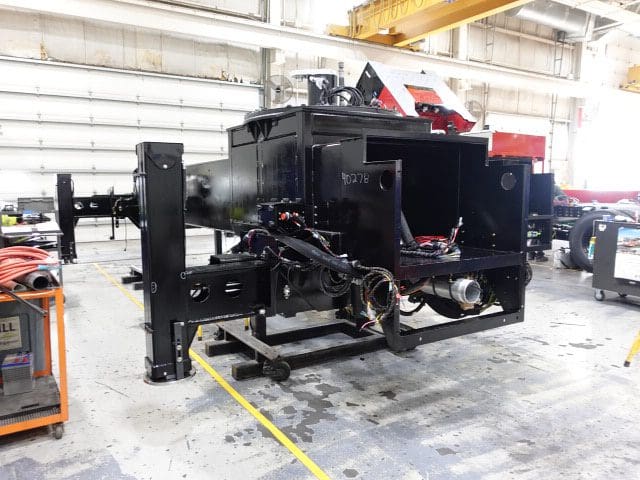

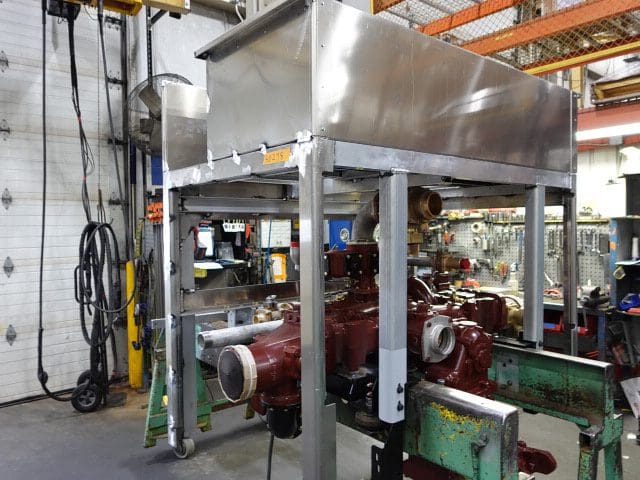

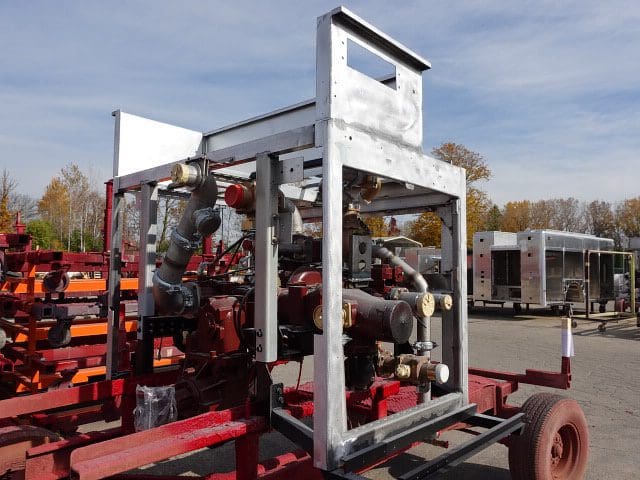

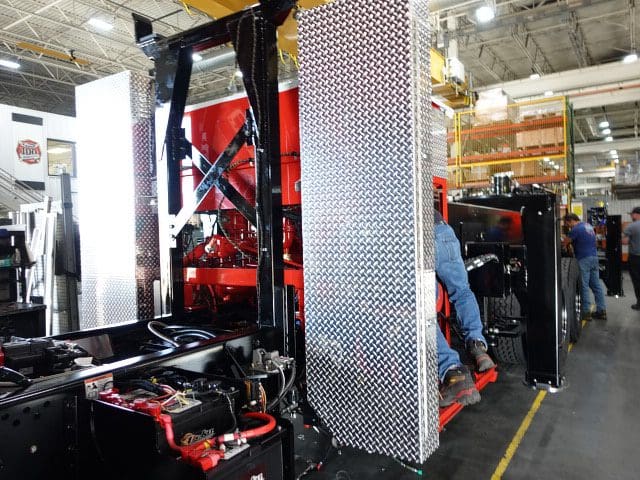

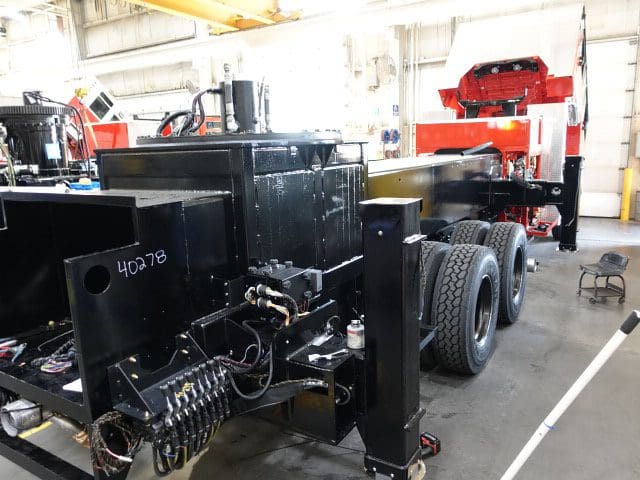

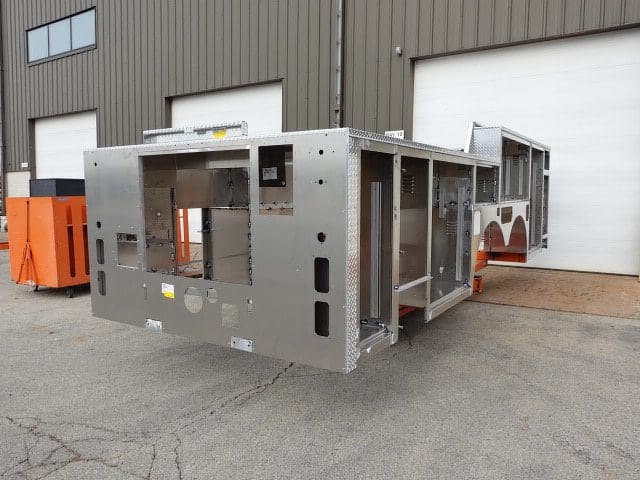

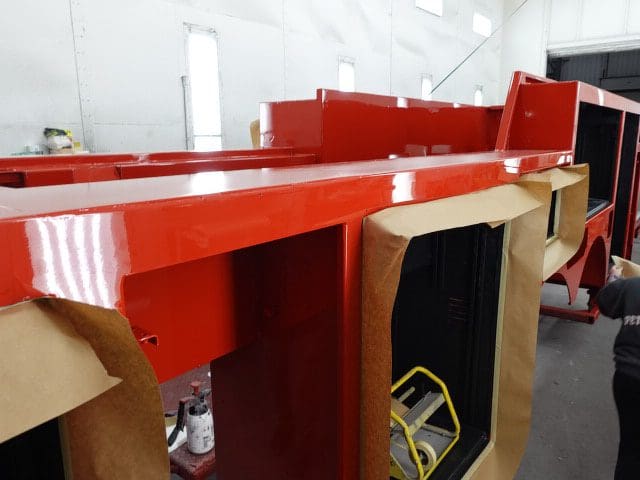

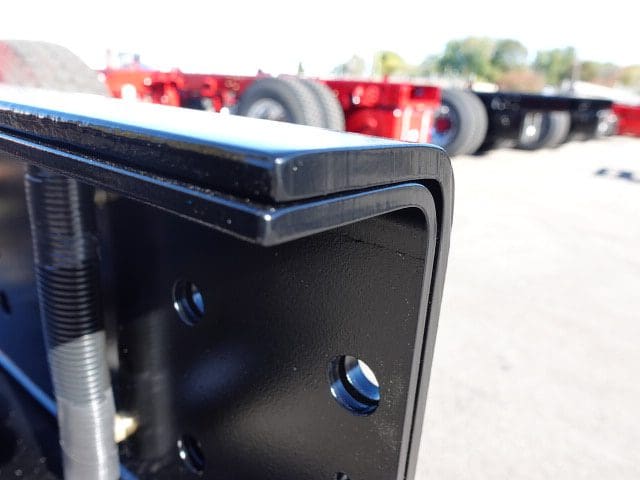

In this report, the cab and pump house completed initial assembly and were merged with the frame along with the pedestal while the body began the paint process.
10-25-24

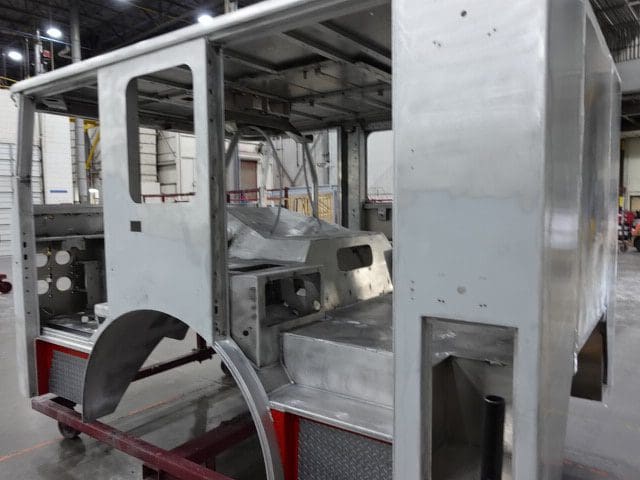

In this report, the cab continued initial assembly, the frame build continued, the pump house continued initial assembly, the pedestal began initial assembly, and the body completed the fabrication process.
10-18-24

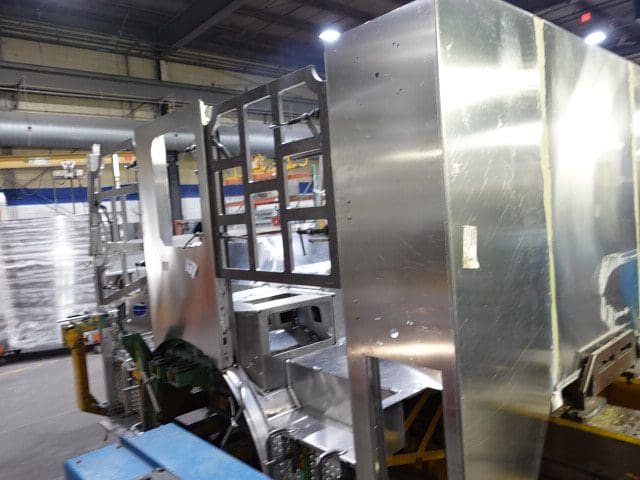

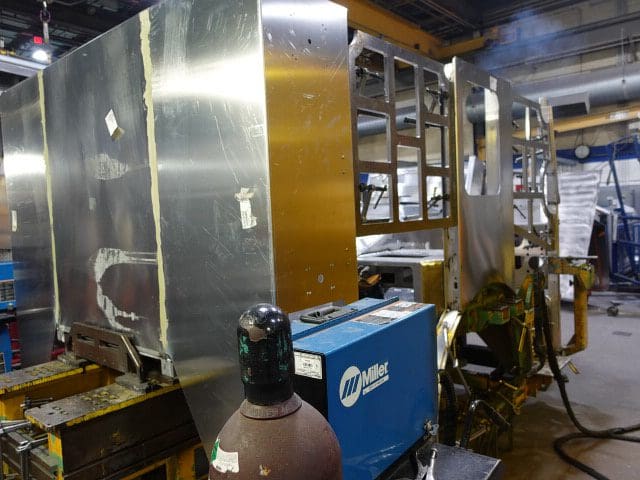

In this report, the cab completed paint and began initial assembly, the frame build continued, the pump house began initial assembly, and the body began fabrication.

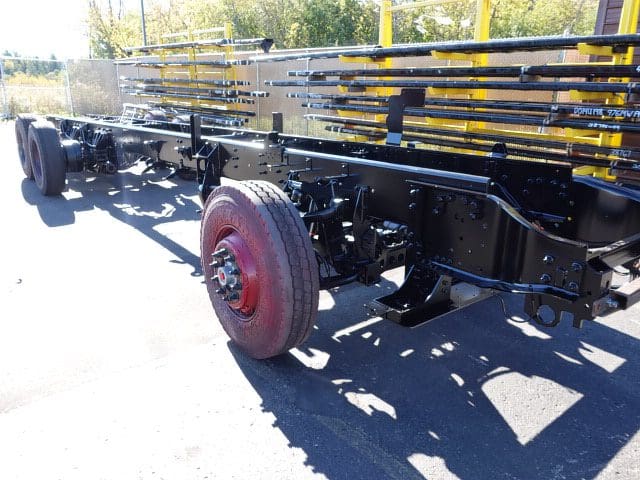

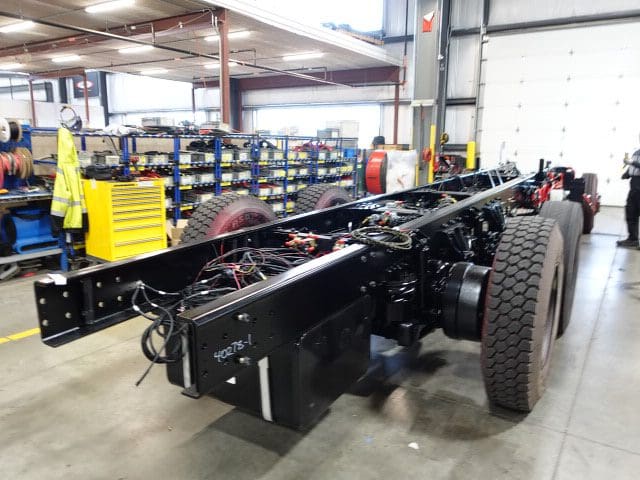

10-11-24

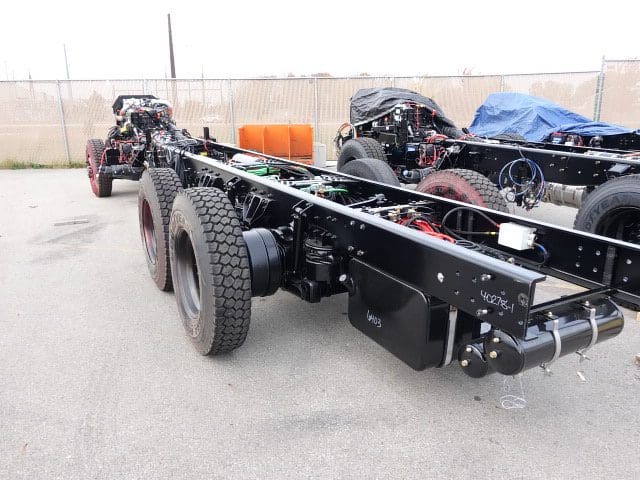

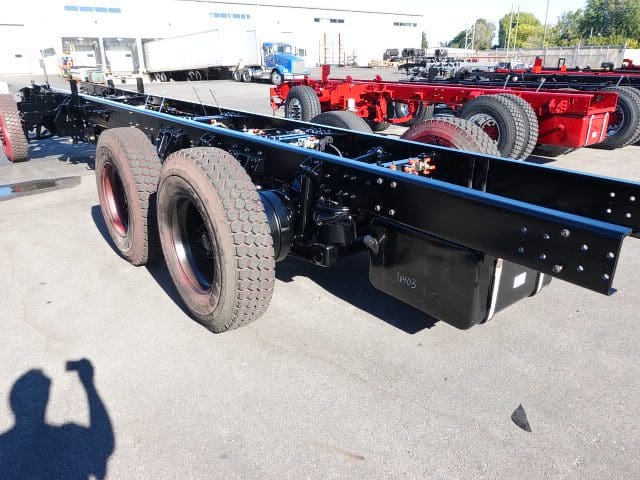

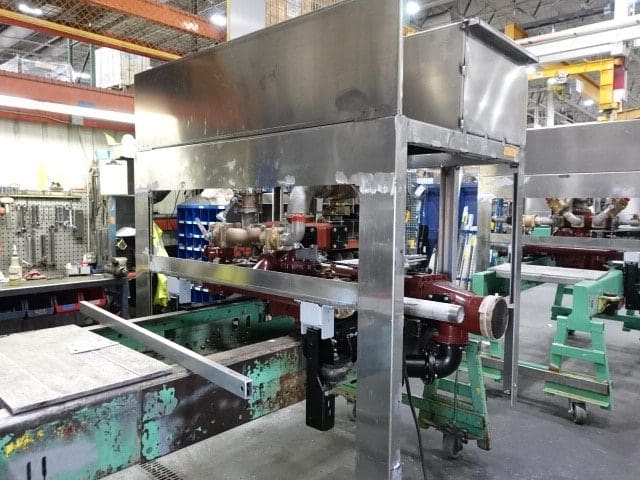

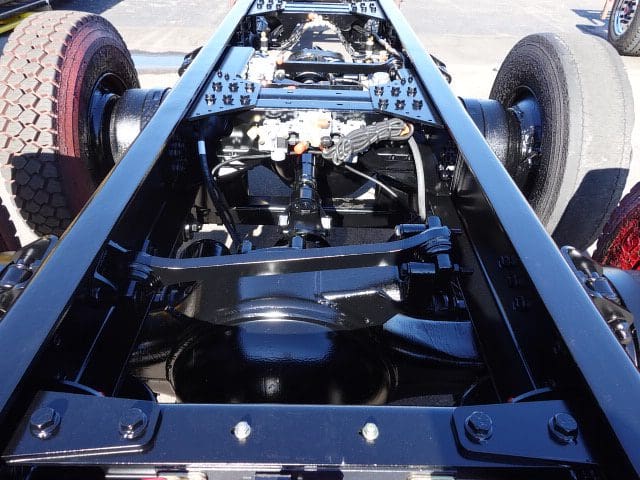

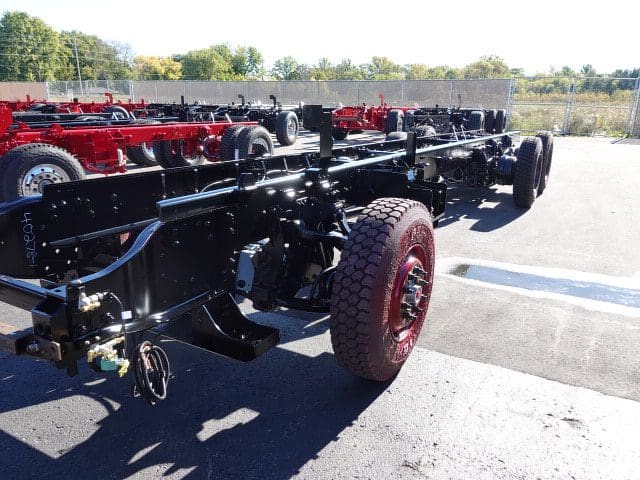

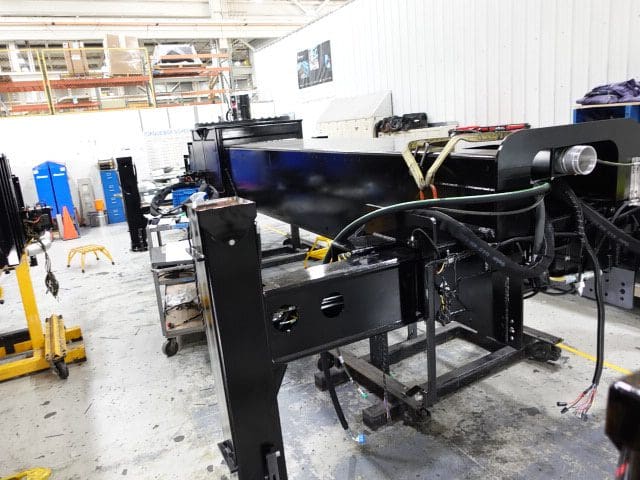

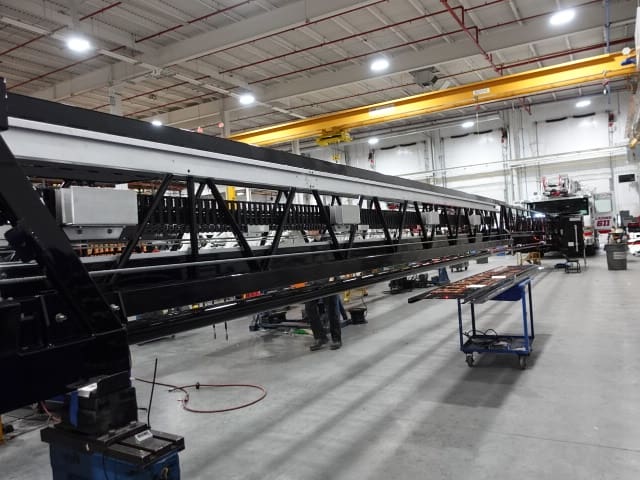

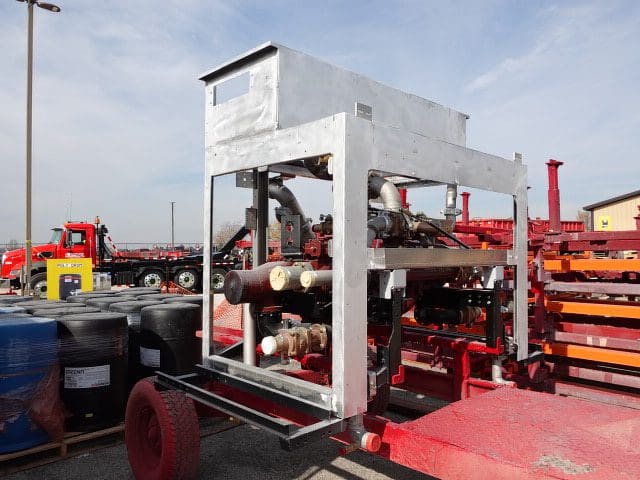

In this report, the cab continued through paint, the frame build began, and the pump house structure was fabricated.
09-27-24
This new Pierce apparatus is now in production!

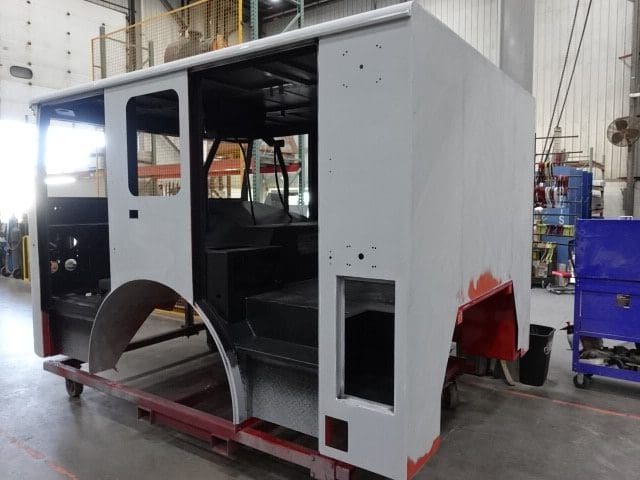

In this report, the cab began fabrication.
