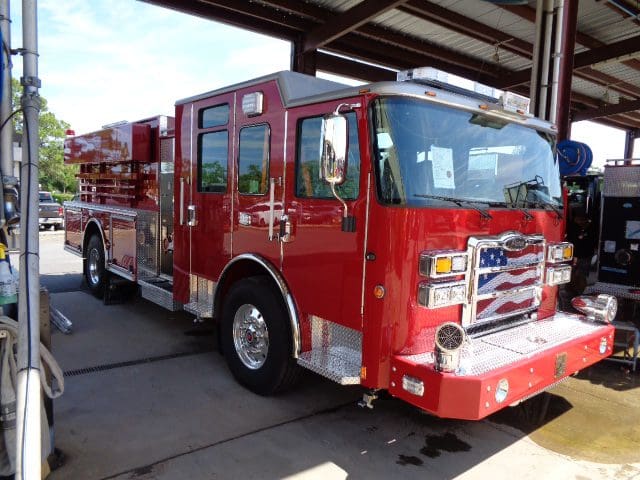

04-05-24

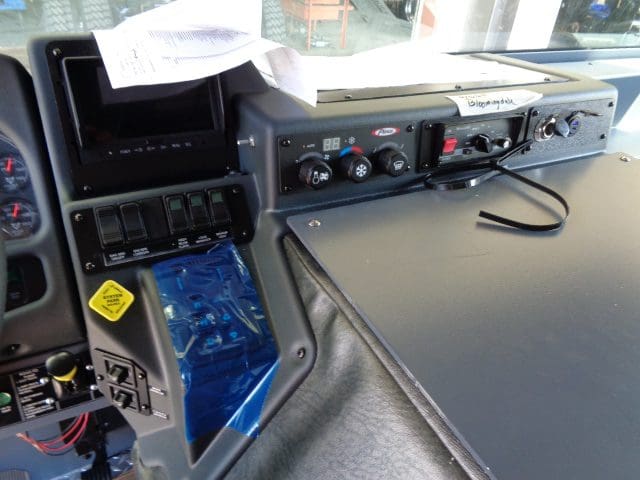

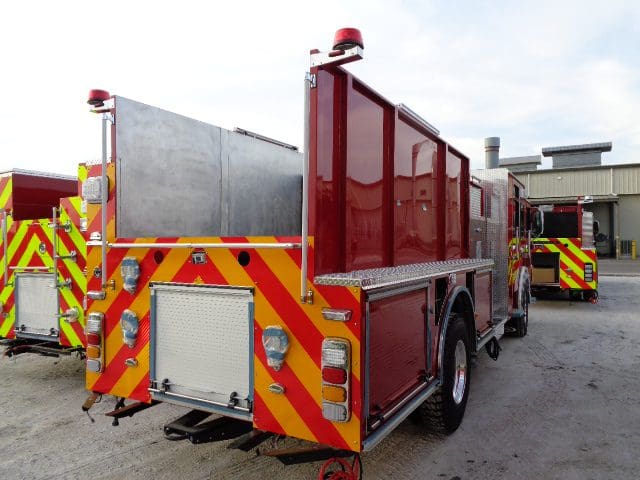

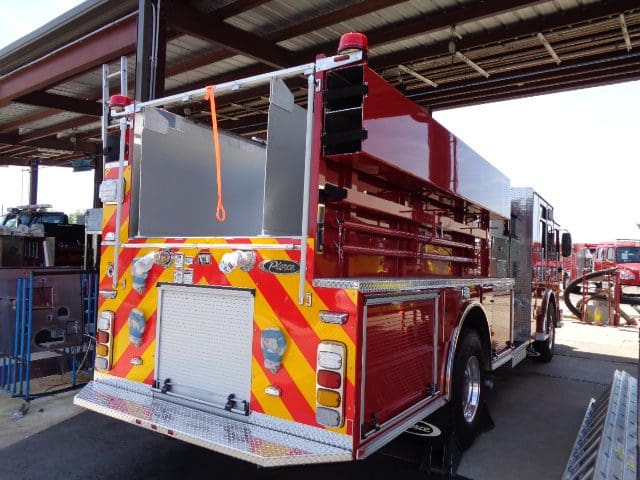

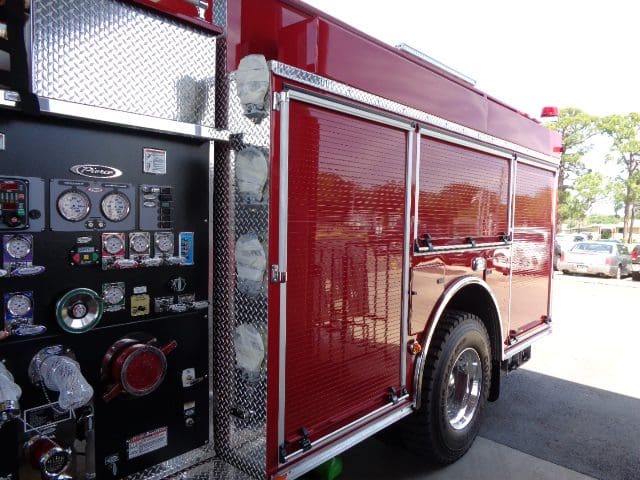

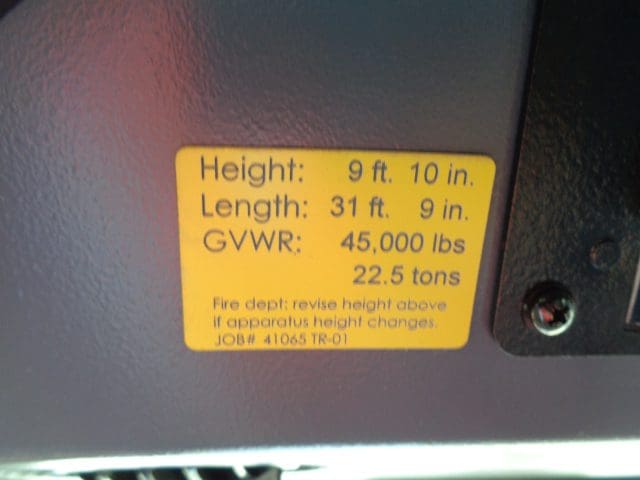

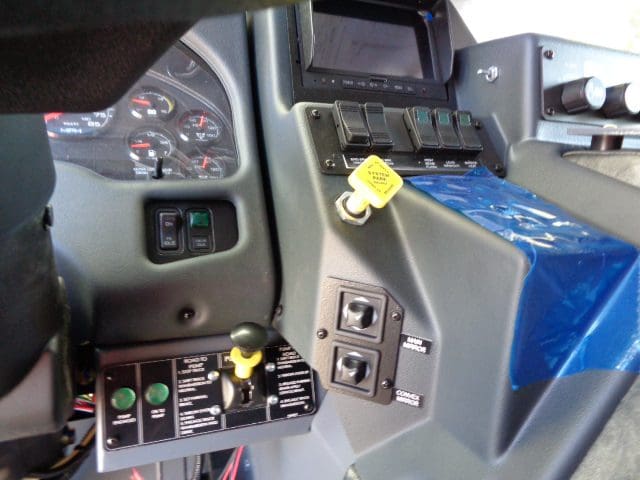

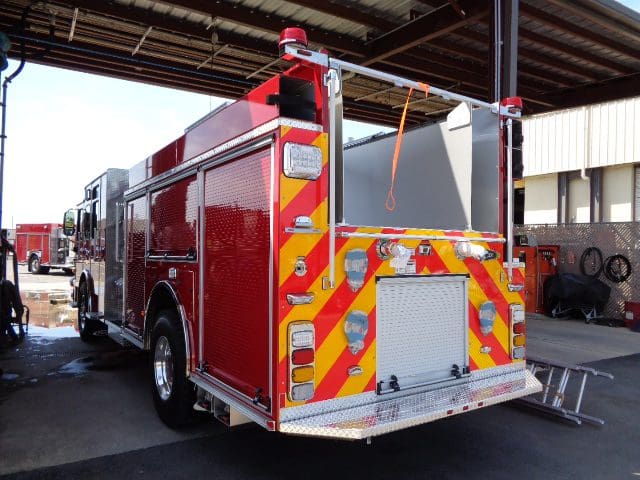

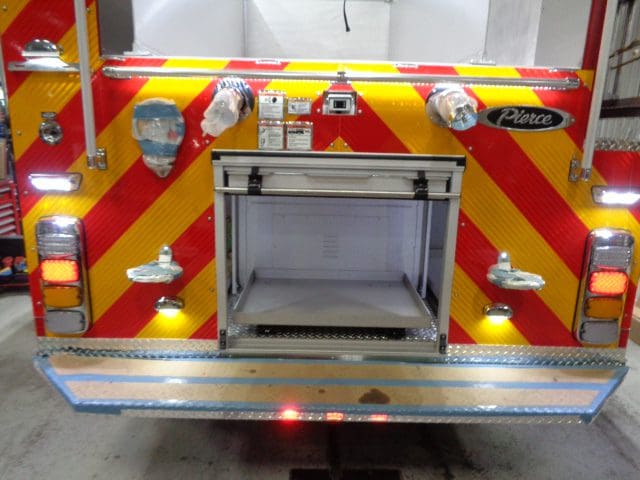

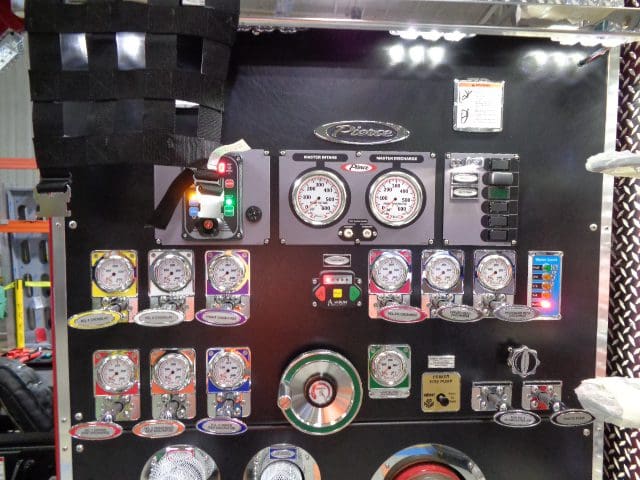

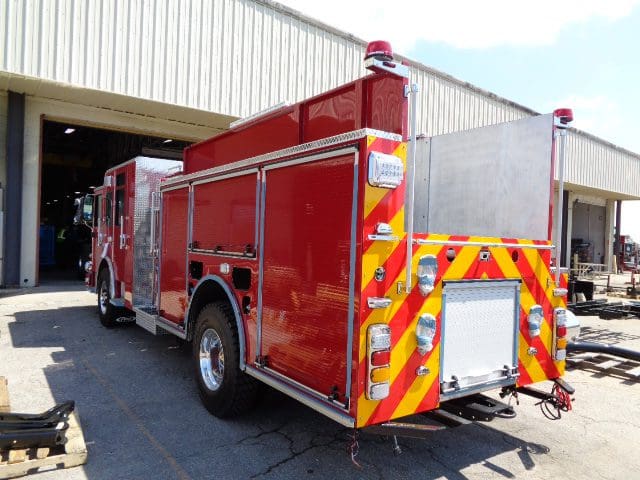

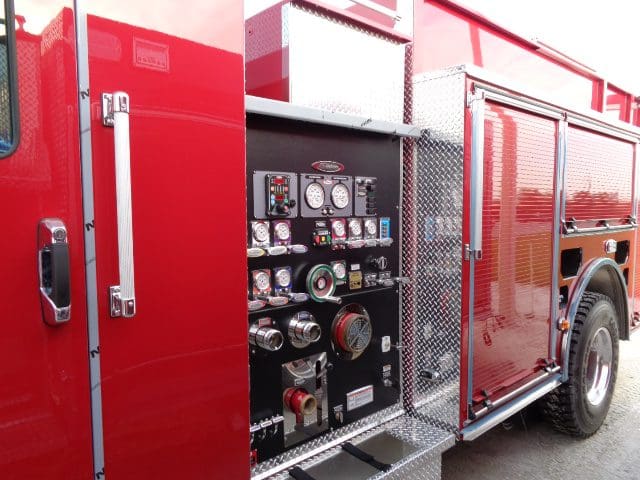

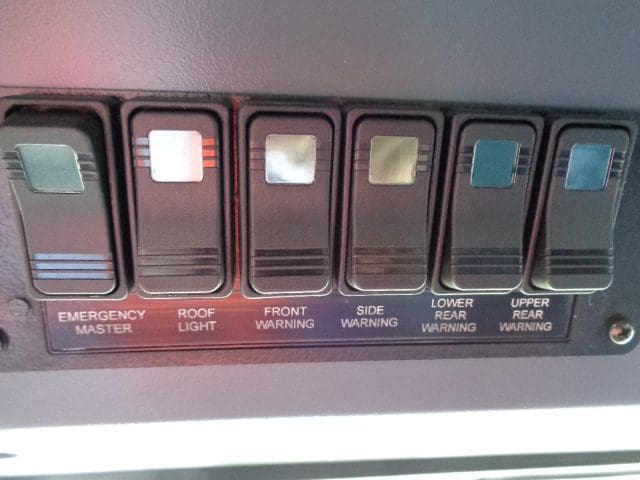

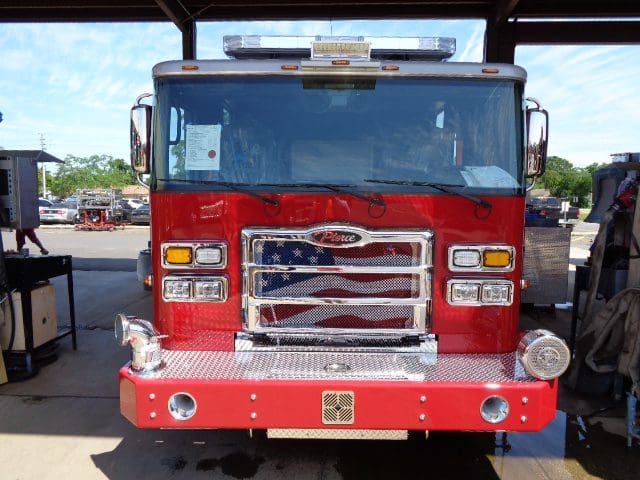

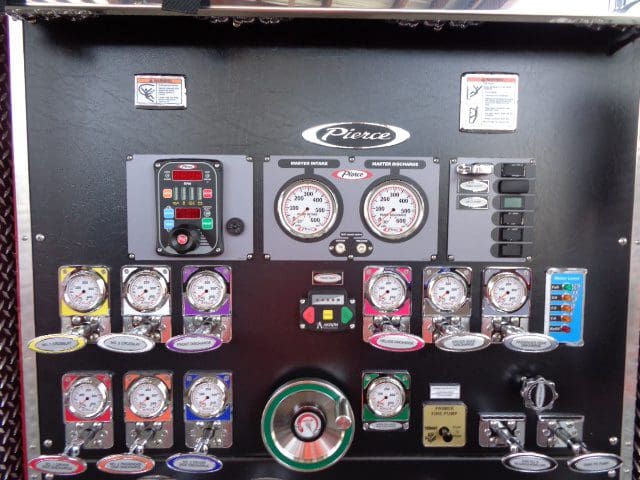

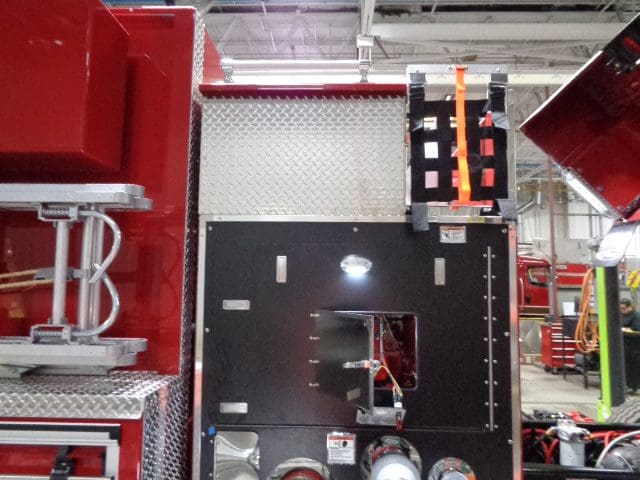

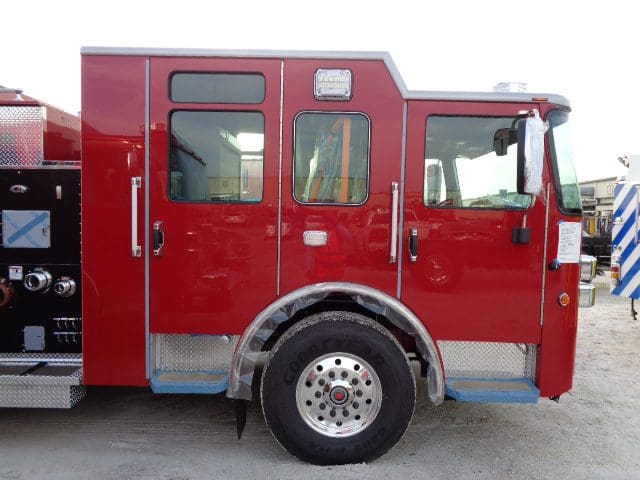

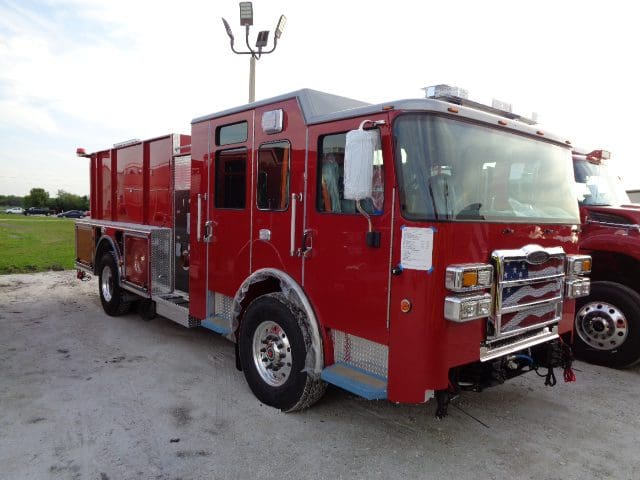

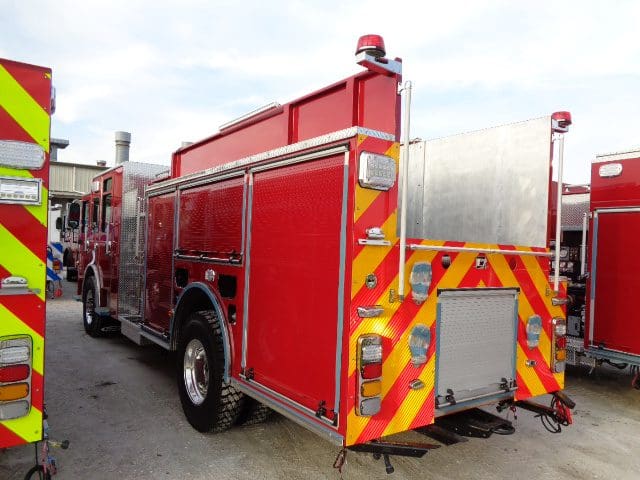

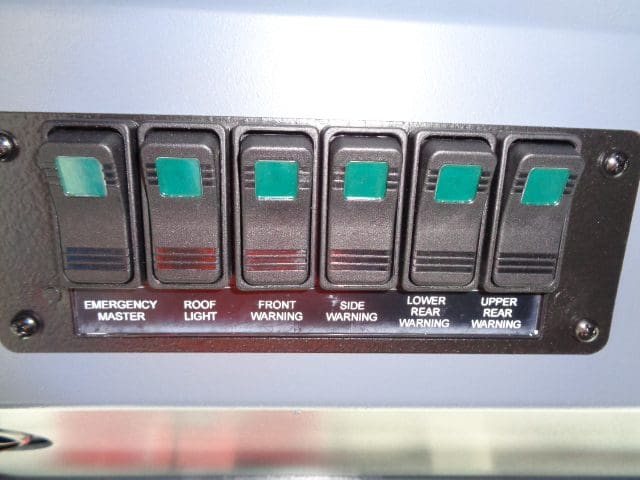

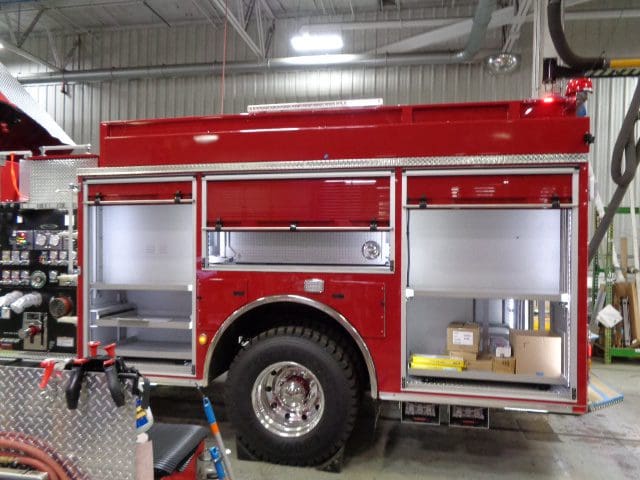

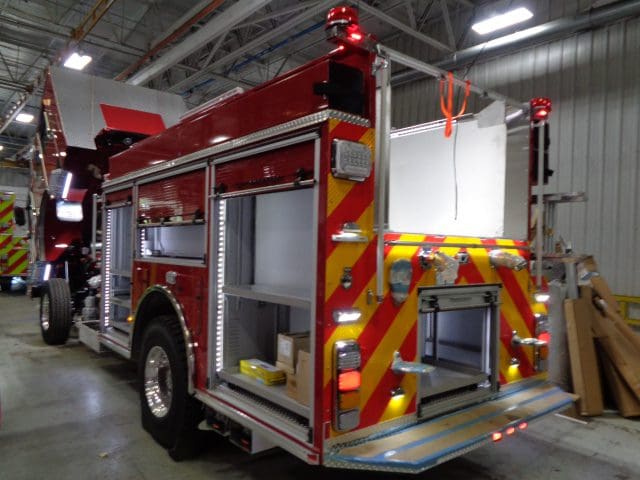

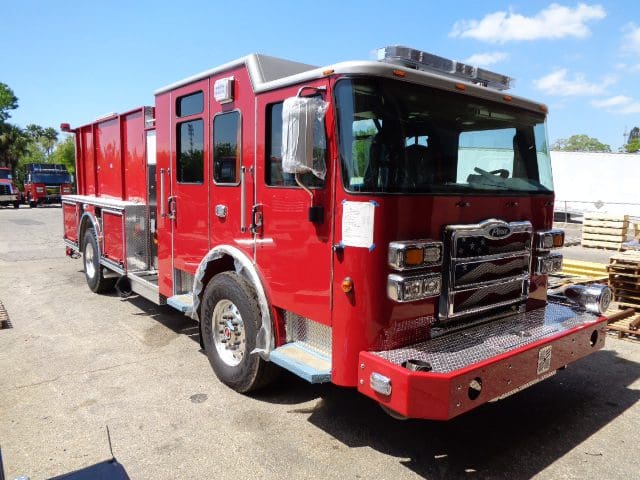

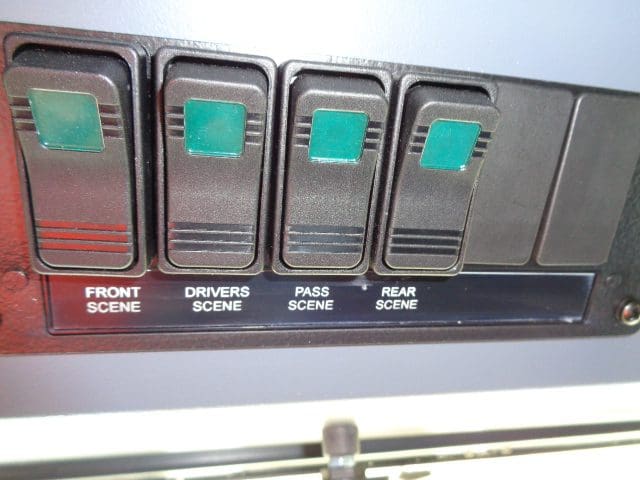

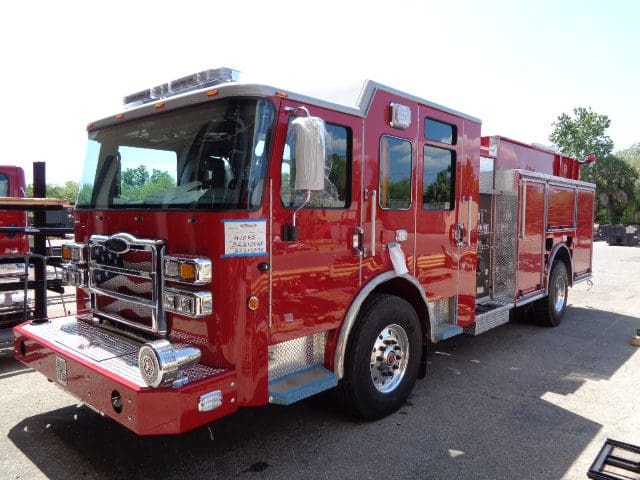

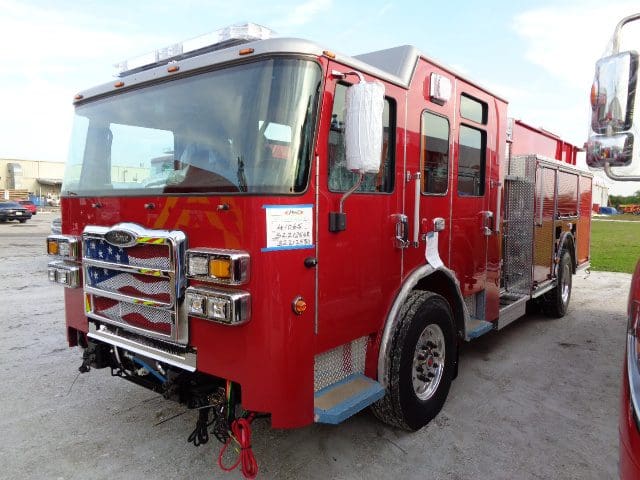

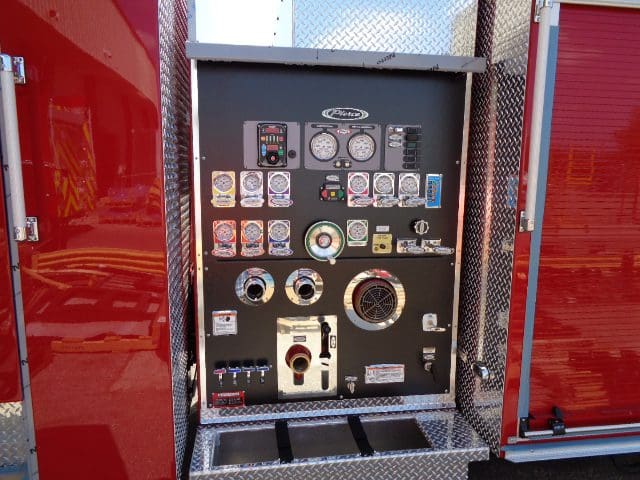

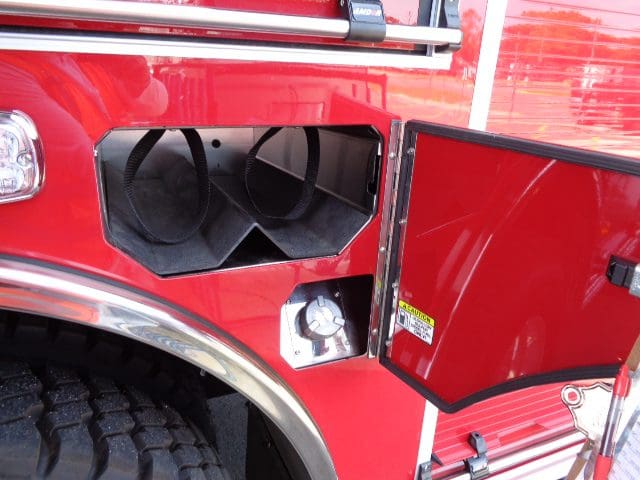

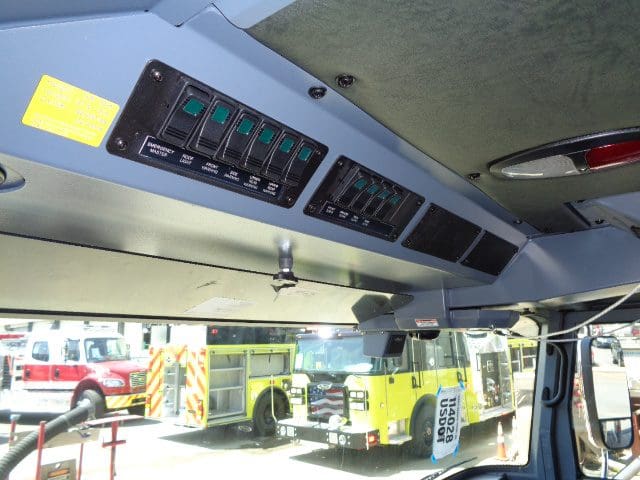

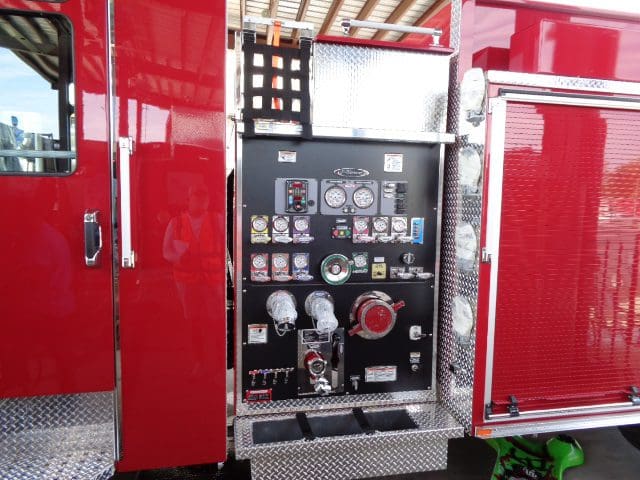

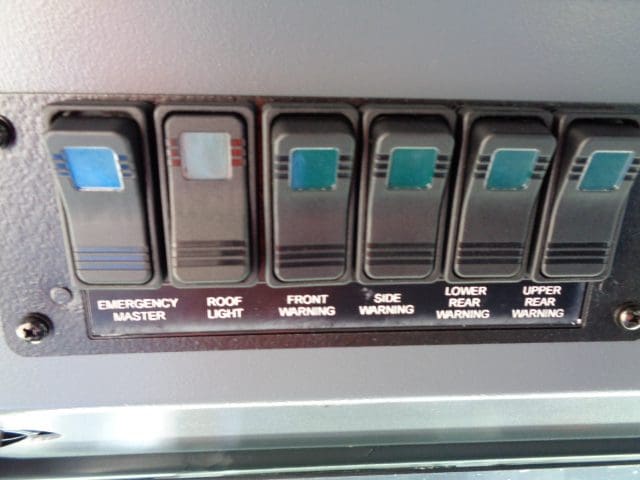

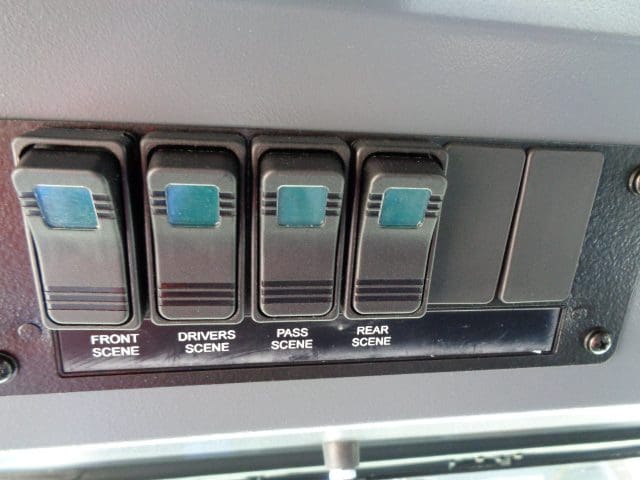

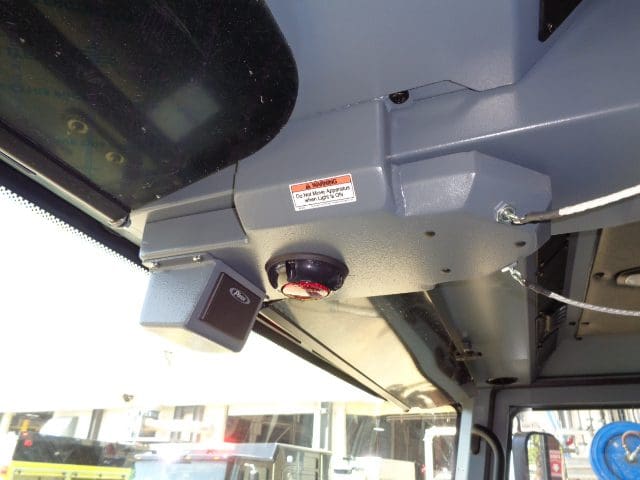

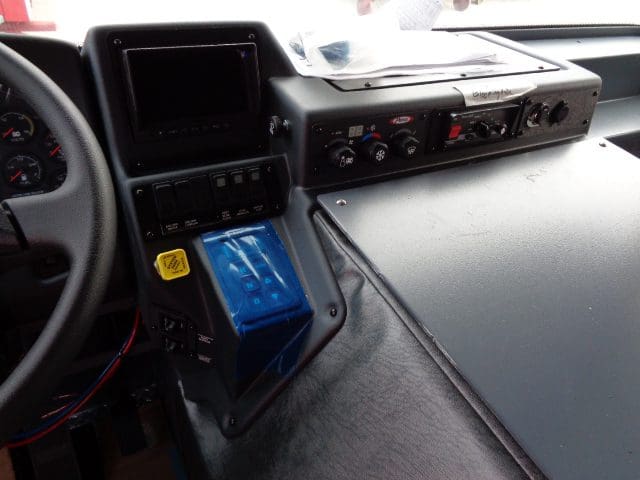

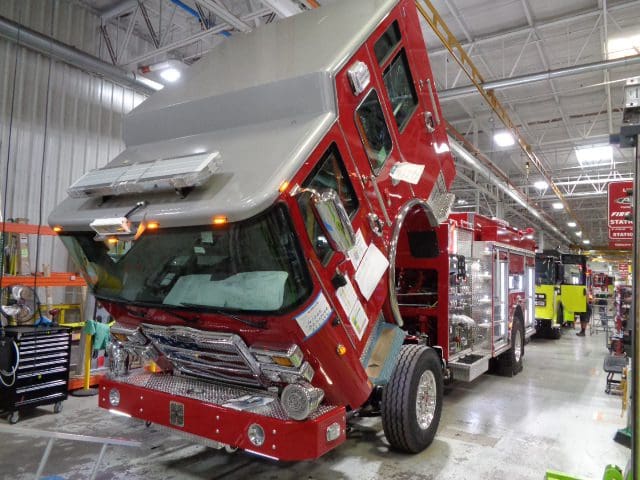

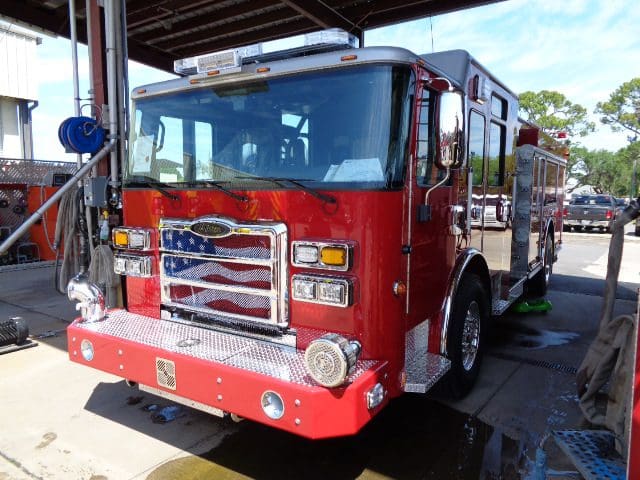

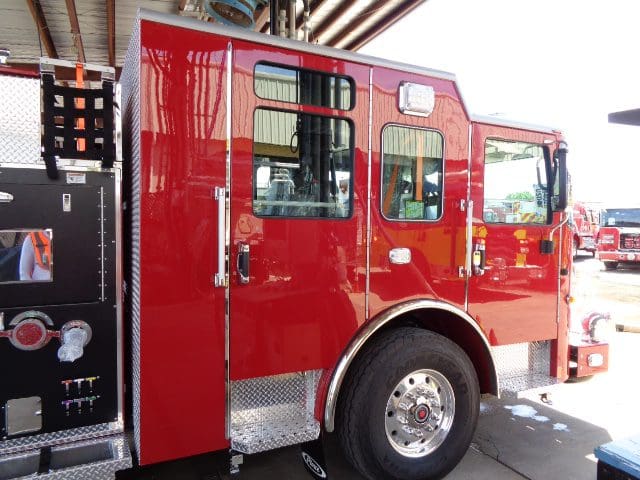

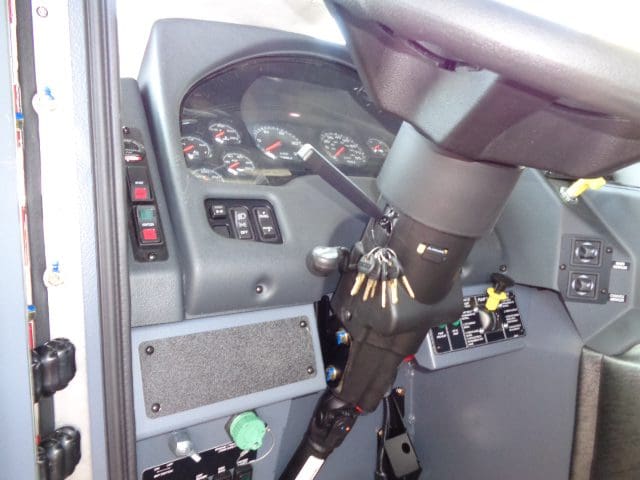

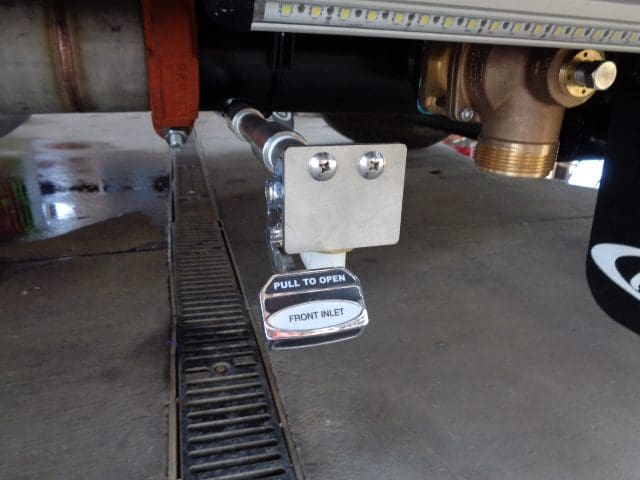

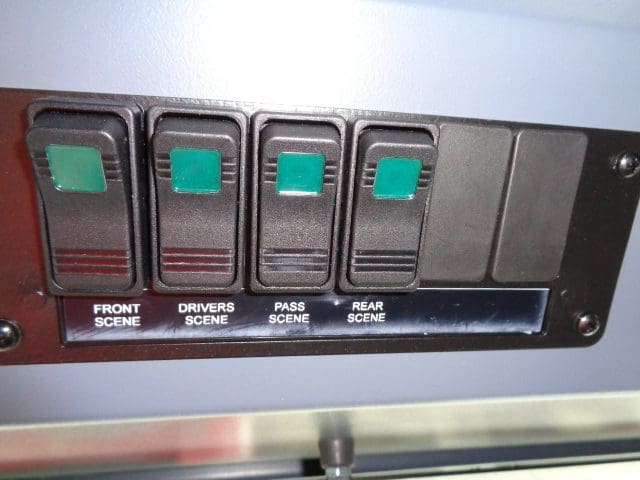

In this report, the apparatus was released for initial and third-party pump testing. the apparatus began final product evaluation, and any remaining content will be installed prior to release and customer acceptance. This is the last scheduled report.
04-02-24

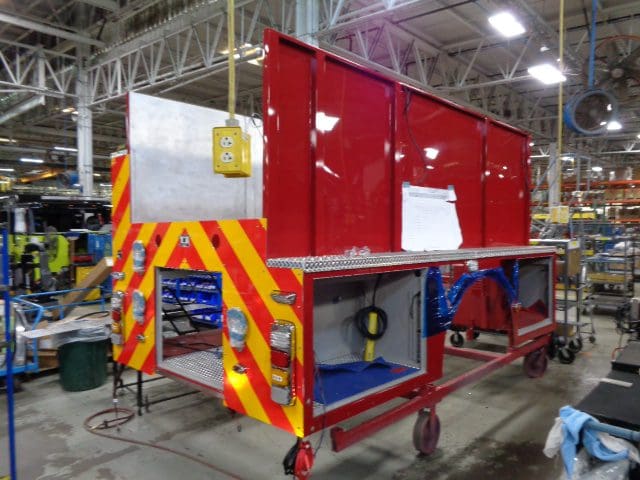

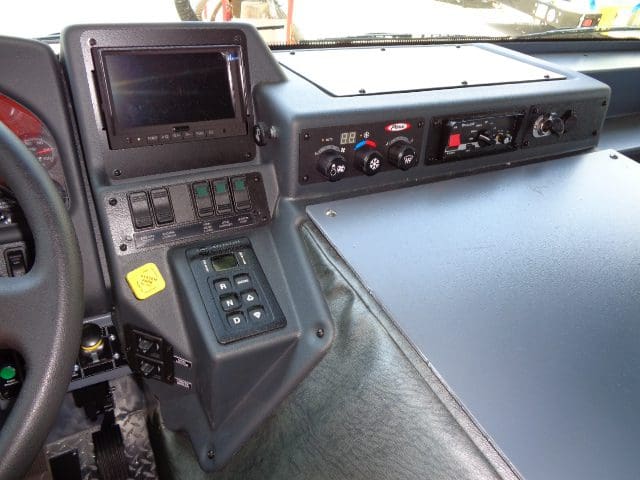

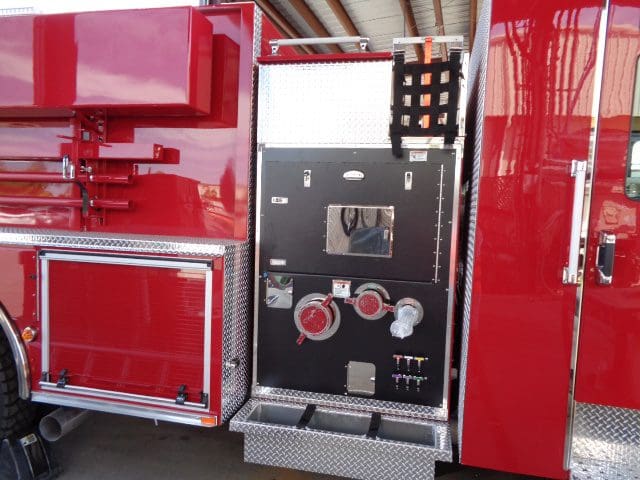

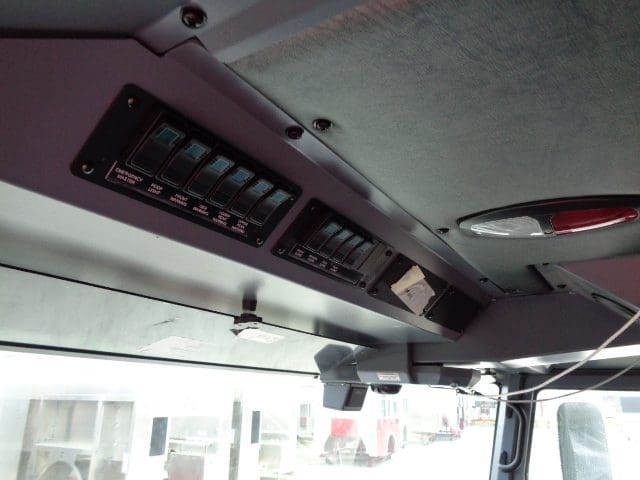

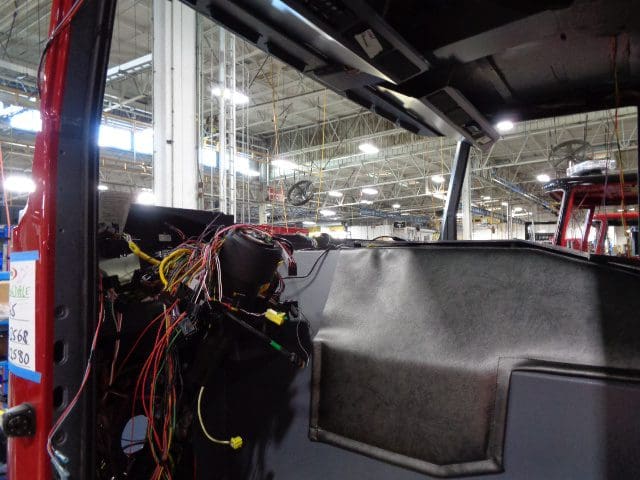

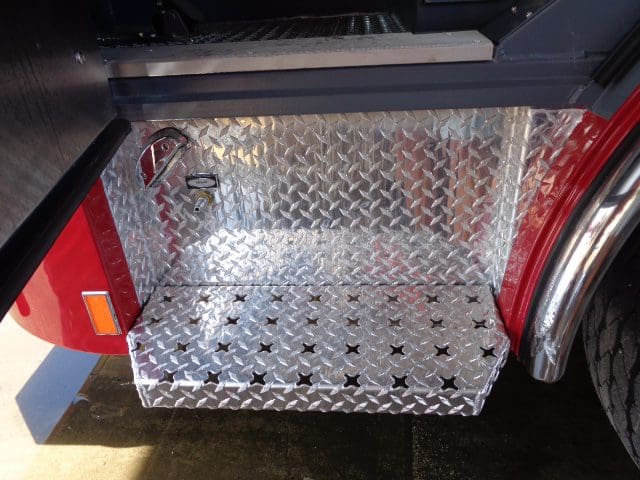

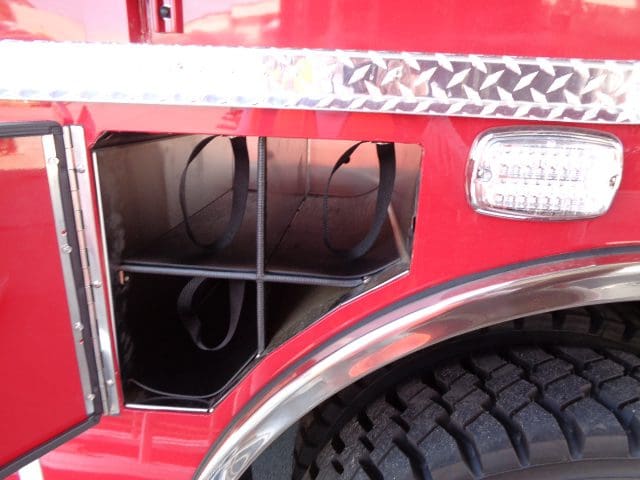

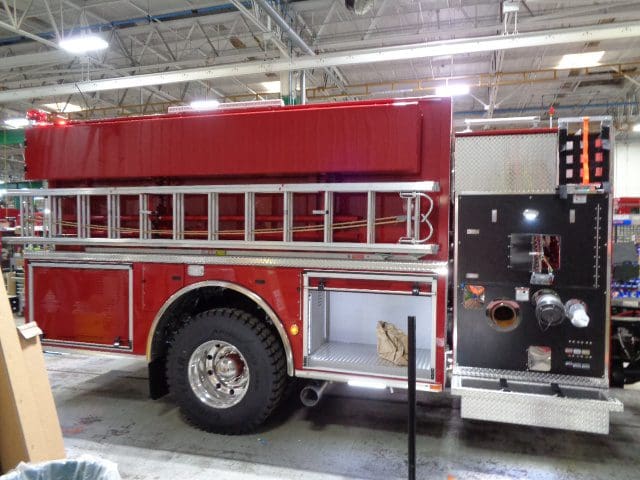

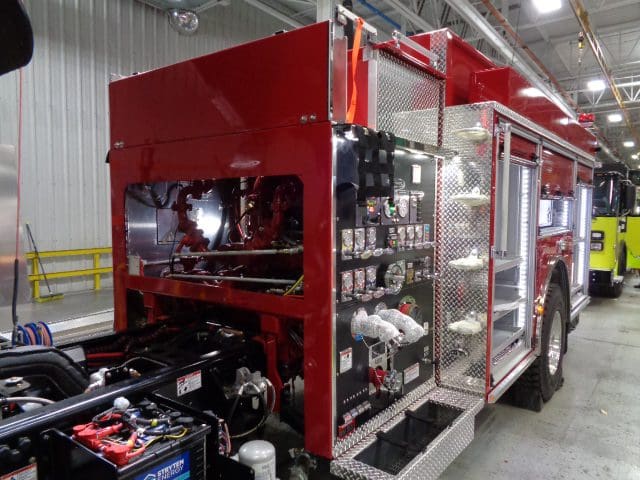

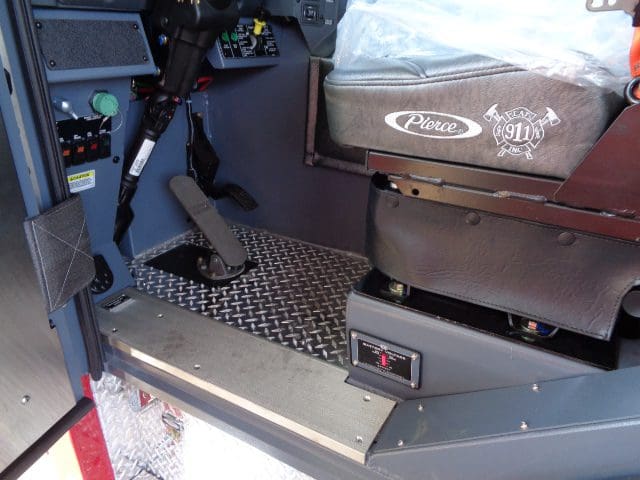

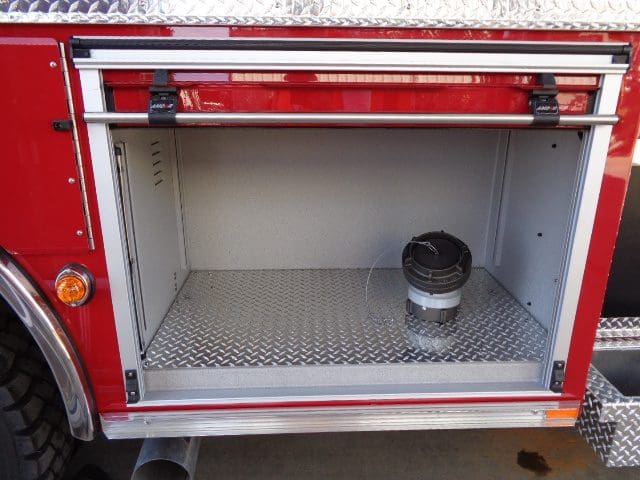

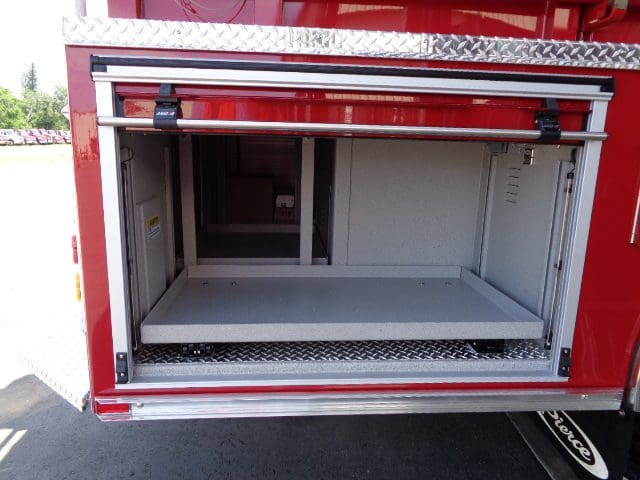

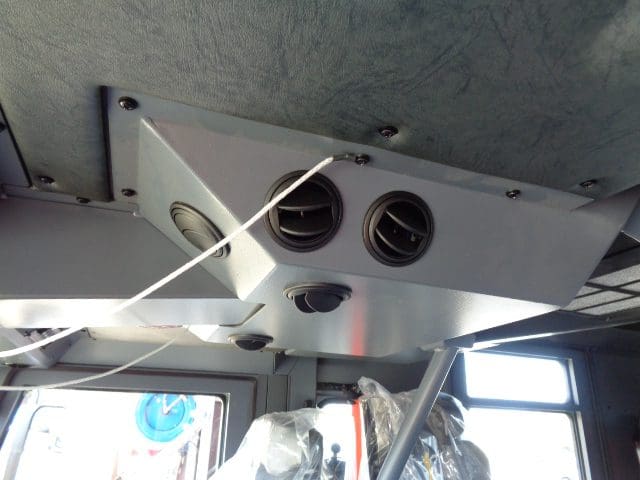

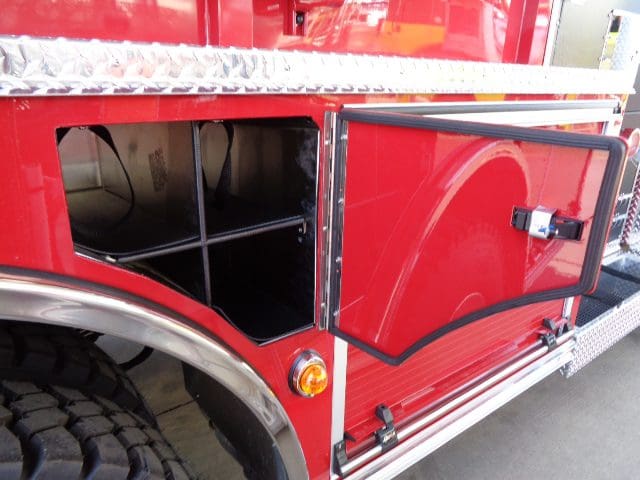

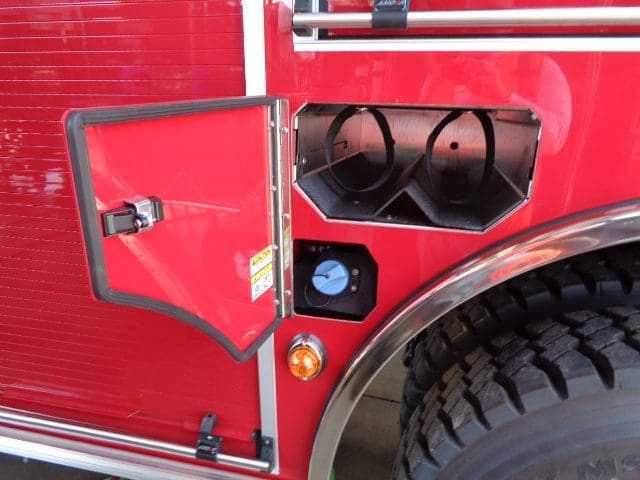

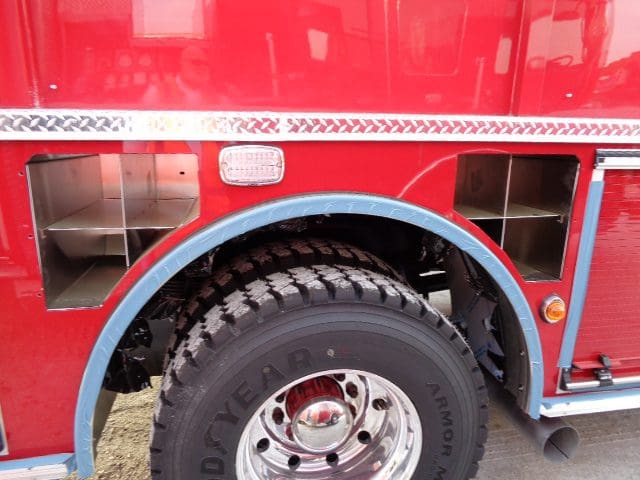

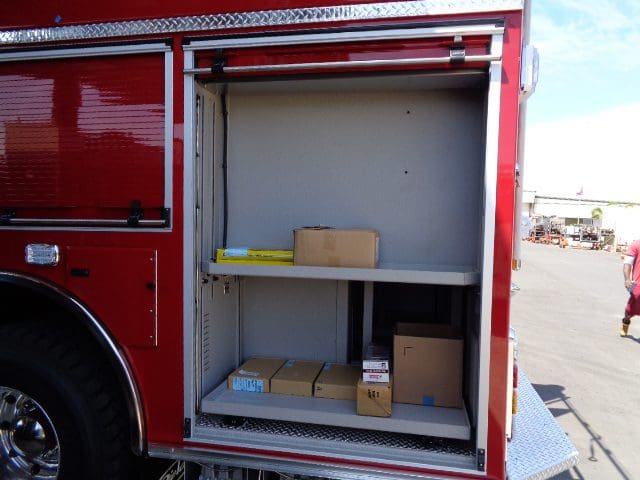

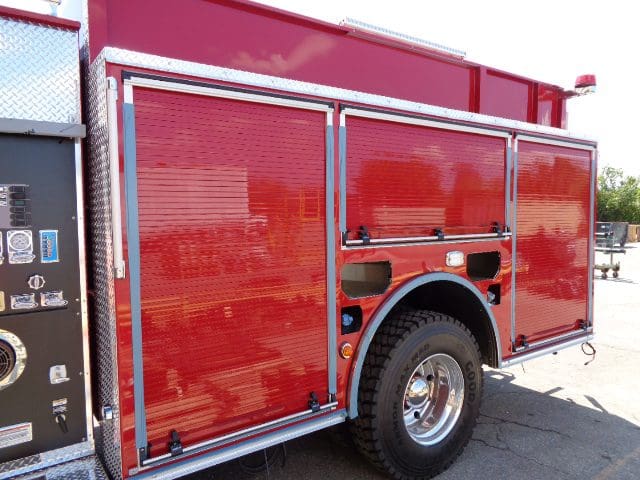

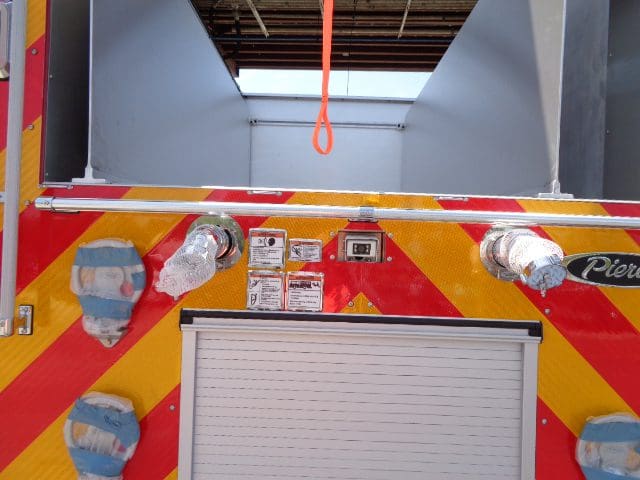

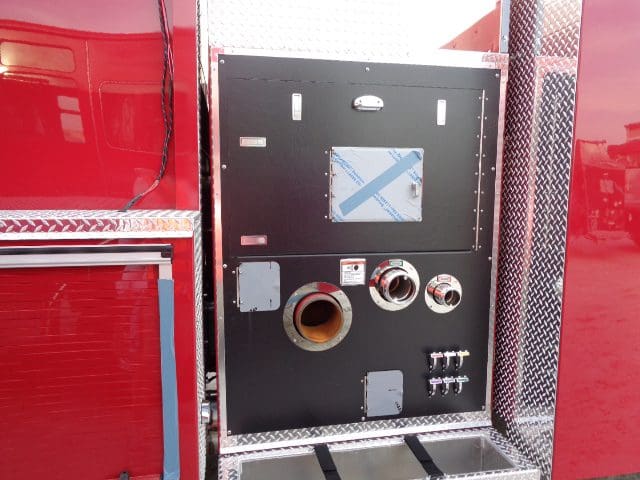

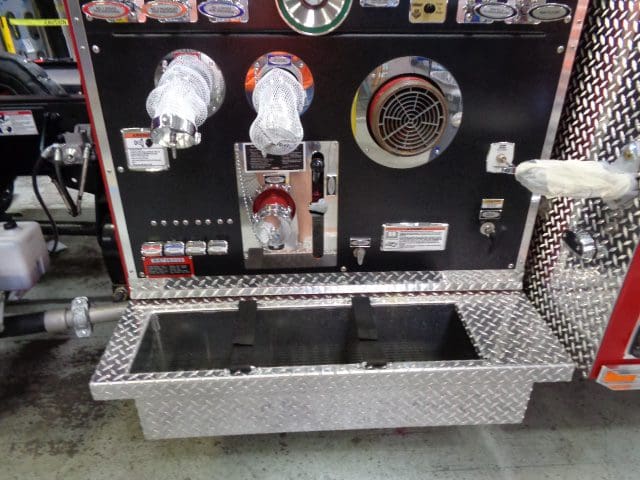

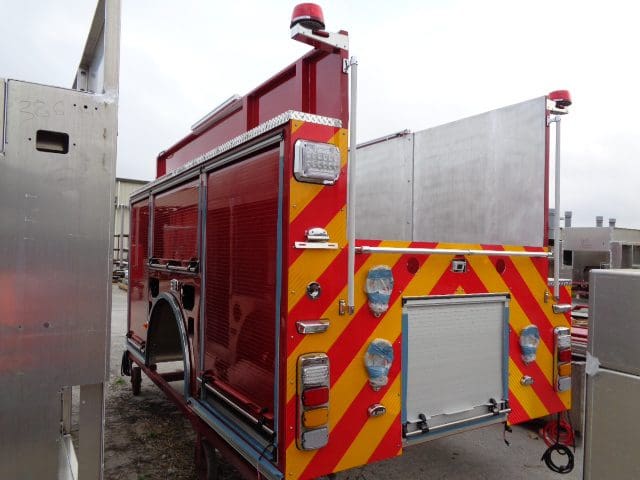

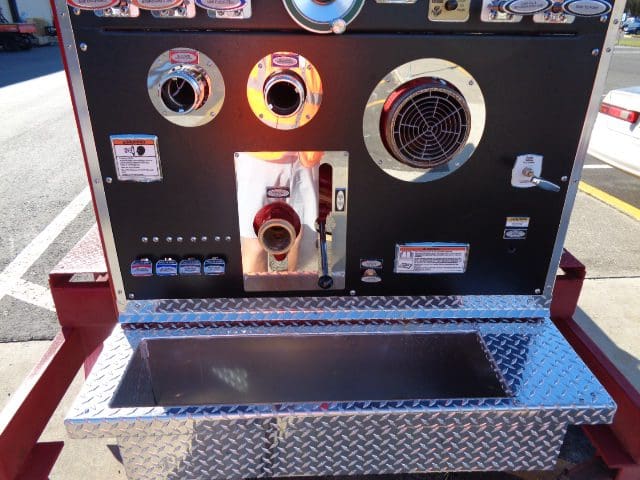

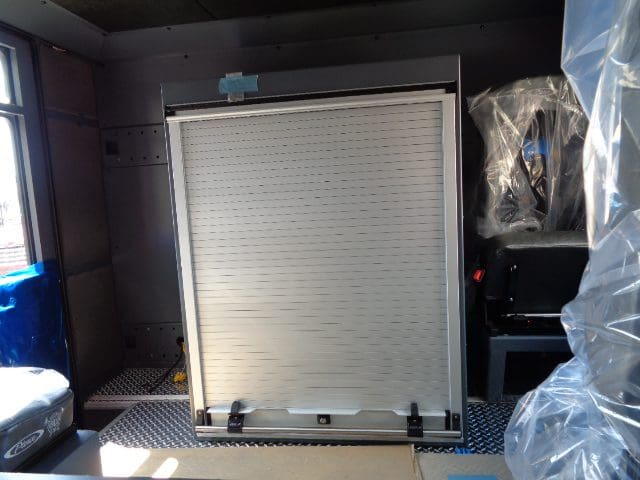

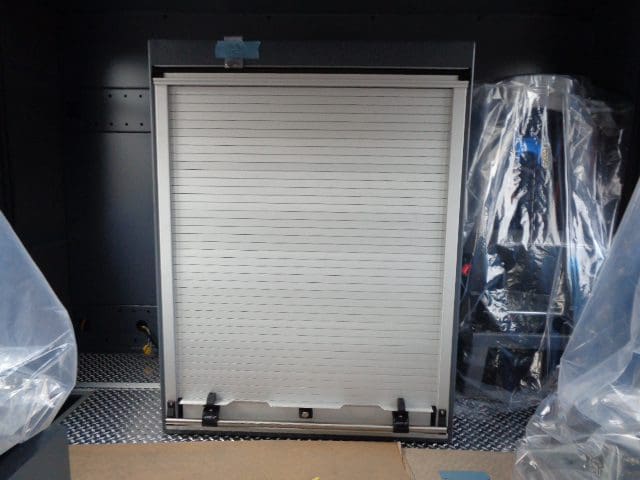

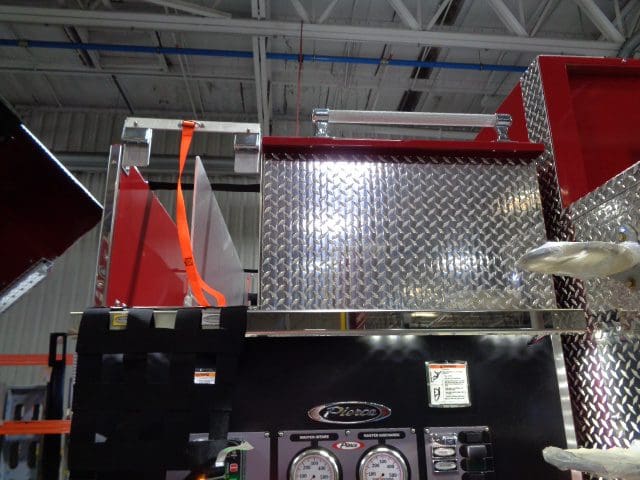

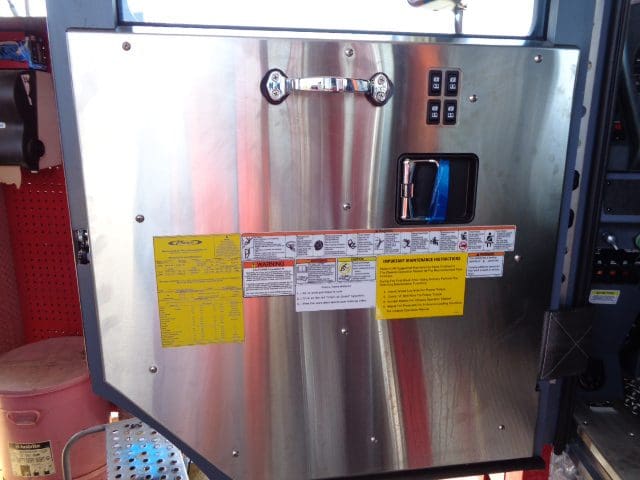

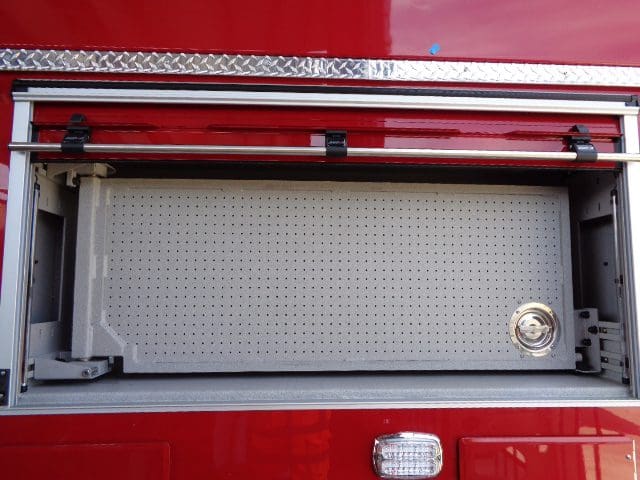

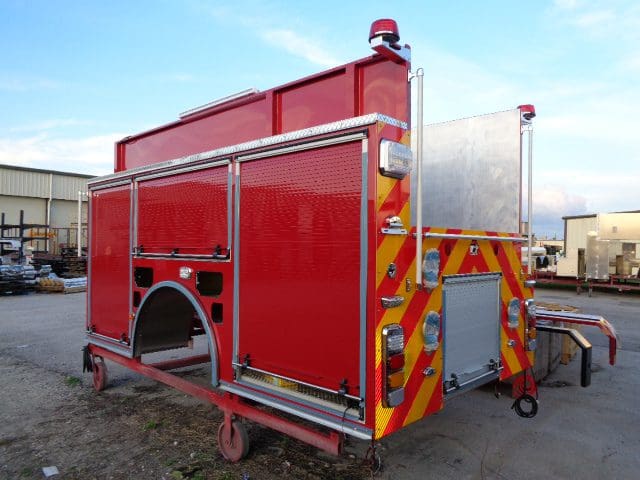

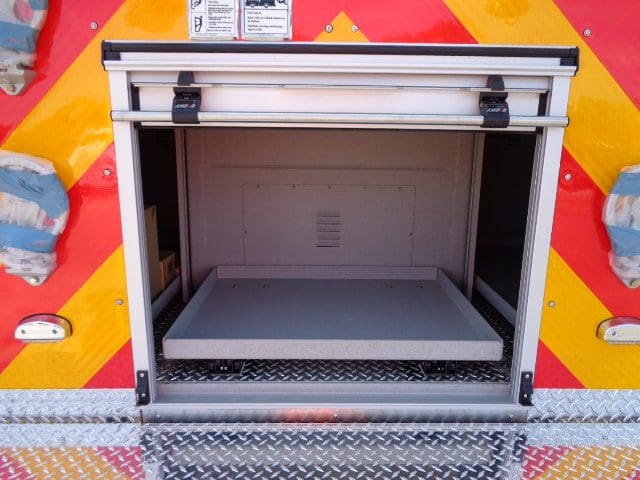

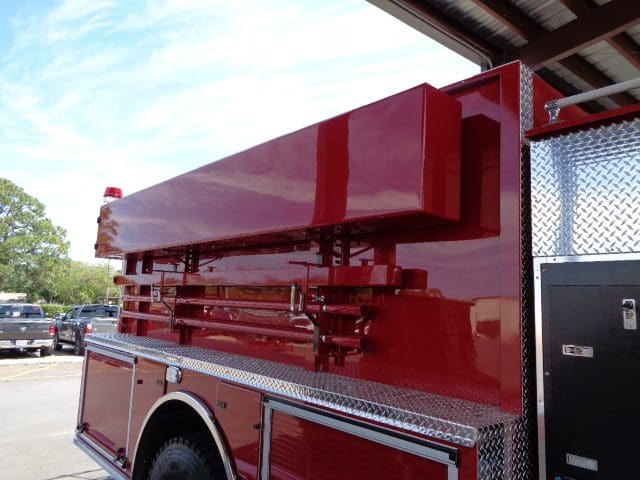

In this report, the apparatus continued with final assembly and installation of option content.
03-22-24

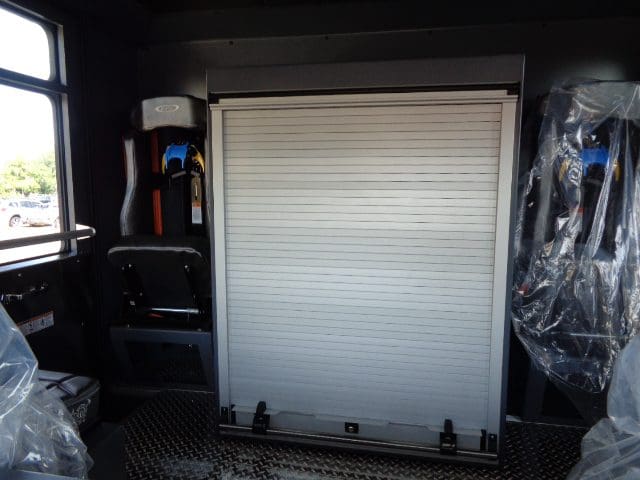

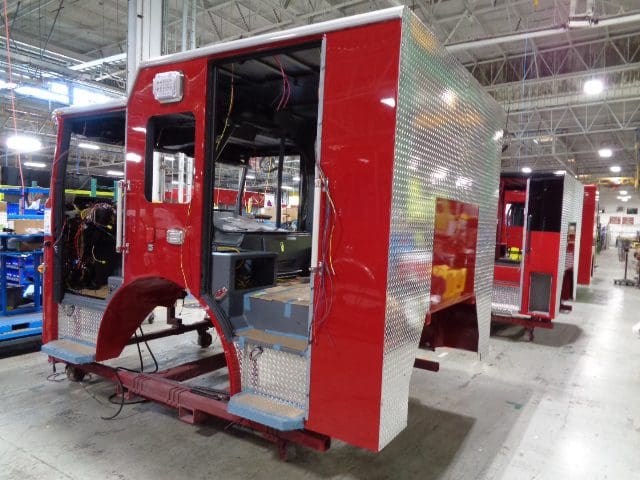

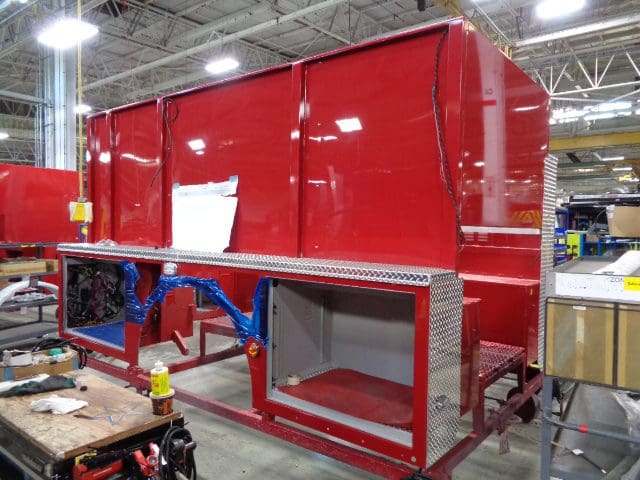

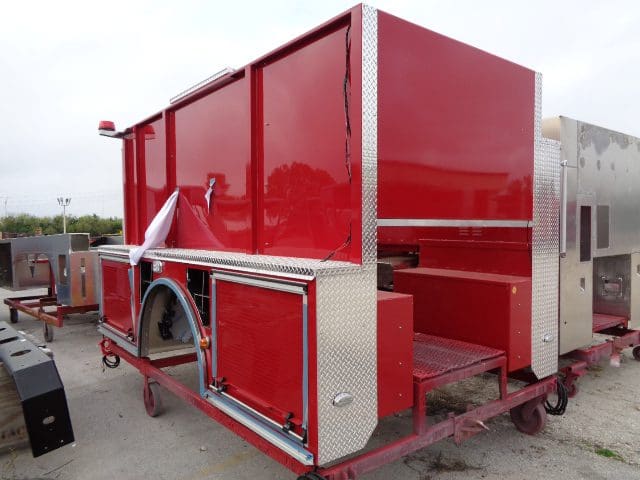

In this report, the apparatus continued with final assembly and installation of option content.
03-15-24

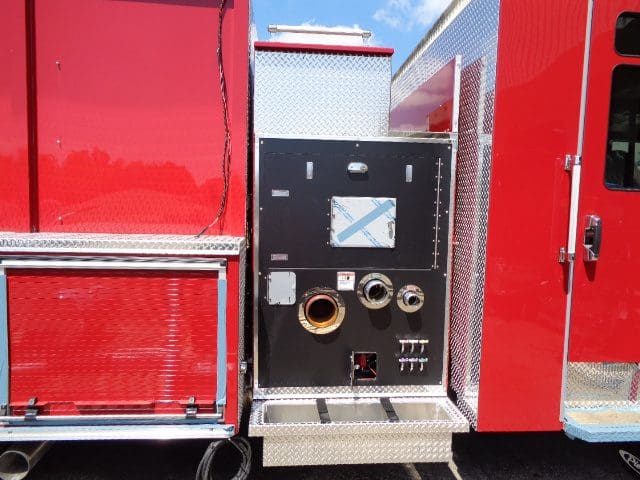

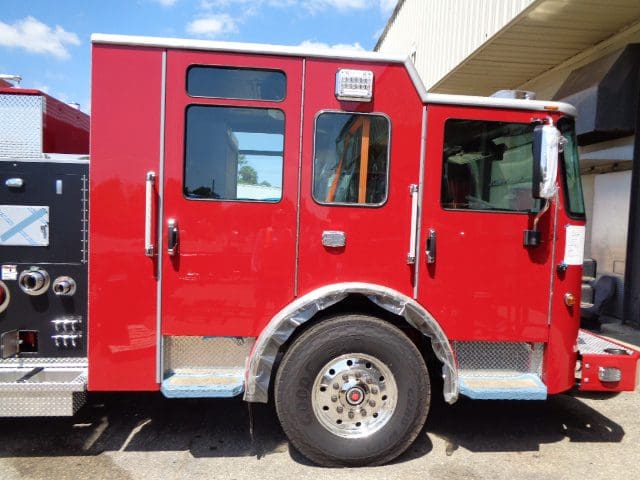

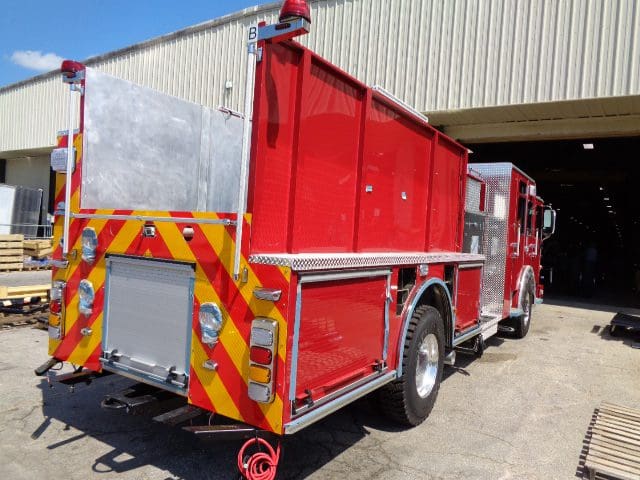

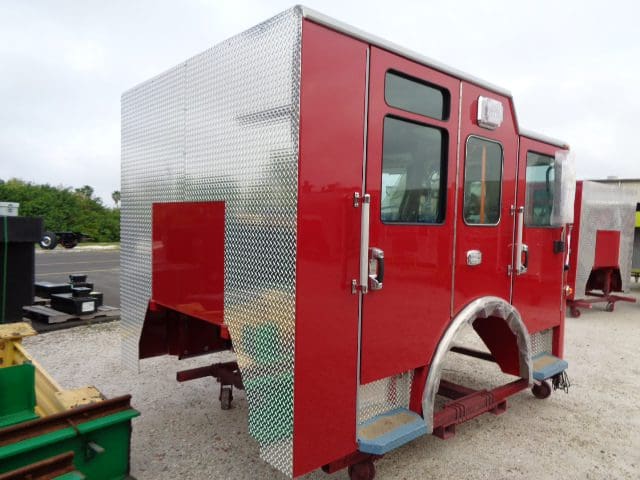

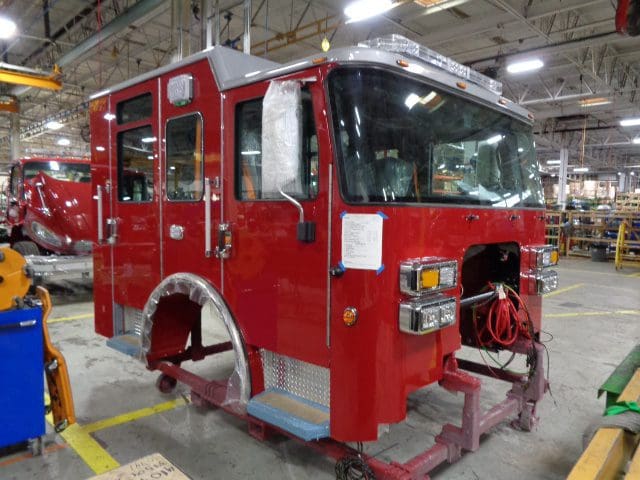

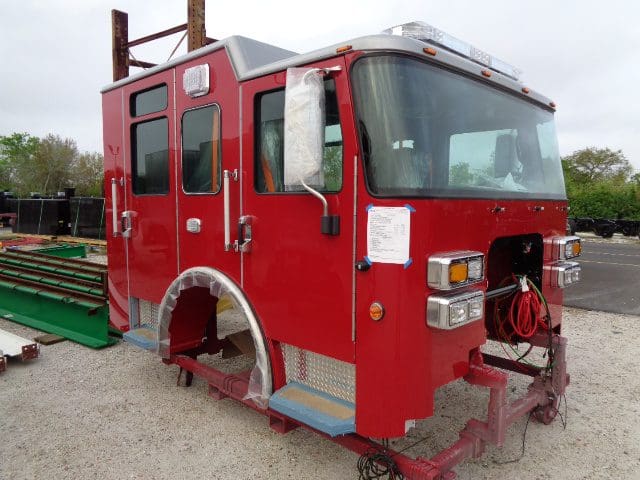

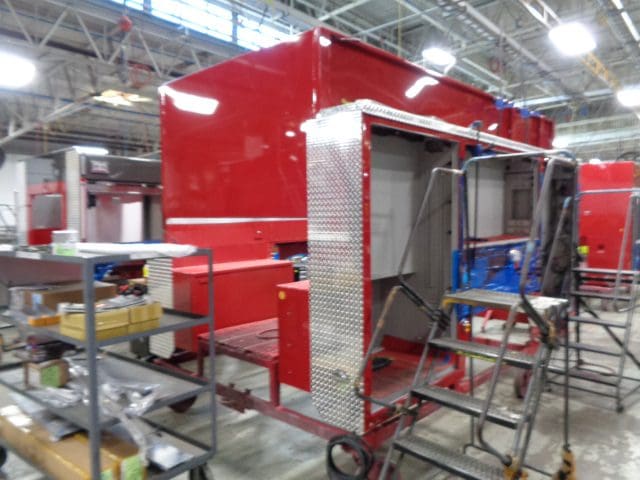

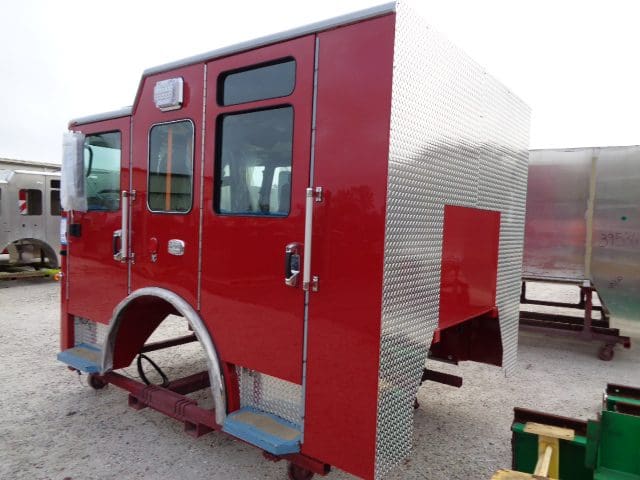

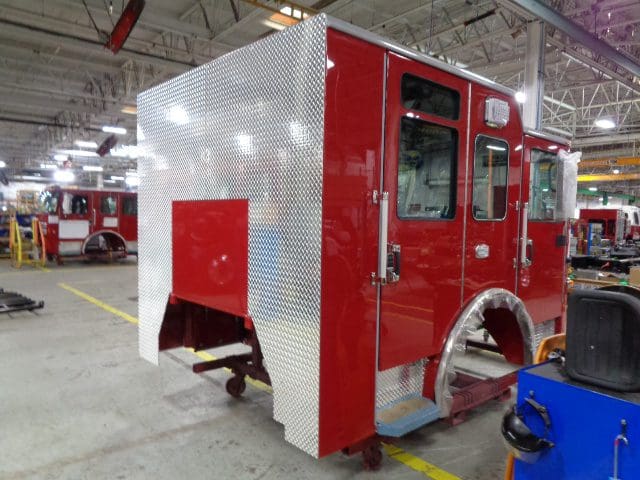

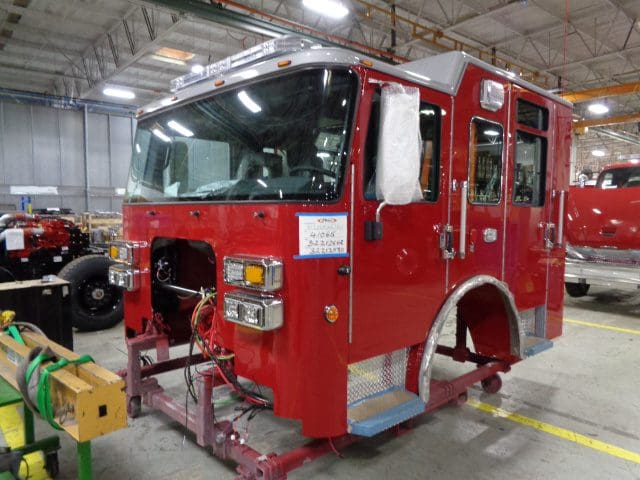

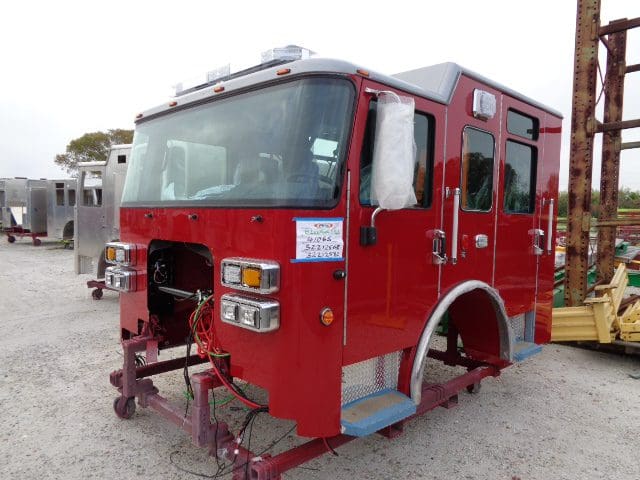

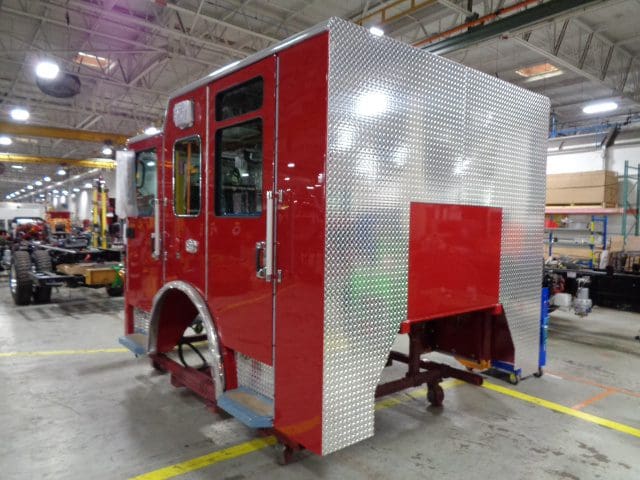

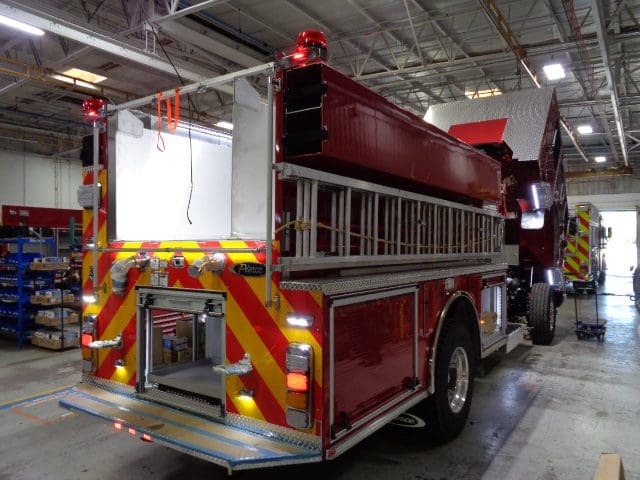

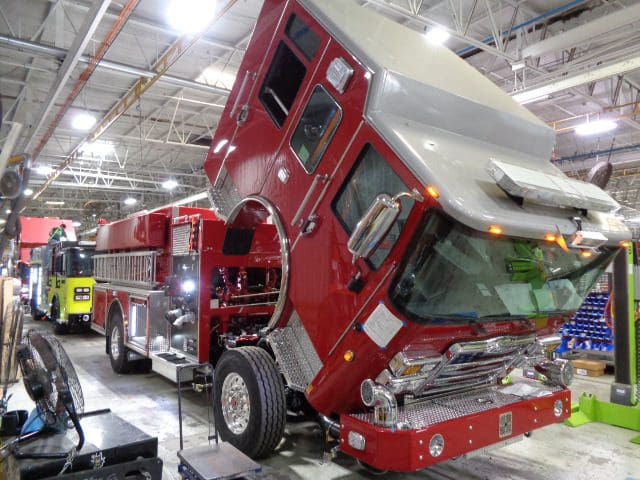

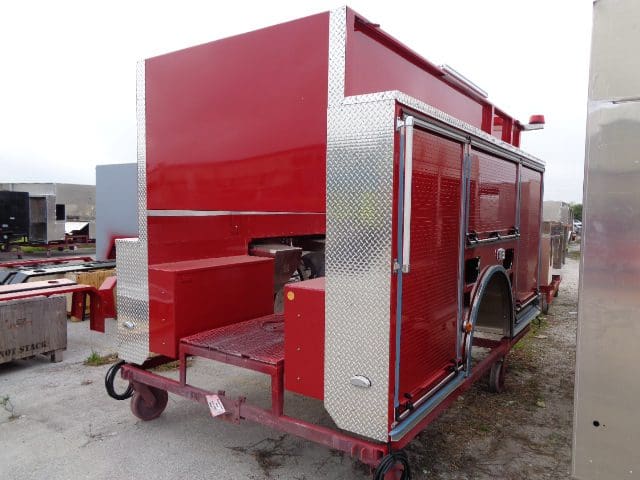

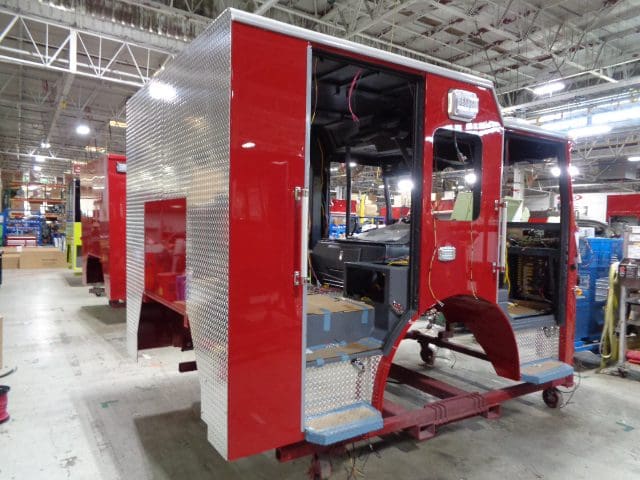

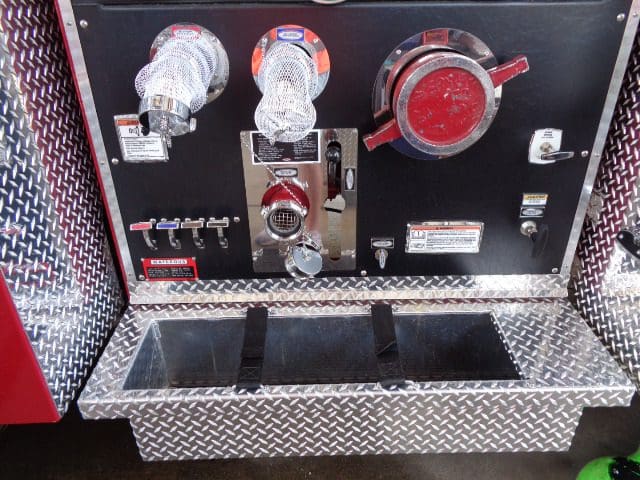

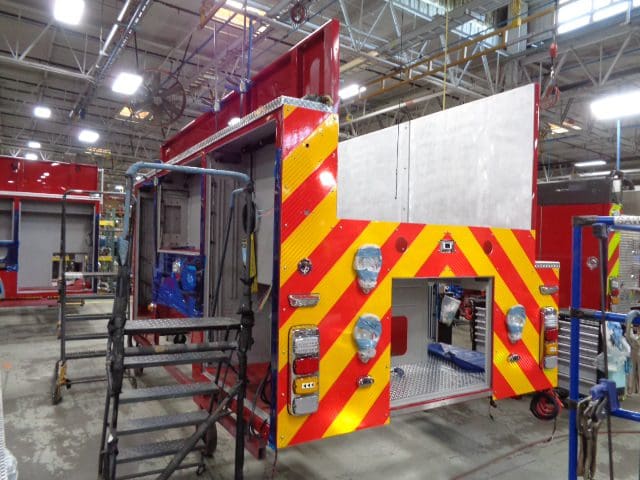

In this report, this apparatus began final assembly after the cab, pump house and body were mounted.
03-08-24
In this report, the cab was in staging and the chassis frame was unavailable for photos. The pump house was in staging (no photos) and the body was in staging.

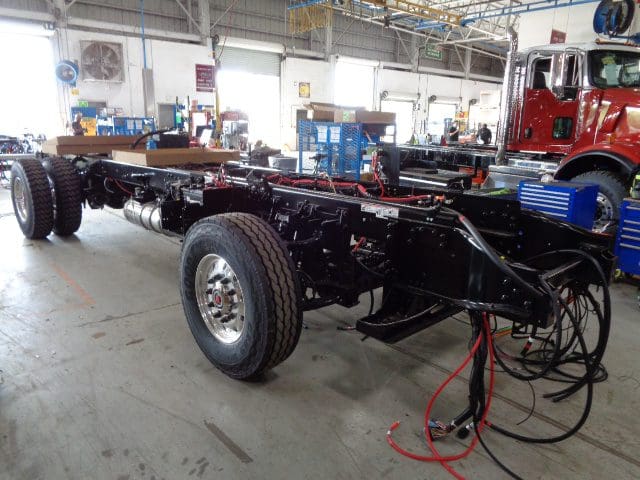

03-01-24

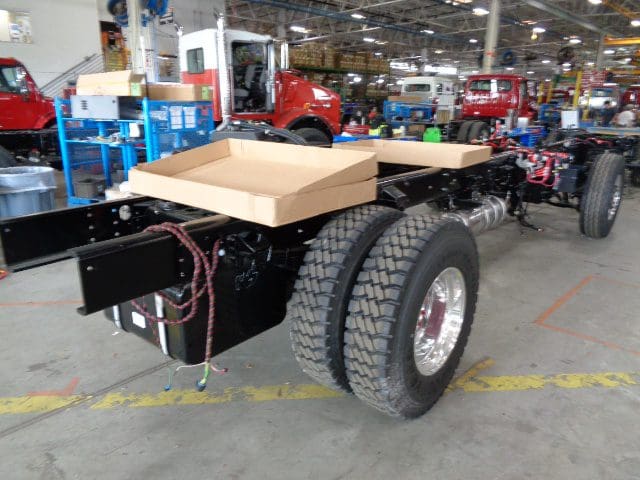

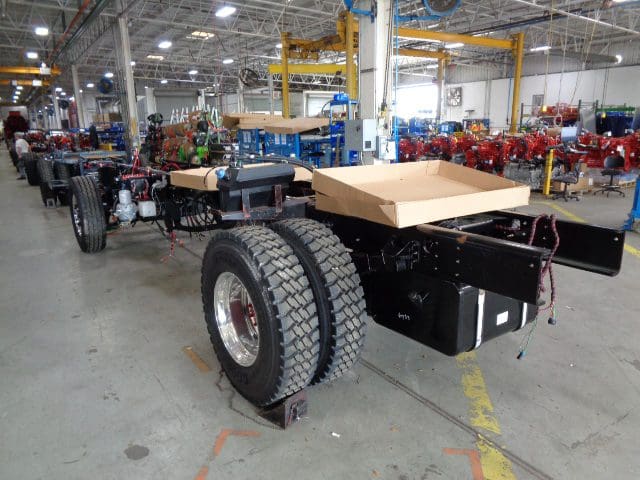

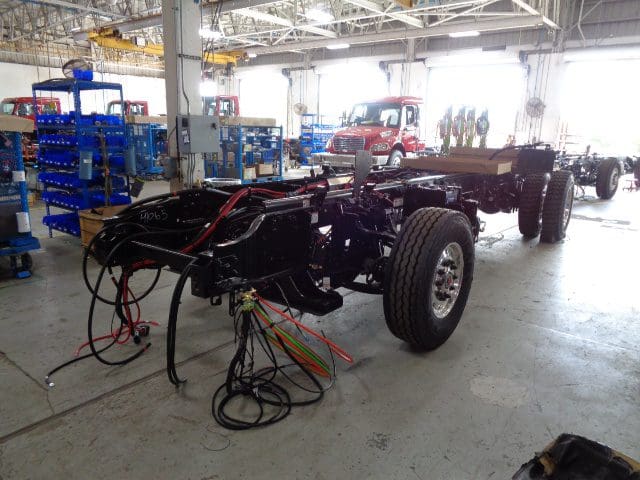

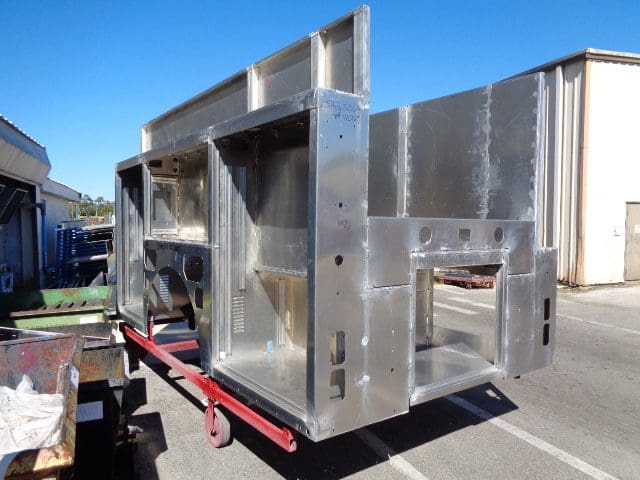

In this report, the cab was in staging and the chassis frame began initial assembly. The pump house and body were in staging.
02-23-24

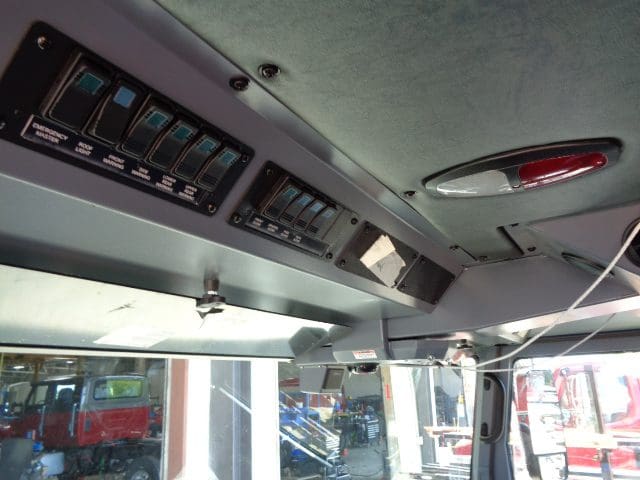

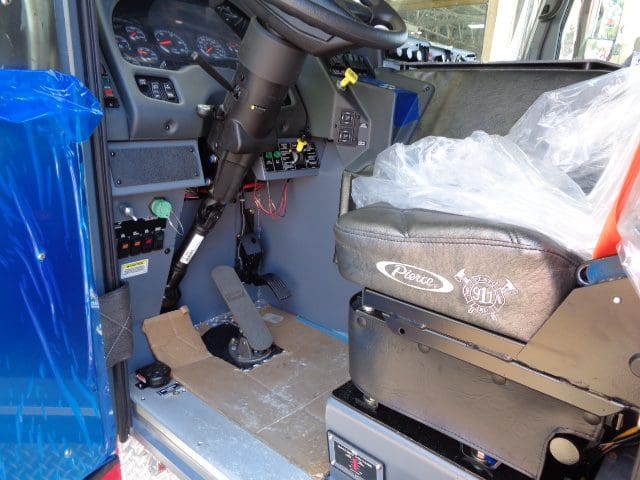

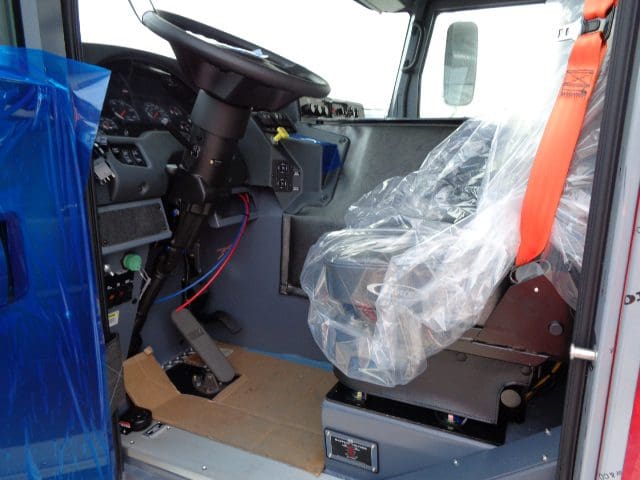

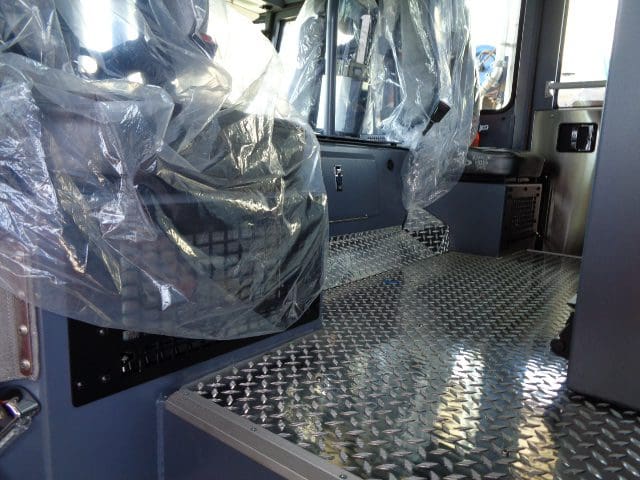

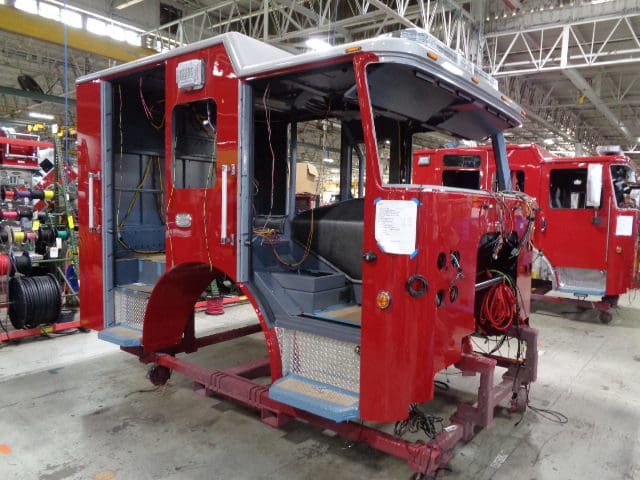

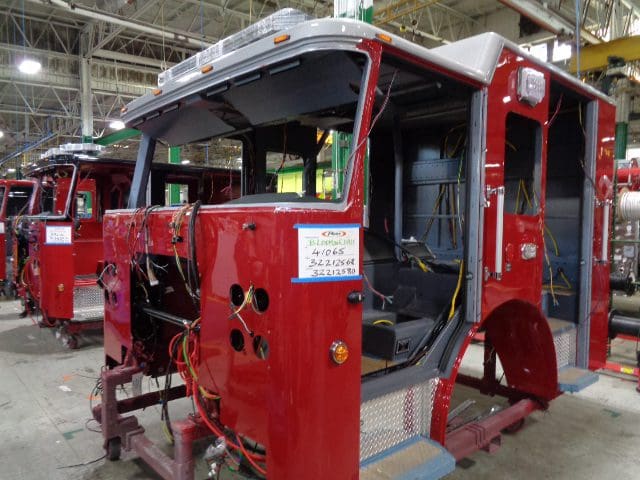

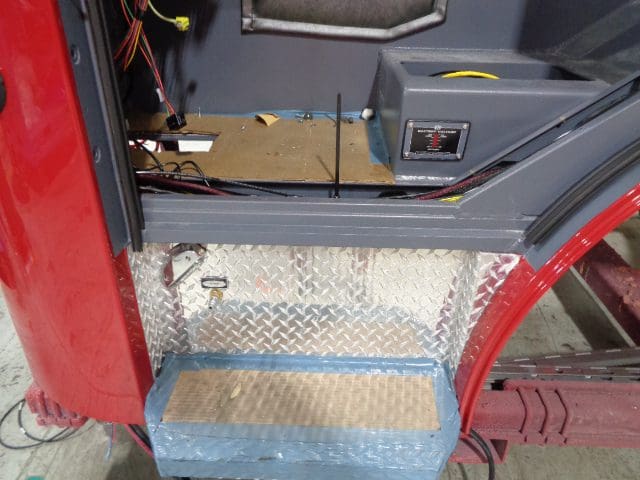

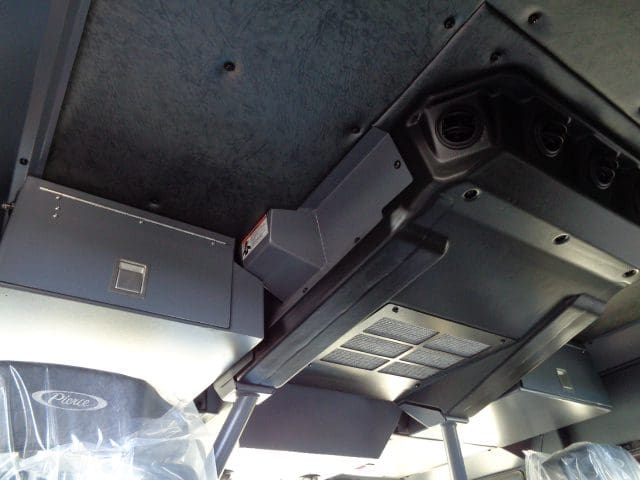

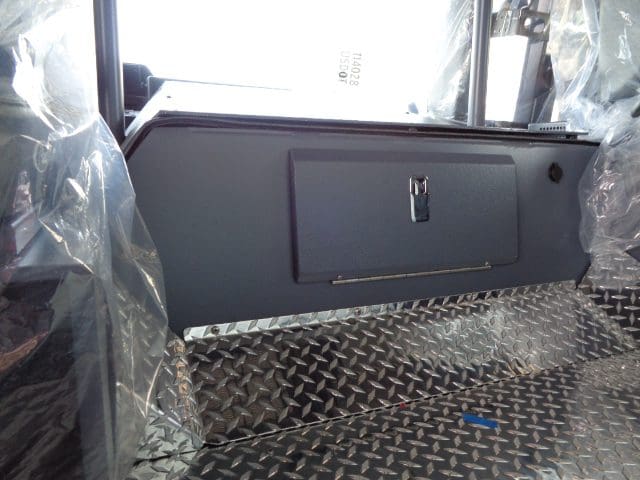

In this report, the cab began to receive trim and wiring harnesses, and the pump house was in staging. The body began to receive trim and wiring harnesses.
02-16-24

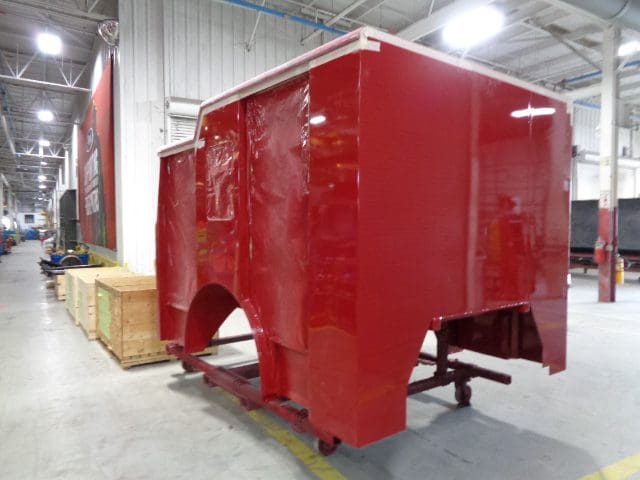

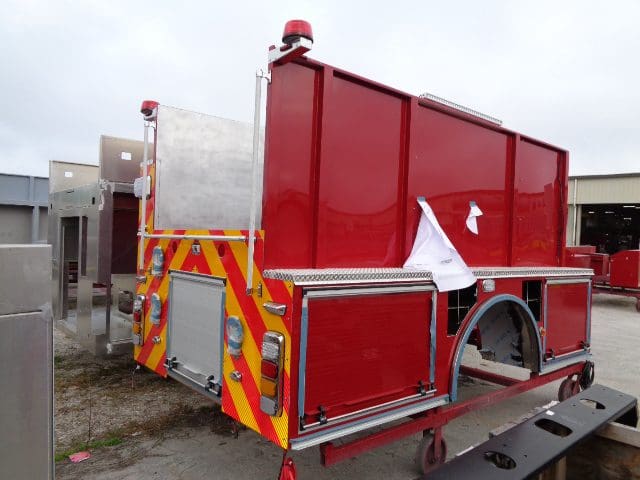

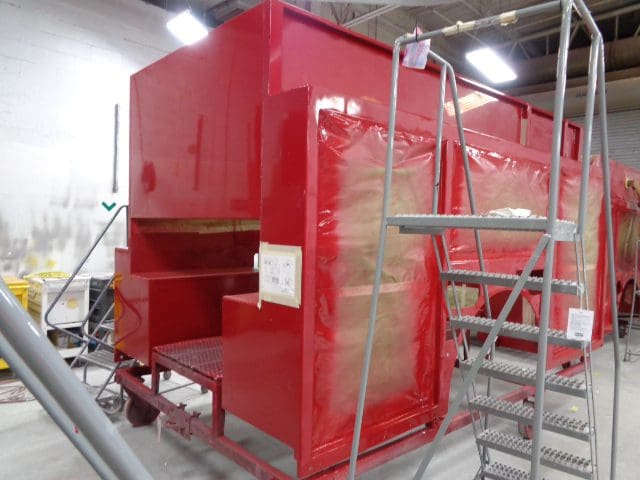

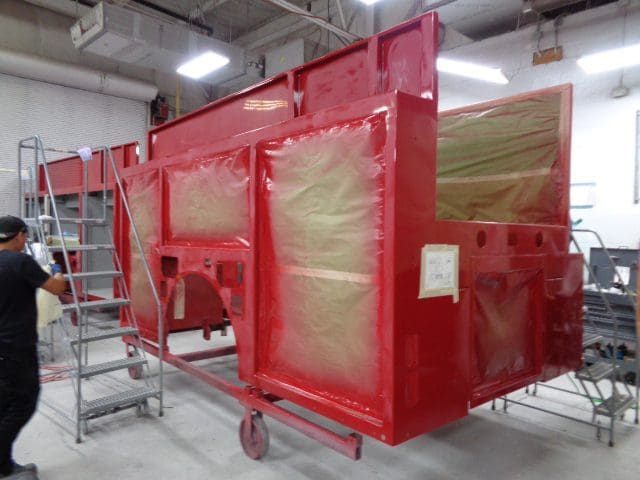

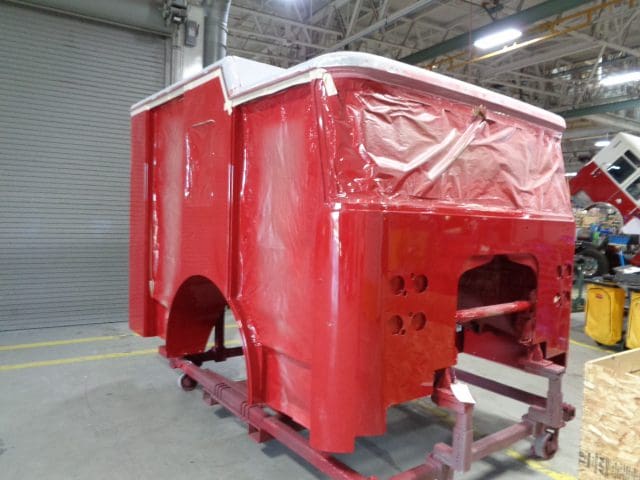

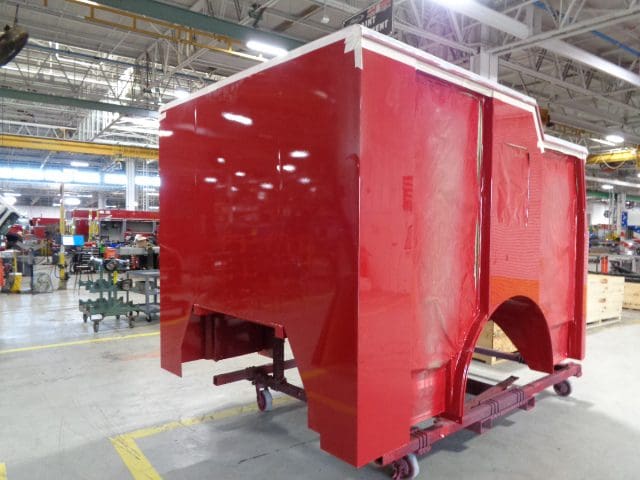

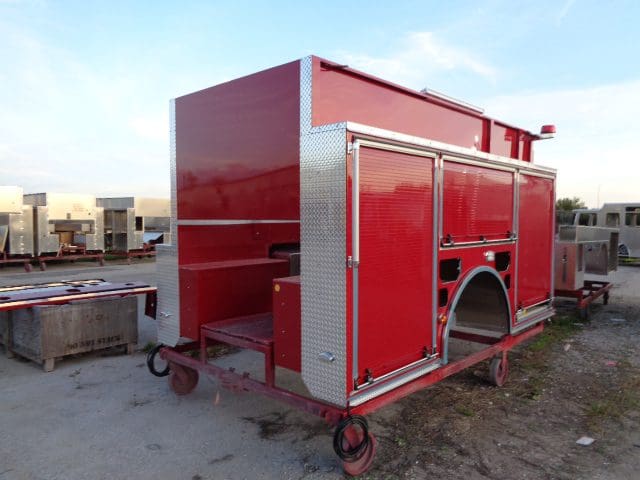

In this report, the cab was unavailable for photos, and the pump house was in staging (no photos). The body began the paint process.

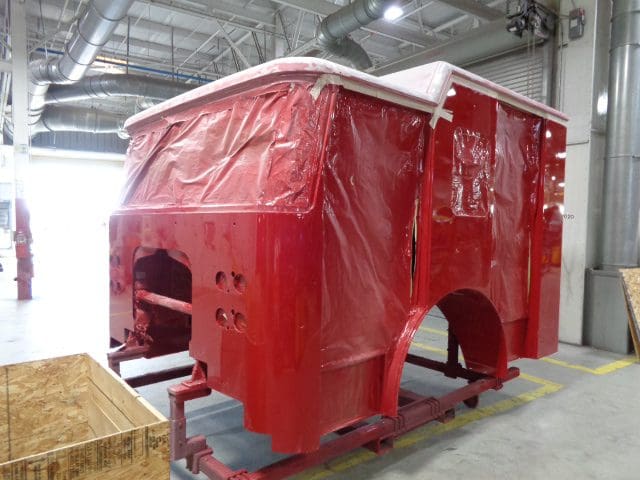

02-09-24

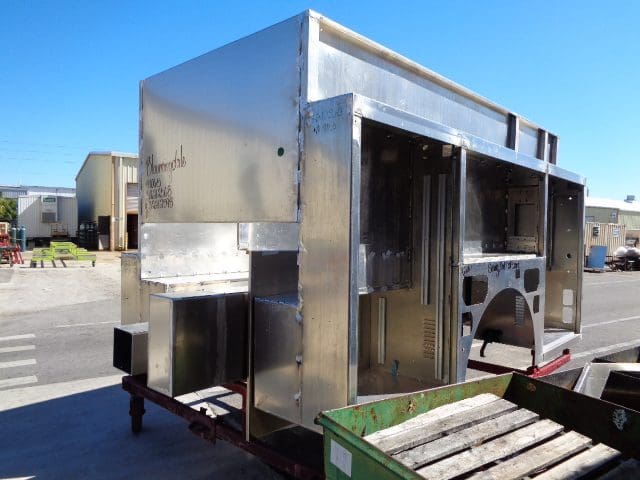

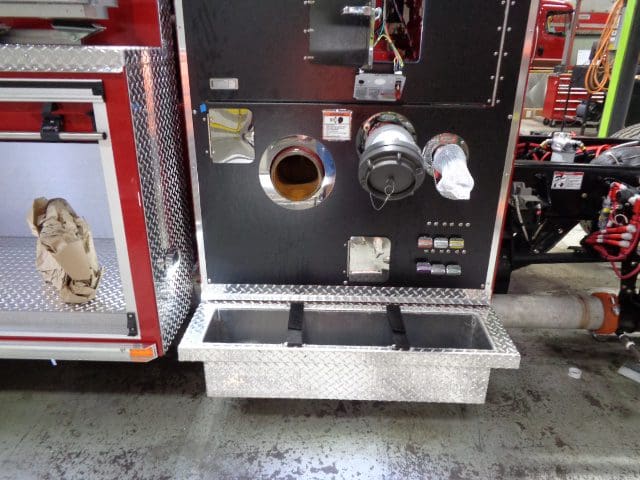

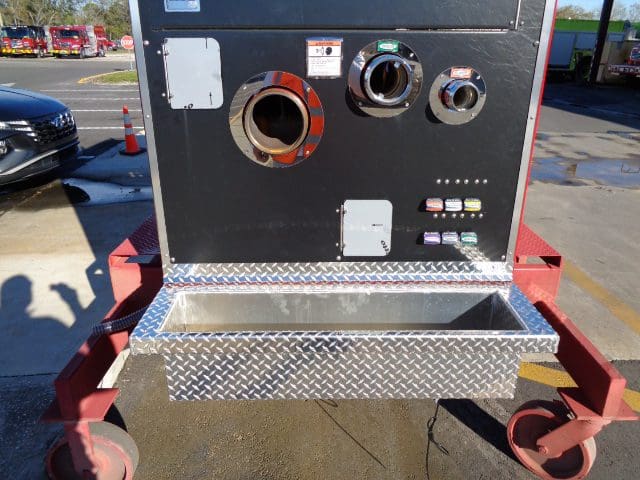

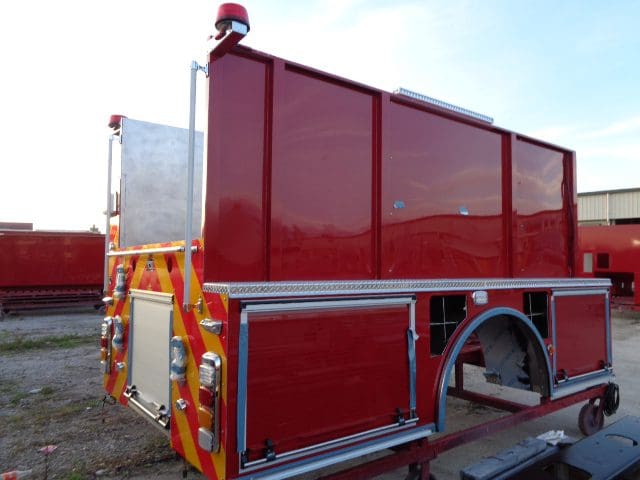

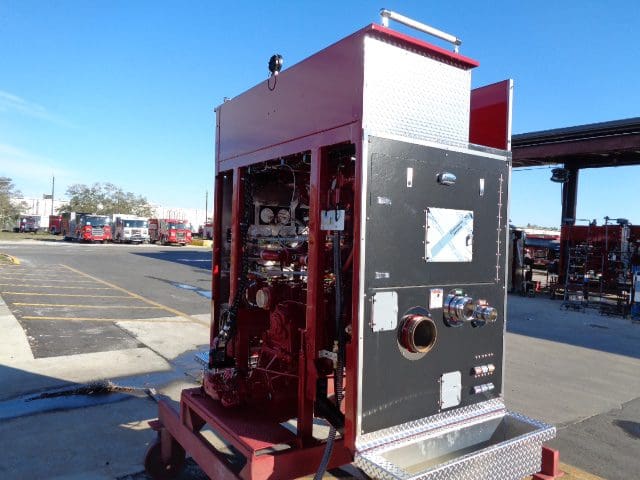

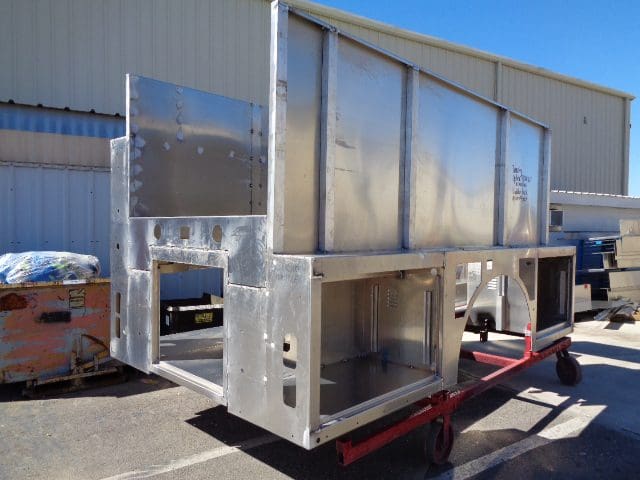

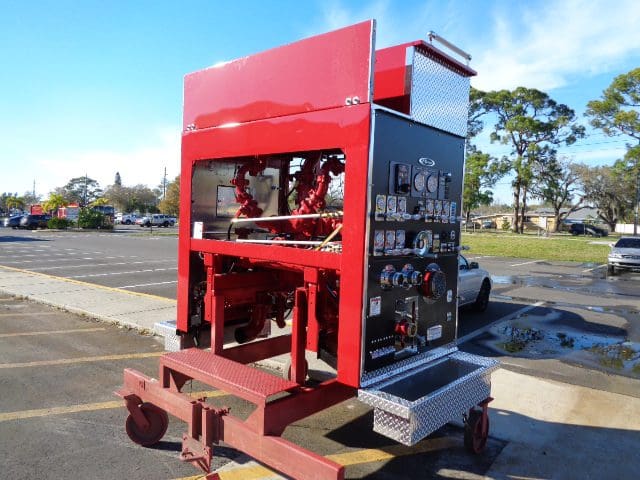

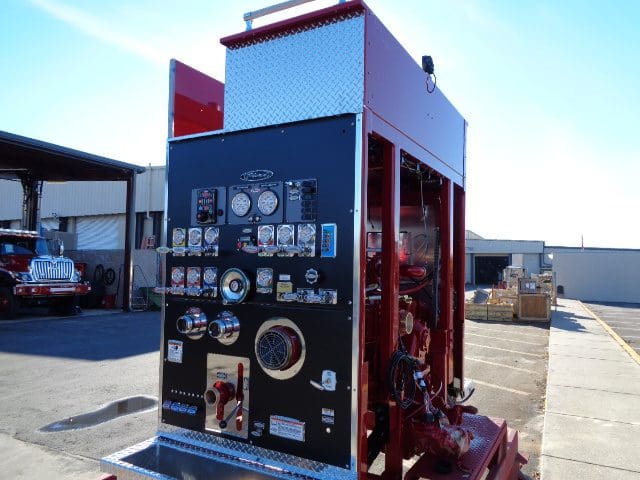

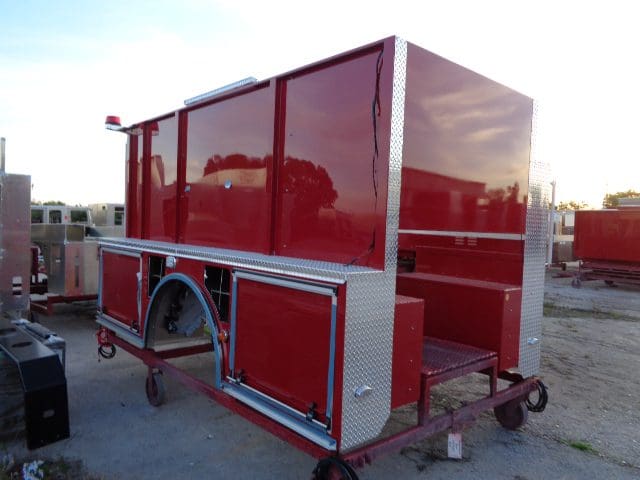

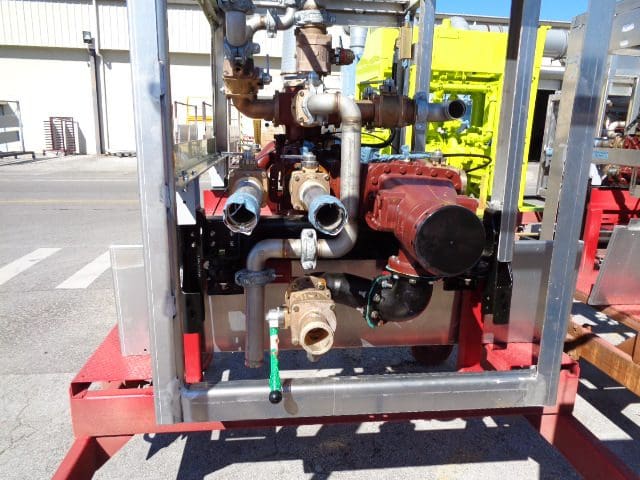

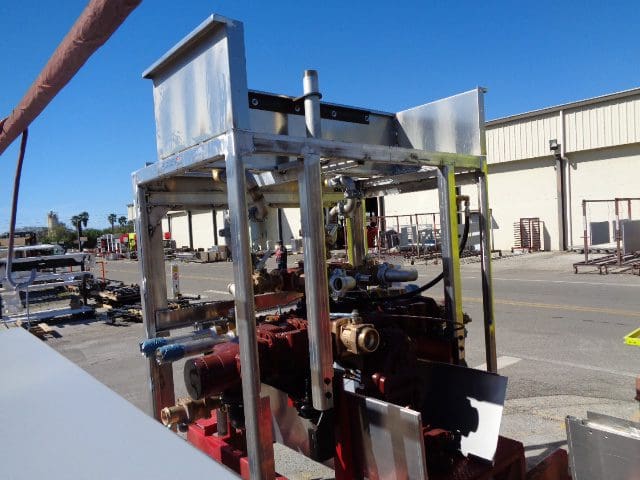

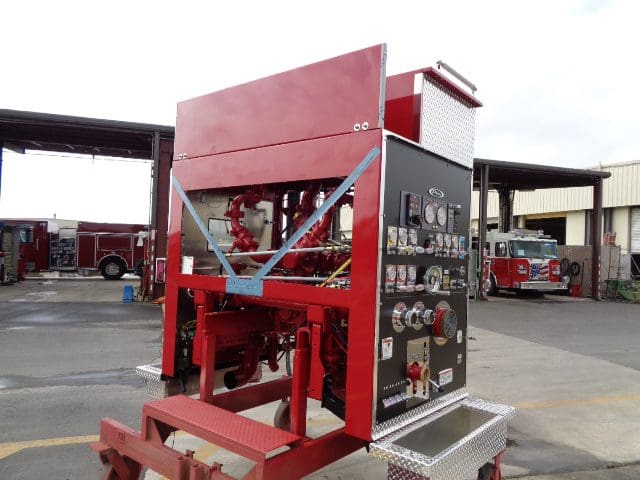

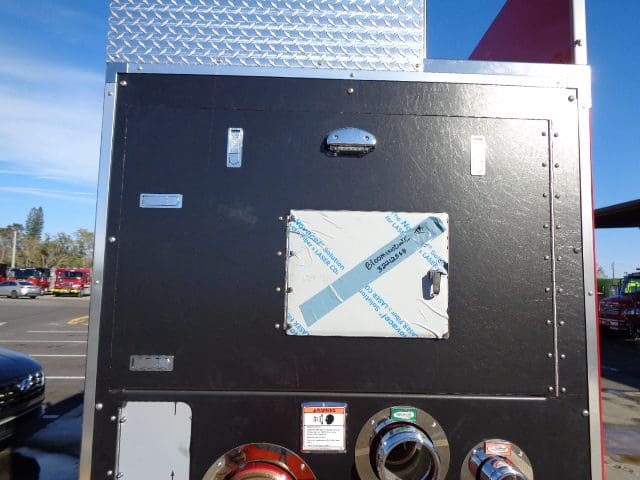

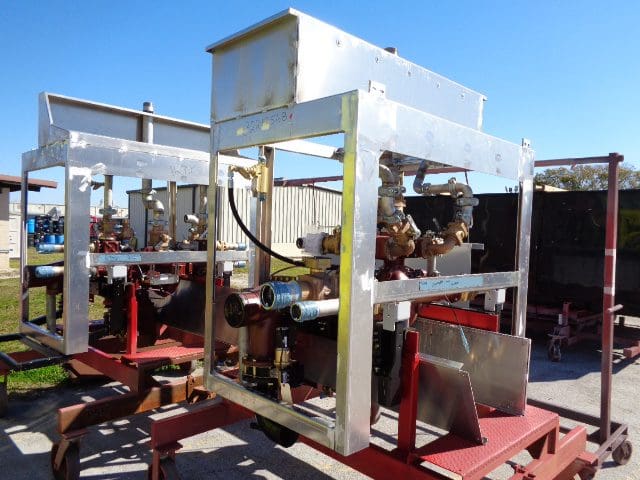

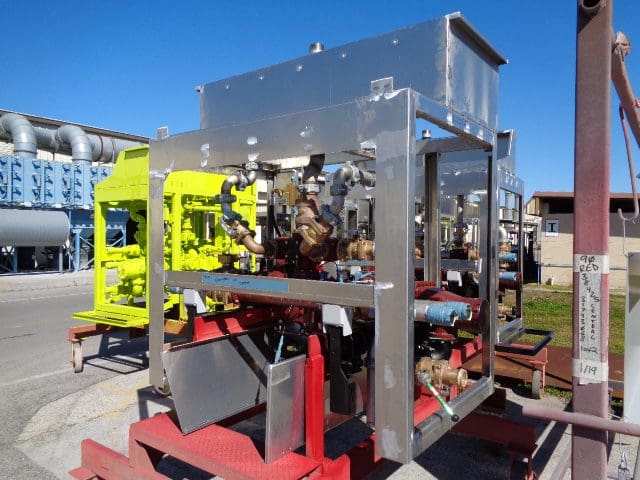

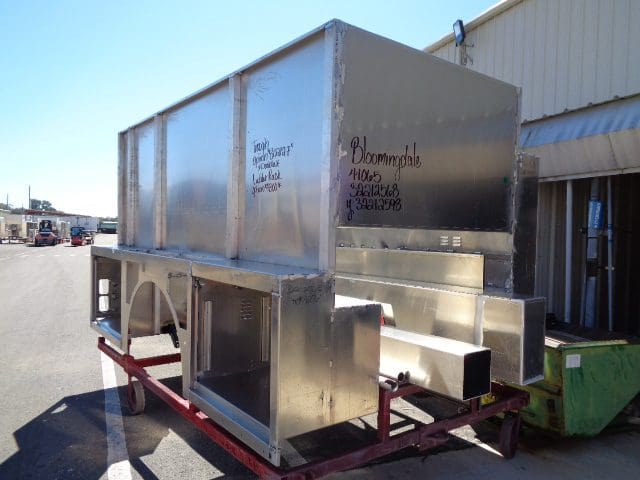

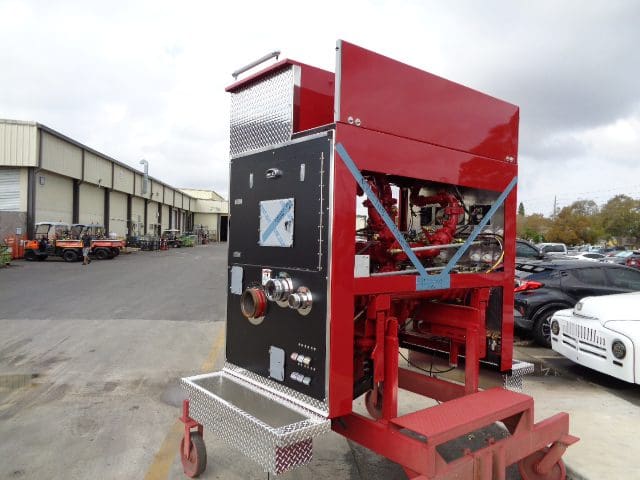

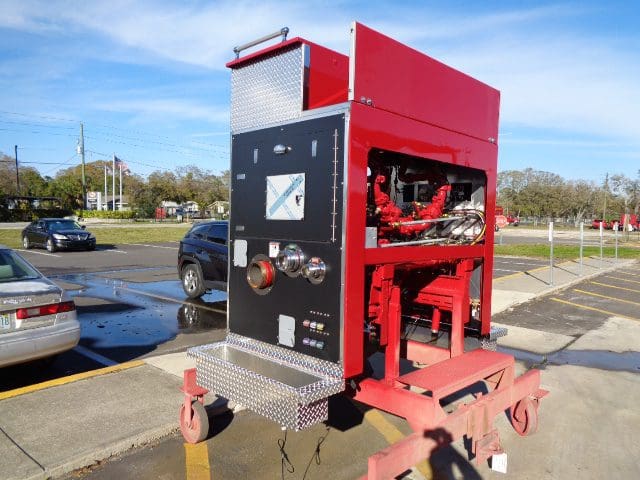

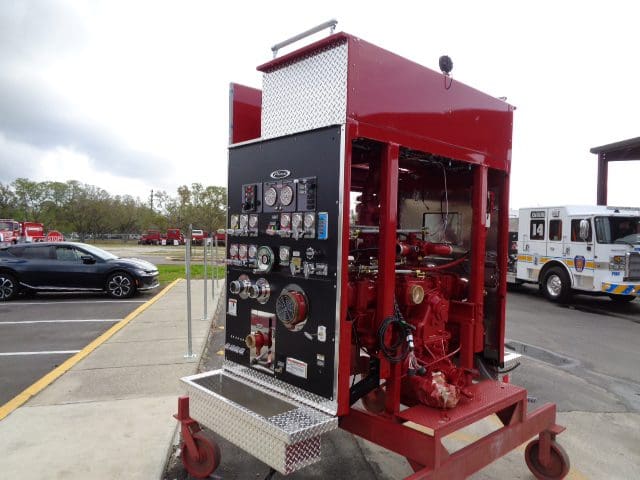

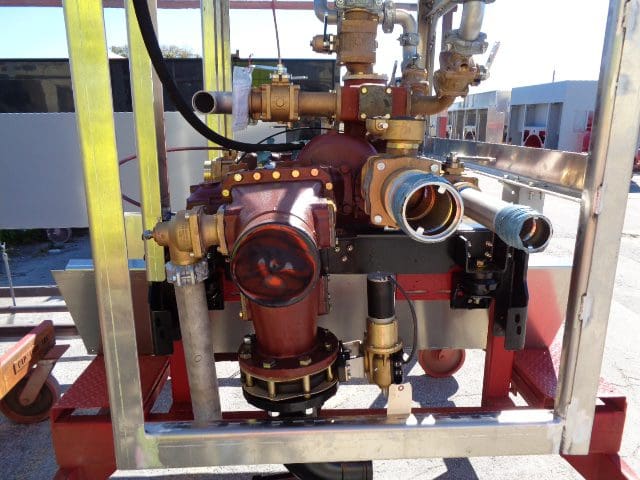

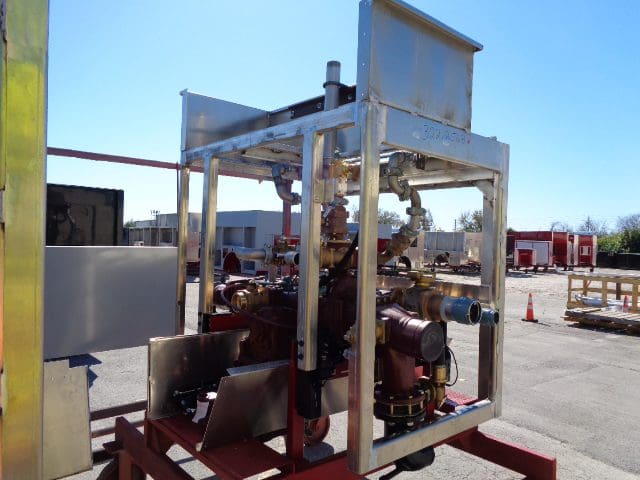

This new Pierce apparatus is now in production at the Bradenton Florida facility. In this report, the cab began the paint process, and the pump house structure was joined with the fire pump. The body began fabrication.
