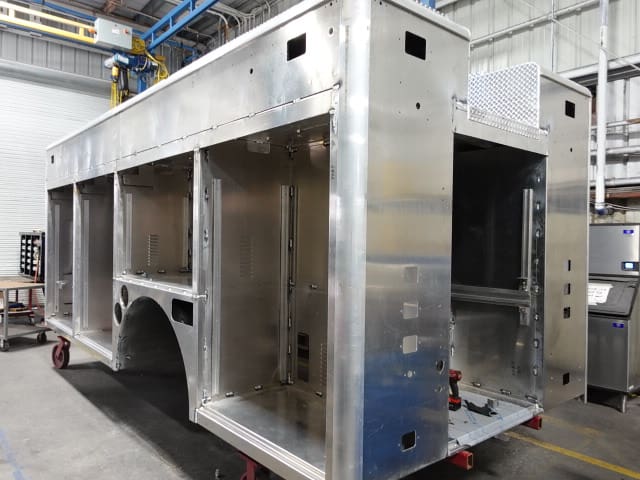

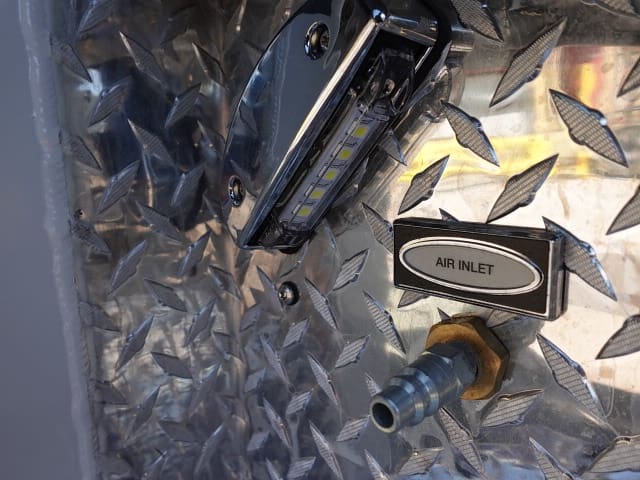

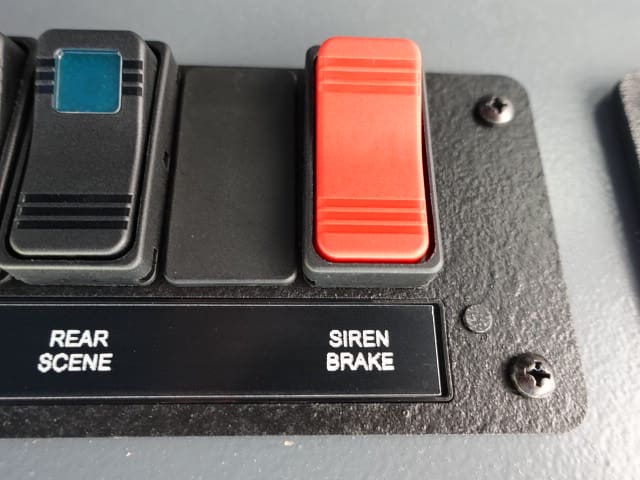

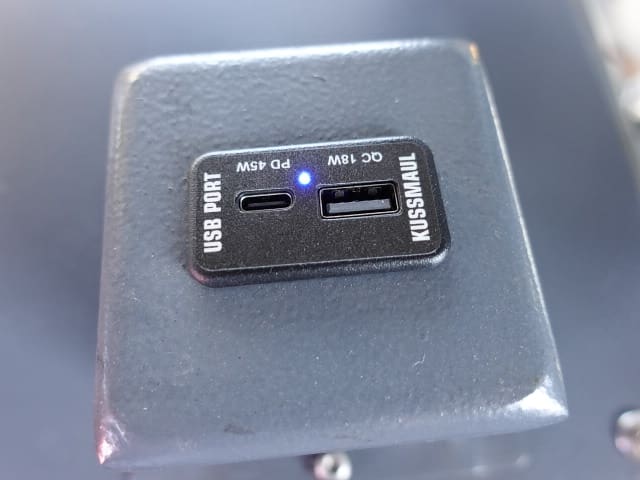

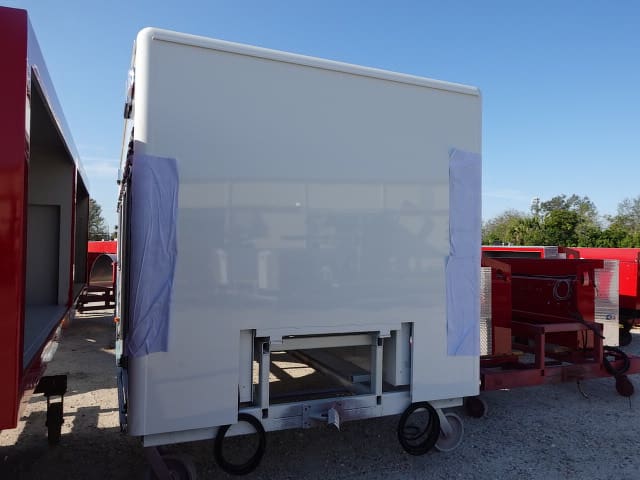

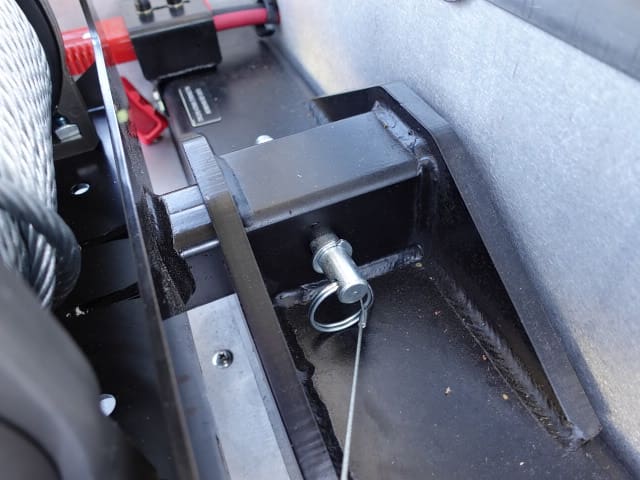

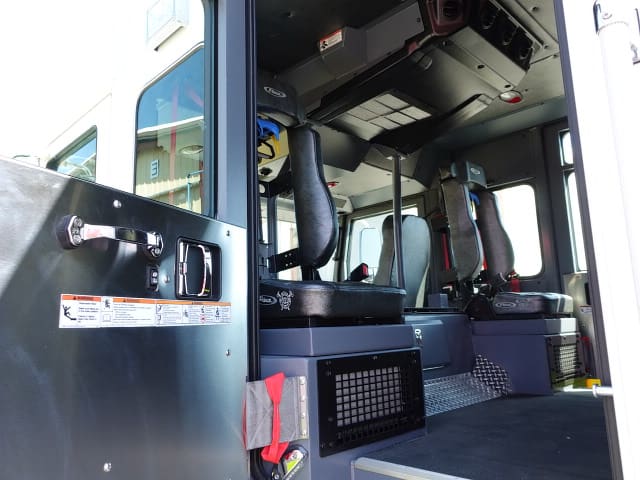

03-21-25

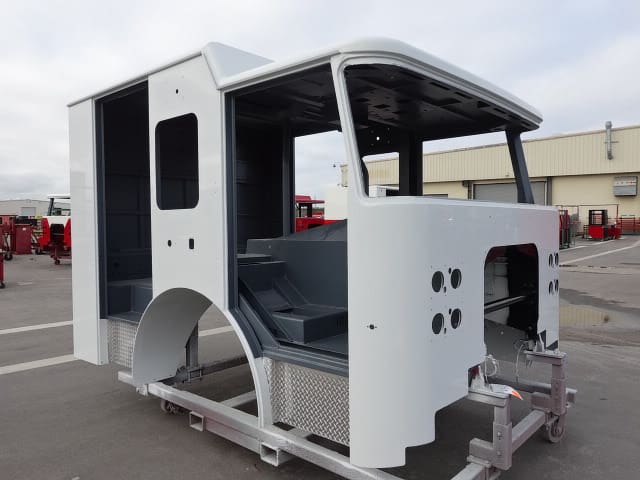

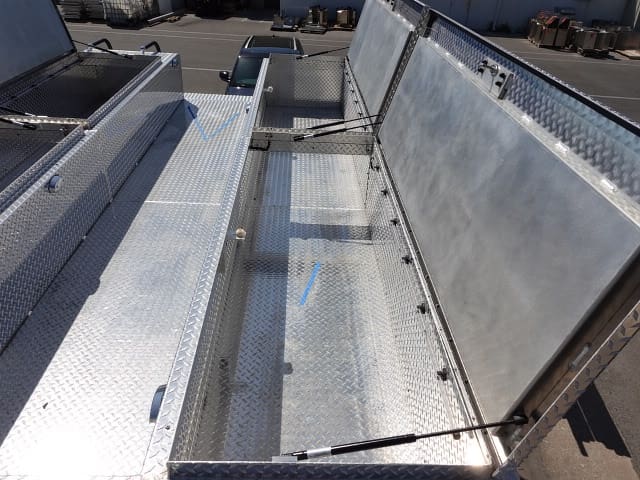

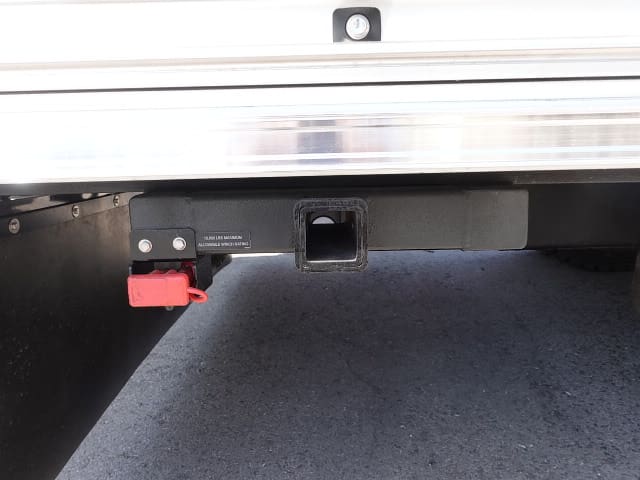

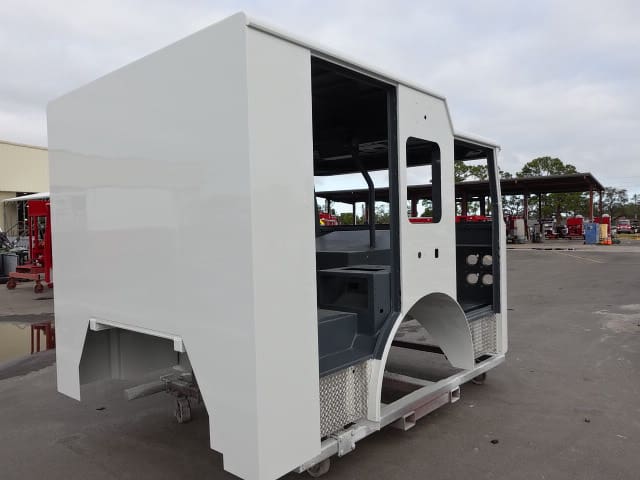

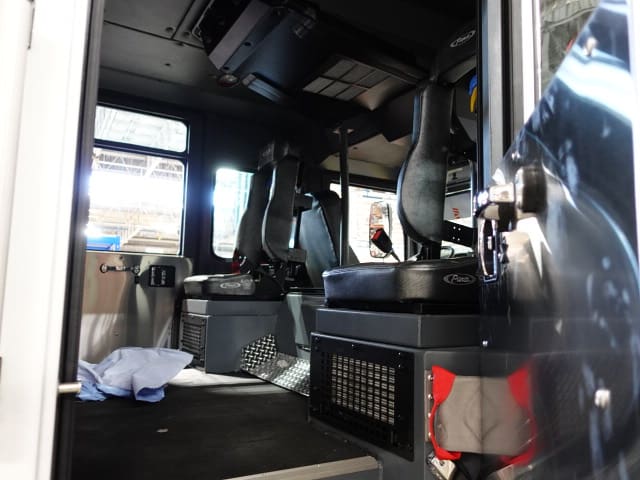

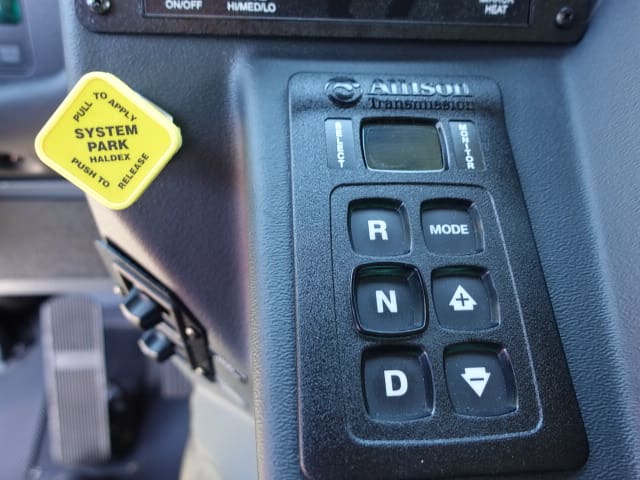

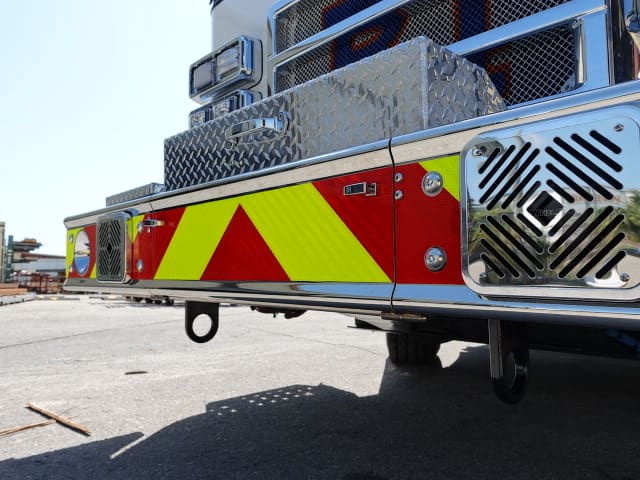

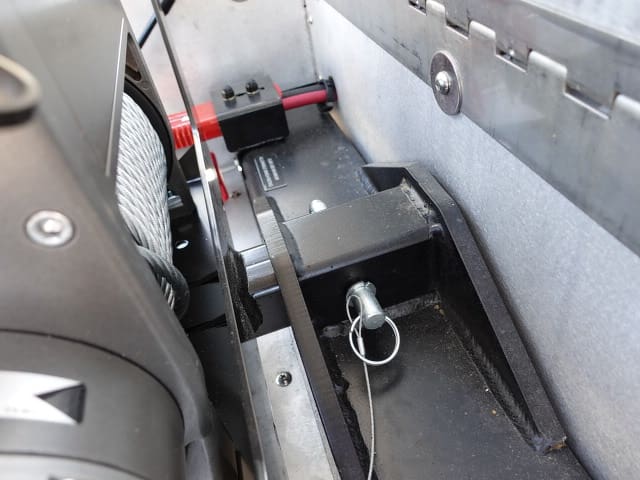

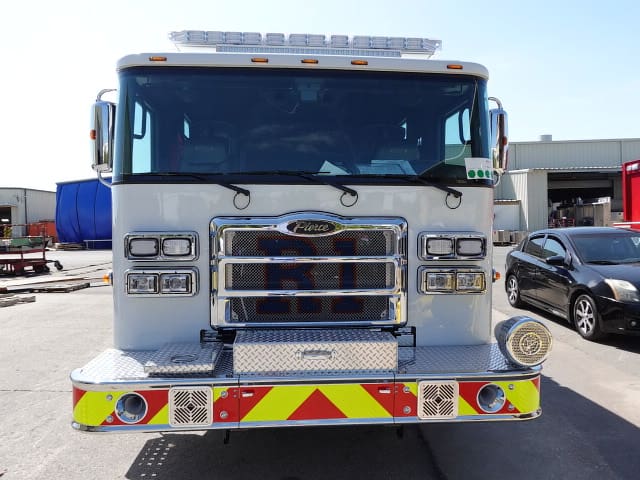

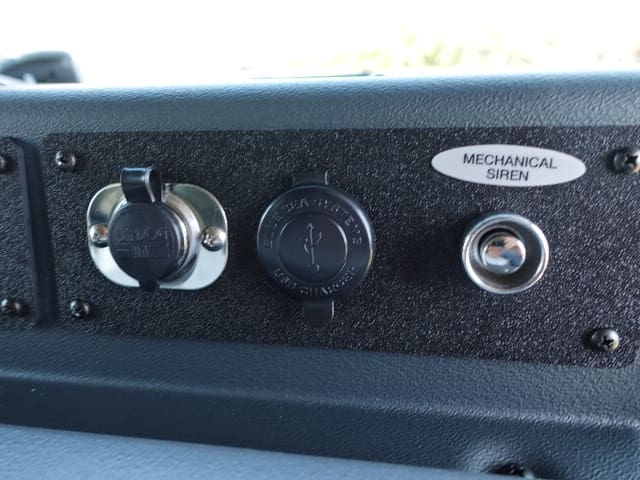

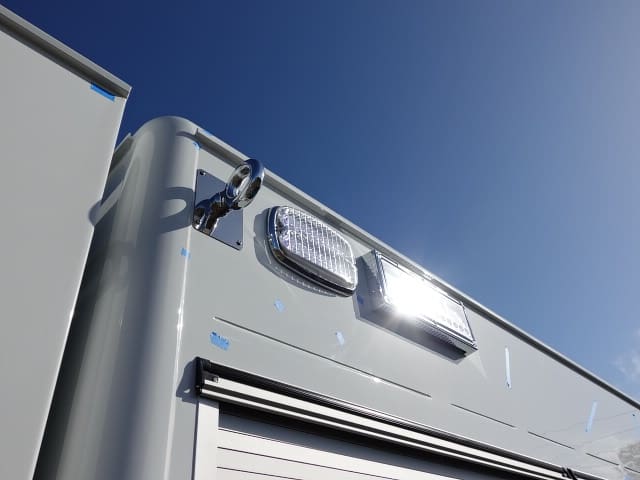

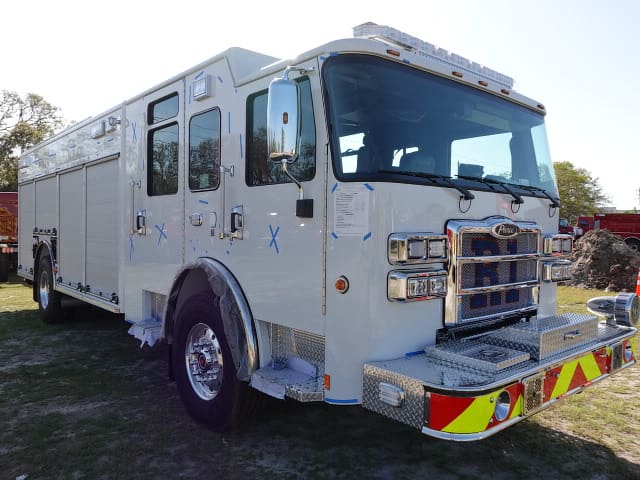

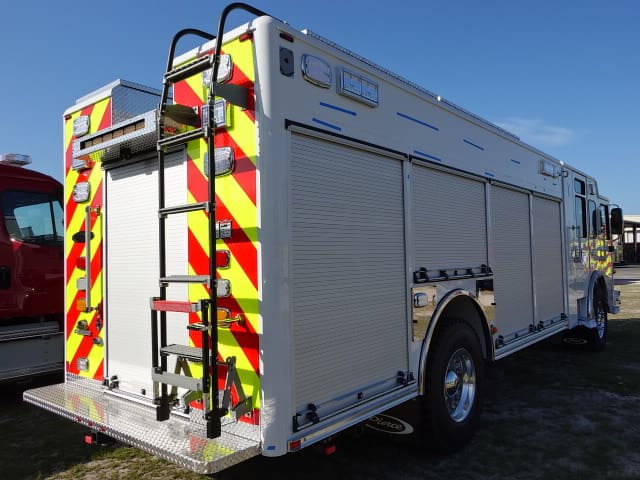

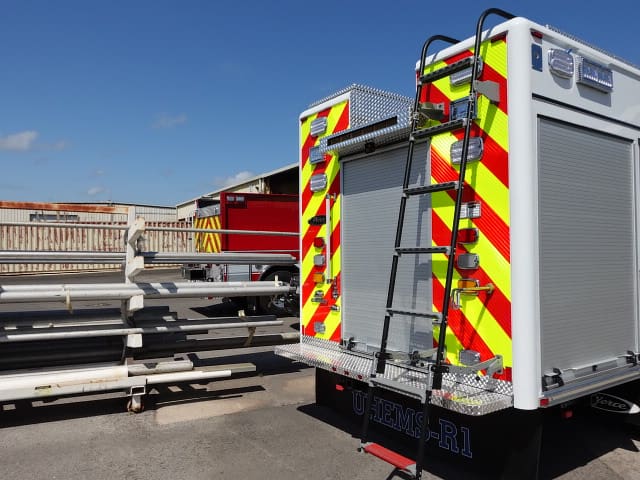

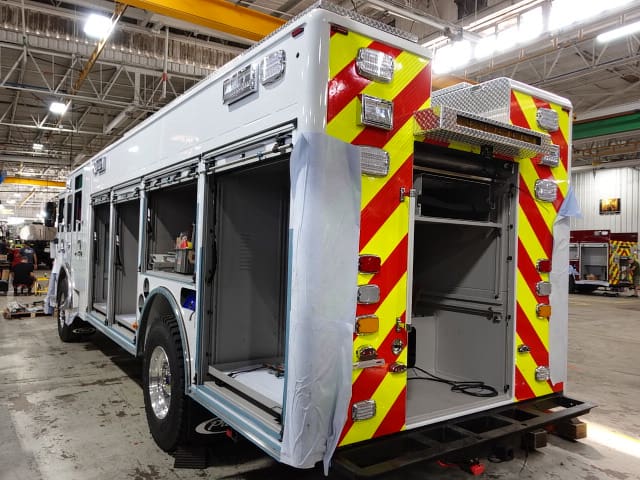

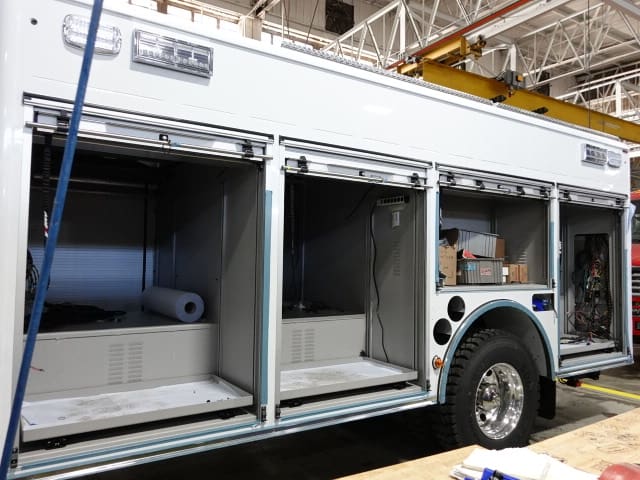

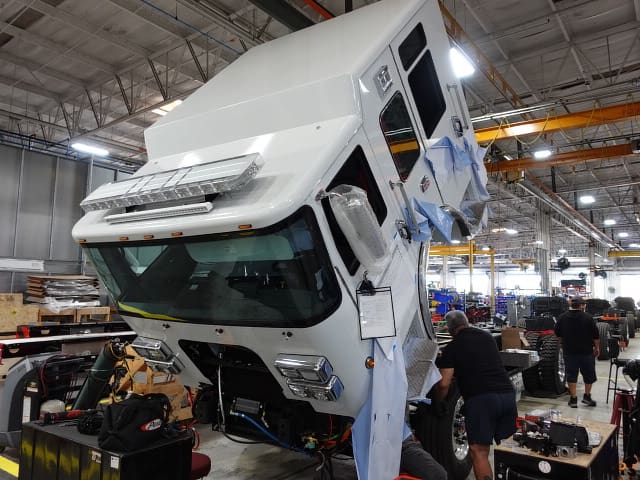

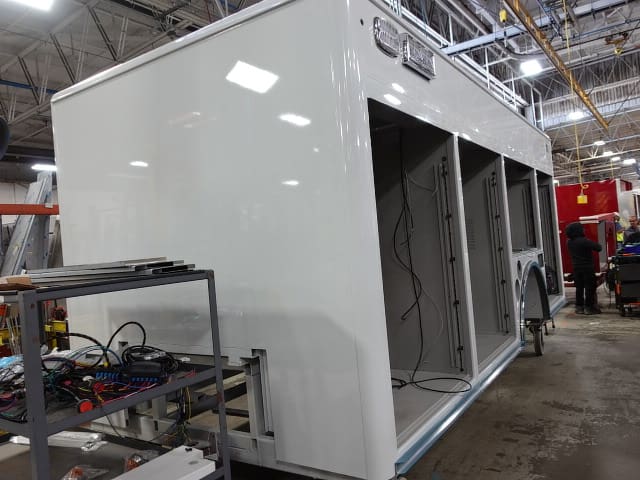

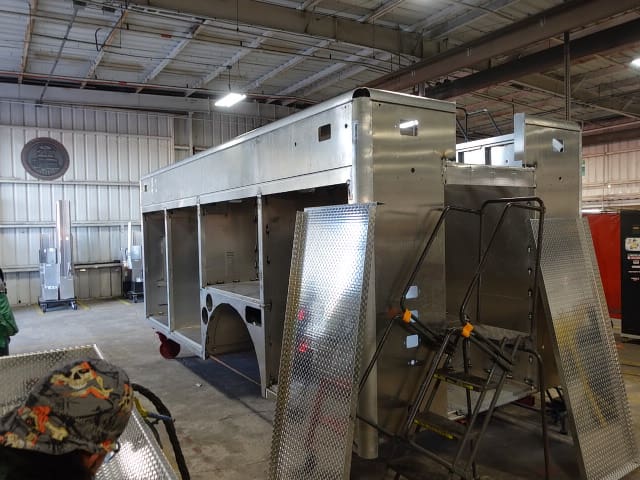

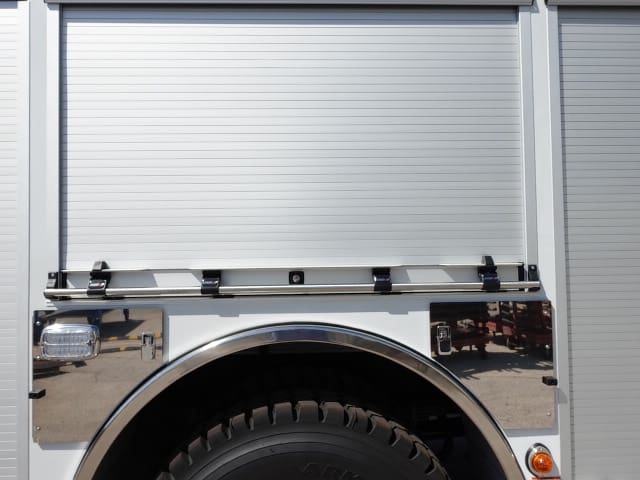

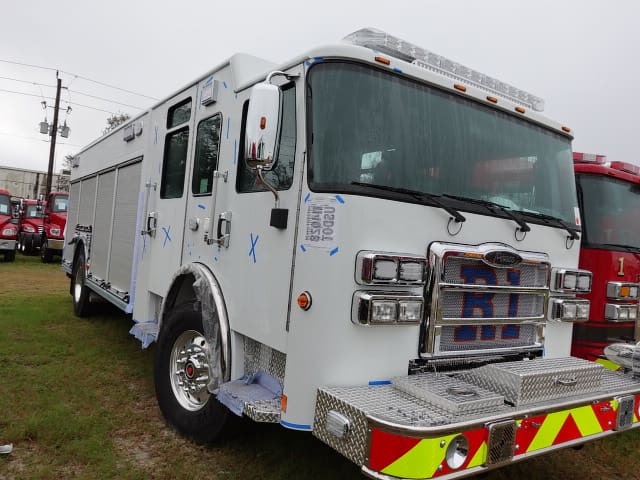

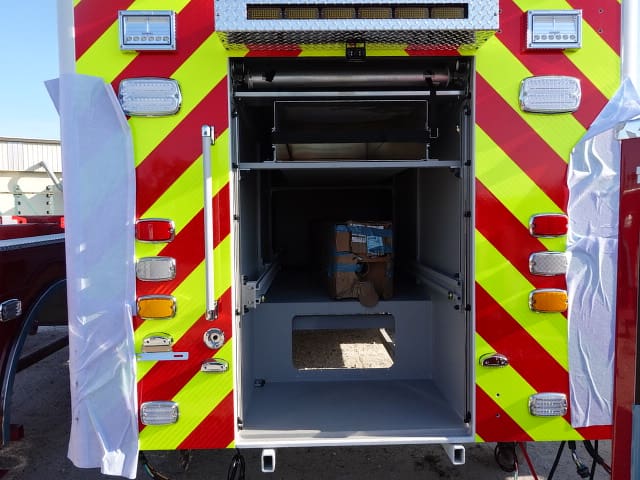

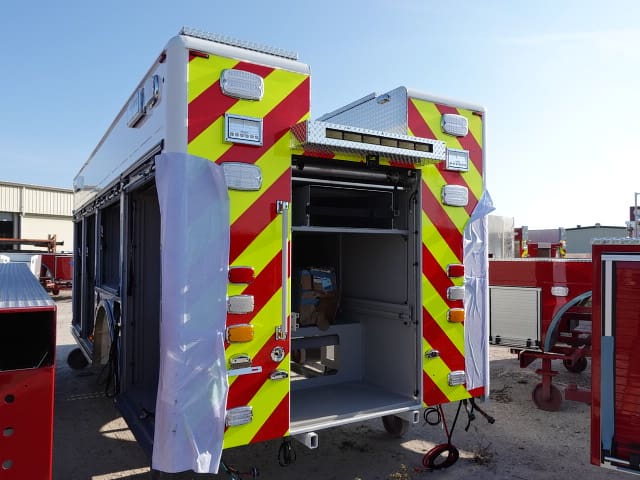

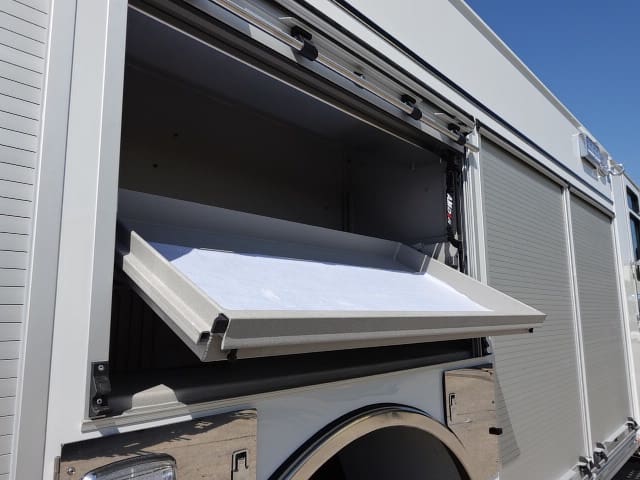

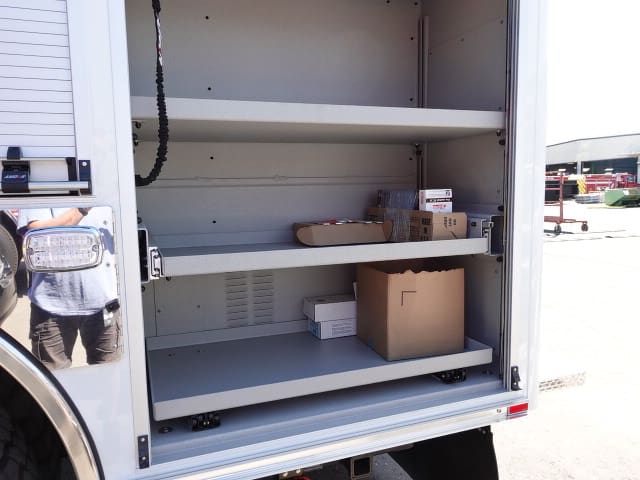

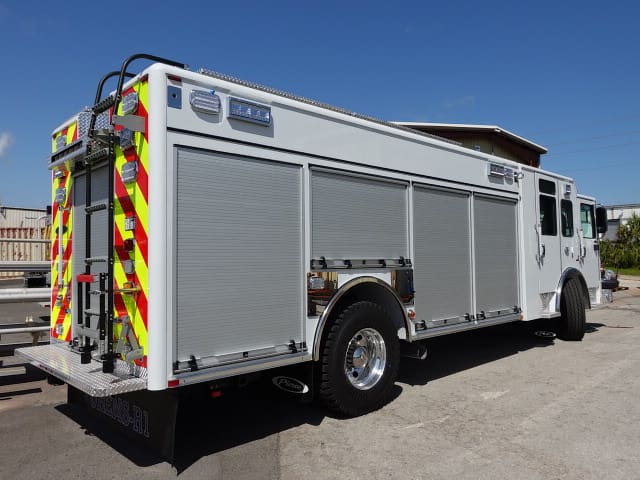

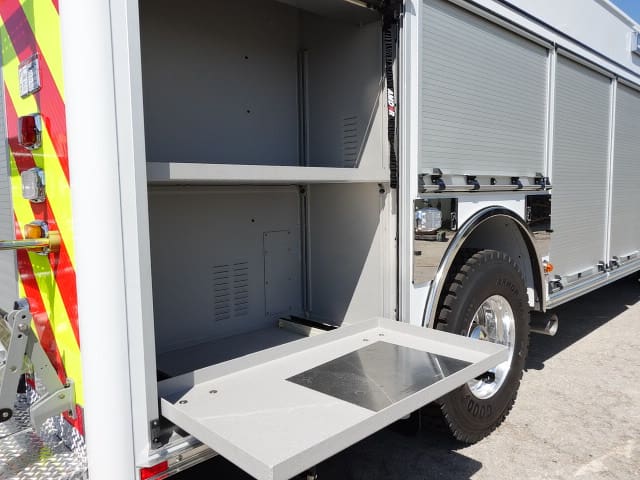

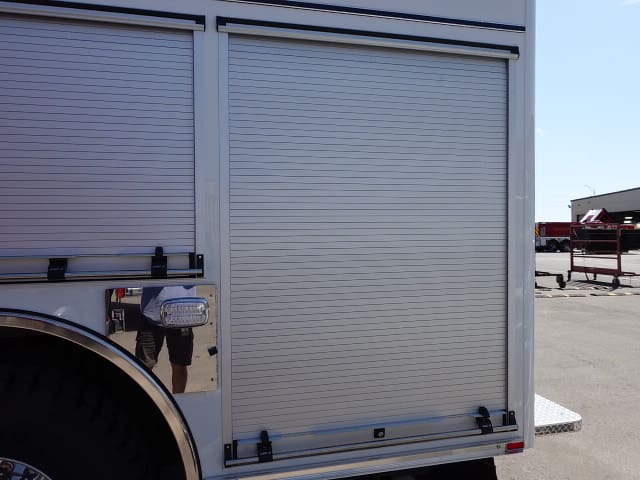

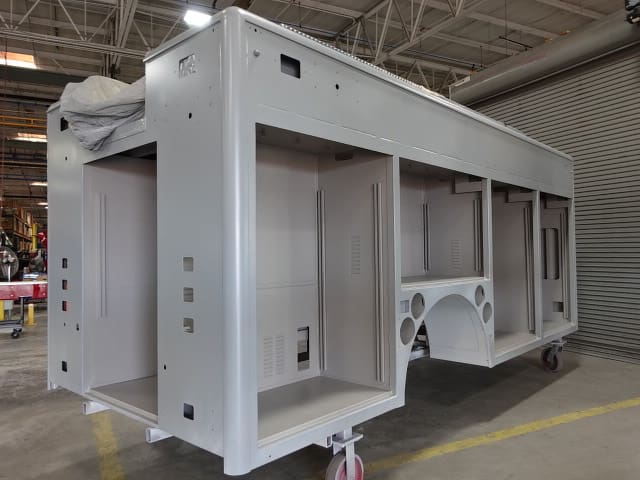

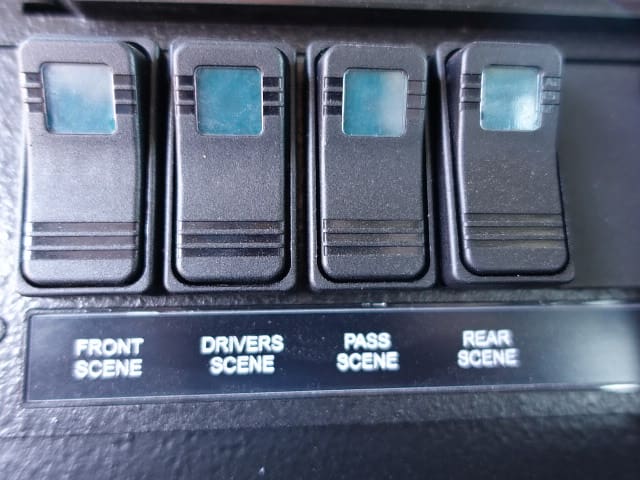

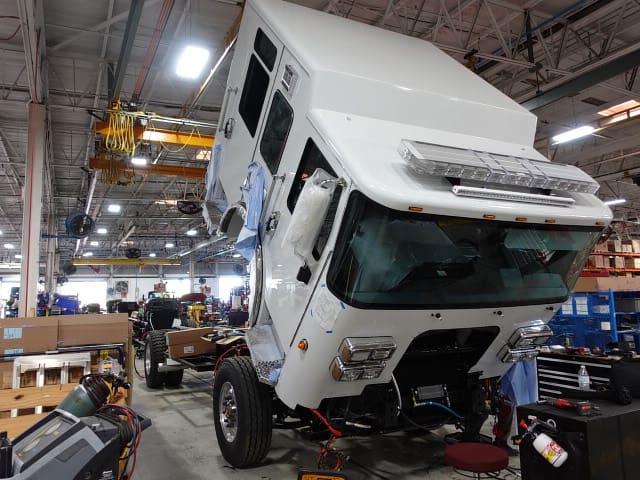

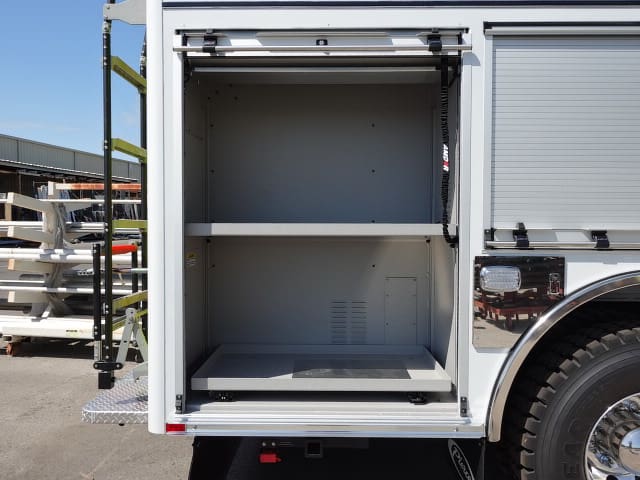

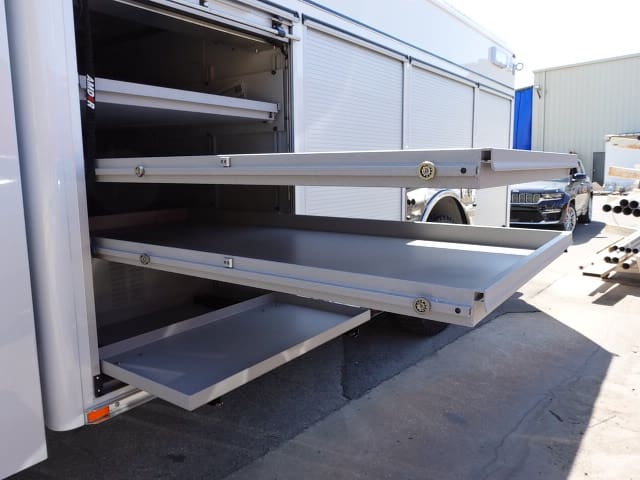

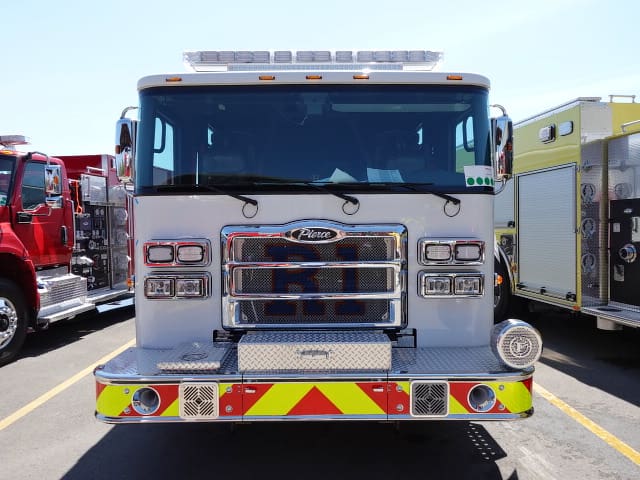

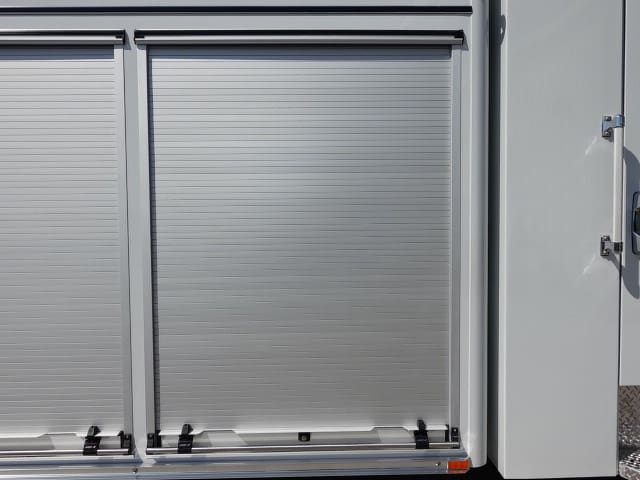

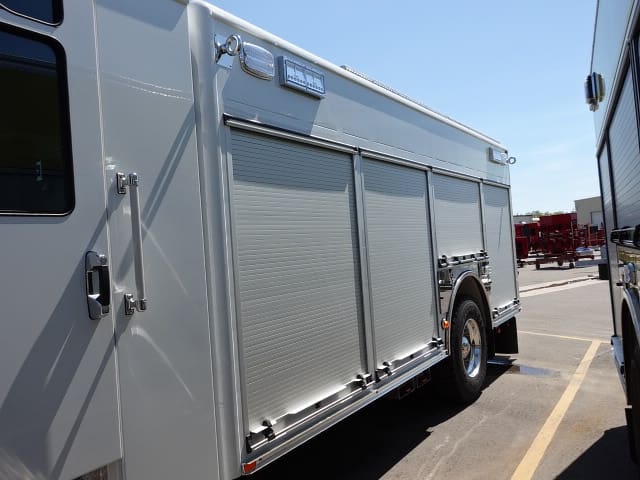

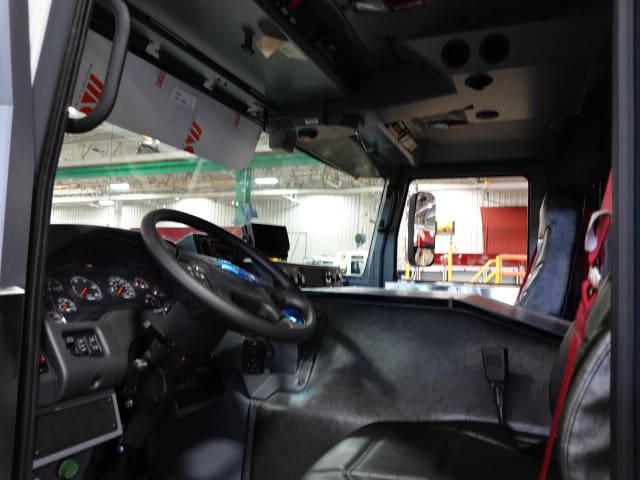

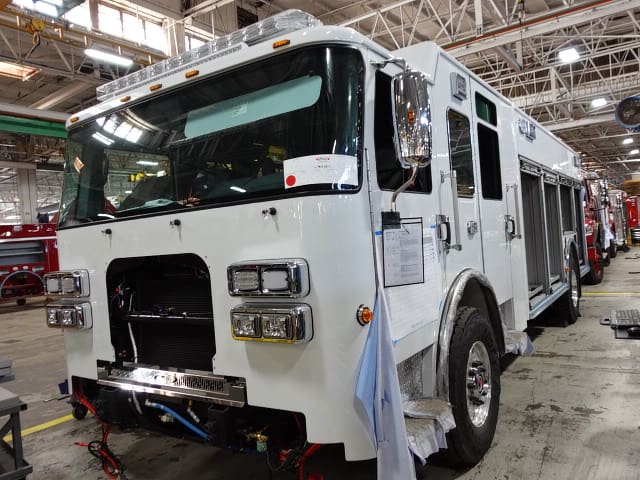

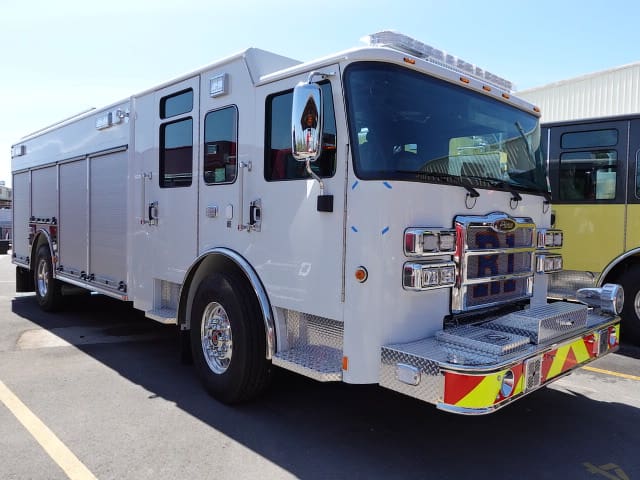

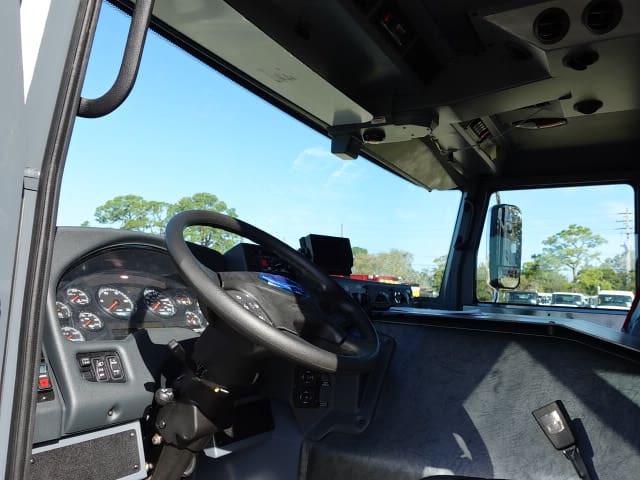

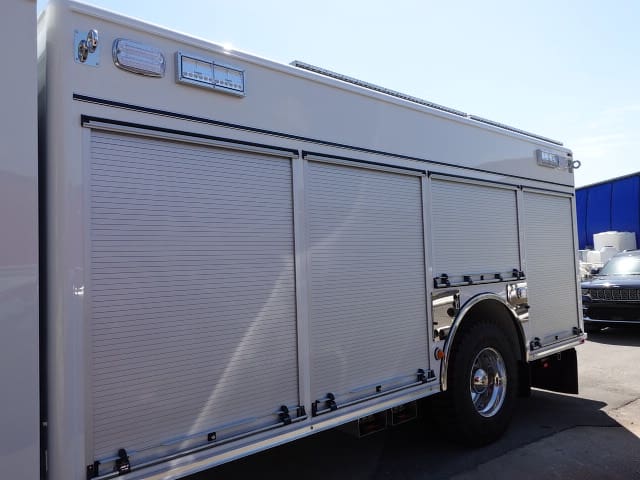

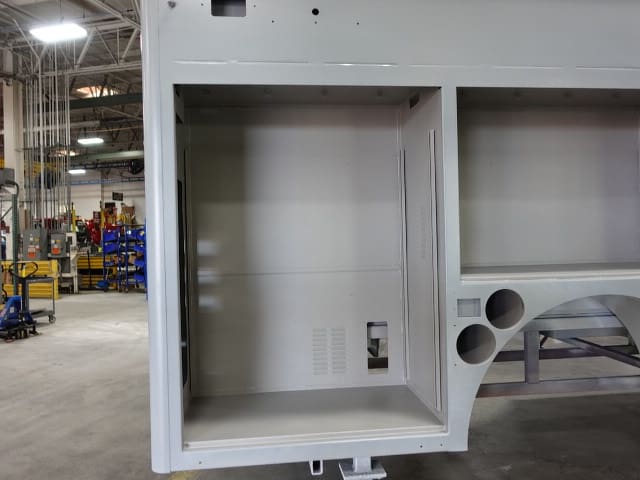

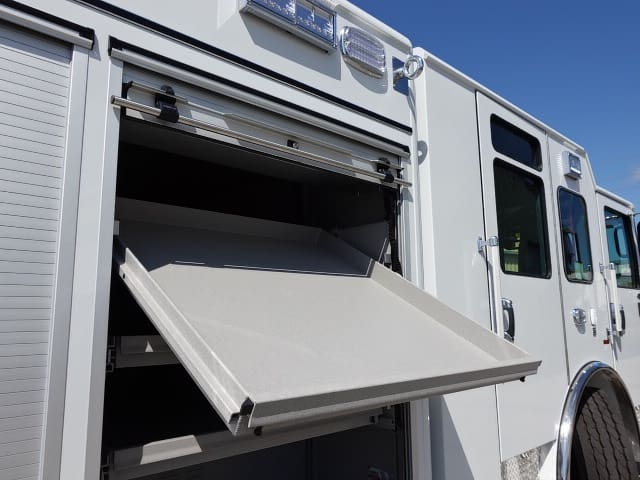

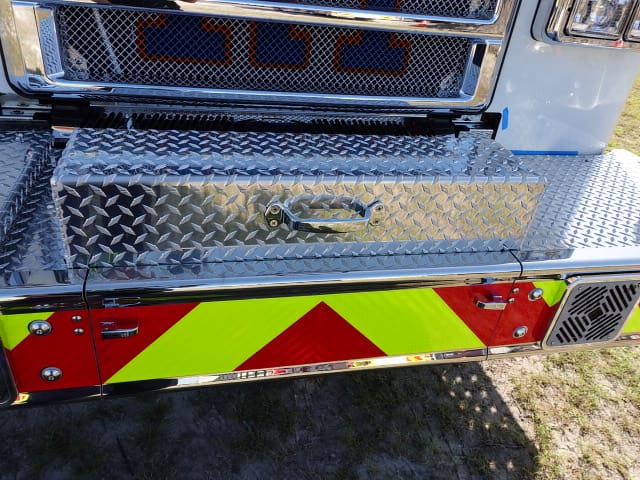

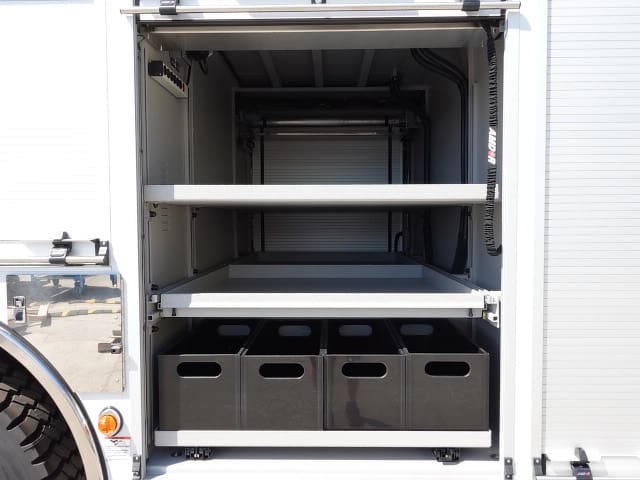

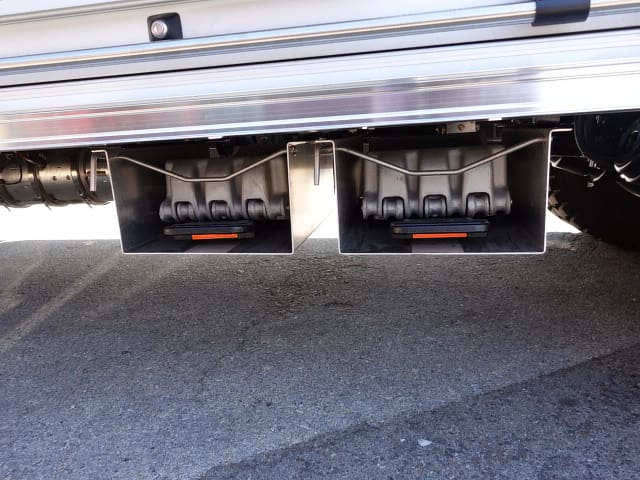

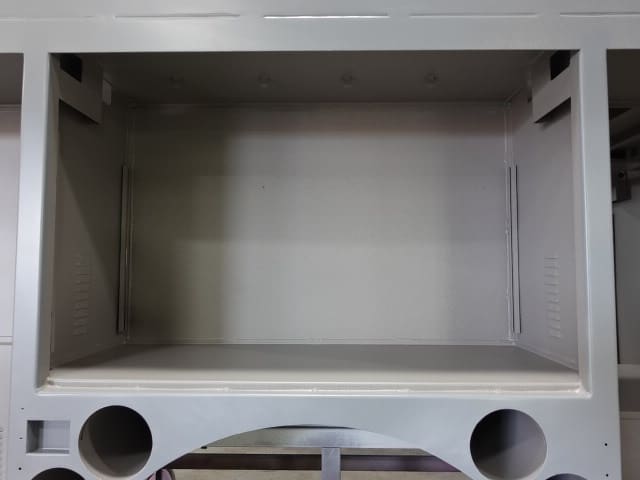

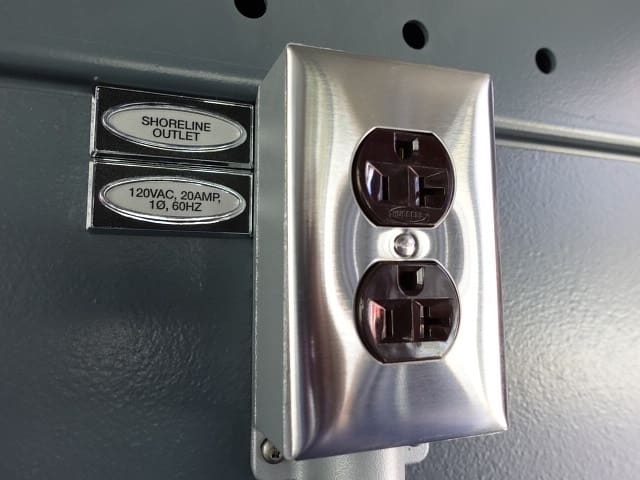

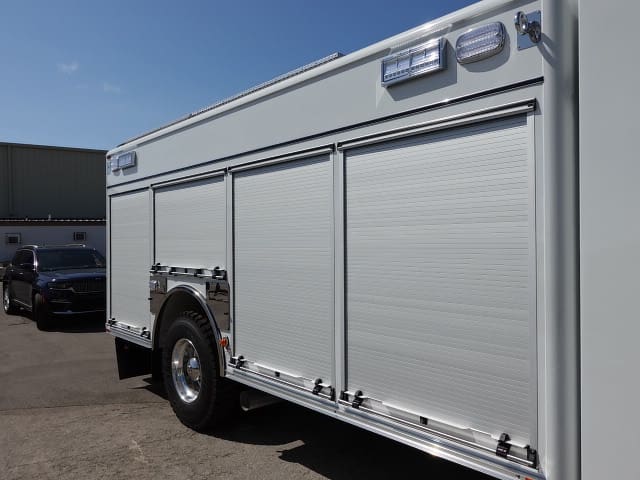

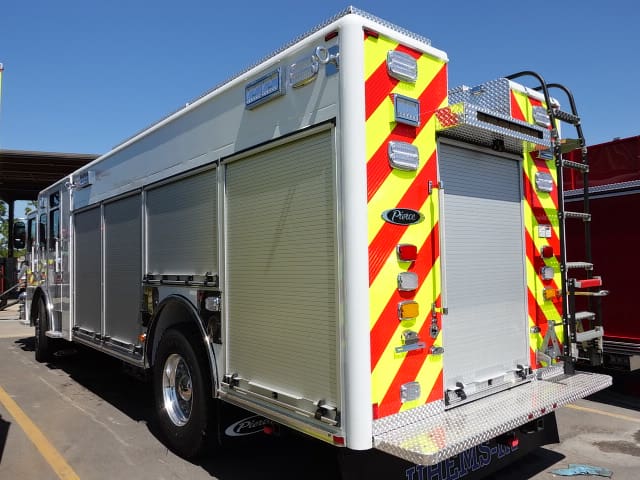

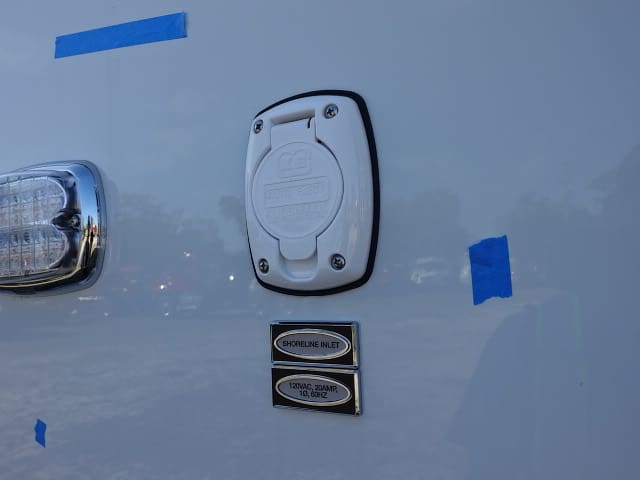

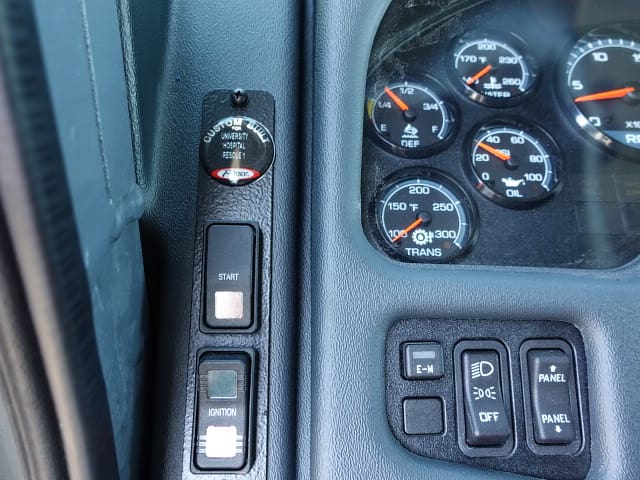

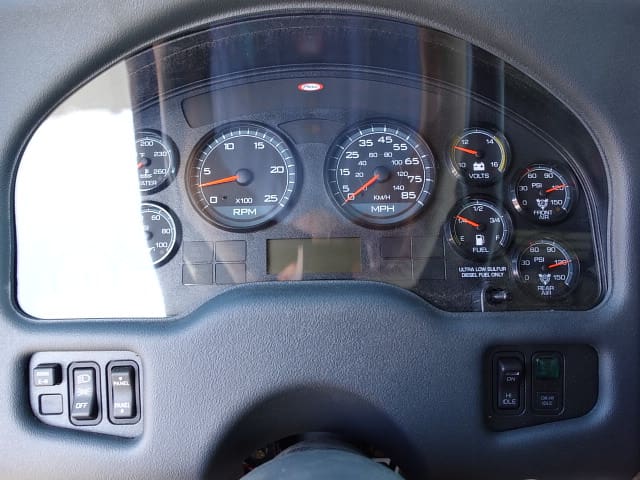

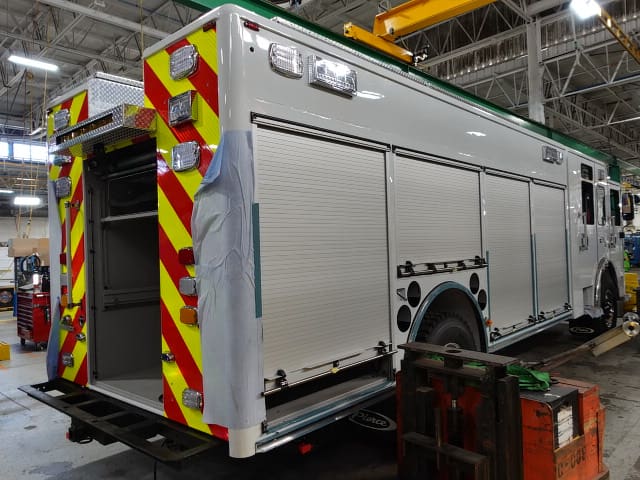

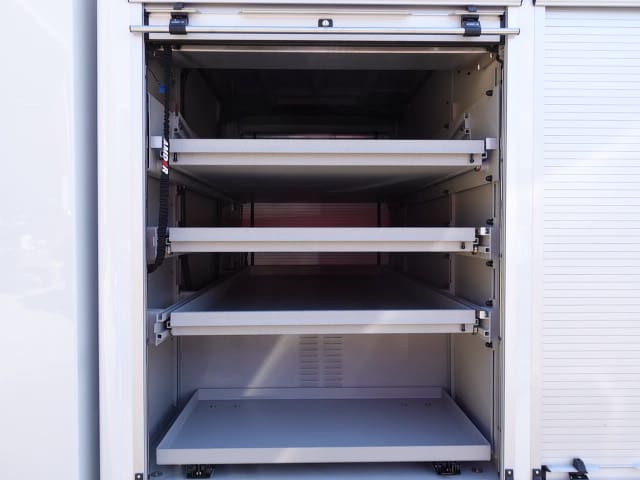

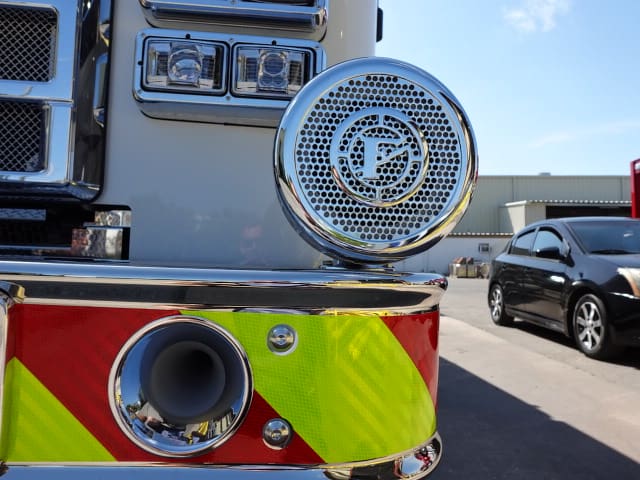

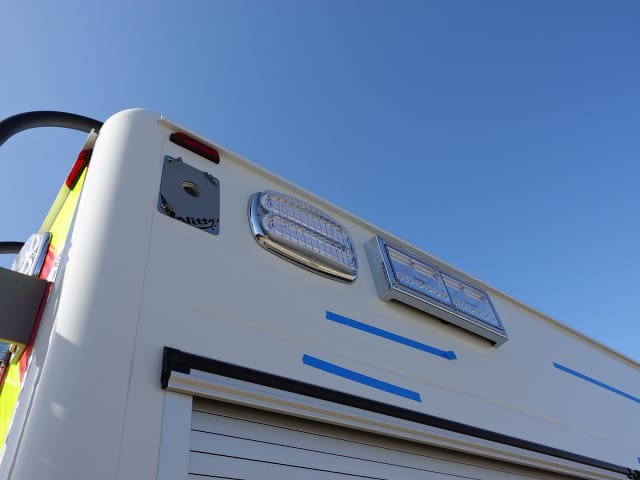

In this report, the apparatus completed final assembly and was then released to final product evaluation where any remaining content will be applied. Once finished, it will be made ready for the customer acceptance inspection. This is the last scheduled report.

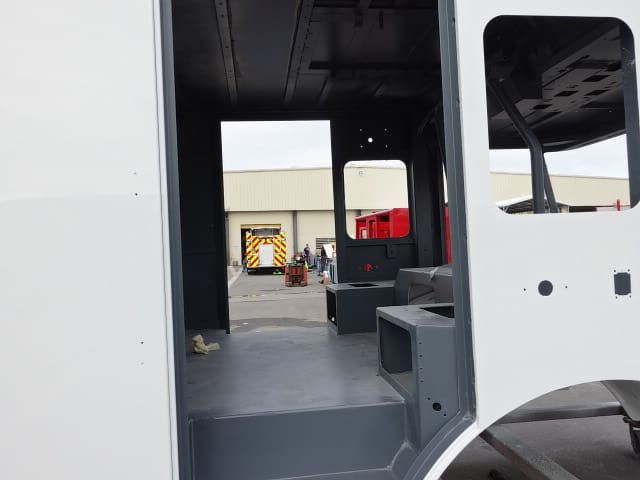

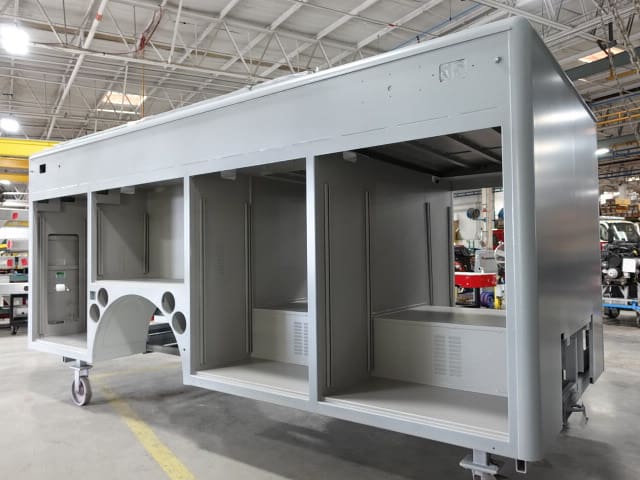

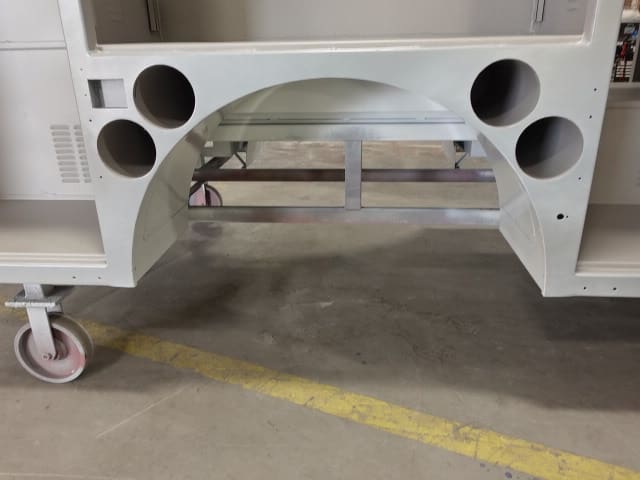

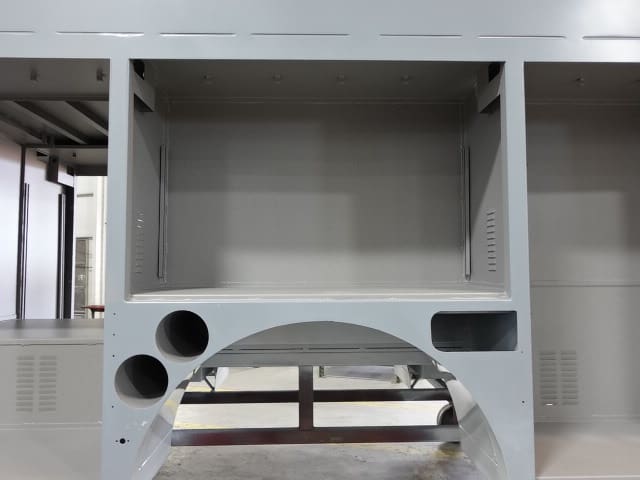

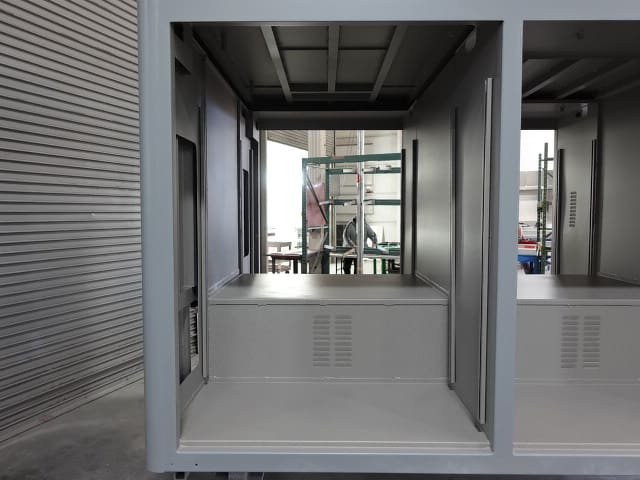

02-14-25

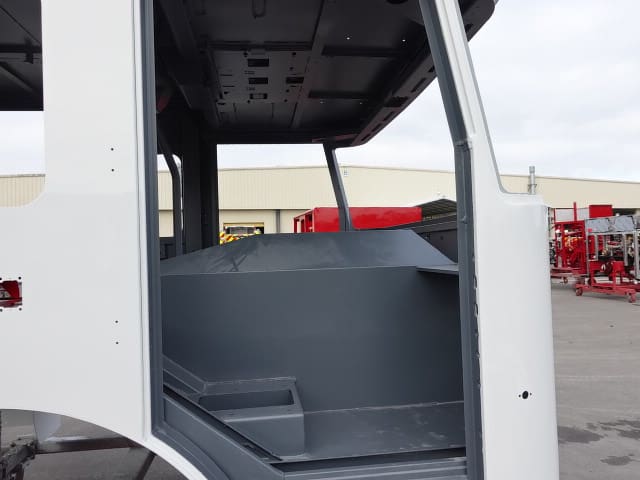

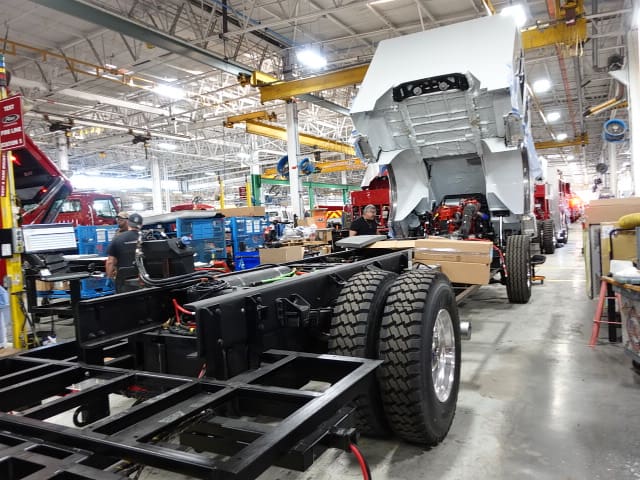

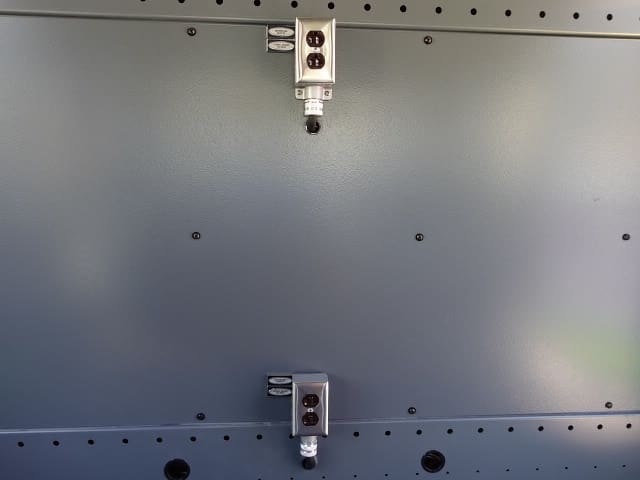

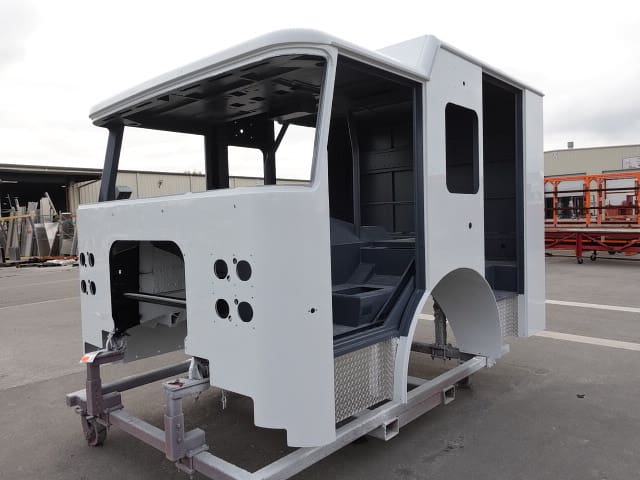

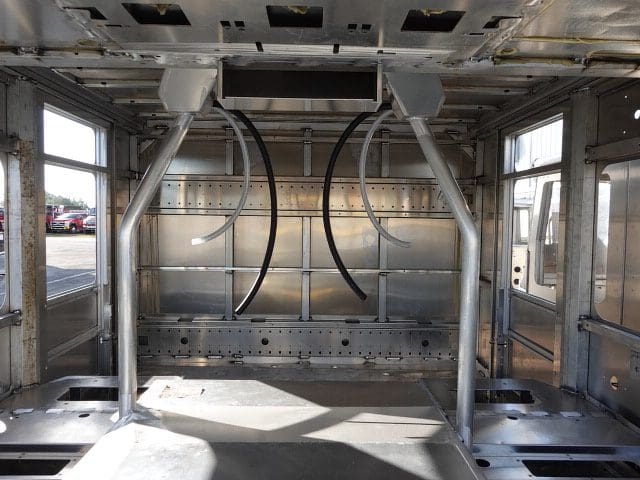

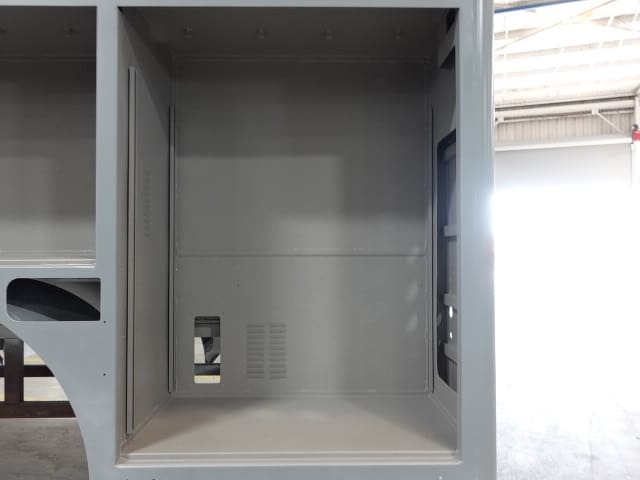

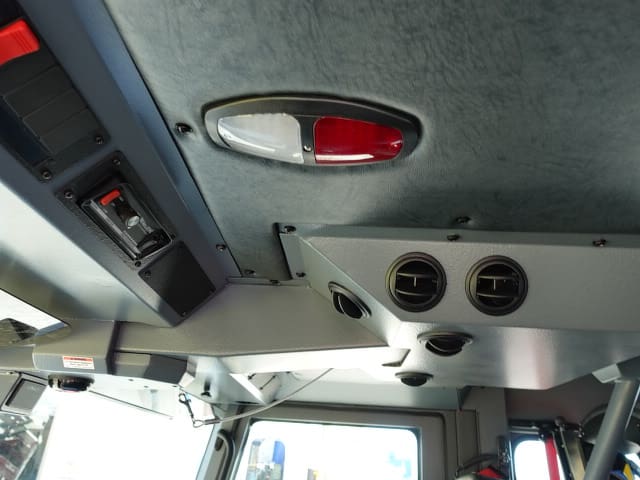

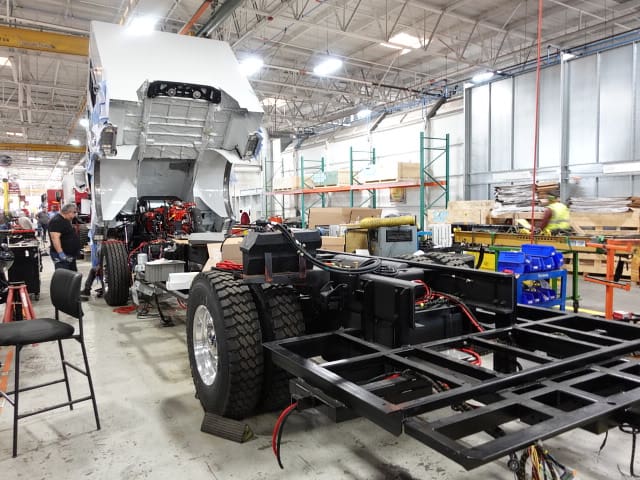

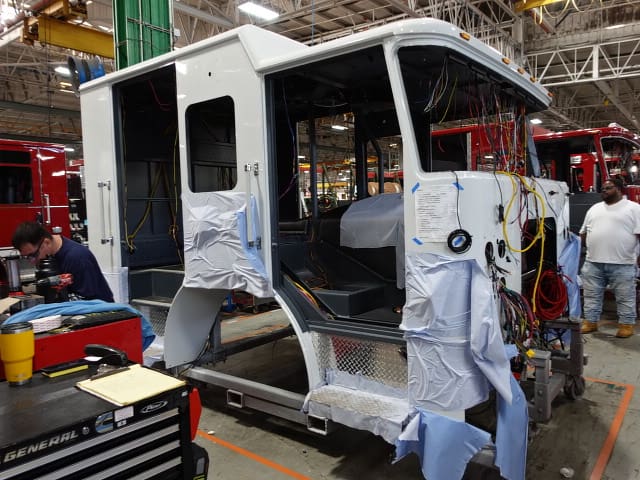

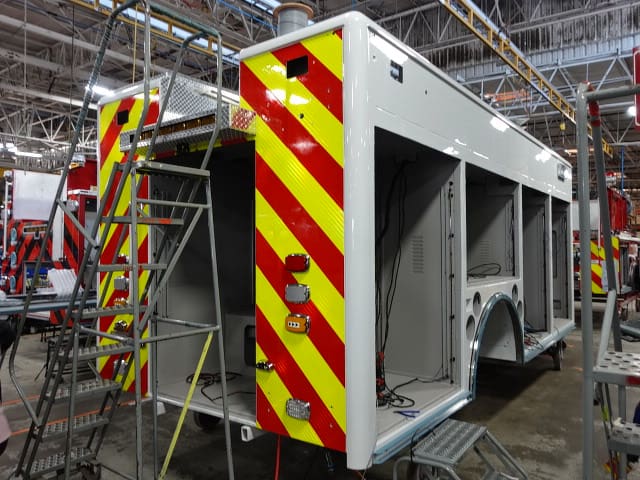

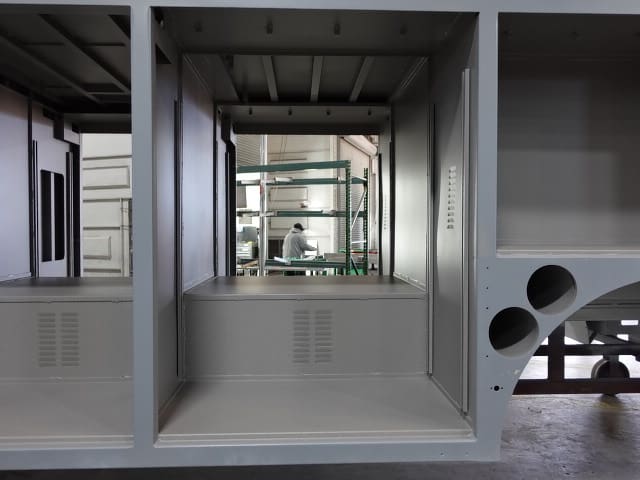

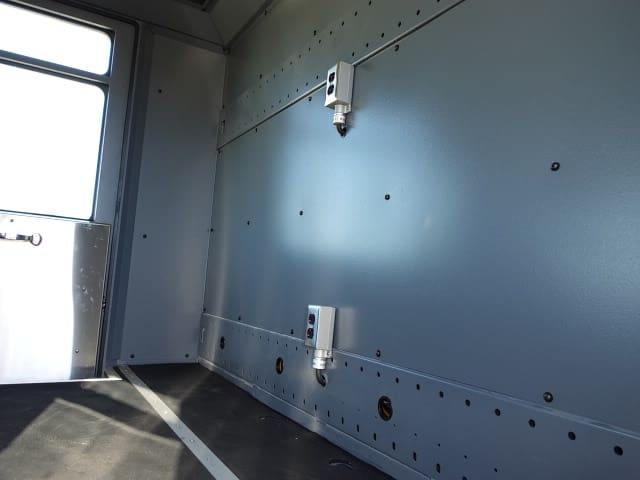

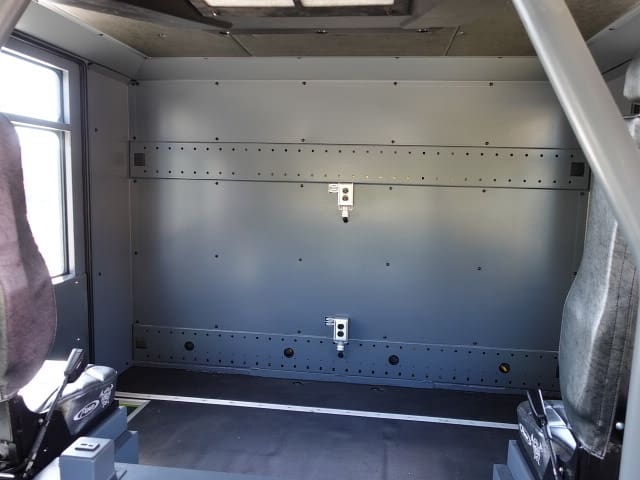

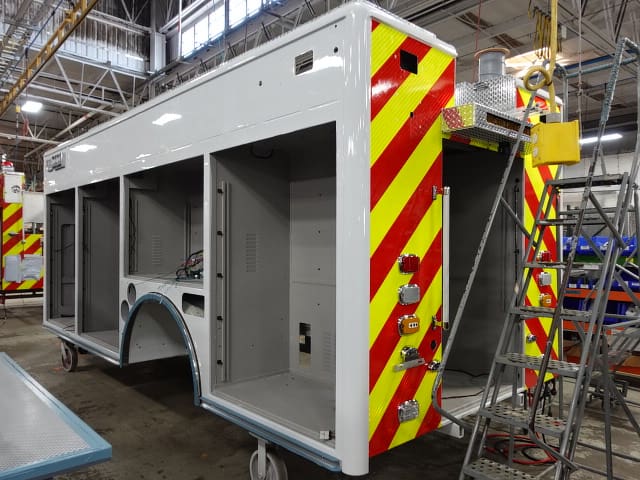

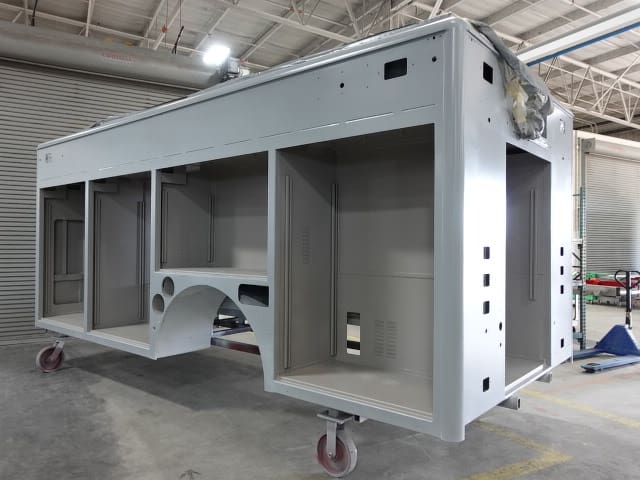

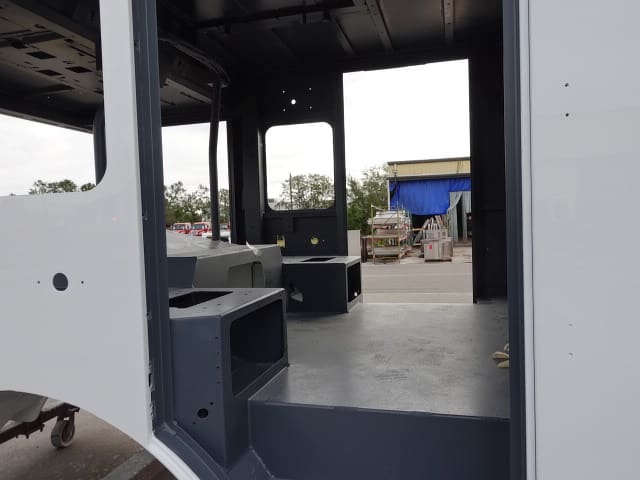

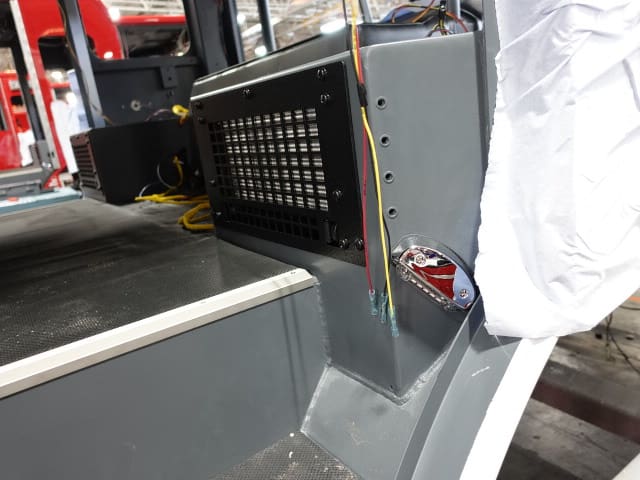

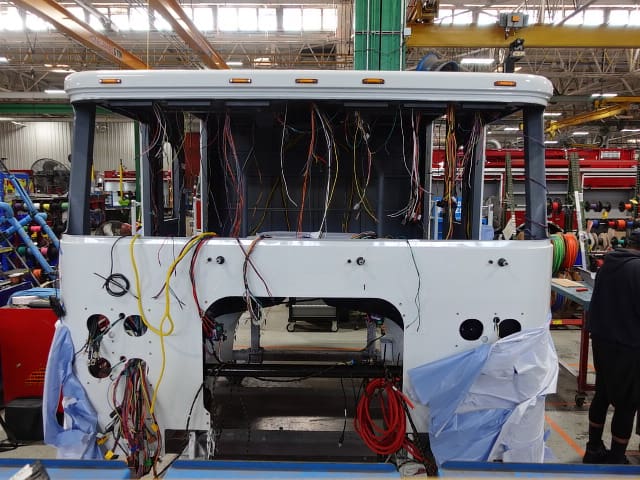

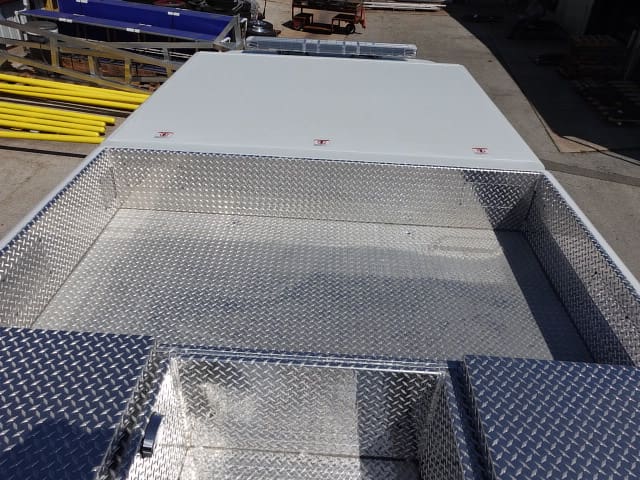

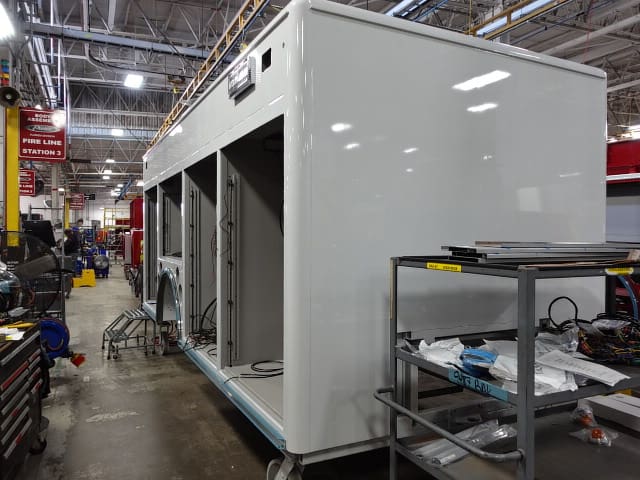

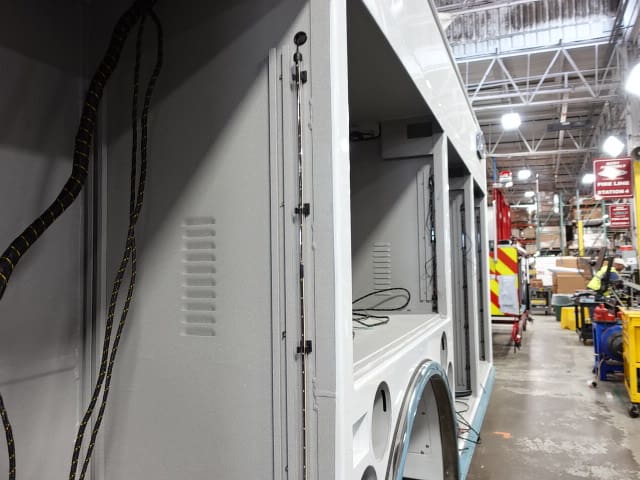

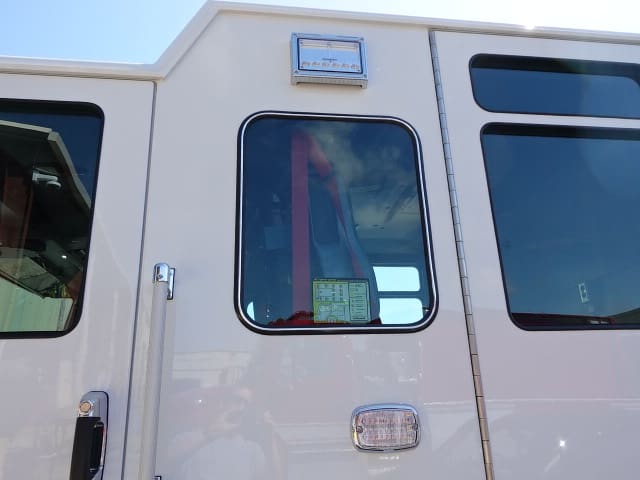

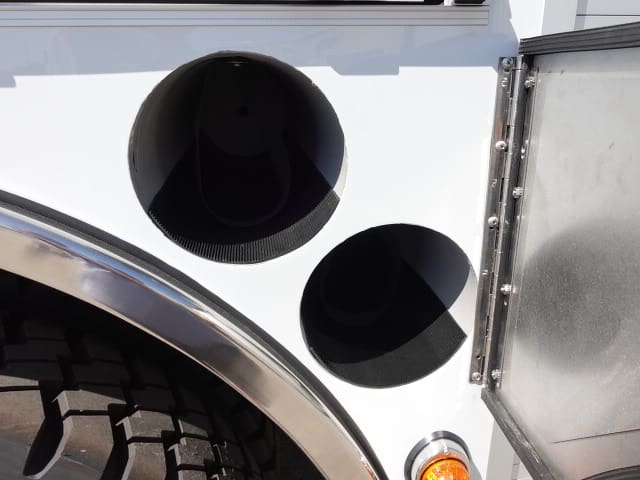

In this report, the body was merged with the chassis and with the start of initial assembly.

02-07-25

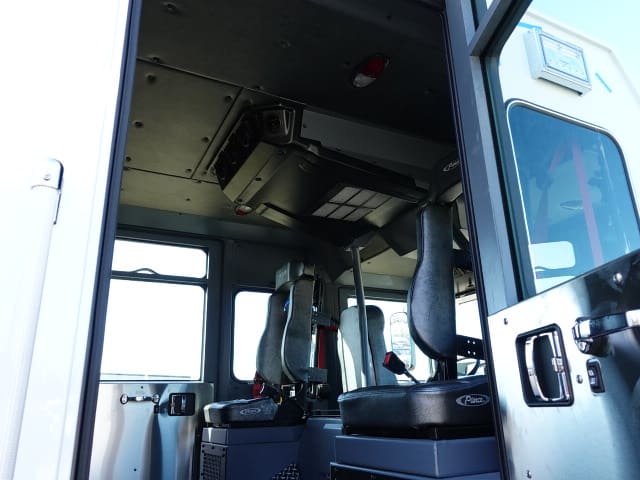

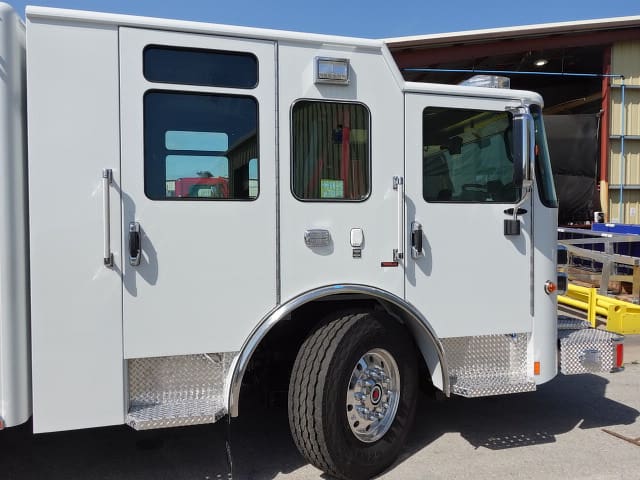

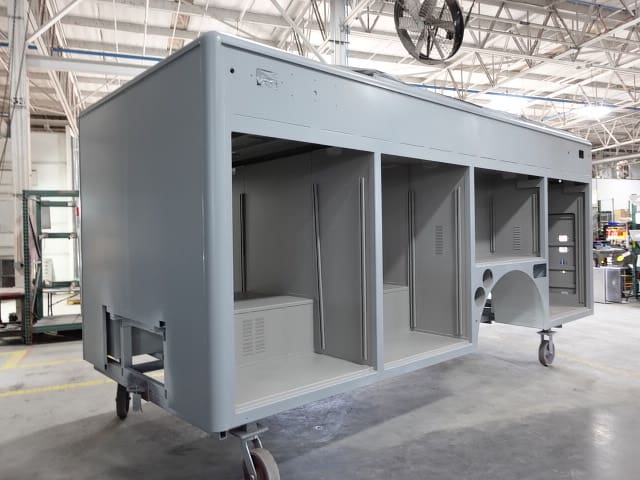

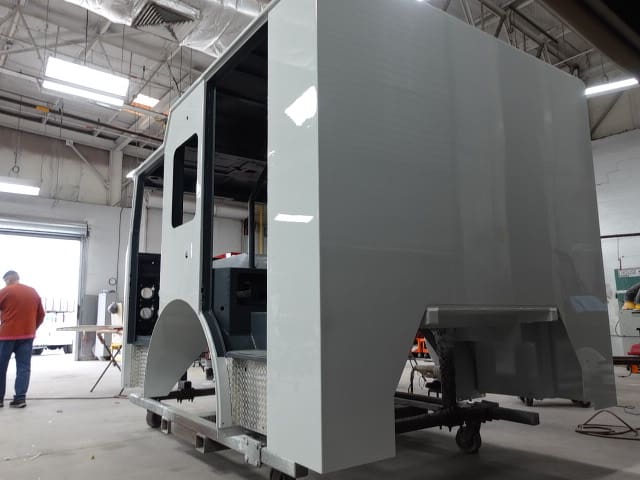

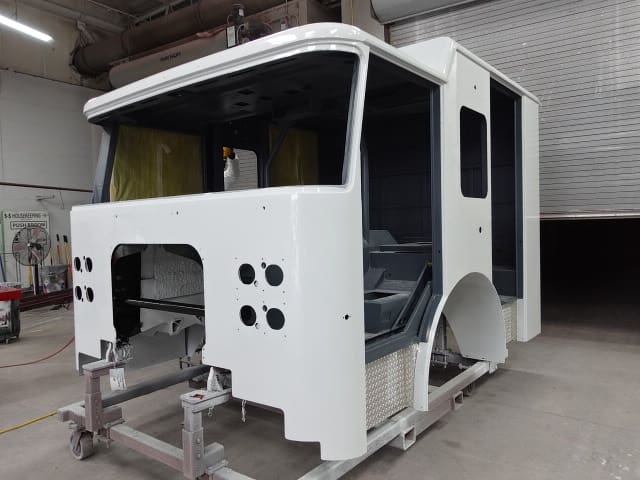

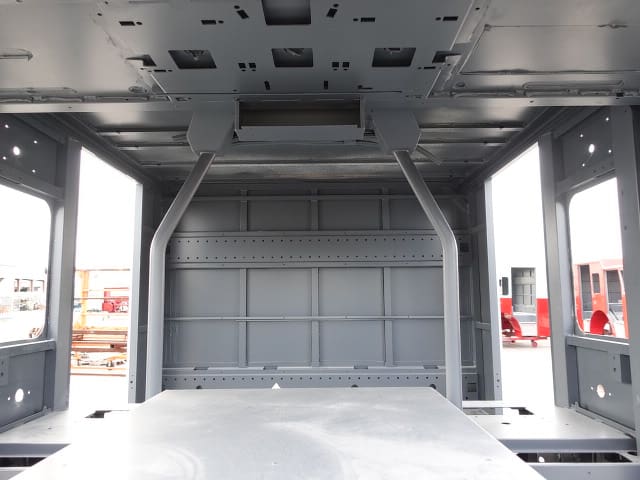

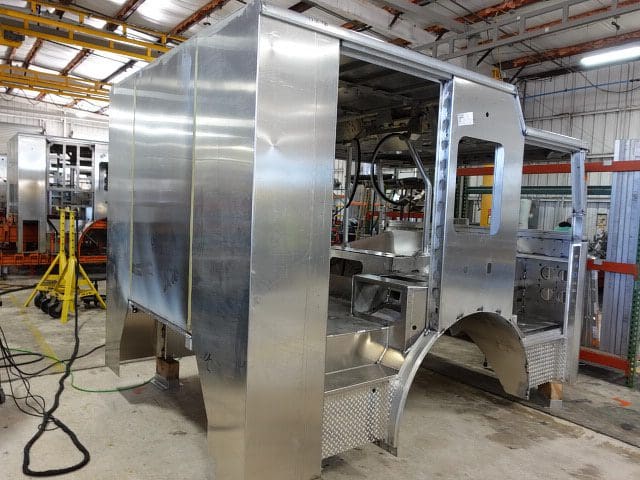

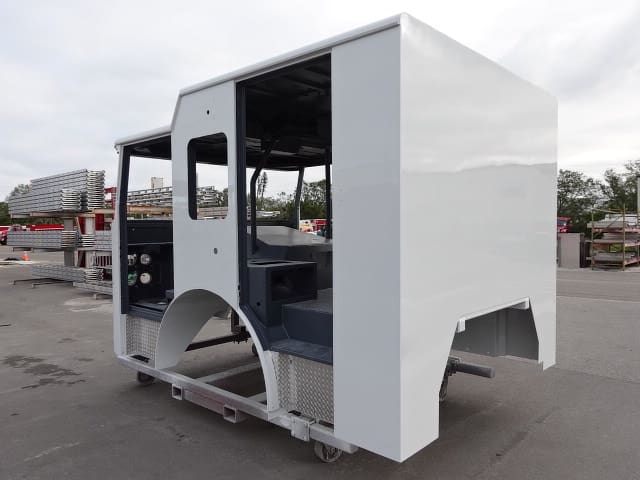

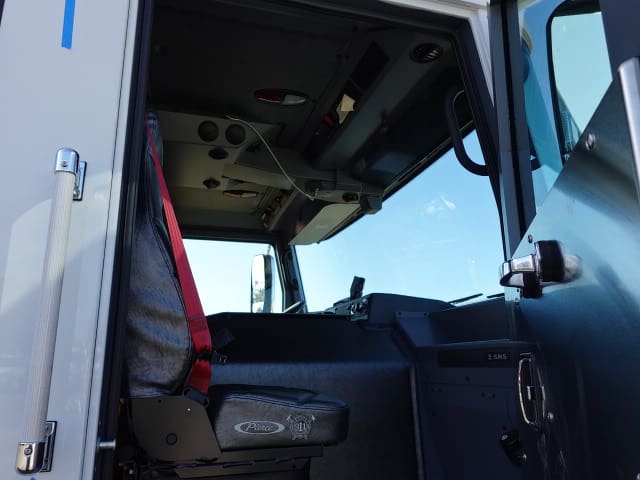

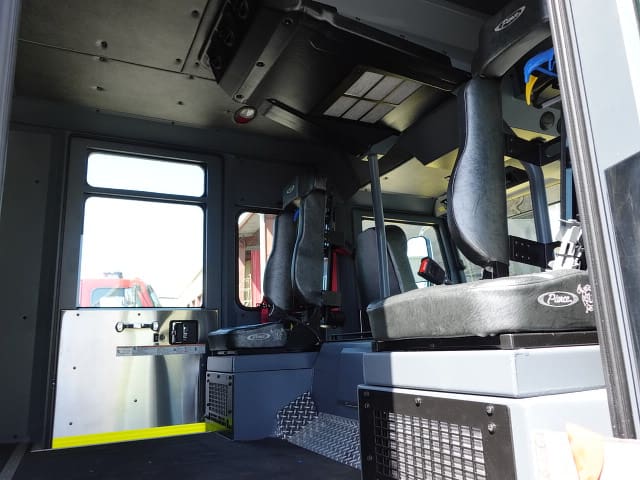

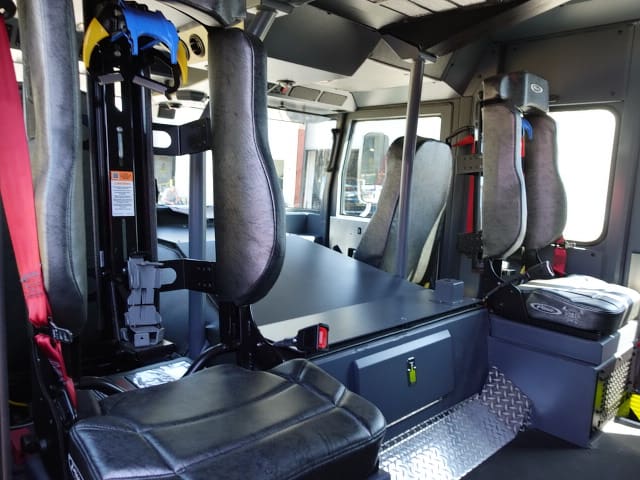

In this report, the cab completed initial assembly and was installed on the frame while the body completed initial assembly.

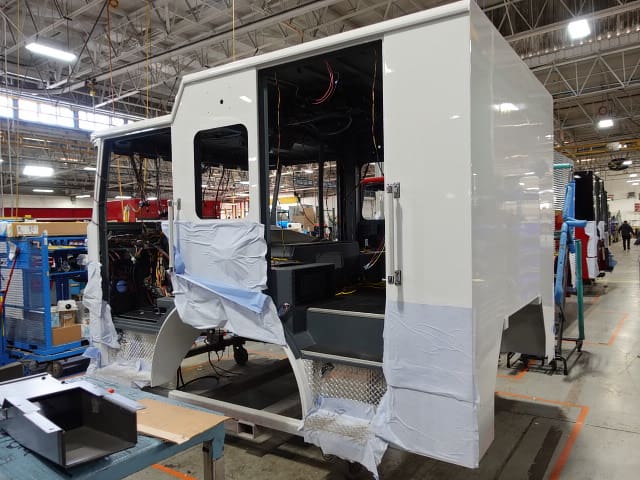

01-31-25

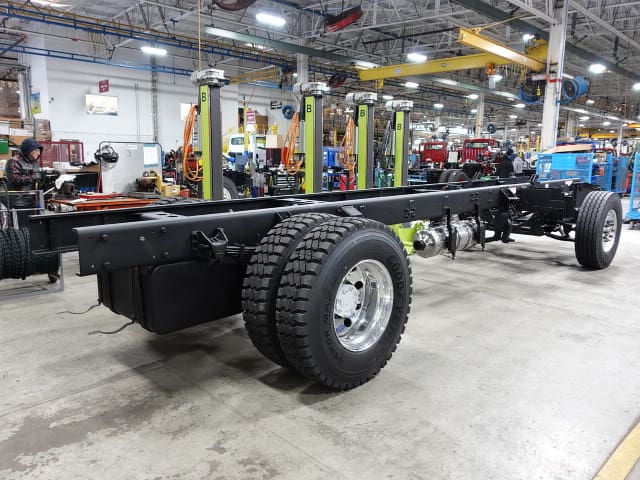

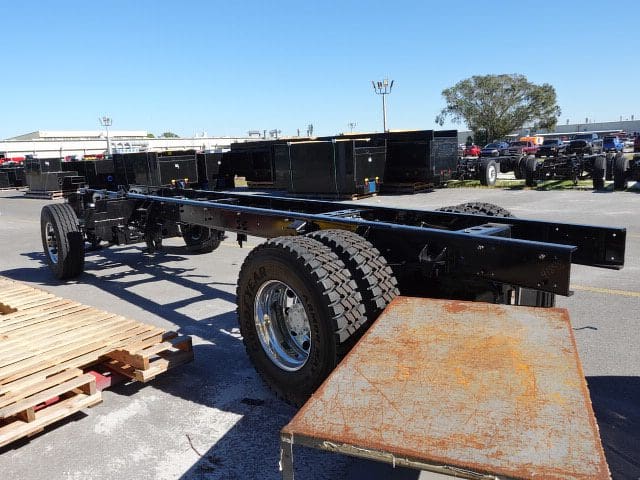

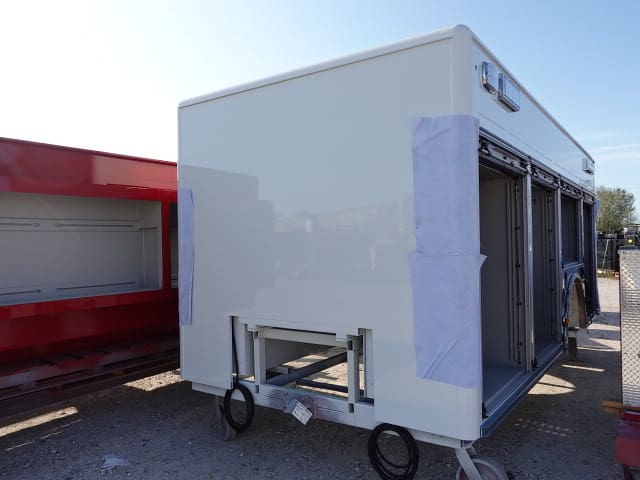

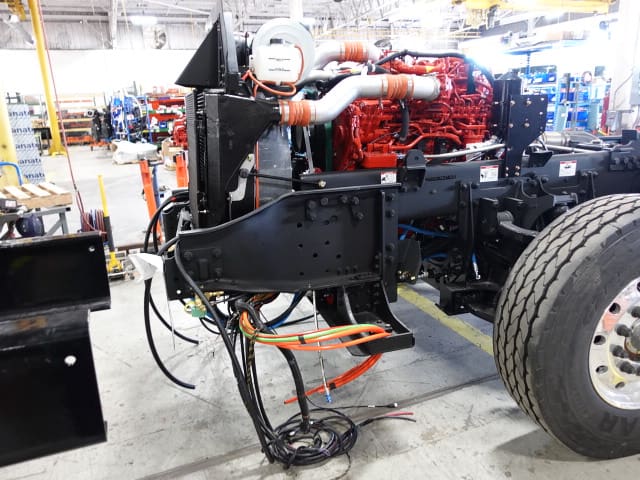

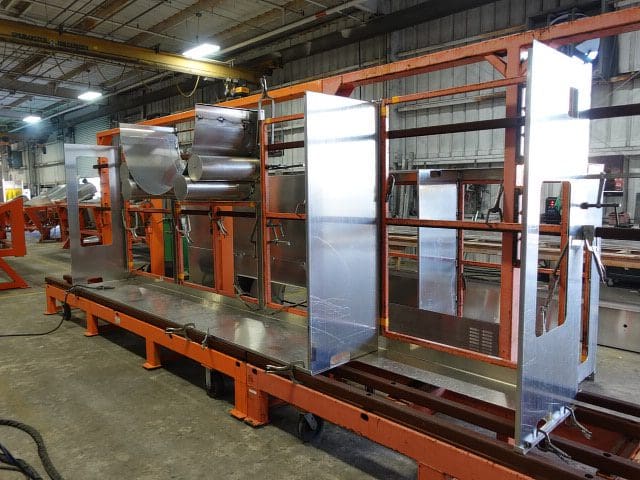

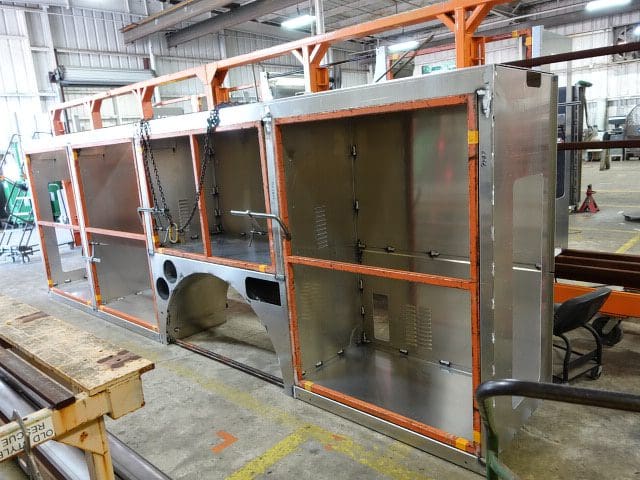

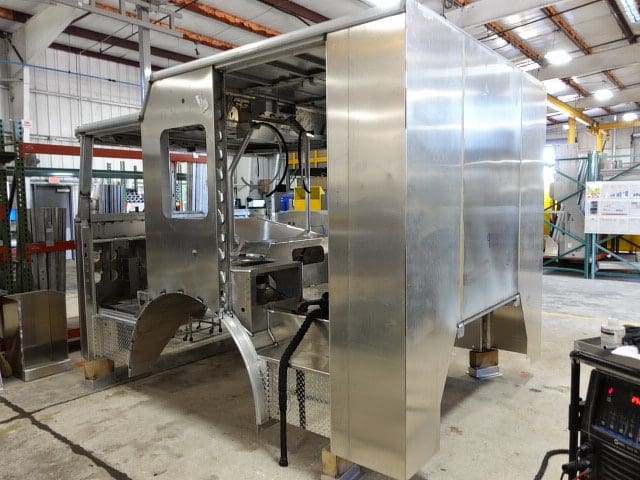

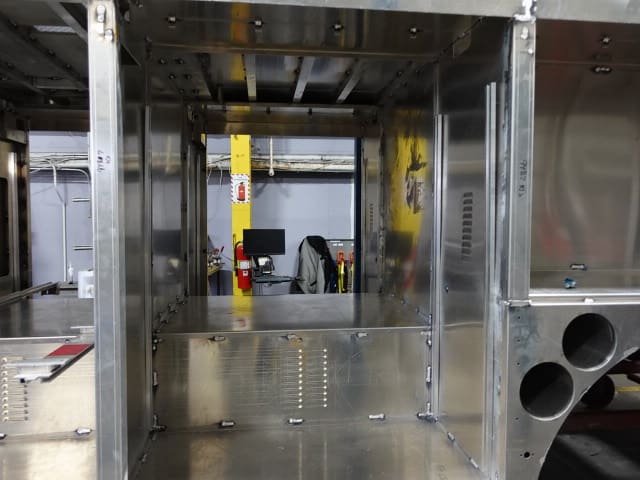

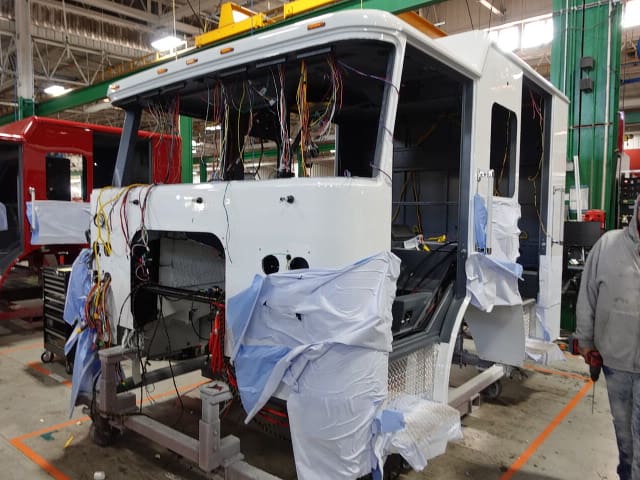

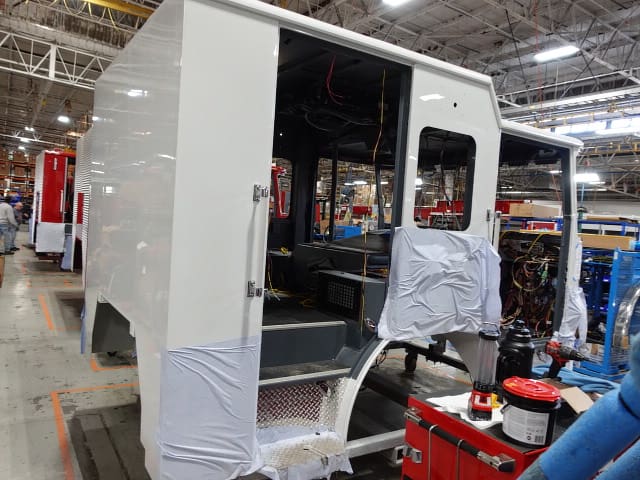

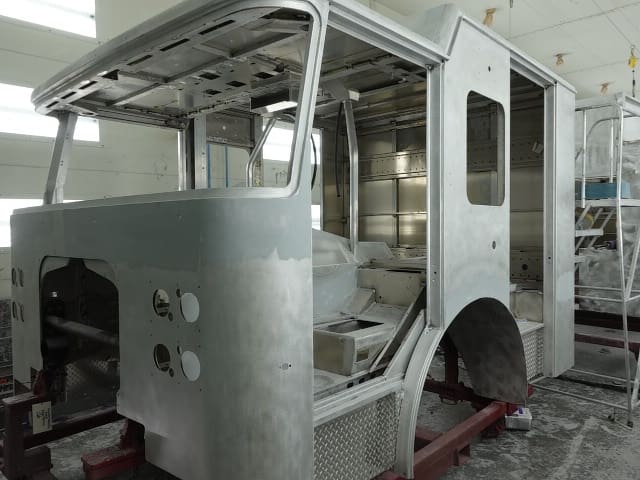

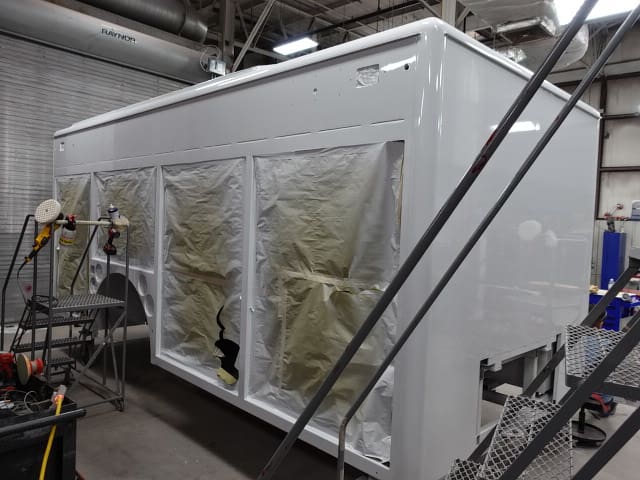

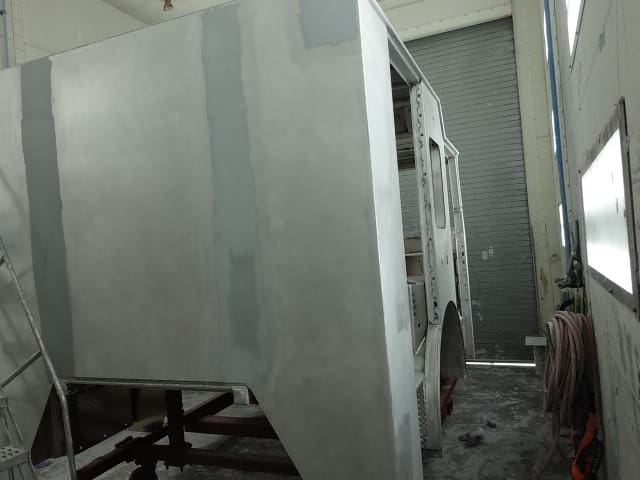

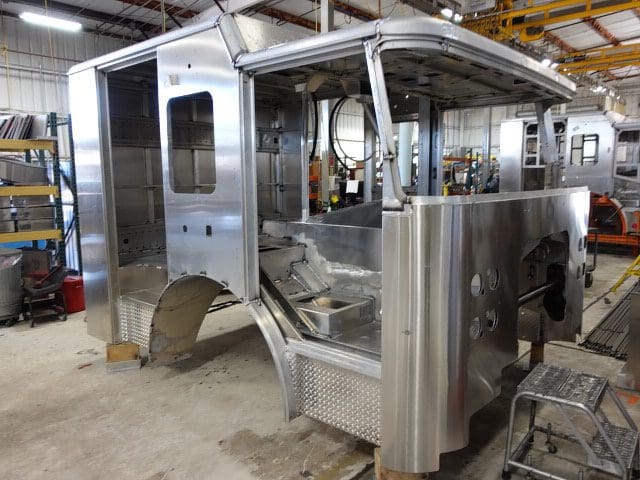

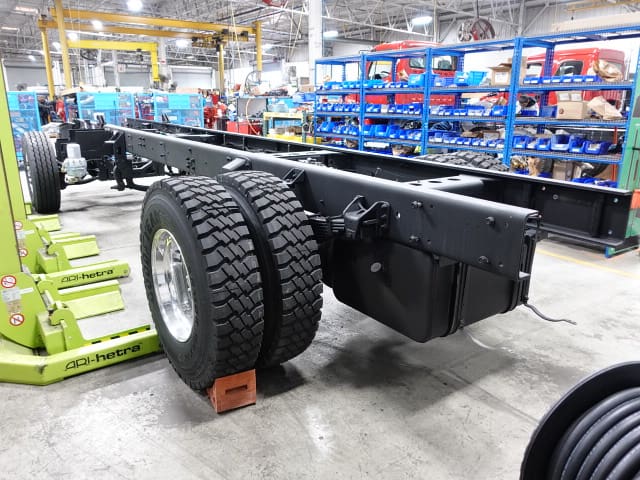

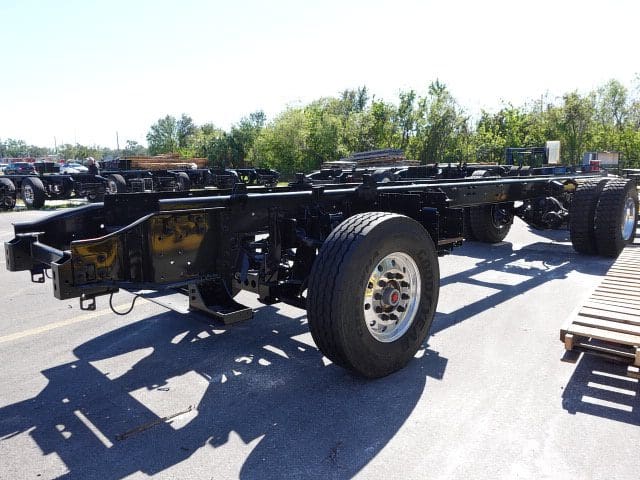

In this report, cab began initial assembly, the frame build continued, and the body completed paint and began initial assembly.

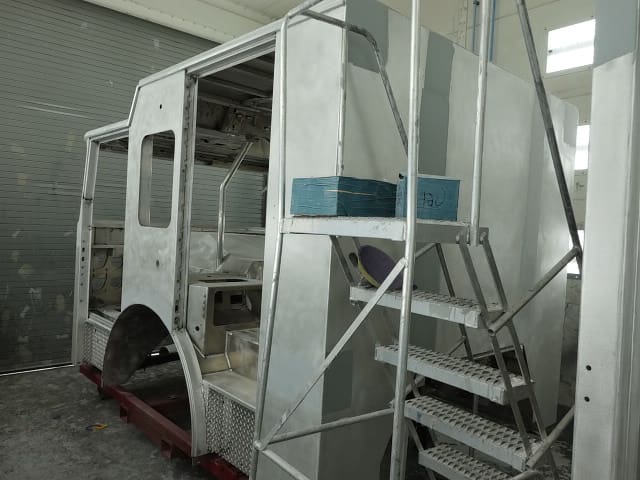

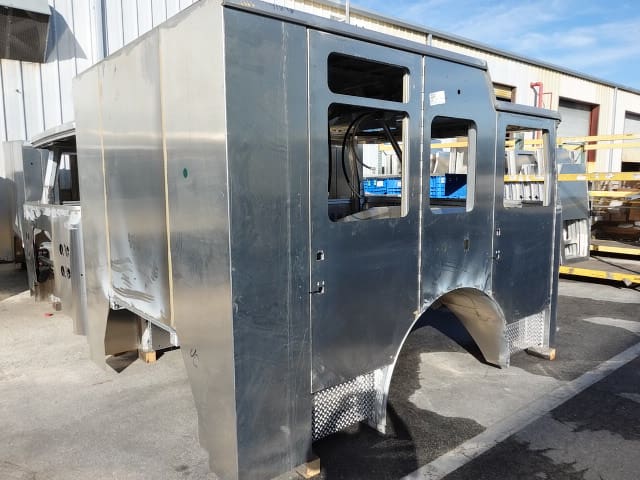

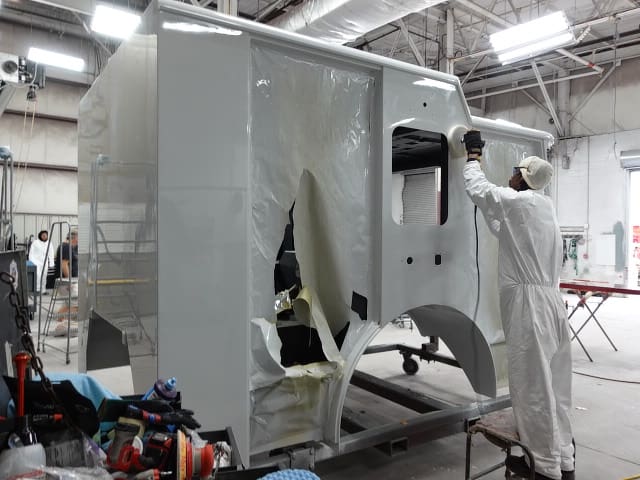

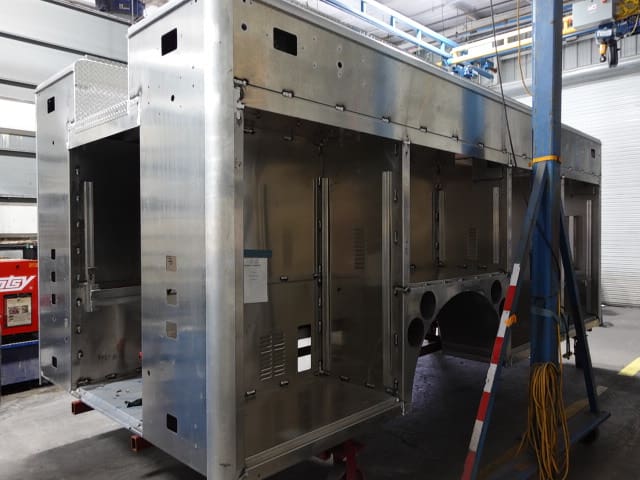

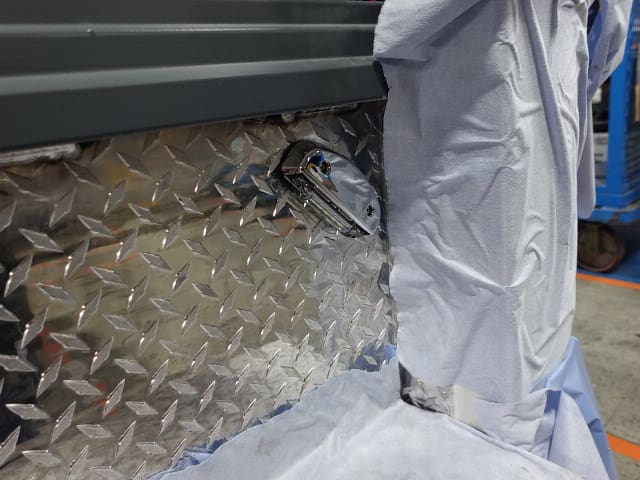

01-17-25

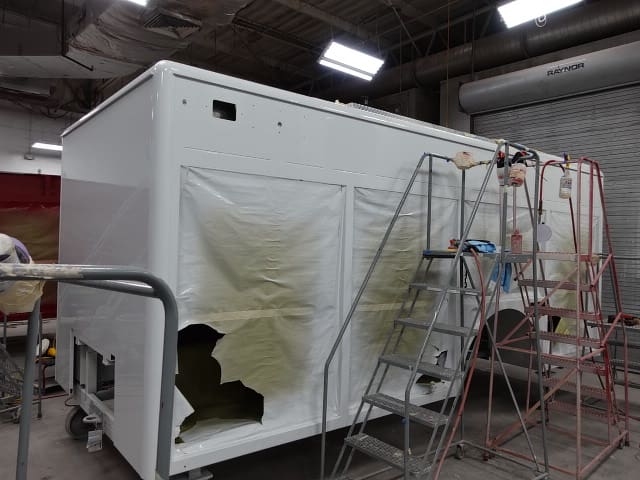

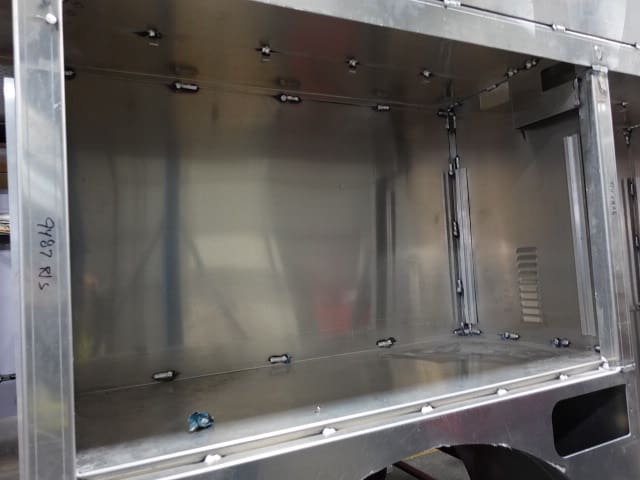

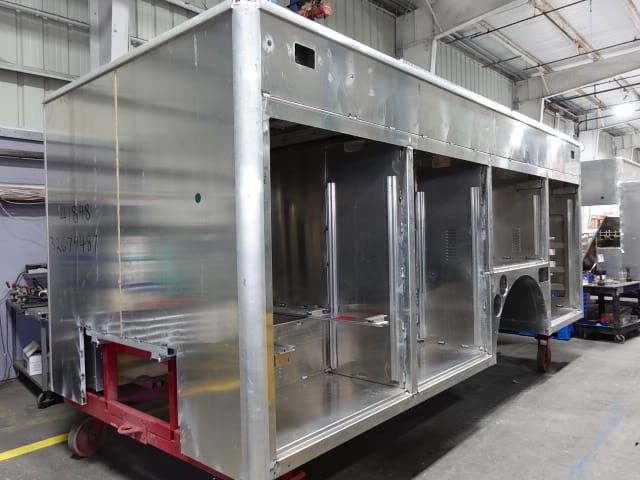

In this report, the cab completed the paint process, the frame remained staged (no photos), and the body completed fabrication and began the paint process.

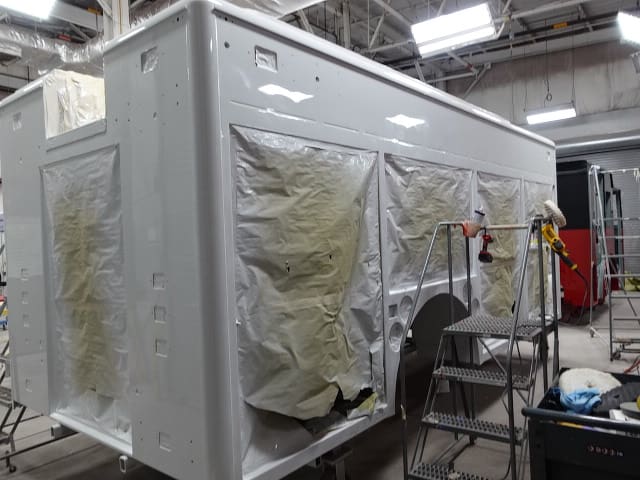

01-24-25
In this report, the cab was staged (no photos), the frame build continued, and the body continued through paint.
01-10-25
In this report, the cab continued the paint process, the frame remained staged (no photos), and the body continued the fabrication process.
12-20-24

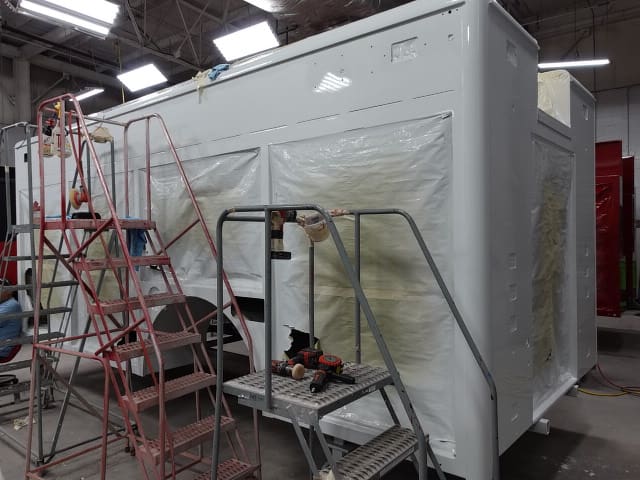

In this report, the cab began the paint process, the frame remained staged (no photos), and the body continued the fabrication process.

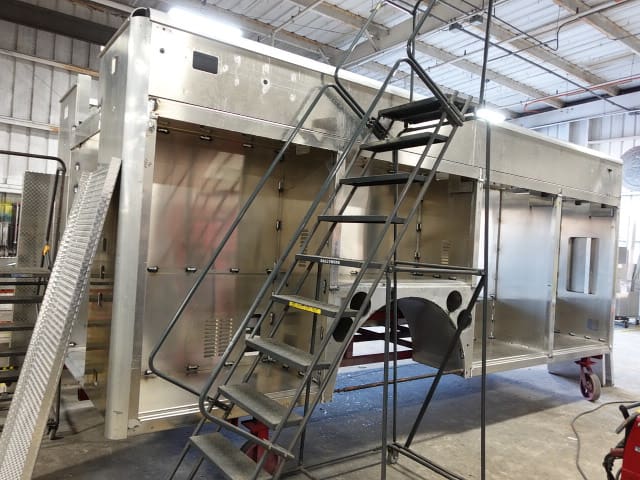

12-14-24

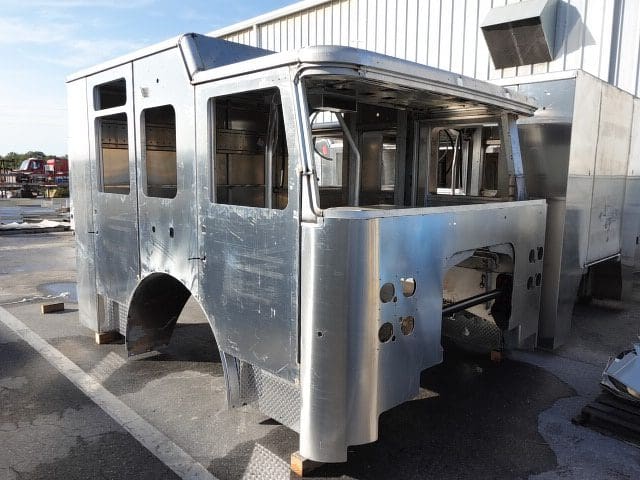

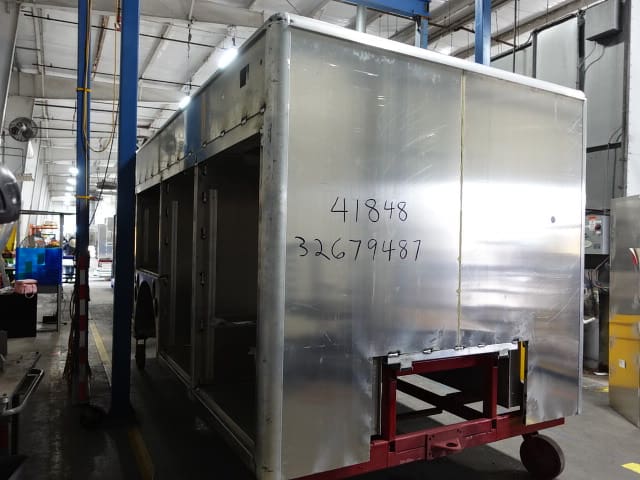

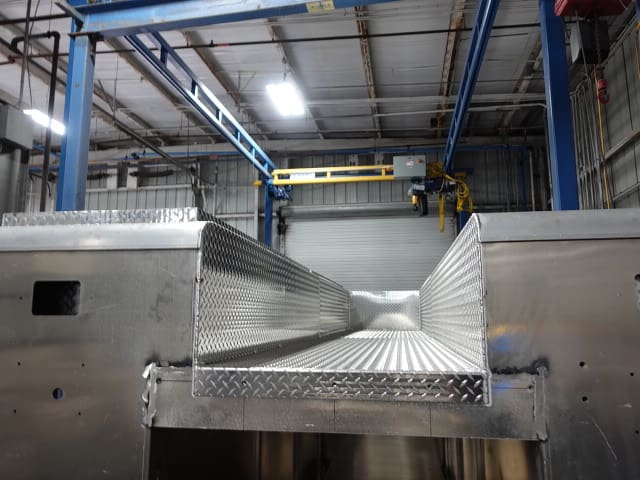

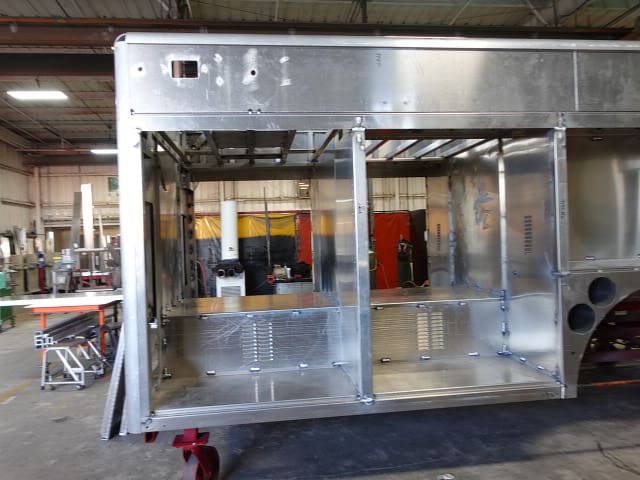

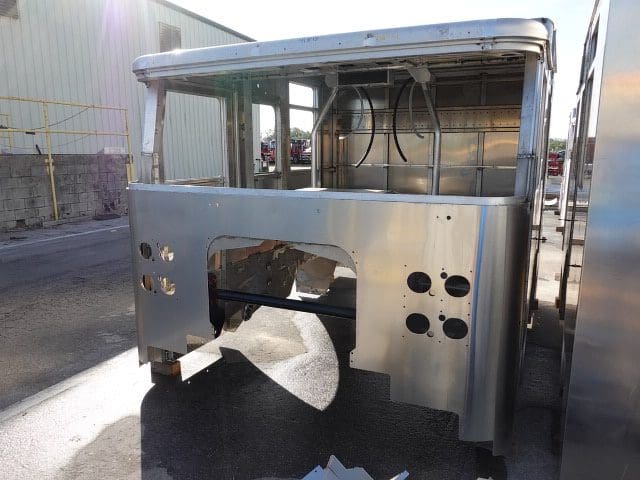

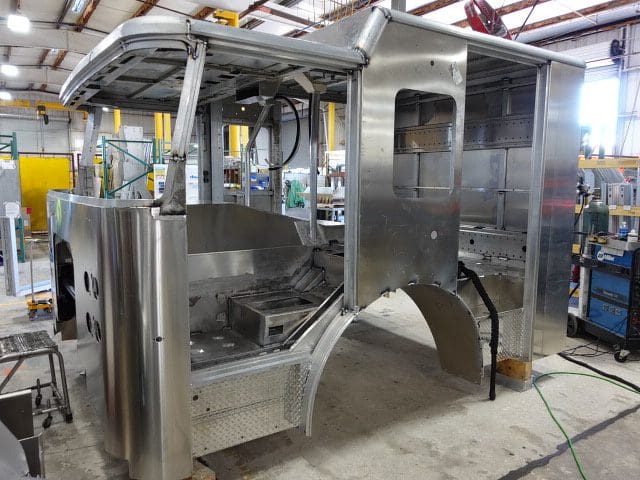

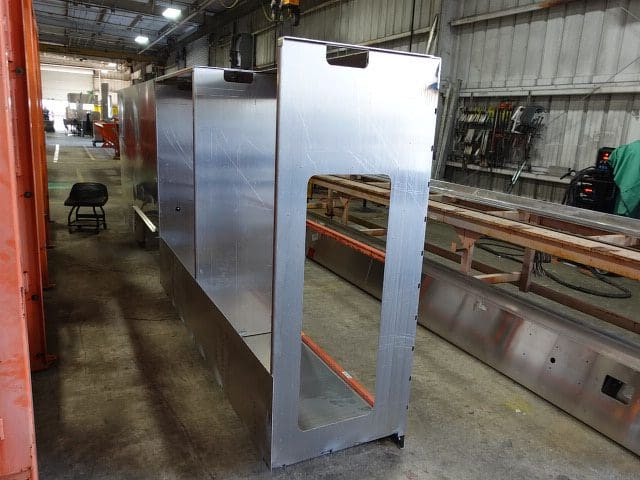

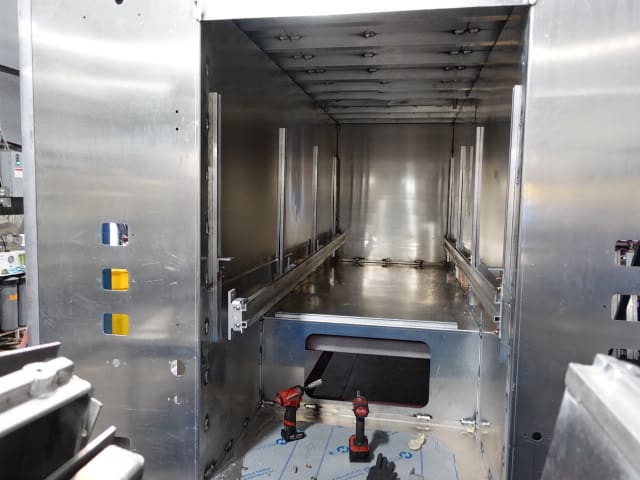

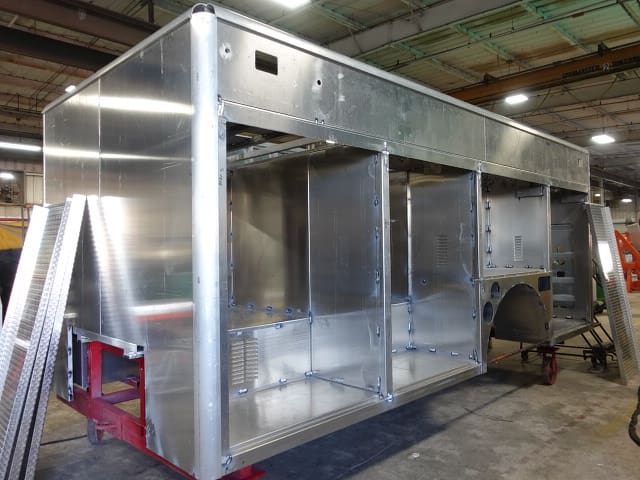

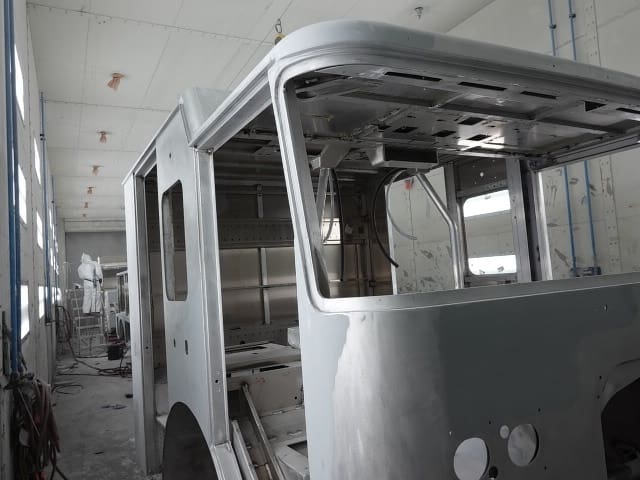

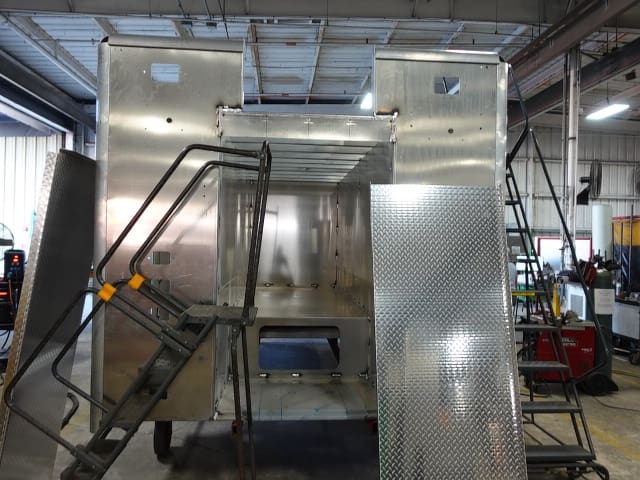

In this report, the cab completed fabrication, the frame was staged (no photos), and the body began fabrication.

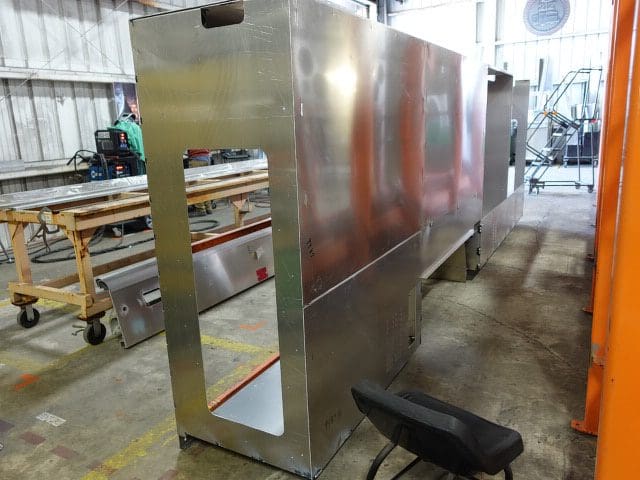

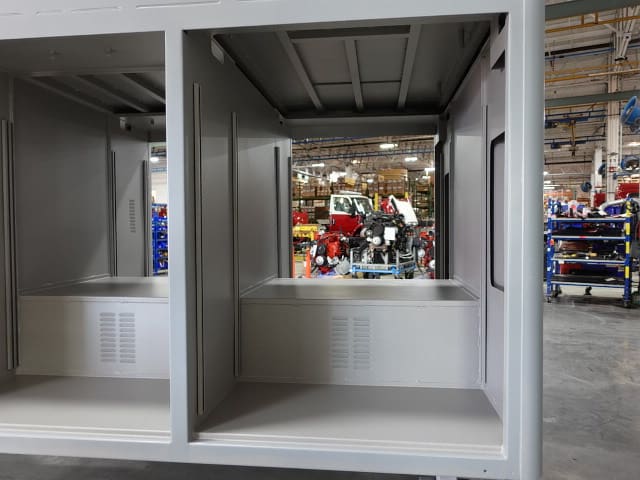

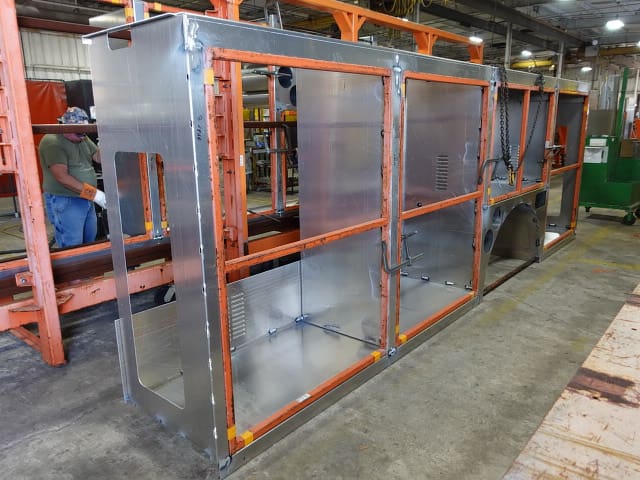

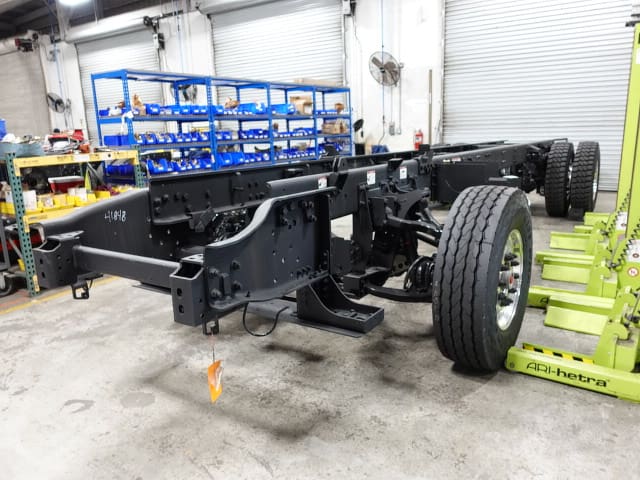

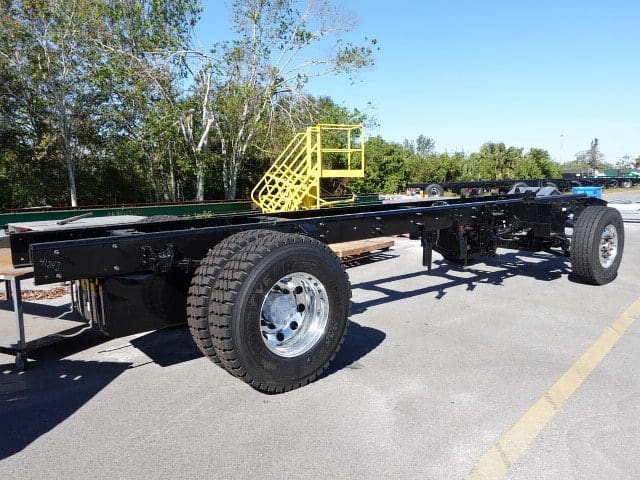

12-07-24

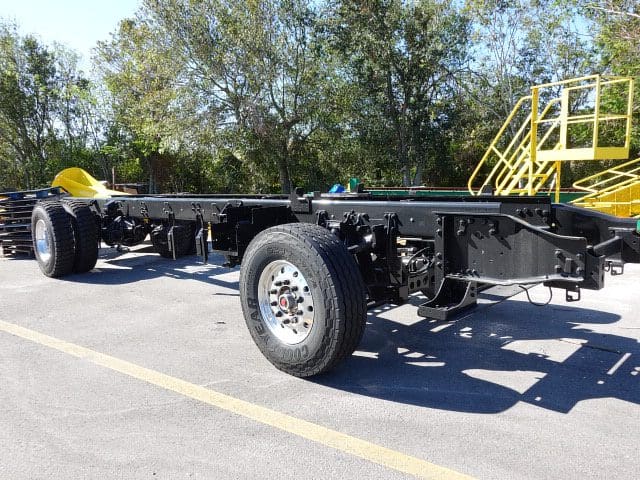

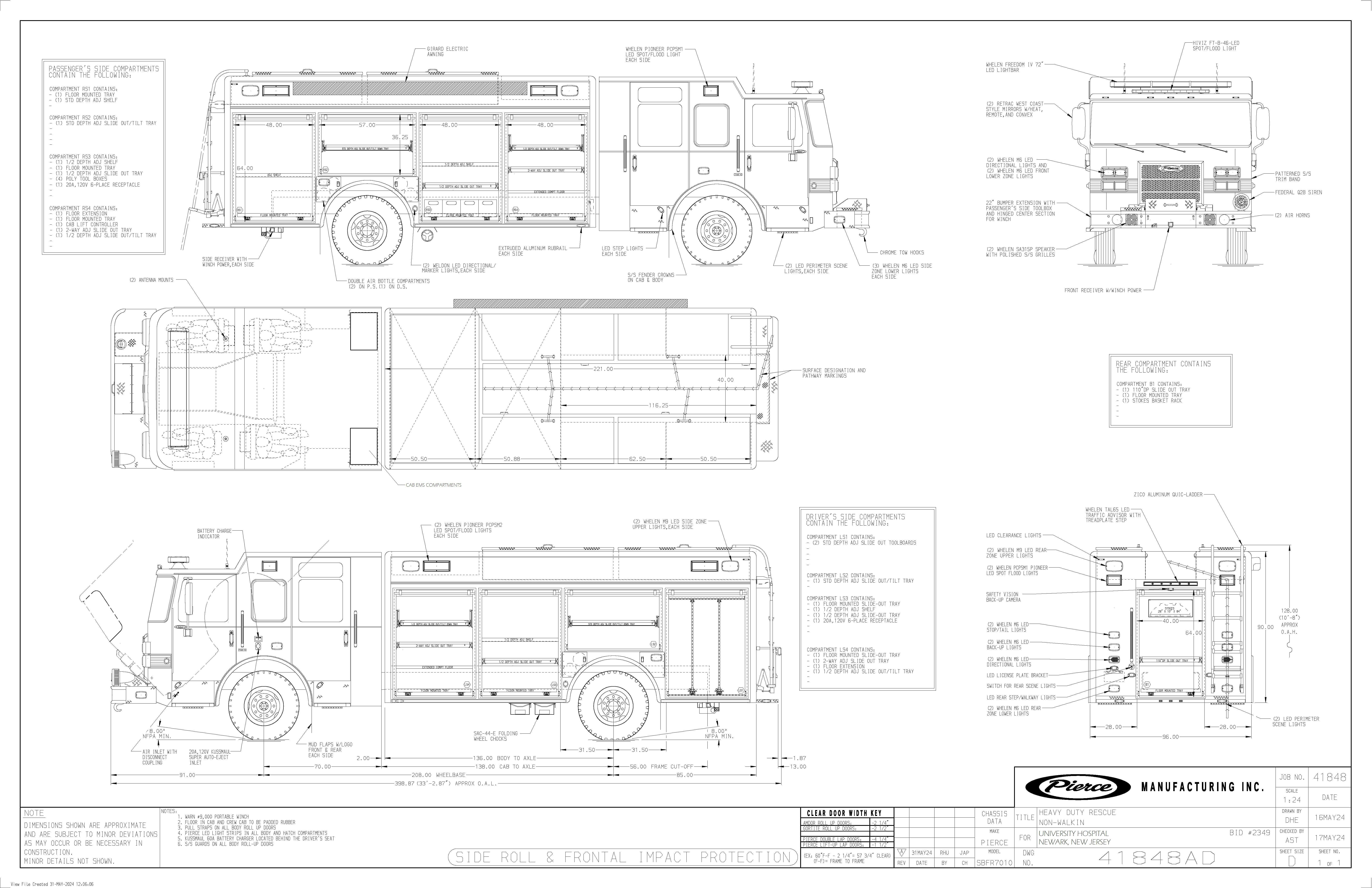

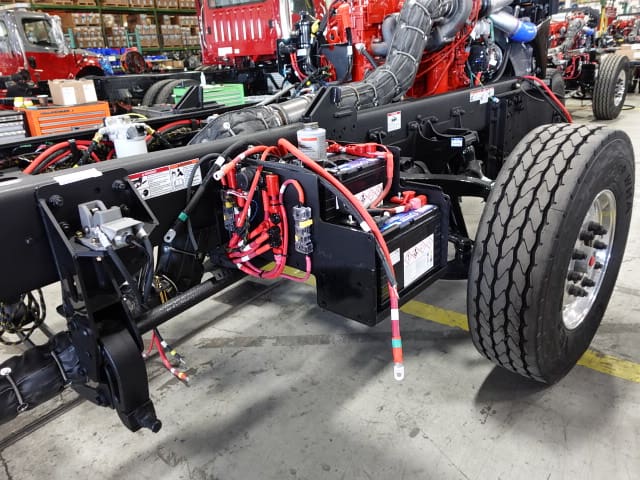

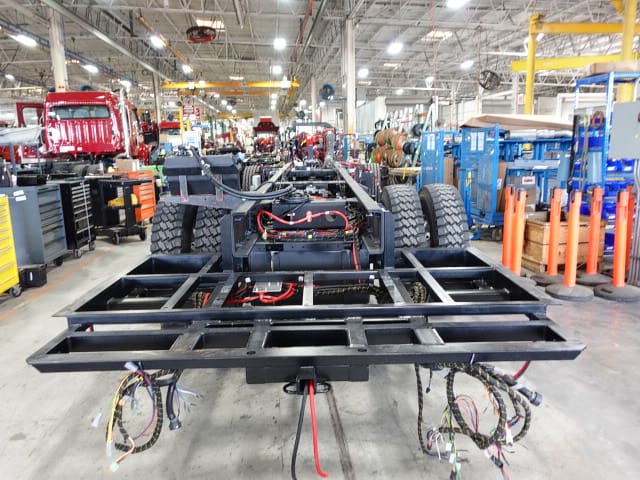

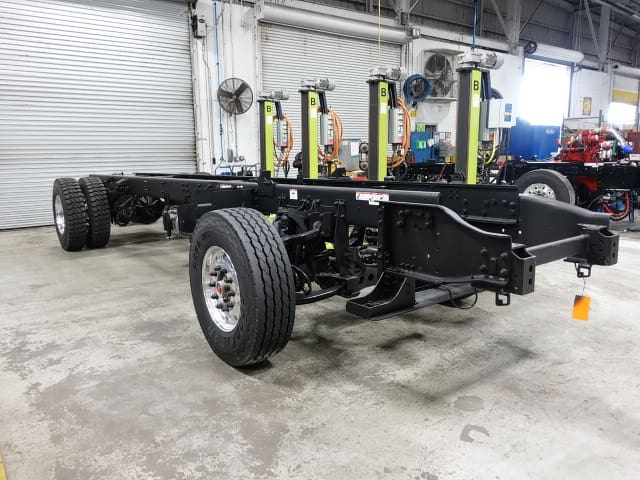

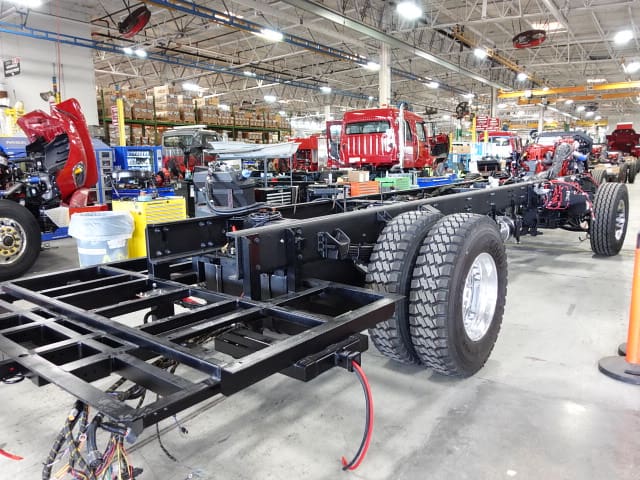

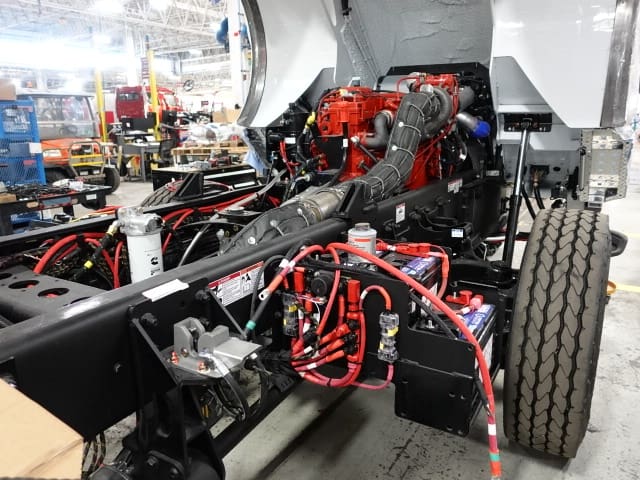

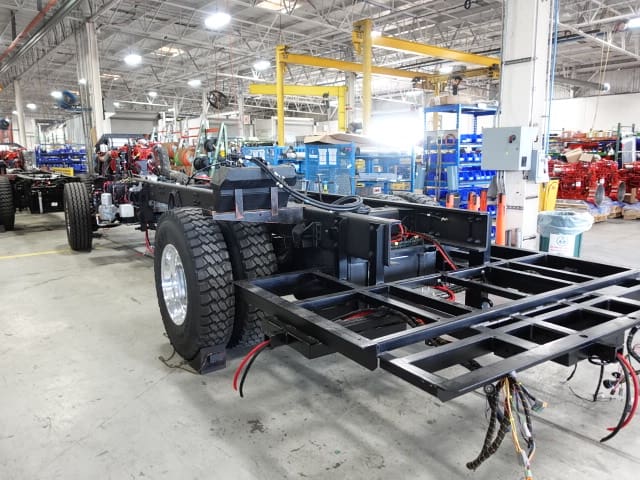

This new Pierce apparatus is now in production! In this report, the cab began fabrication while the frame build began.
