43082 – Jefferson

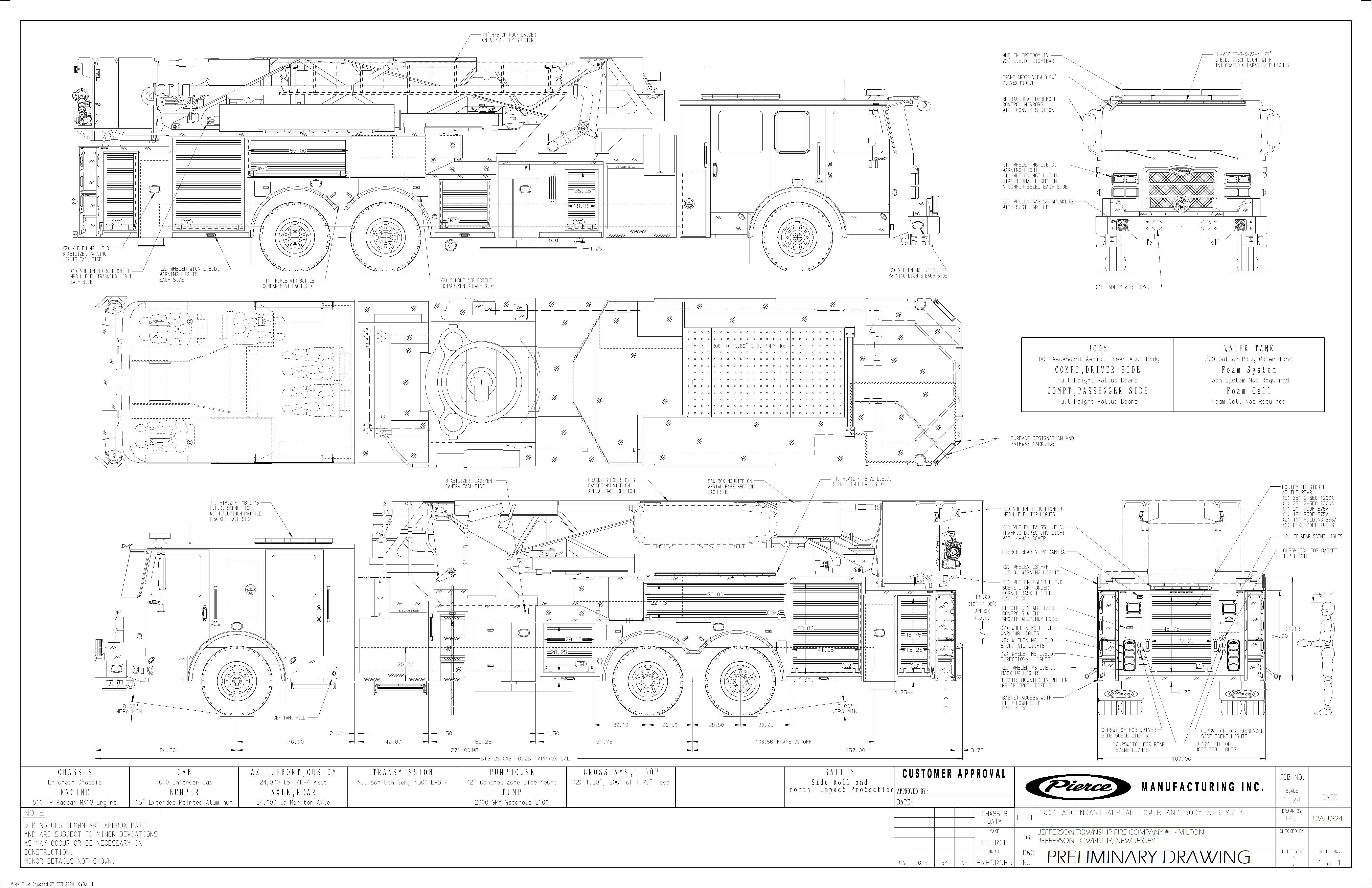

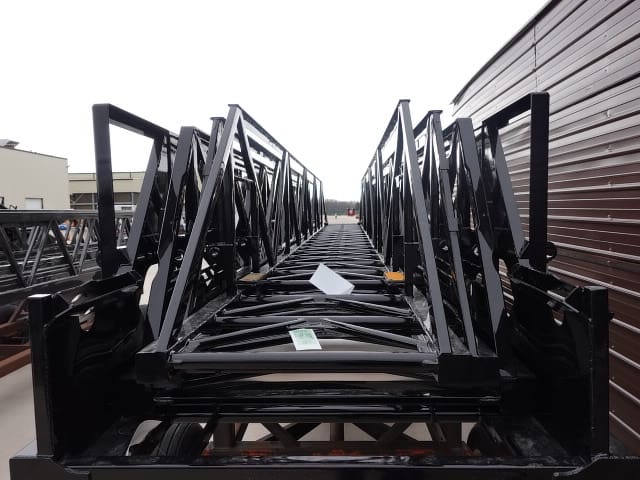

Enforcer 100' Ascendant Aerial Tower (AAT) - Quint
Job #: 43082

PROGRESS UPDATES

03-21-25

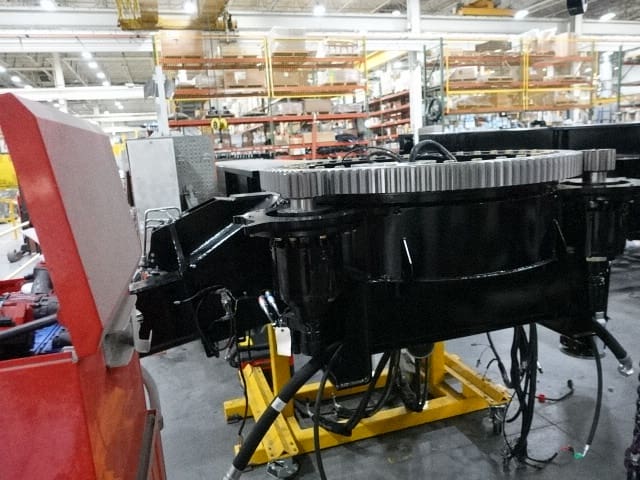

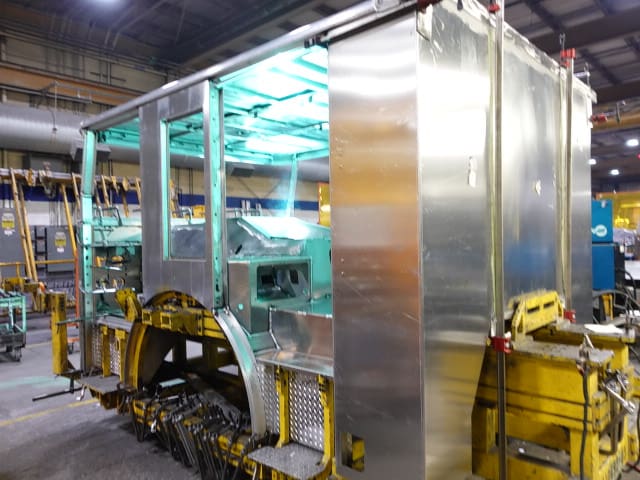

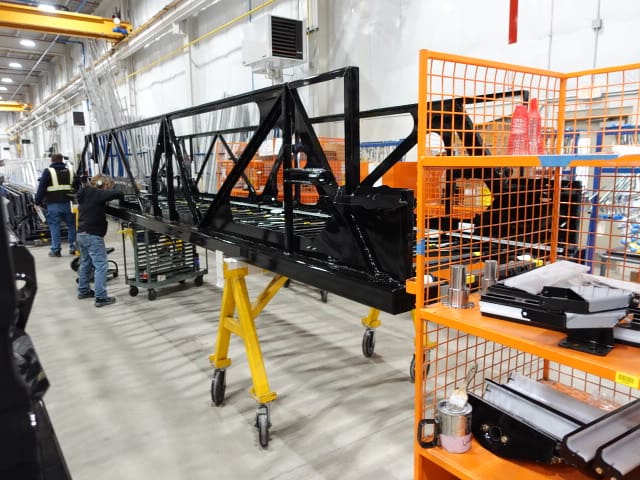

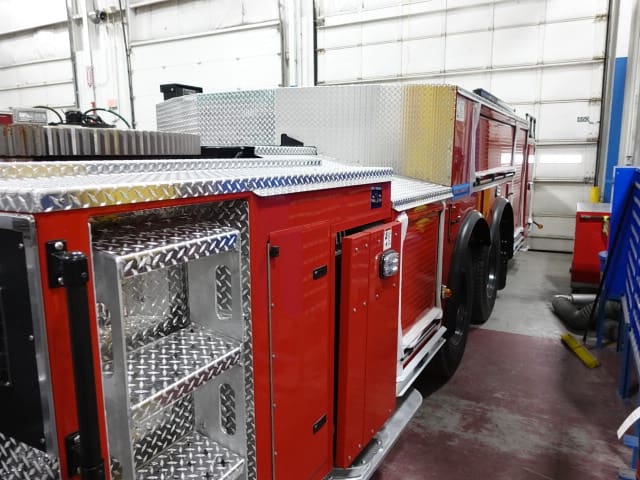

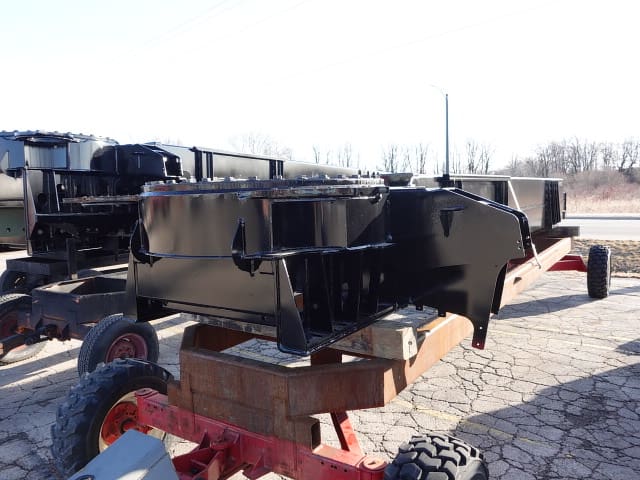

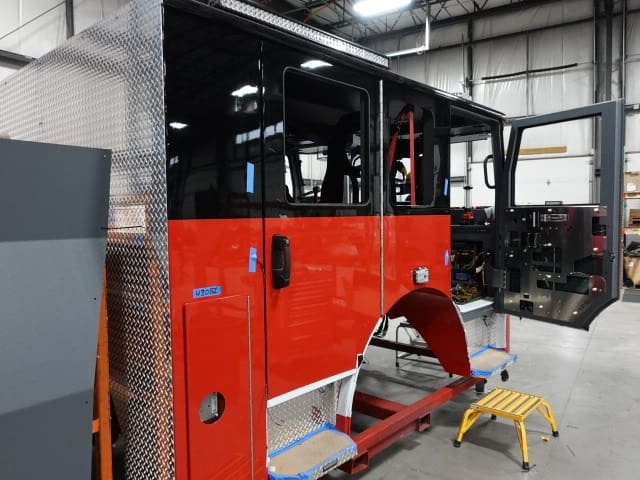

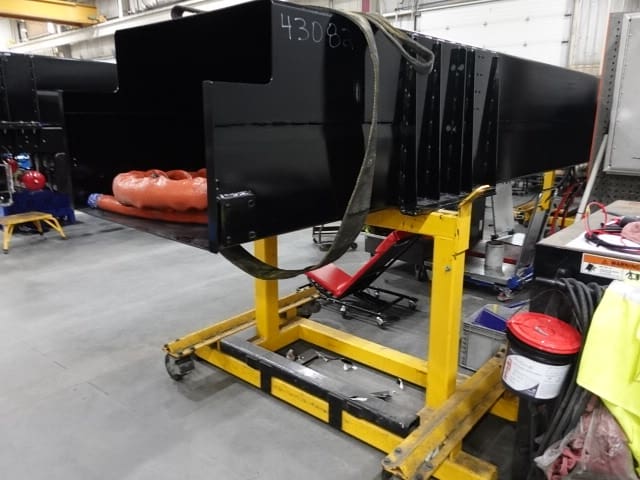

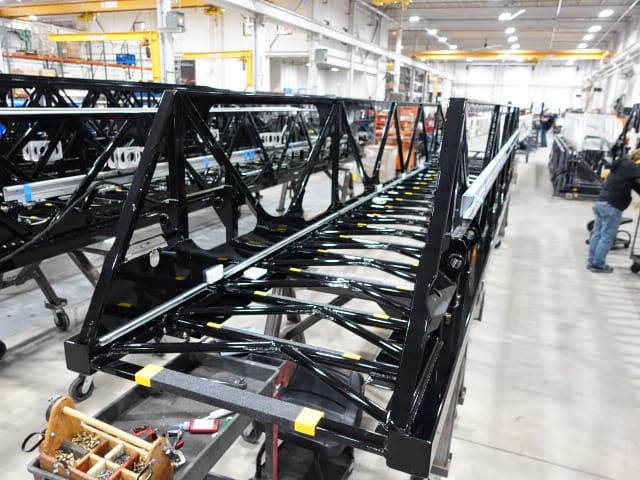

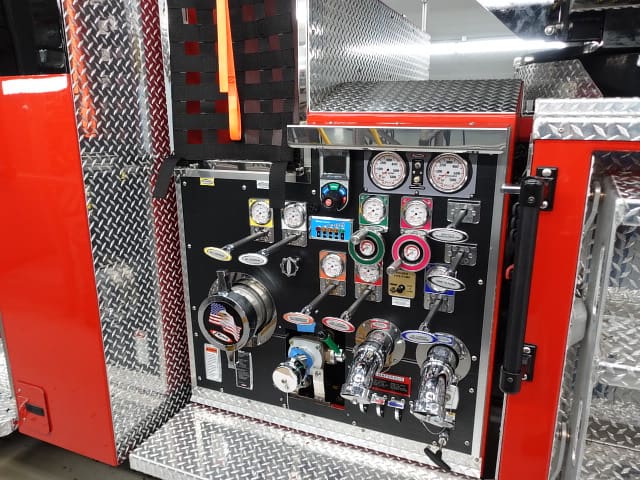

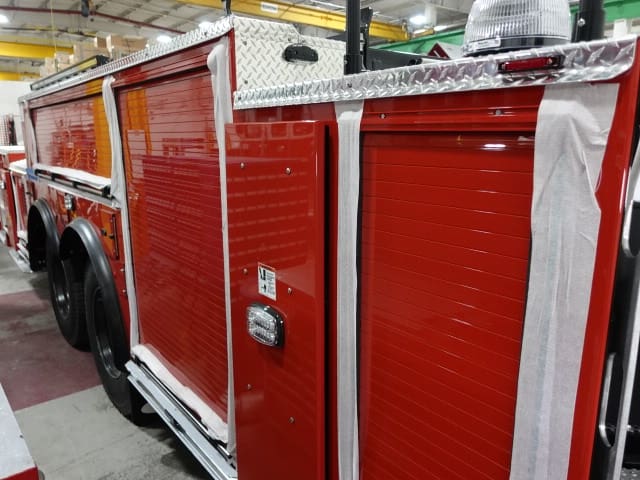

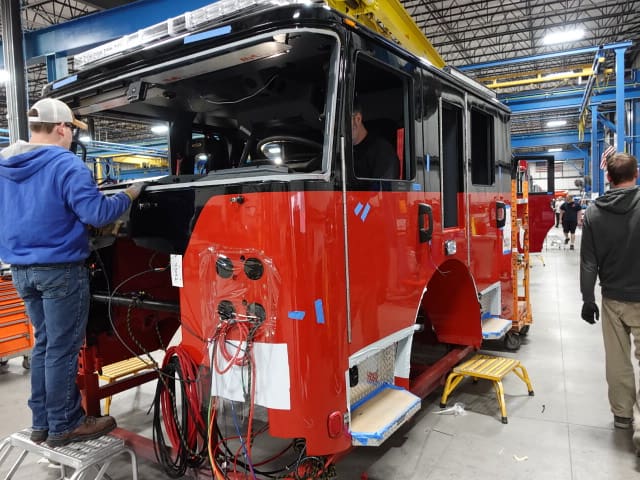

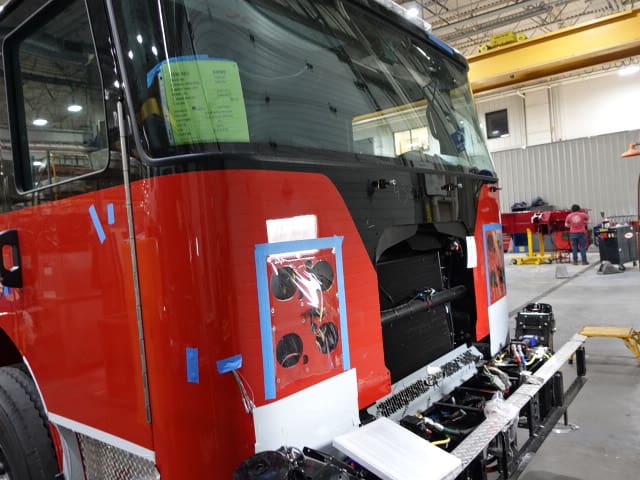

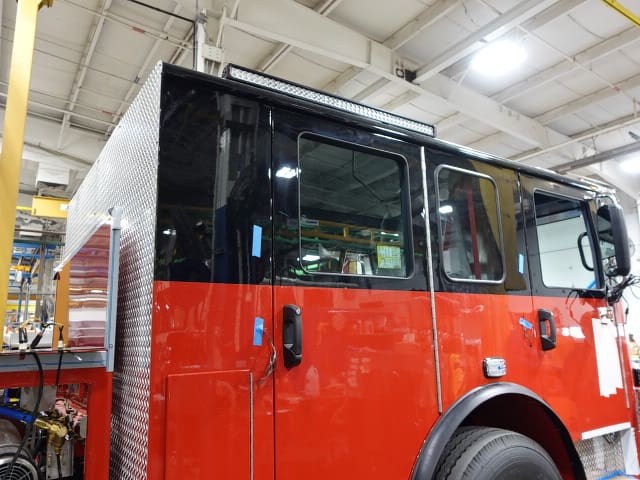

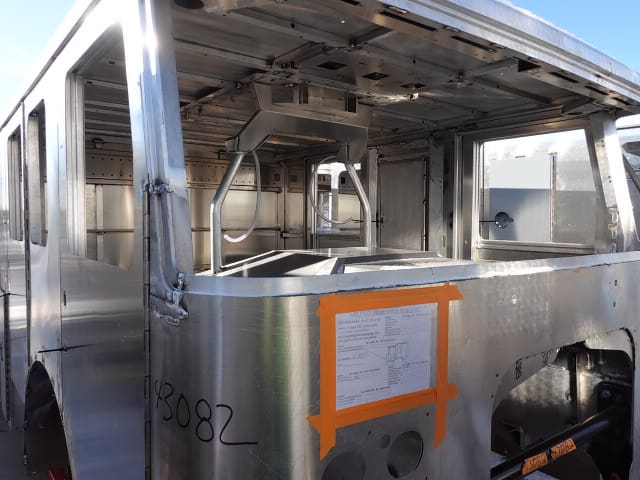

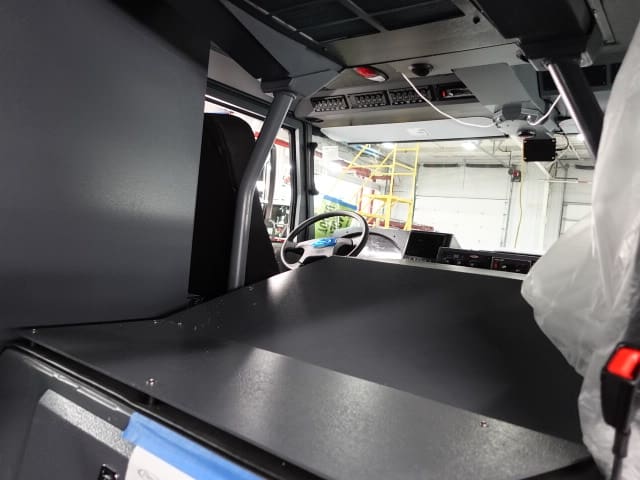

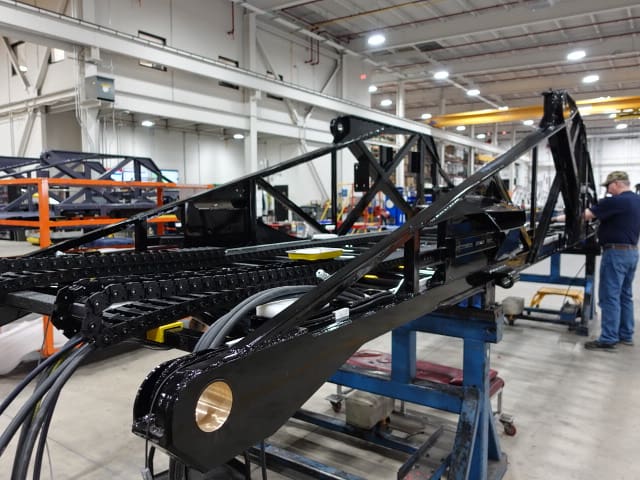

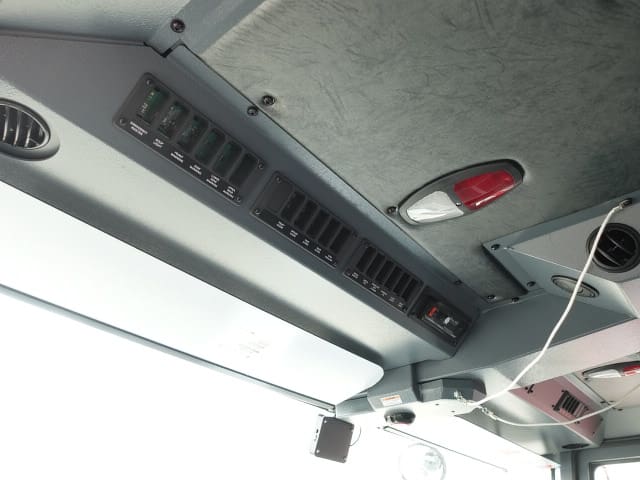

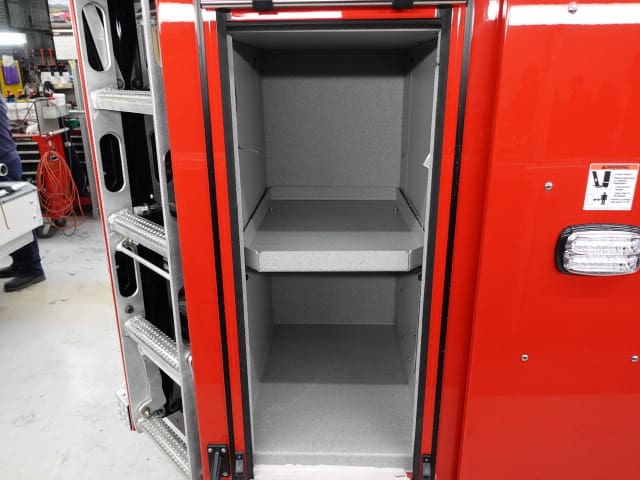

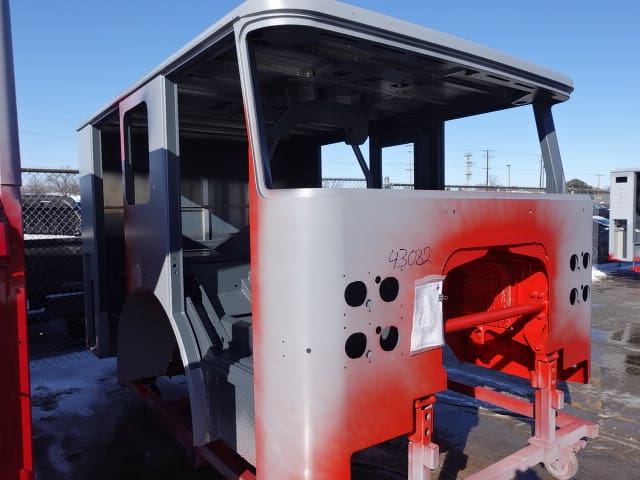

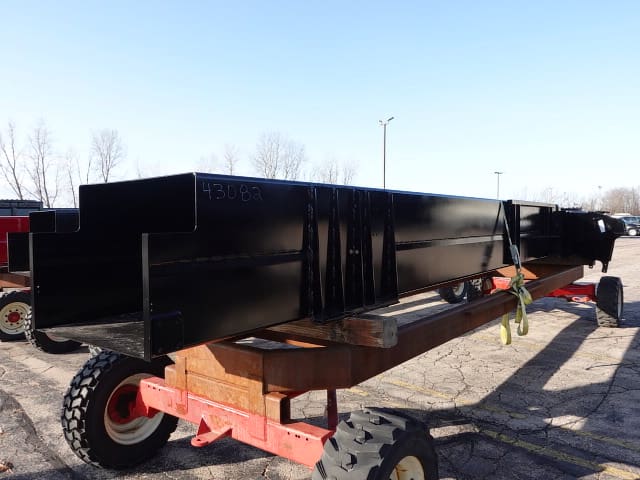

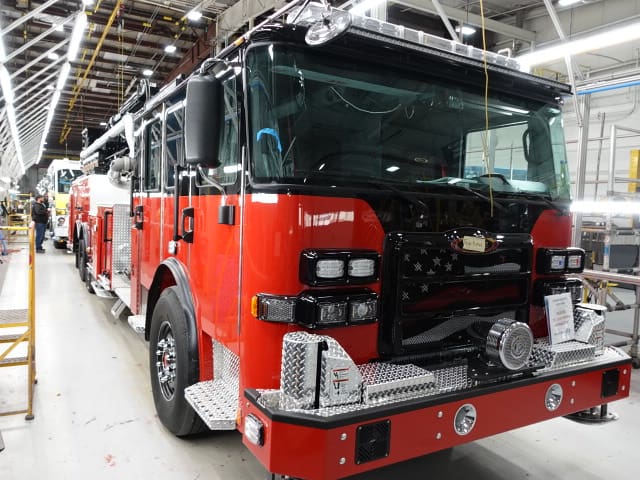

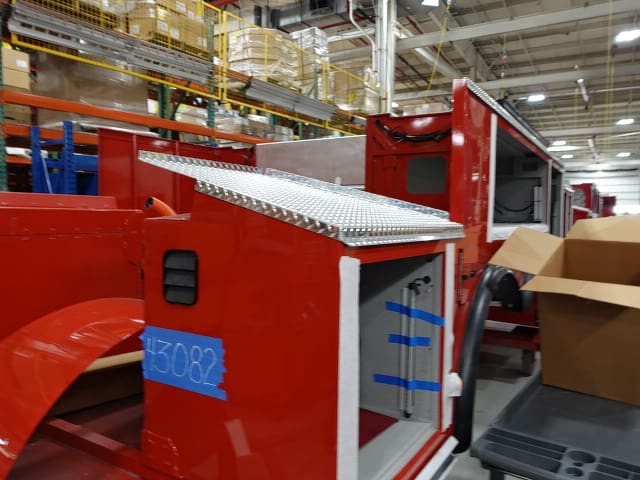

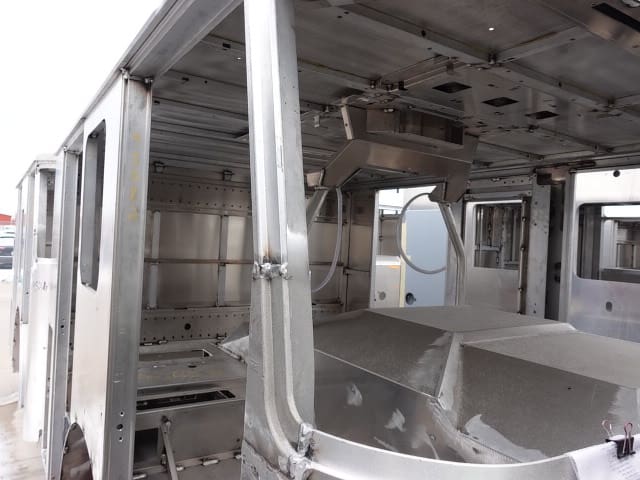

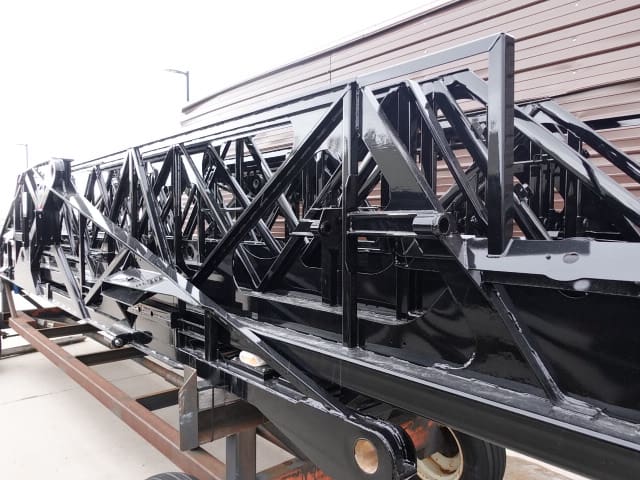

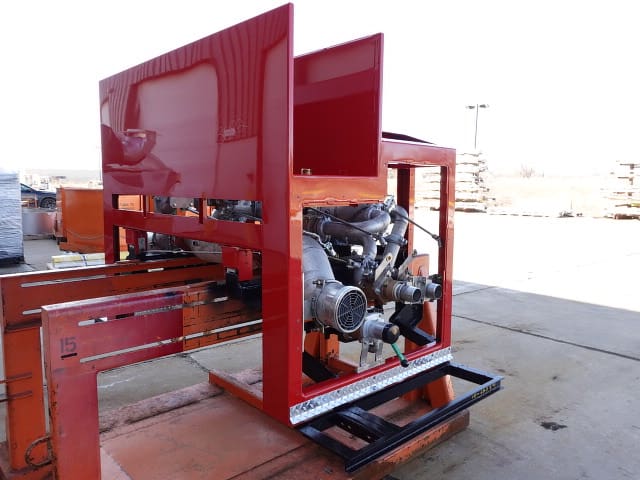

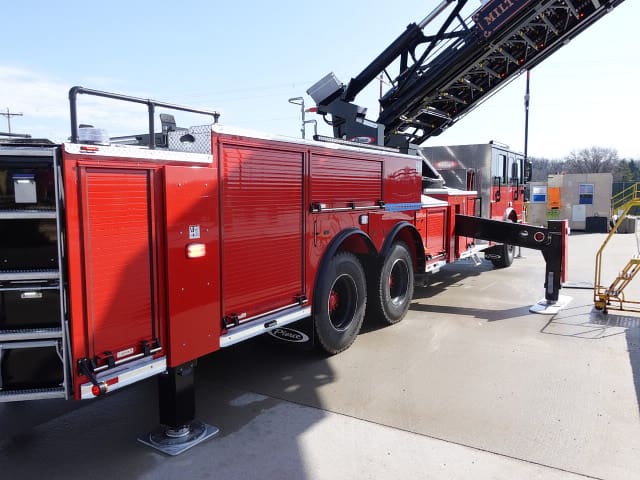

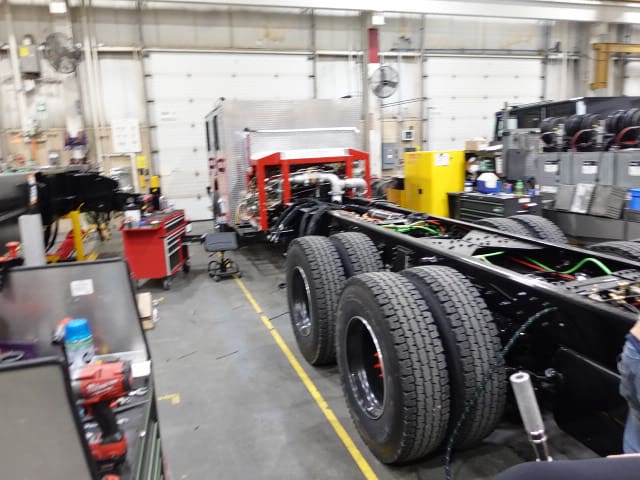

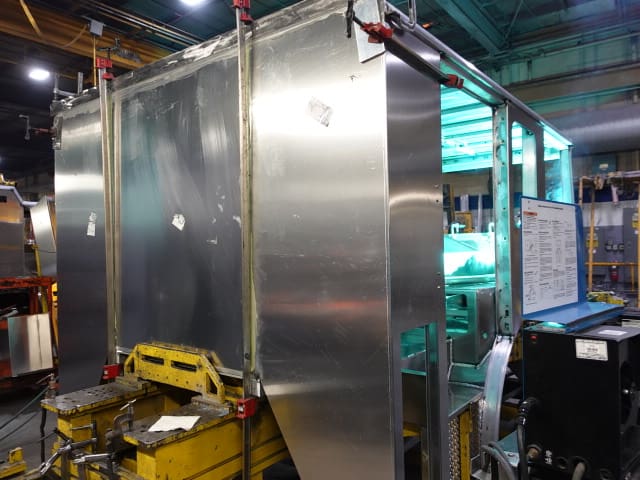

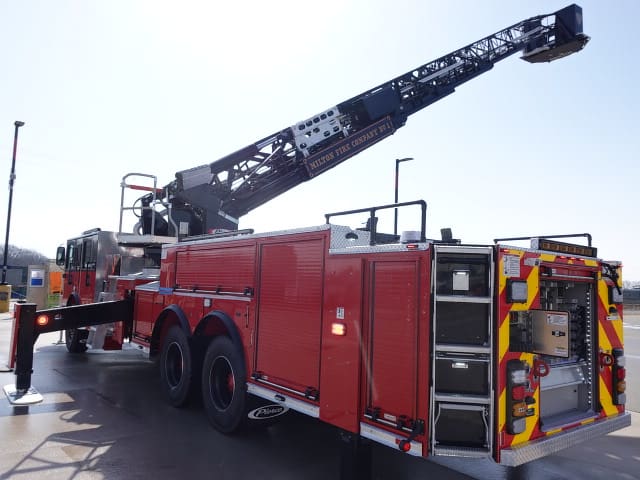

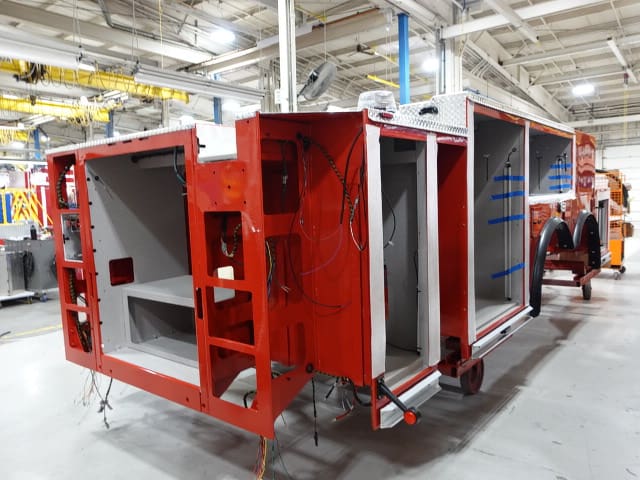

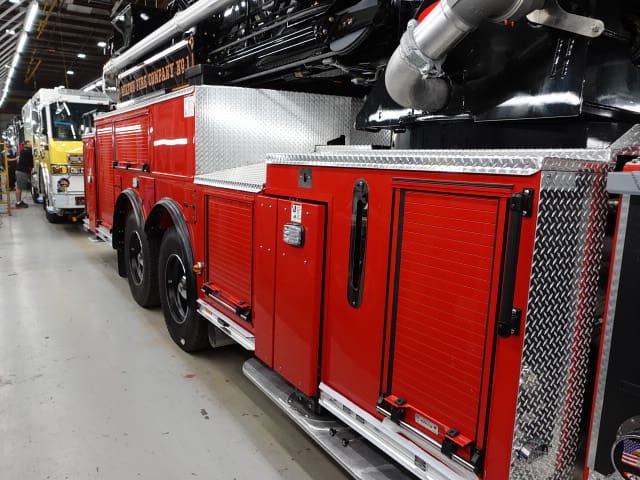

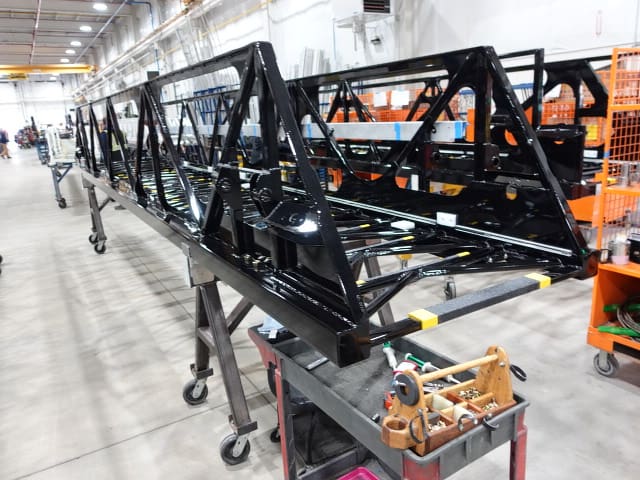

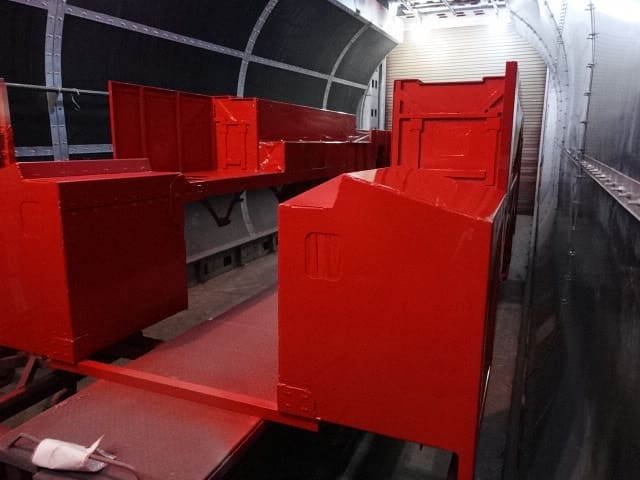

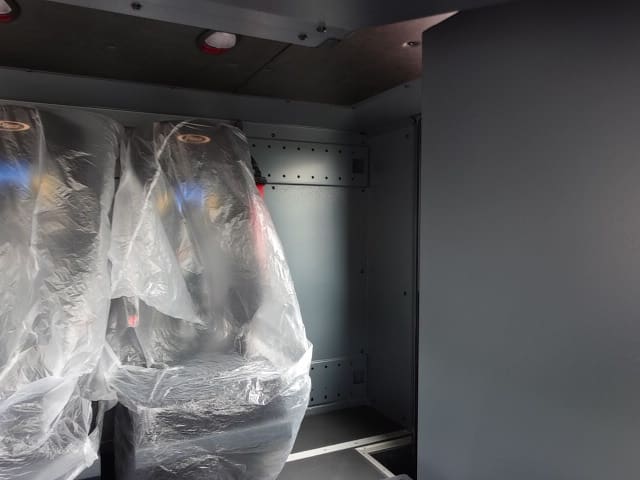

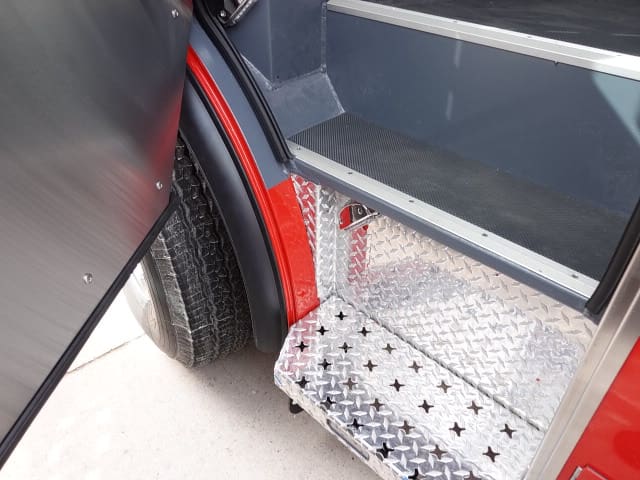

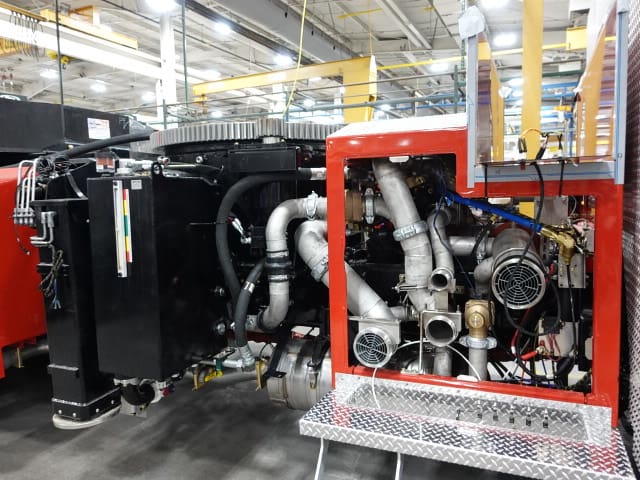

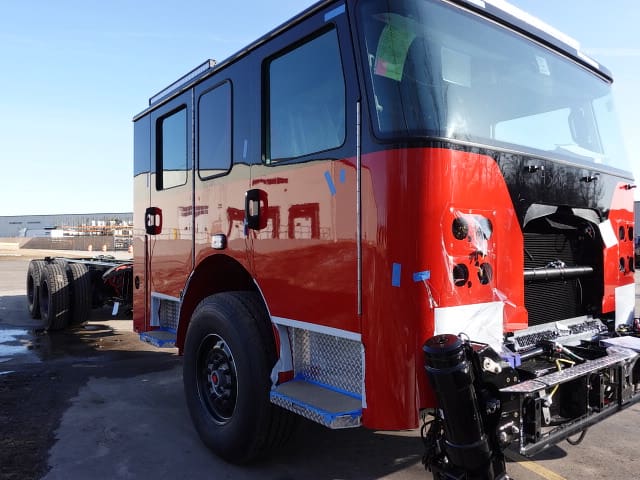

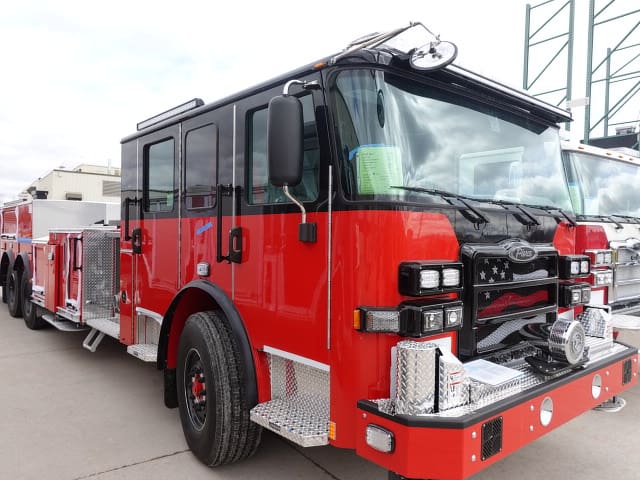

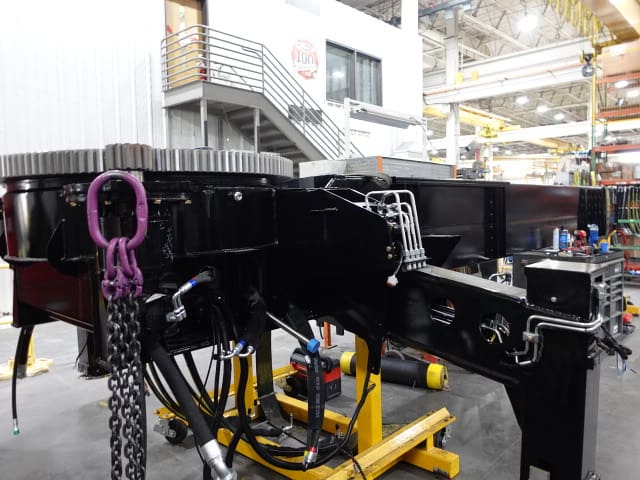

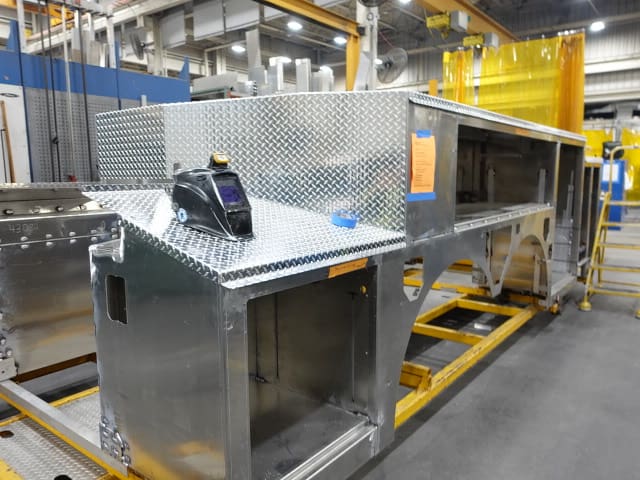

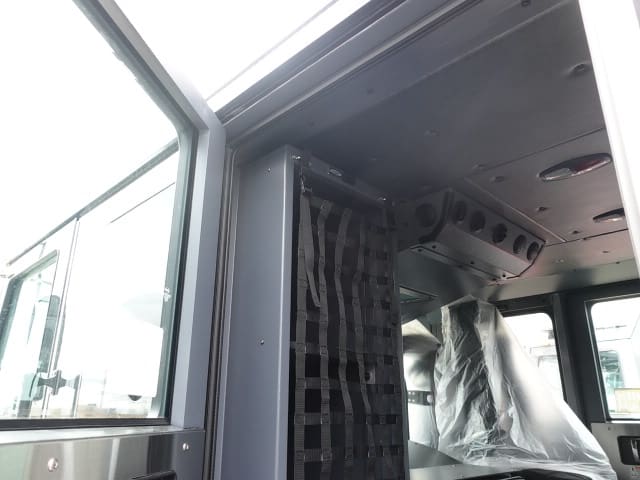

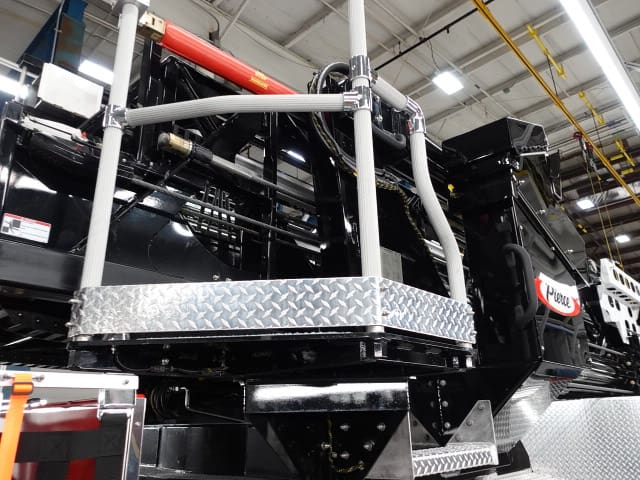

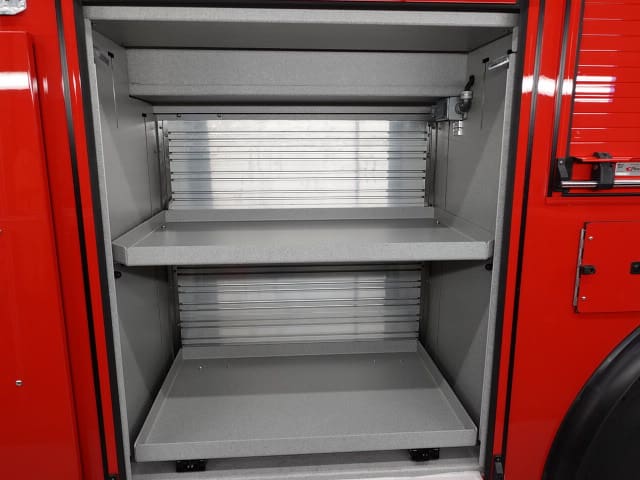

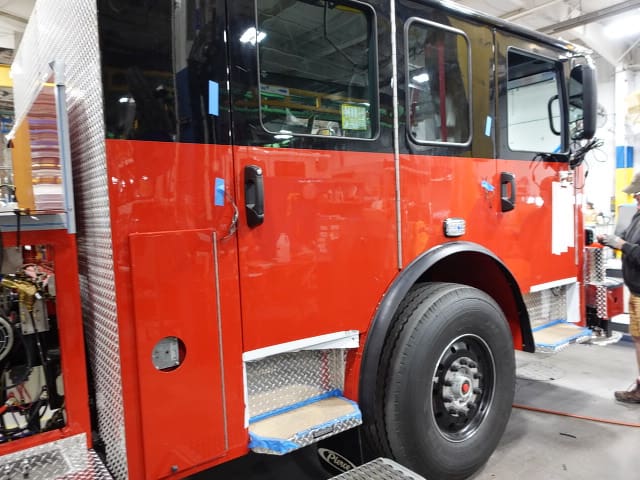

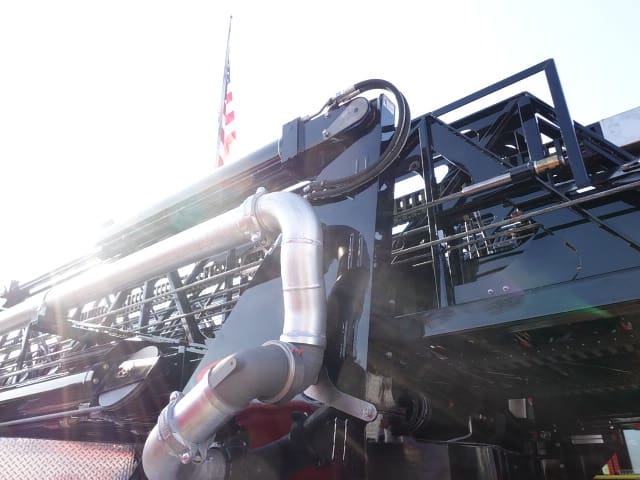

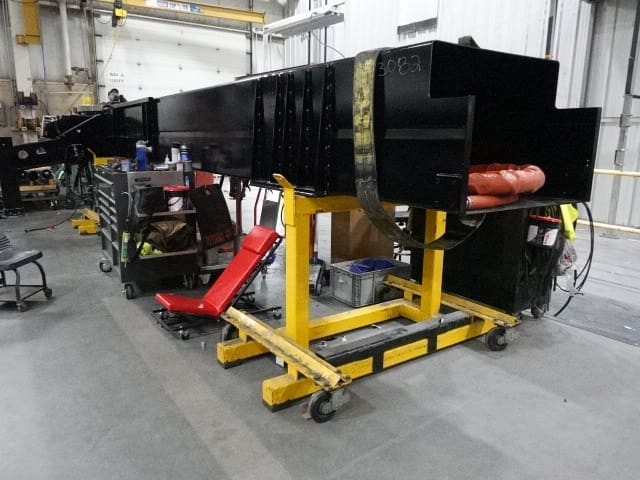

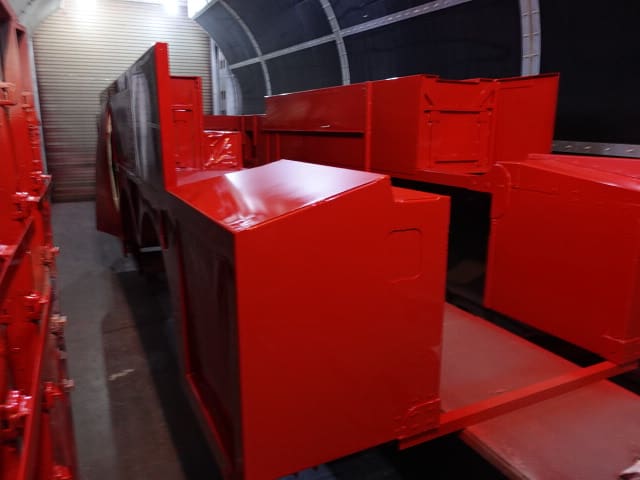

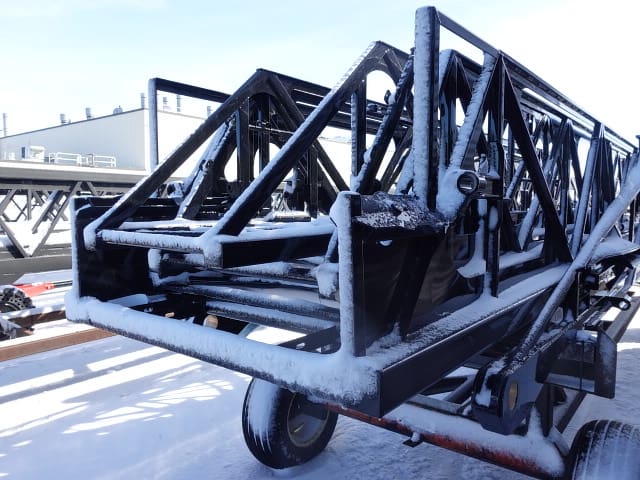

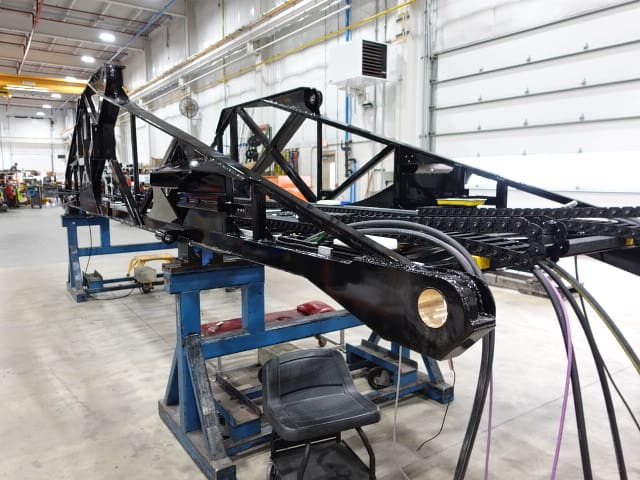

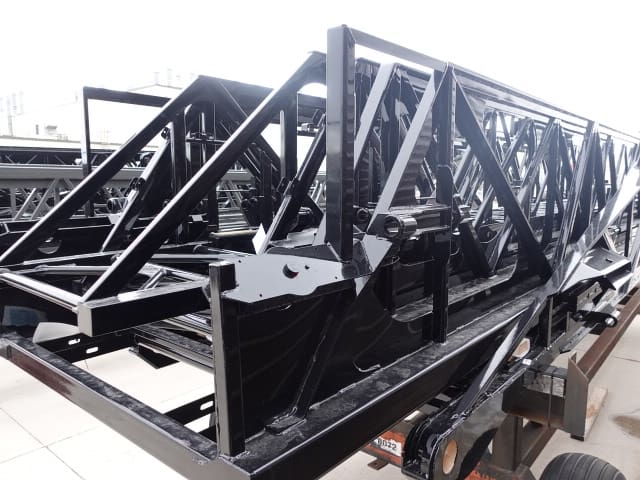

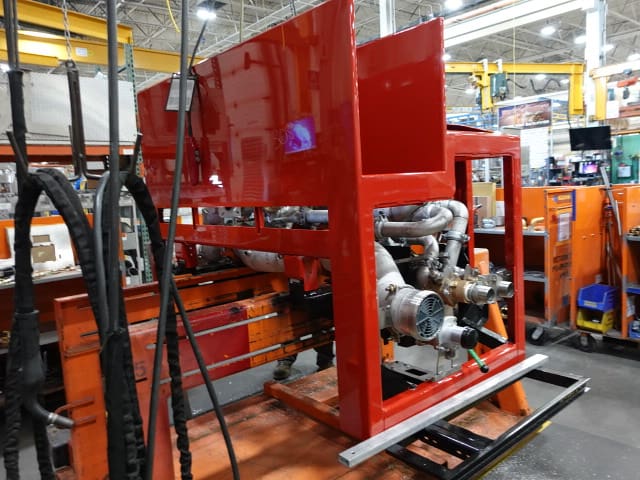

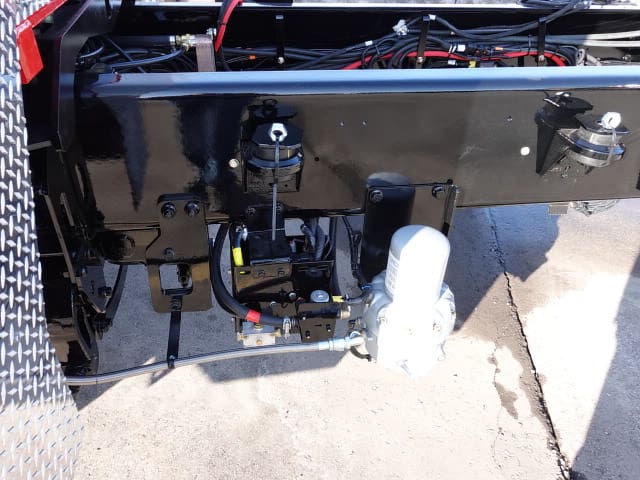

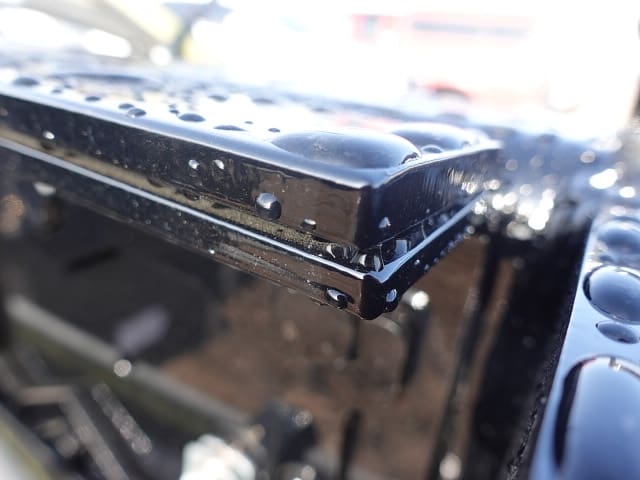

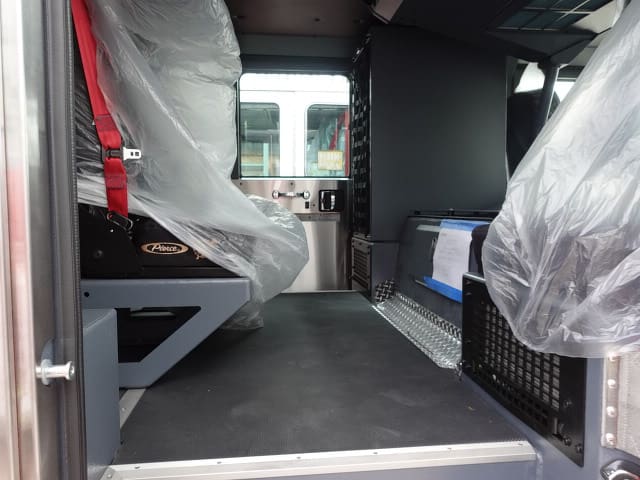

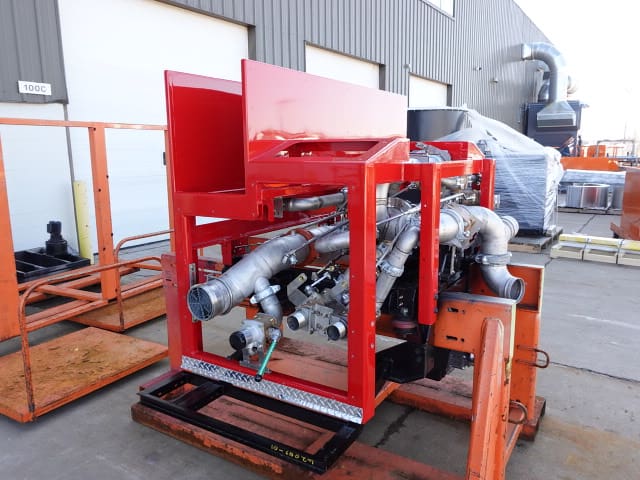

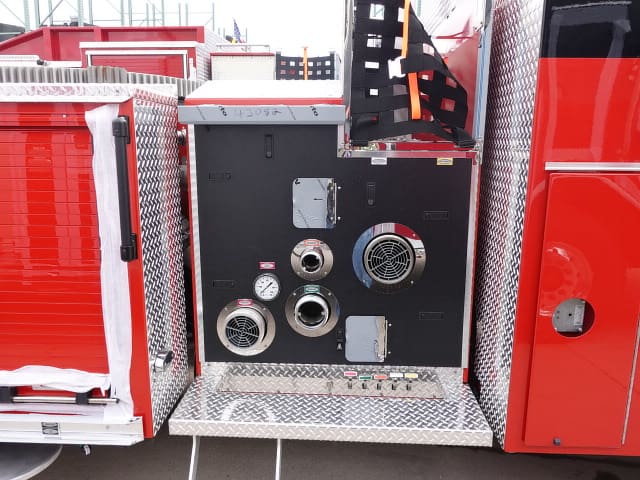

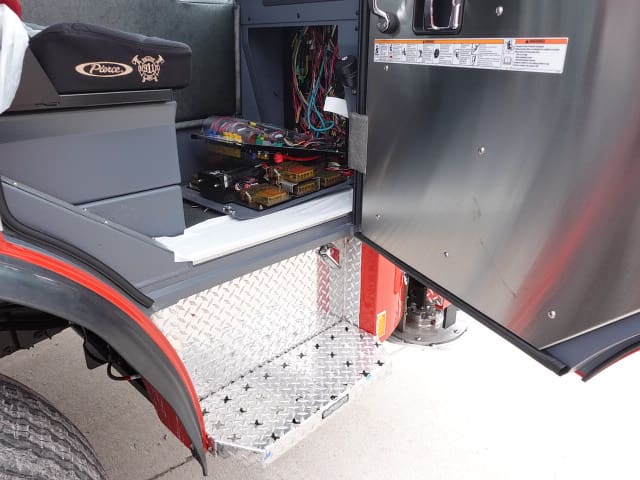

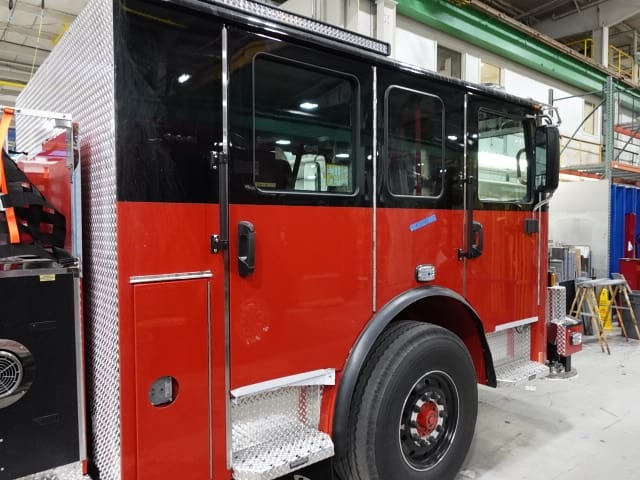

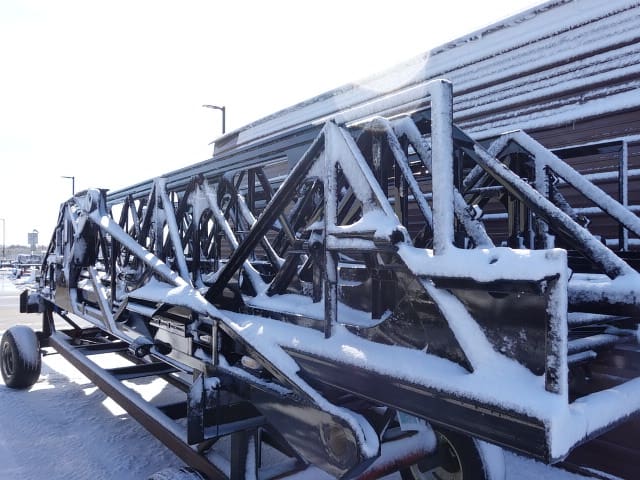

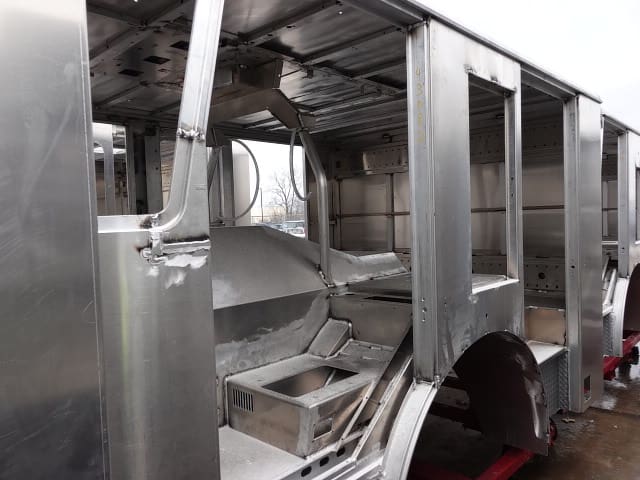

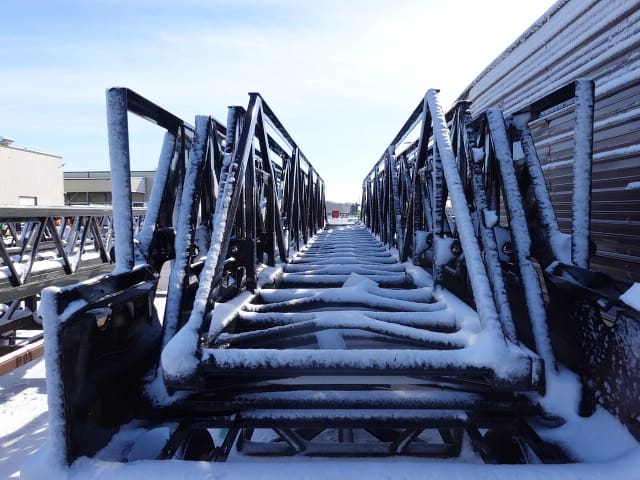

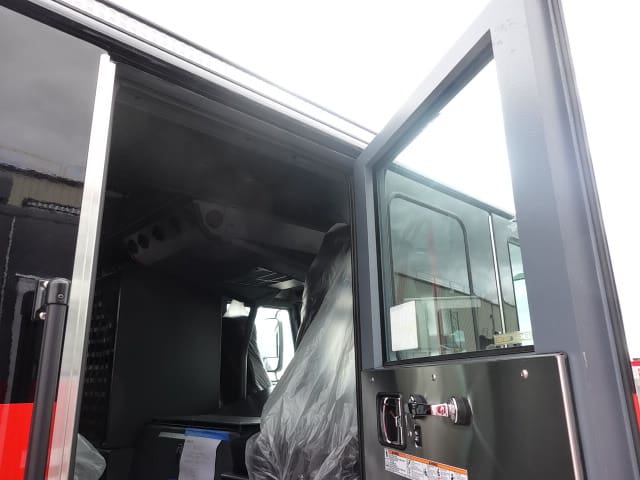

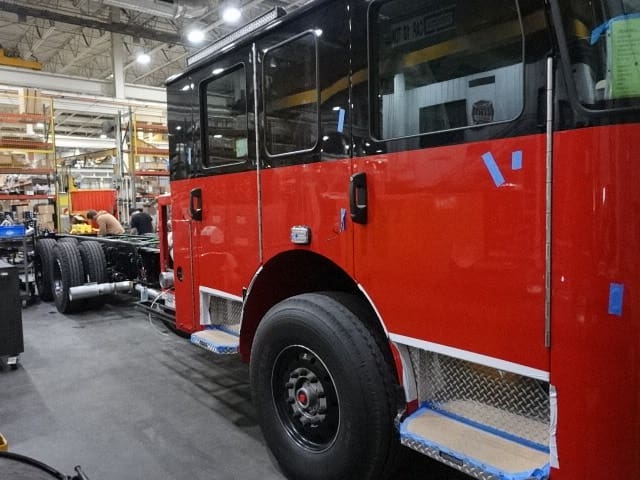

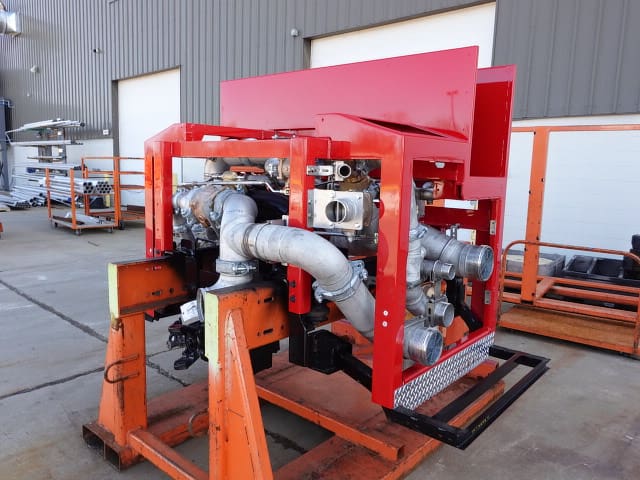

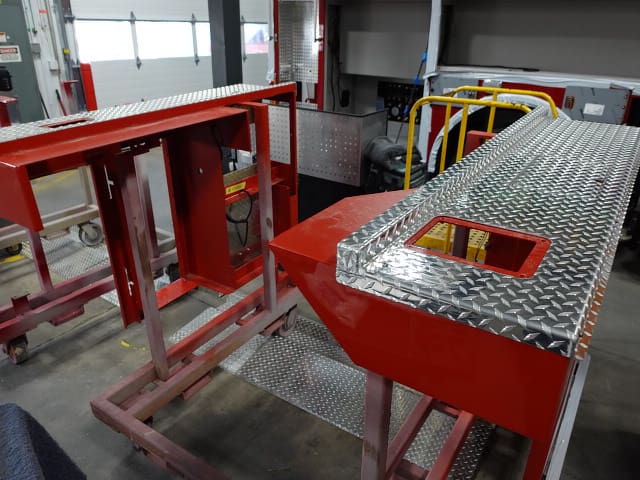

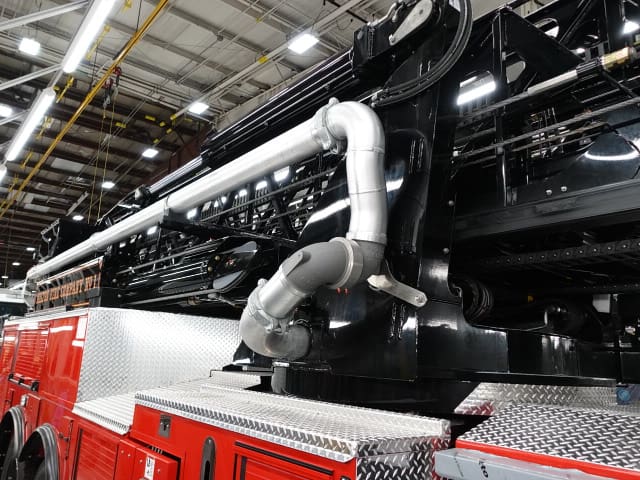

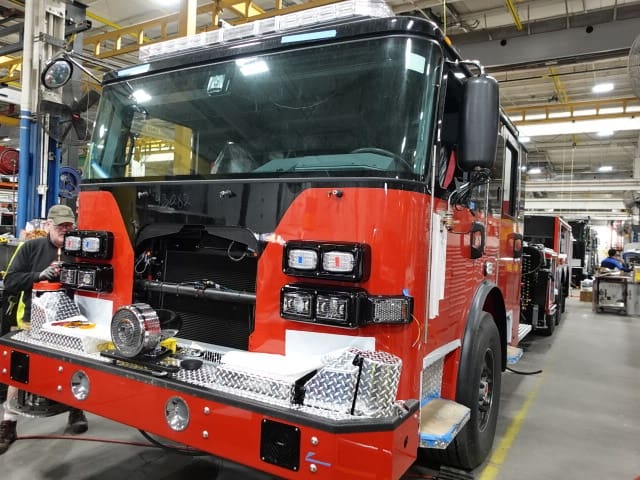

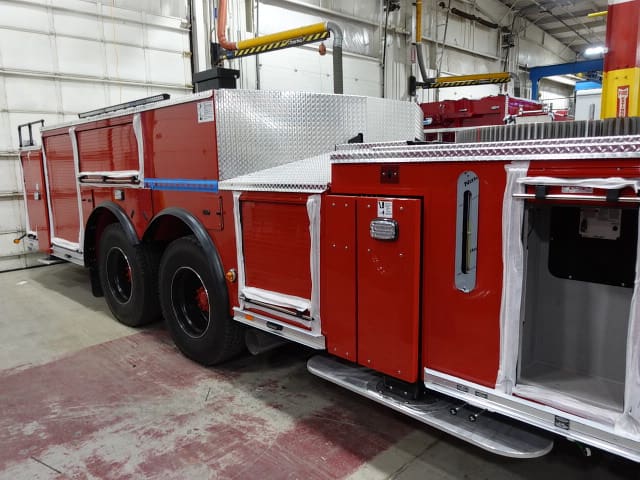

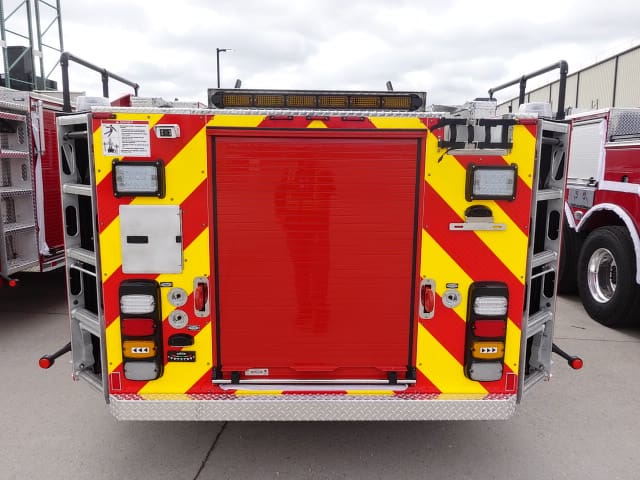

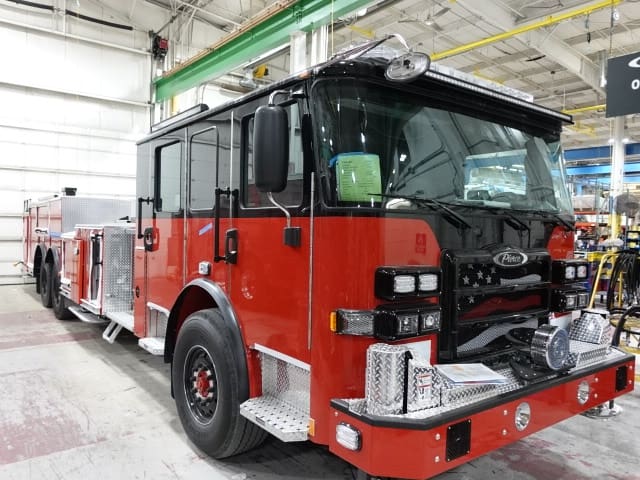

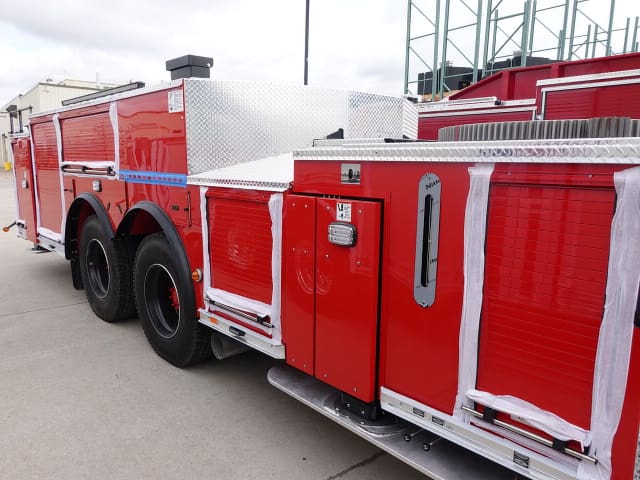

In this report, the pump house was merged with the chassis while the torque box began initial assembly, the turntable module complete paint, the rear body module completed paint and began initial assembly, and the aerial device arrived and was staged.

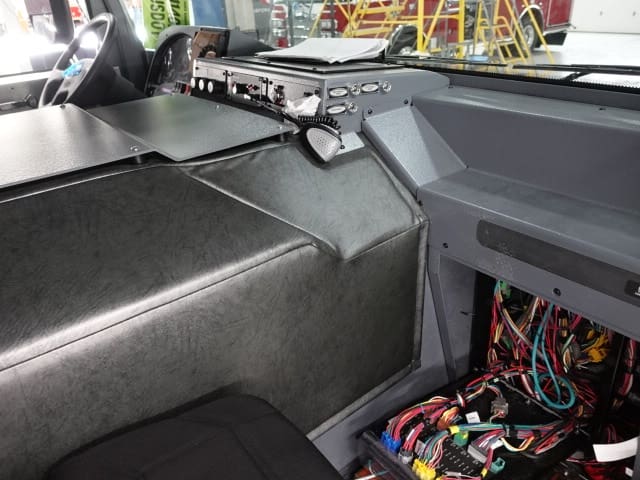

03-14-25

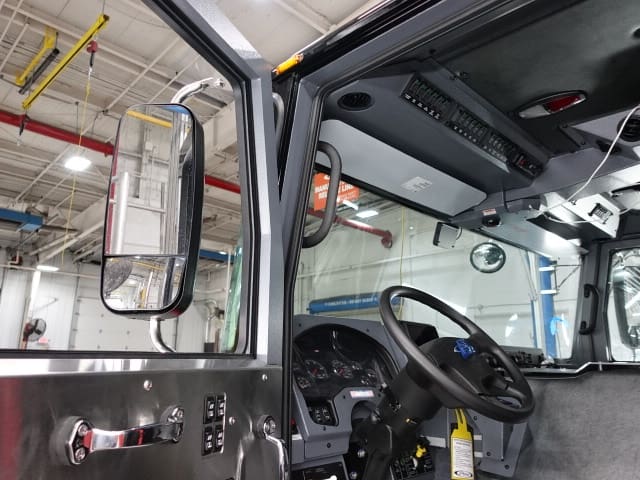

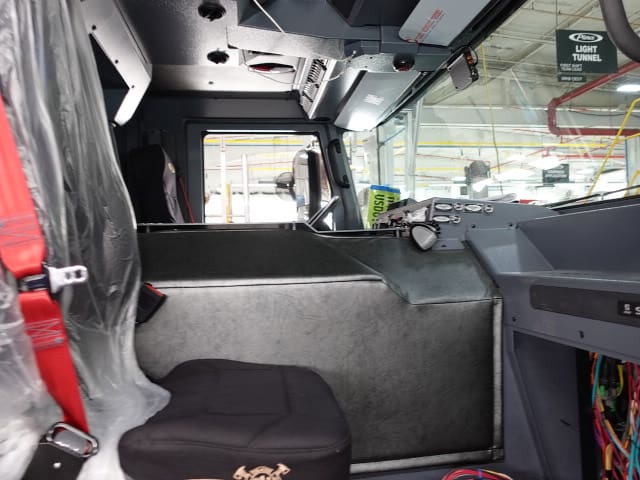

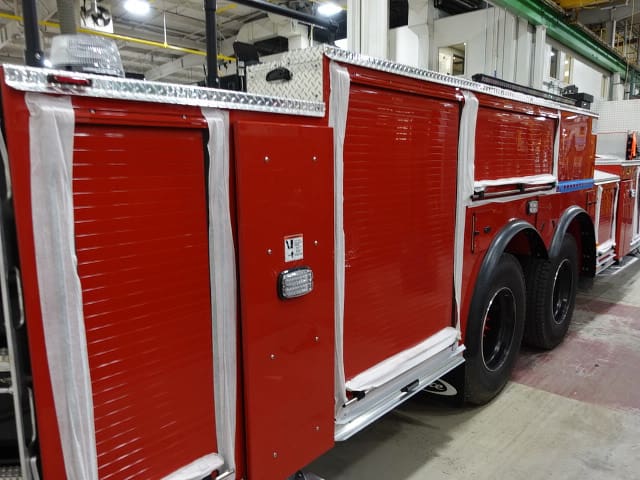

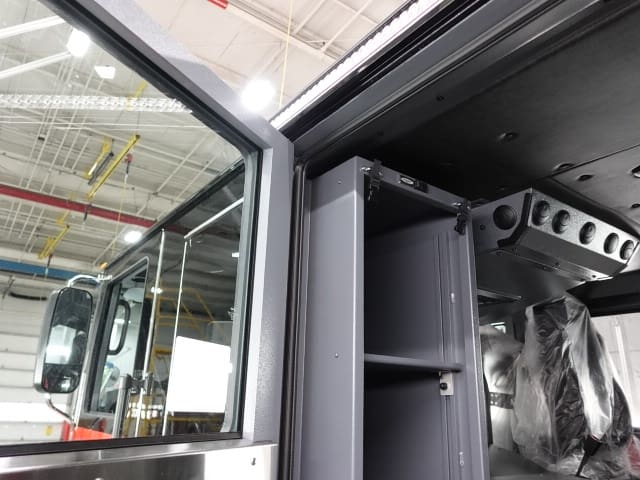

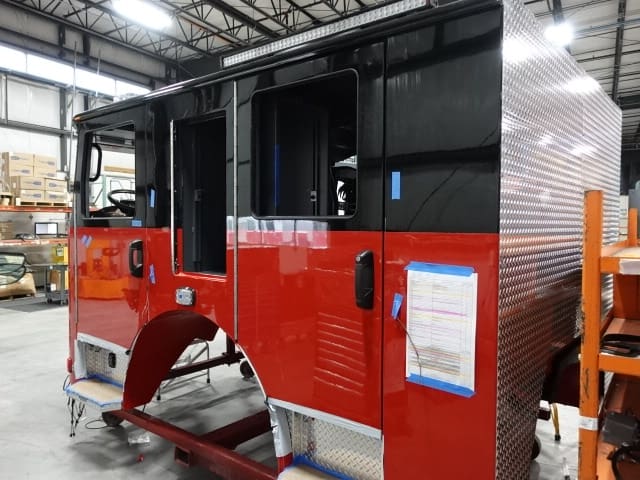

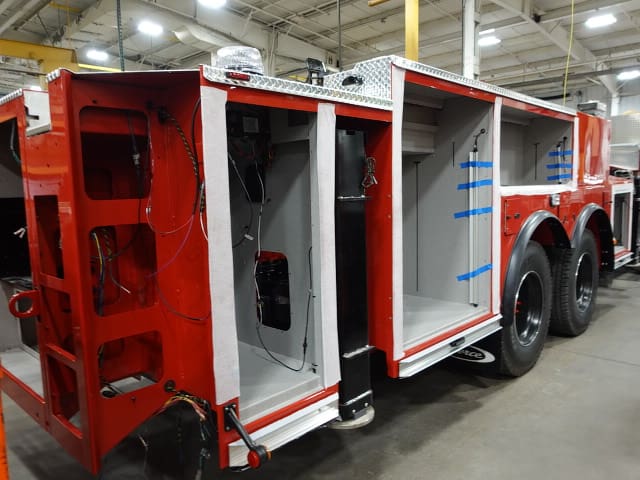

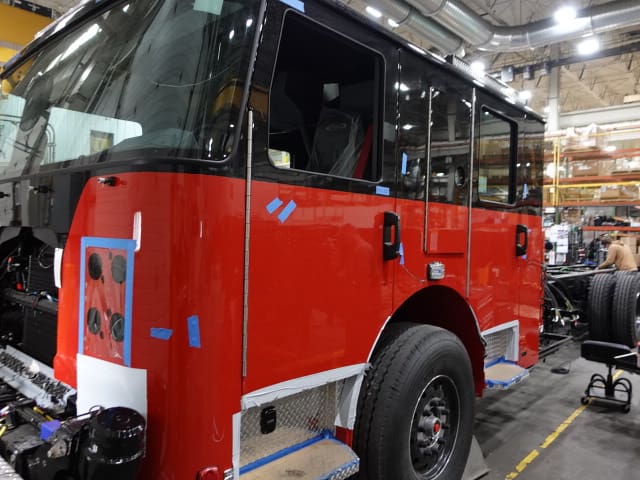

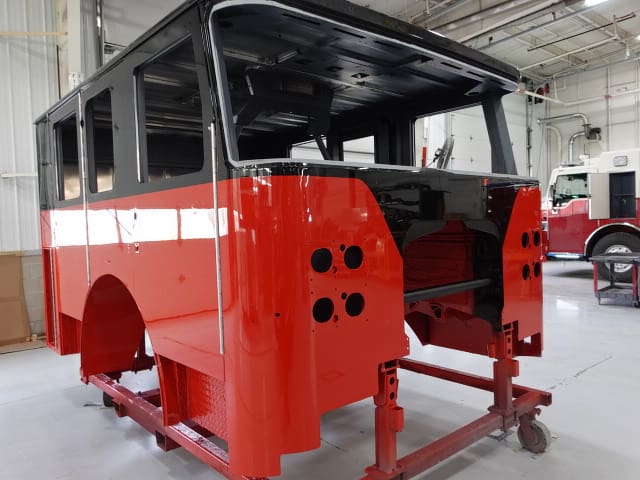

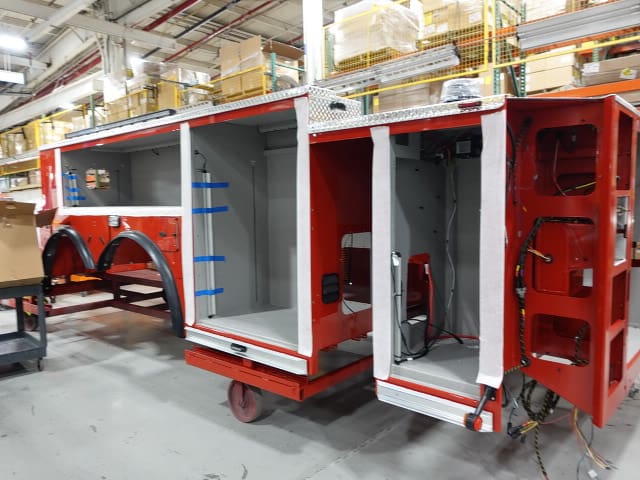

In this report, the cab competed initial assembly and was installed on the frame, the pump house continued initial assembly, the torque box remained staged, and the rear body module completed fabrication and began the paint process.

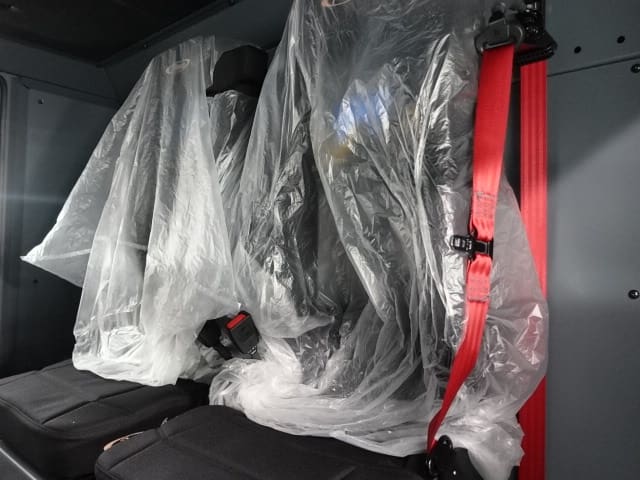

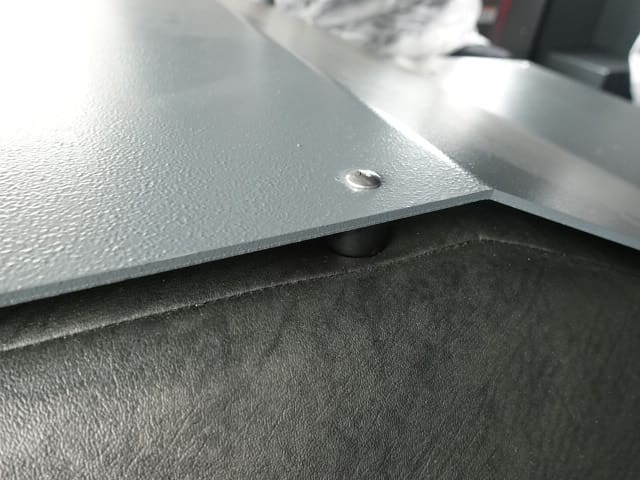

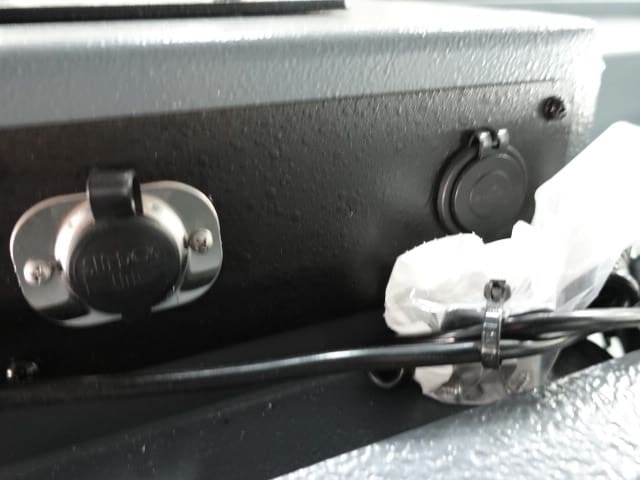

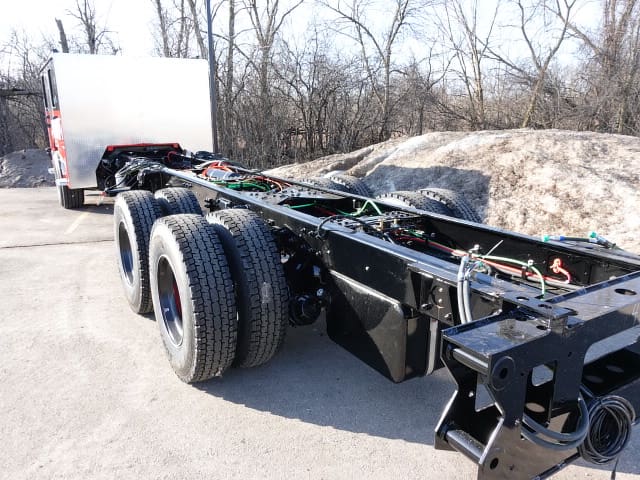

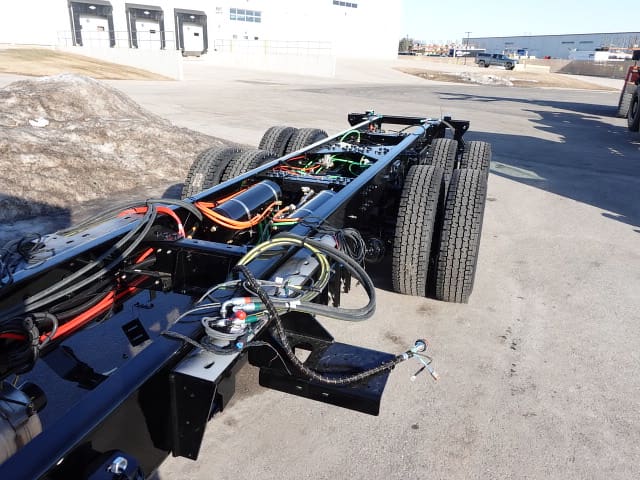

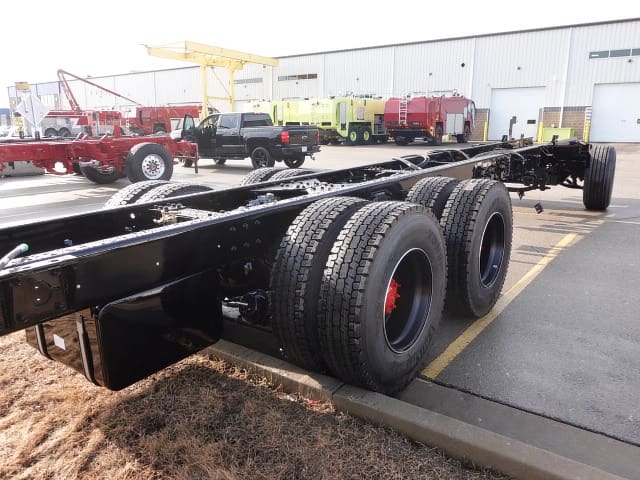

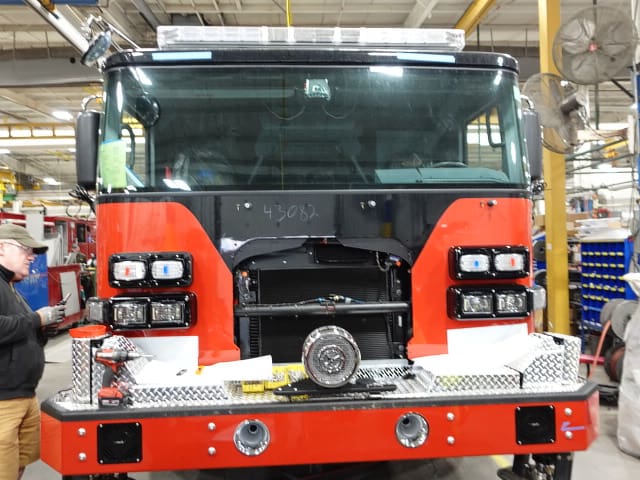

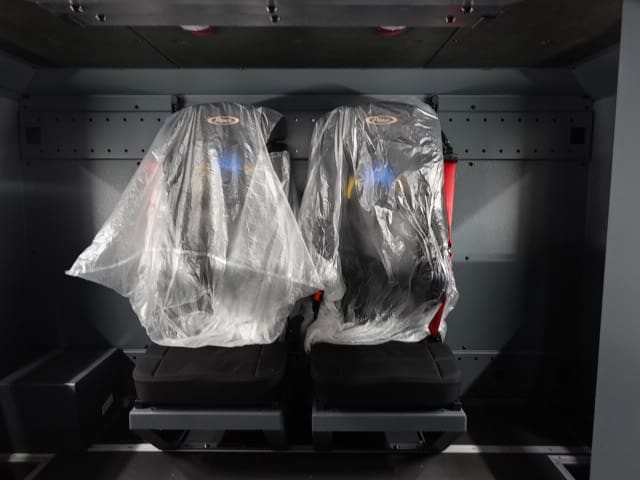

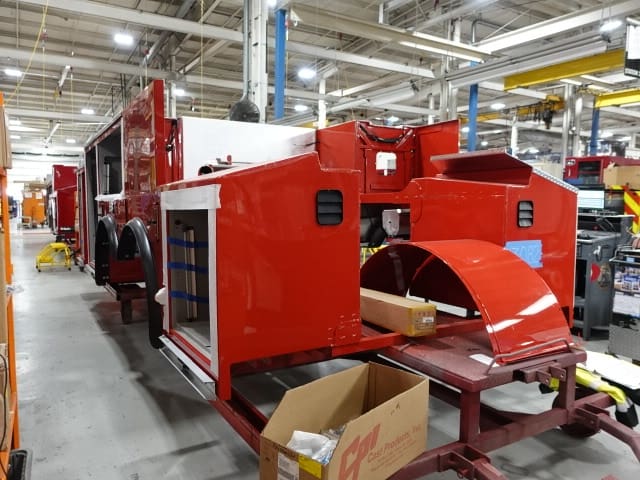

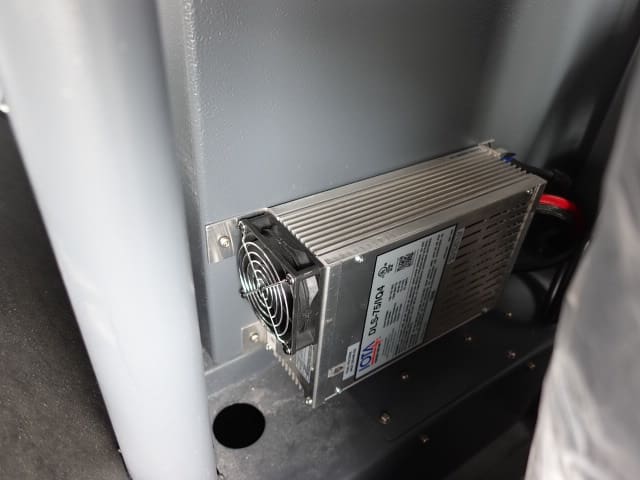

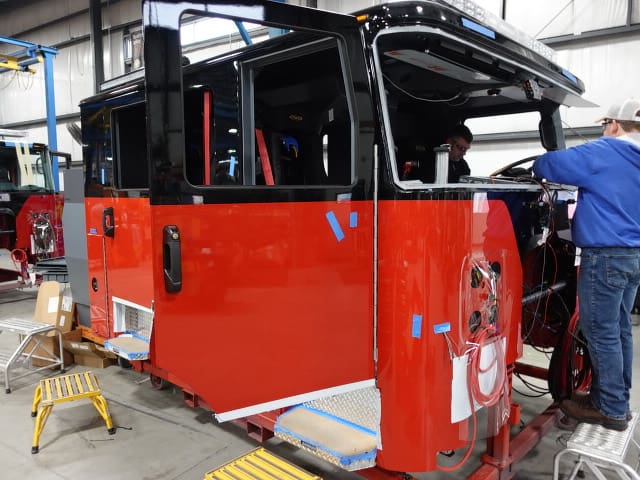

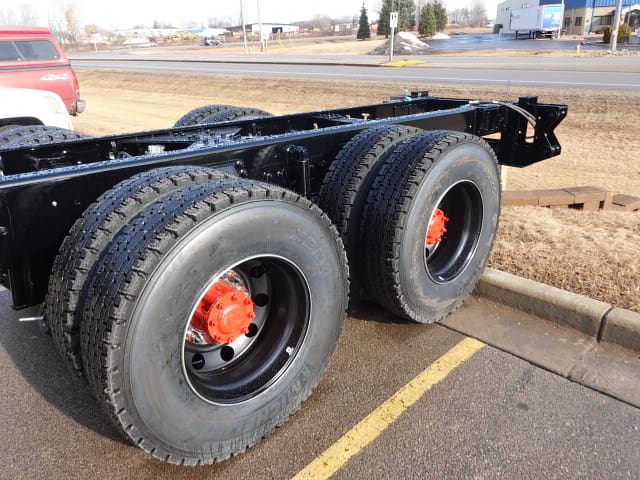

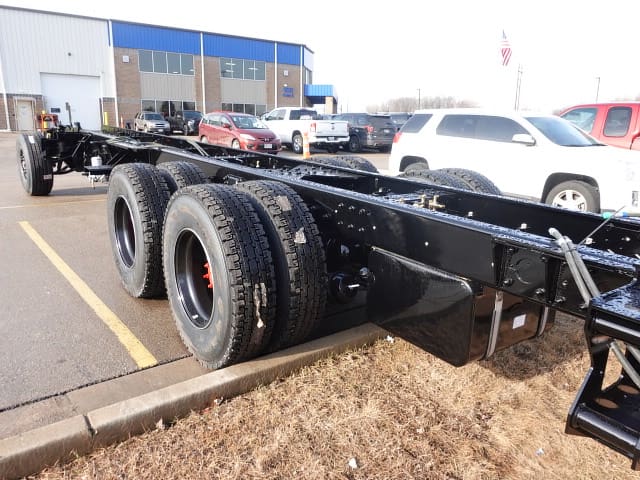

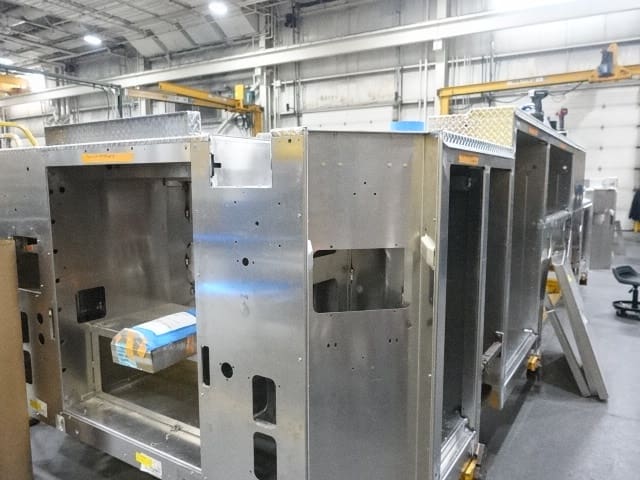

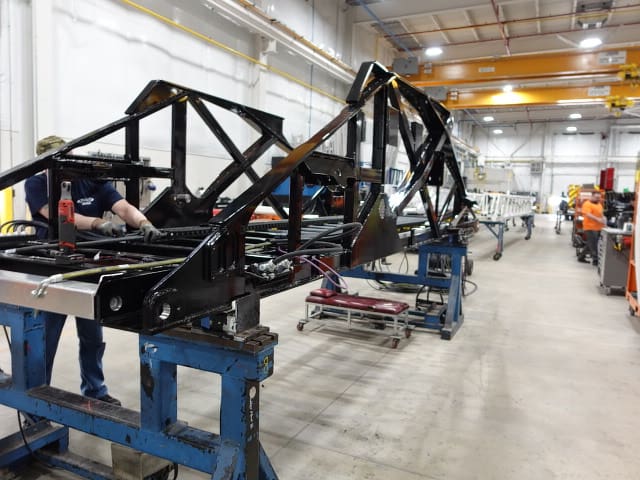

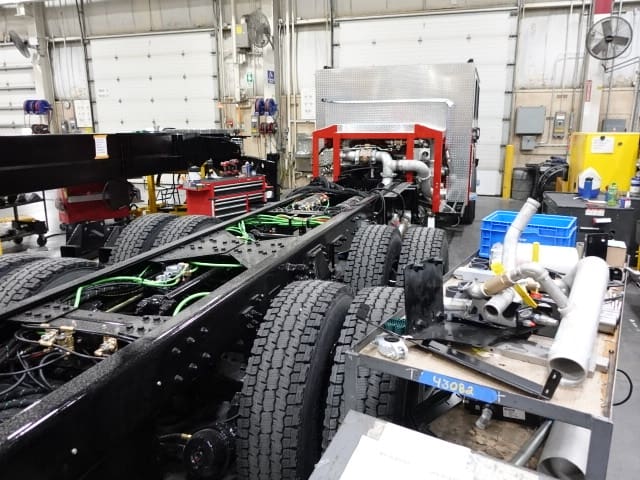

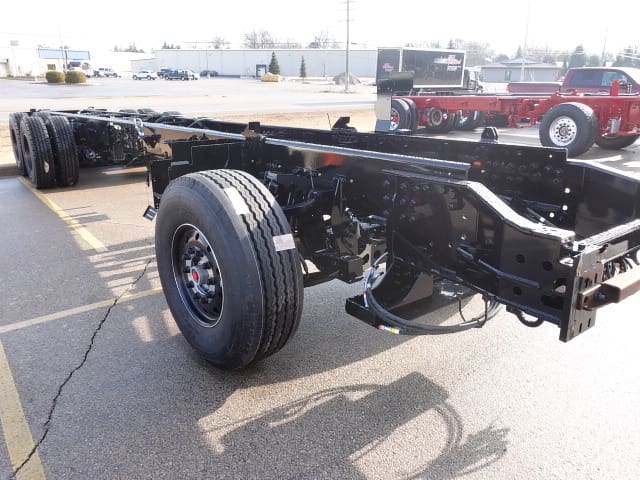

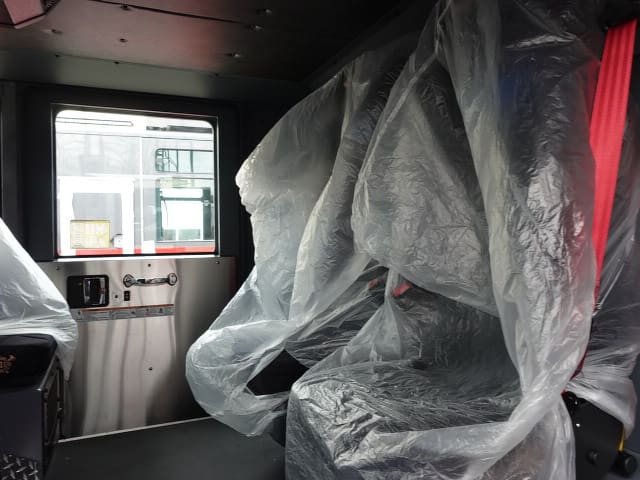

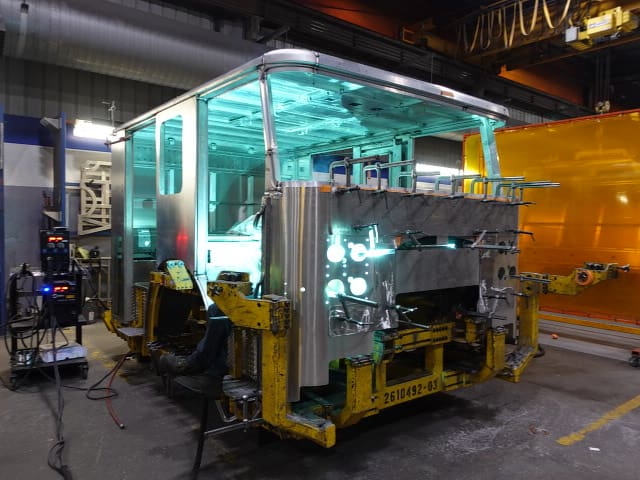

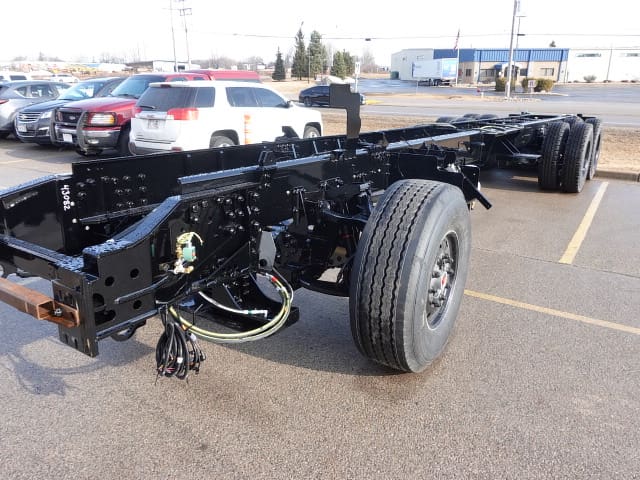

03-07-25

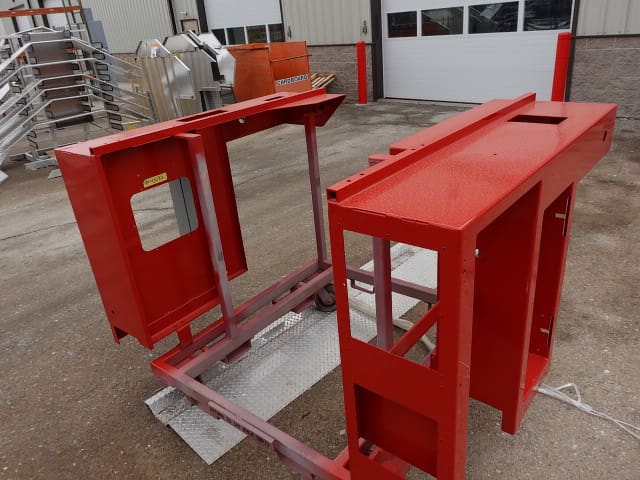

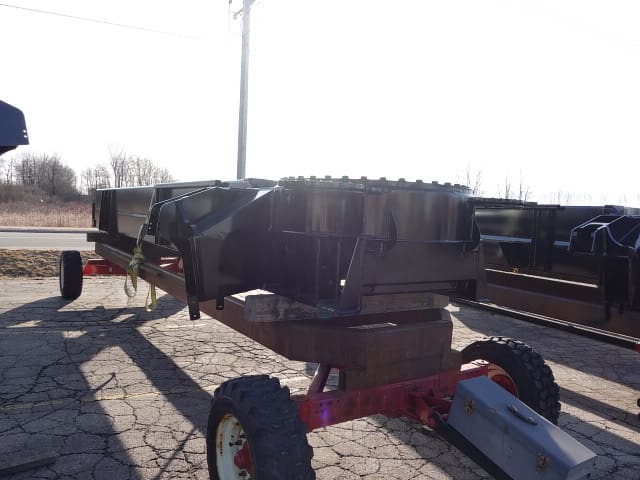

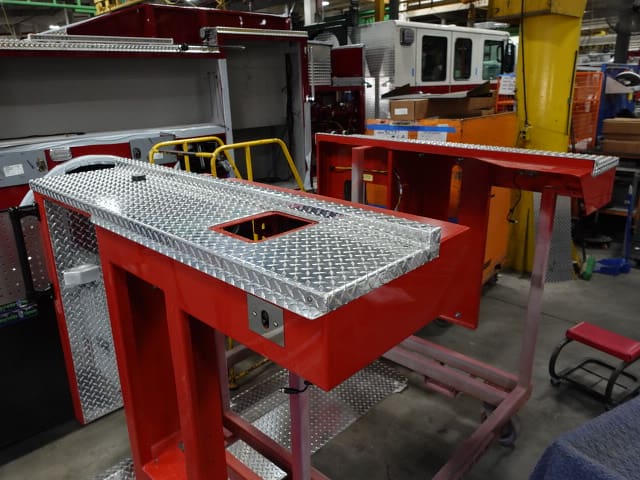

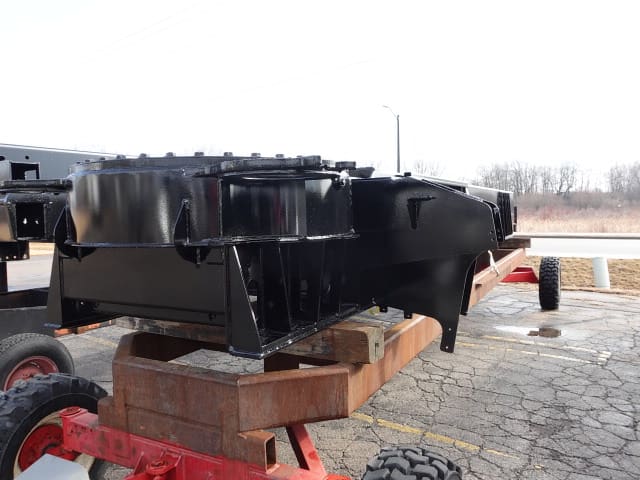

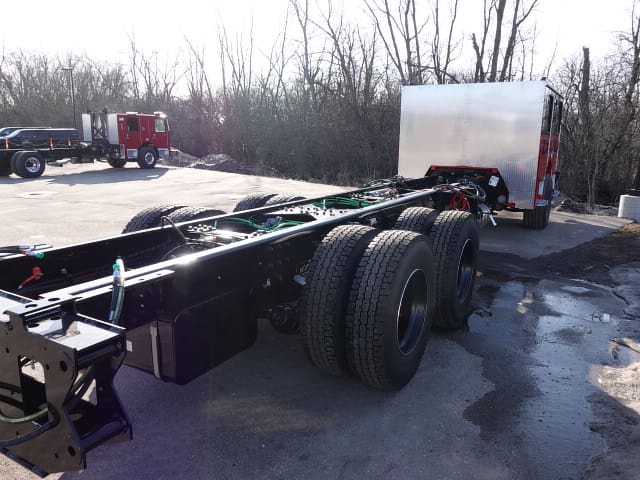

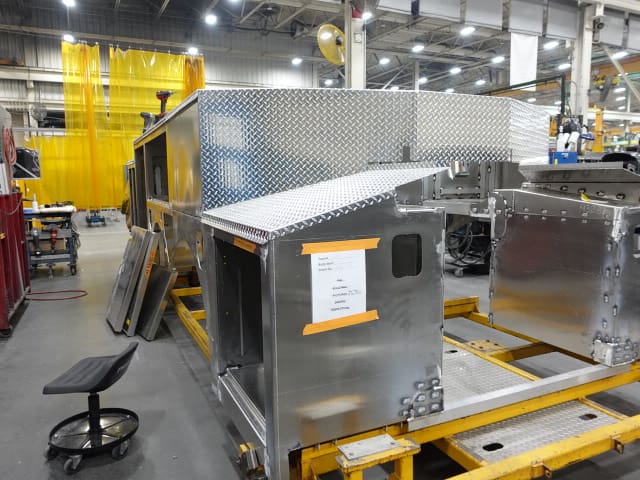

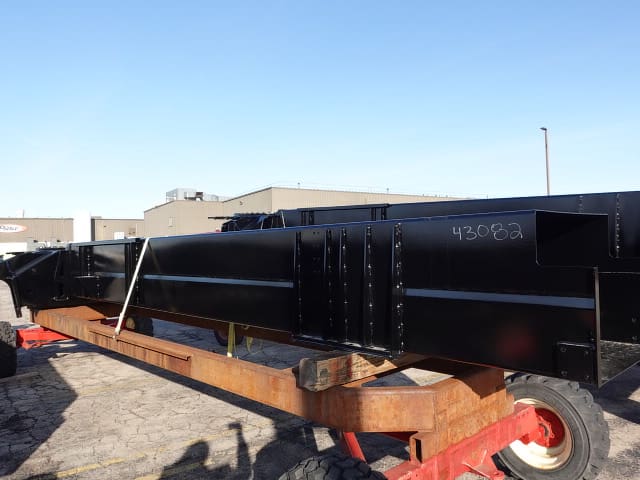

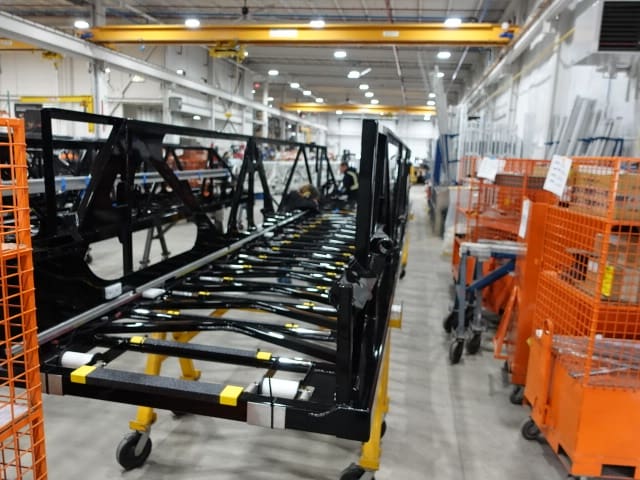

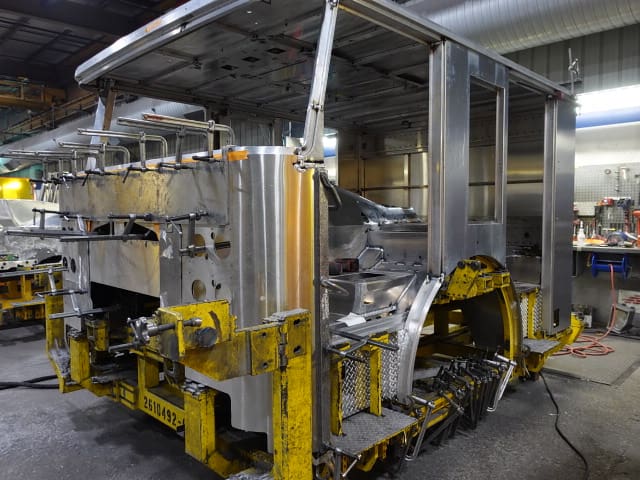

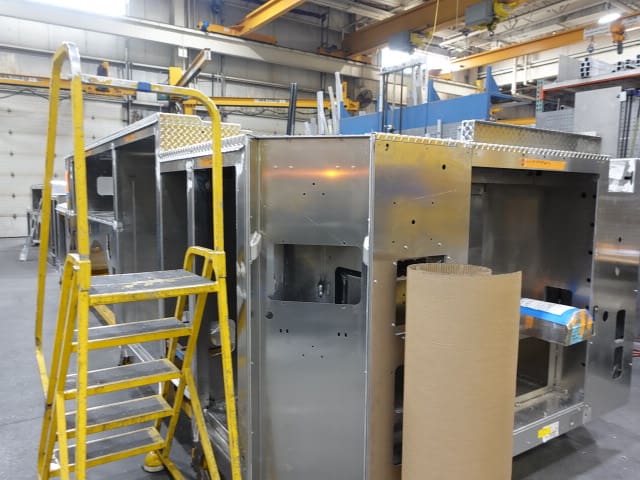

In this report, the cab began initial assembly, the frame build began, the pump house began initial assembly, the torque box arrived and was staged, and the rear body module began fabrication.

02-28-25

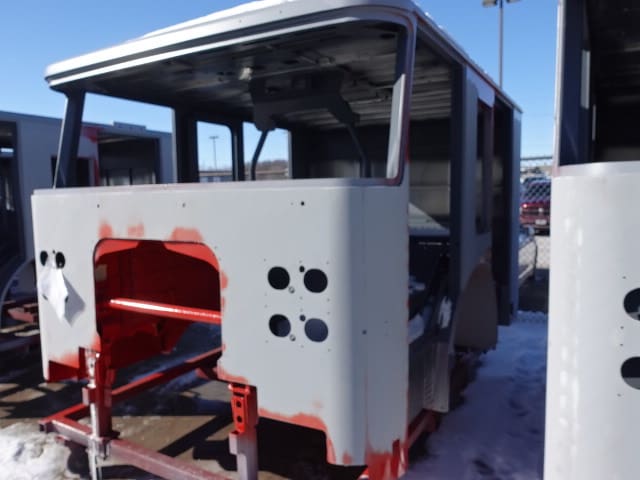

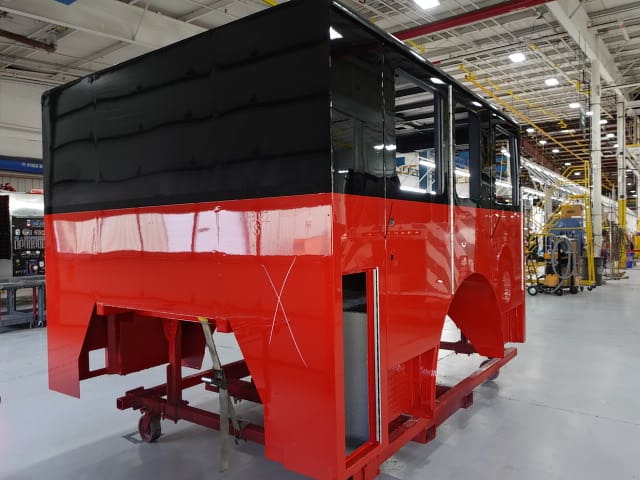

In this report, the cab completed the paint process.

02-21-25

In this report, the cab remained staged to continue through paint.

02-14-25

In this report, the cab began the paint process.

02-07-25

In this report, the cab remained staged to begin the paint process.

01-24-25

In this report, the cab completed fabrication and was staged.

01-17-25

This new Pierce apparatus is now in production! In this report, the cab began fabrication.
