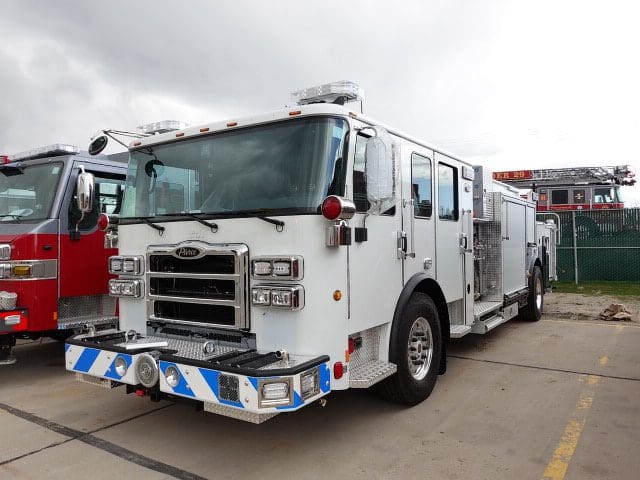

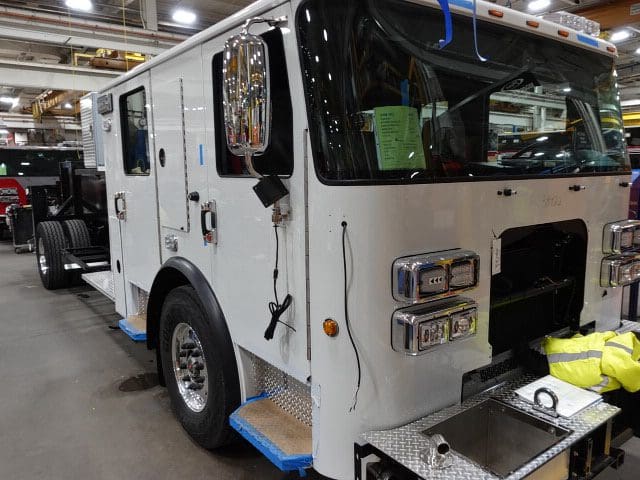

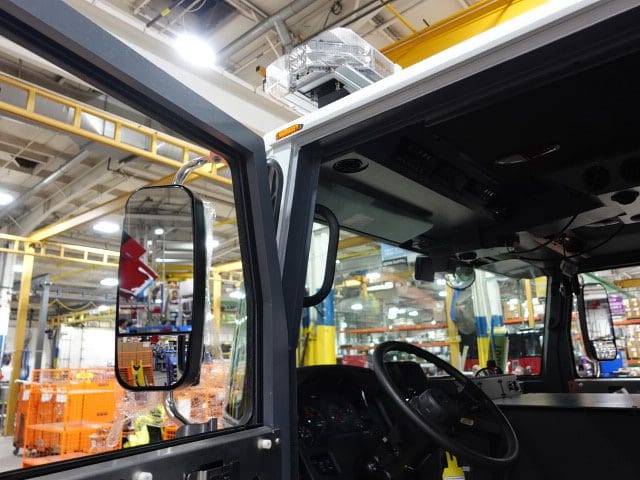

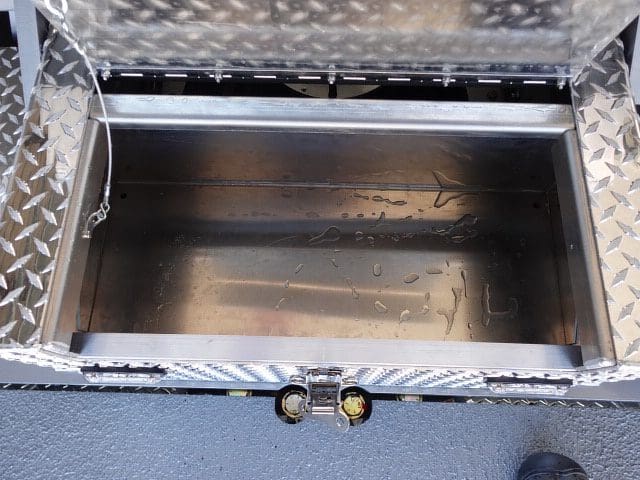

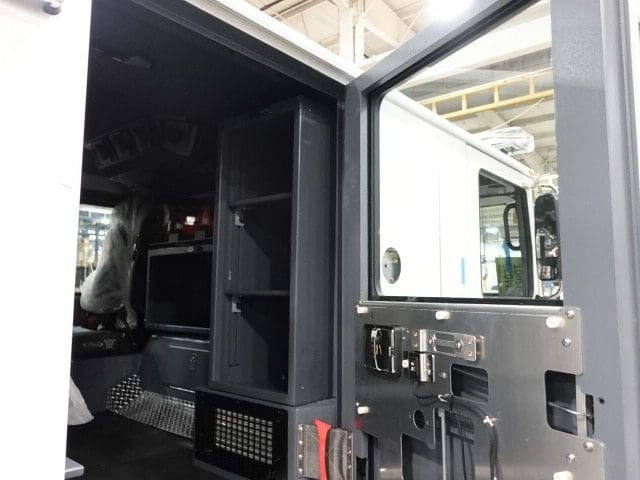

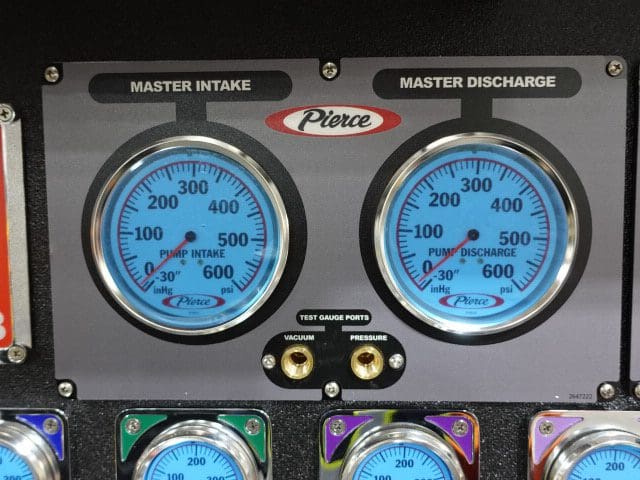

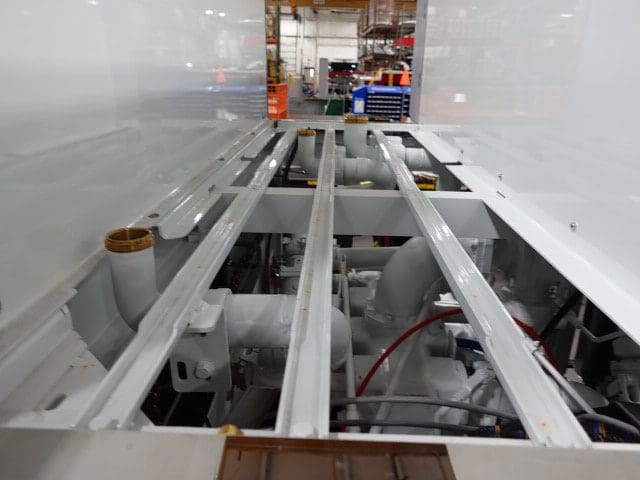

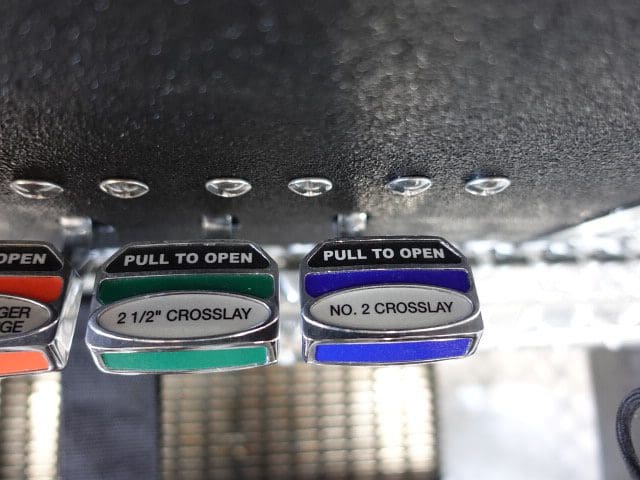

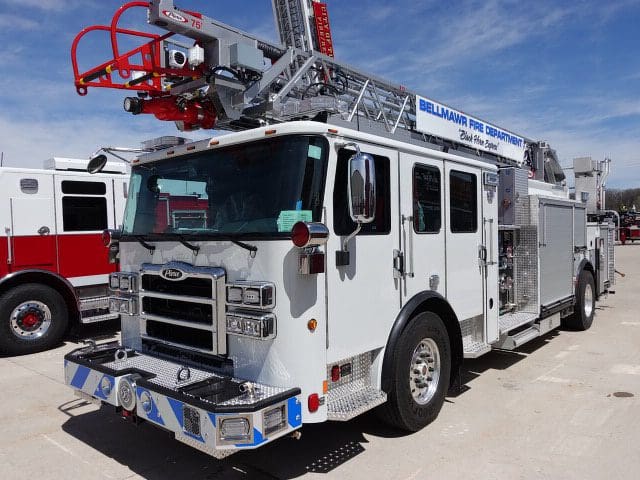

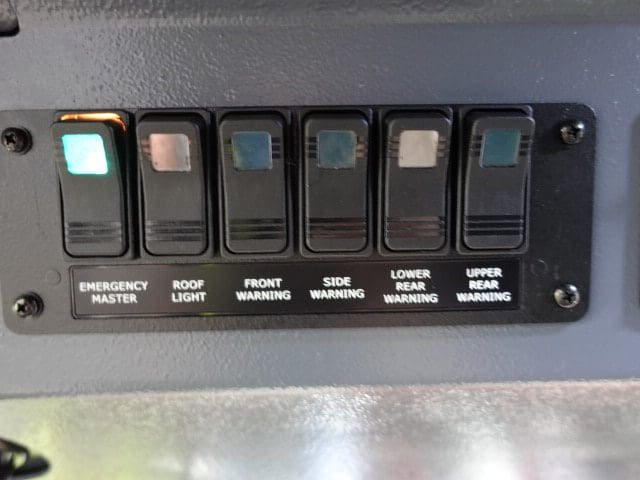

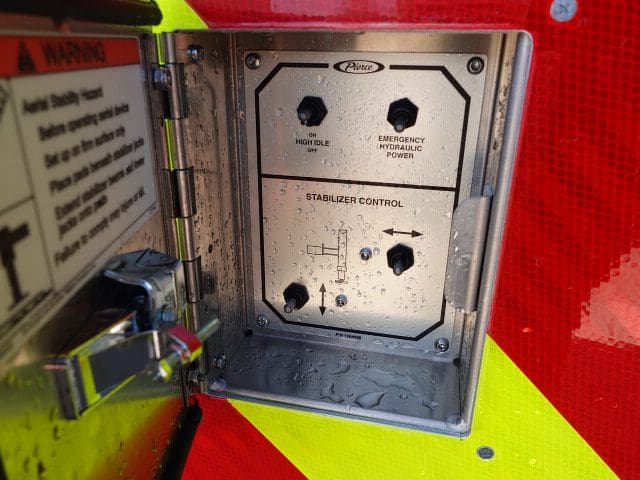

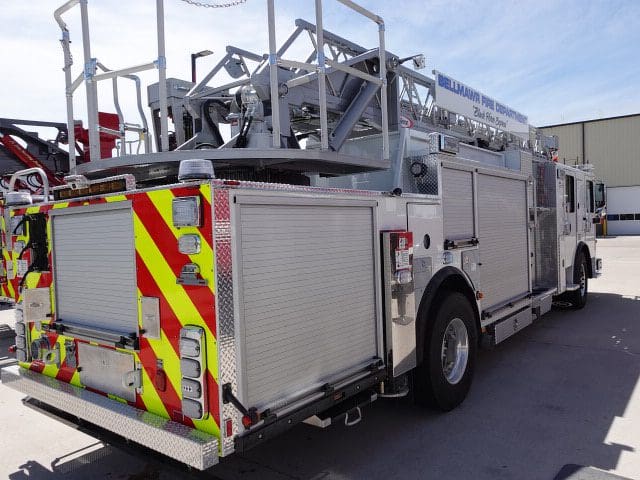

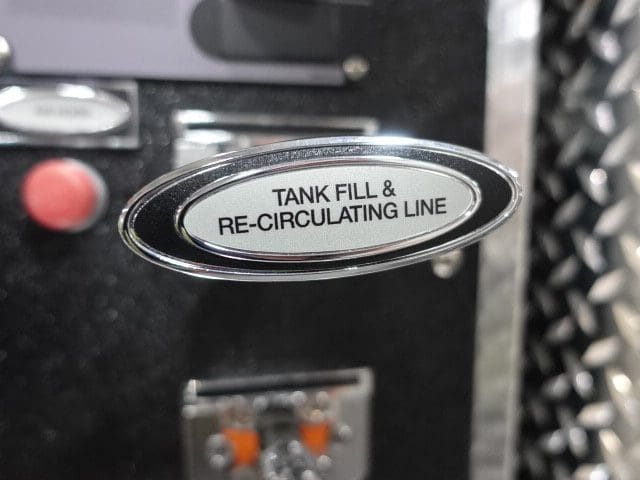

05-10-24

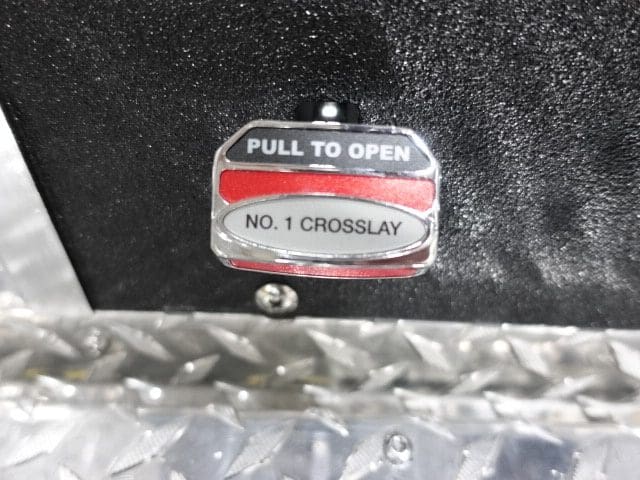

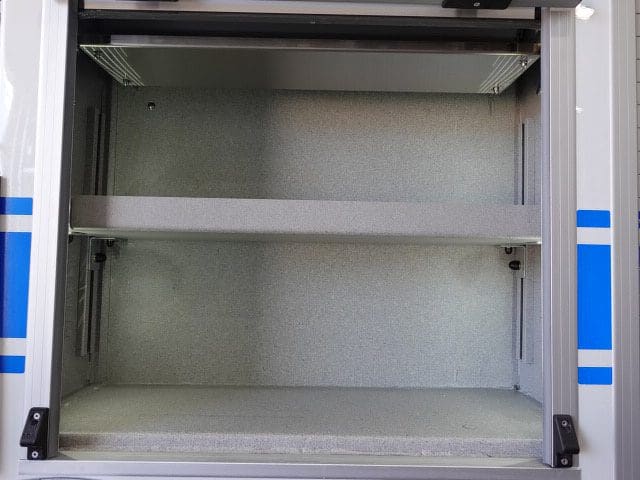

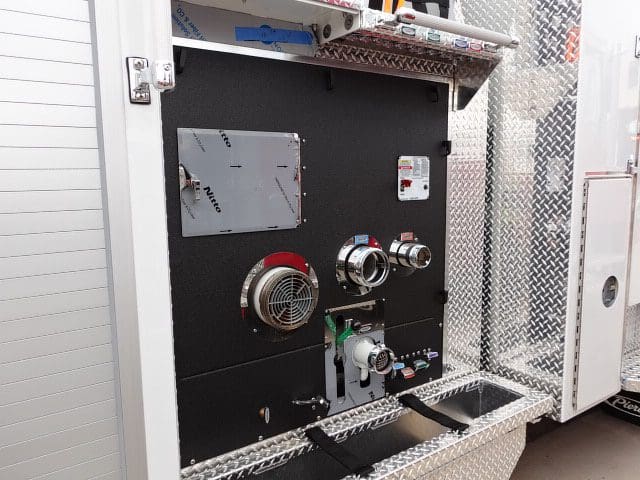

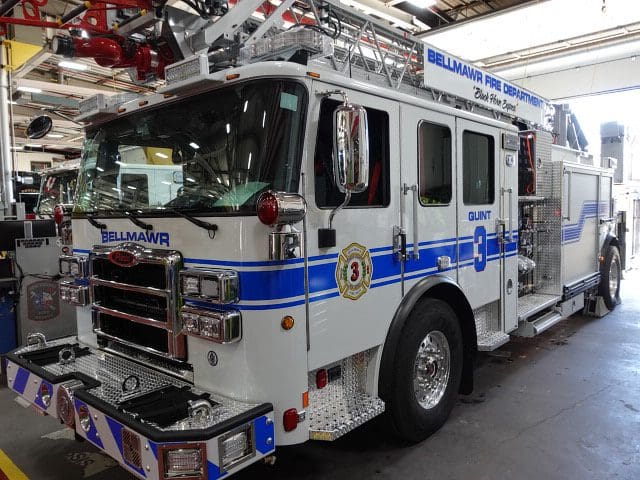

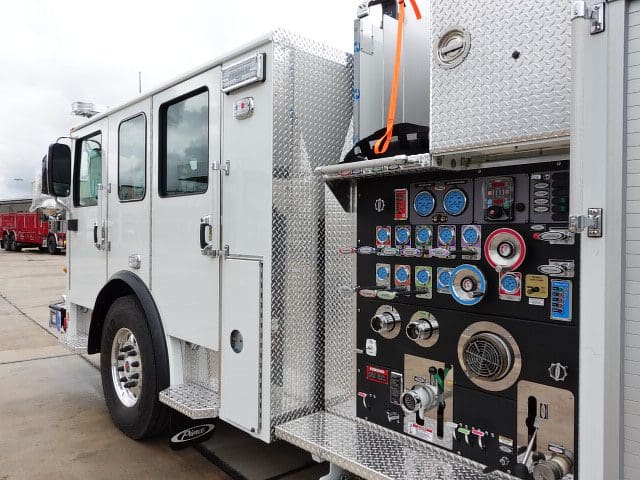

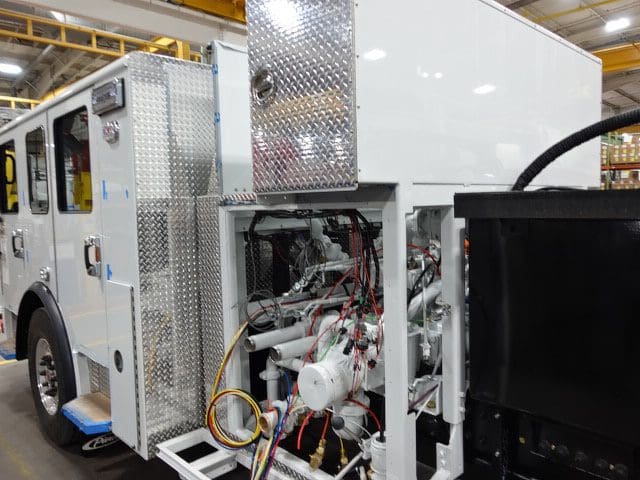

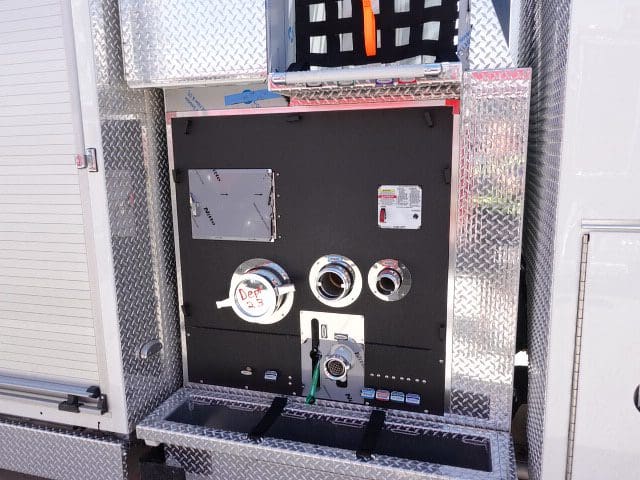

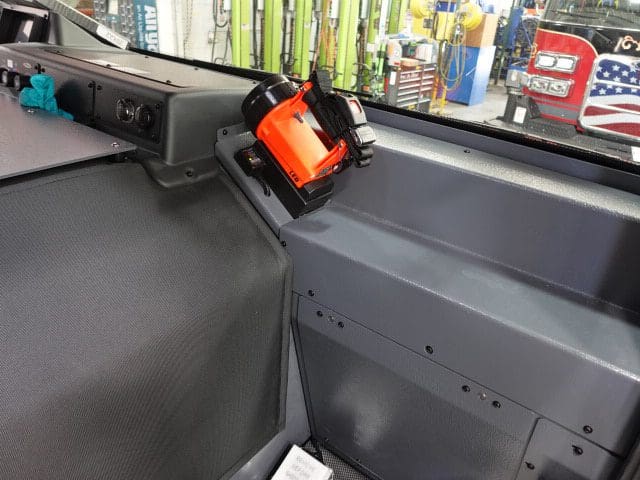

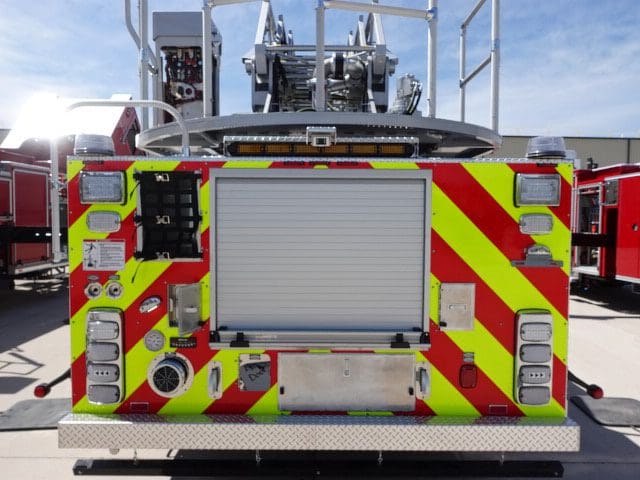

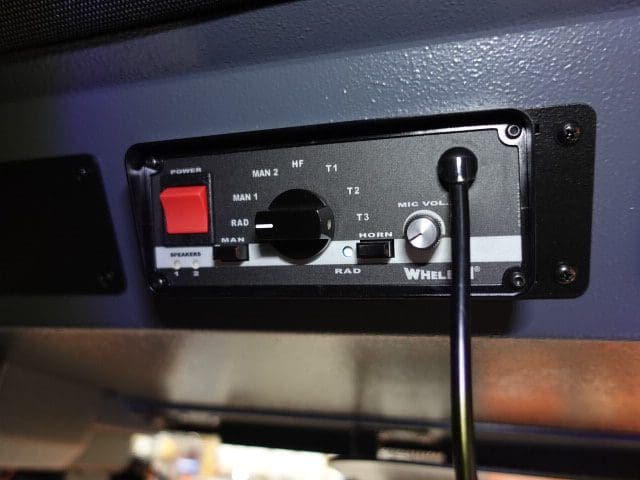

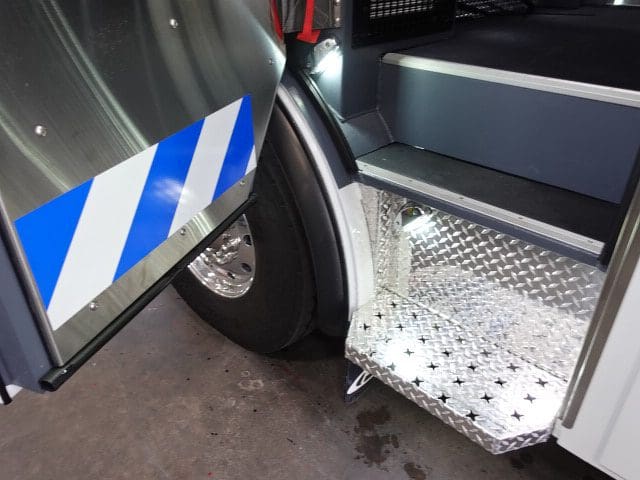

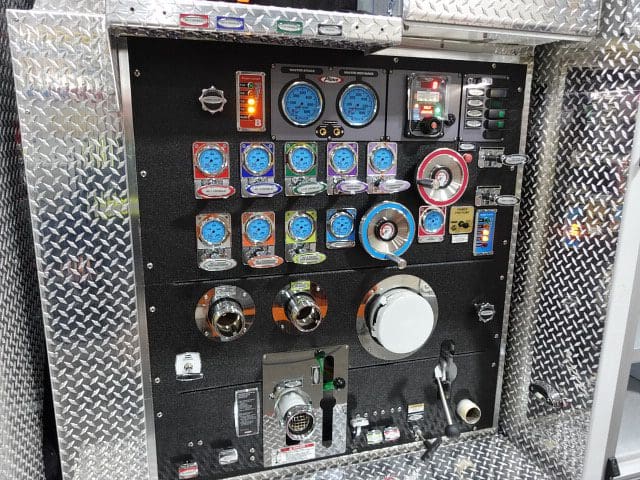

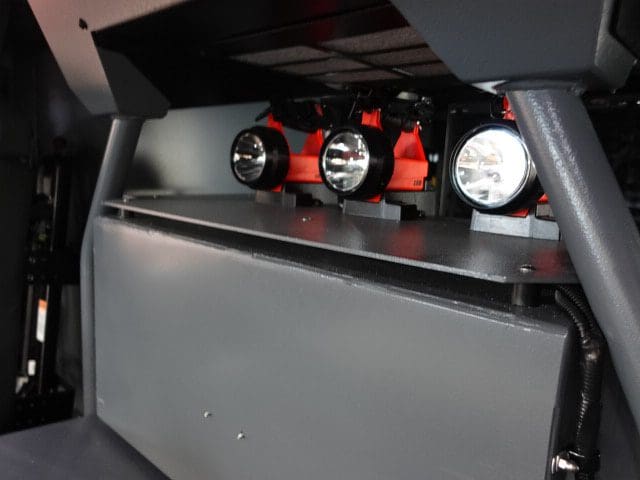

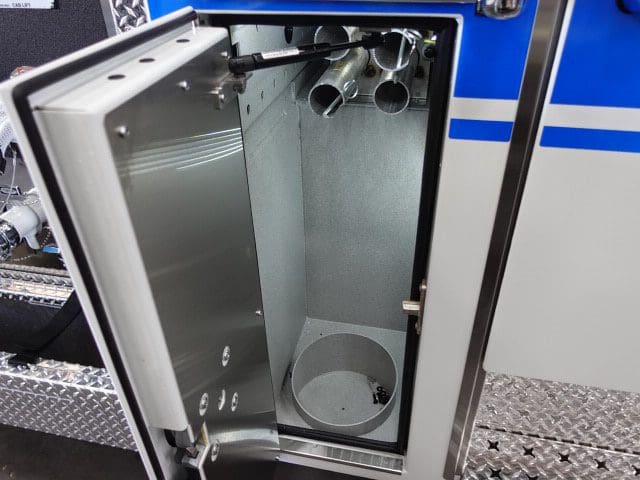

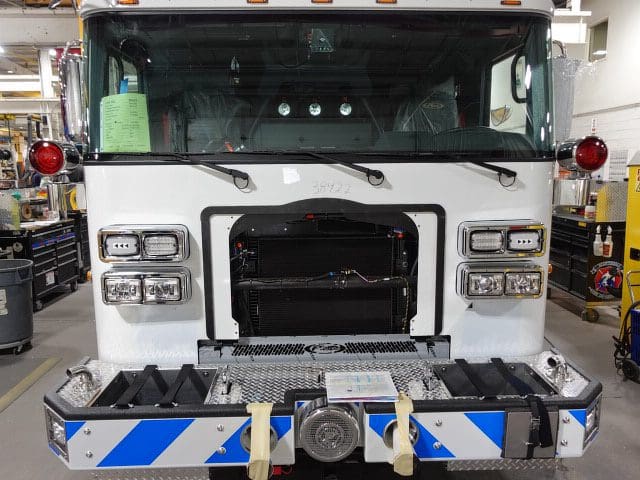

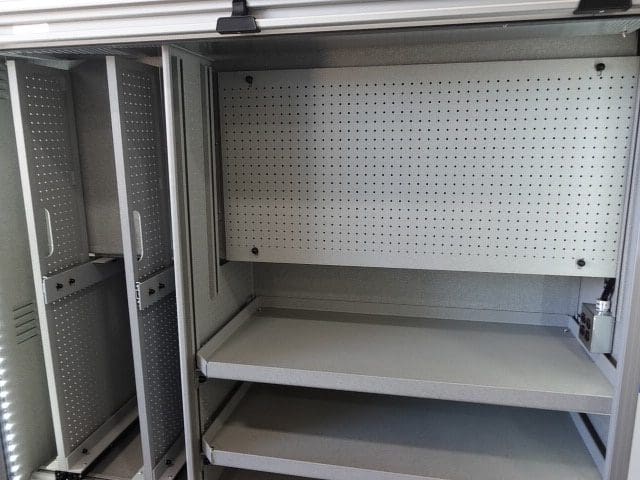

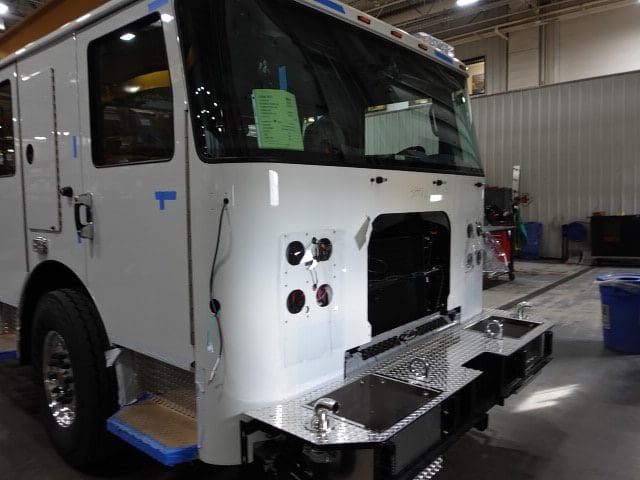

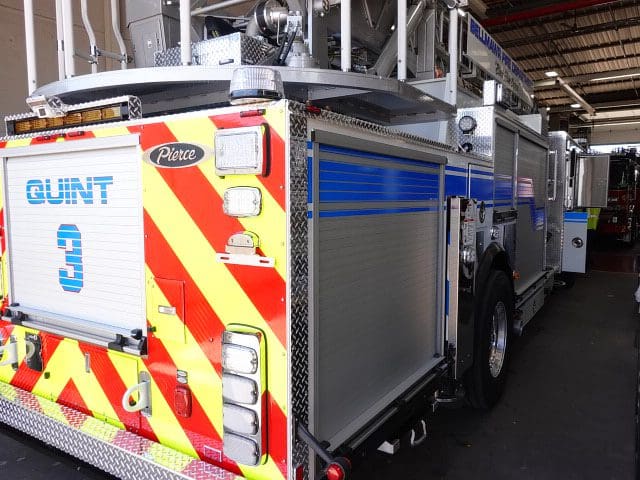

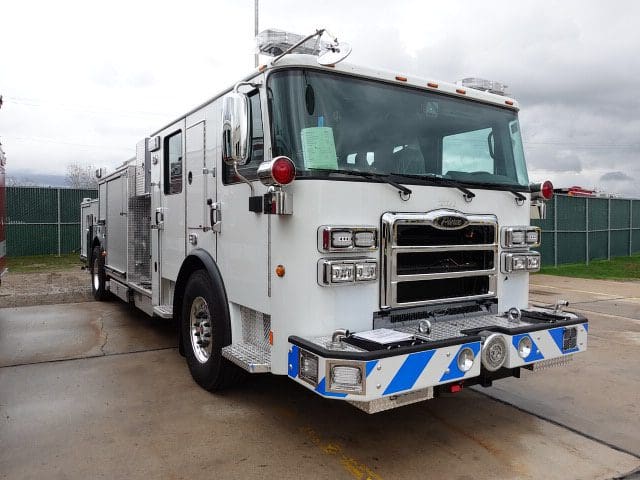

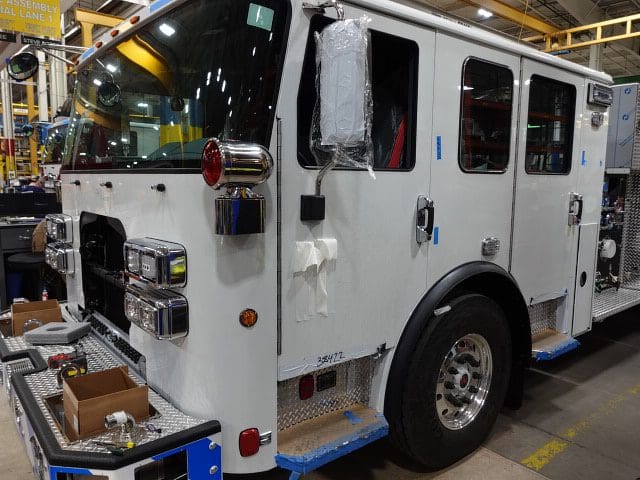

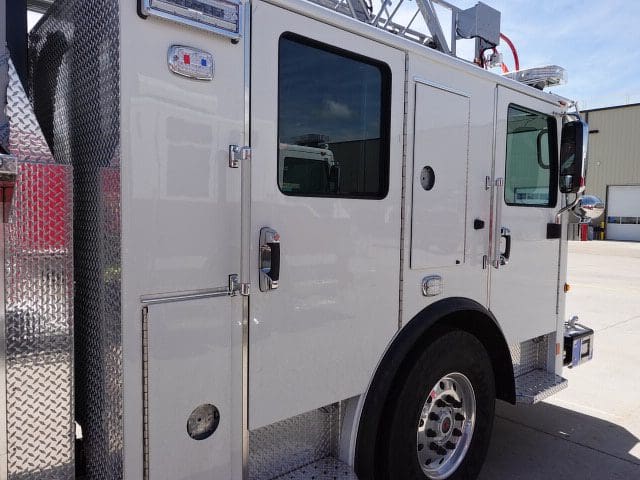

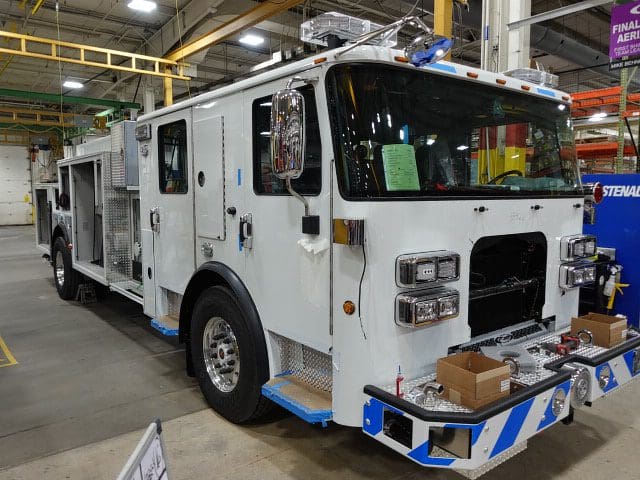

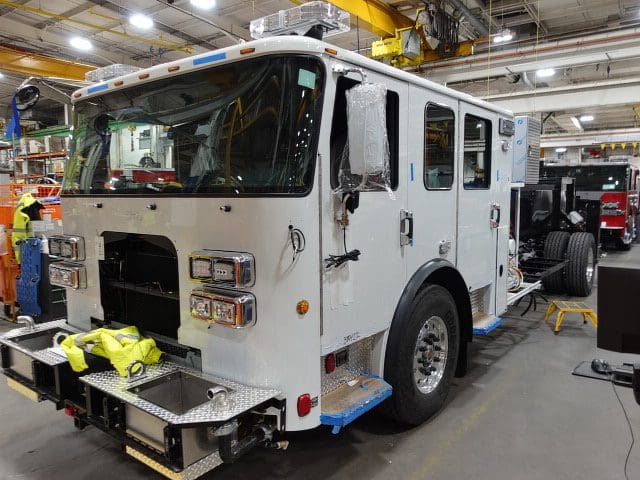

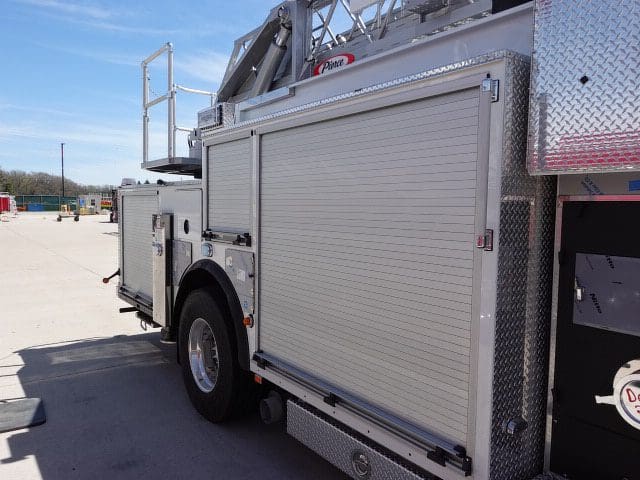

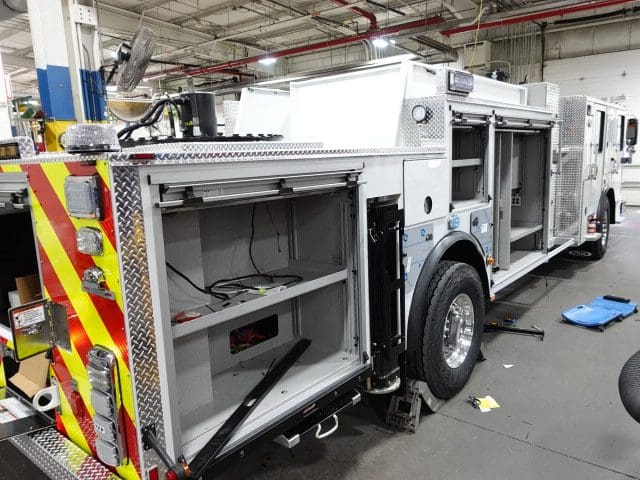

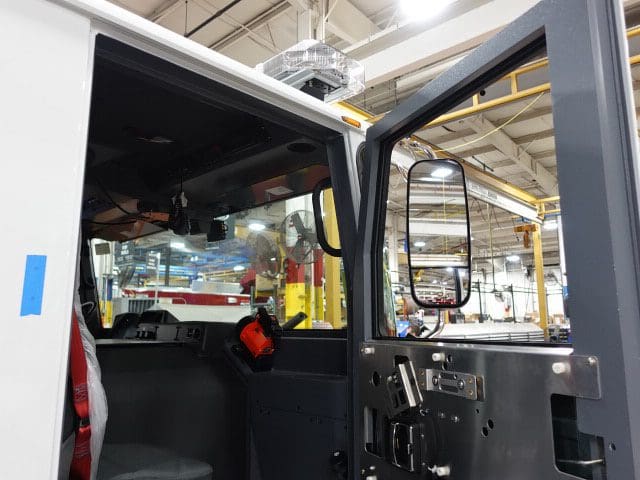

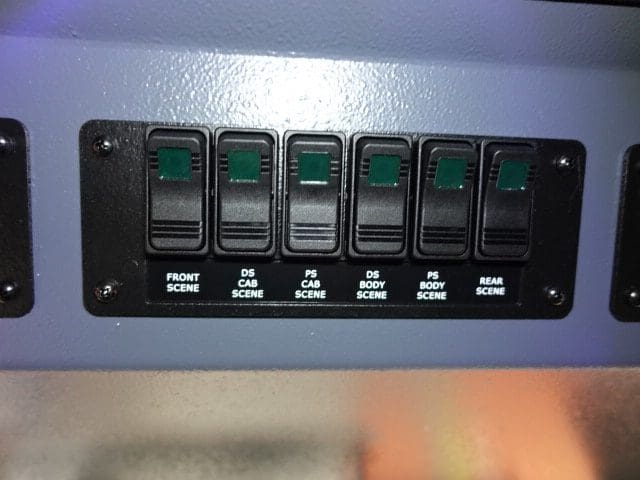

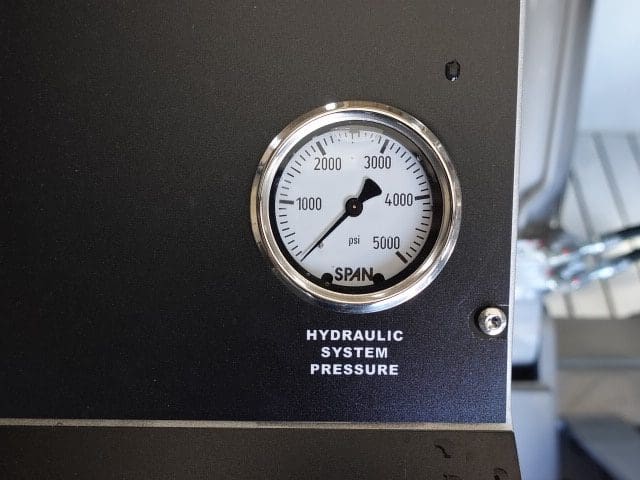

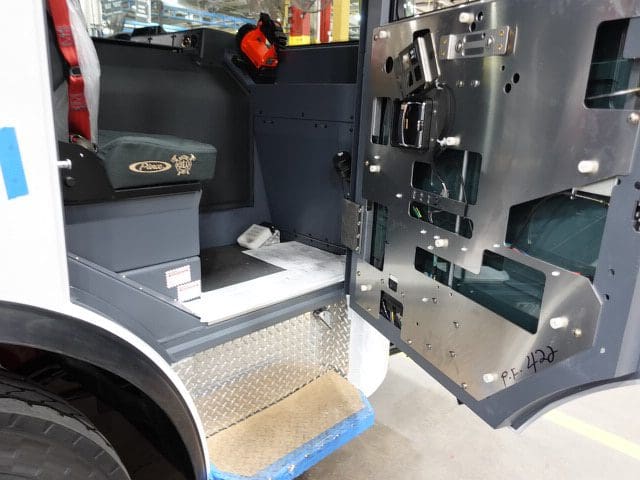

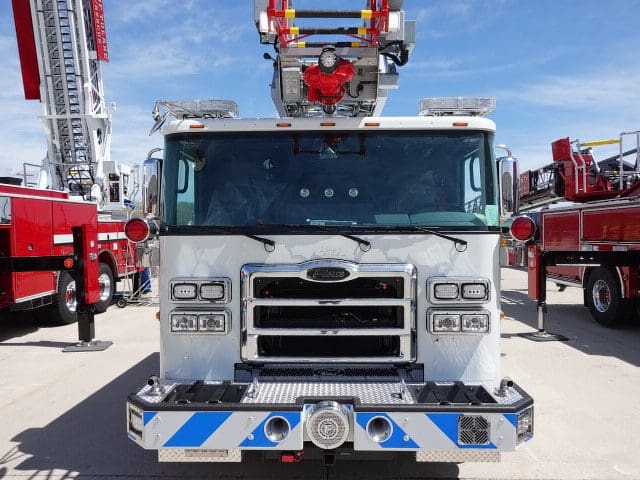

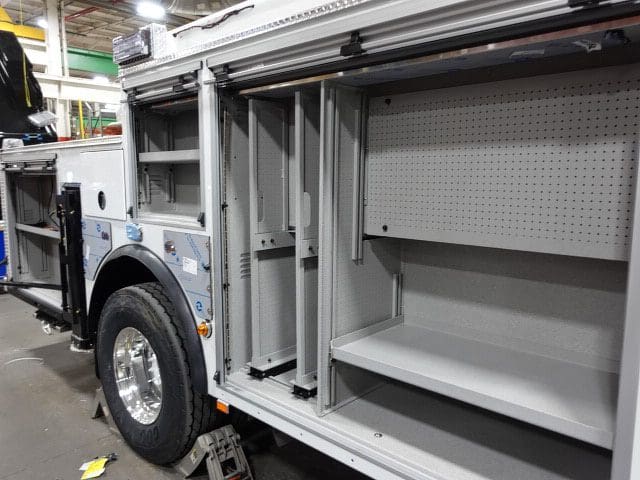

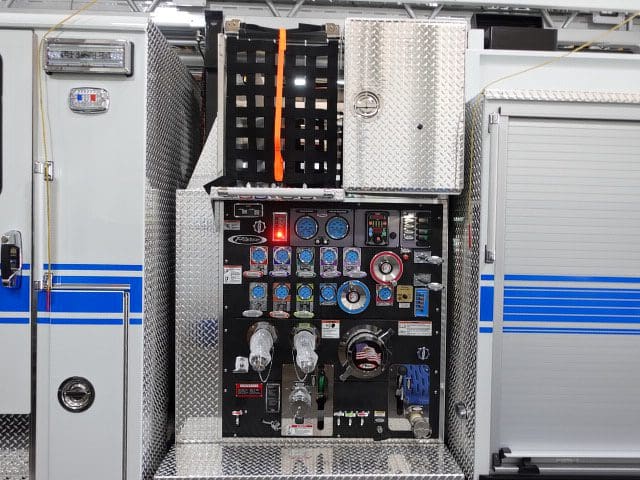

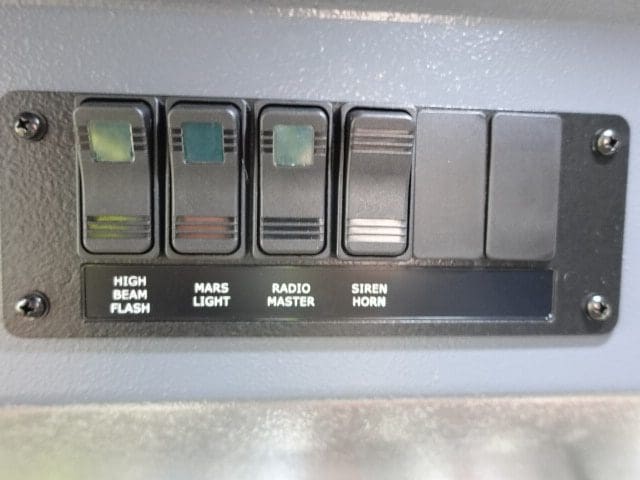

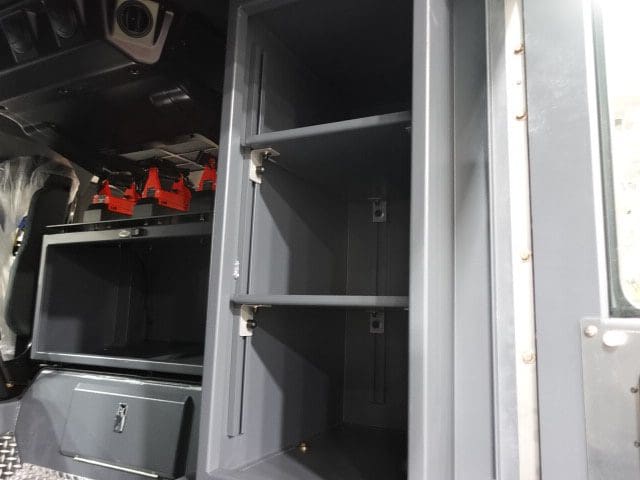

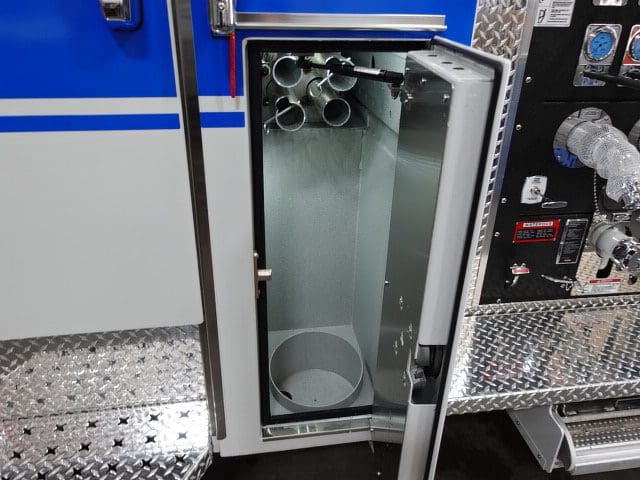

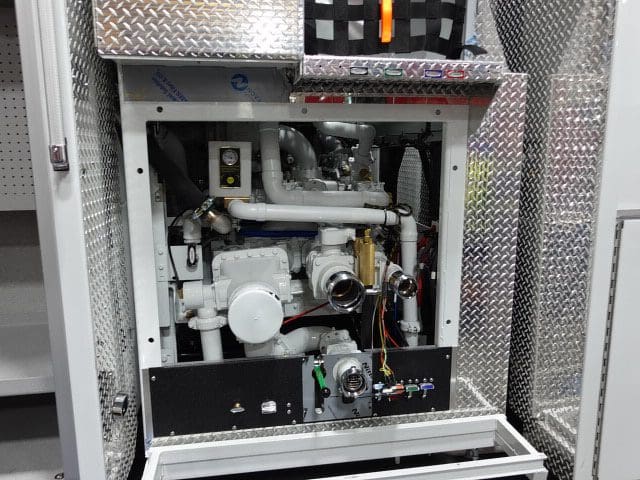

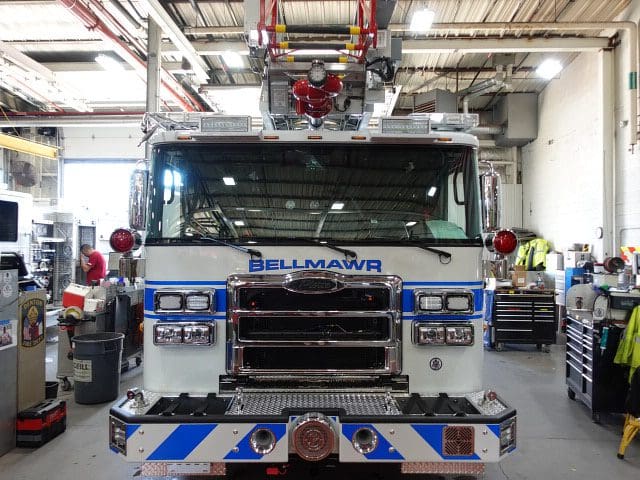

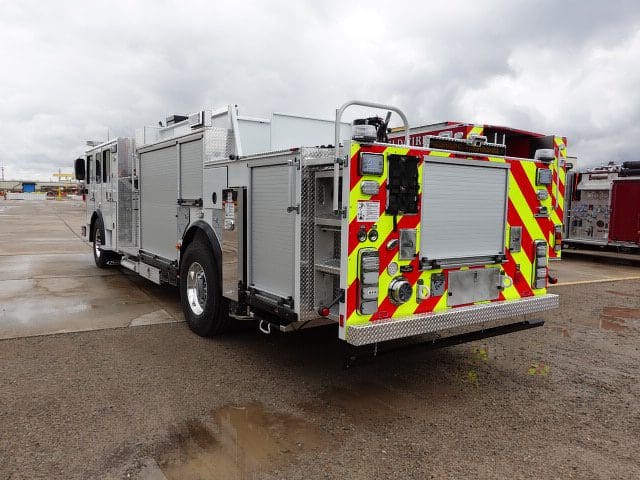

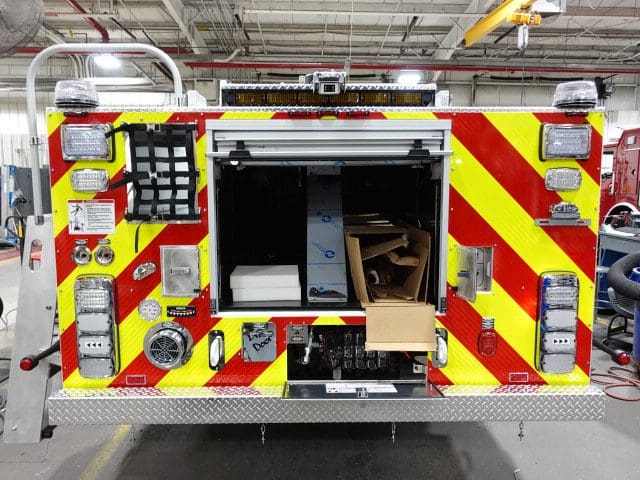

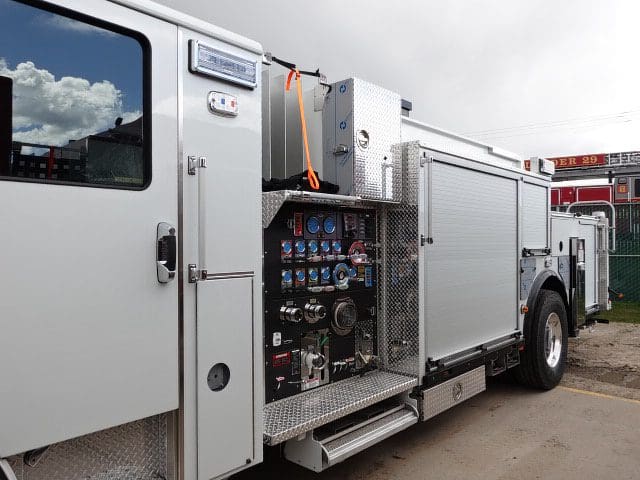

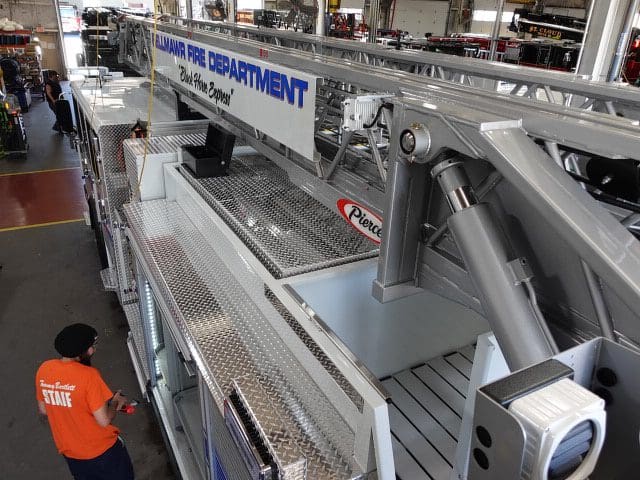

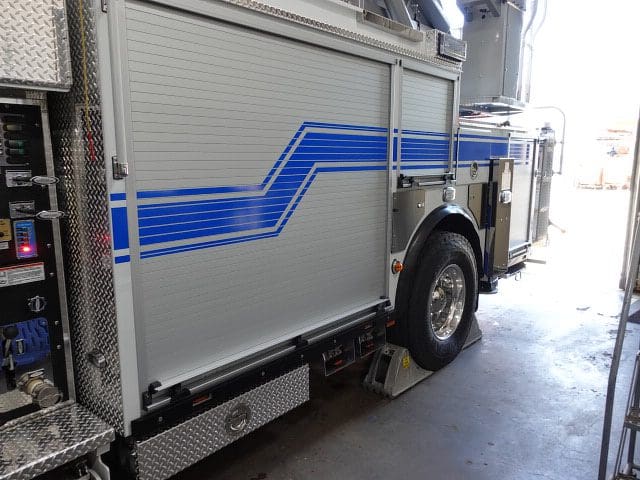

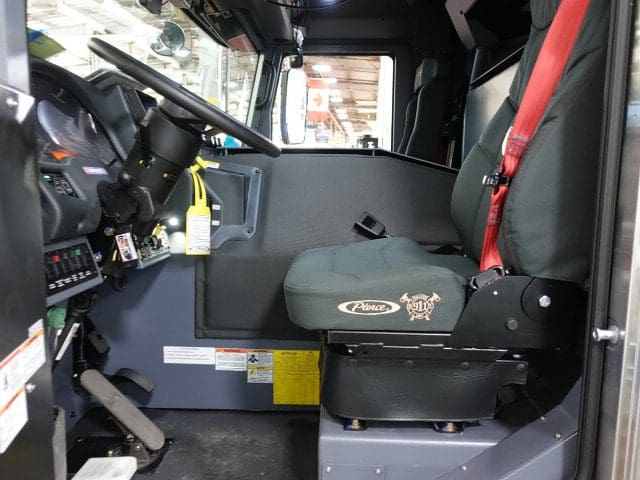

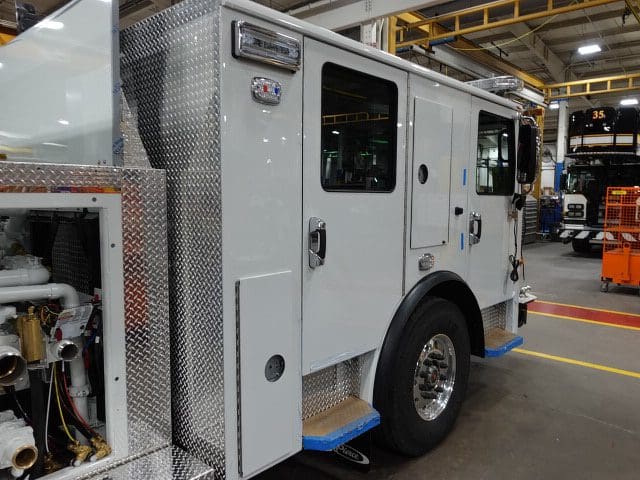

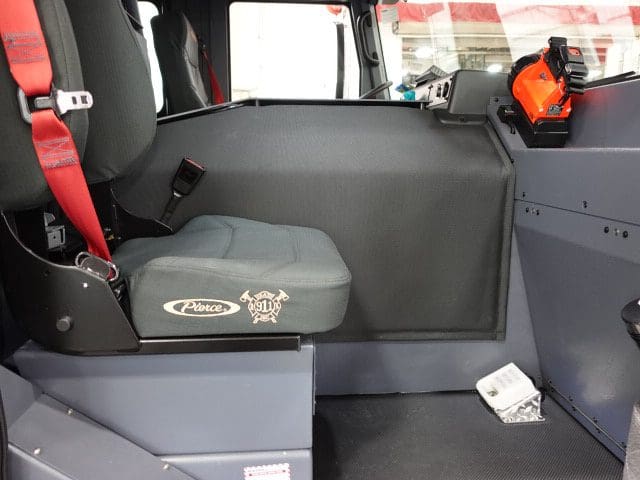

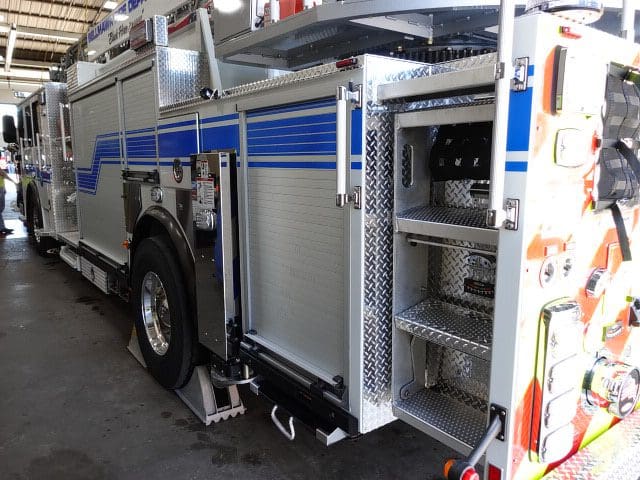

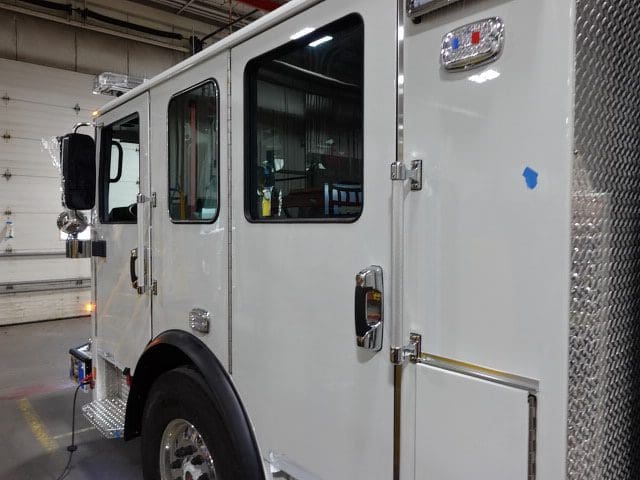

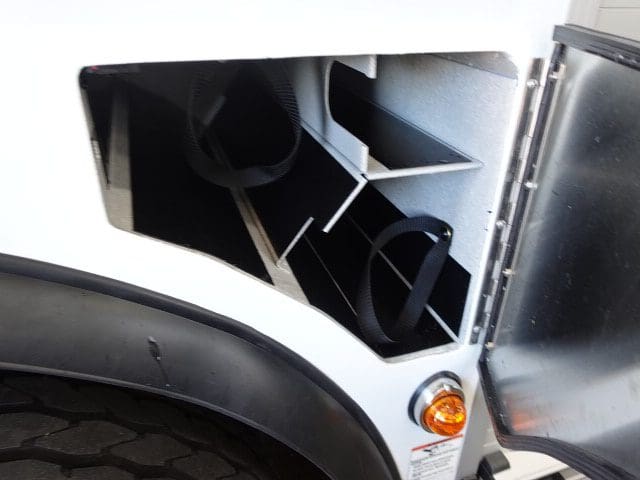

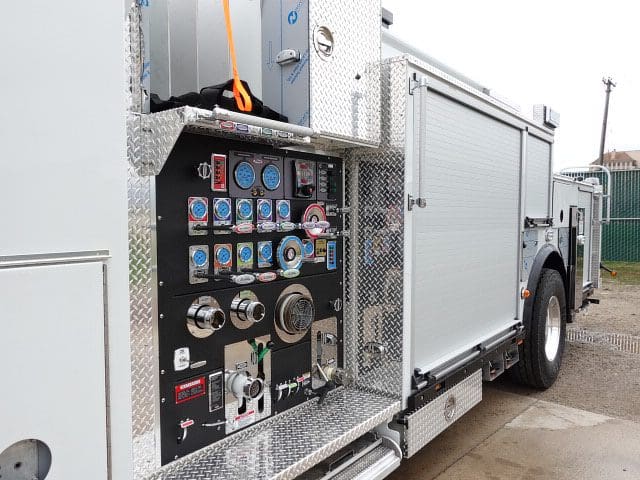

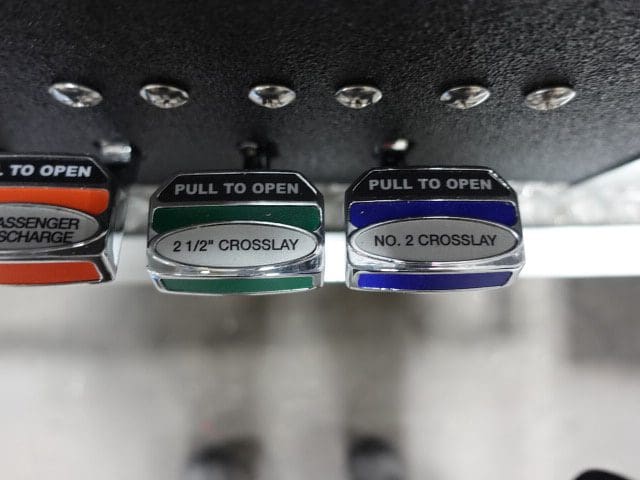

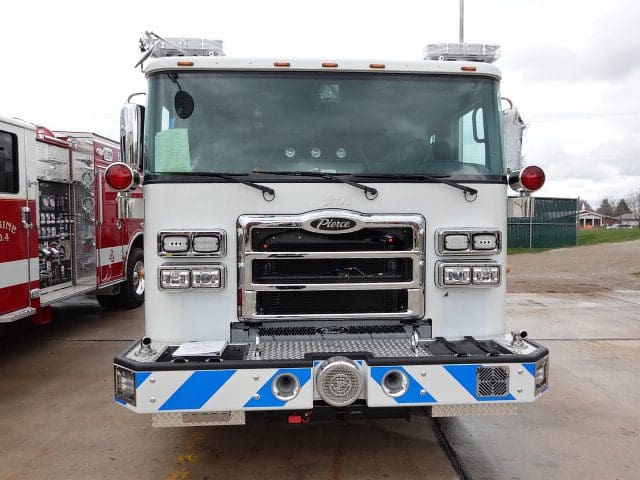

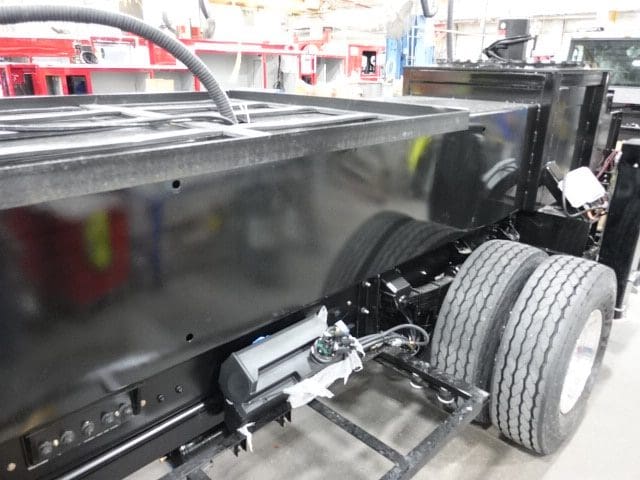

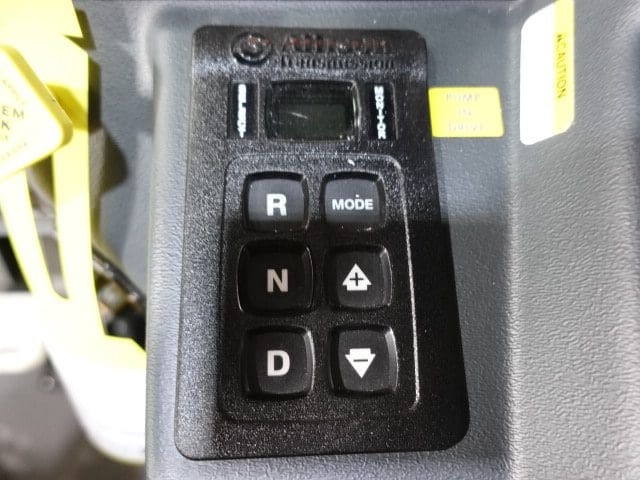

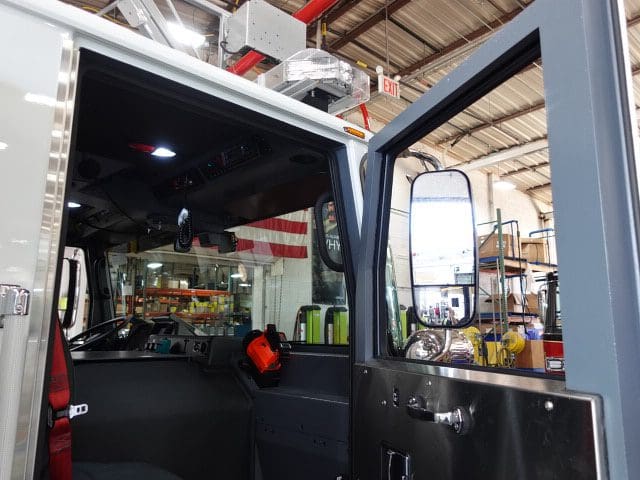

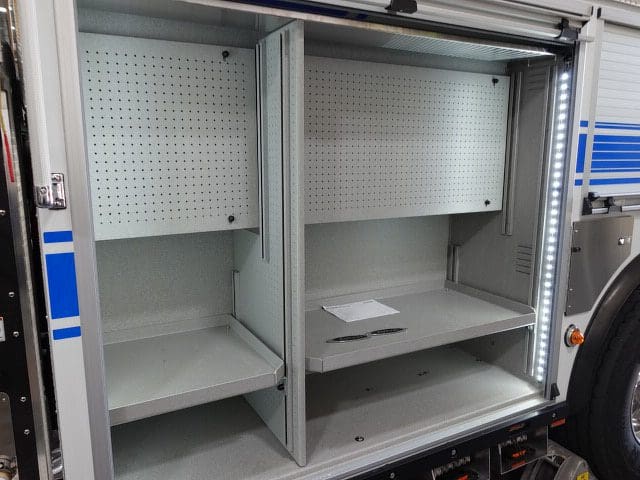

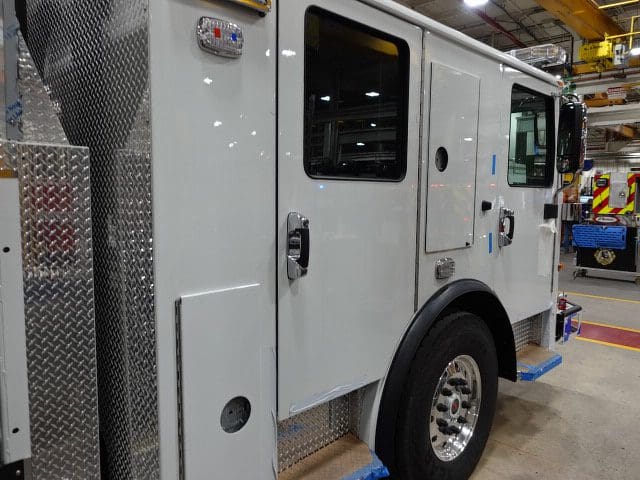

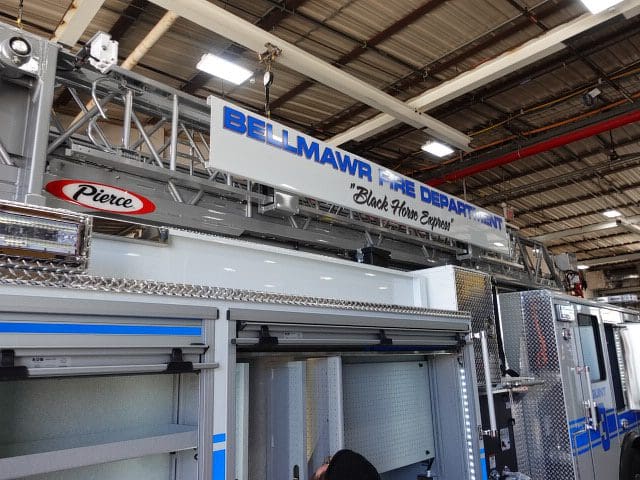

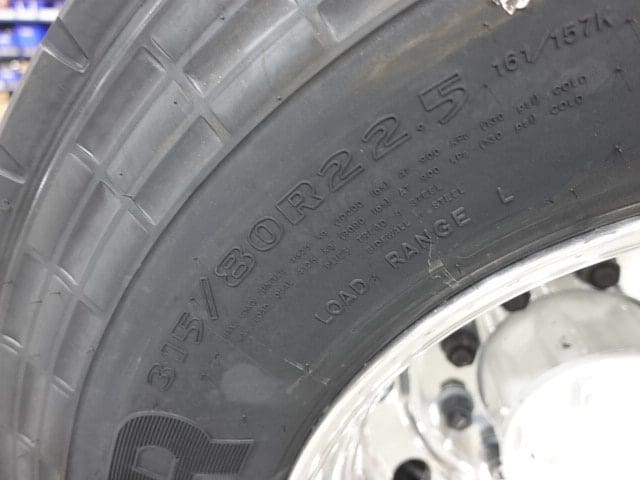

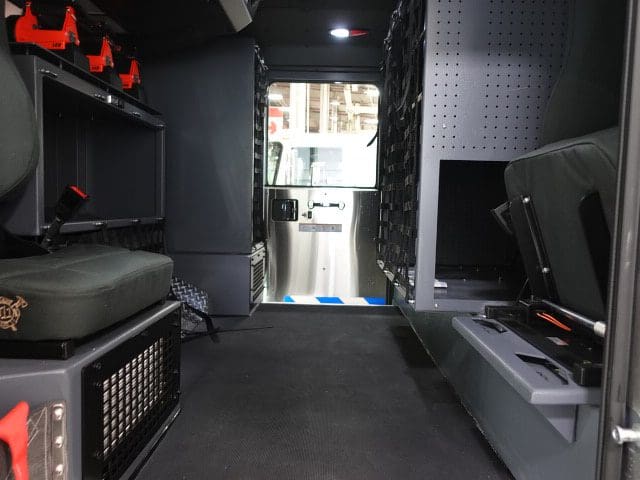

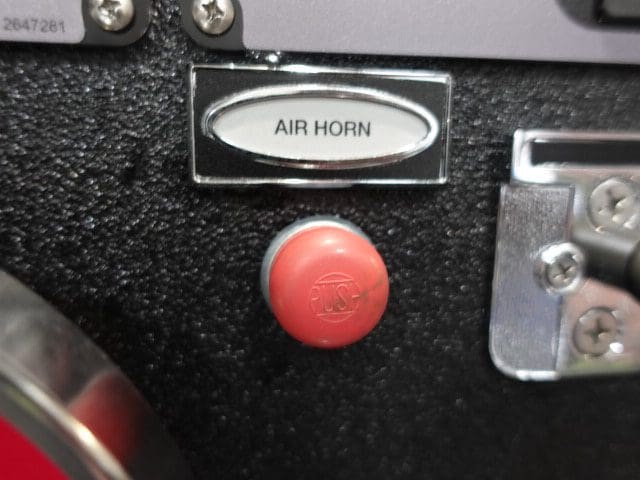

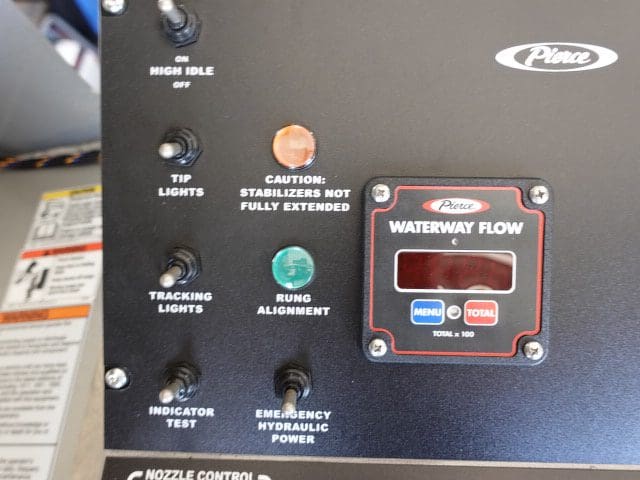

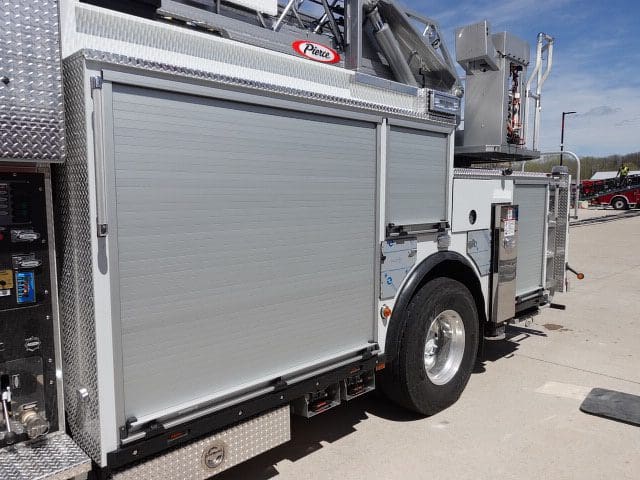

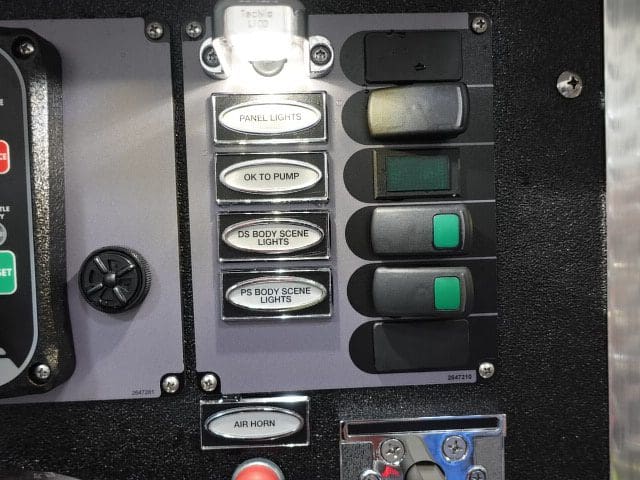

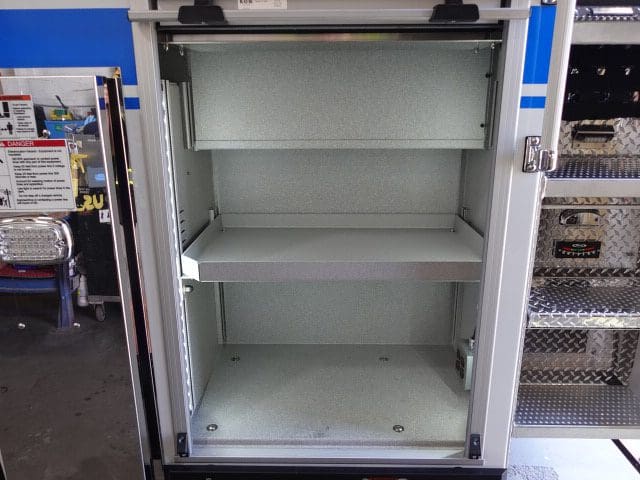

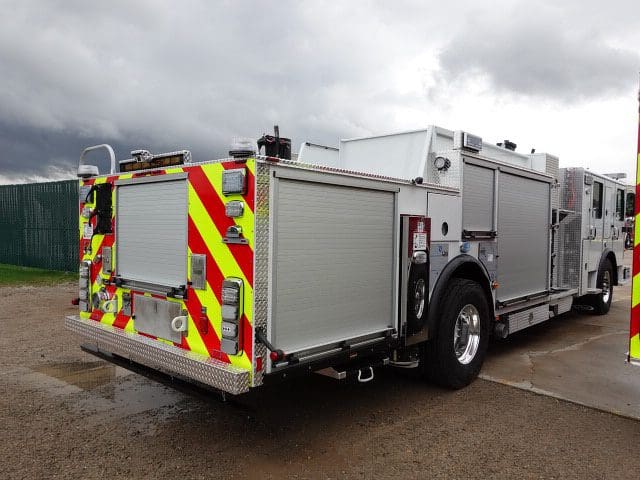

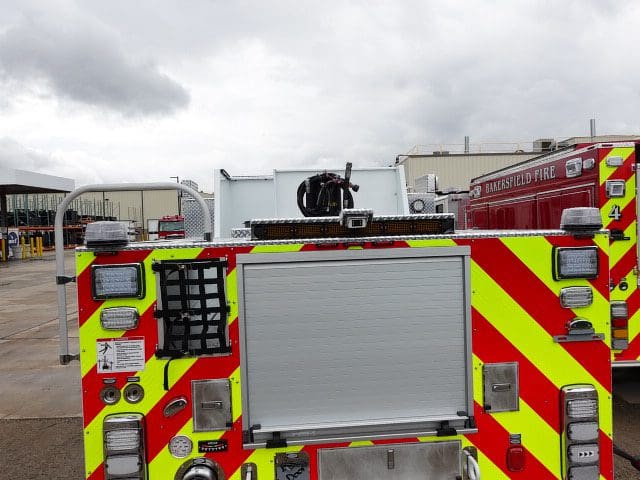

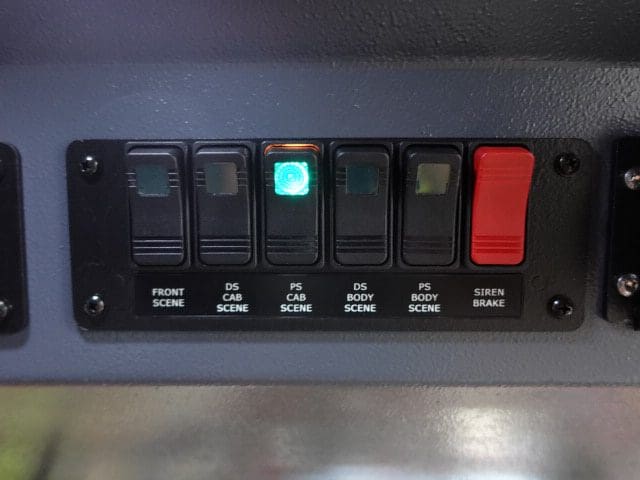

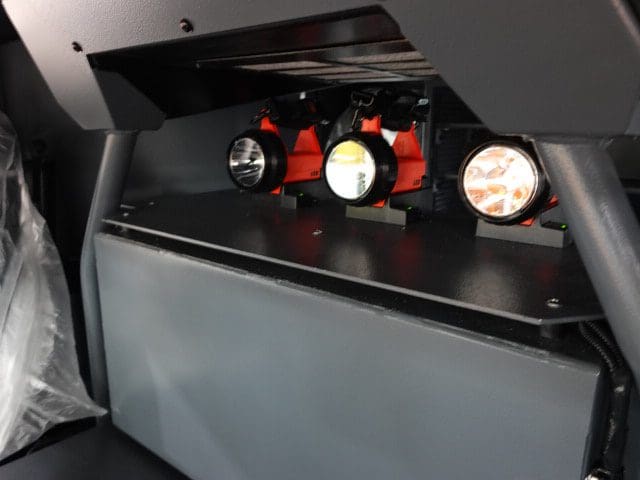

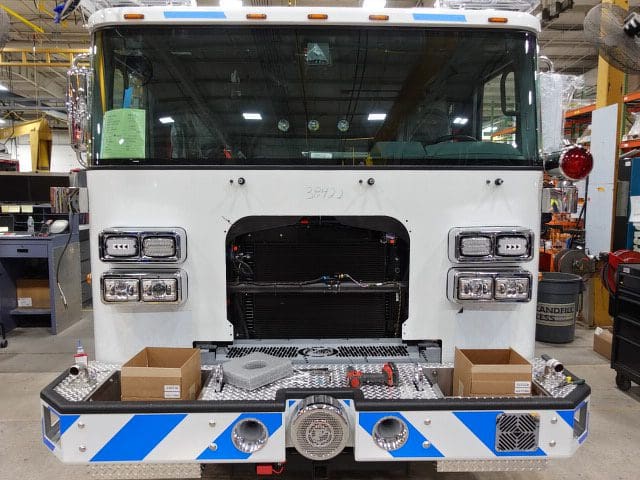

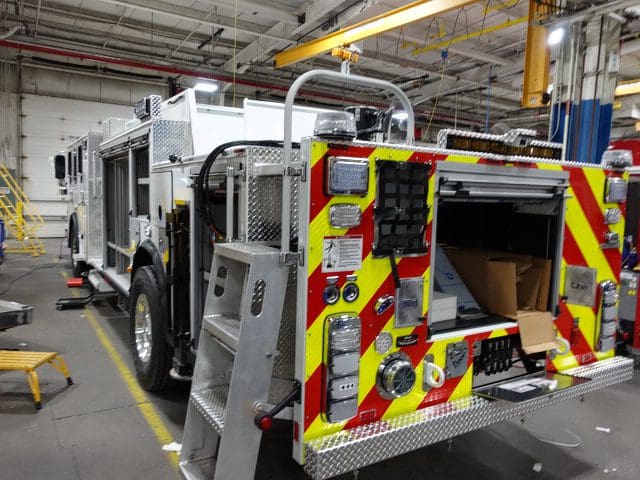

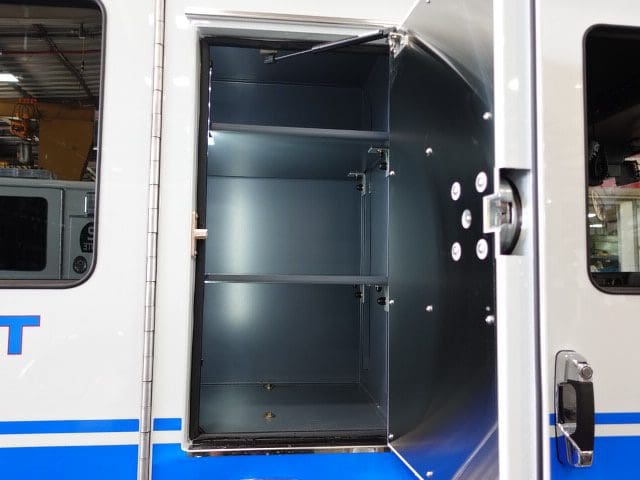

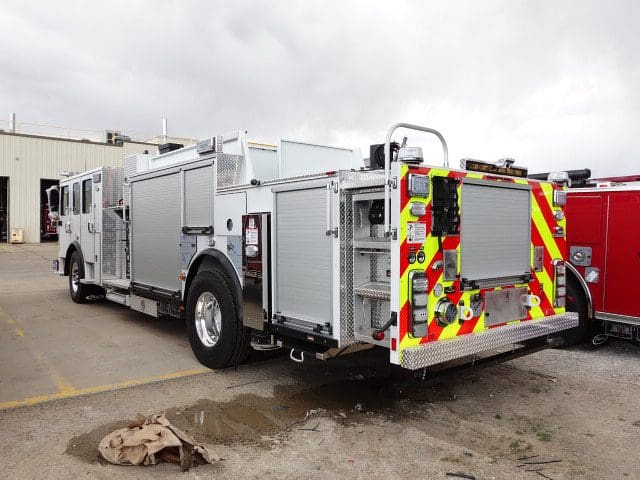

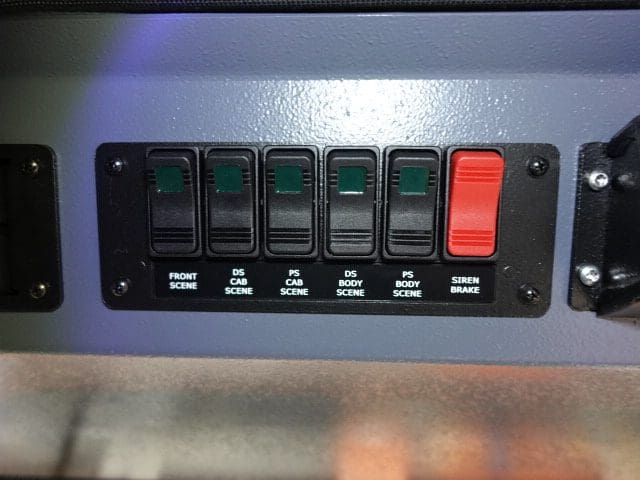

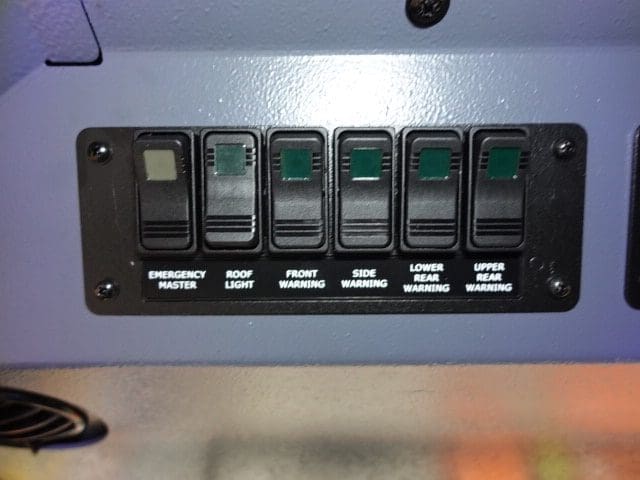

In this report, the apparatus completed testing and was released to quality and graphics where any remaining content will be applied. Once finished it will be made ready for the customer acceptance inspection. This is the last scheduled report.

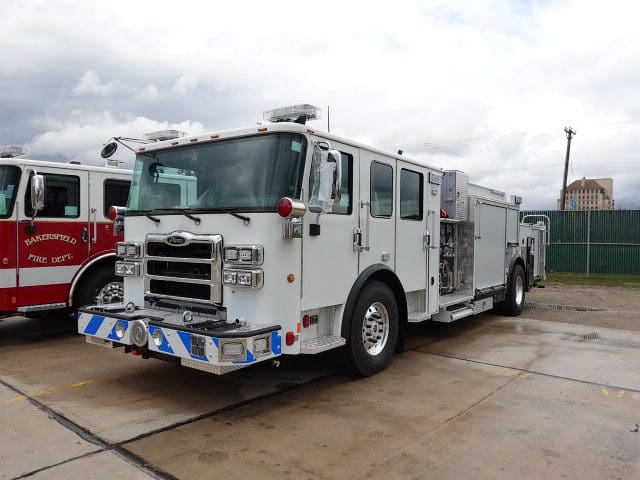

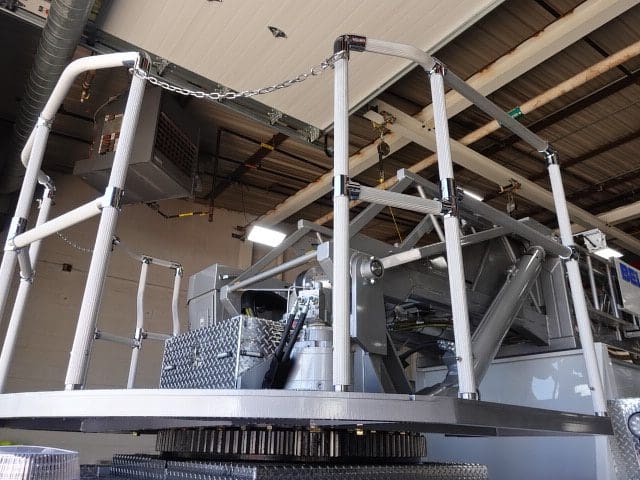

05-03-24

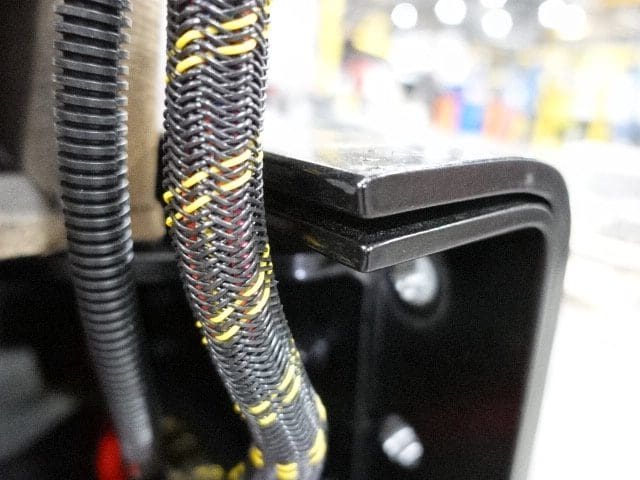

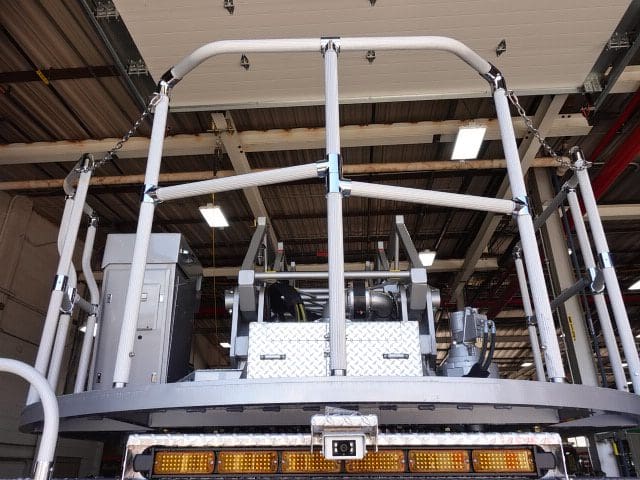

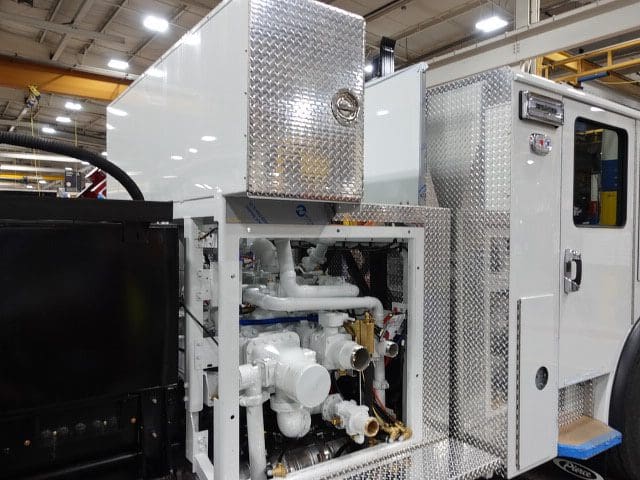

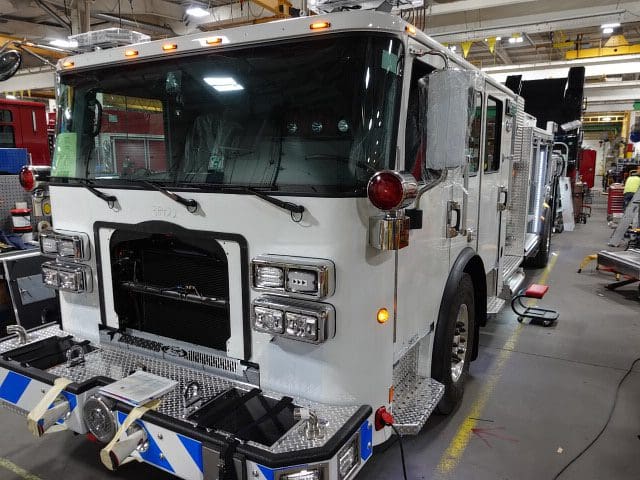

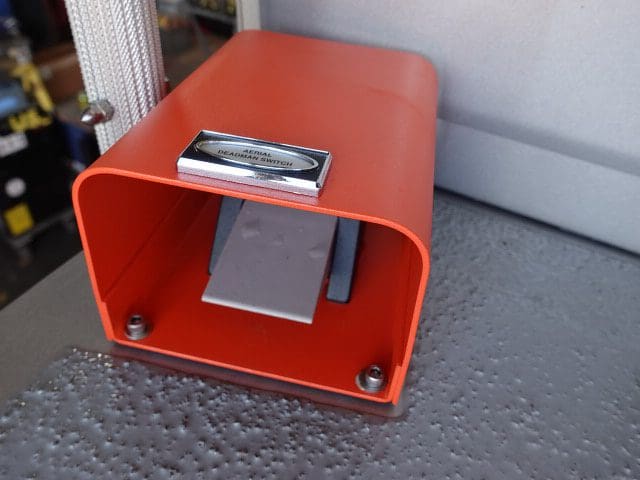

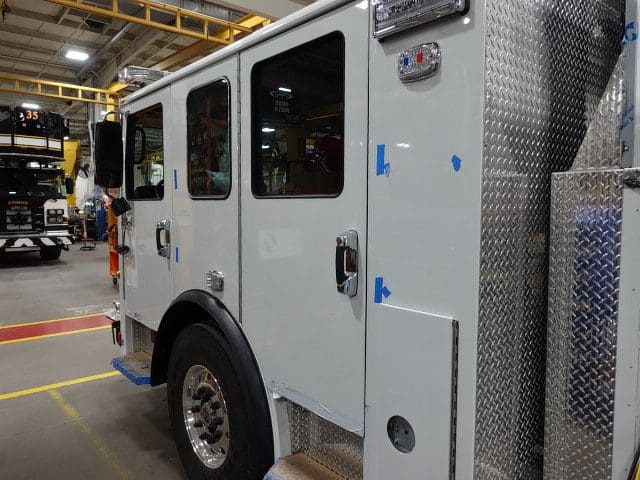

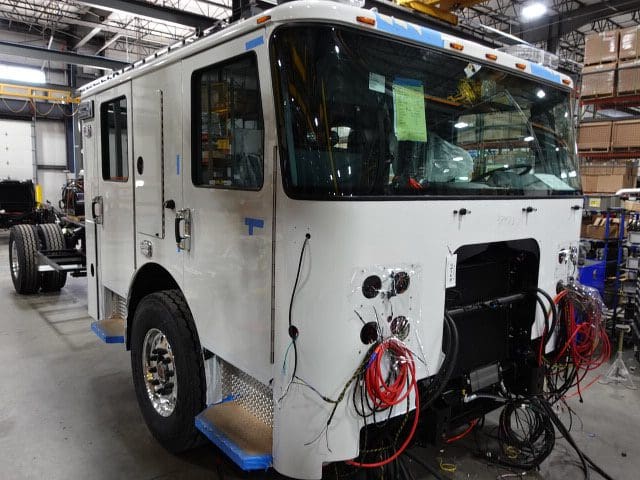

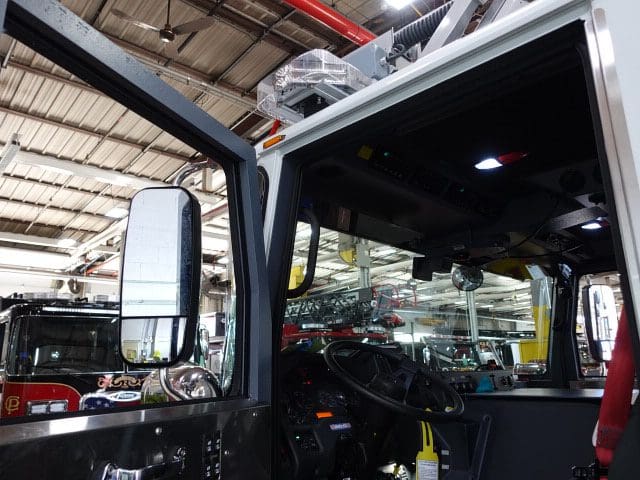

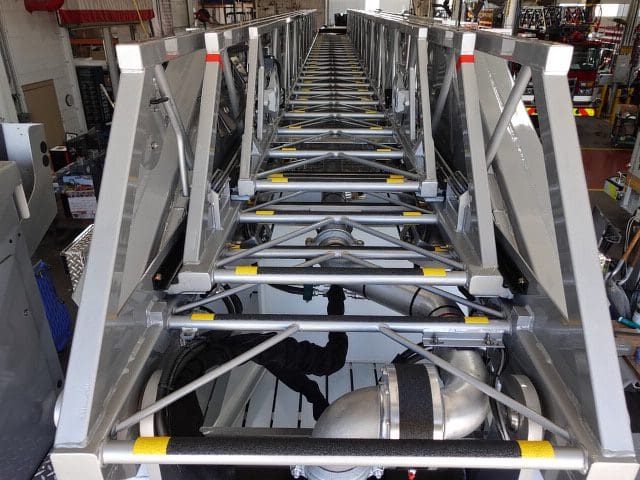

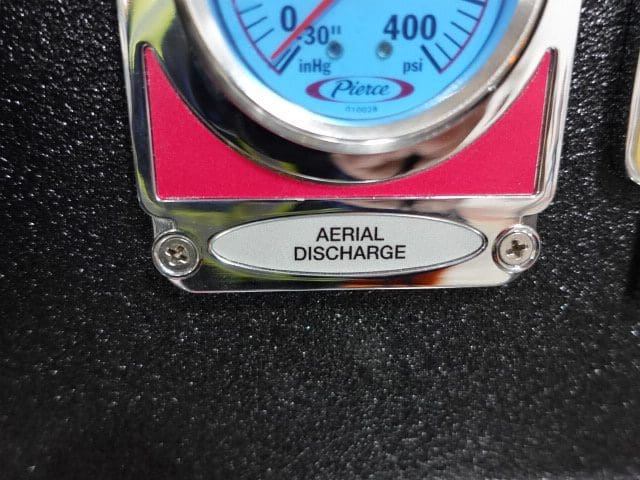

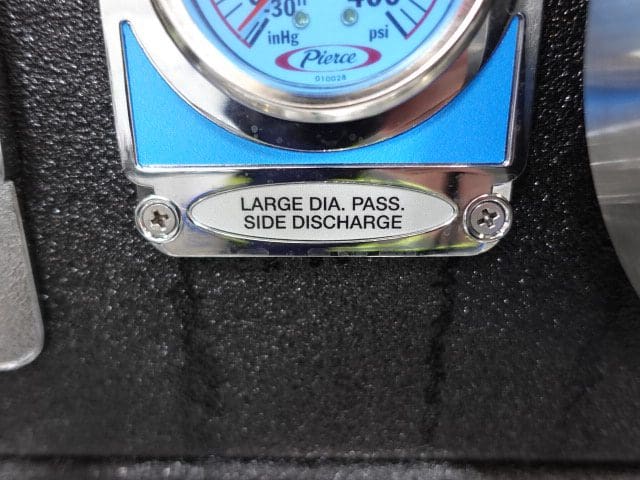

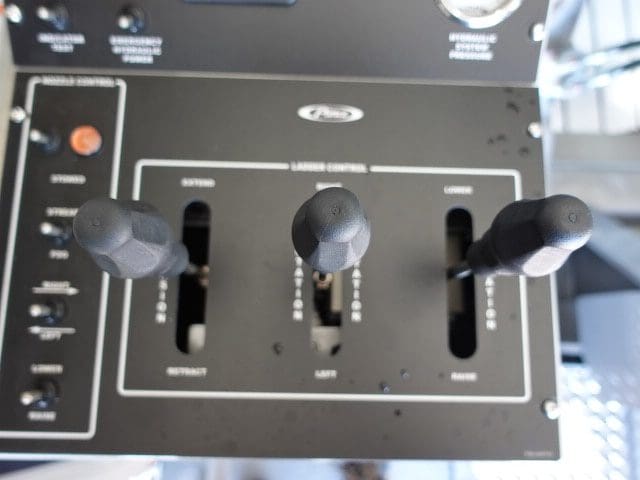

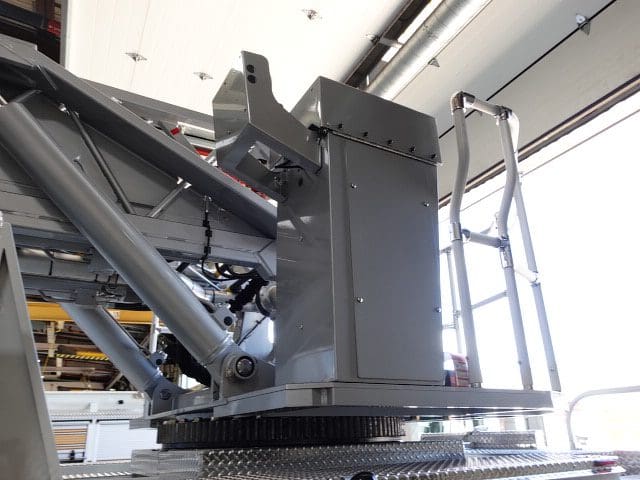

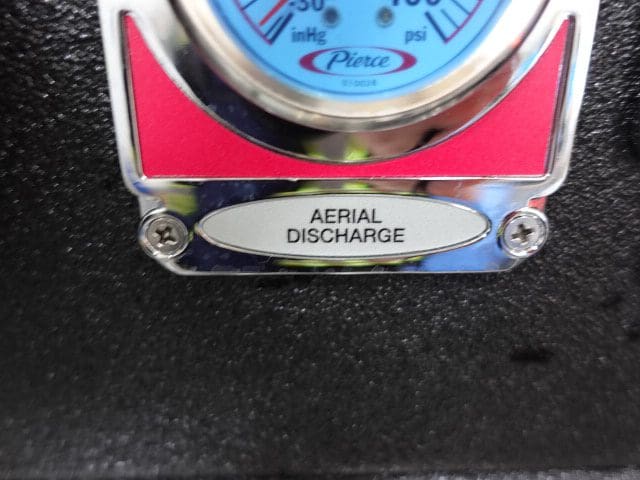

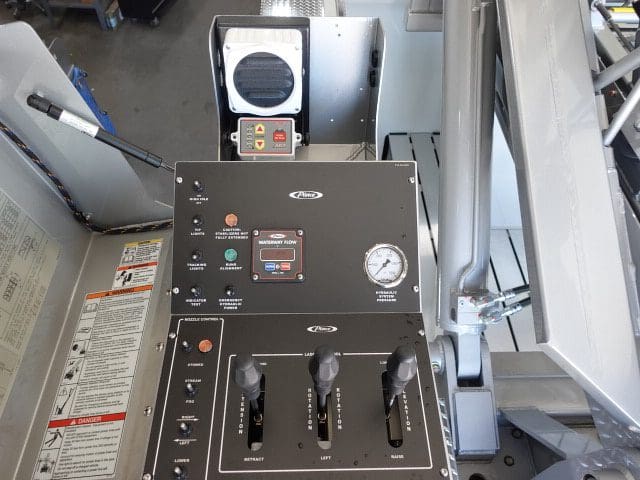

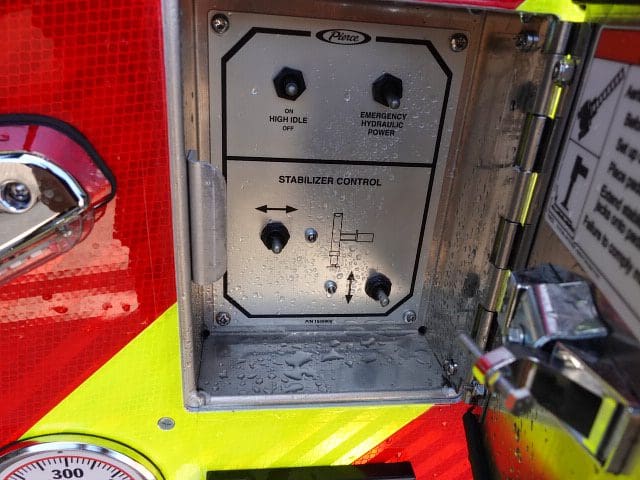

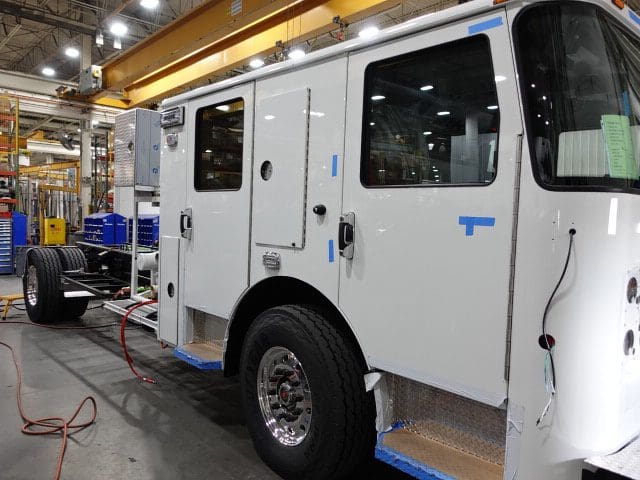

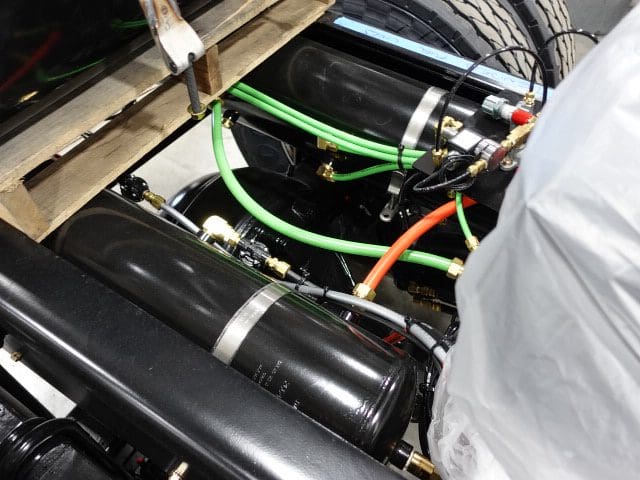

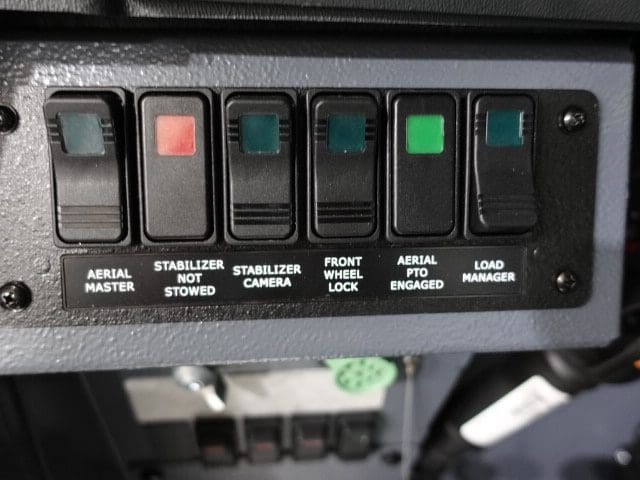

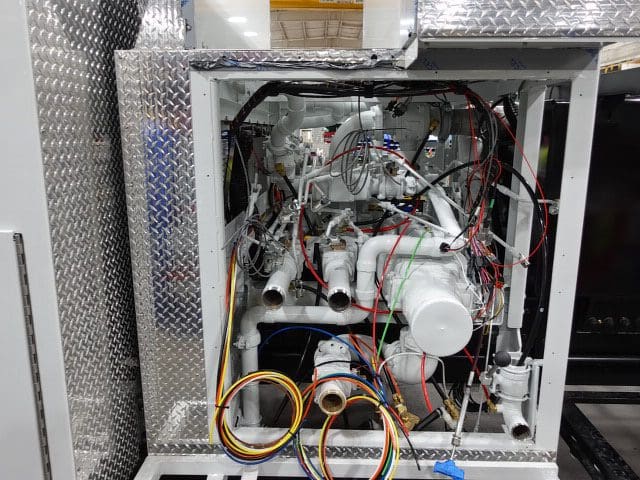

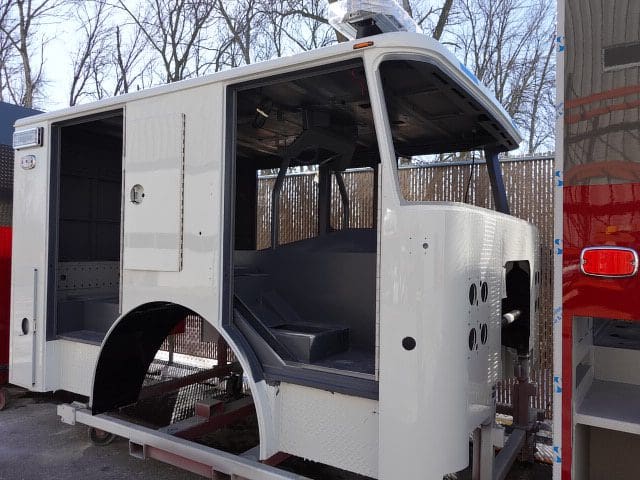

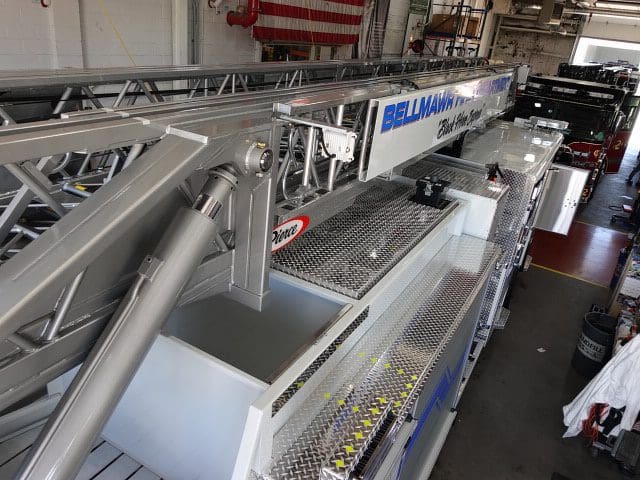

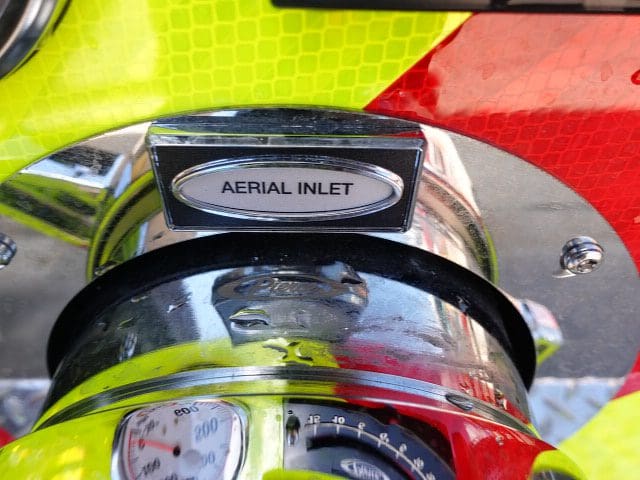

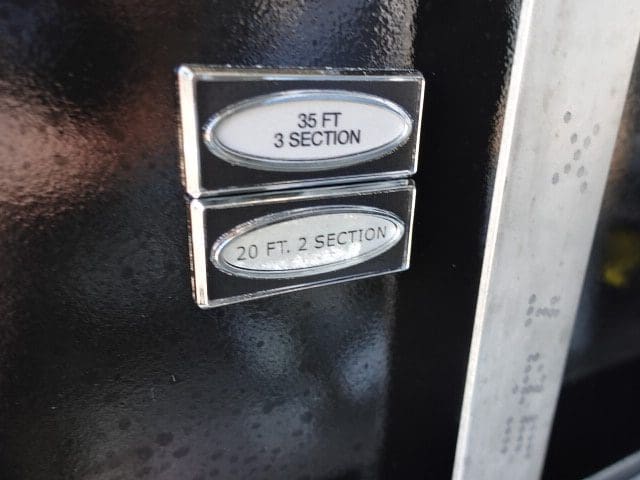

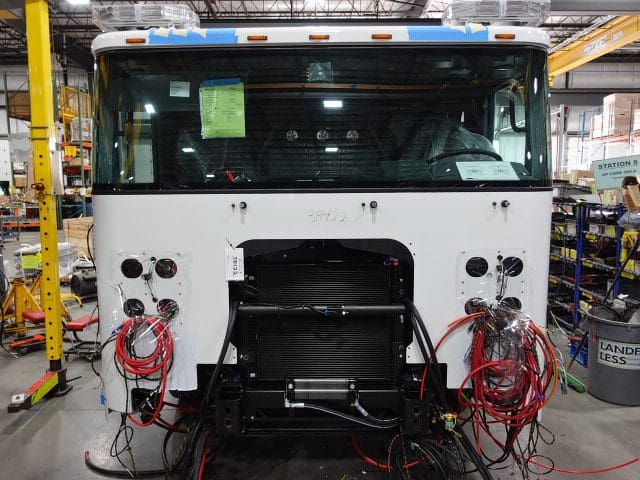

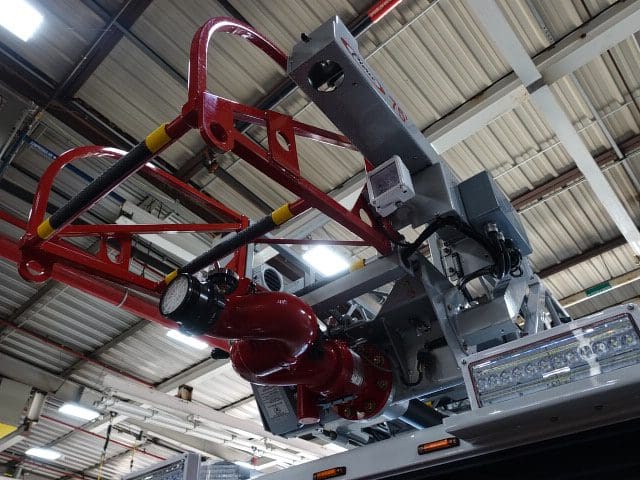

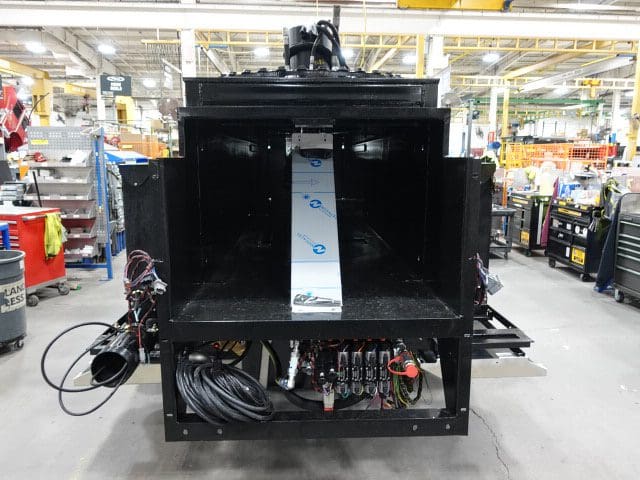

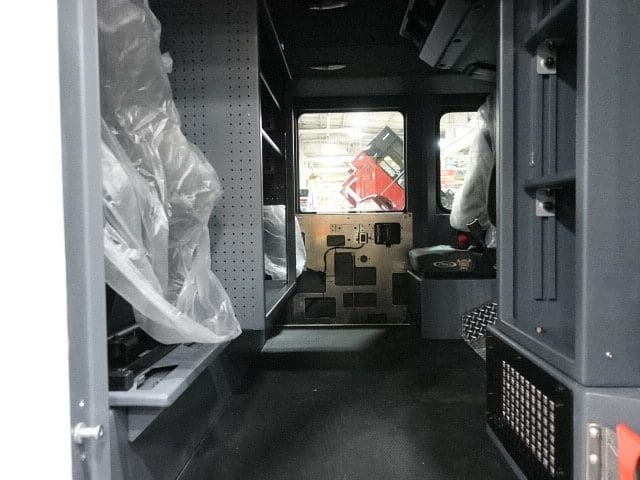

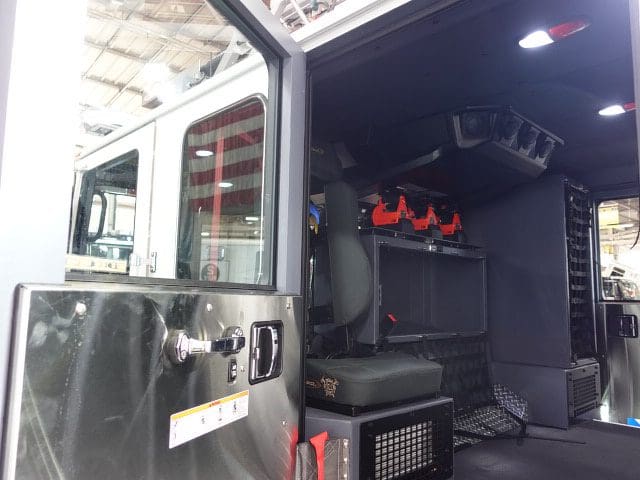

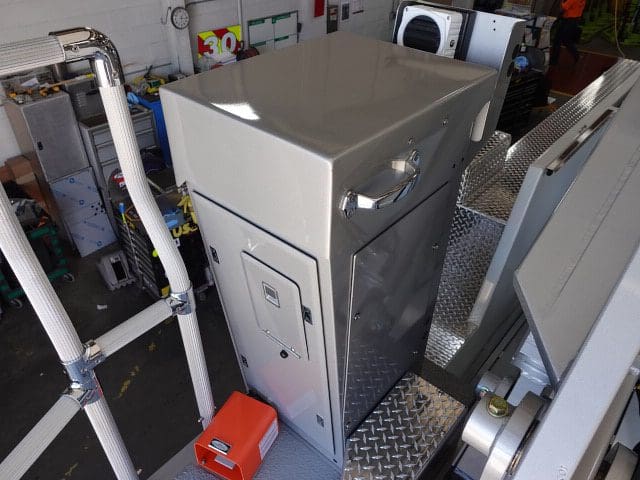

In this report, the aerial device arrived, completed initial assembly, and was pinned to the apparatus followed by the start of aerial testing.
04-05-24

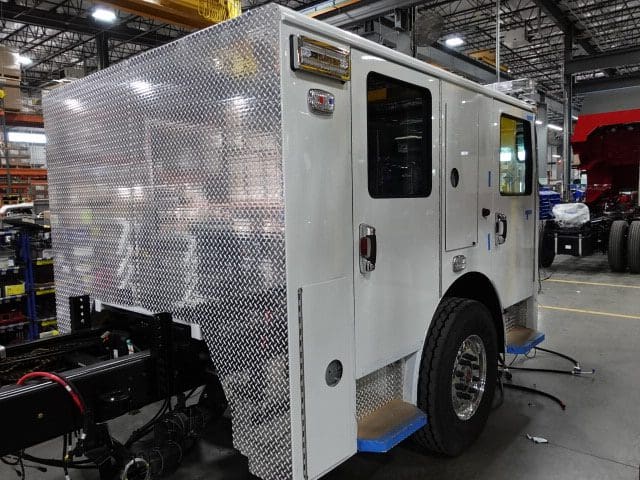

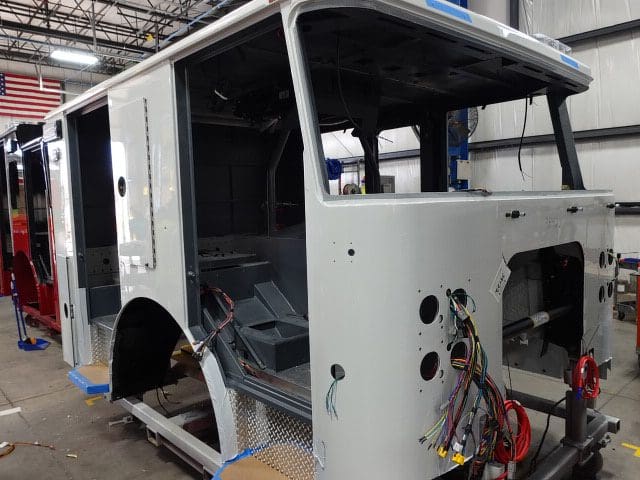

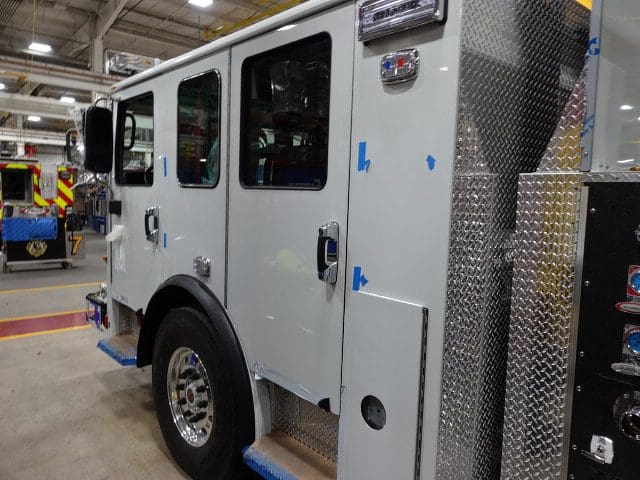

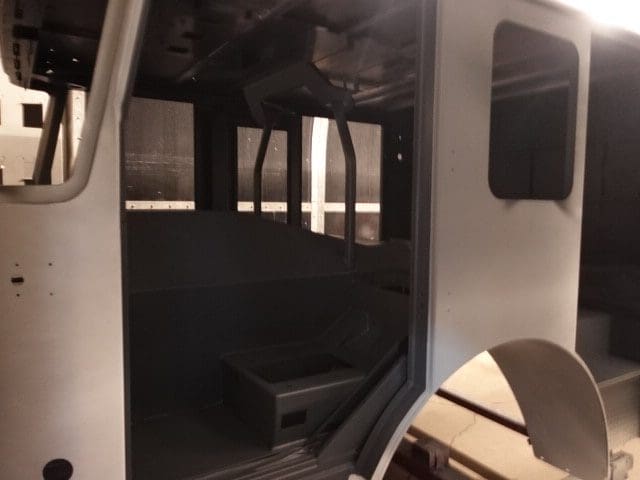

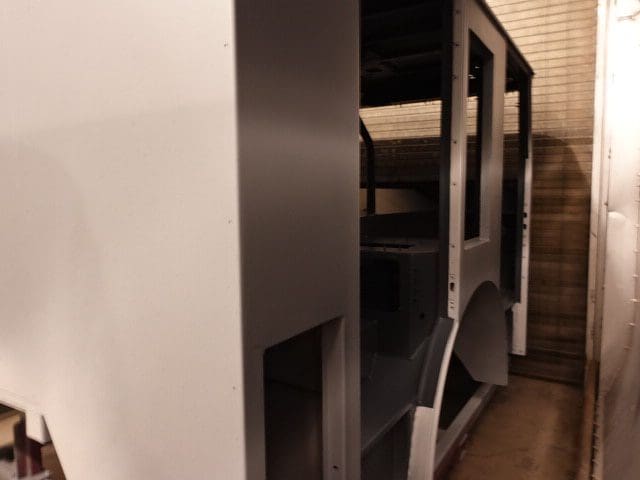

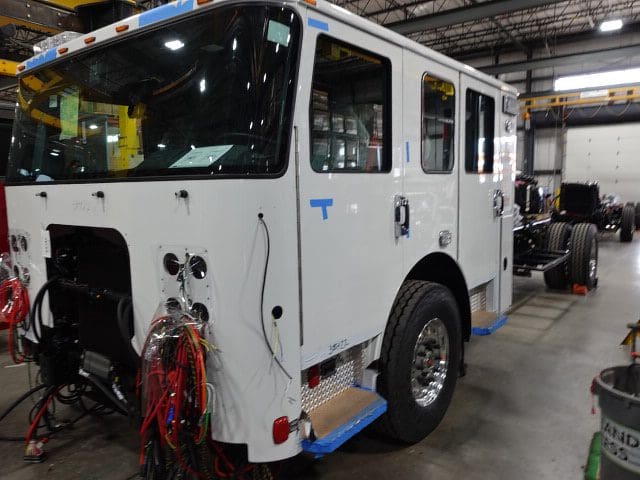

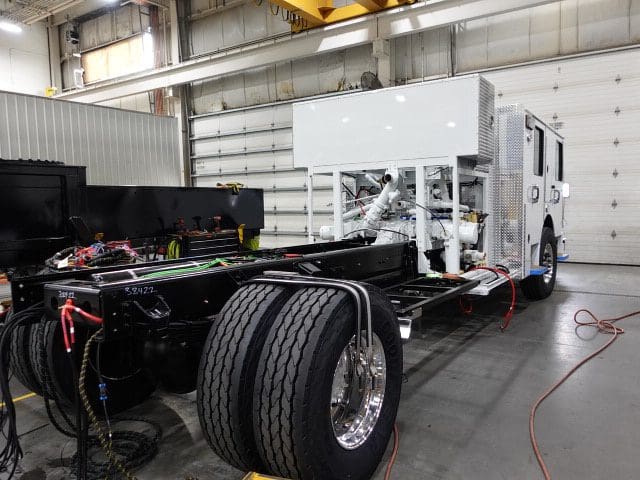

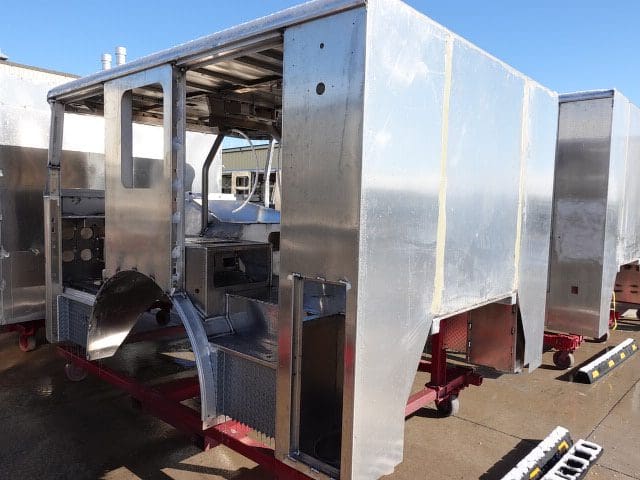

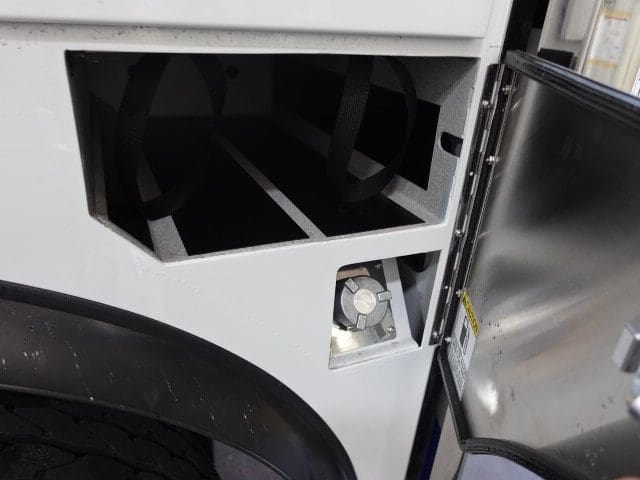

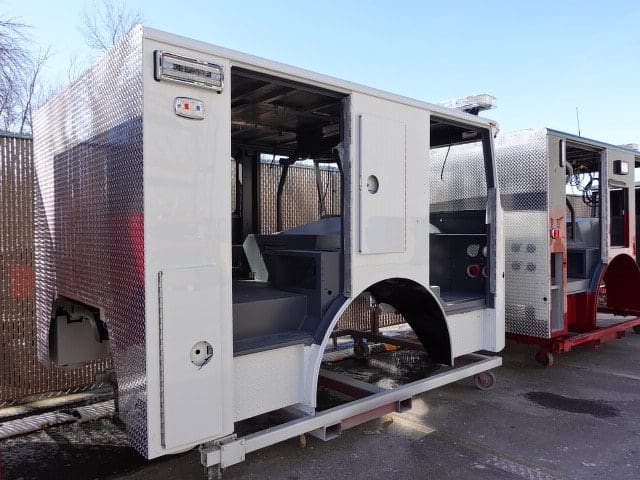

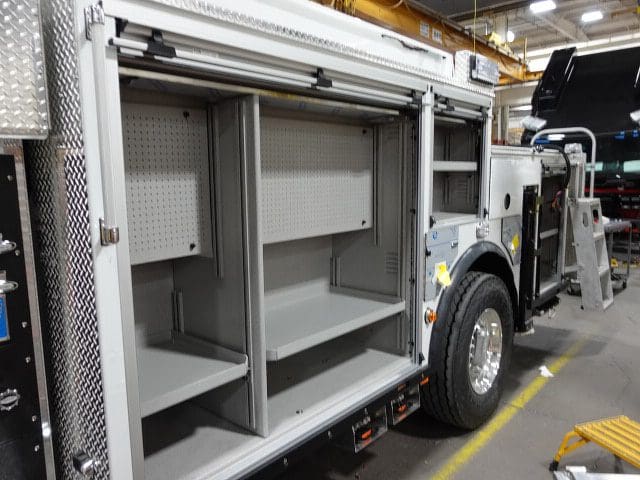

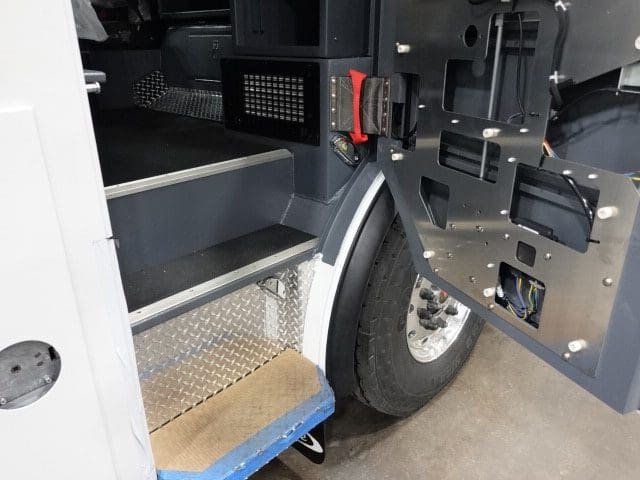

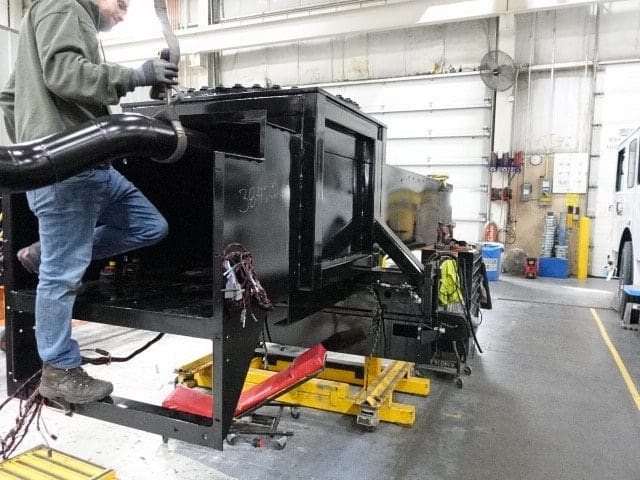

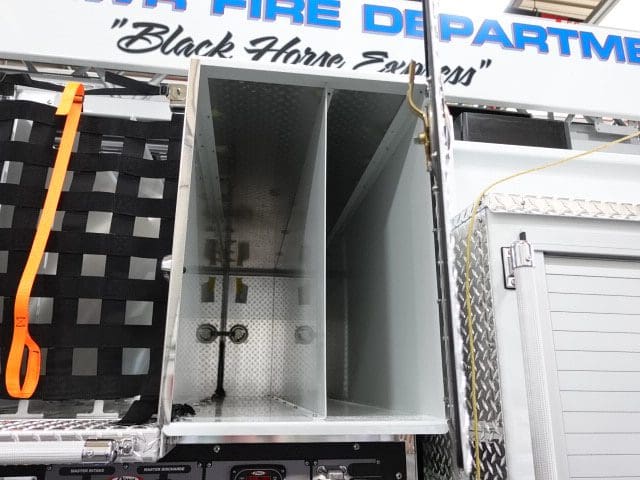

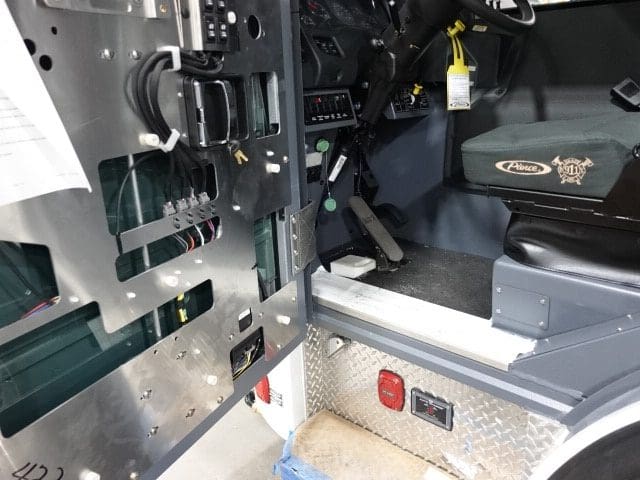

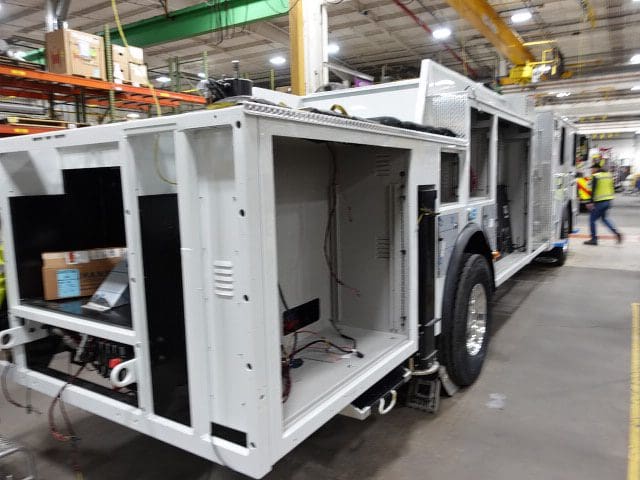

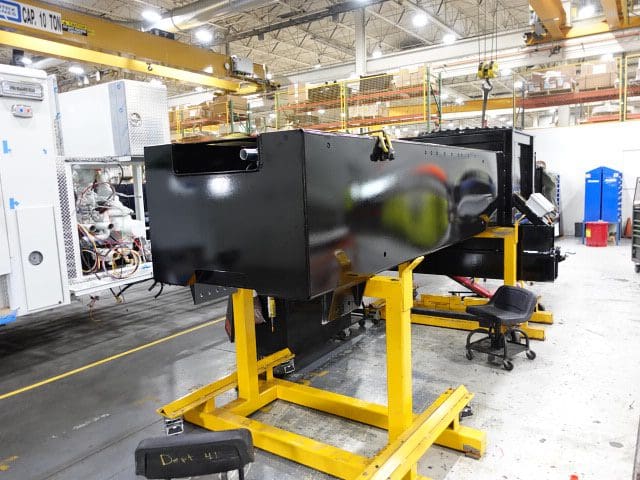

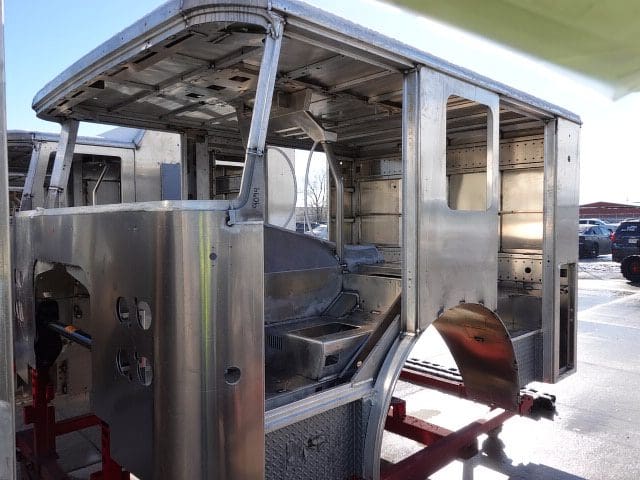

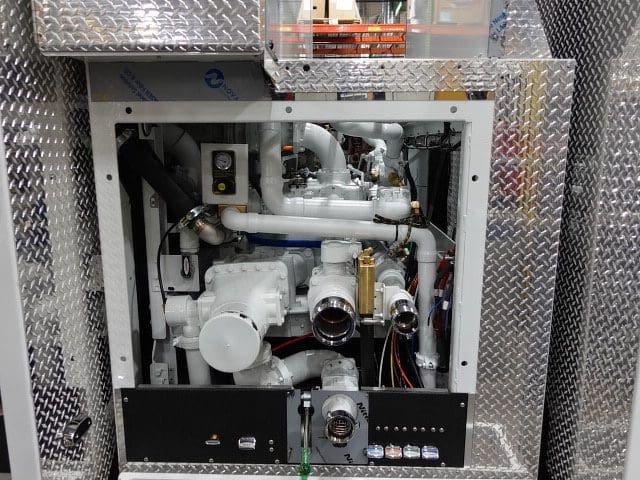

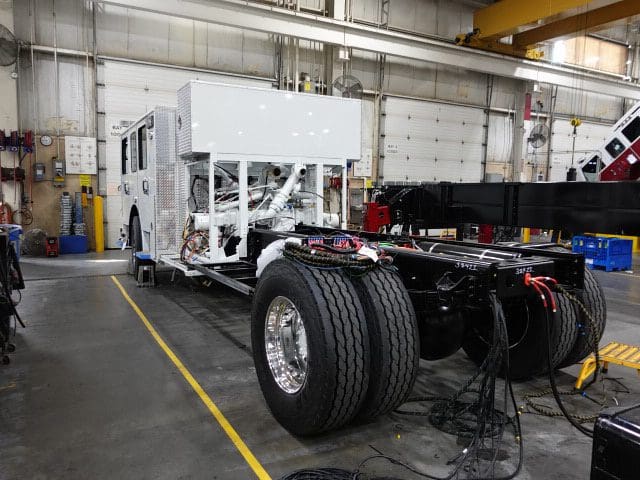

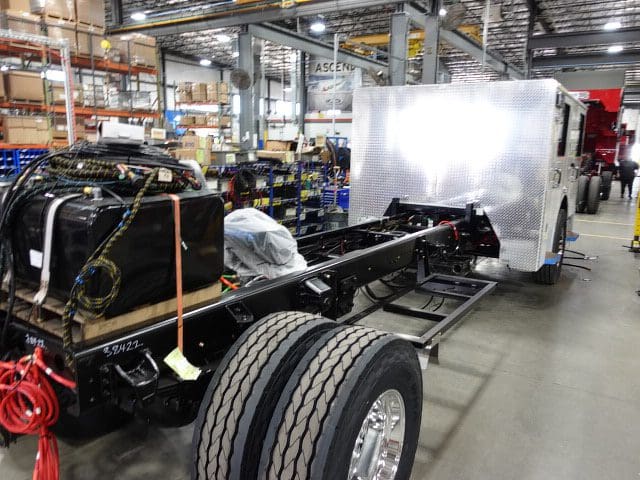

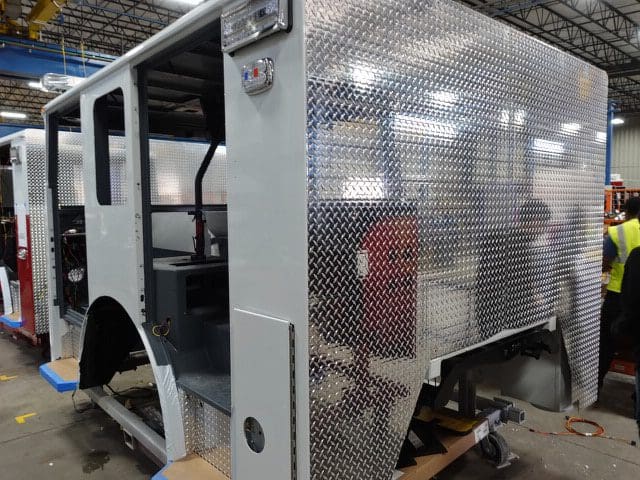

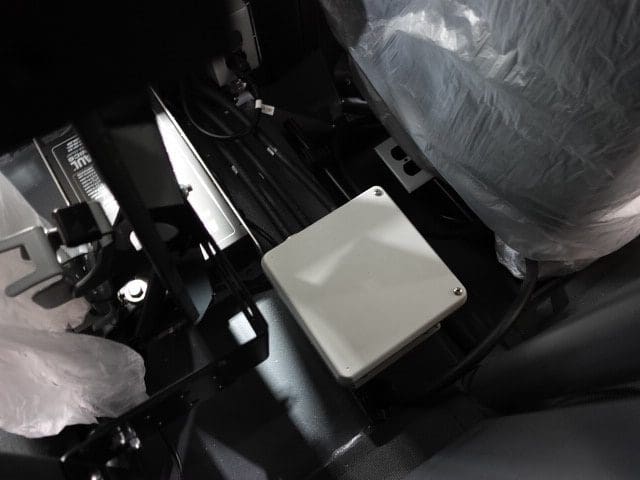

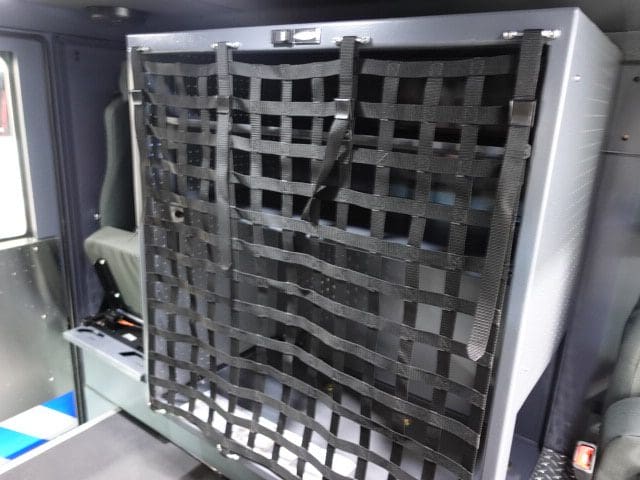

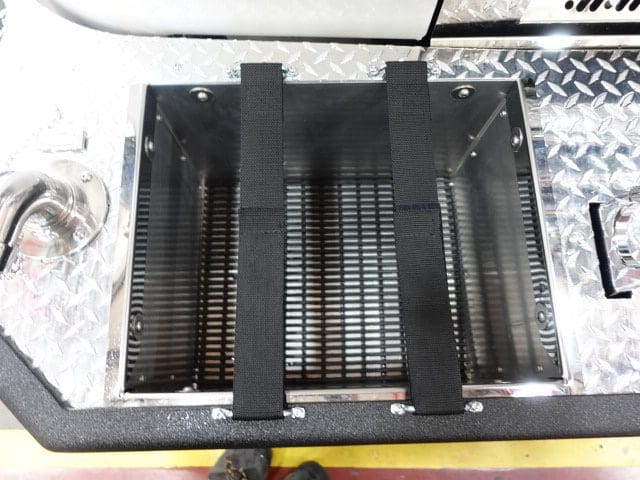

In this report, the body completed initial assembly and was merged with the chassis followed by the start of final assembly.

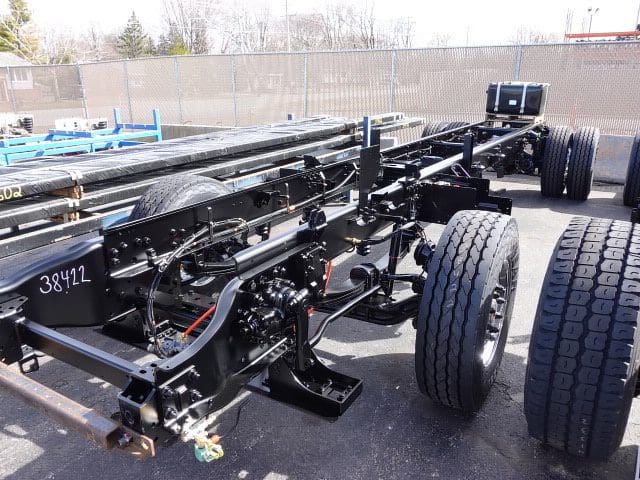

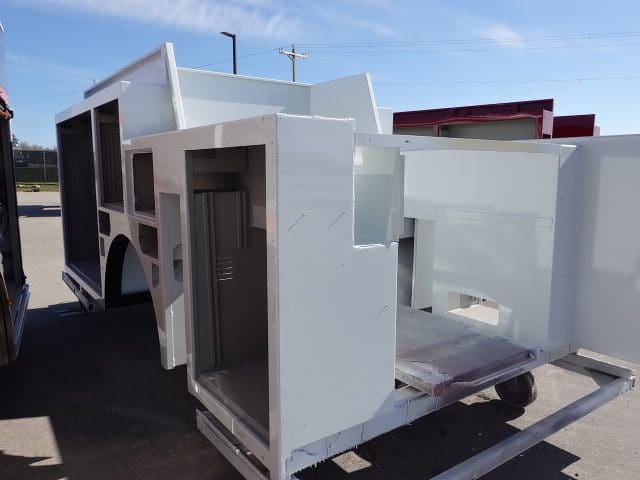

03-29-24

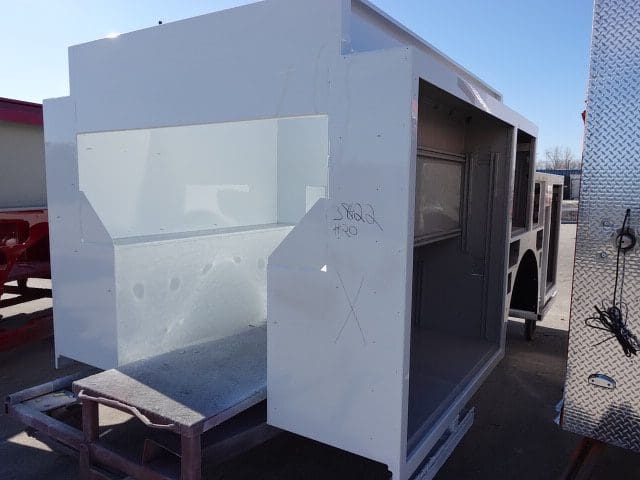

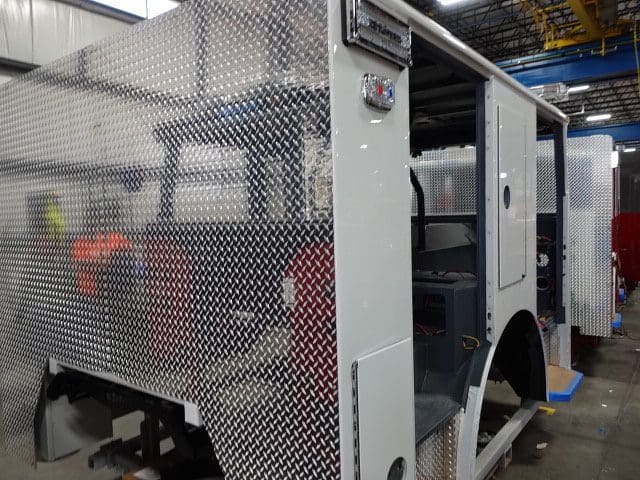

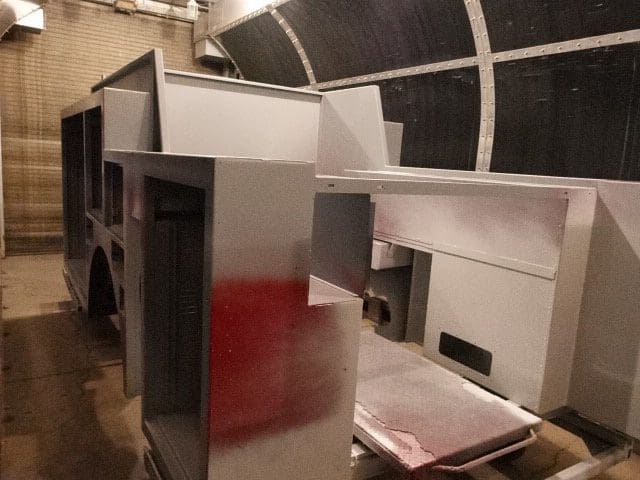

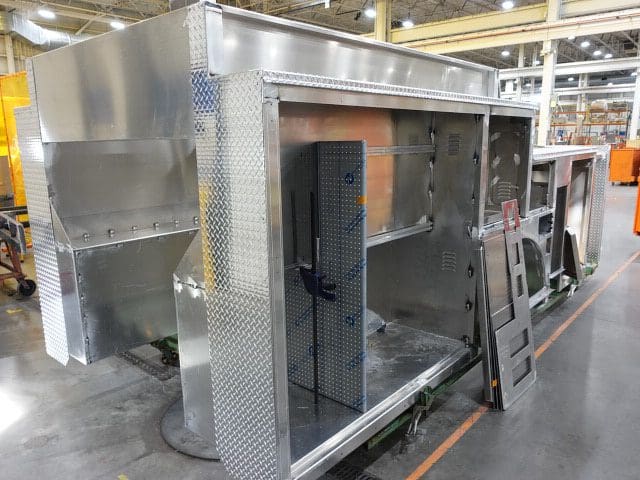

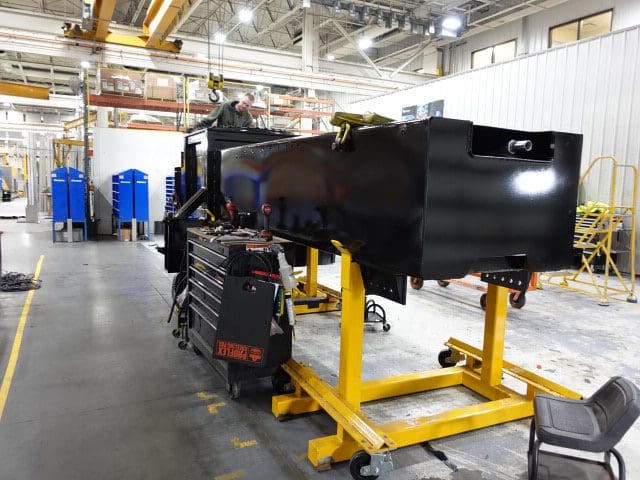

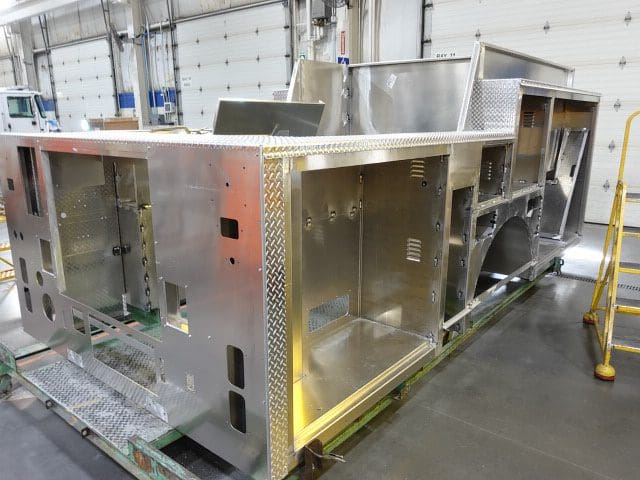

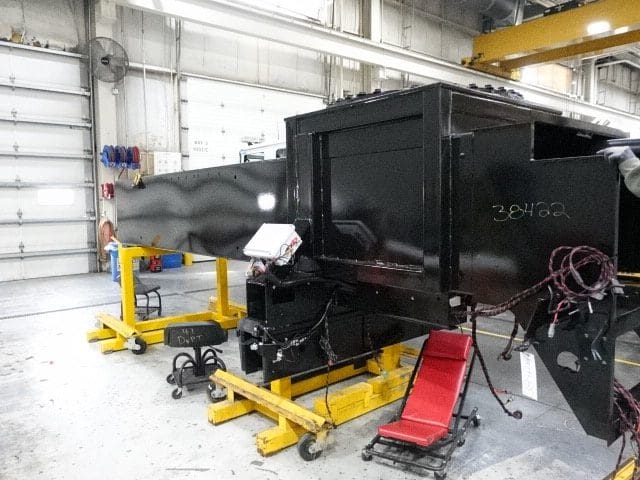

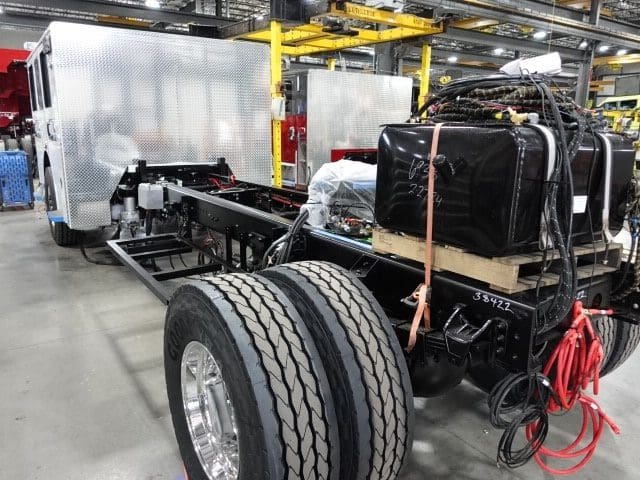

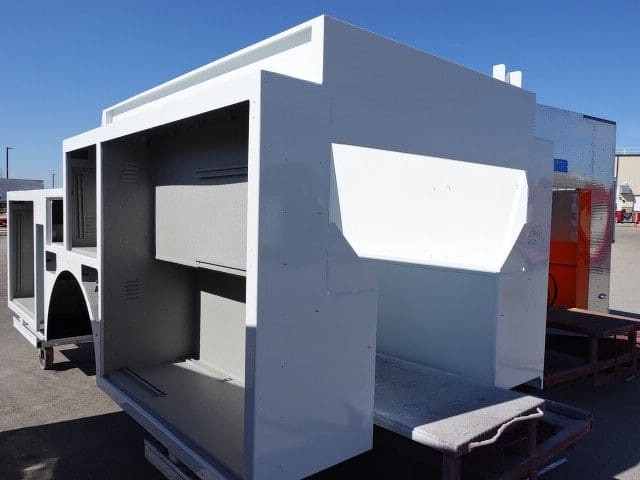

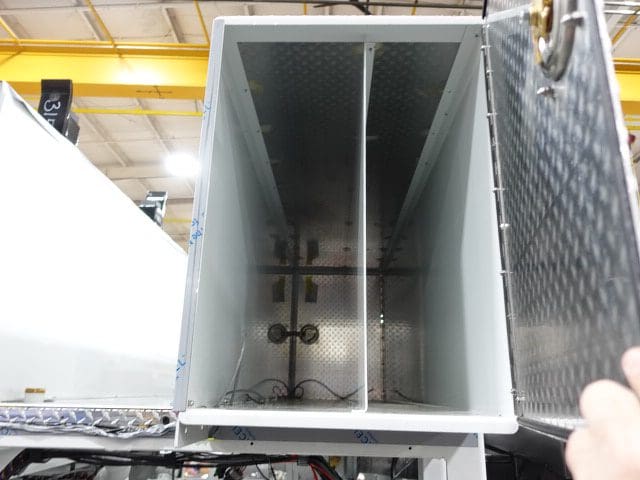

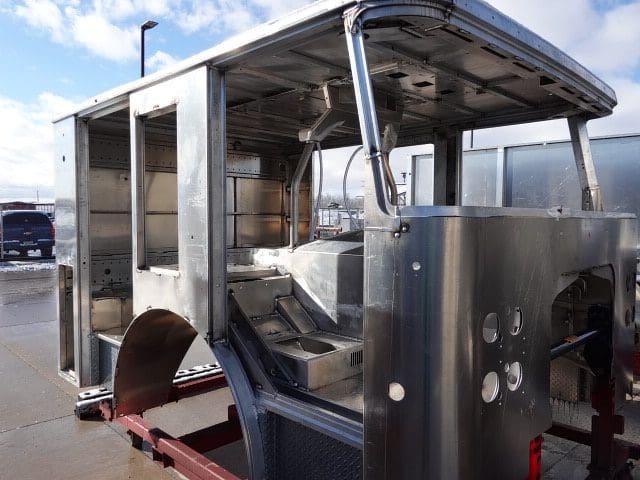

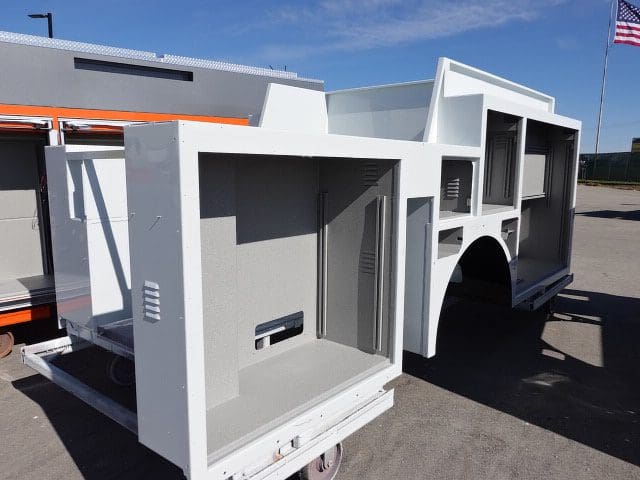

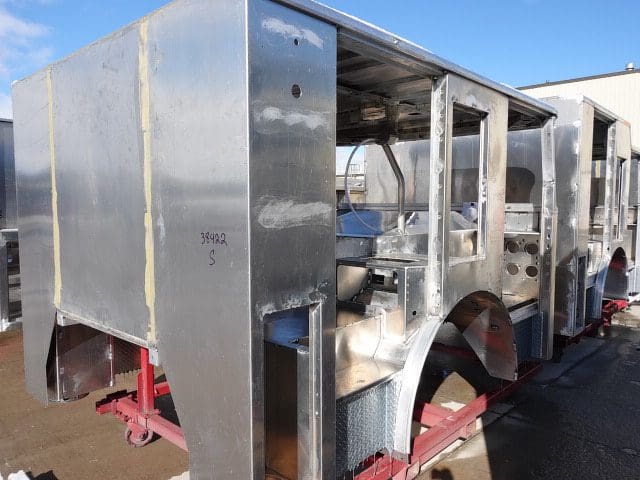

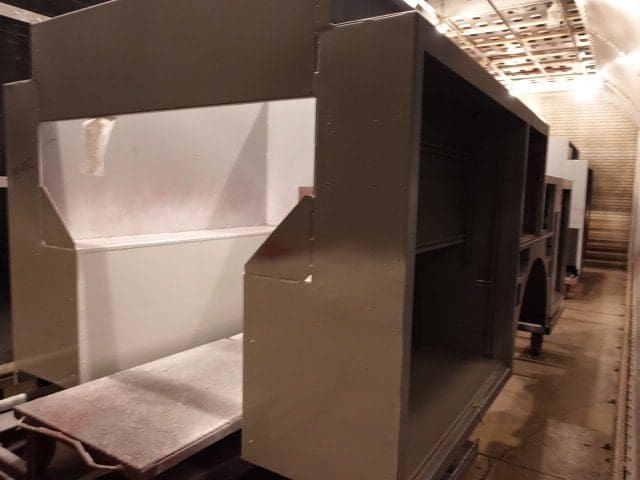

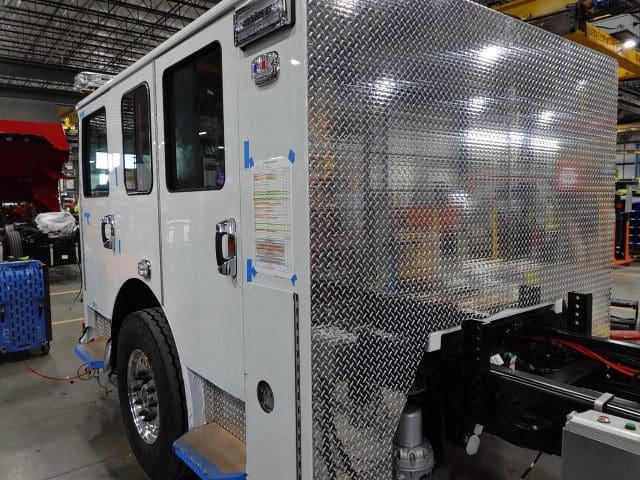

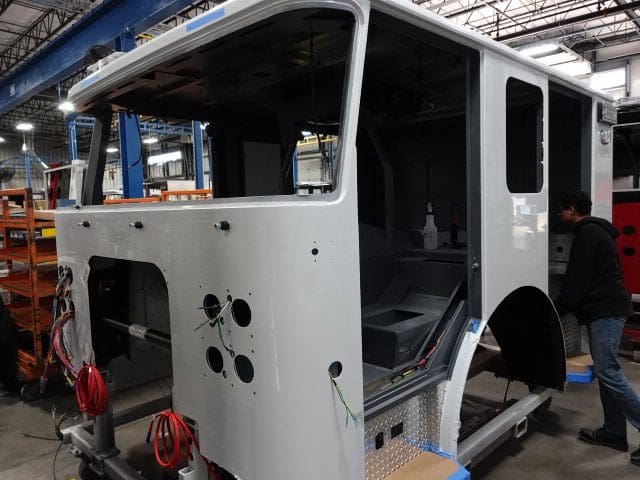

In this report, the torque box was installed on the chassis while assembly continued, and the body completed paint and was staged.
03-22-24

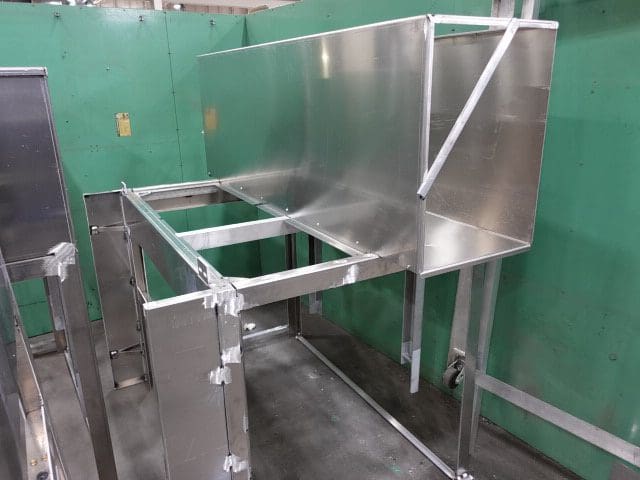

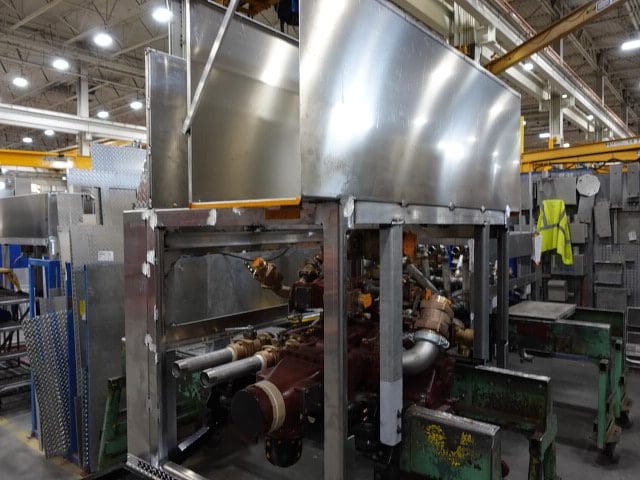

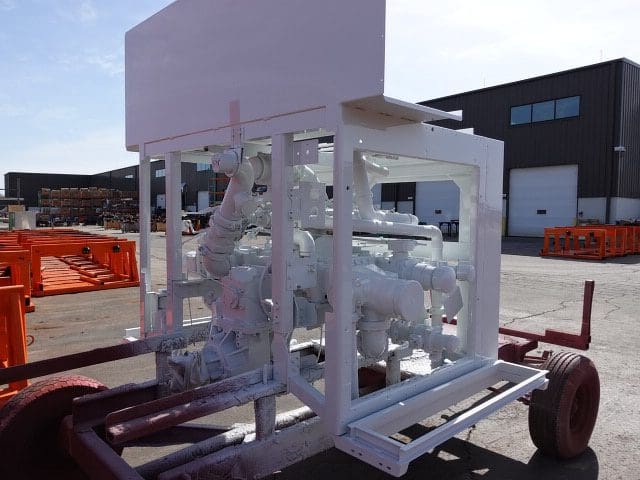

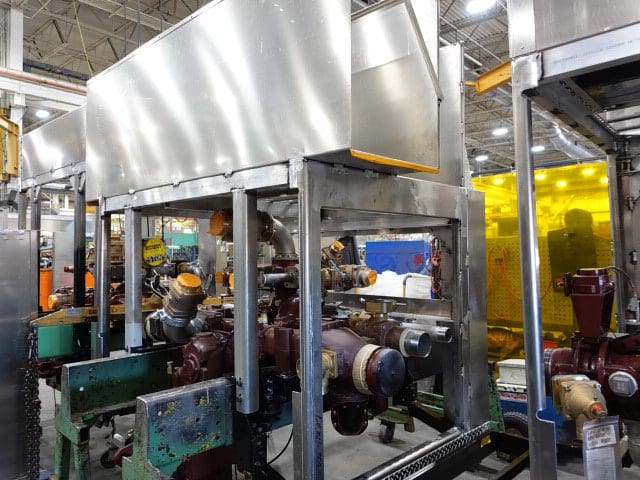

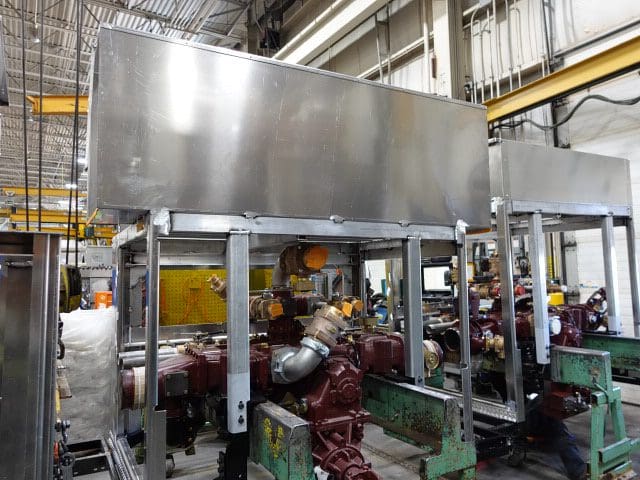

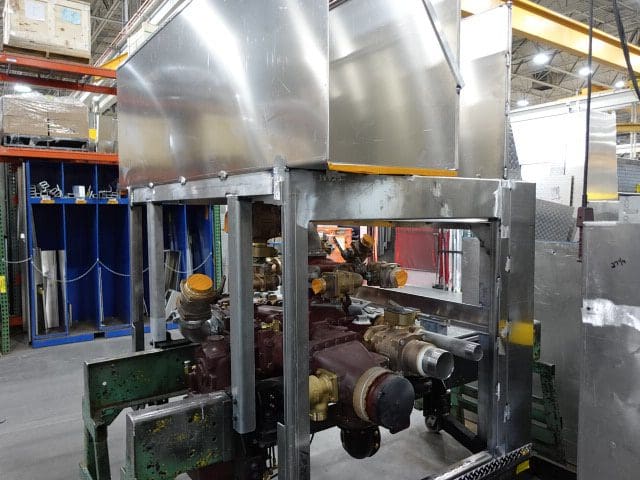

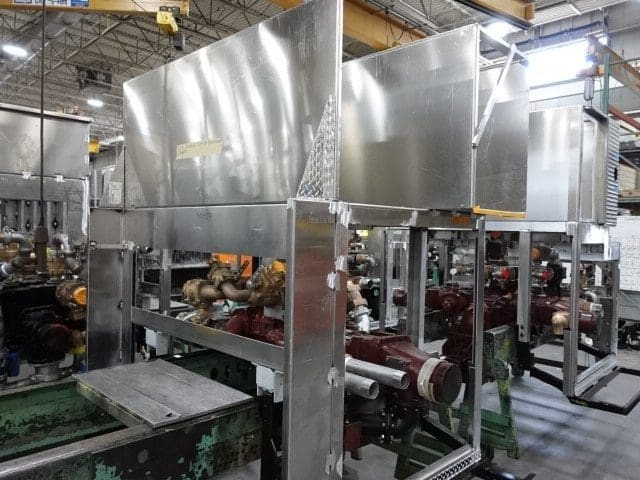

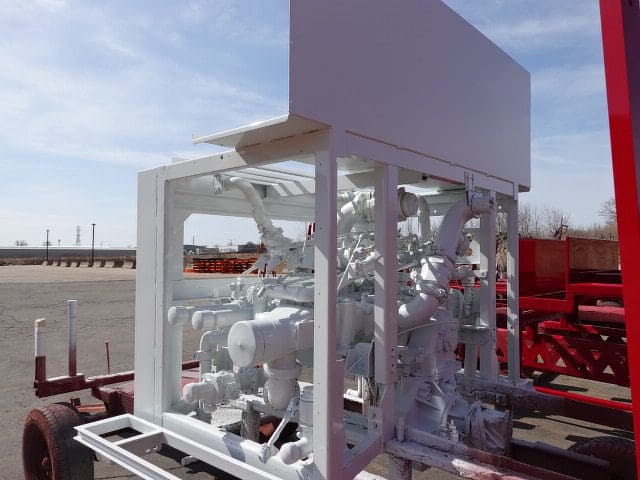

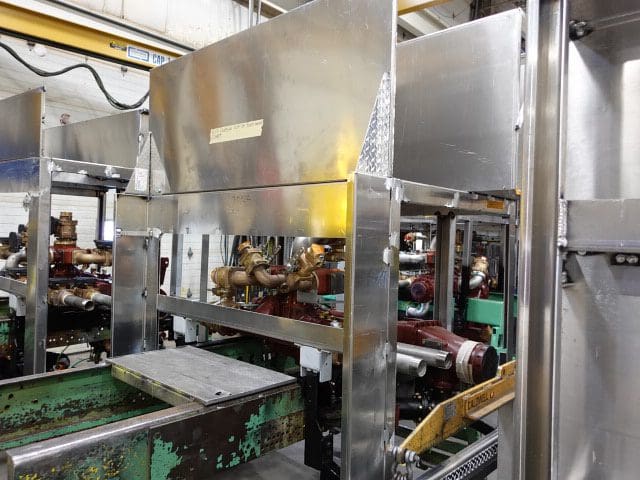

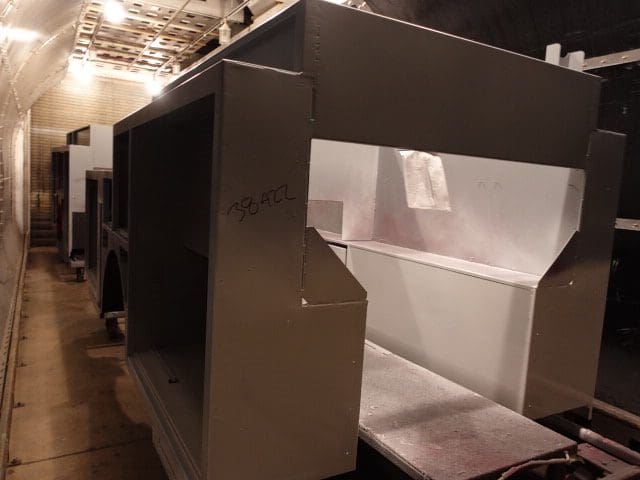

In this report, the pump house completed initial assembly and was merged with the chassis, the torque box arrived and began initial assembly, and the body began the paint process.
03-15-24

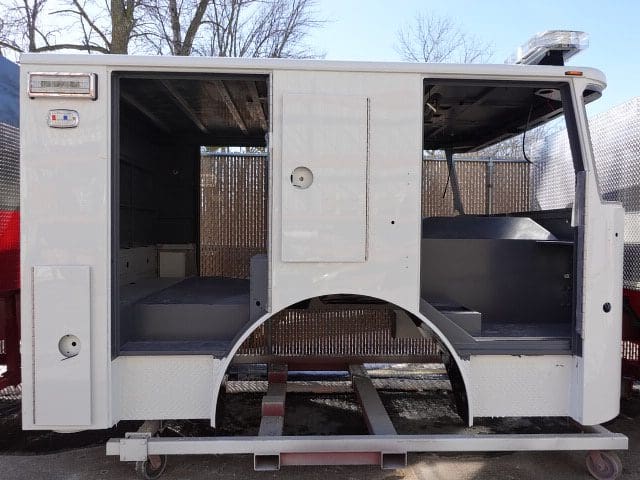

In this report, the cab was installed on the frame, the pump house was painted, and the body completed fabrication and was staged (no photos).
03-08-24

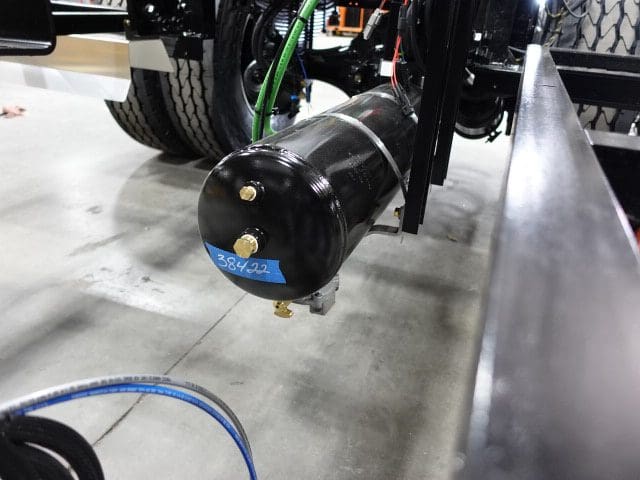

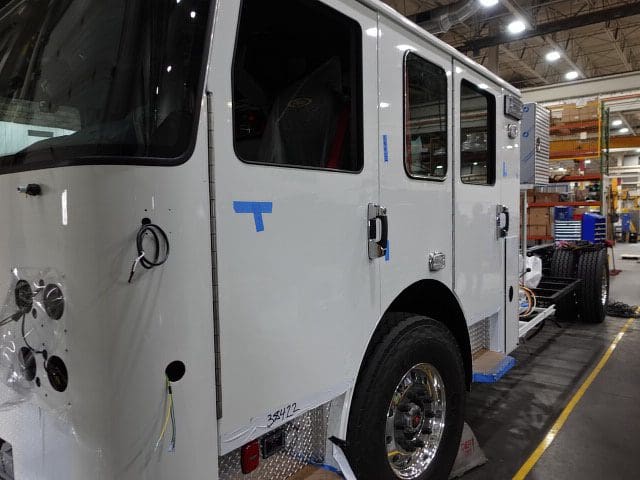

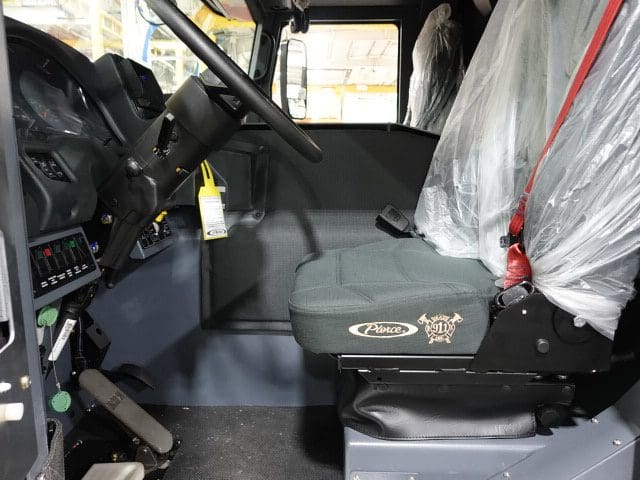

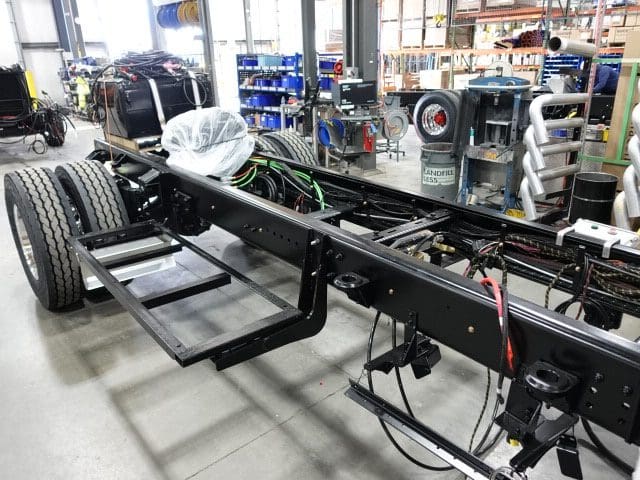

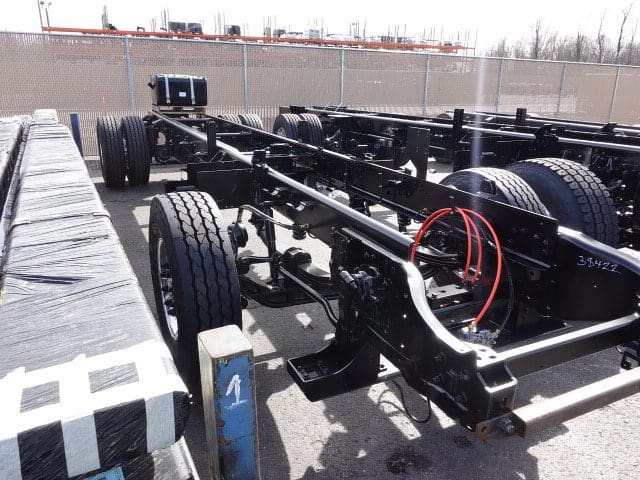

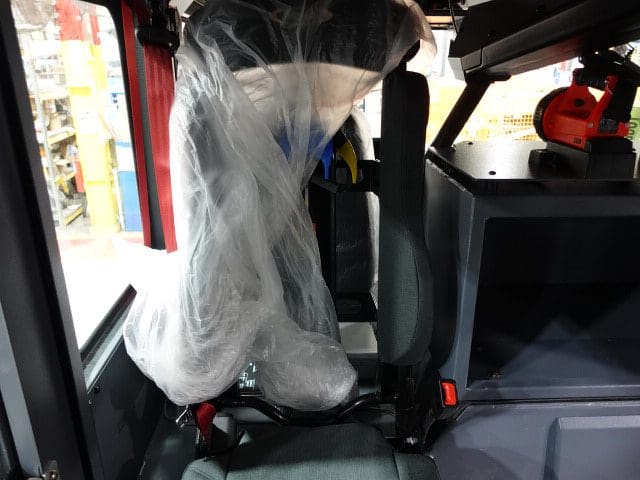

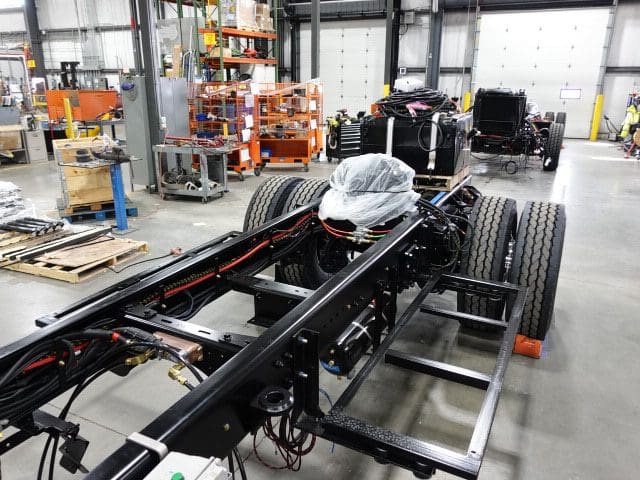

In this report, the cab continued initial assembly, the frame build began, the pump house continued initial assembly, and the body began fabrication.
03-01-24

In this report, the cab completed paint and began initial assembly while the pump house began initial assembly.
02-23-24
In this report, the cab began the paint process while the pump house structure was fabricated and staged.
02-16-24
This new Pierce apparatus is now in production! In this report, the cab was fabricated and staged.
