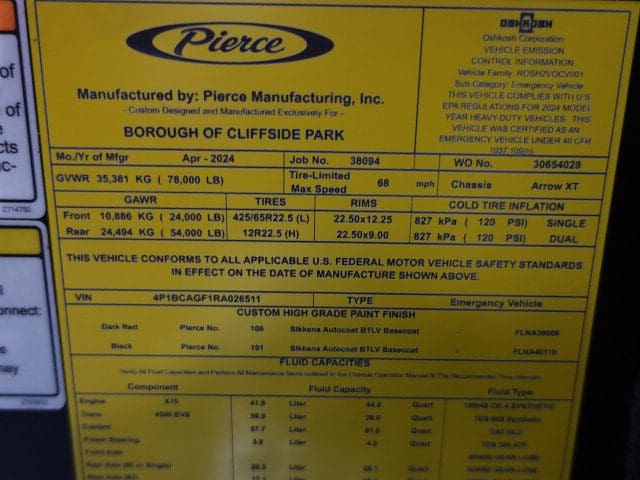

05-10-24

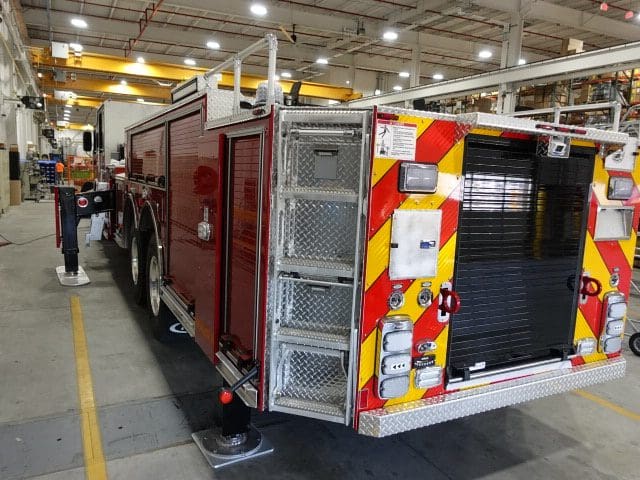

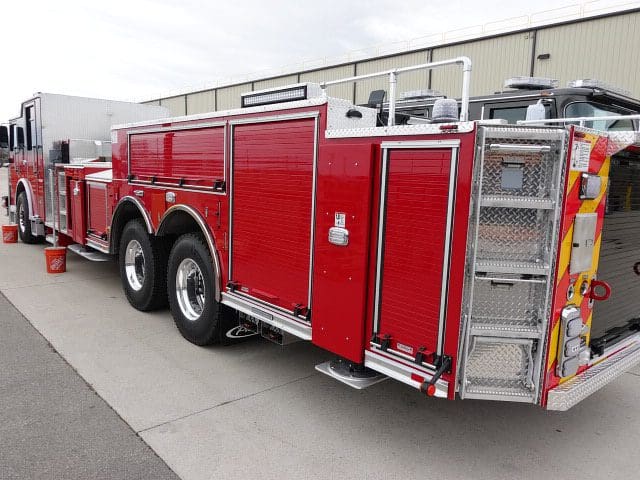

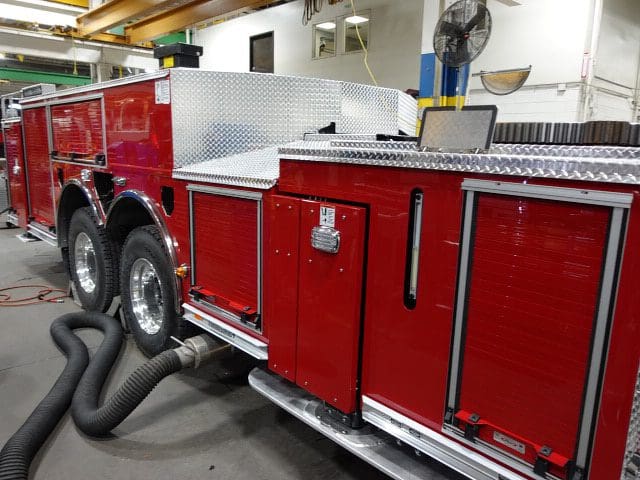

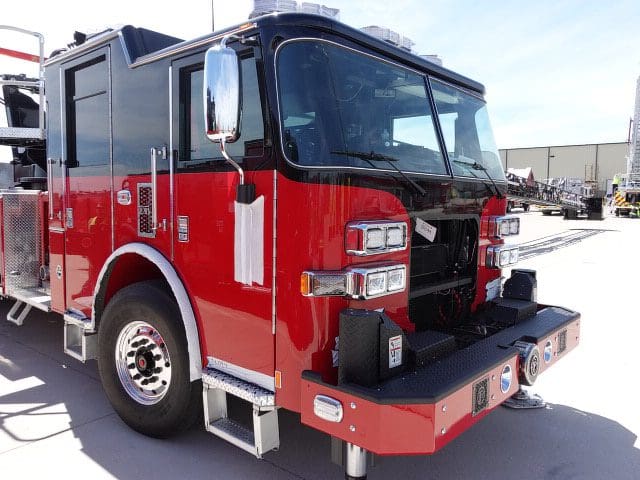

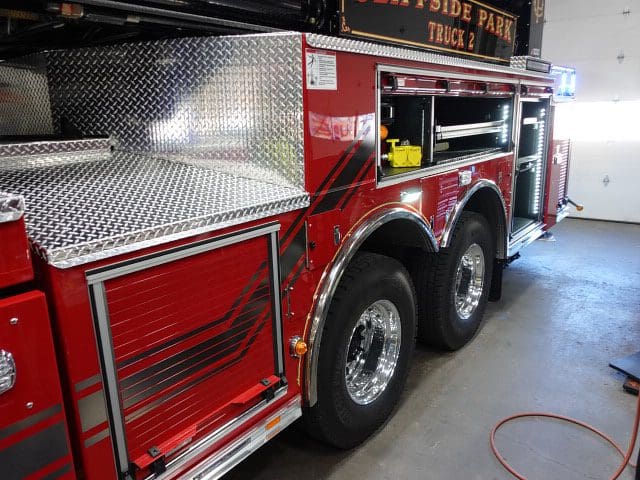

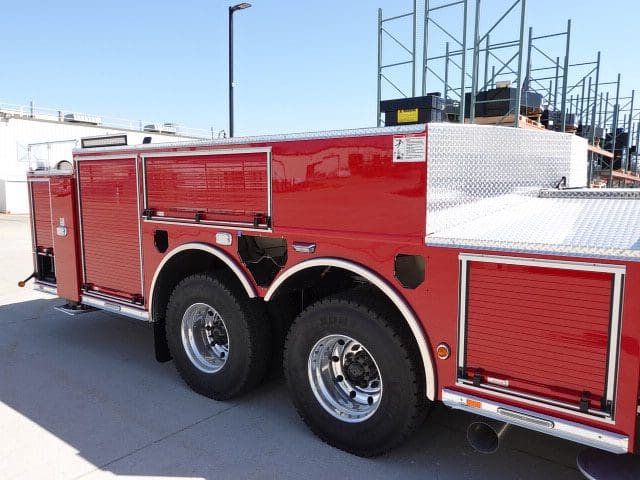

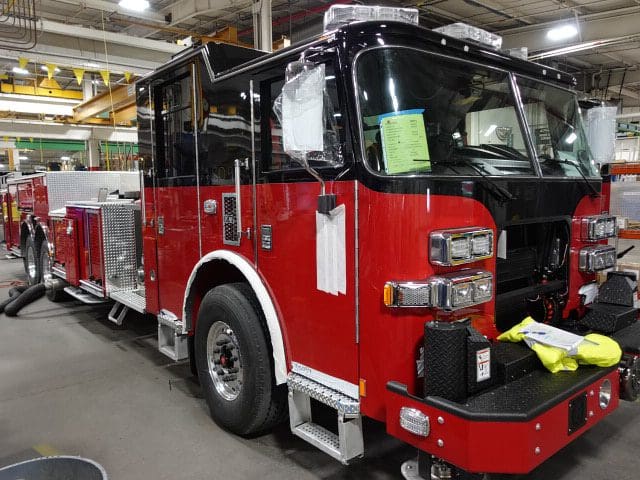

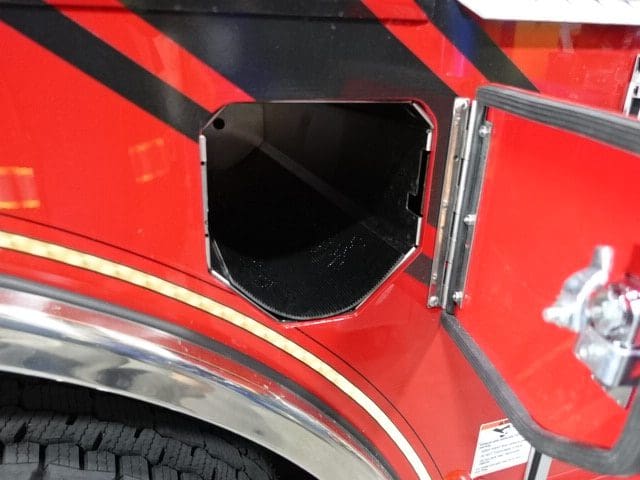

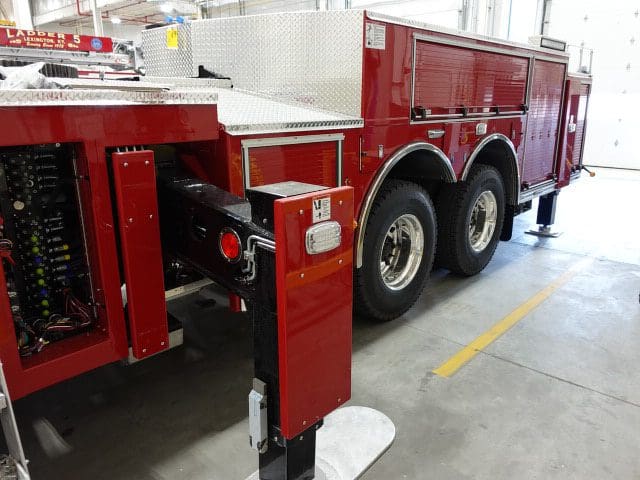

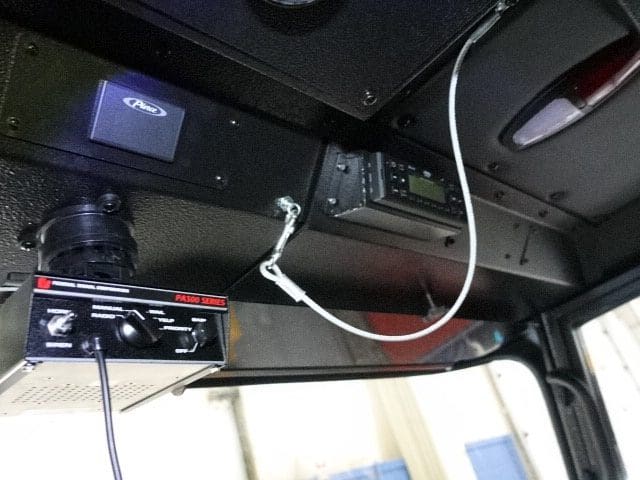

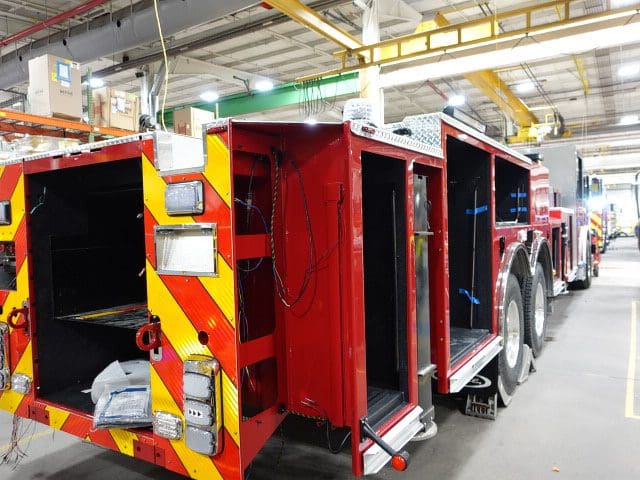

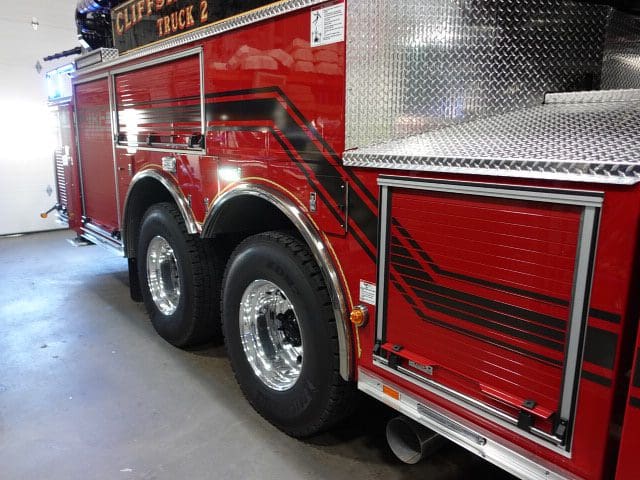

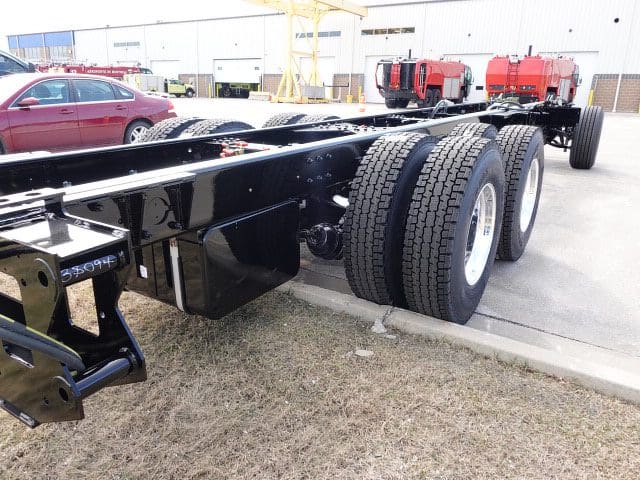

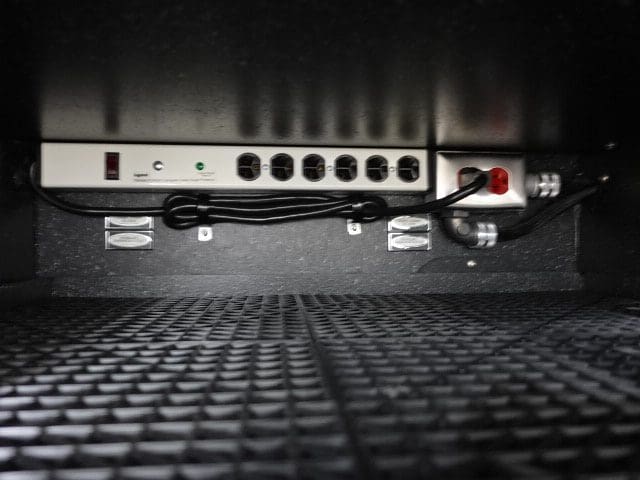

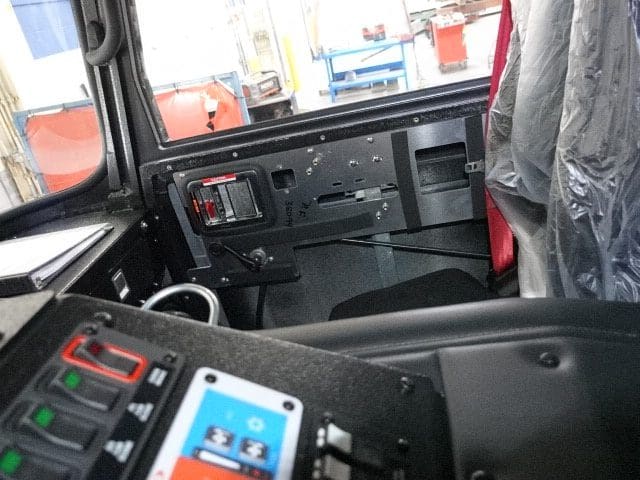

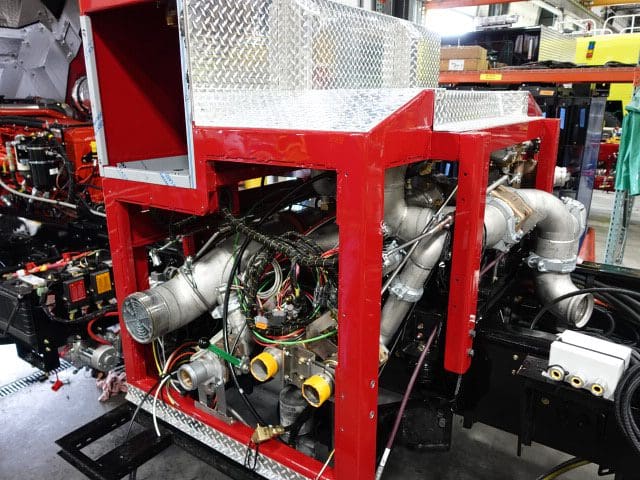

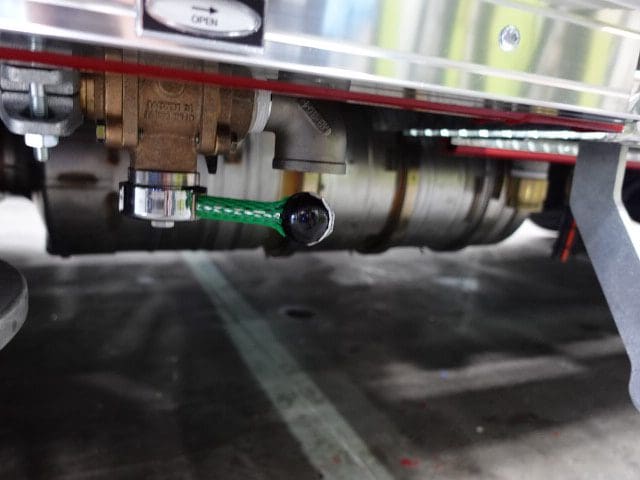

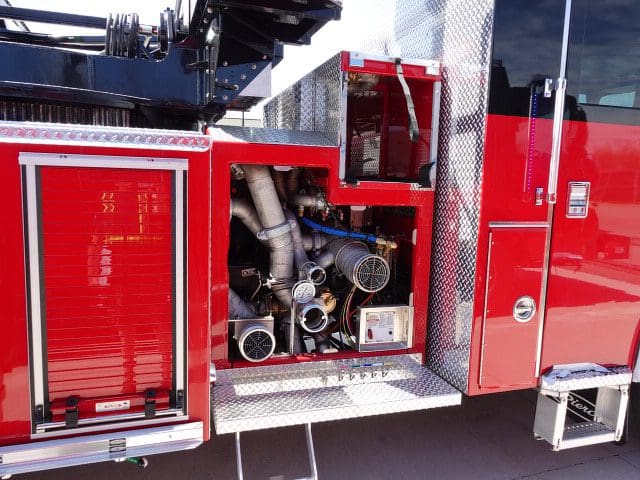

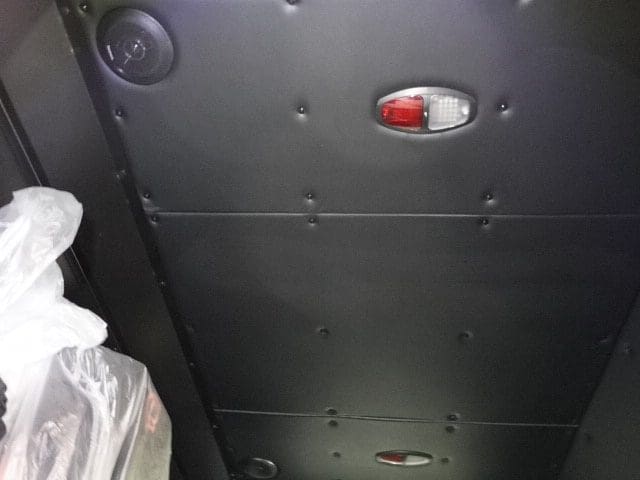

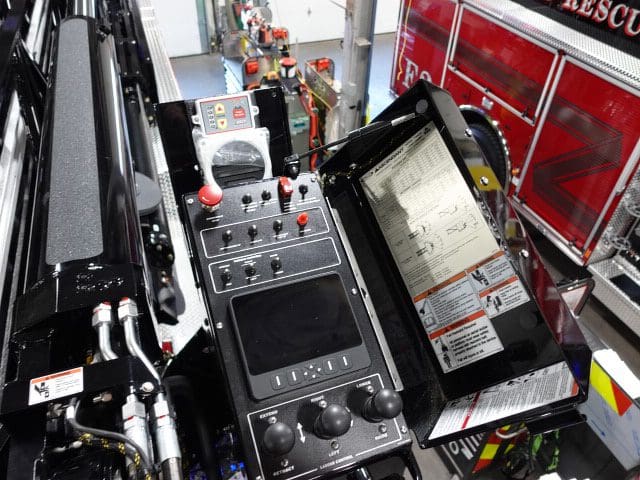

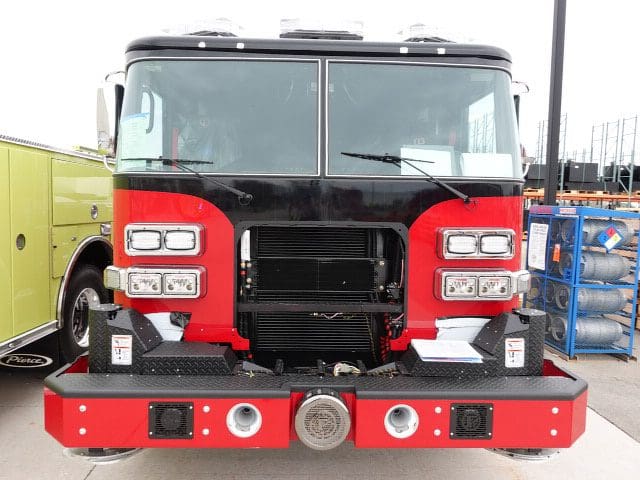

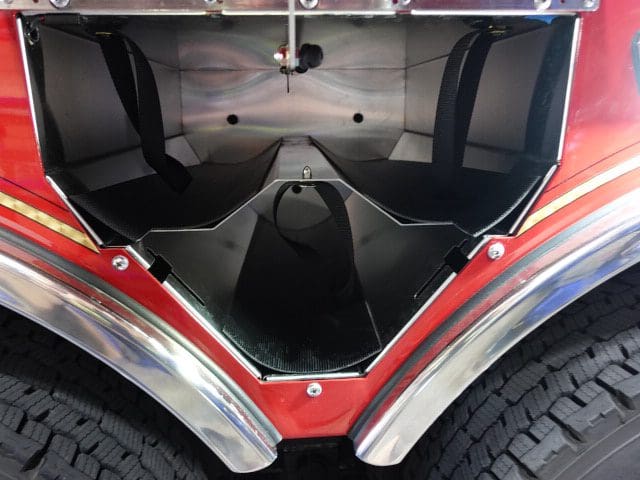

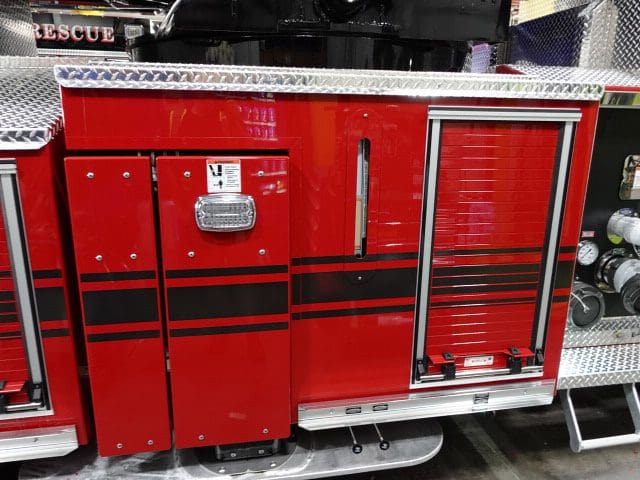

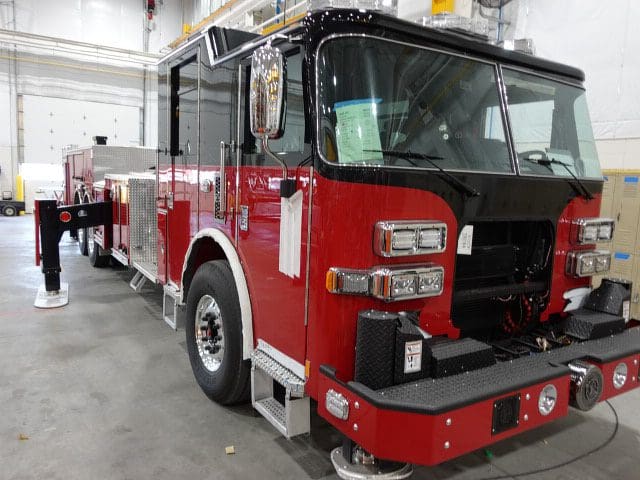

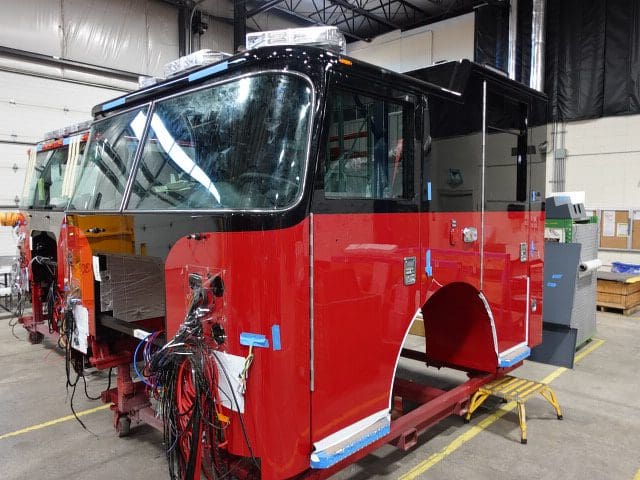

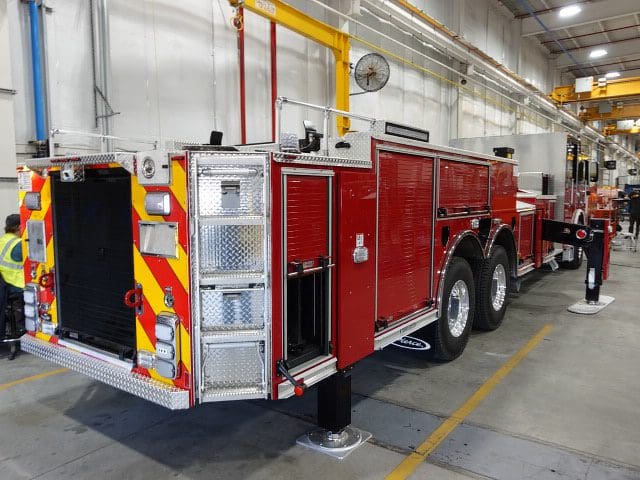

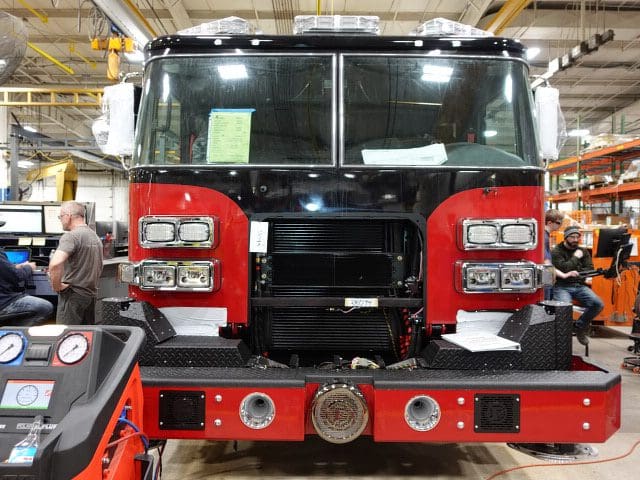

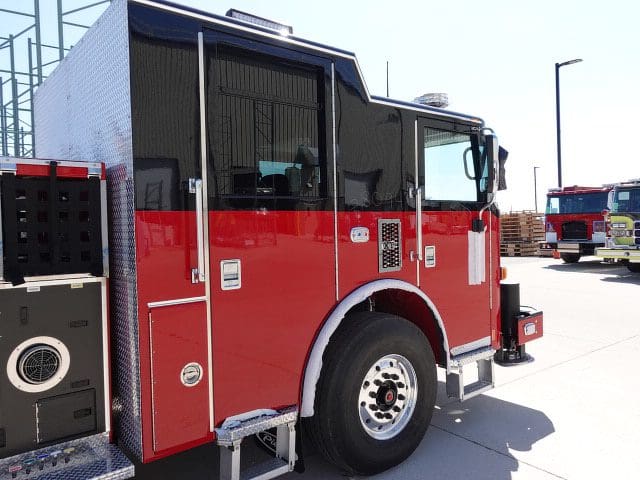

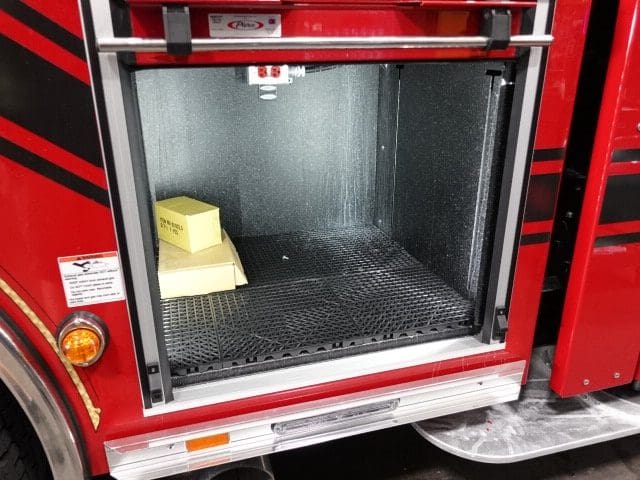

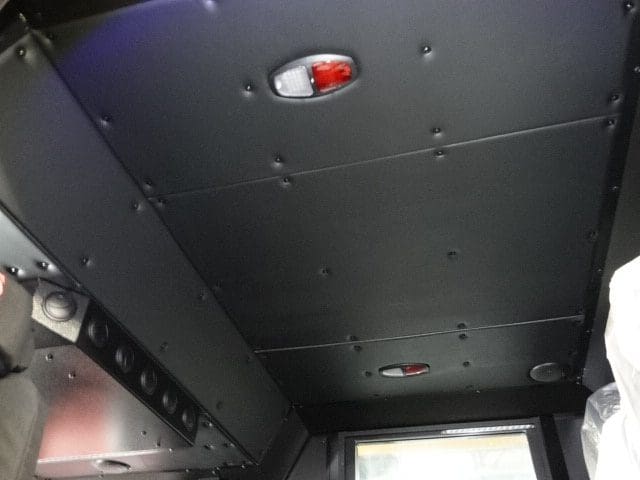

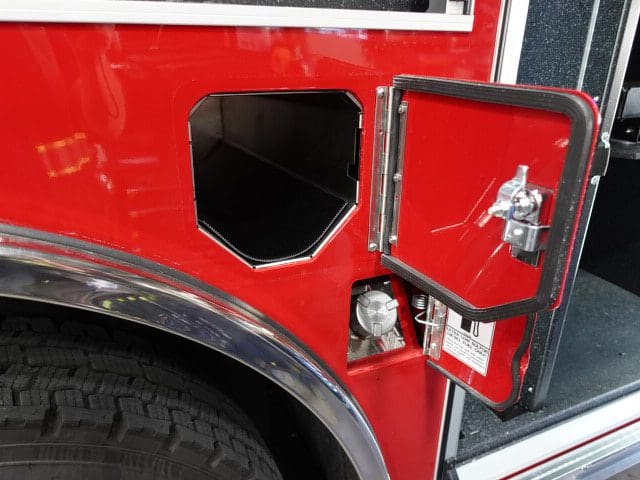

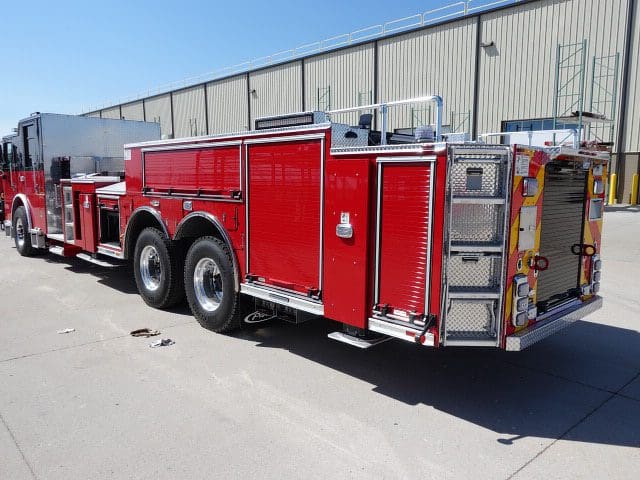

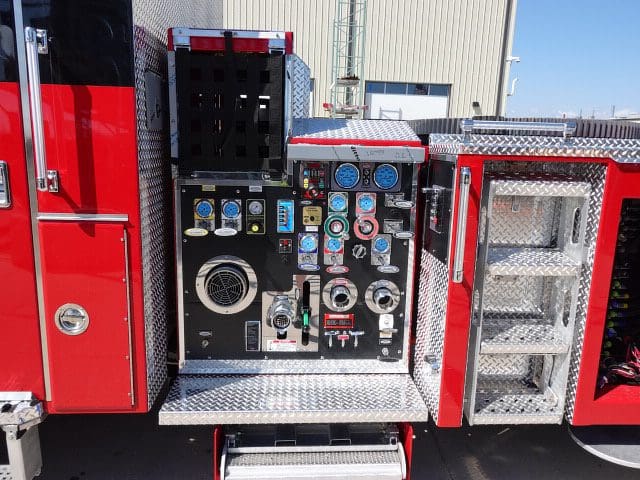

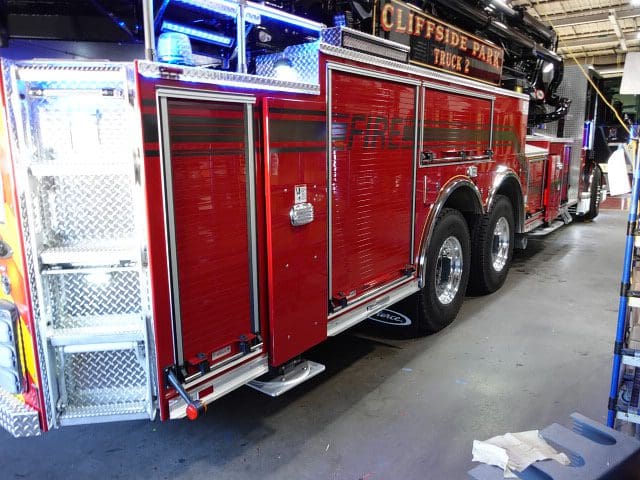

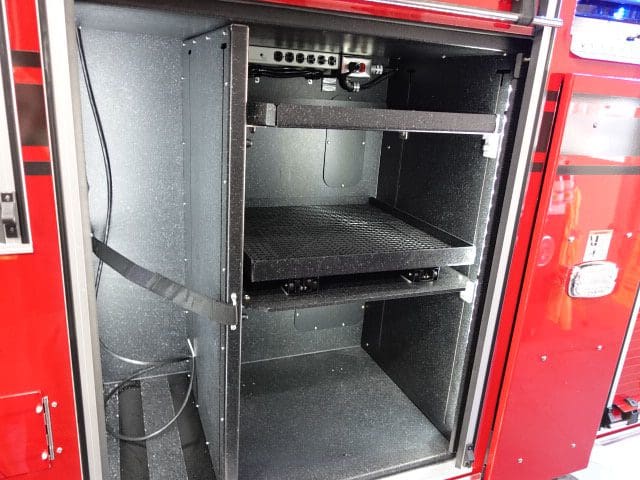

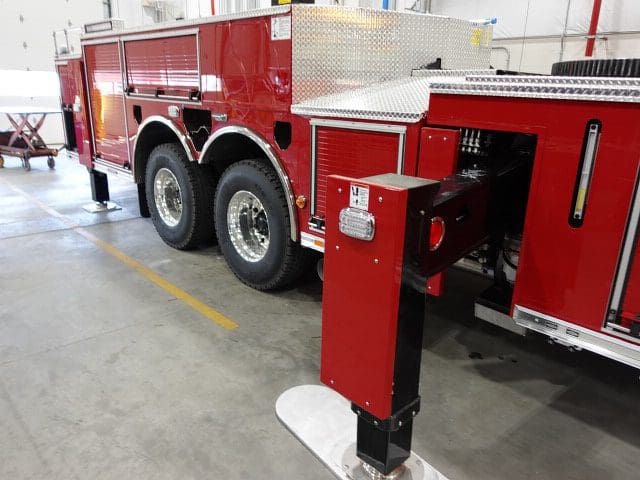

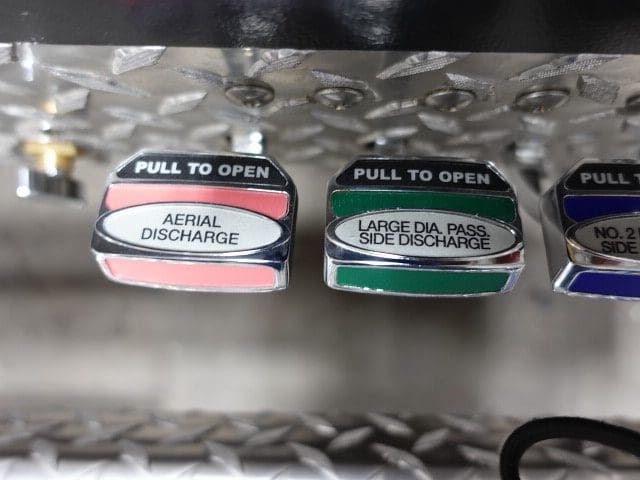

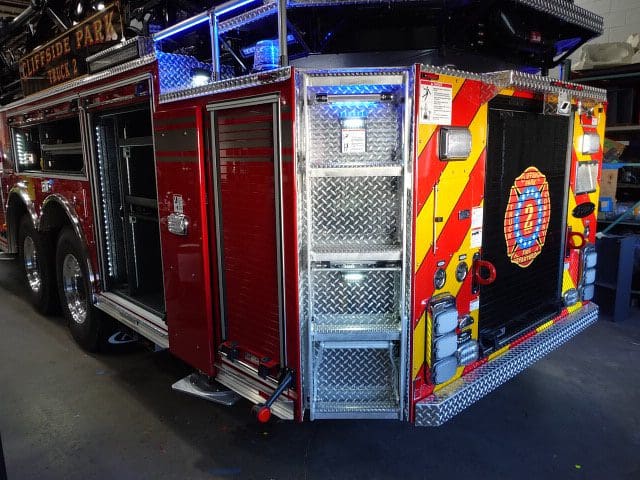

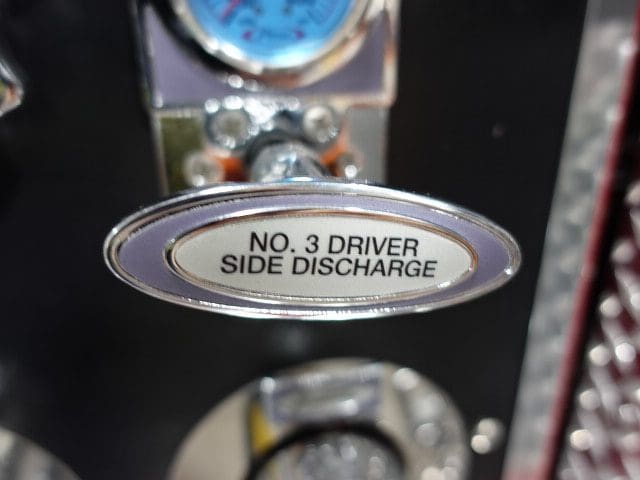

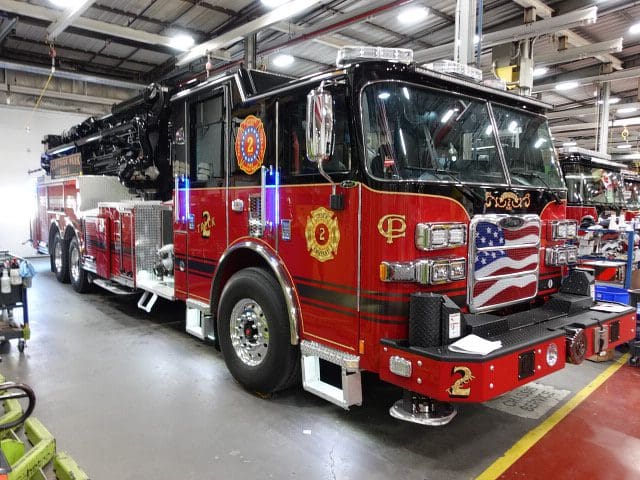

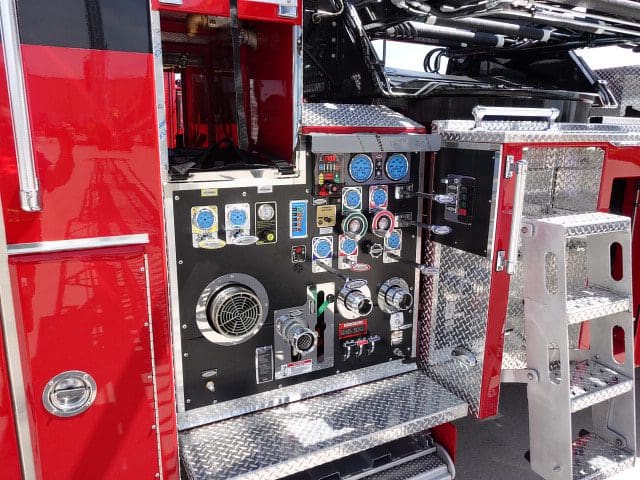

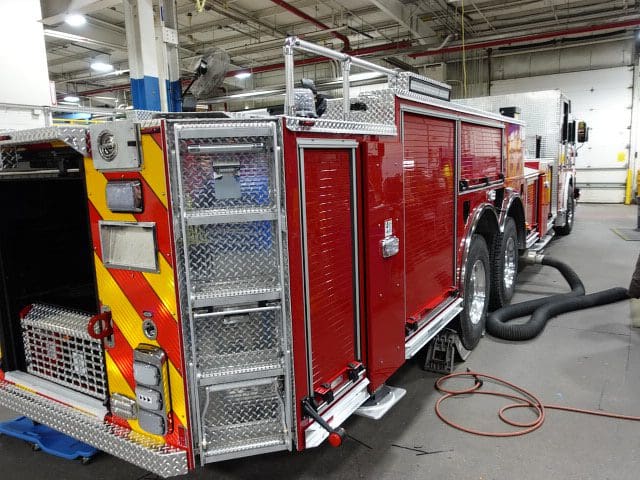

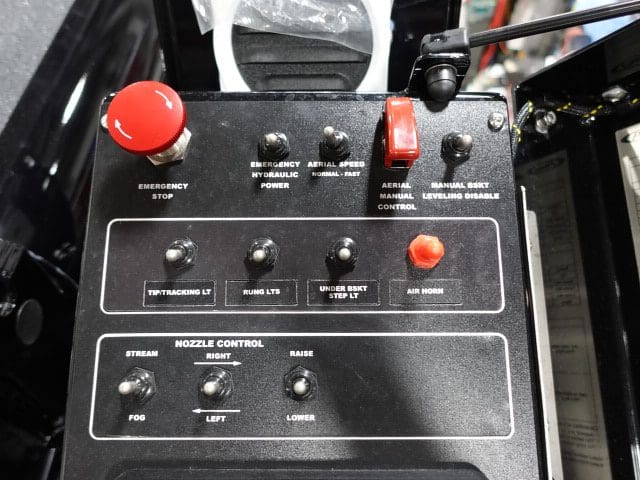

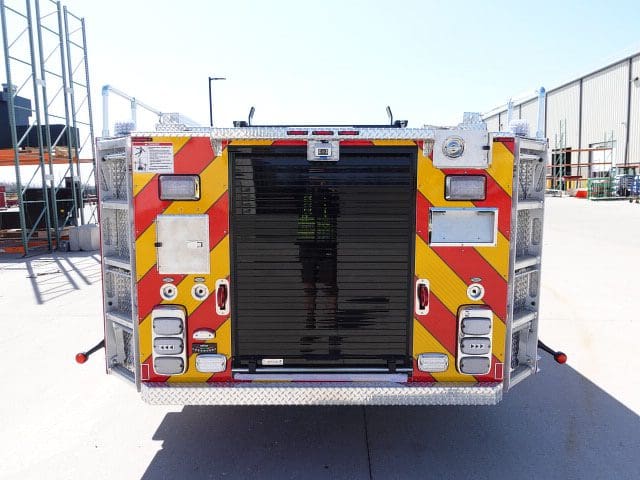

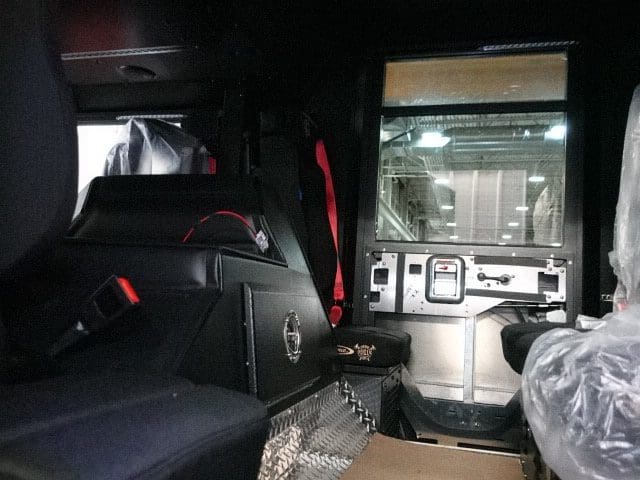

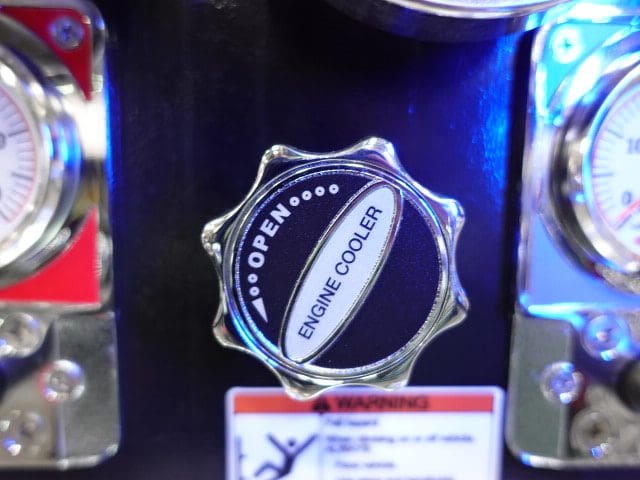

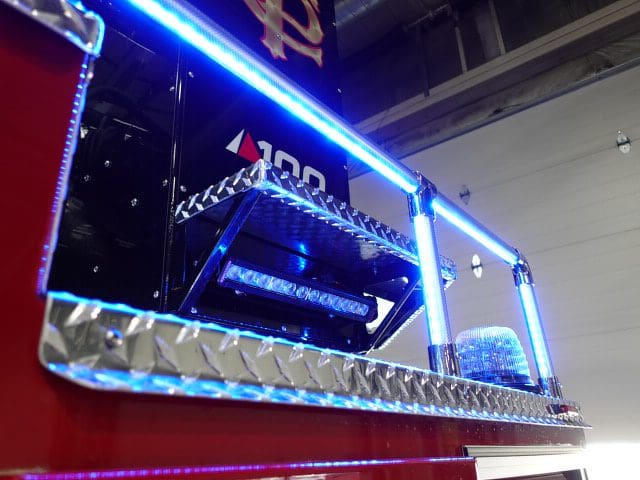

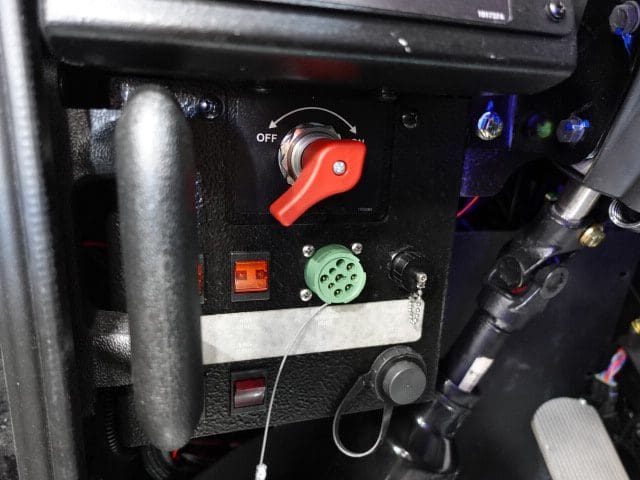

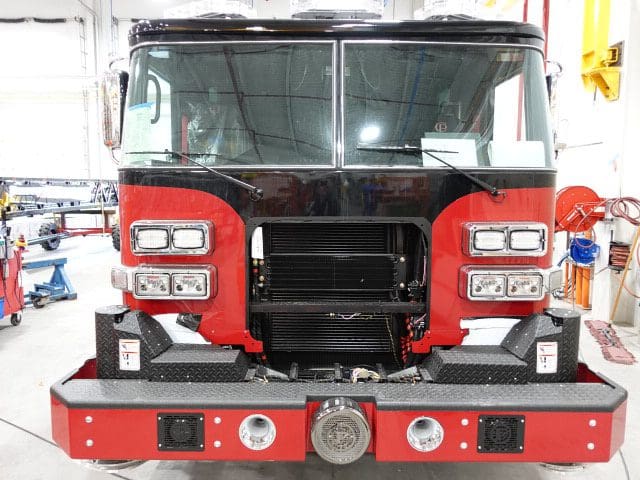

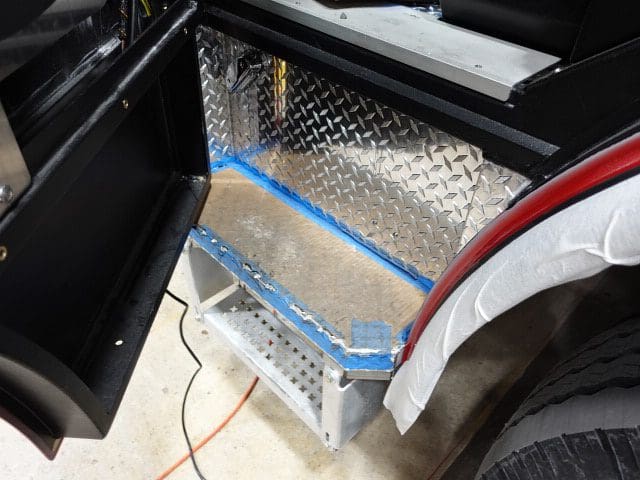

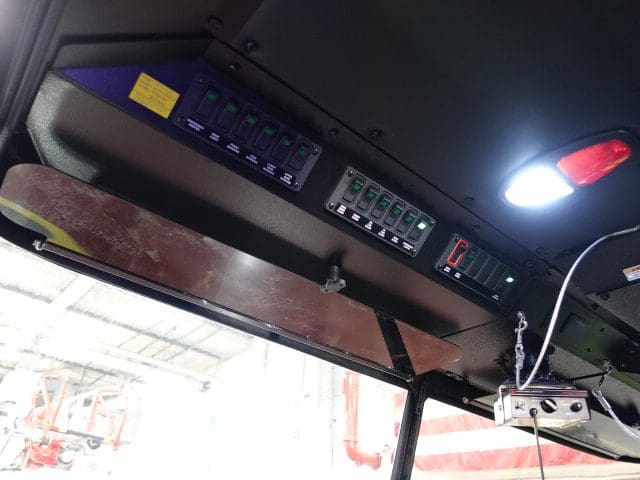

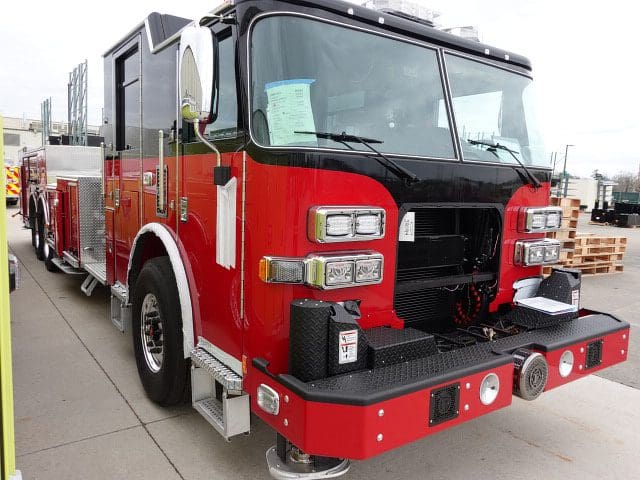

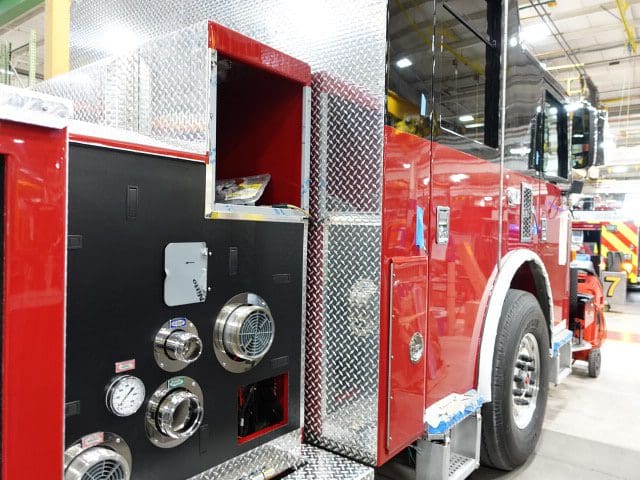

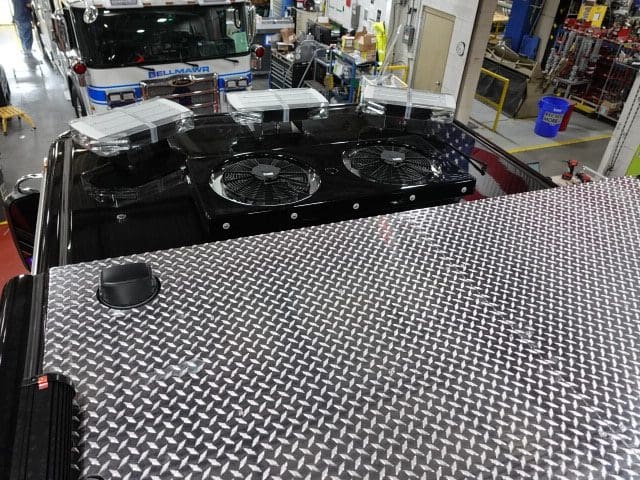

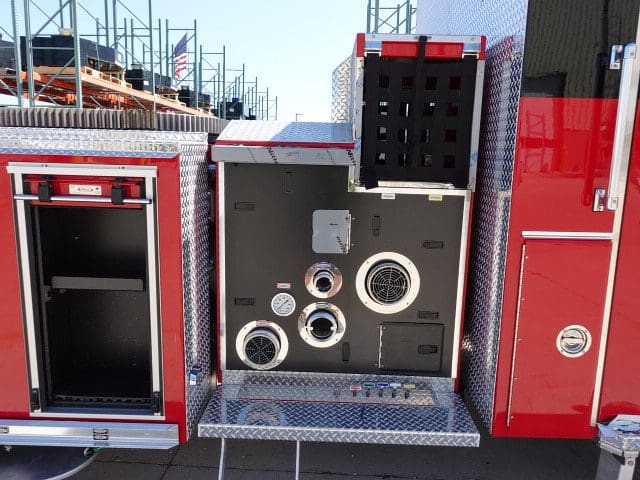

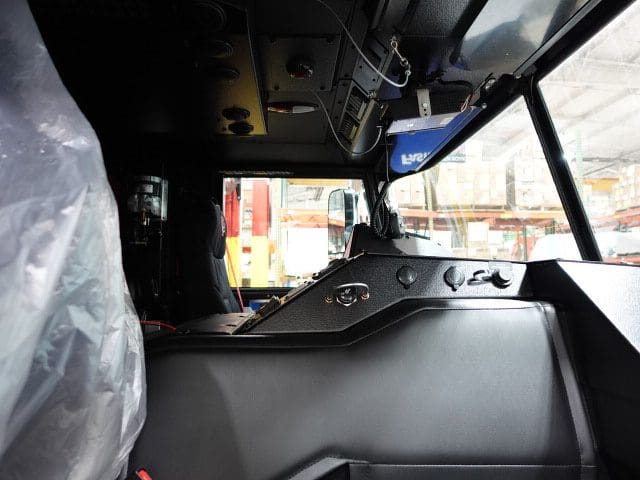

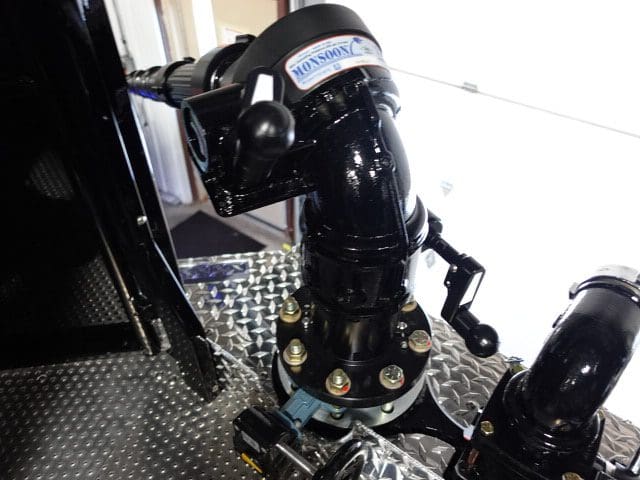

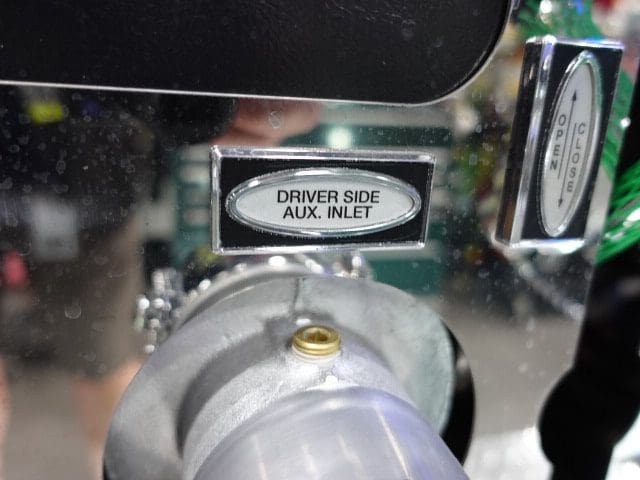

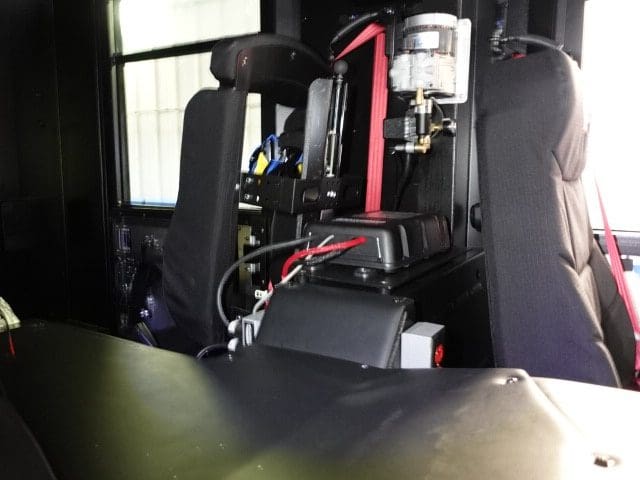

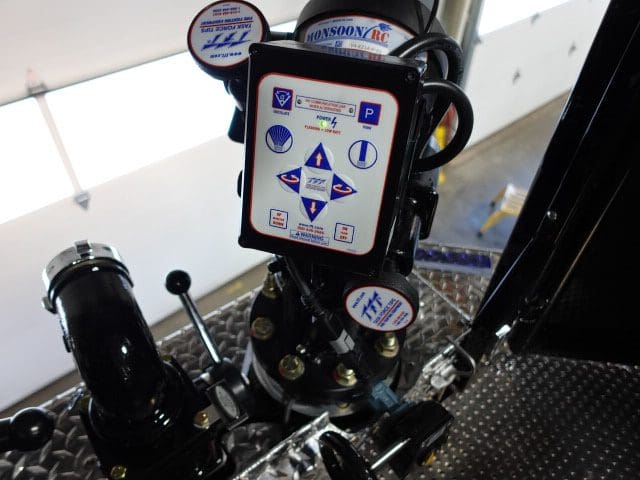

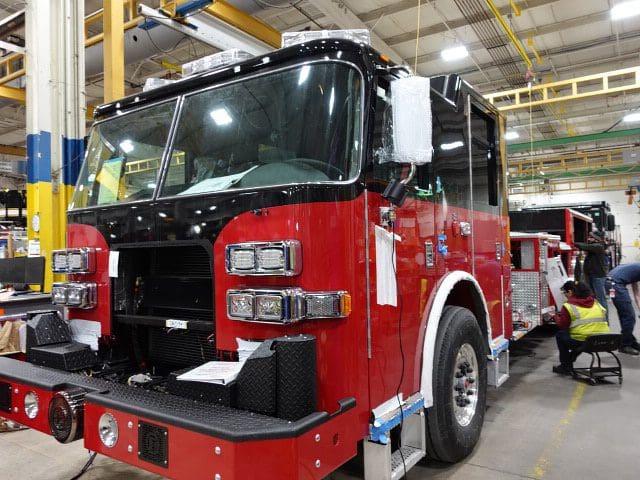

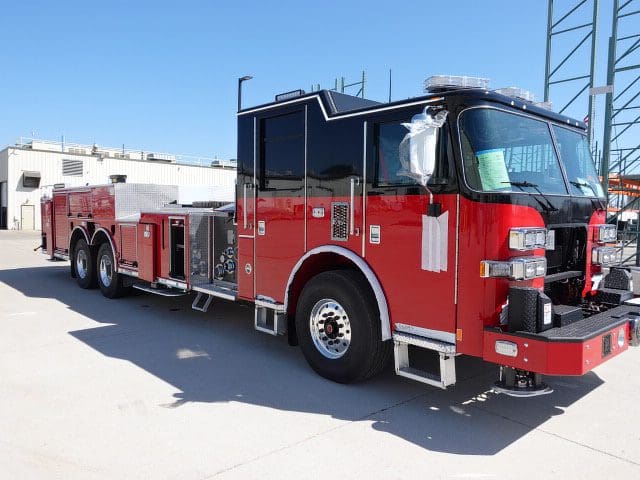

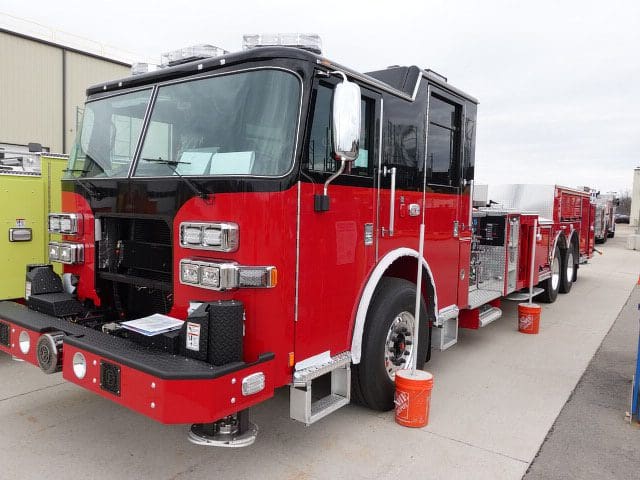

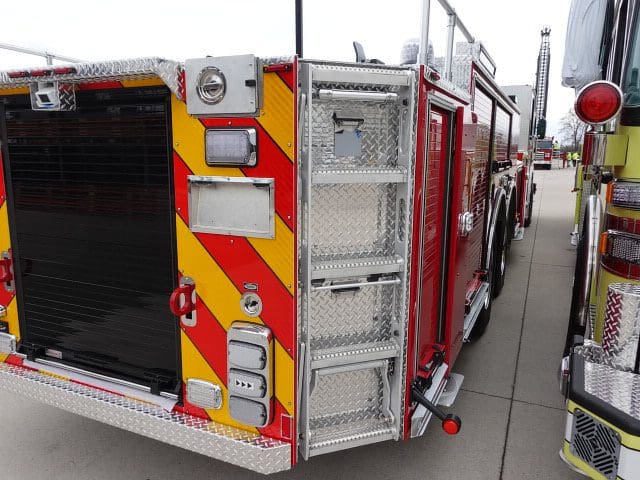

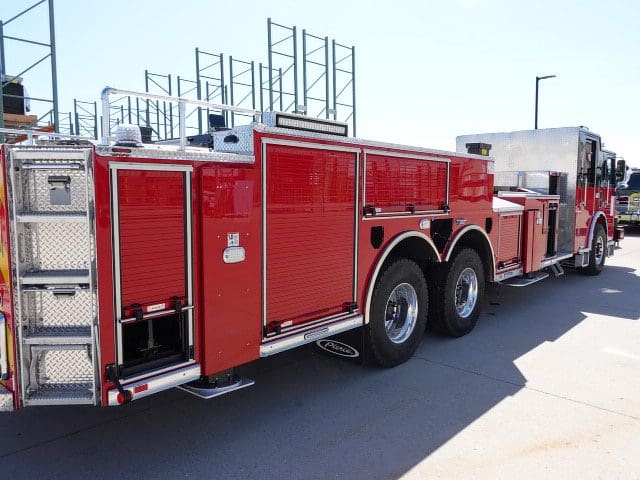

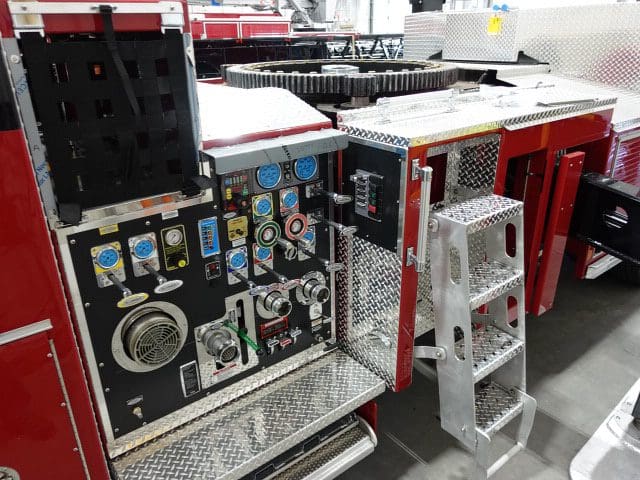

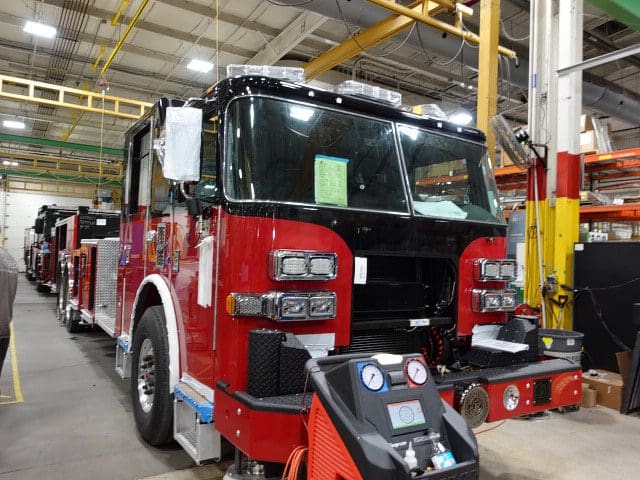

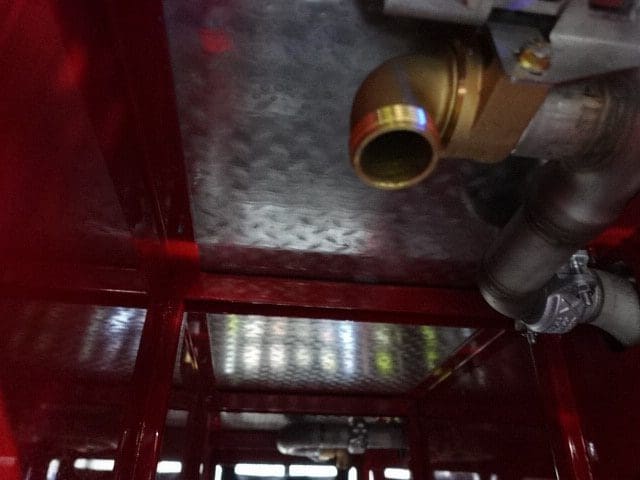

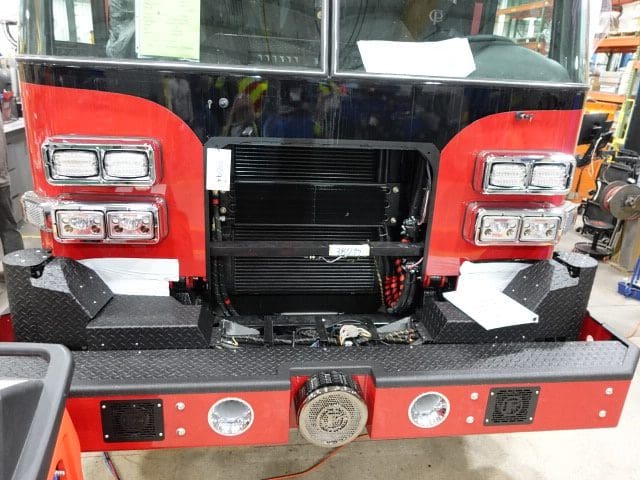

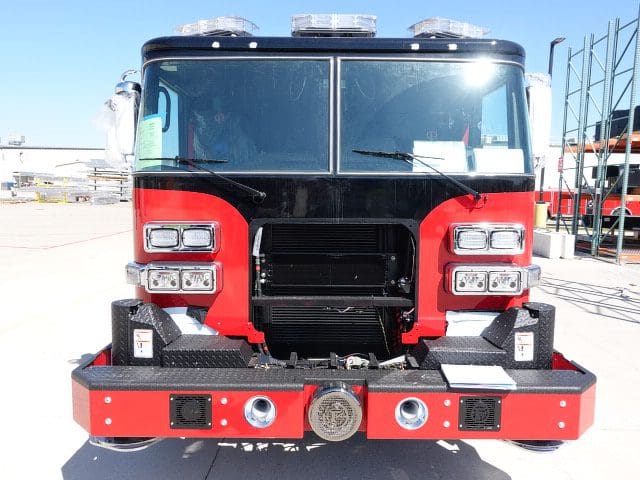

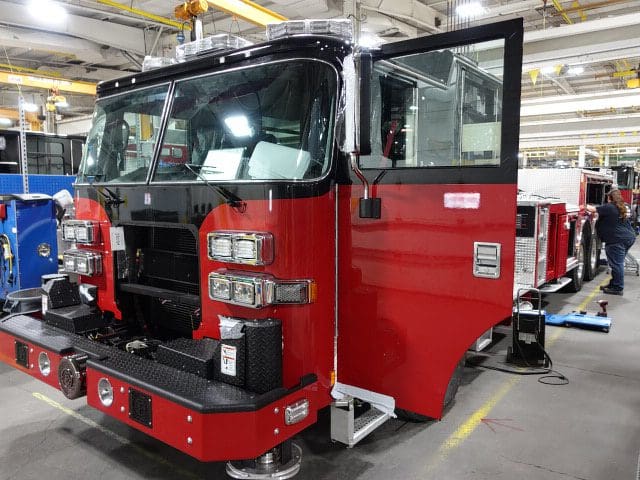

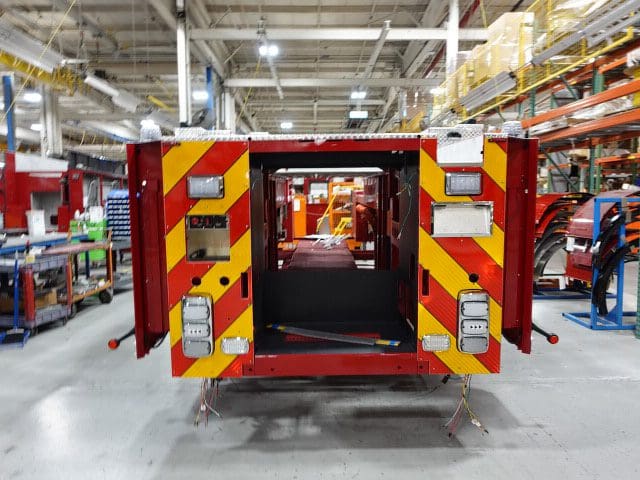

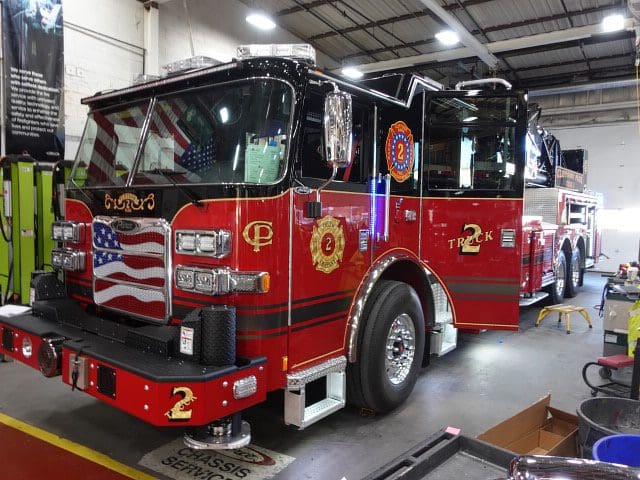

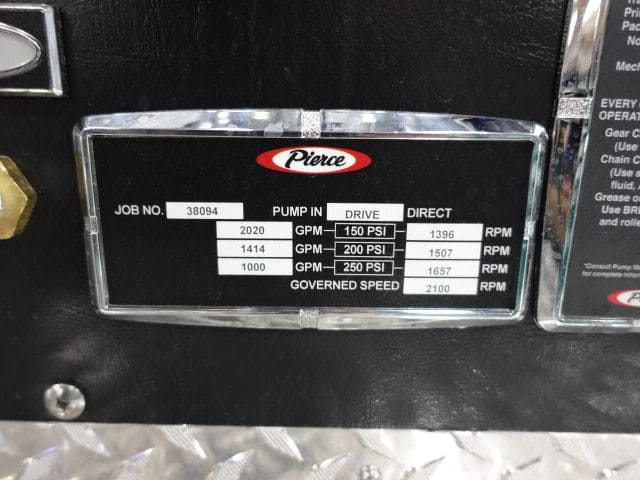

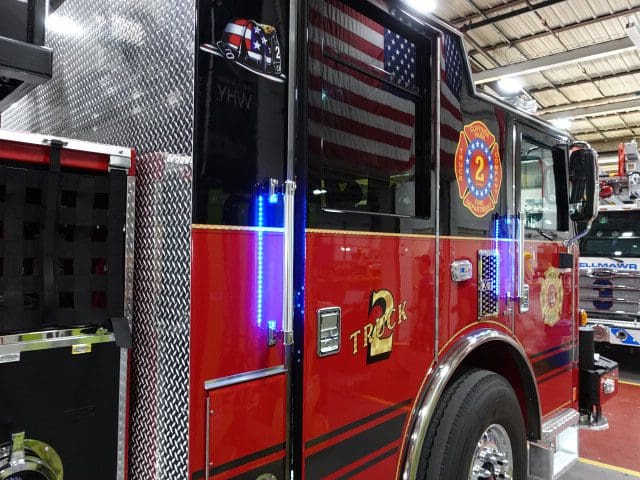

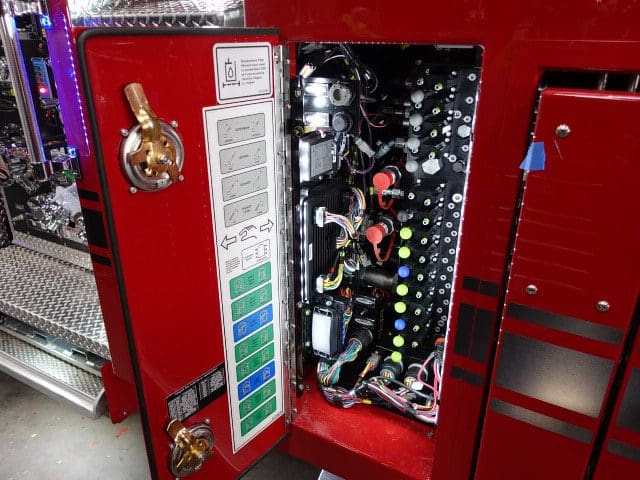

In this report, the apparatus completed testing and was released to quality and graphics where any remaining content is applied. Once finished, it will be made ready for the customer acceptance inspection. This is the last scheduled report.
05-03-24

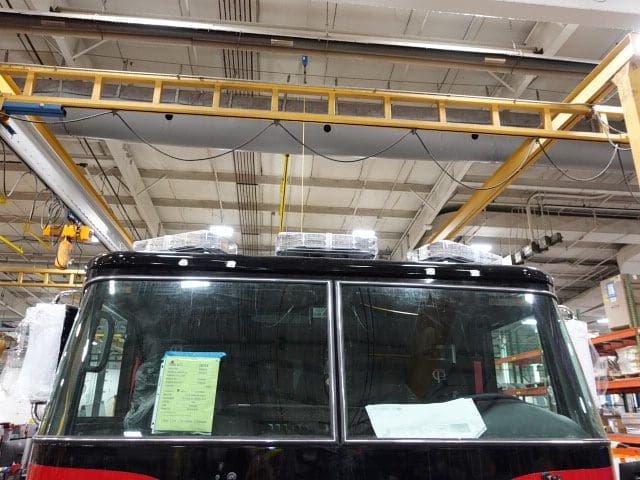

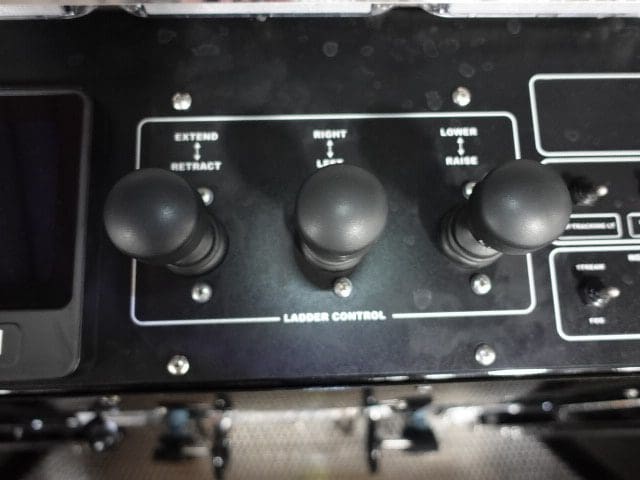

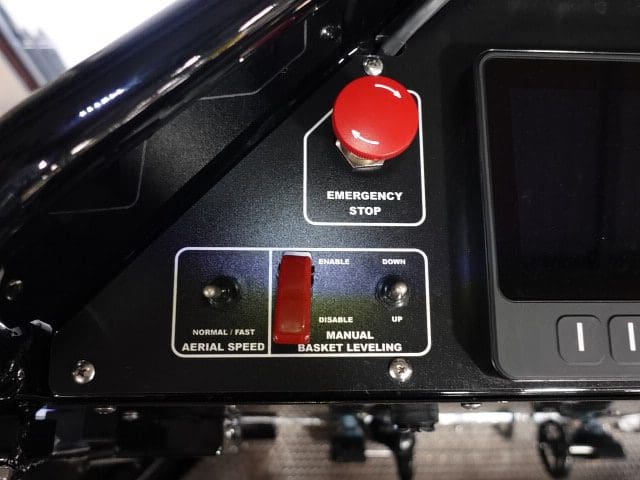

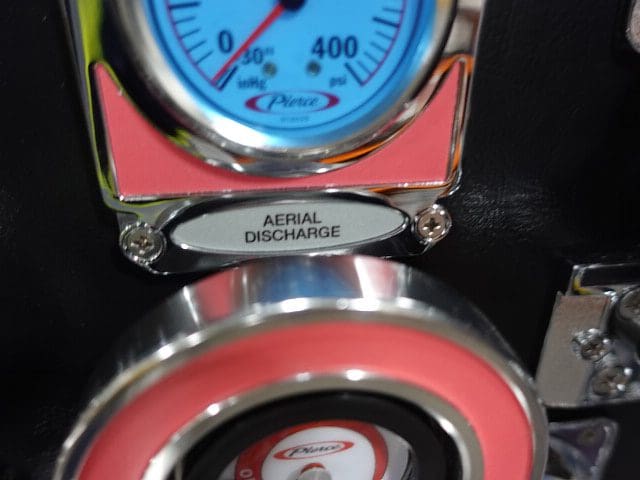

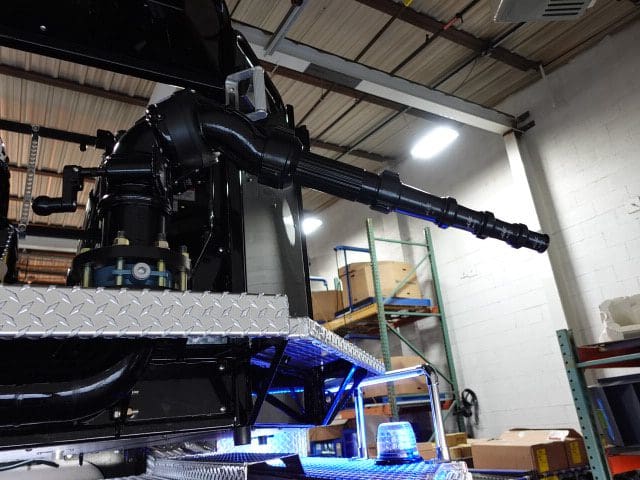

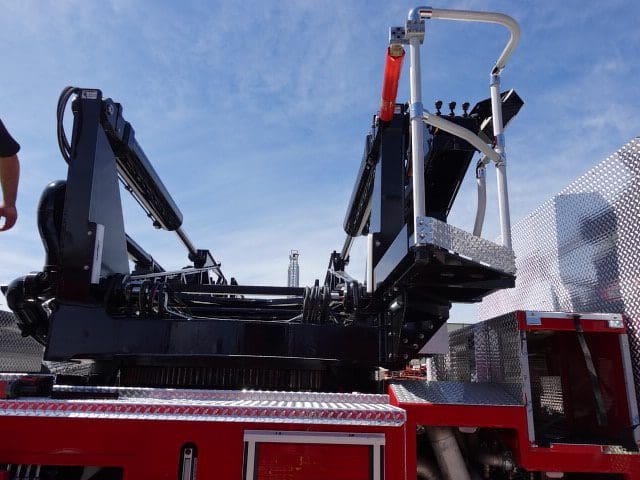

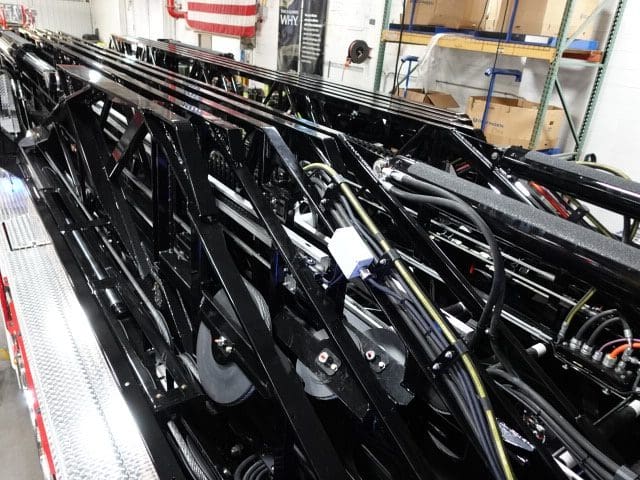

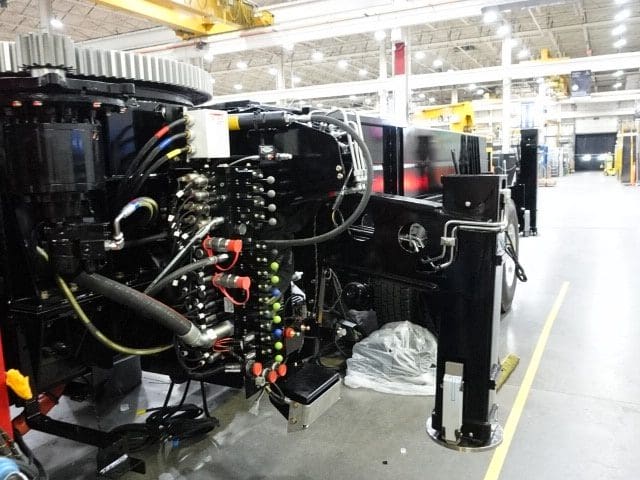

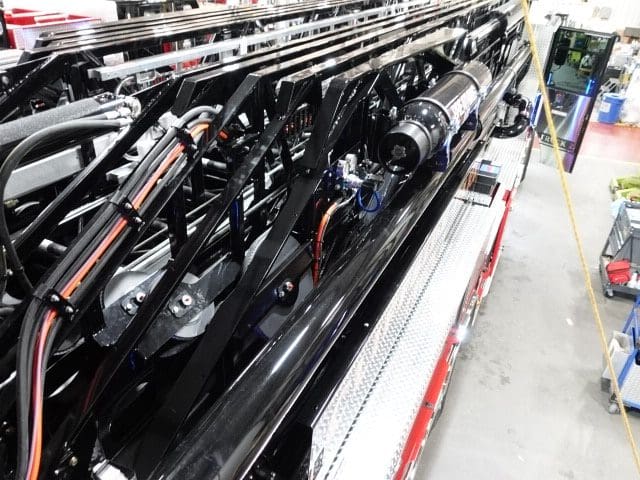

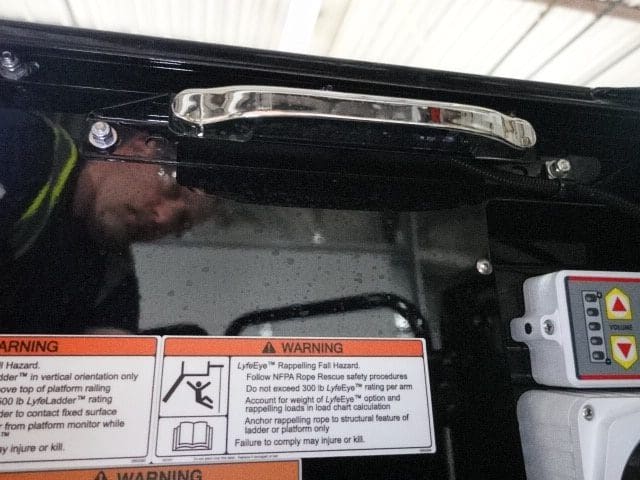

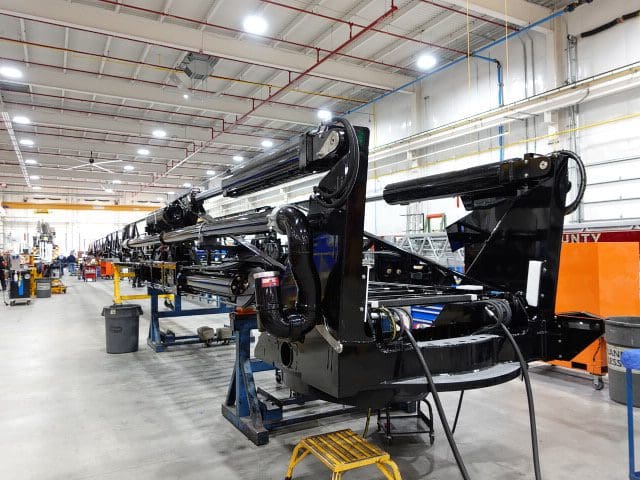

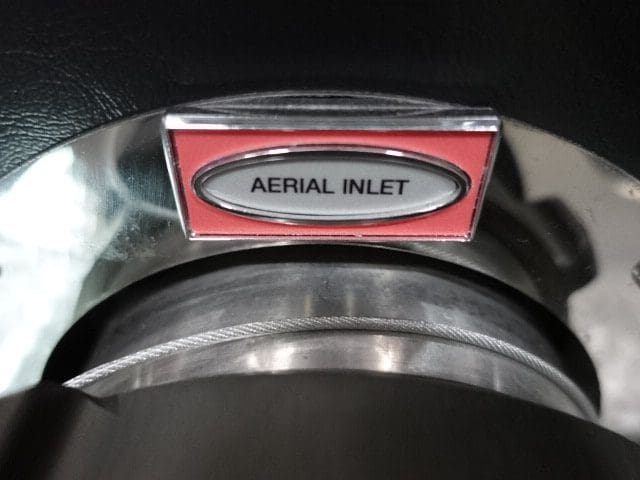

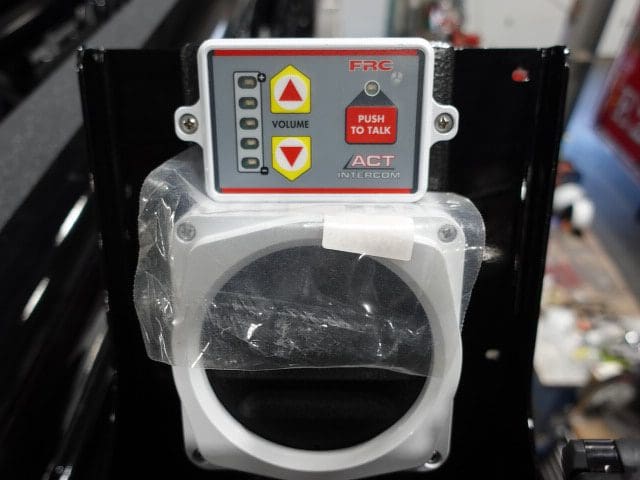

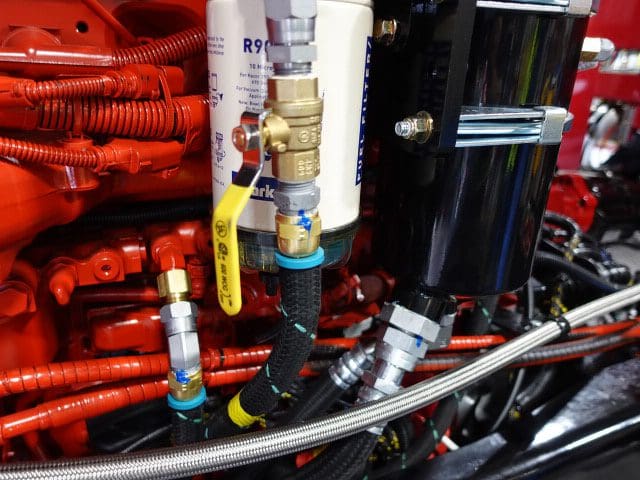

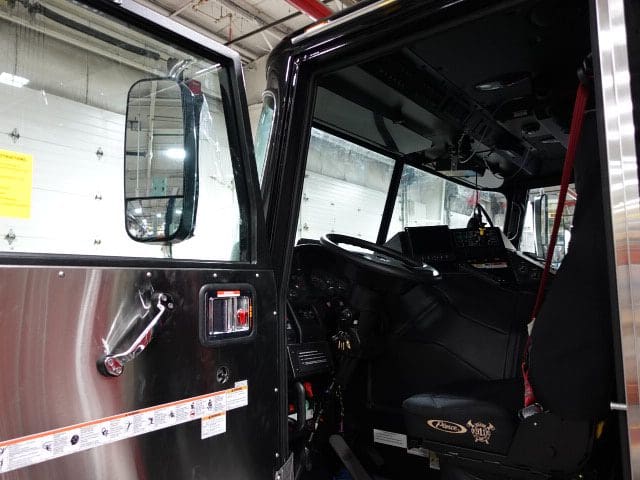

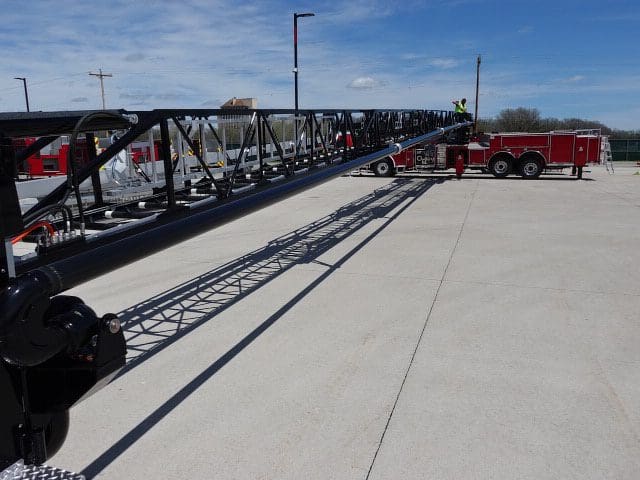

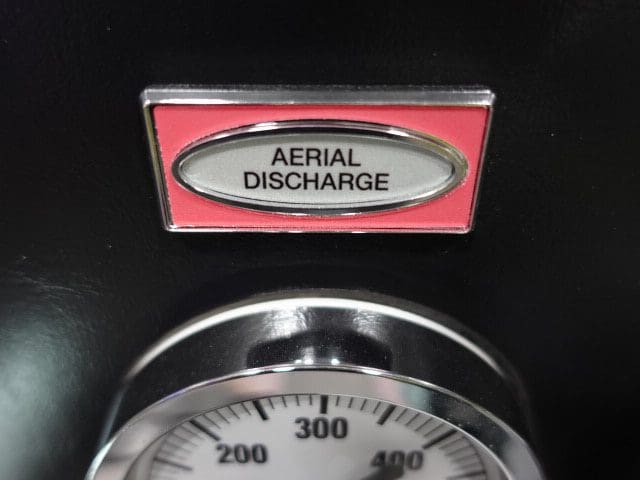

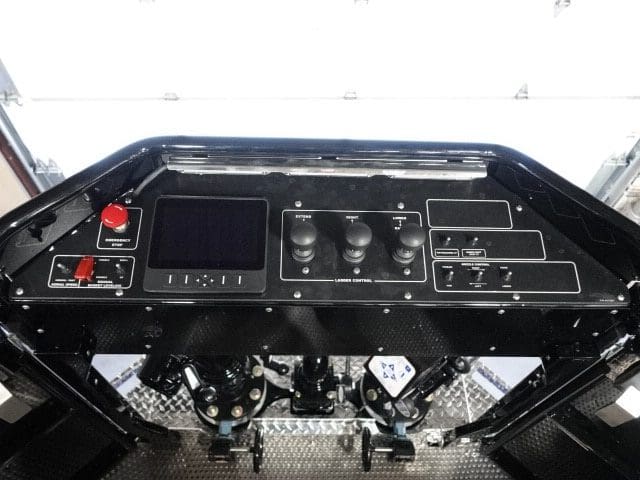

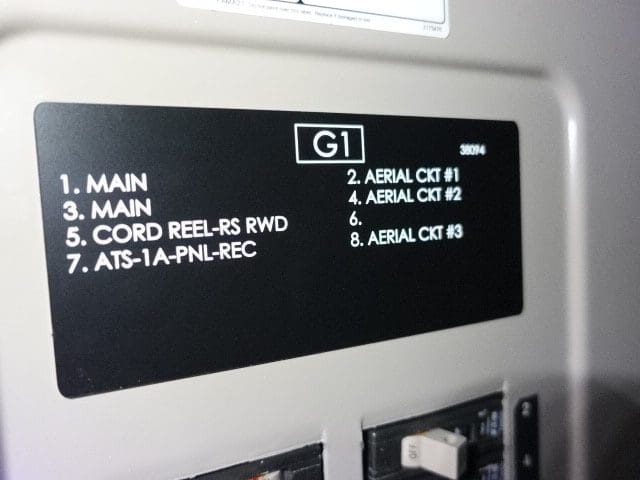

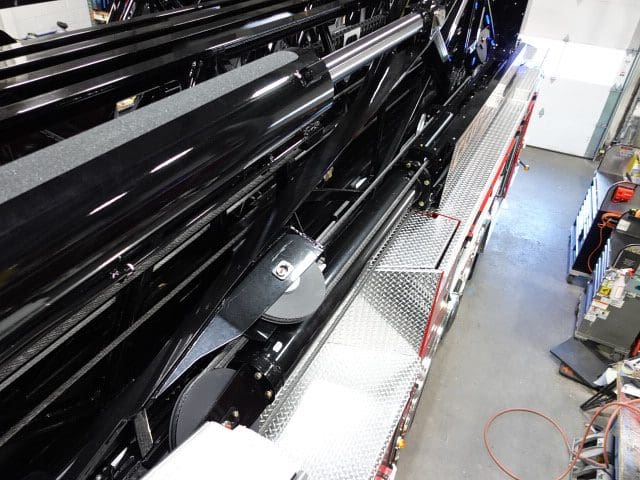

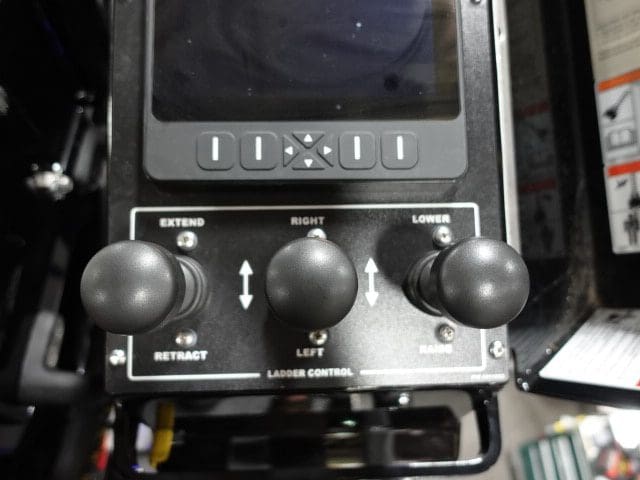

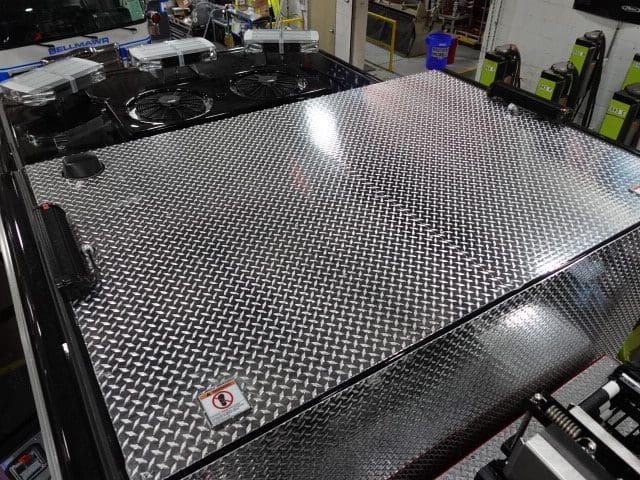

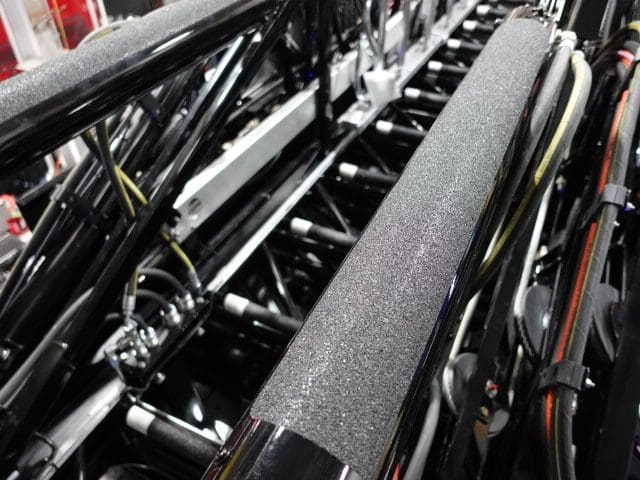

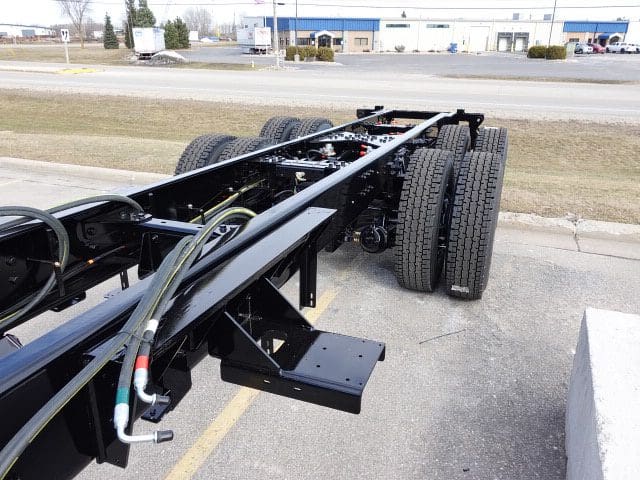

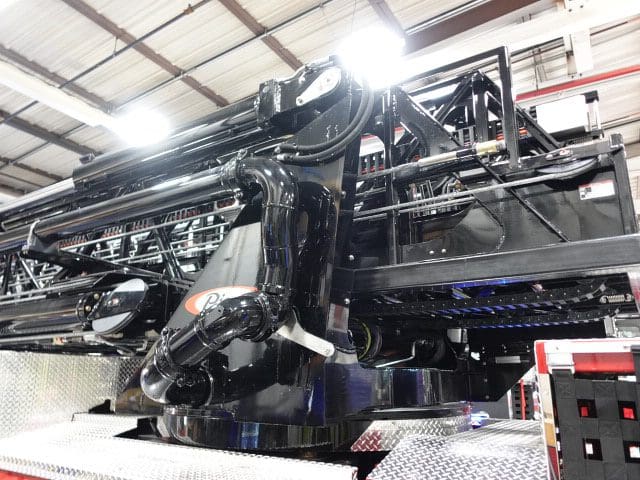

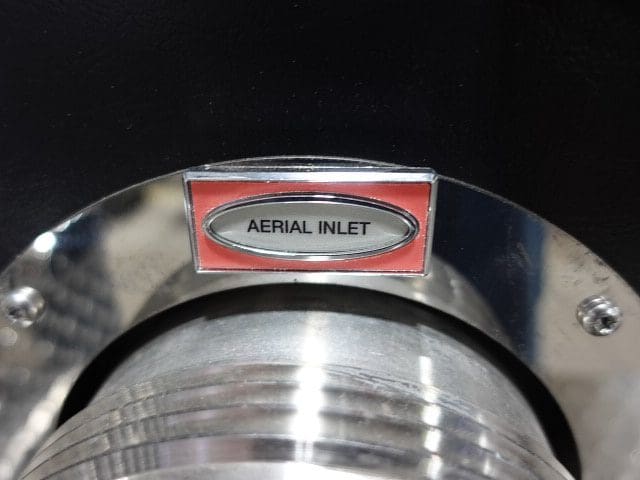

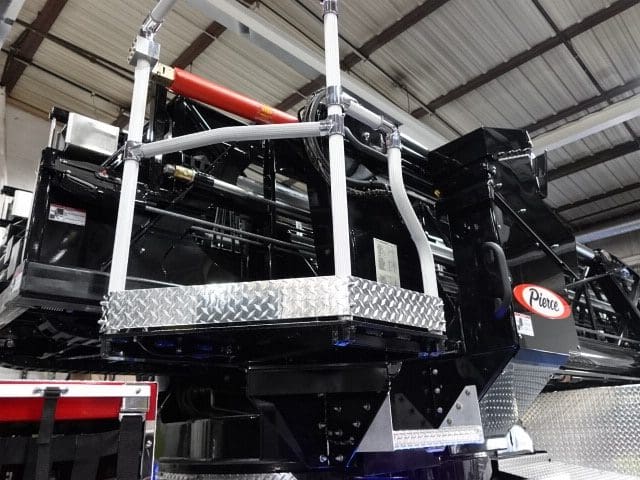

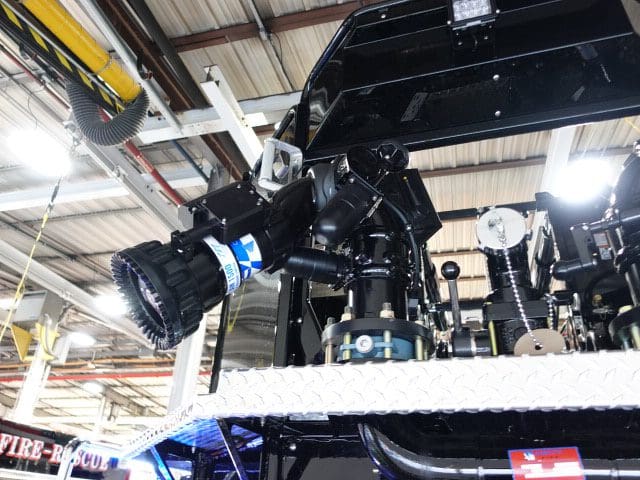

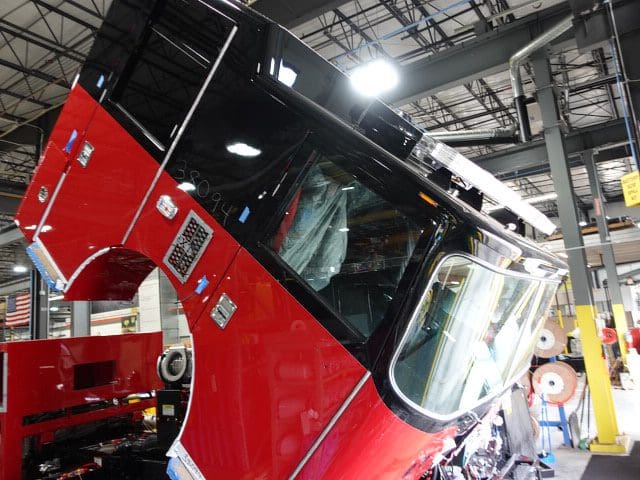

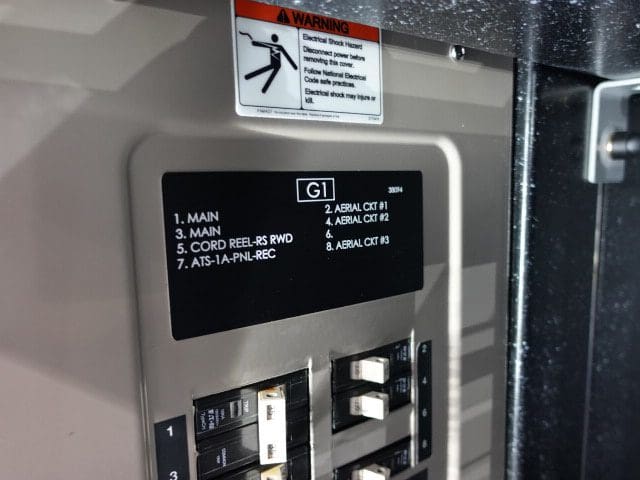

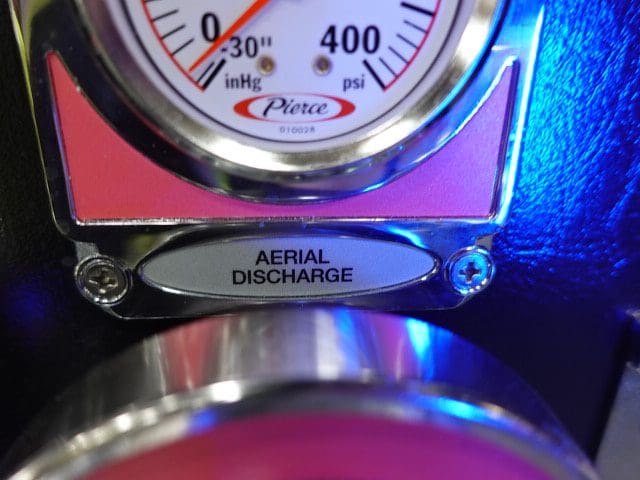

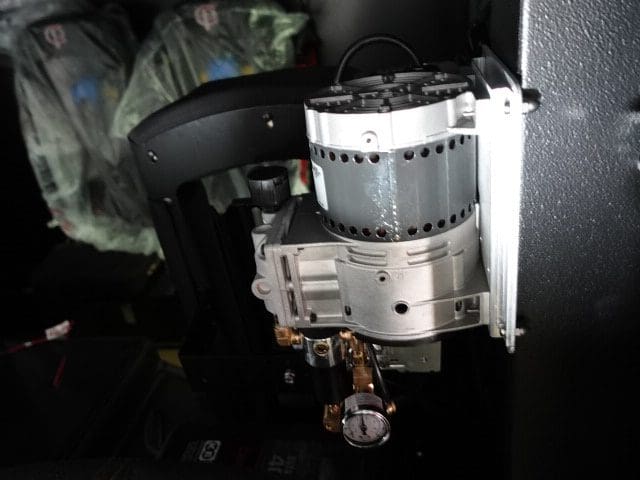

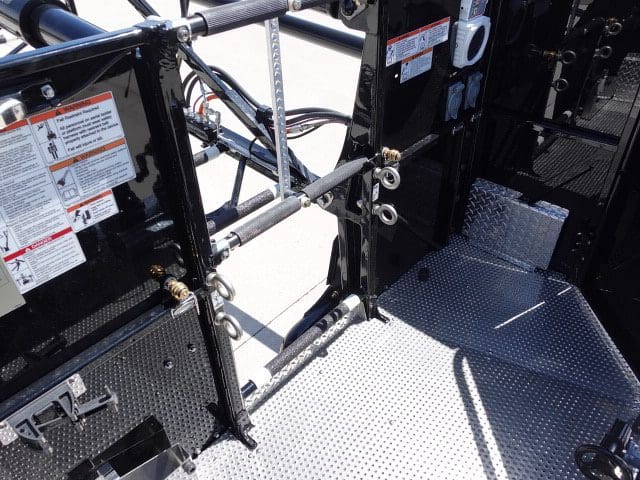

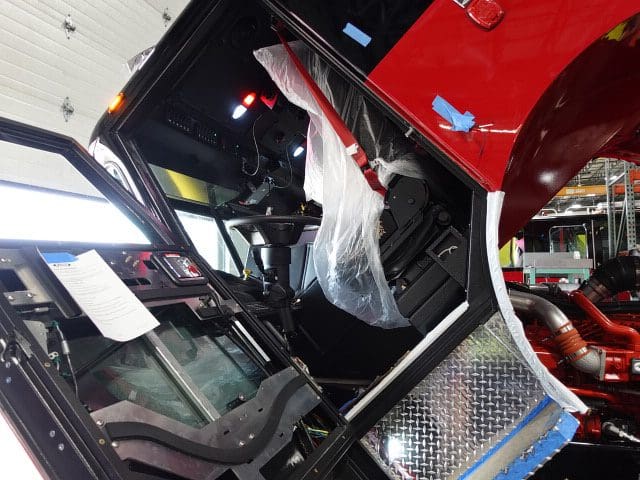

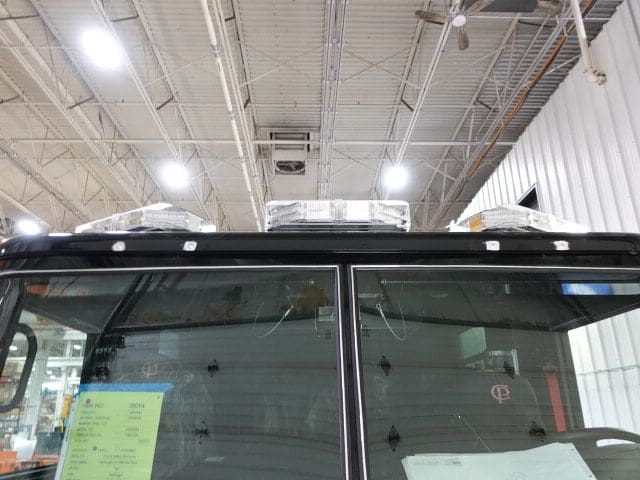

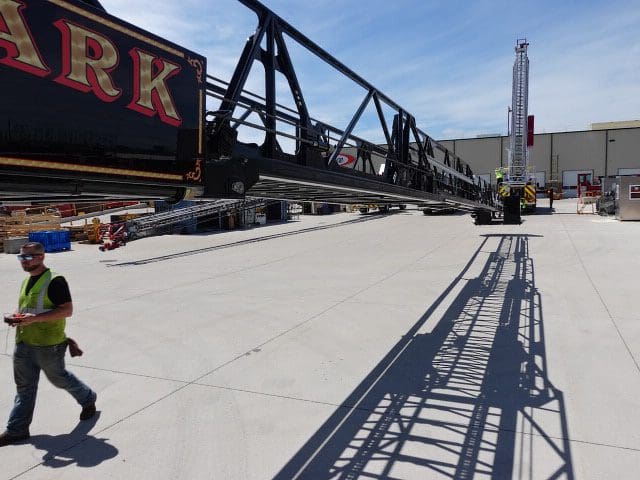

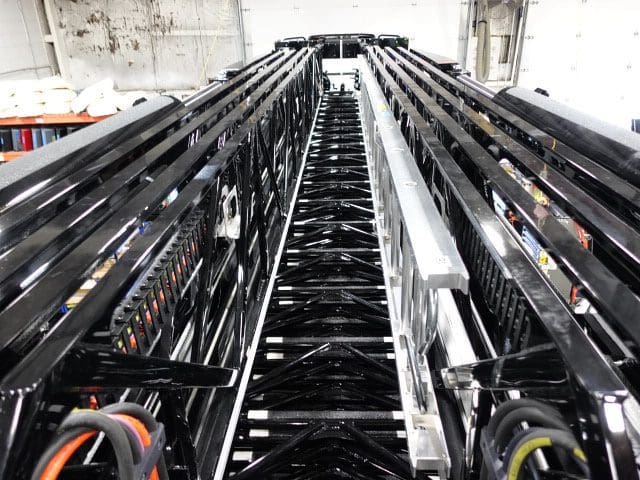

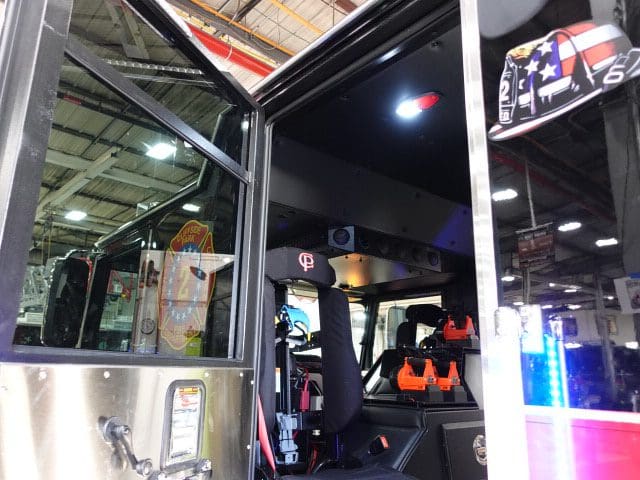

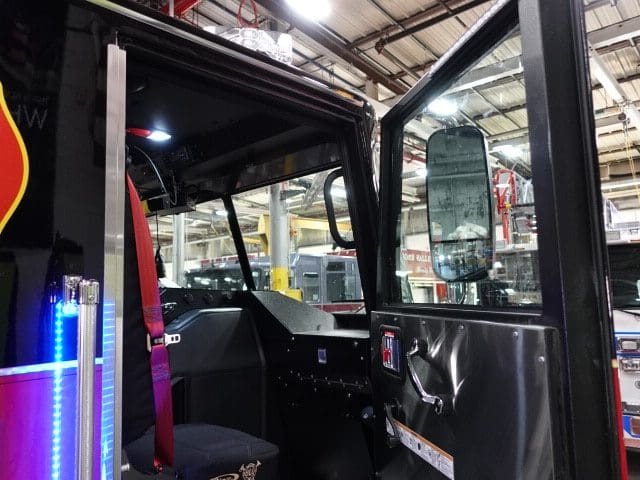

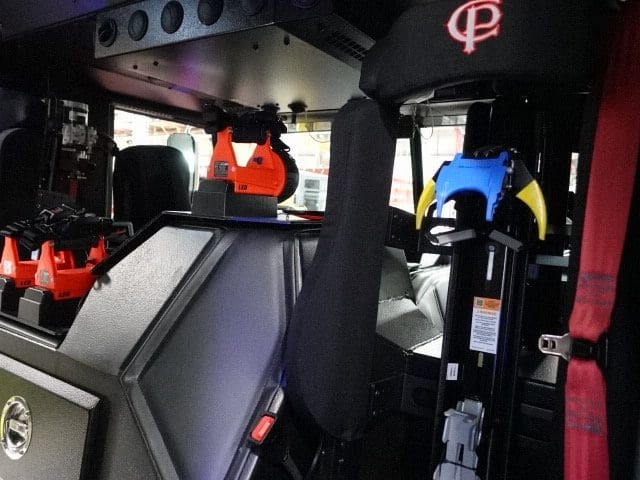

In this report, the aerial device was pinned to the apparatus followed by the start of aerial testing.

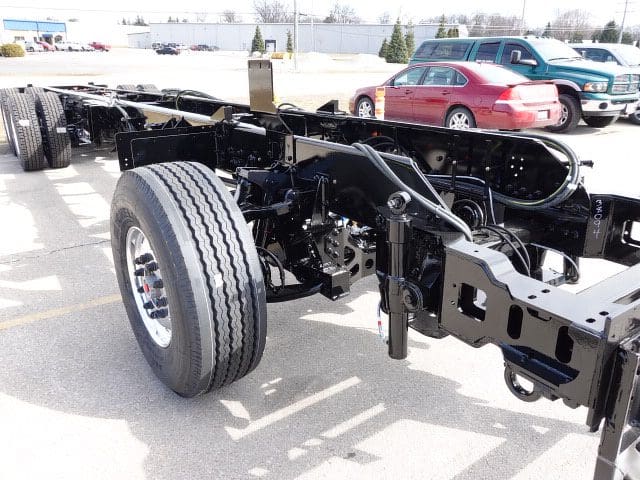

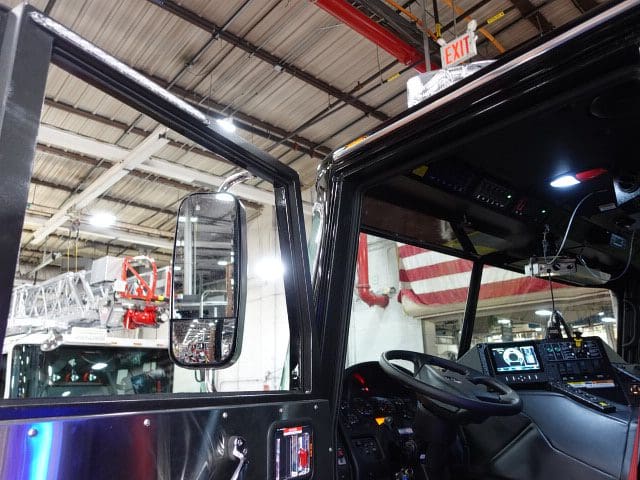

04-26-24
In this report, the apparatus was staged for aerial pin while the aerial device arrived and began initial assembly.

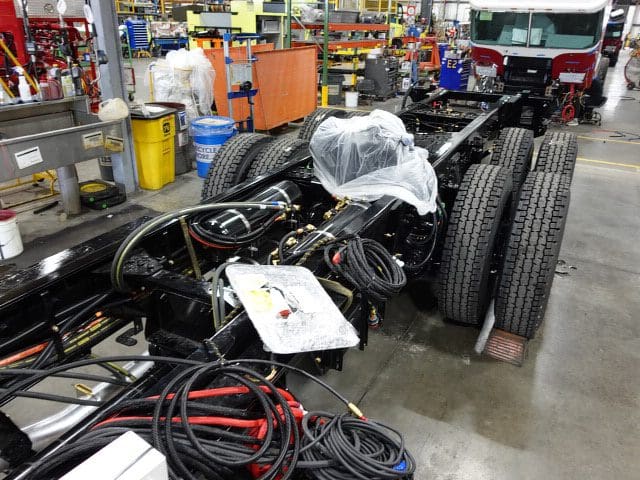

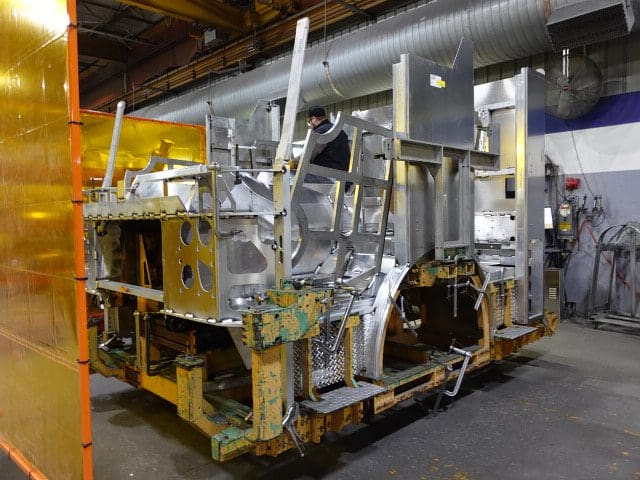

03-29-24

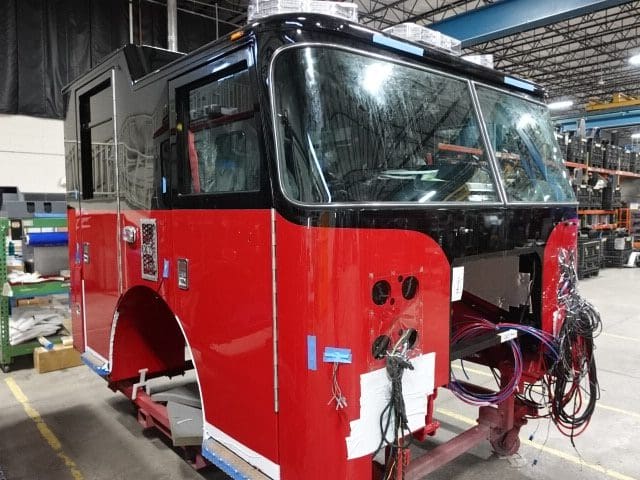

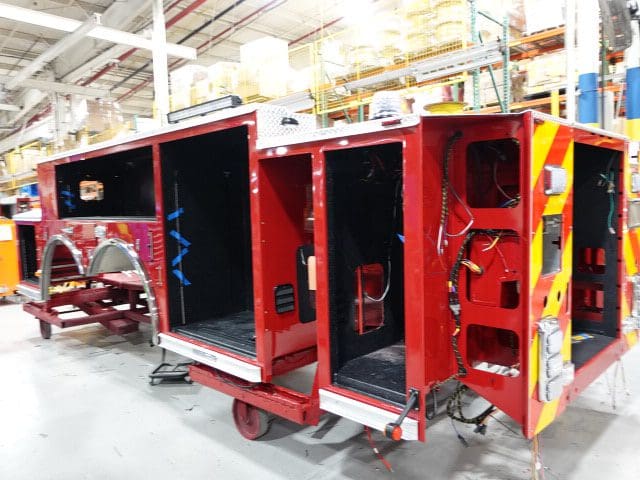

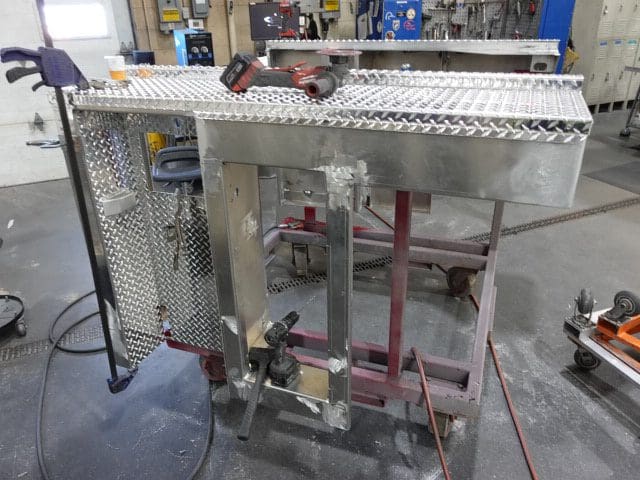

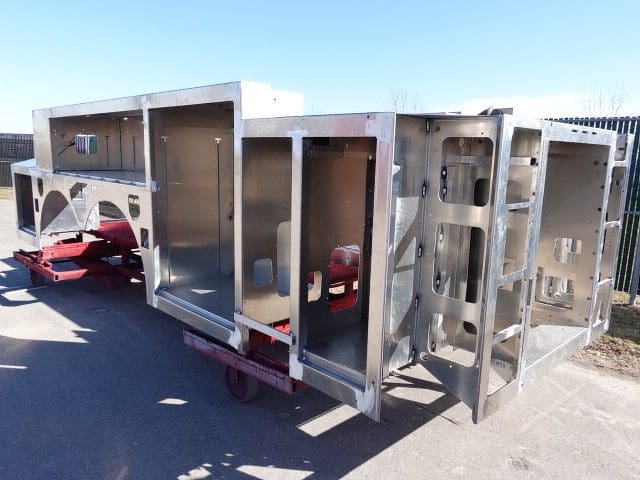

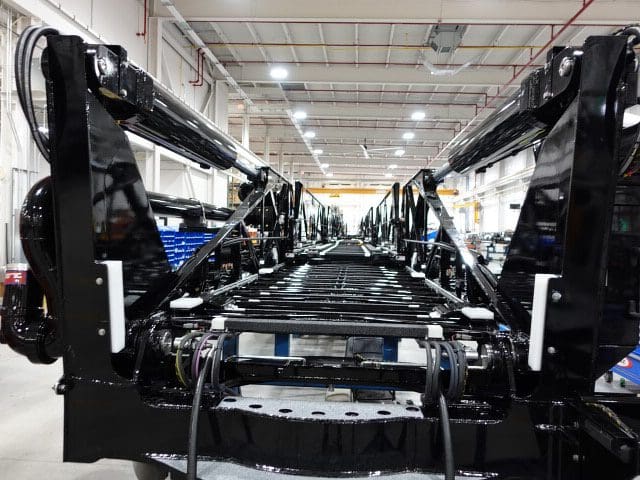

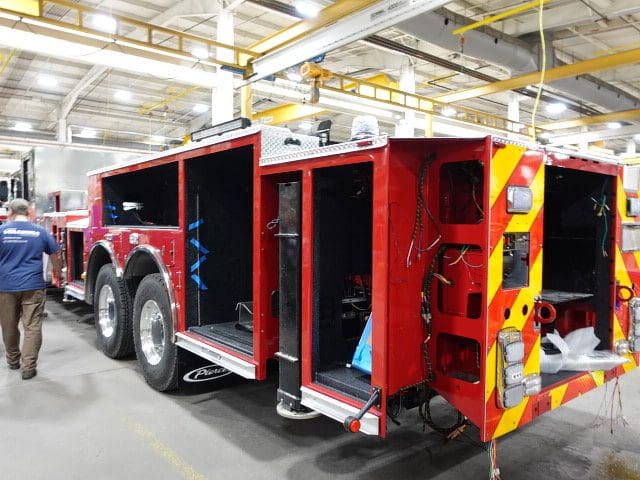

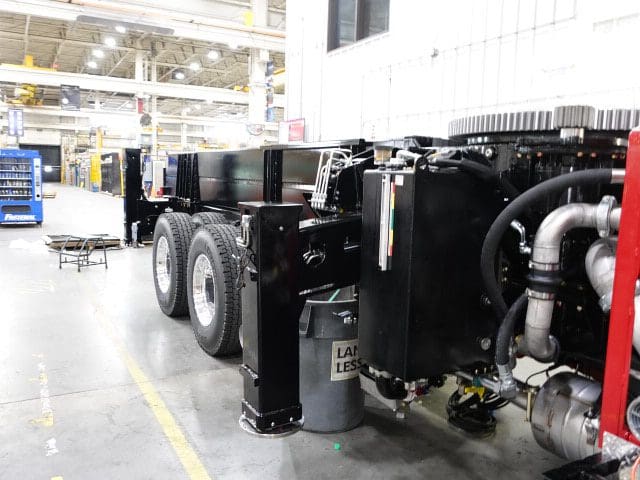

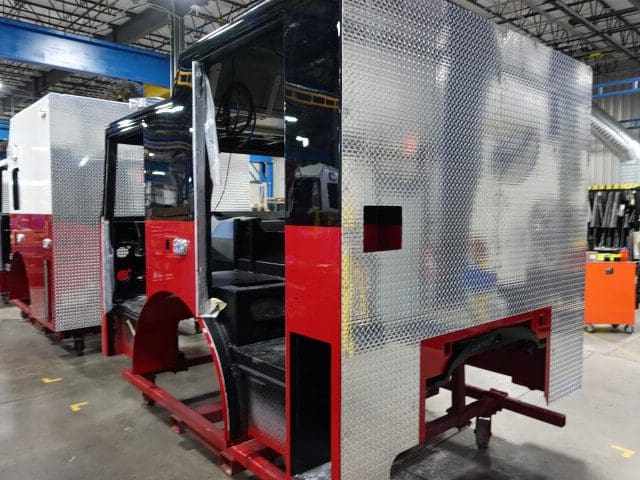

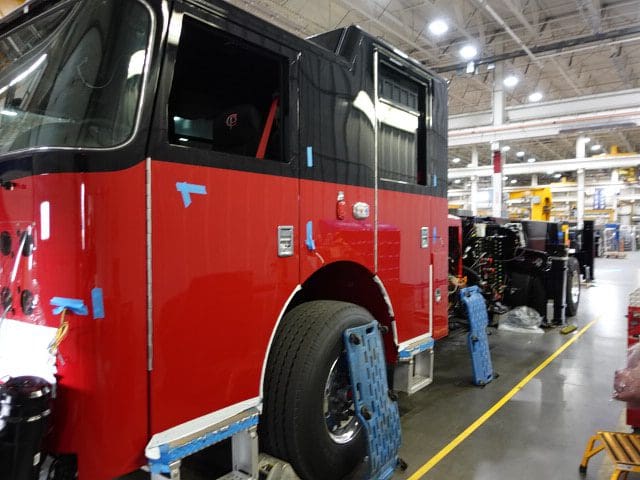

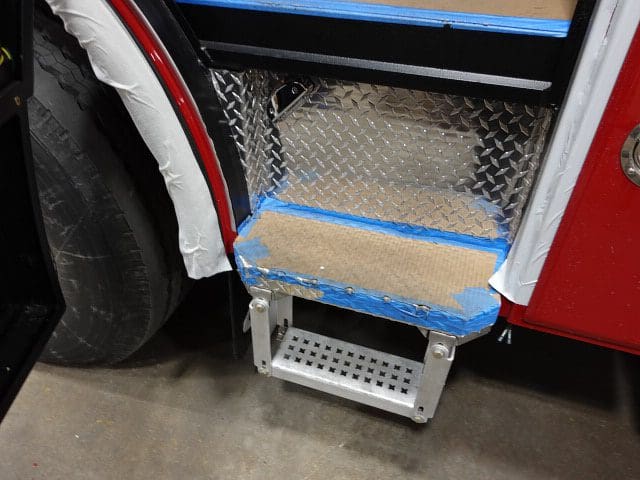

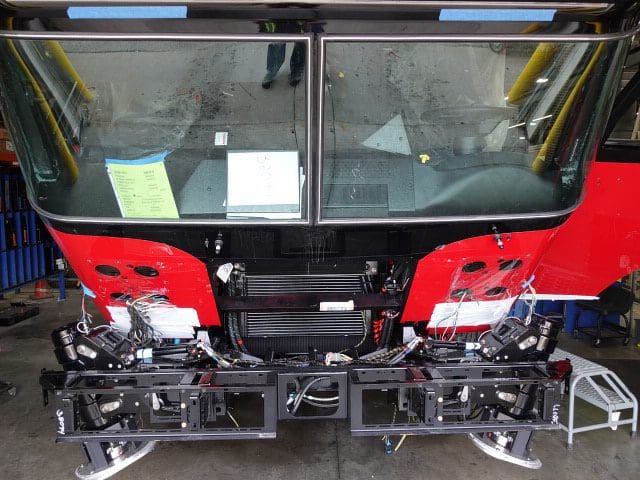

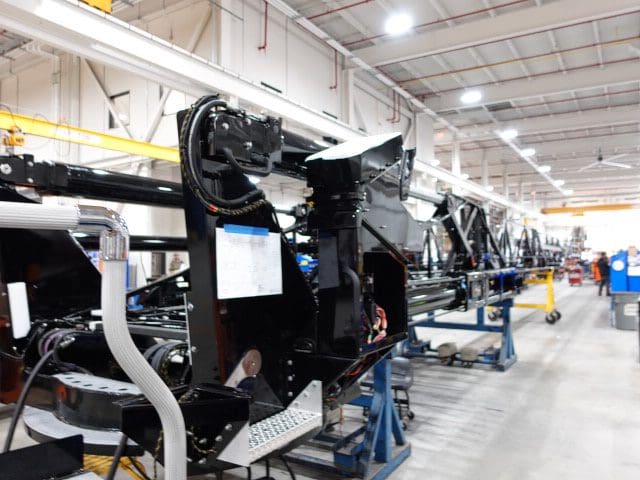

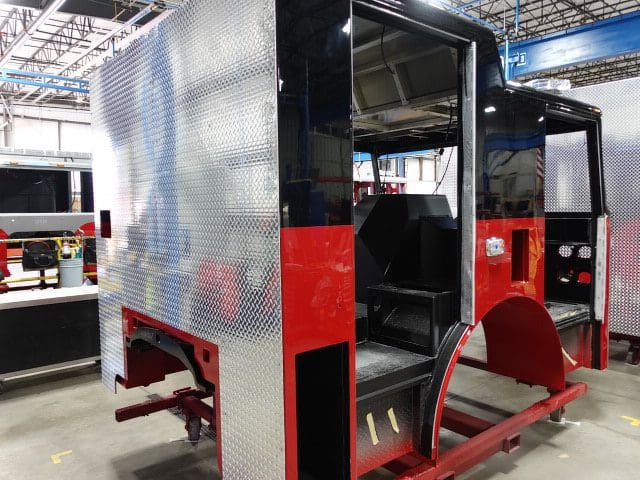

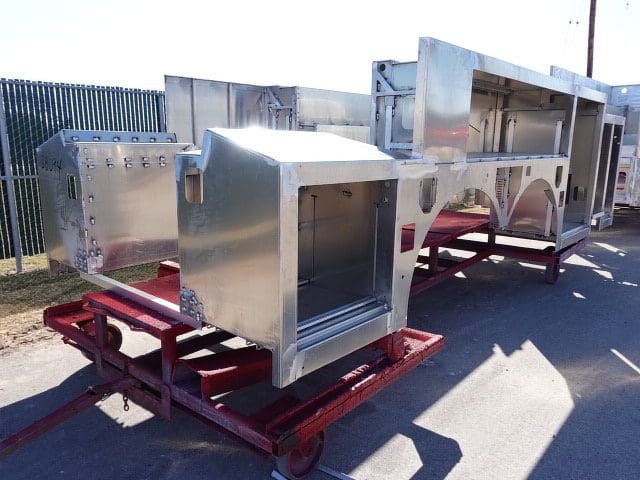

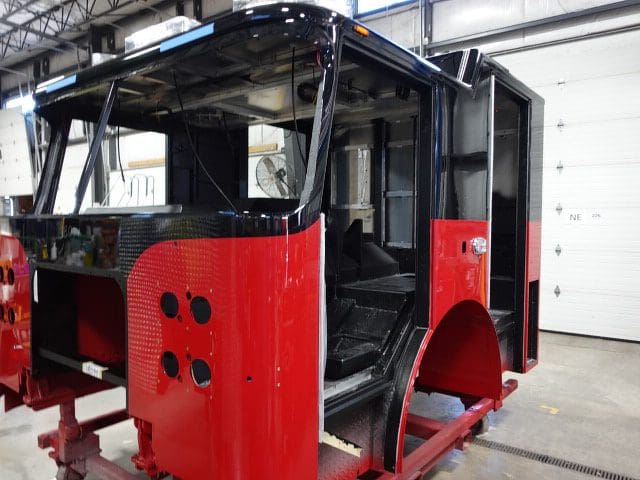

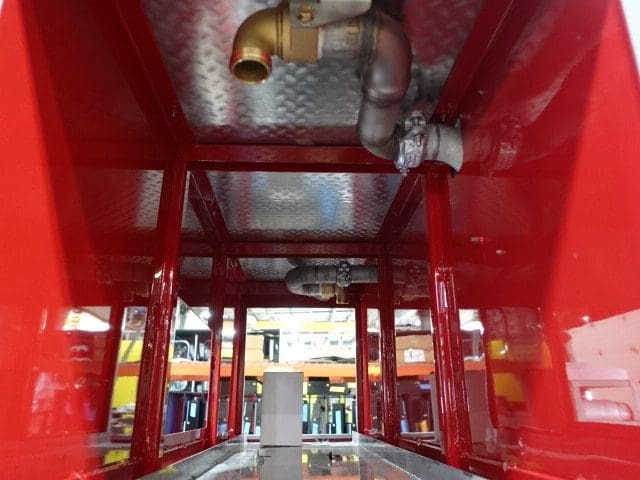

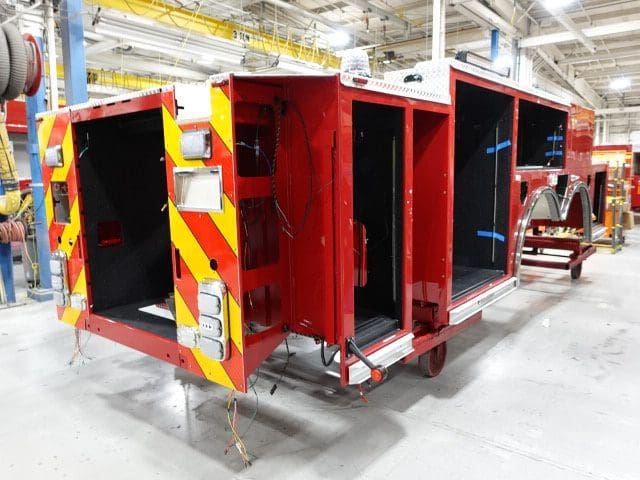

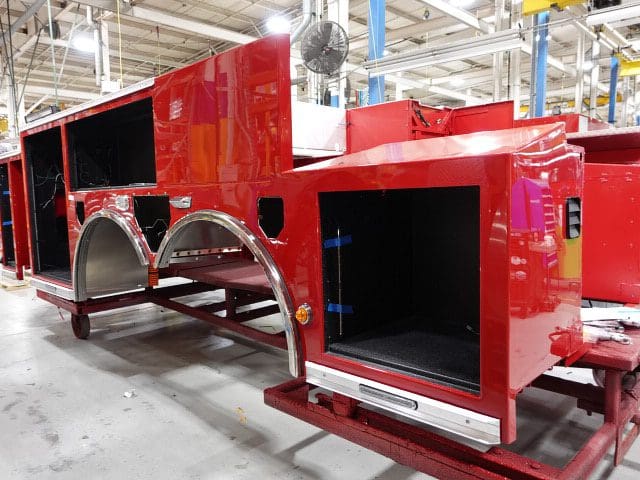

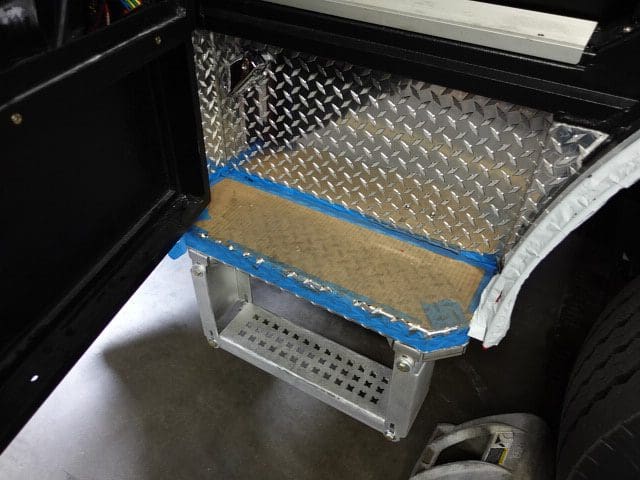

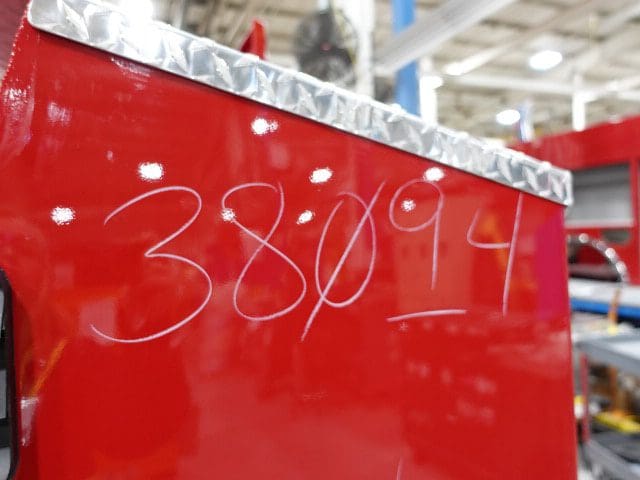

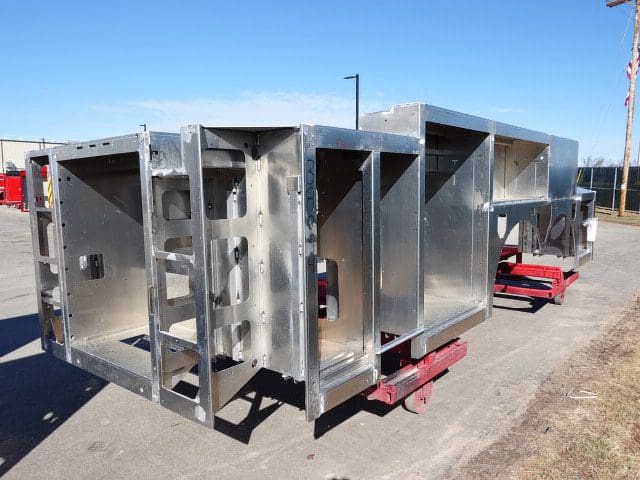

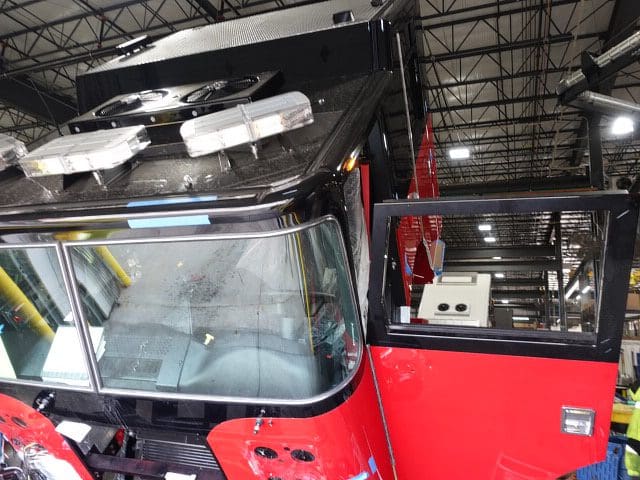

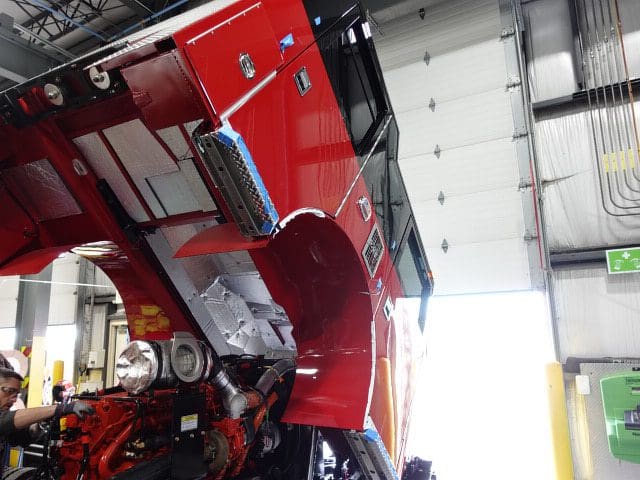

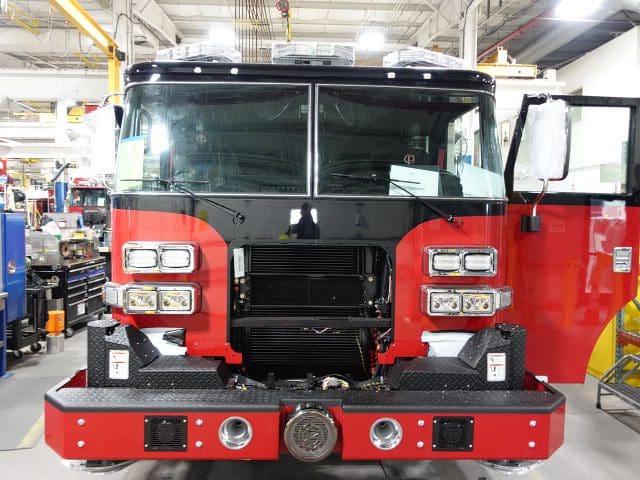

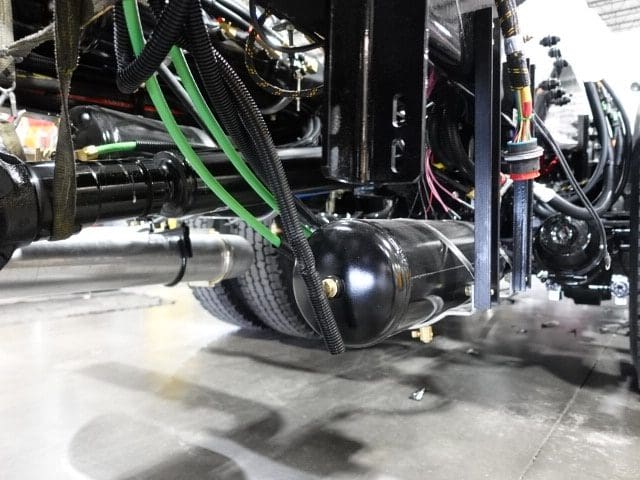

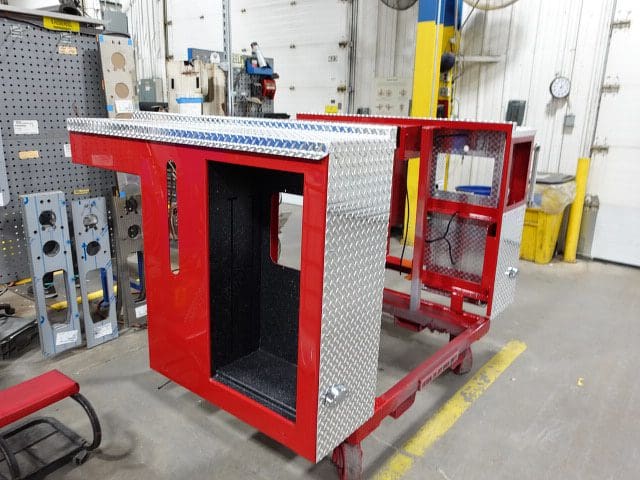

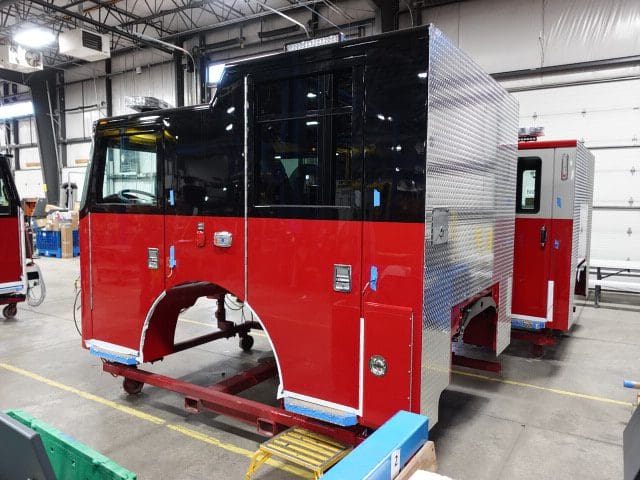

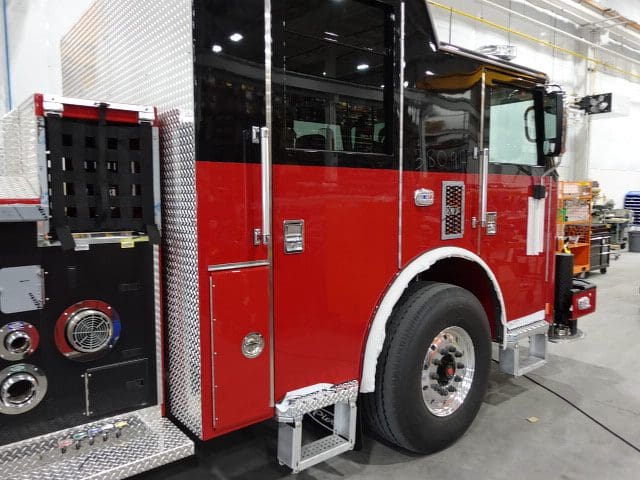

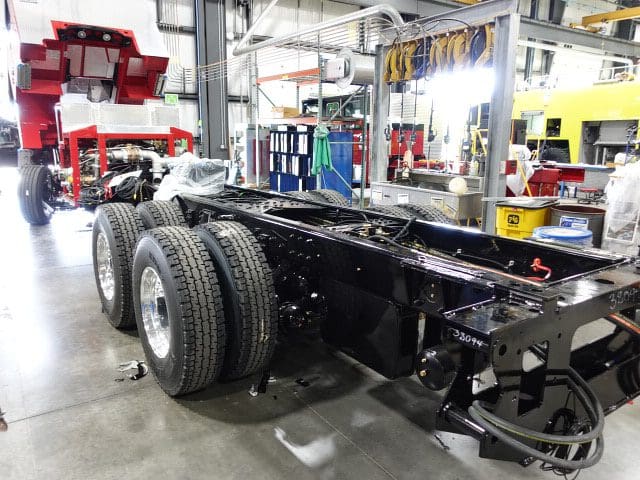

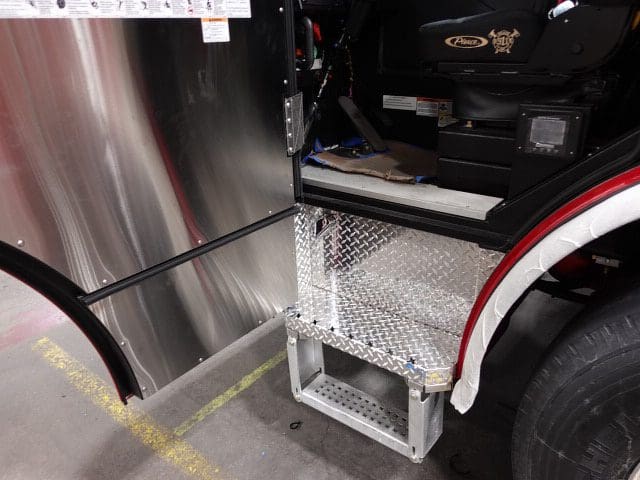

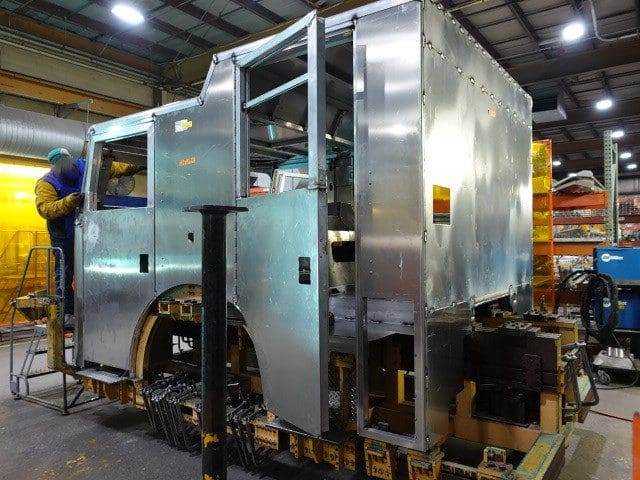

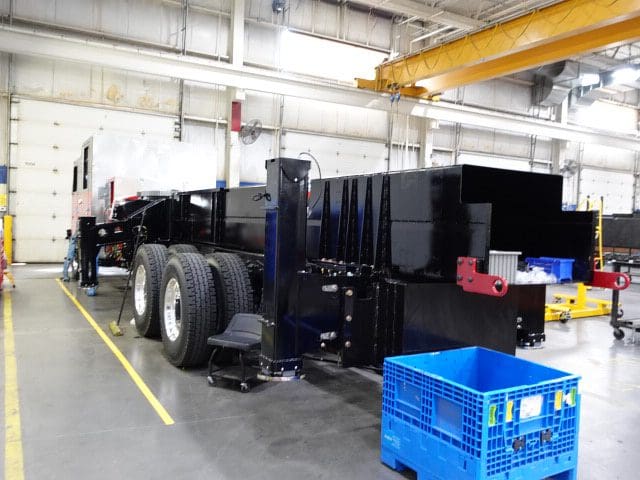

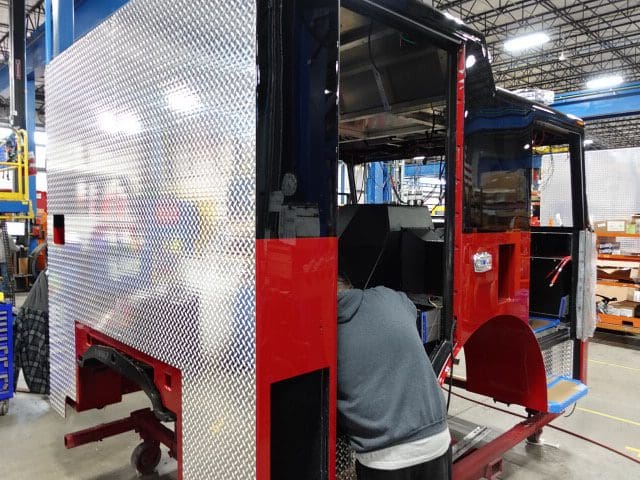

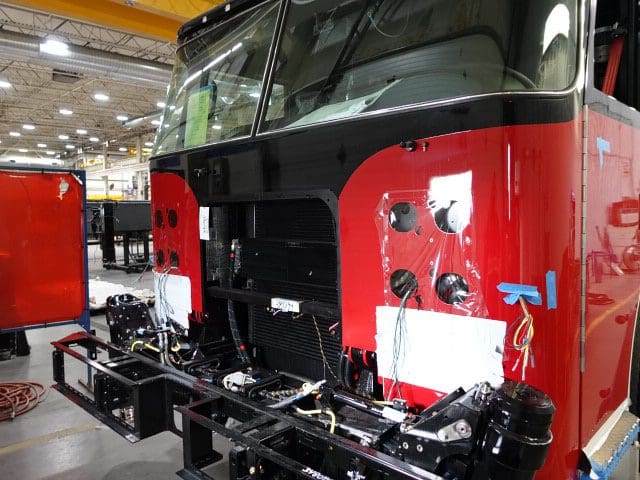

In this report, the front and rear body modules completed initial assembly and were merged with the chassis followed by the start of final assembly.
03-22-24

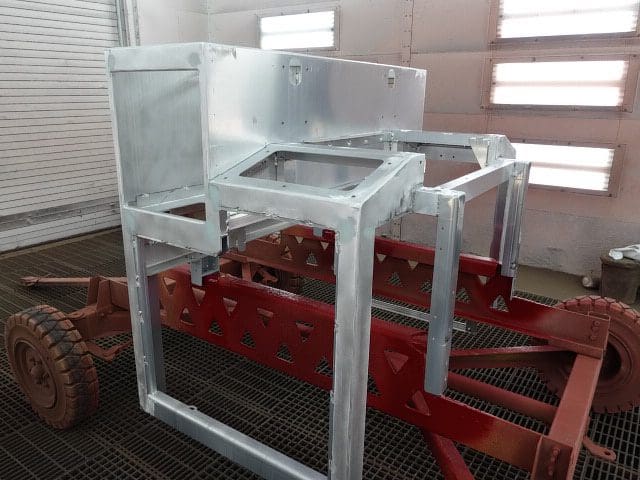

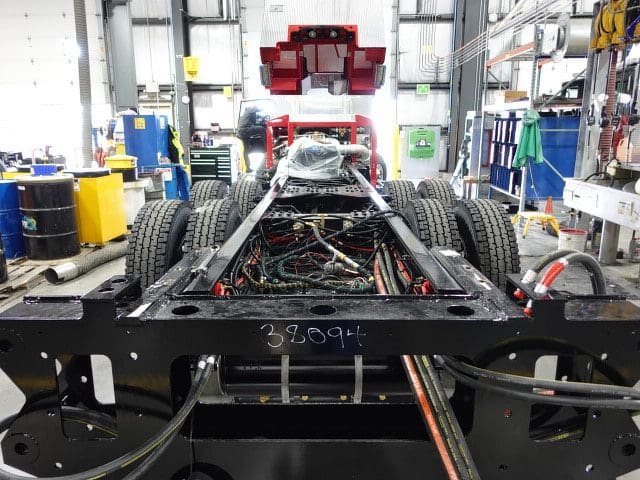

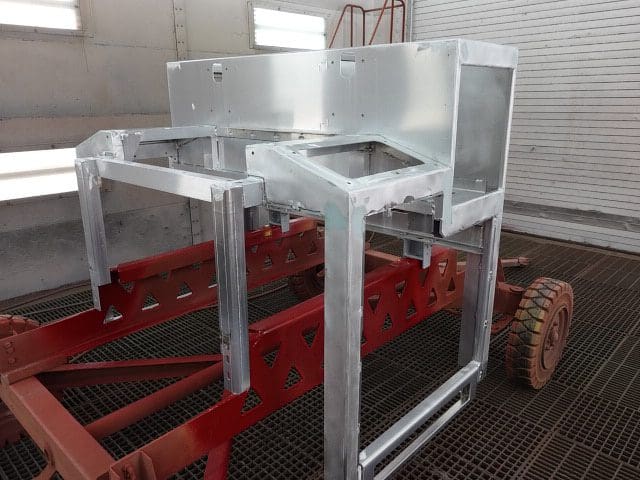

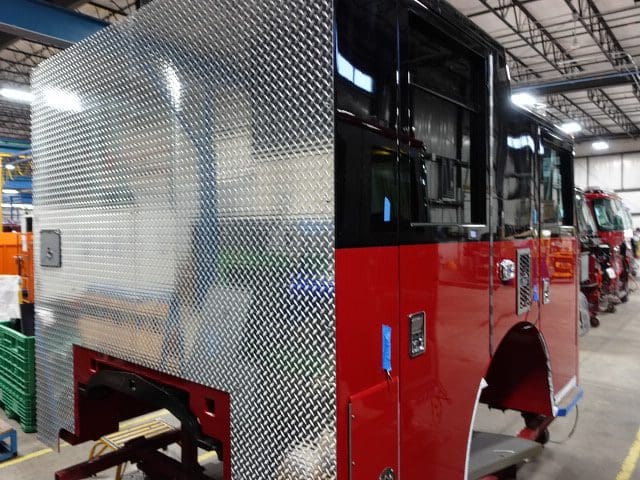

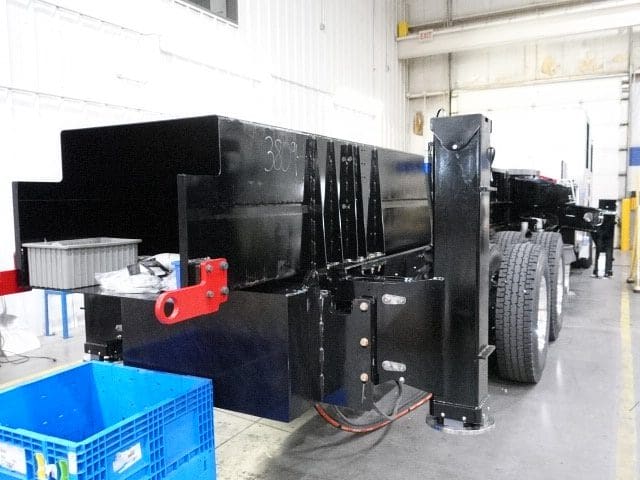

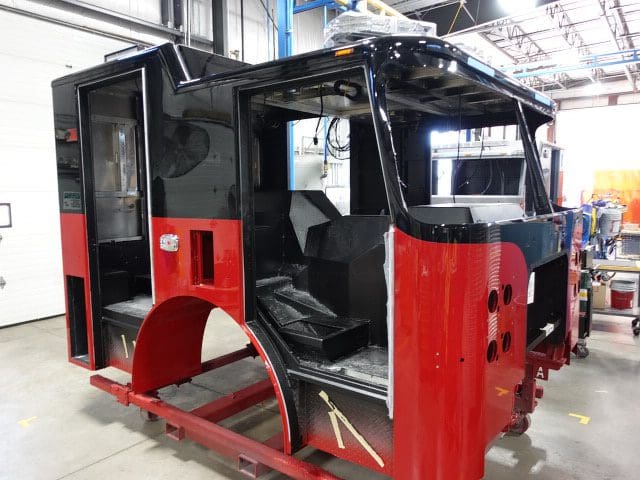

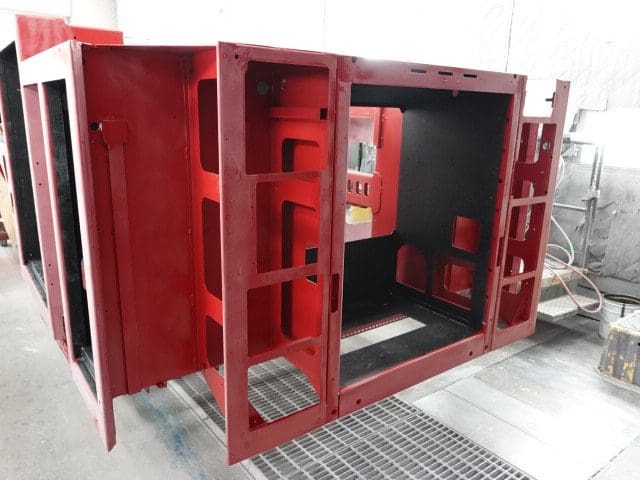

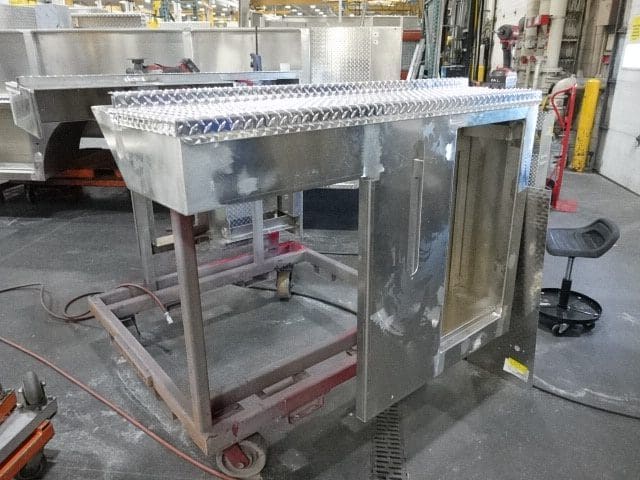

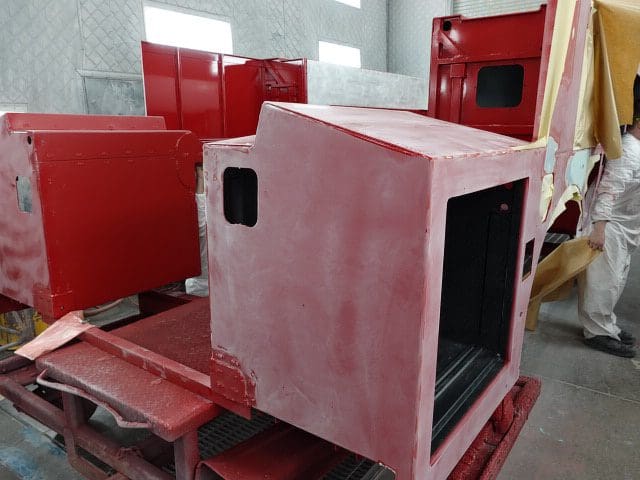

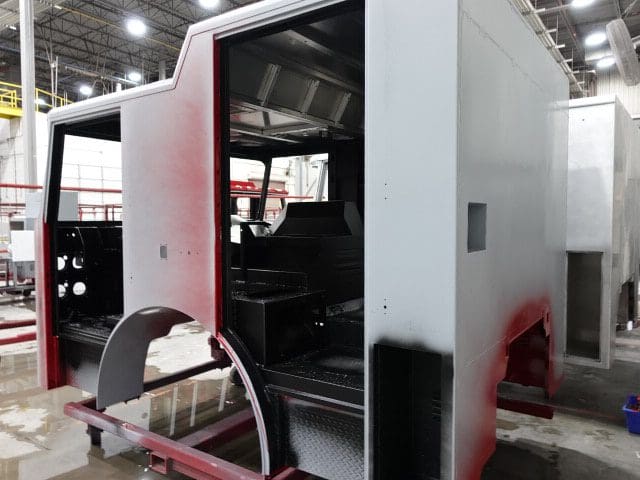

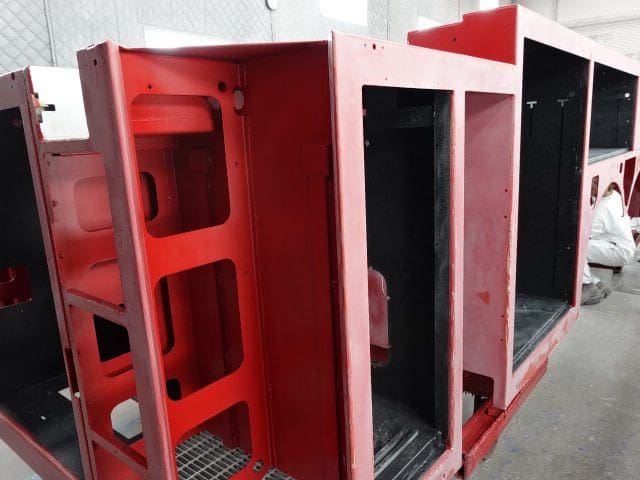

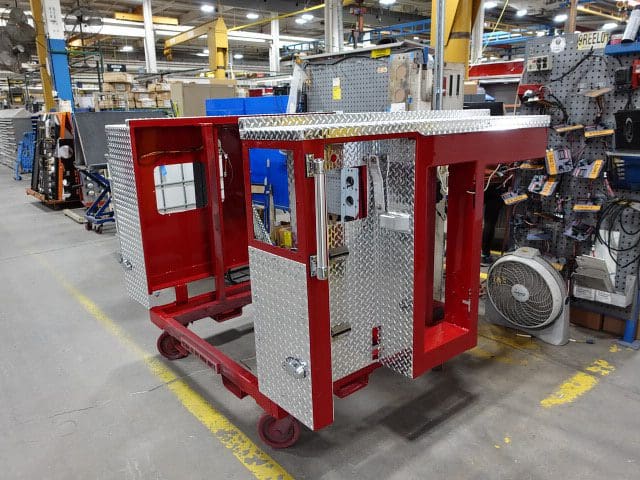

In this report, the torque box was installed on the chassis and assembly continued while the front and rear body modules completed paint and began initial assembly.
03-15-24

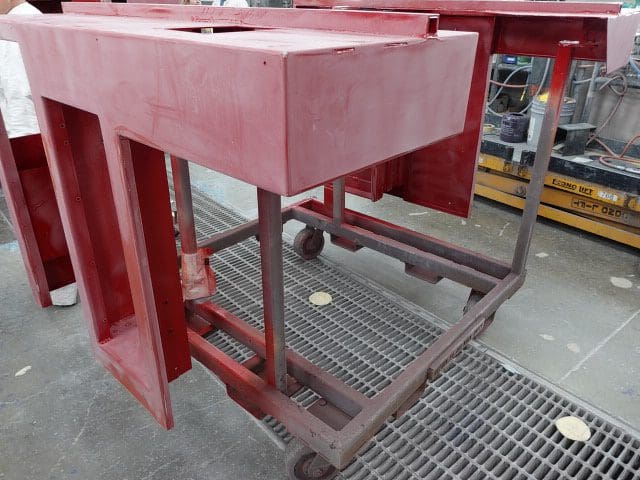

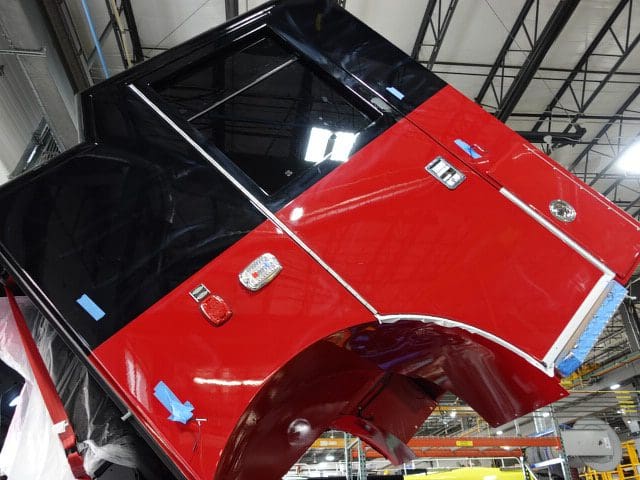

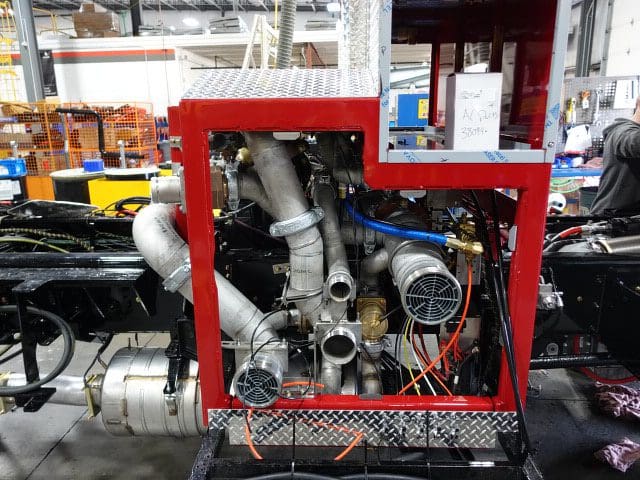

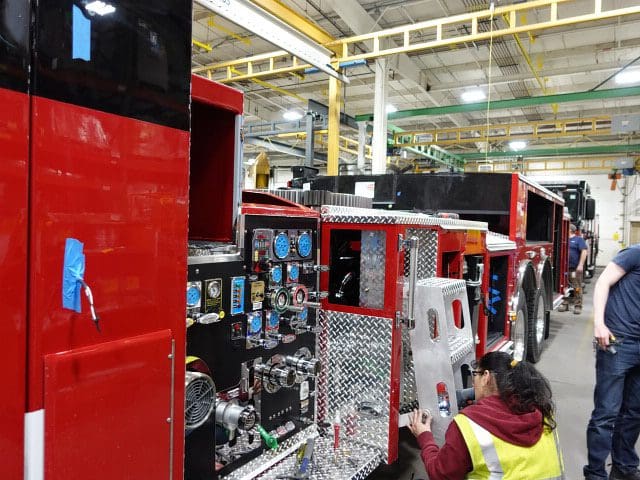

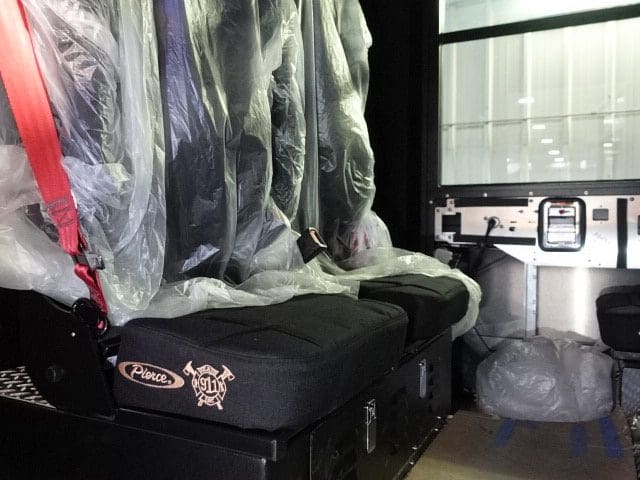

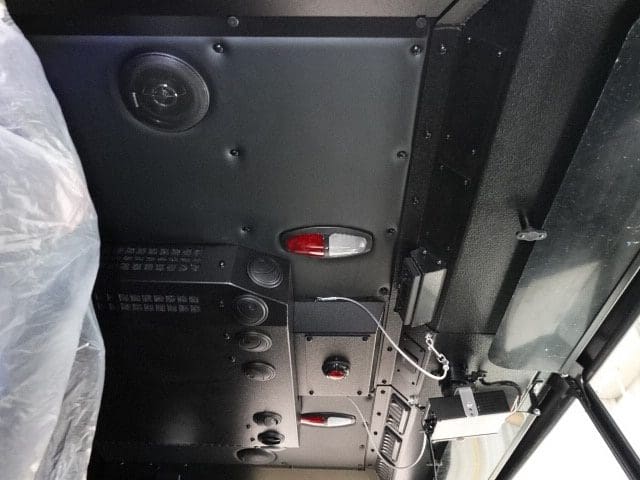

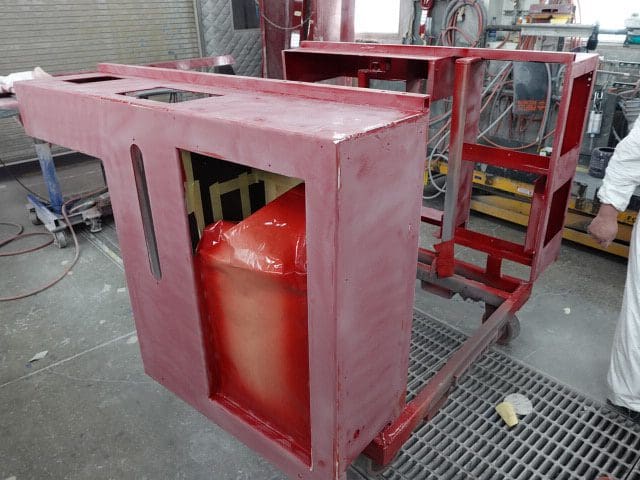

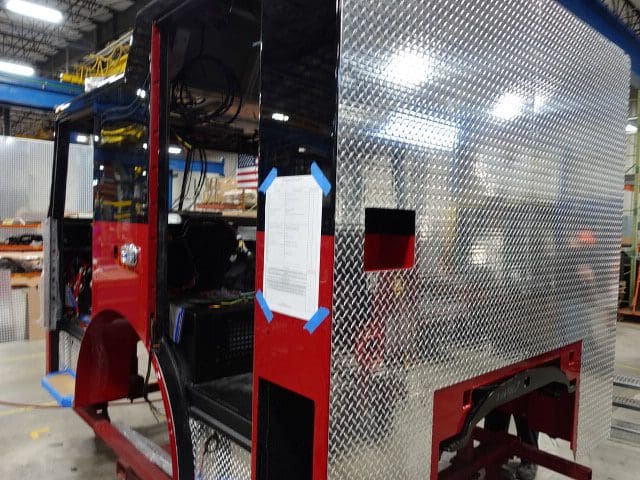

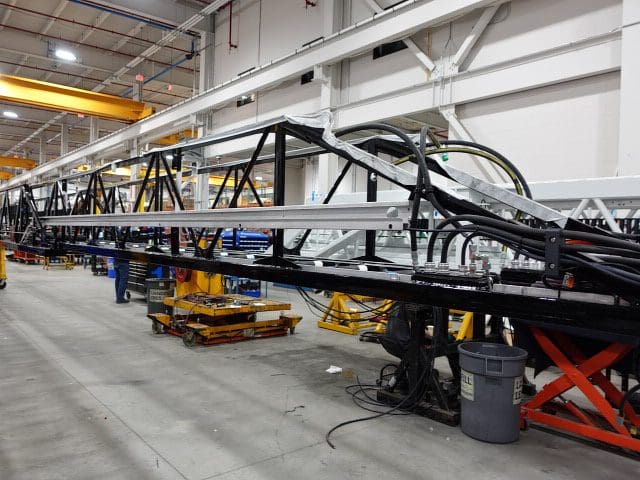

In this report, the cab and pump house were installed on the frame, the torque box began initial assembly, the front body module completed fabrication and began the paint process, and the rear body module continued the paint process.
03-08-24

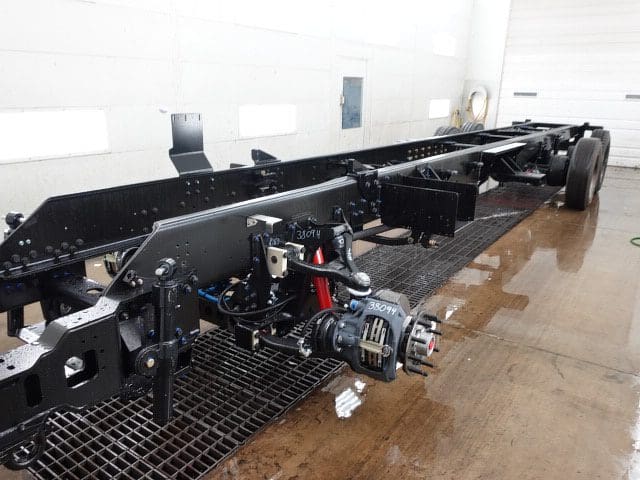

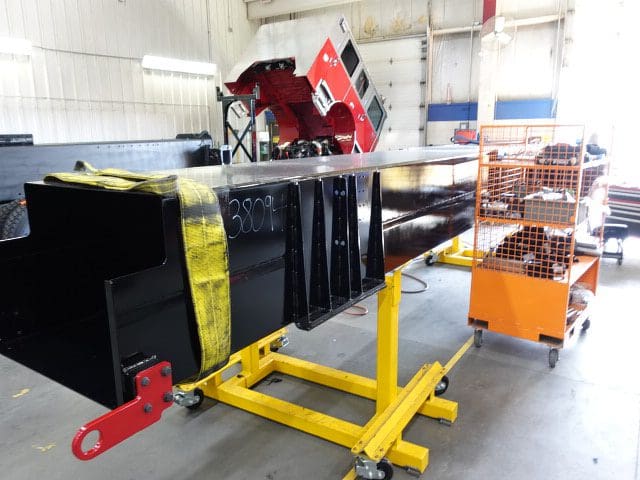

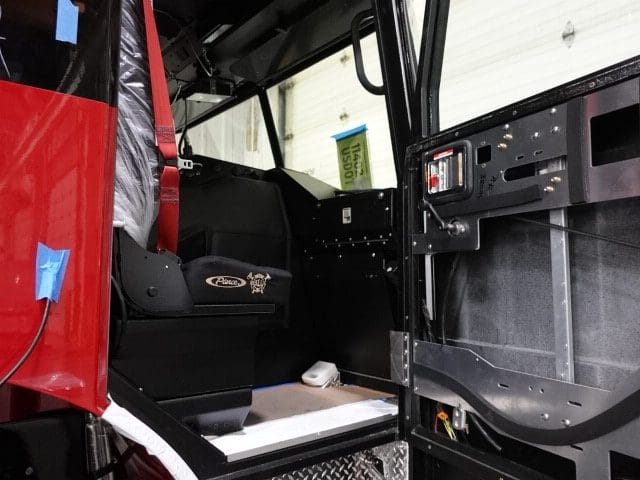

In this report, the cab continued initial assembly, the frame build continued, the pump house structure was fabricated and began the paint process, the front body module began fabrication, and the rear body module was fabricated and released to paint.
03-01-24

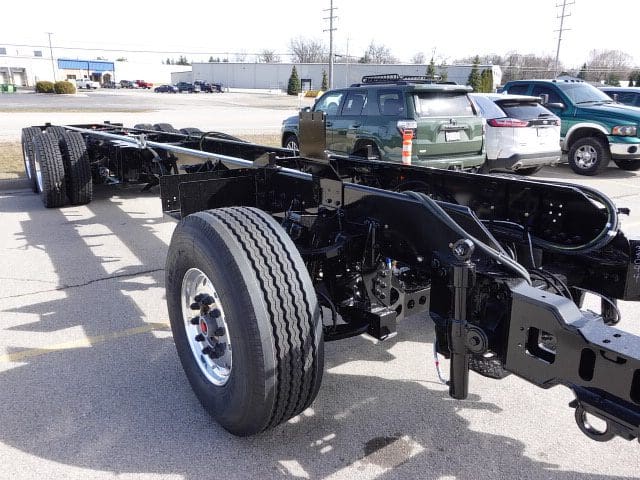

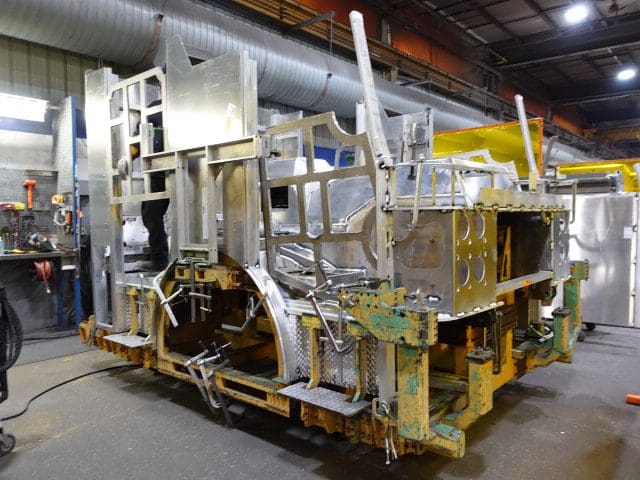

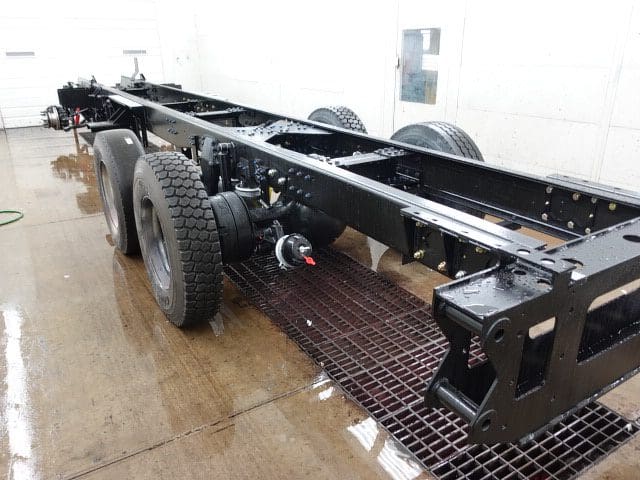

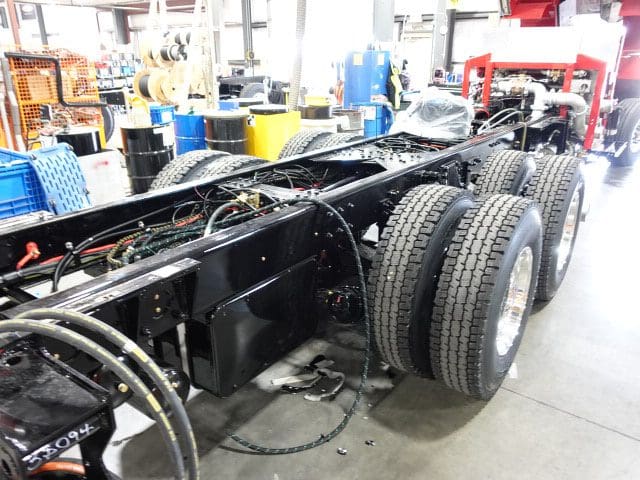

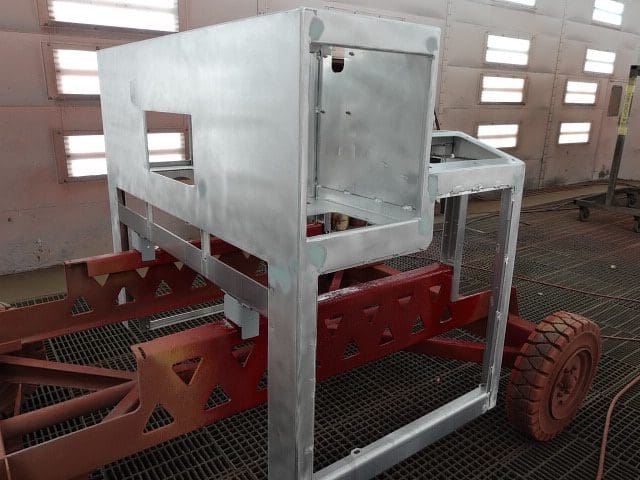

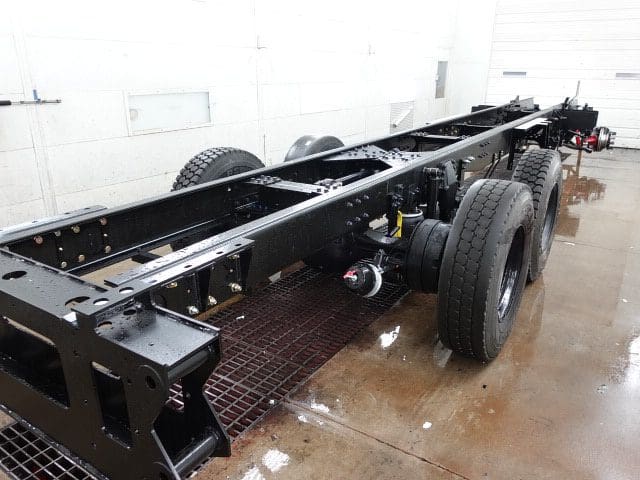

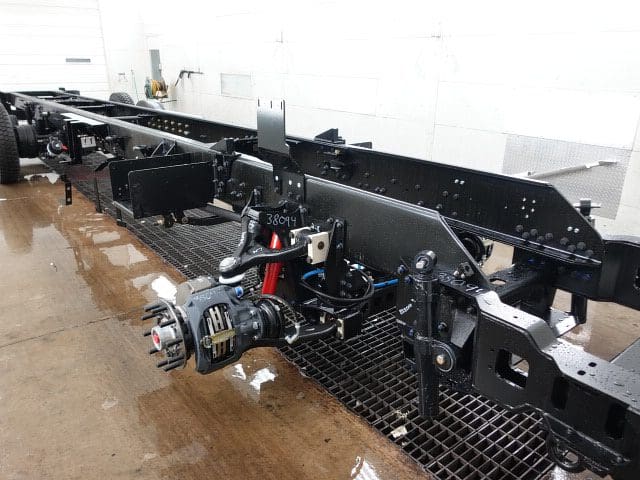

In this report, the cab continued initial assembly while the frame build continued.

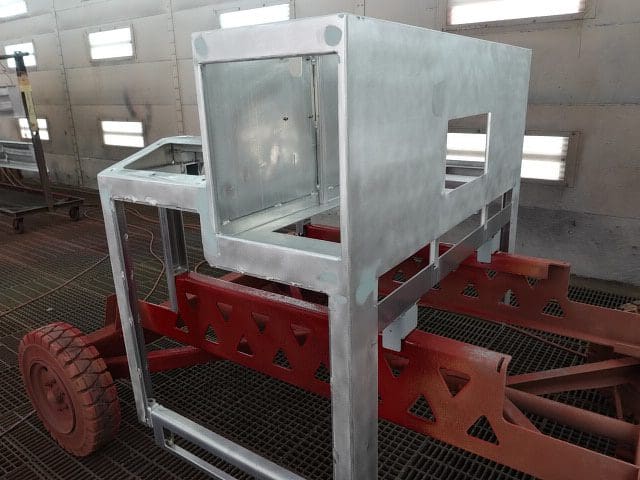

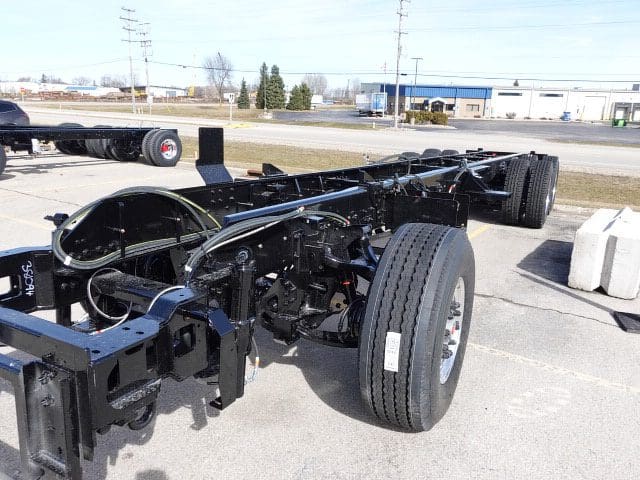

02-23-24

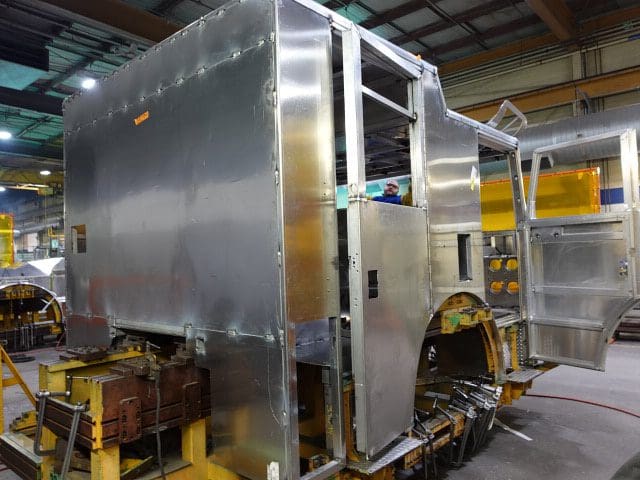

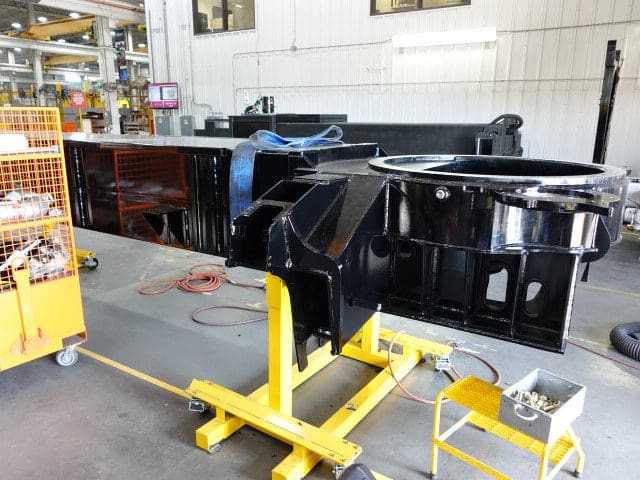

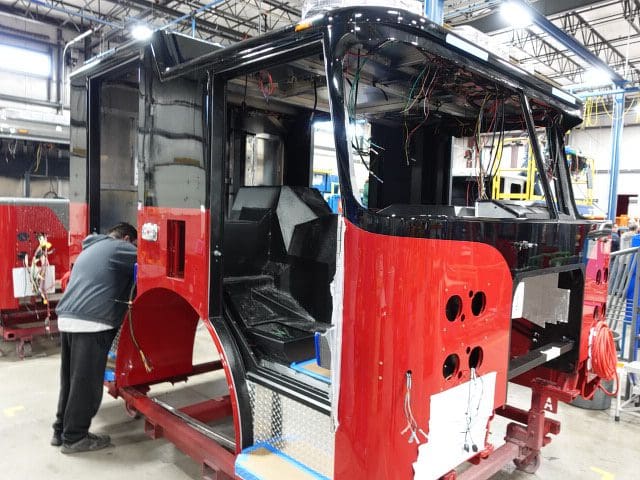

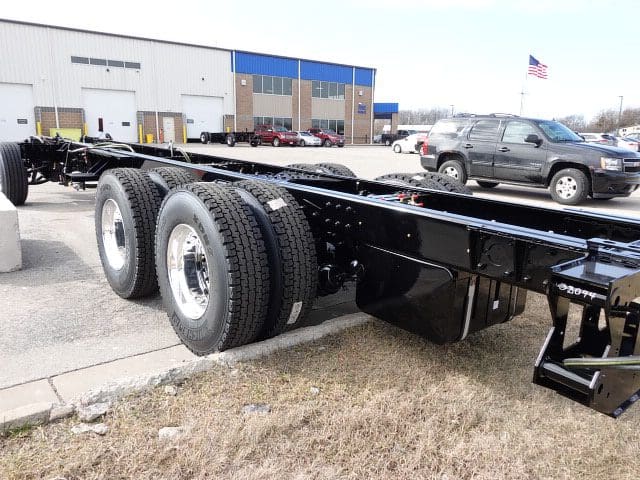

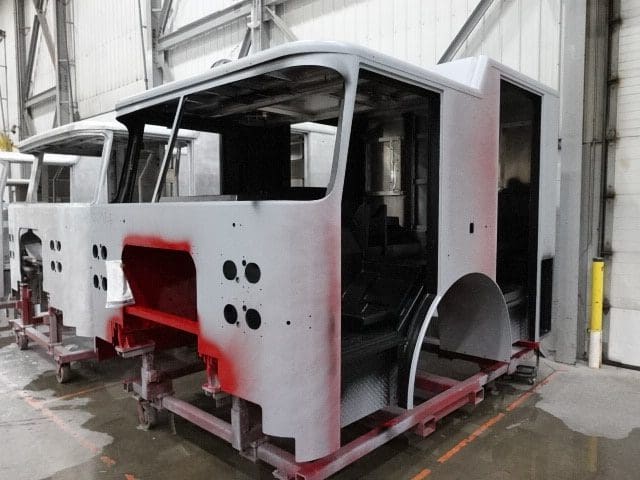

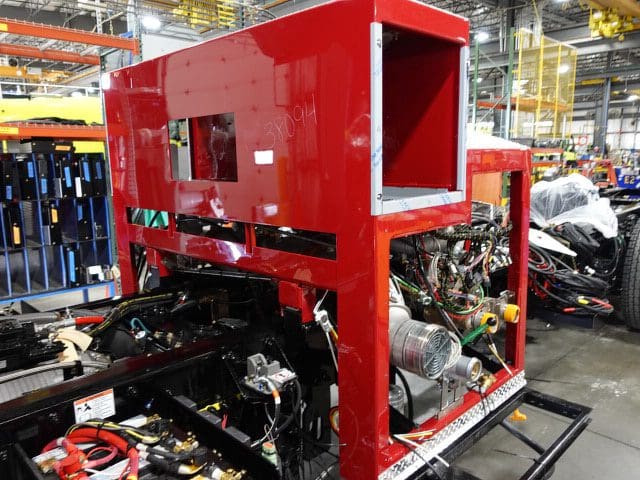

In this report, the cab completed the paint process and began initial assembly while the frame build began.

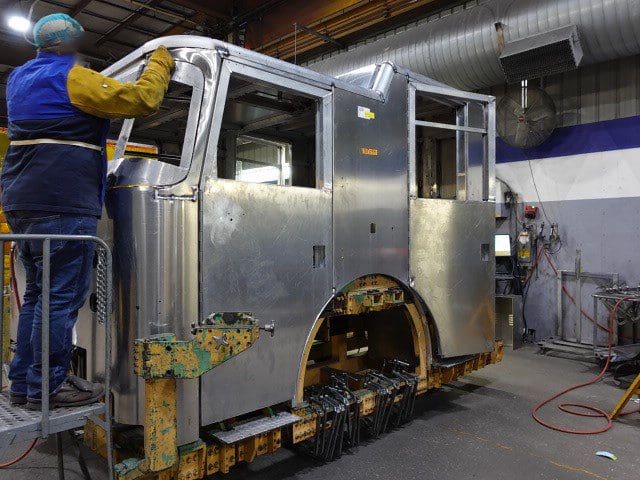

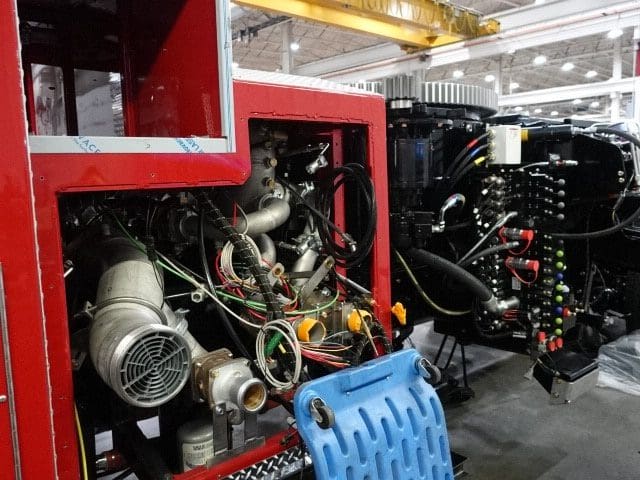

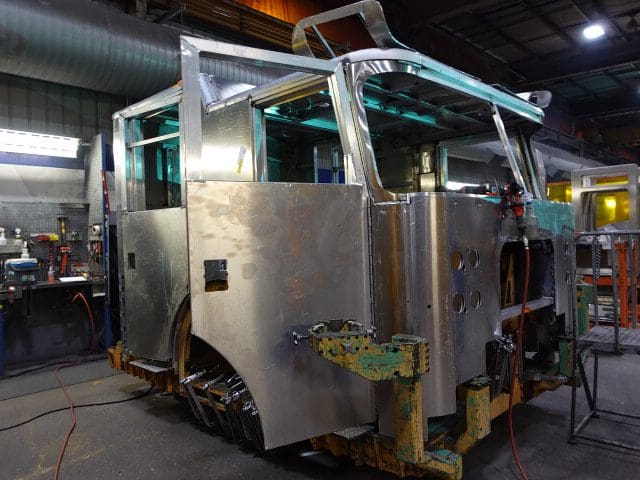

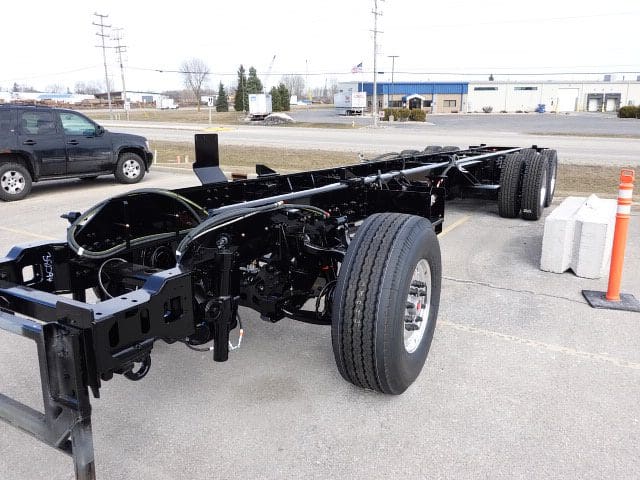

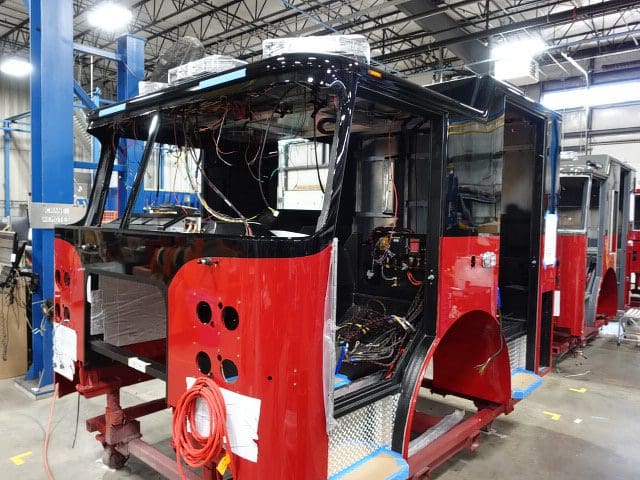

02-09-24
This new Pierce apparatus is now in production! In this report, the cab began fabrication.
