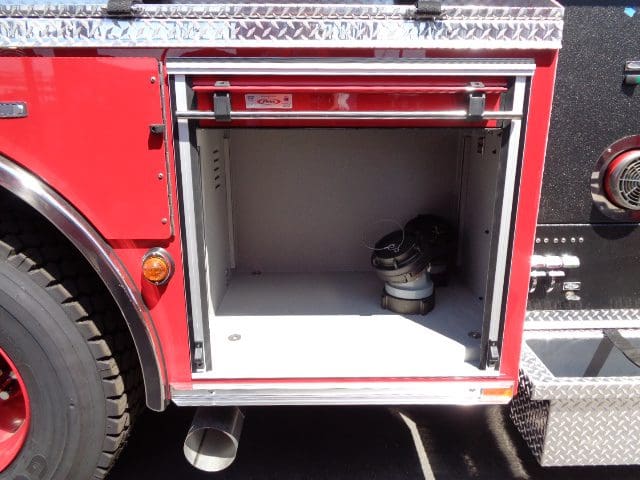

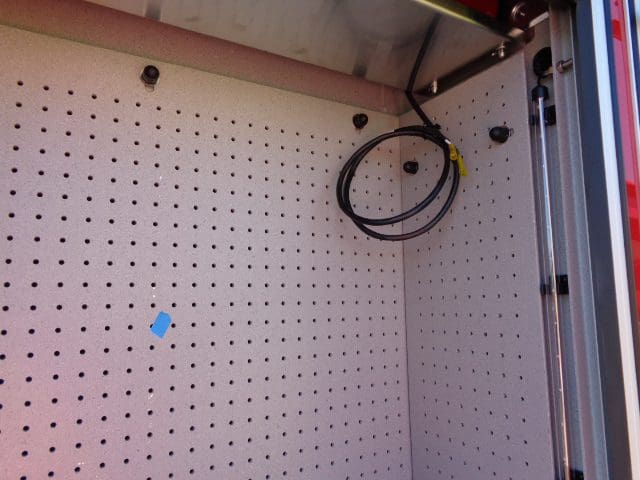

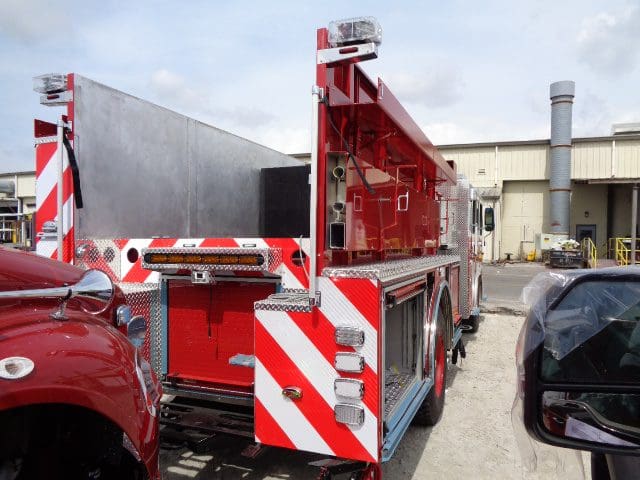

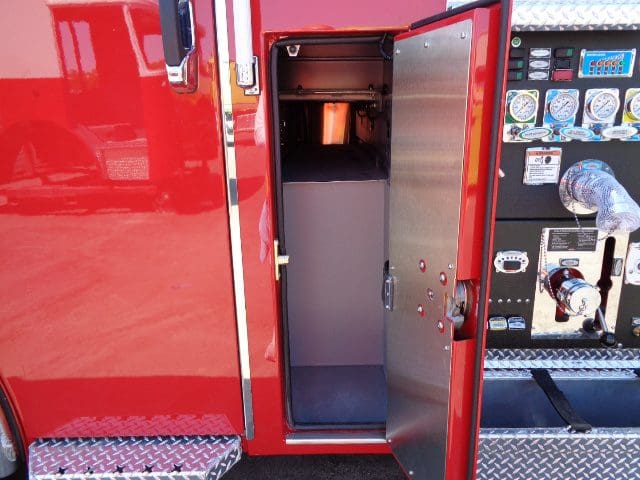

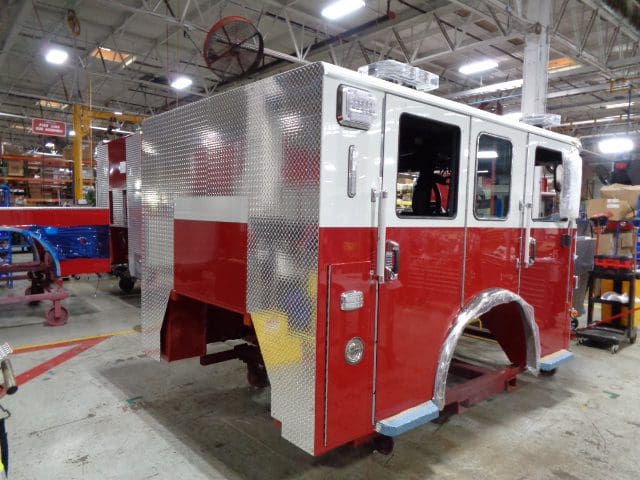

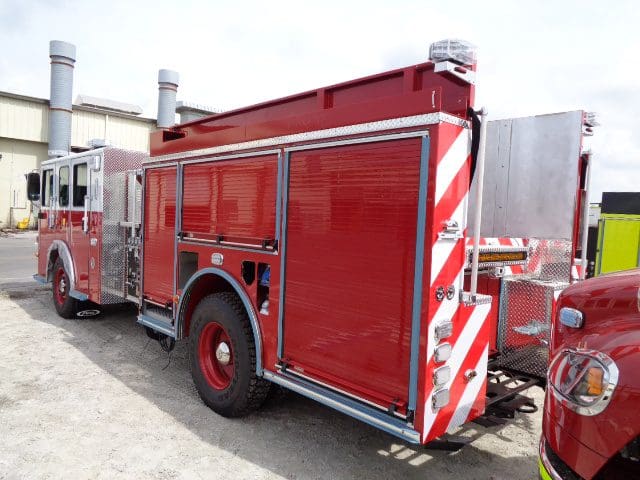

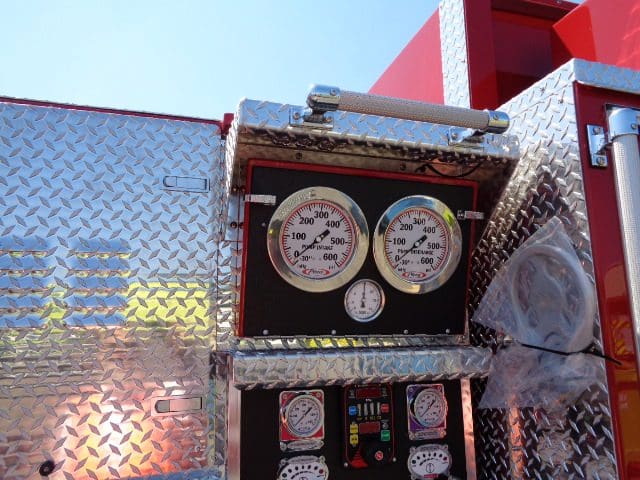

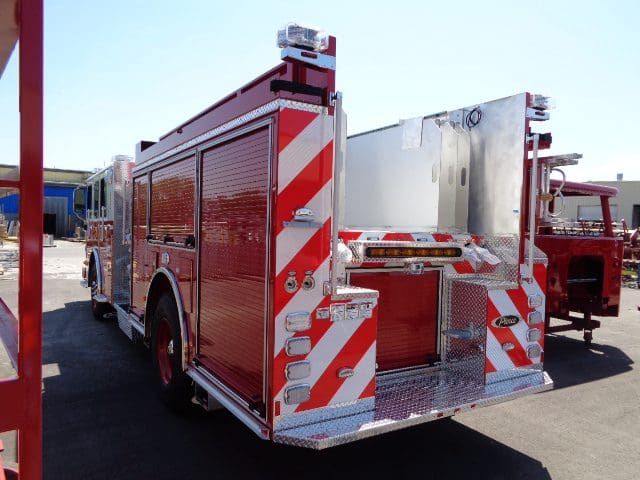

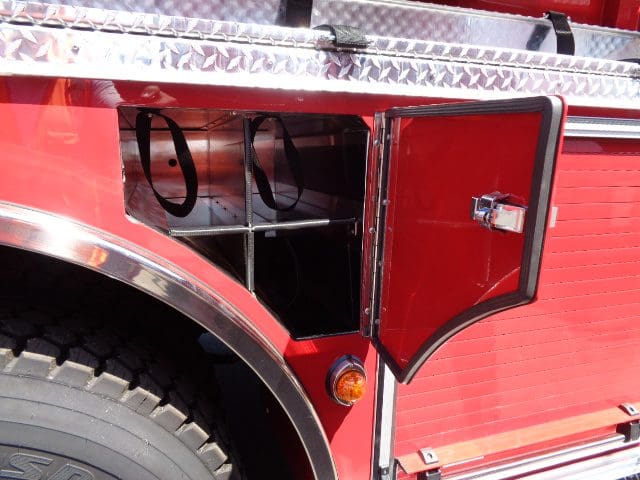

03-22-24

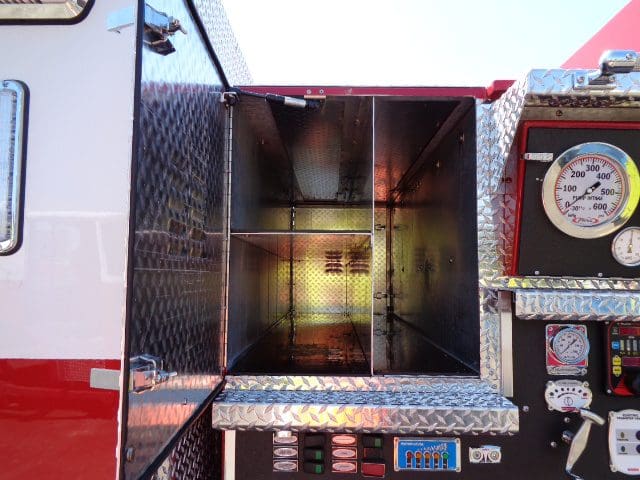

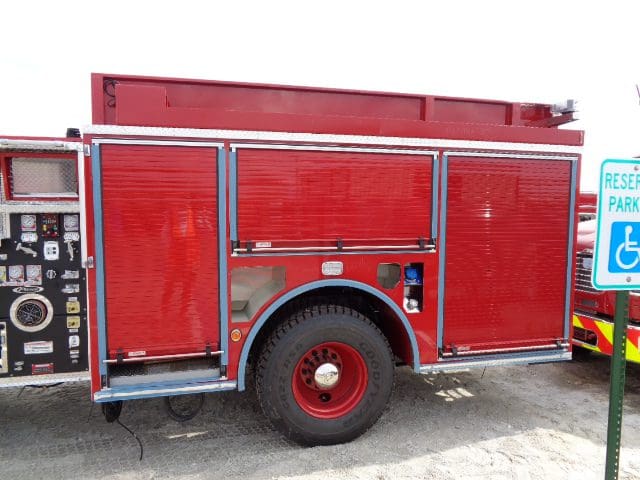

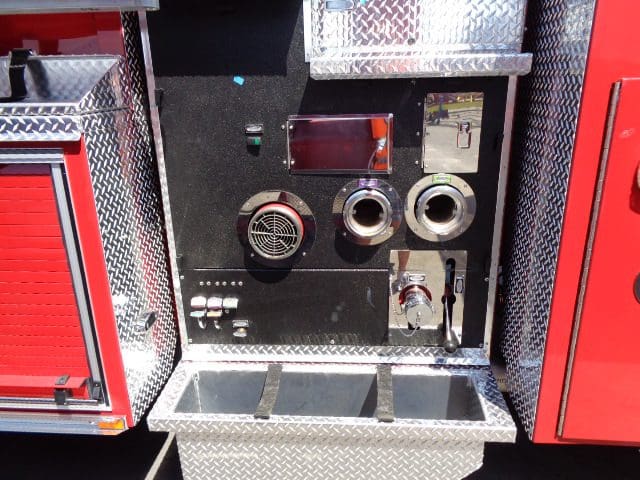

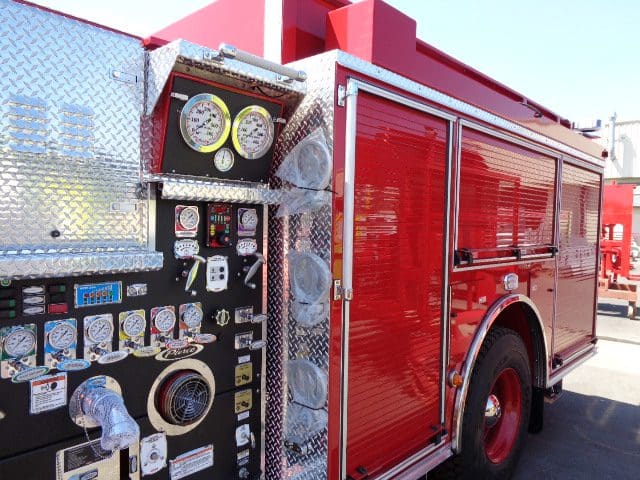

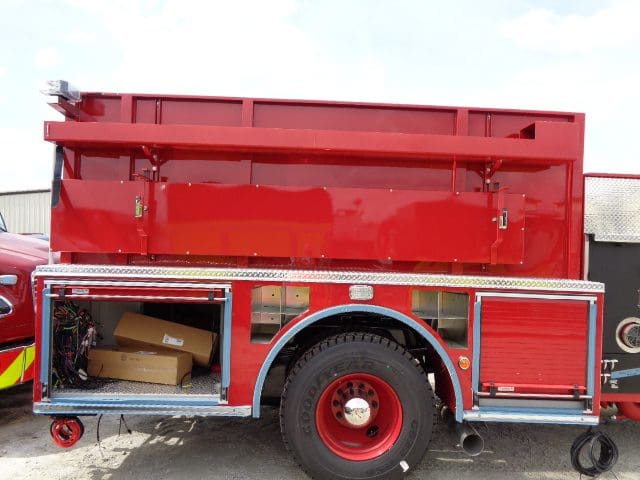

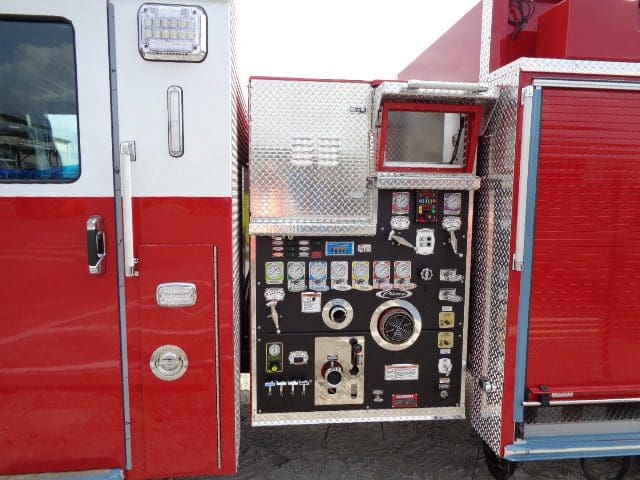

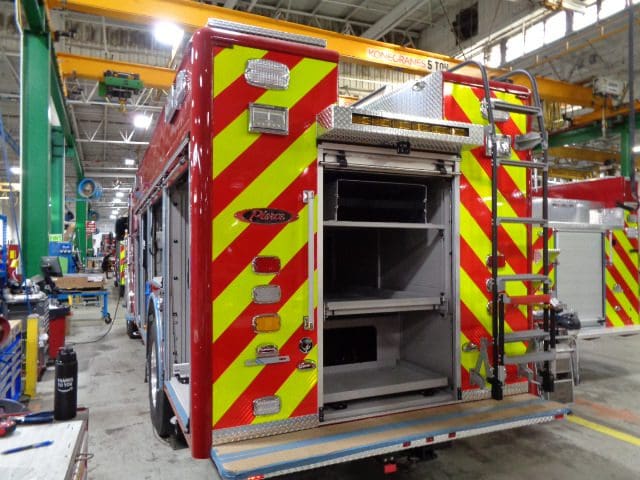

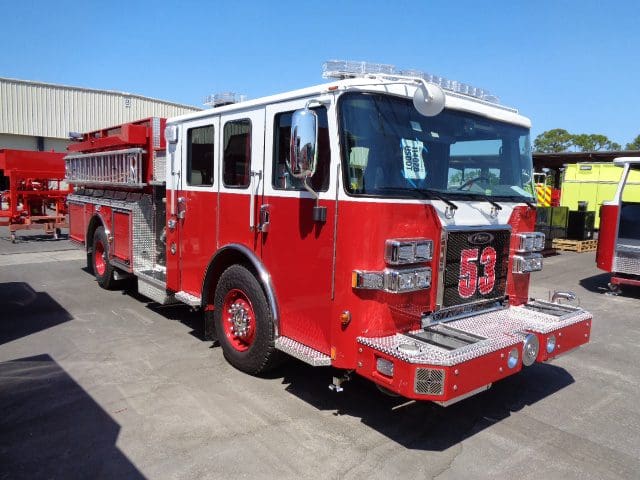

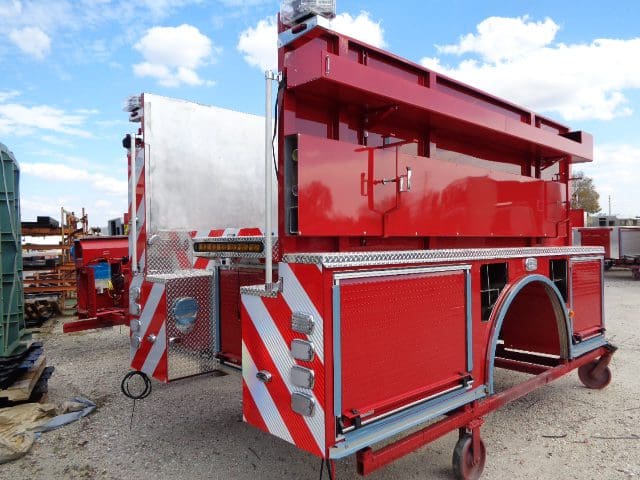

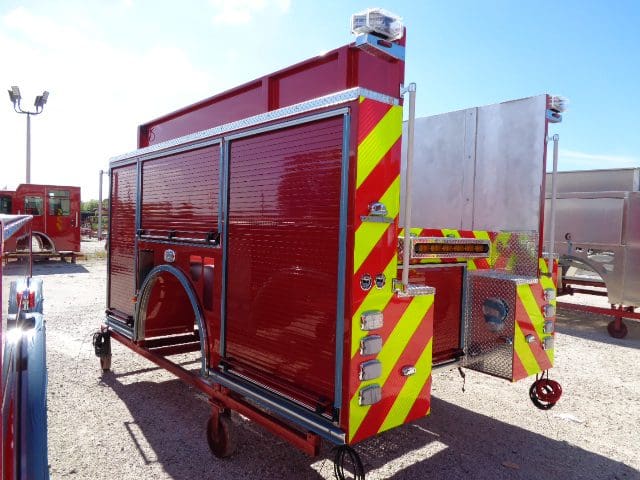

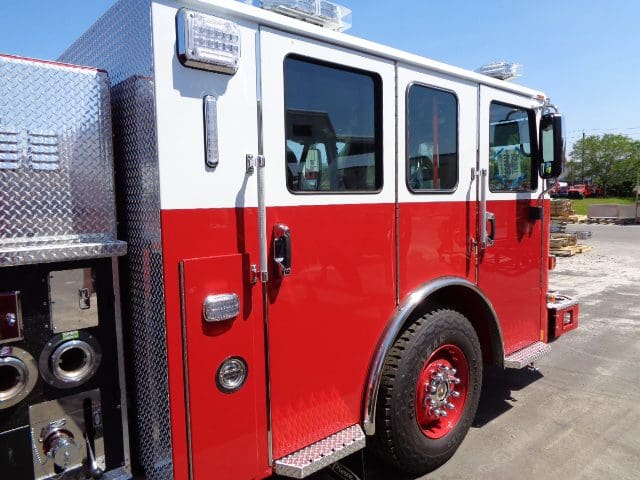

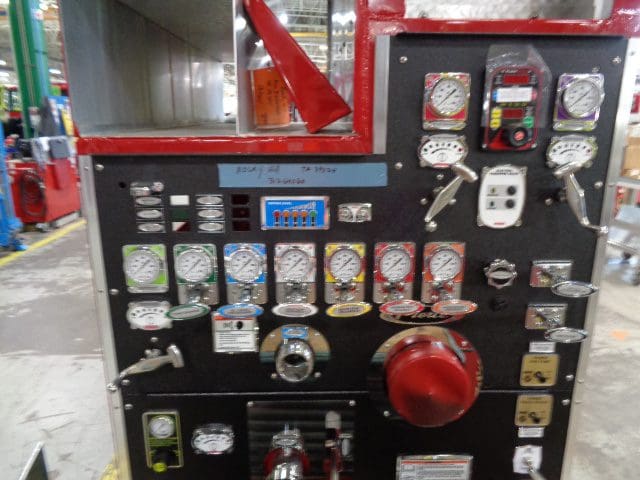

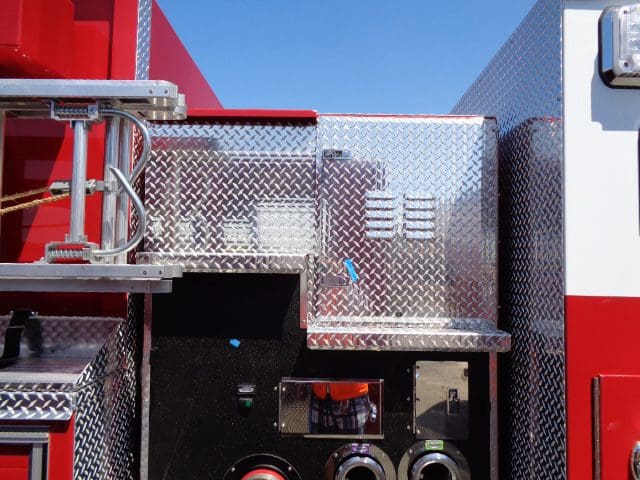

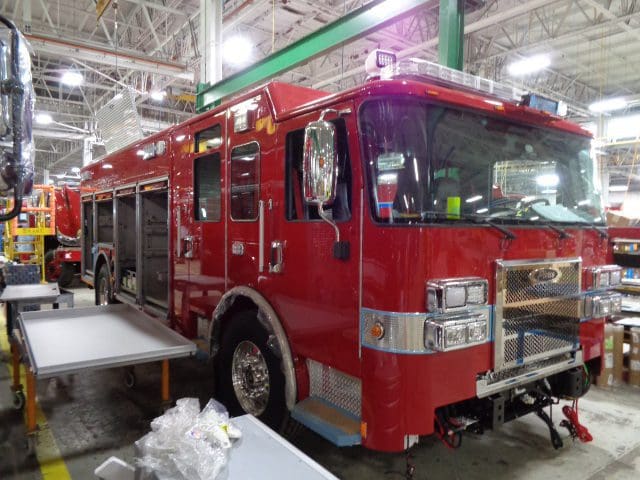

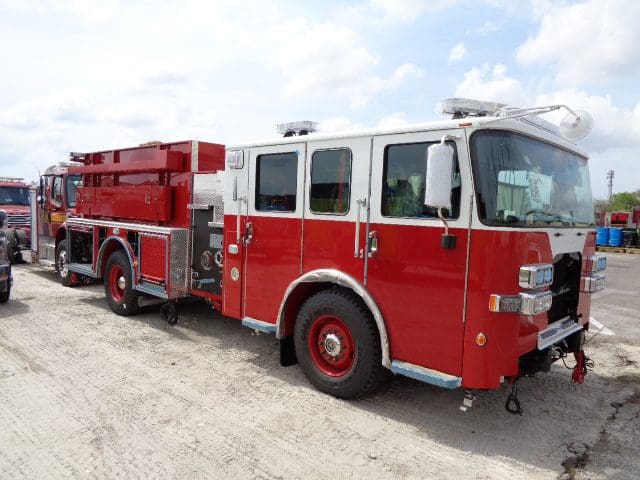

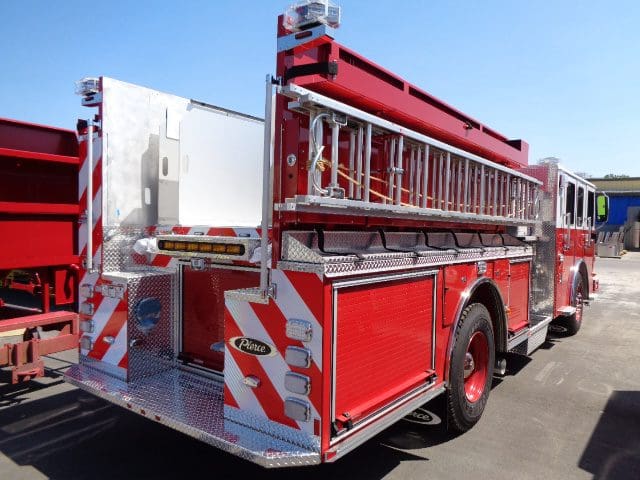

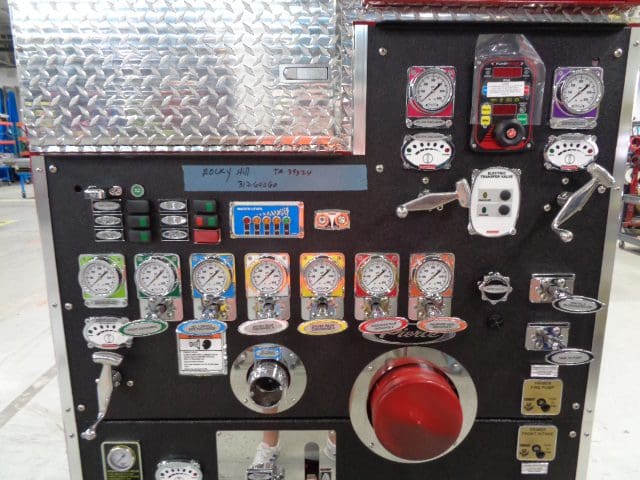

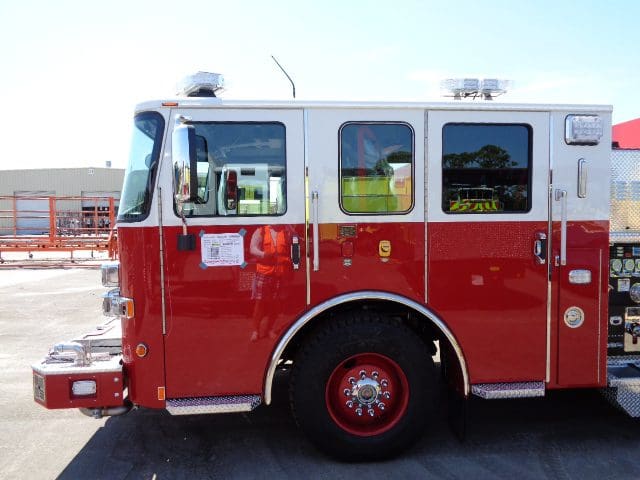

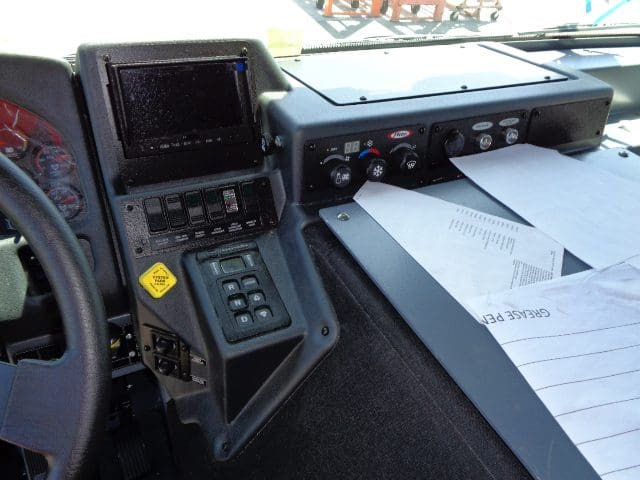

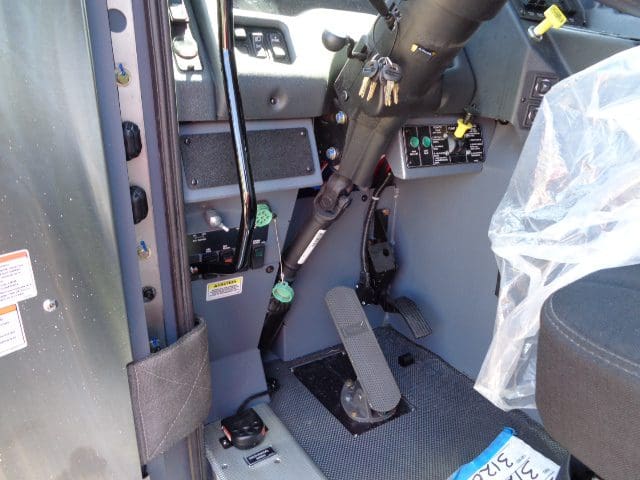

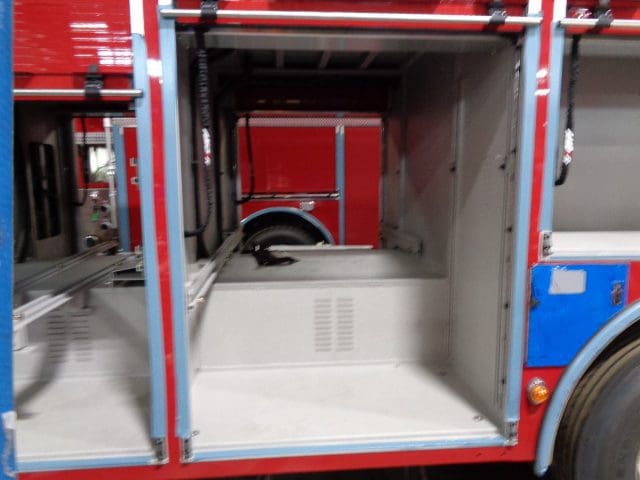

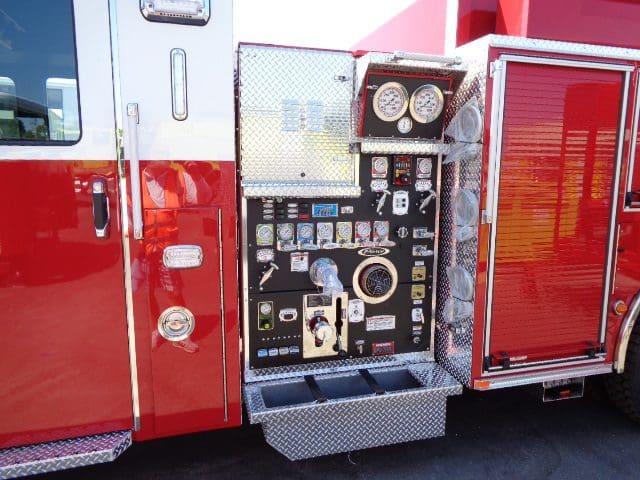

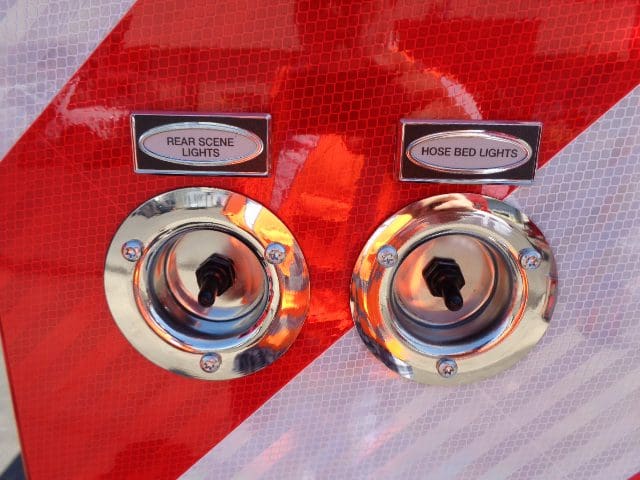

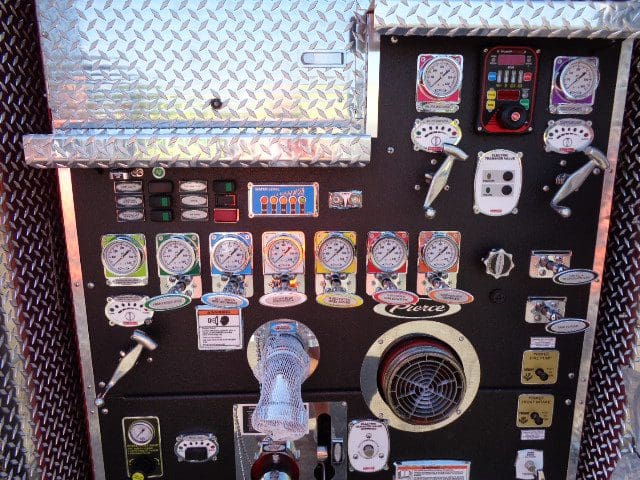

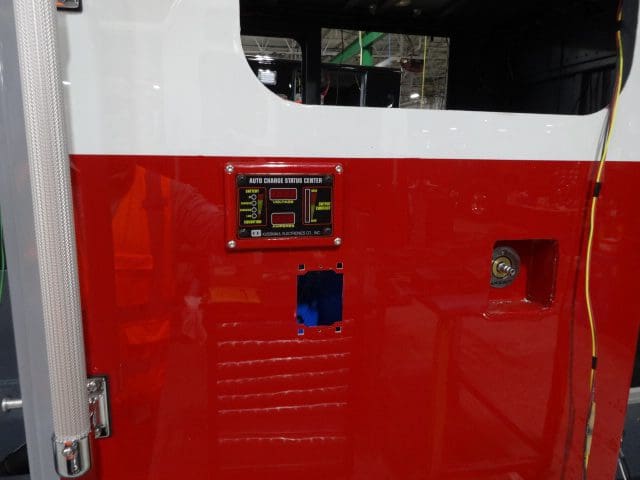

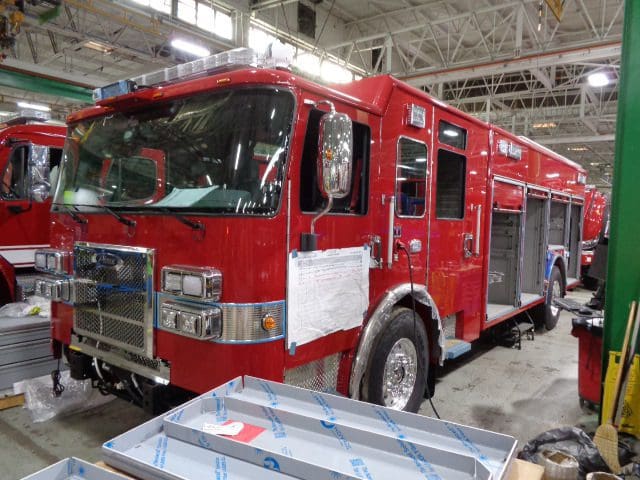

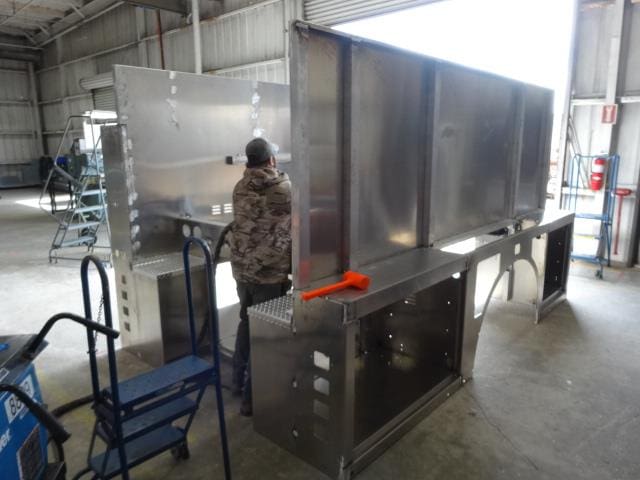

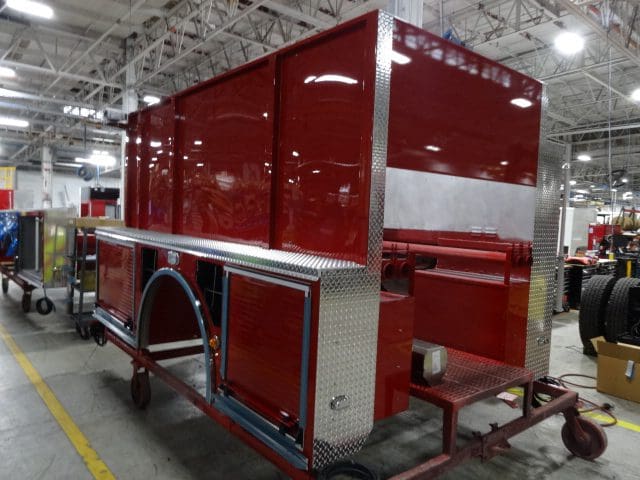

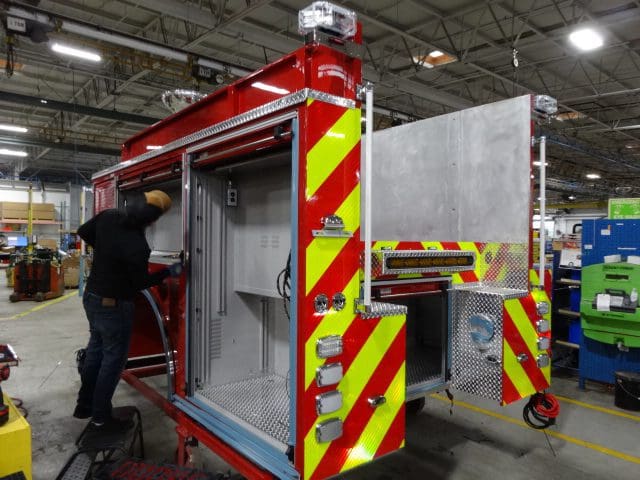

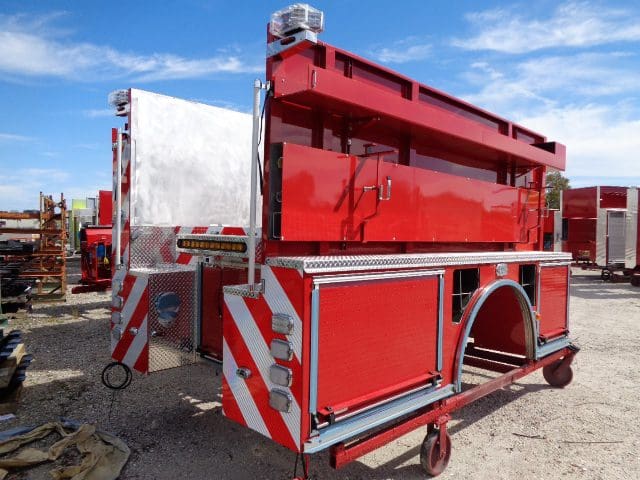

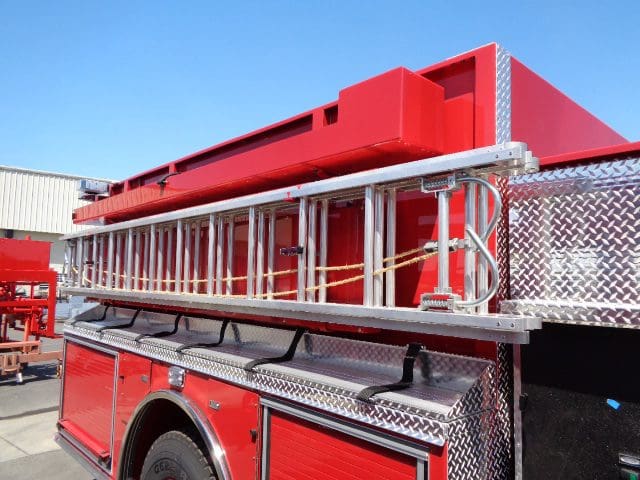

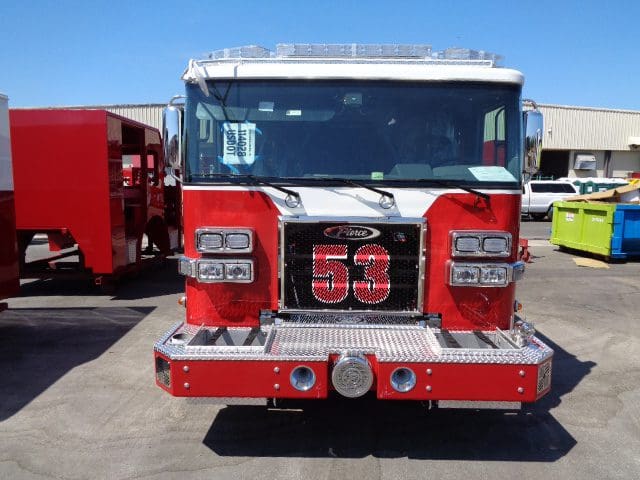

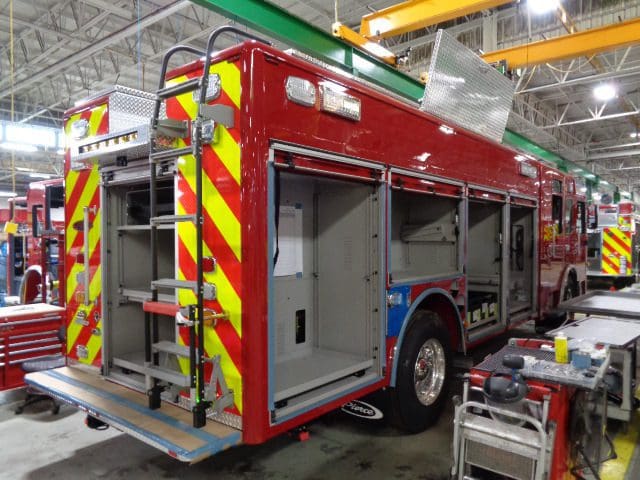

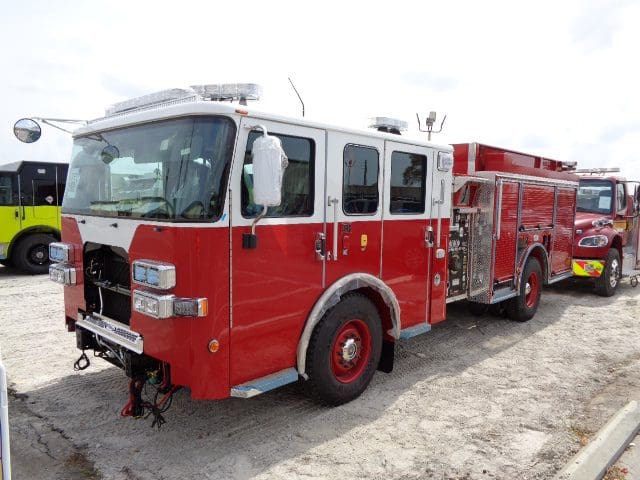

In this report, the apparatus was released for initial and third-party pump testing. the apparatus began final product evaluation, and any remaining content will be installed prior to release and customer acceptance. This is the last scheduled report.
03-01-24

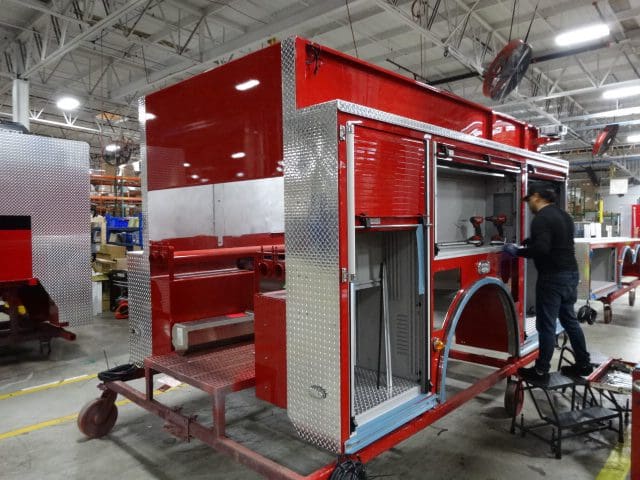

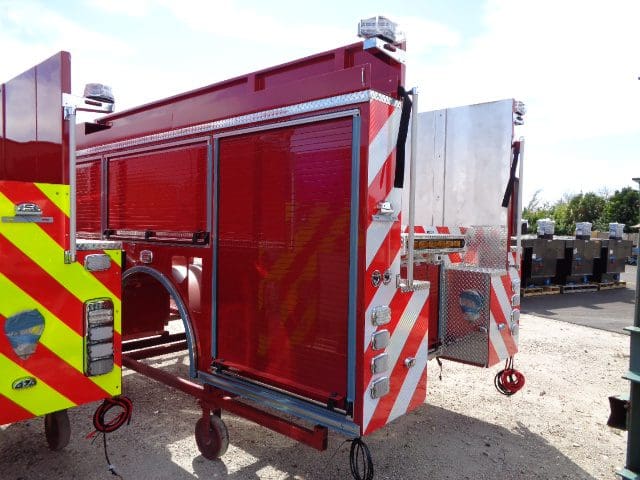

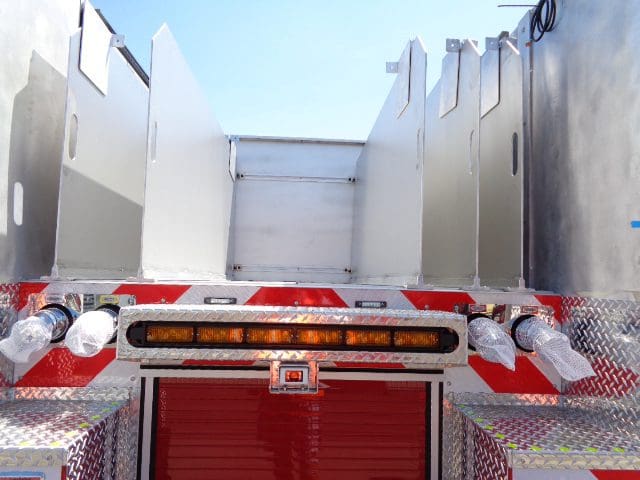

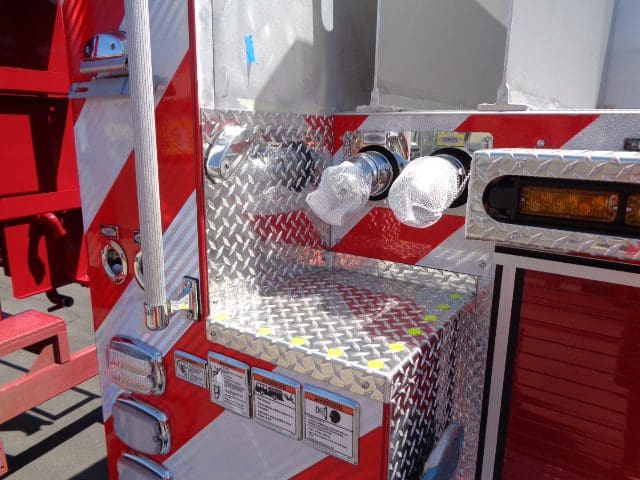

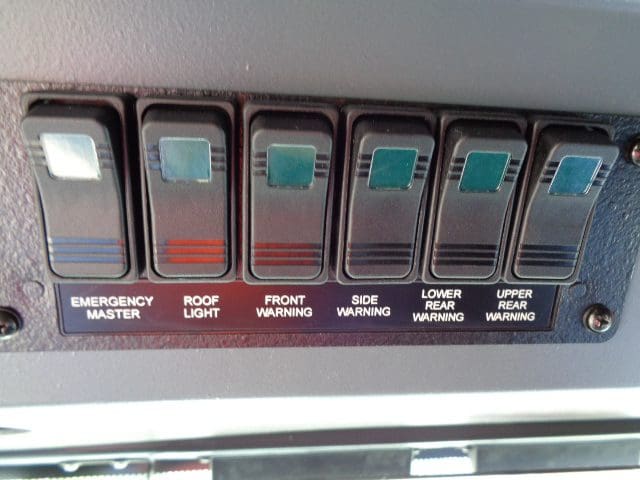

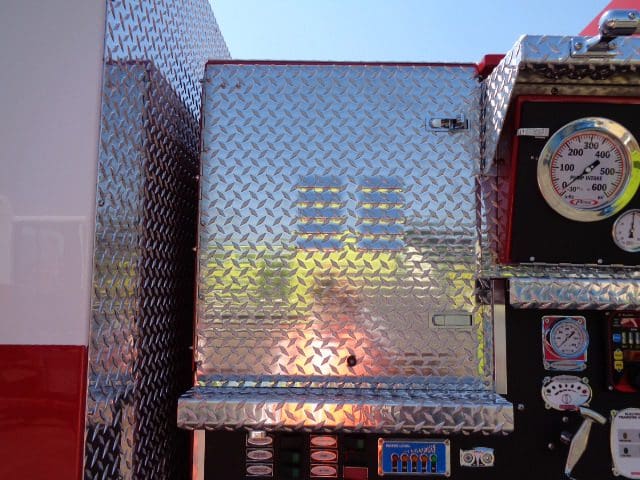

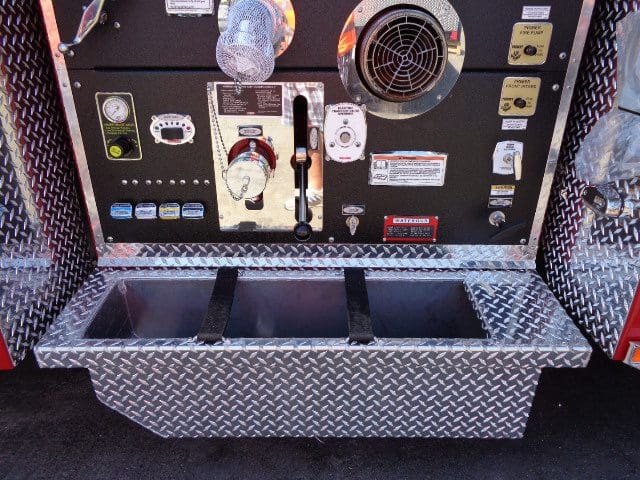

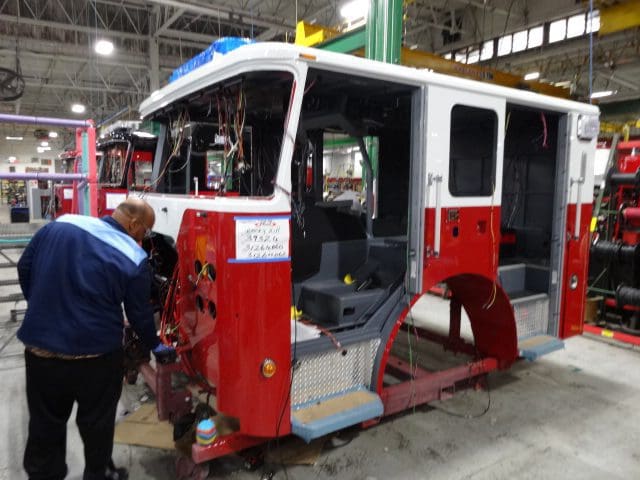

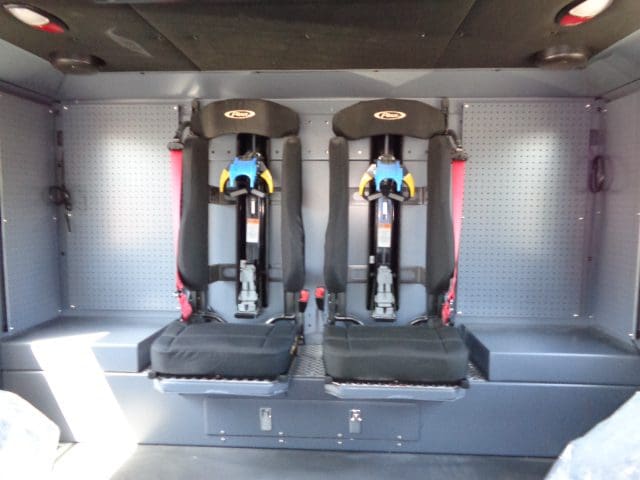

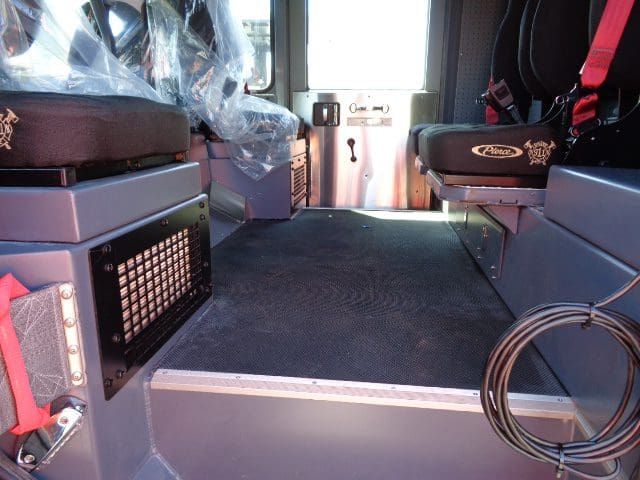

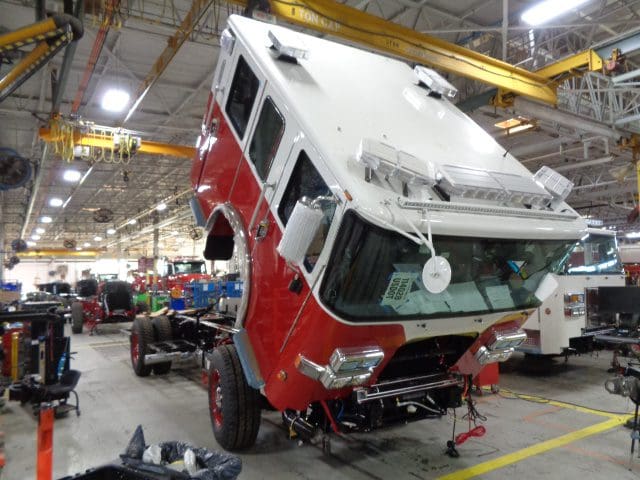

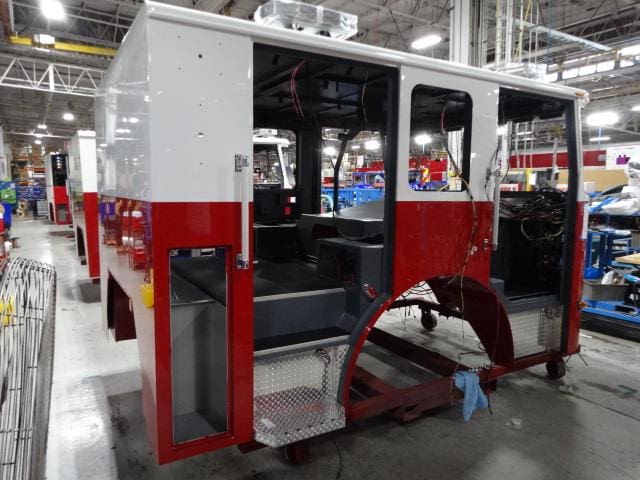

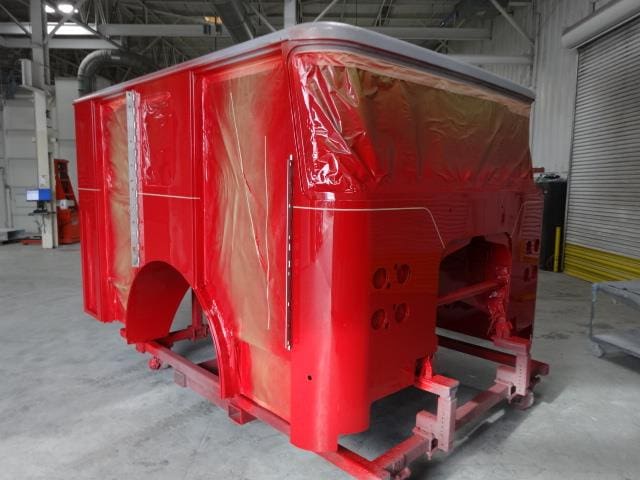

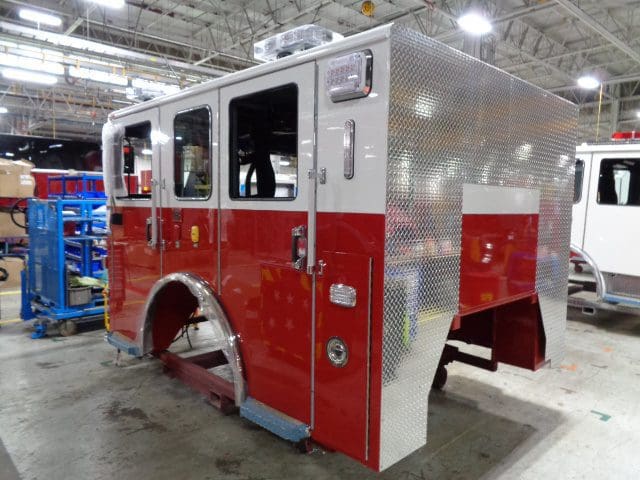

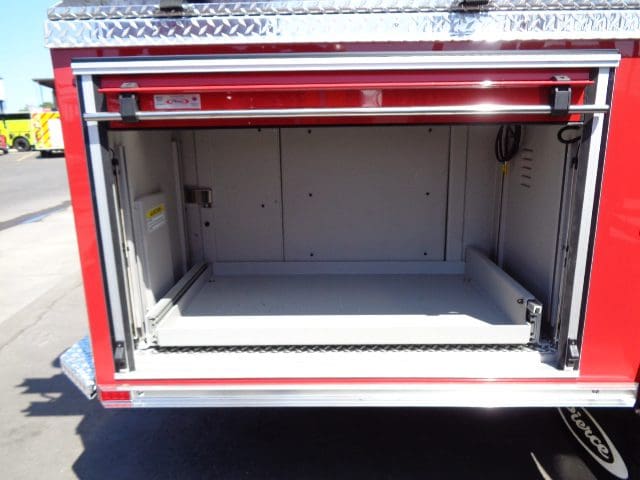

In this report, The apparatus began final assembly after the pump house and body were mounted.
02-23-24

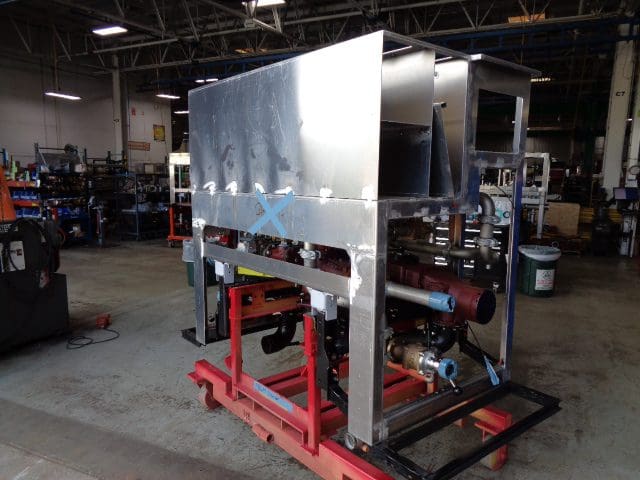

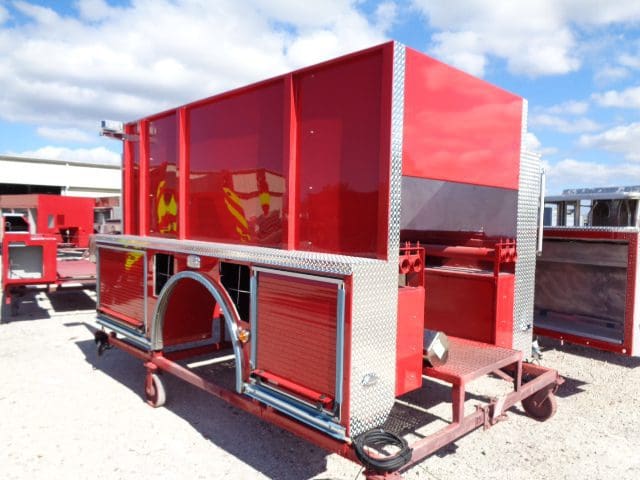

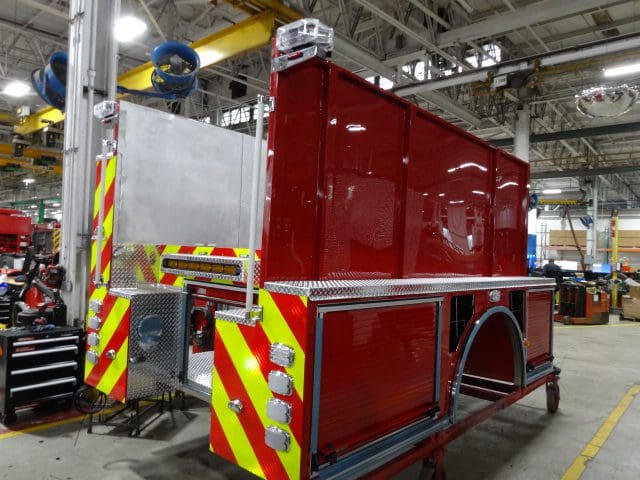

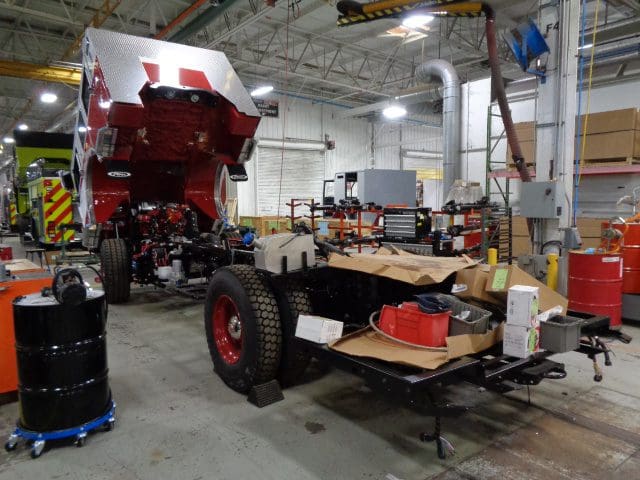

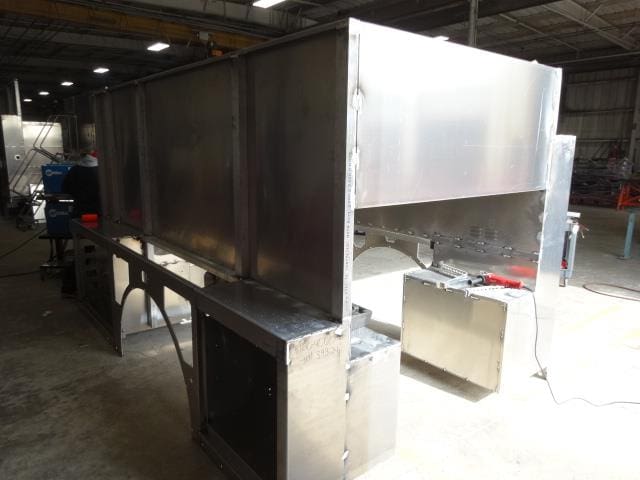

In this report, the chassis continued with chassis prep, and the pump house continued with final assembly. The body was in staging.
02-16-24

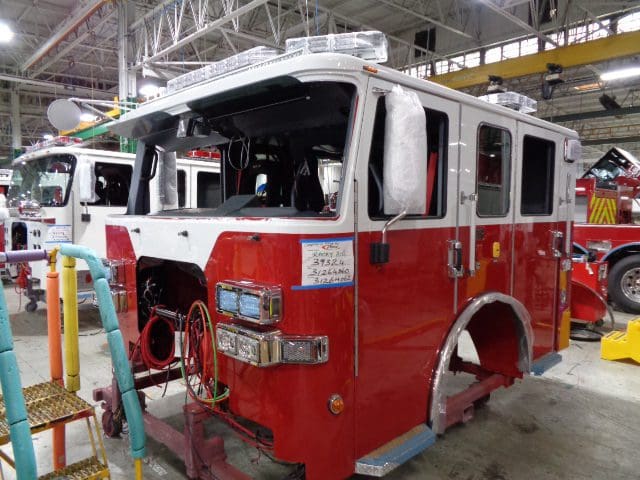

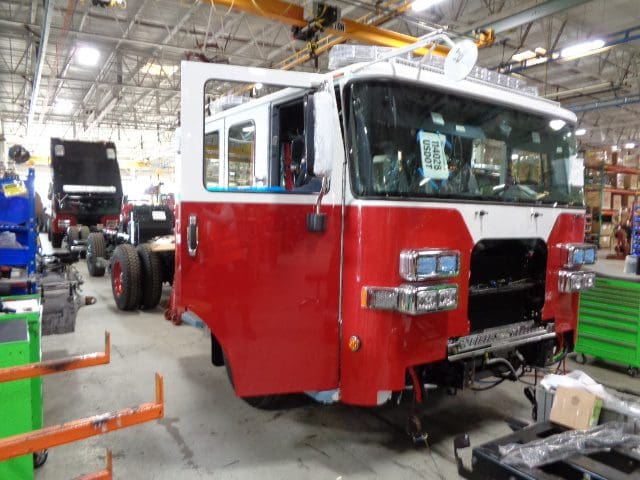

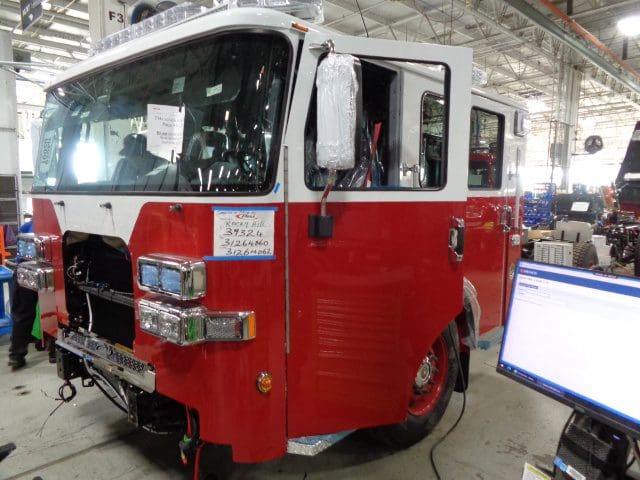

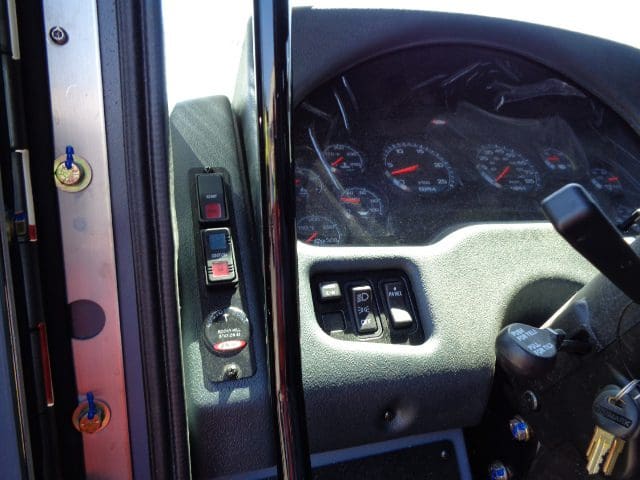

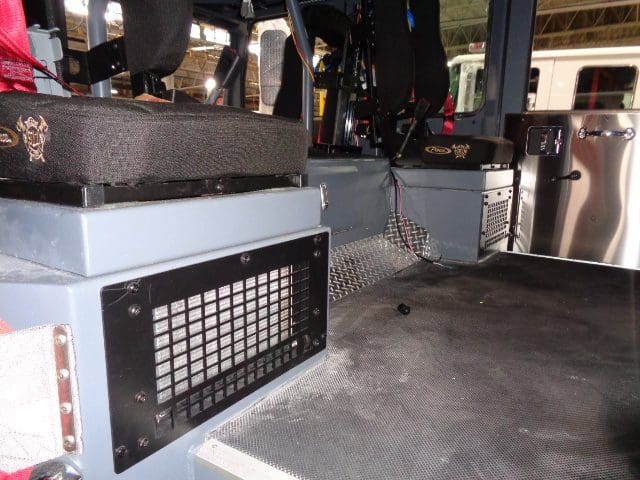

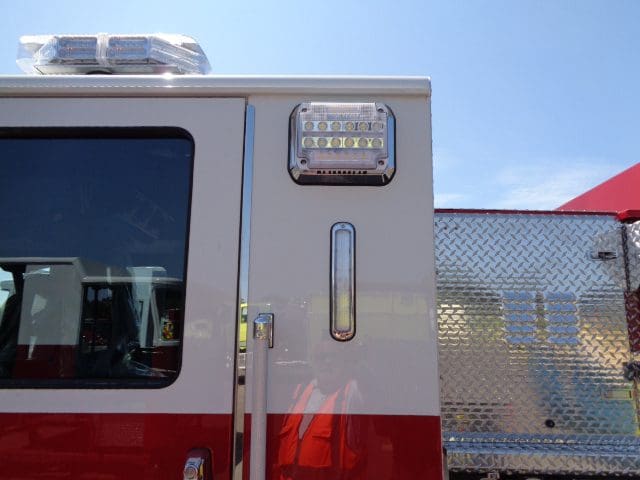

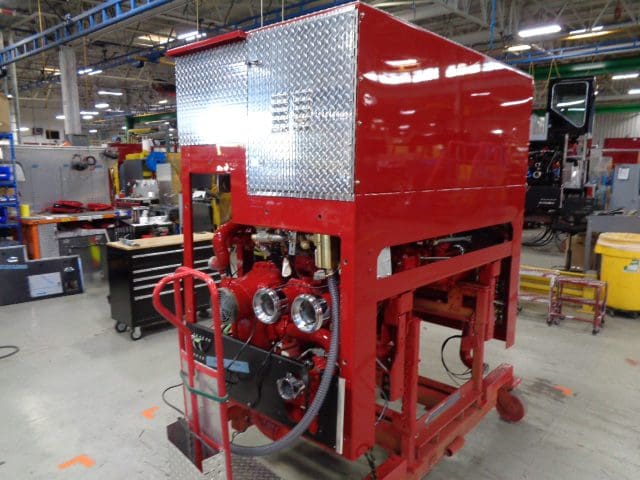

In this report, the cab was mounted, and the pump house continued with final assembly. The body was in staging.

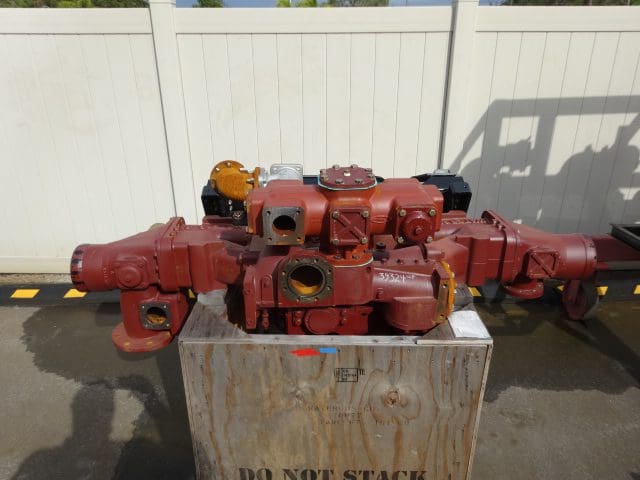

02-09-24

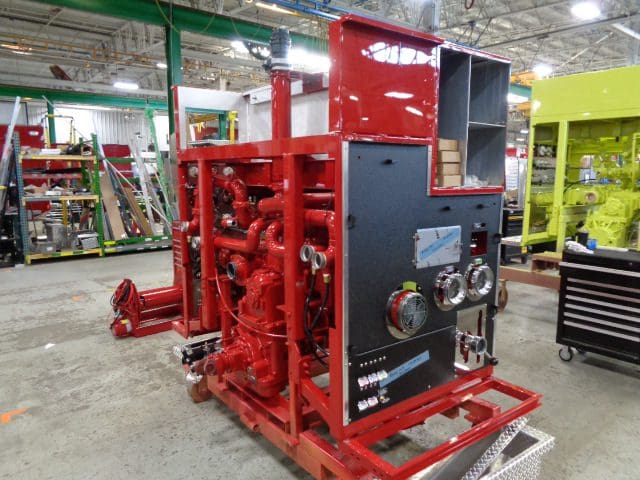

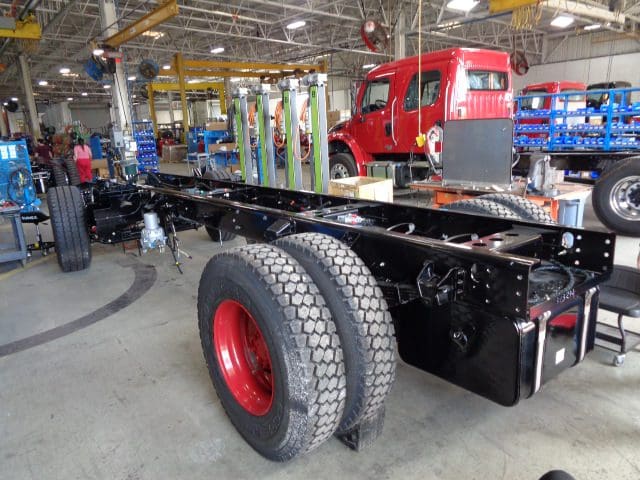

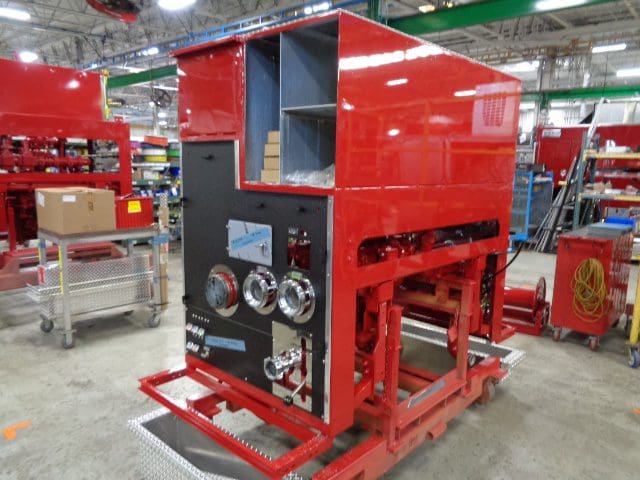

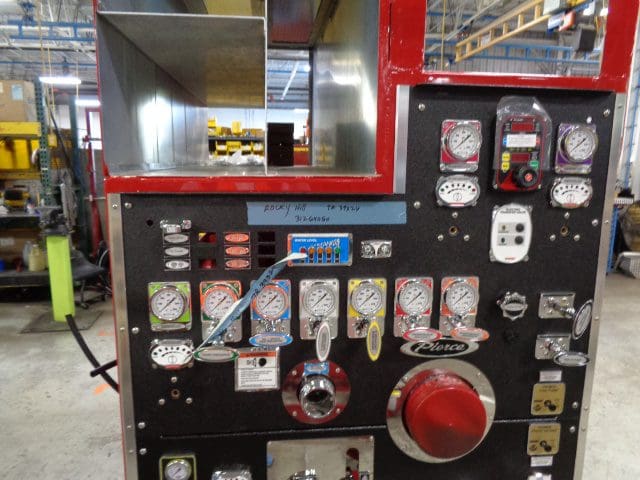

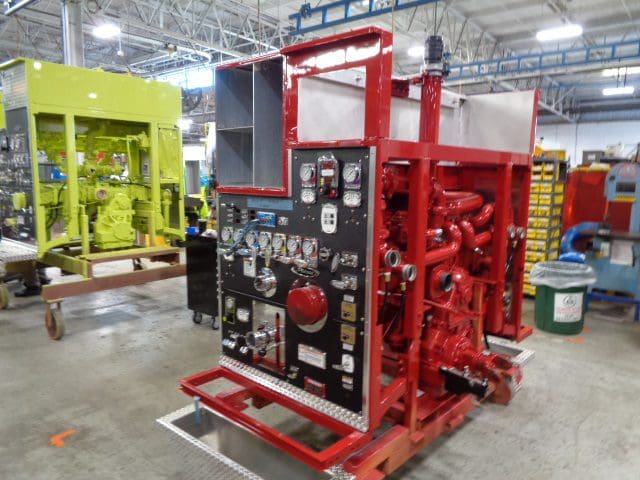

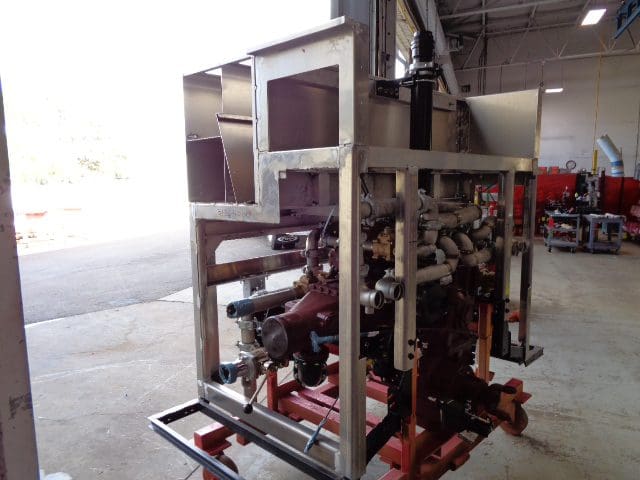

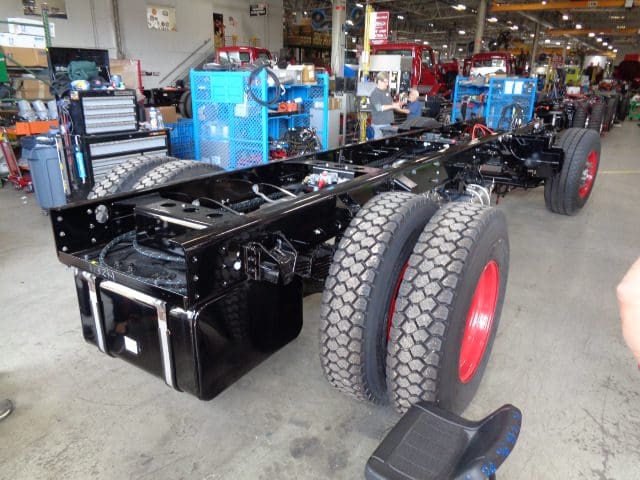

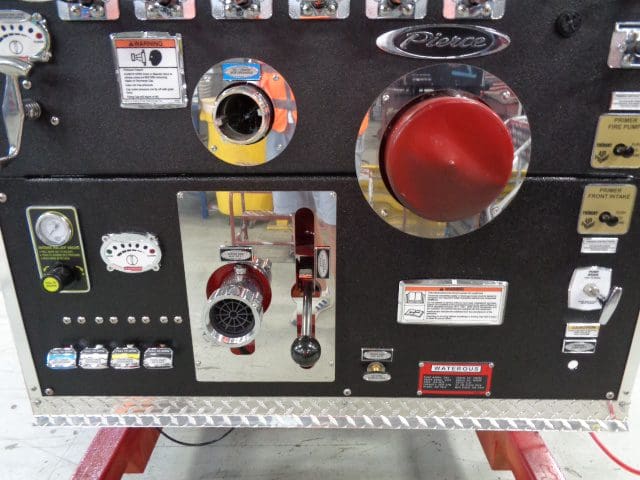

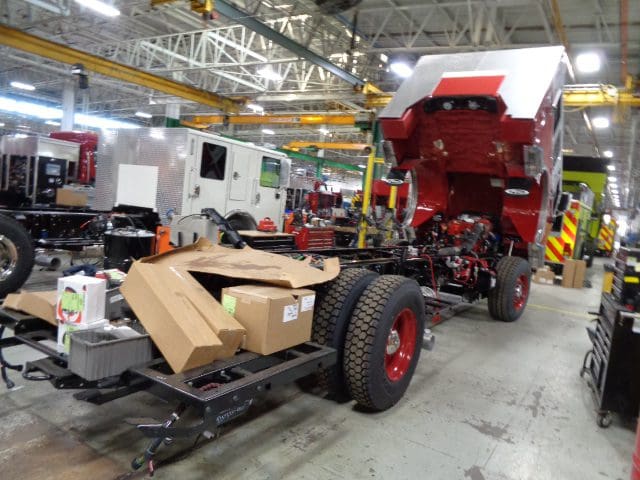

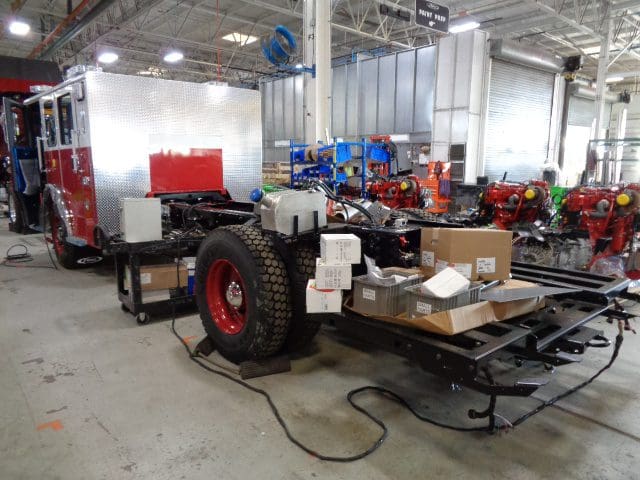

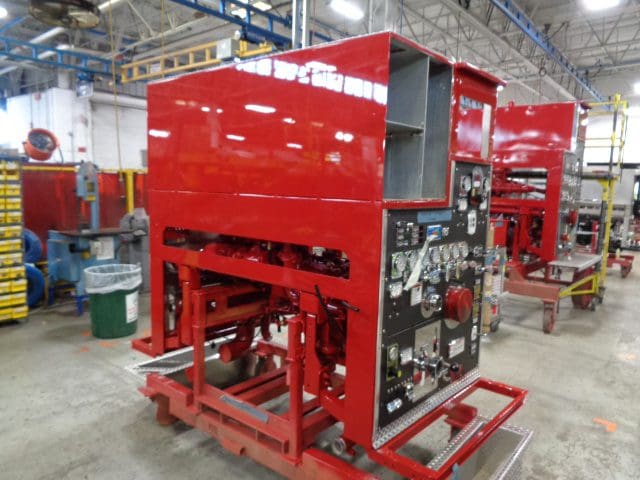

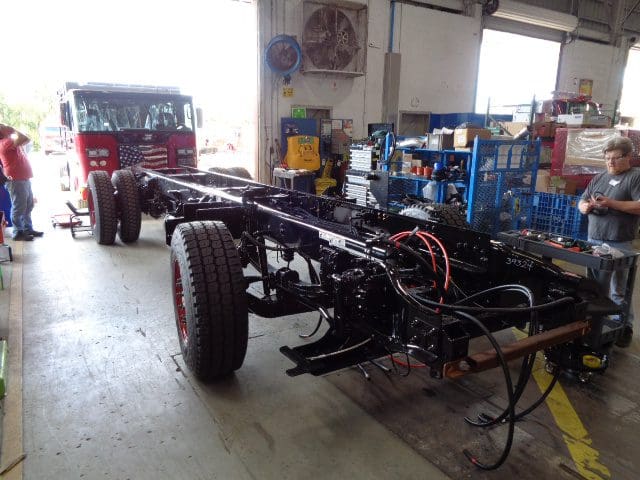

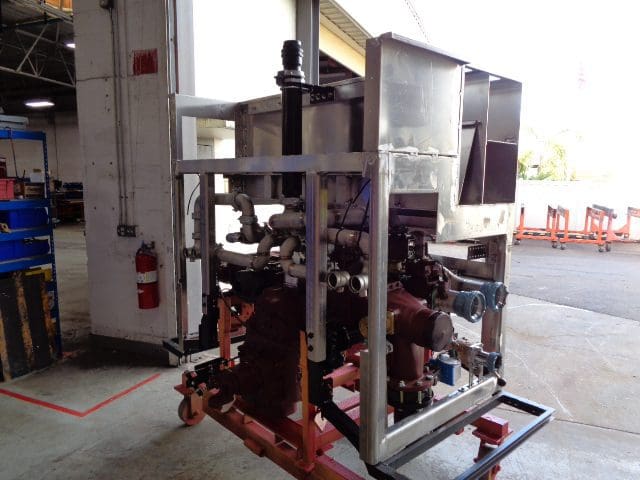

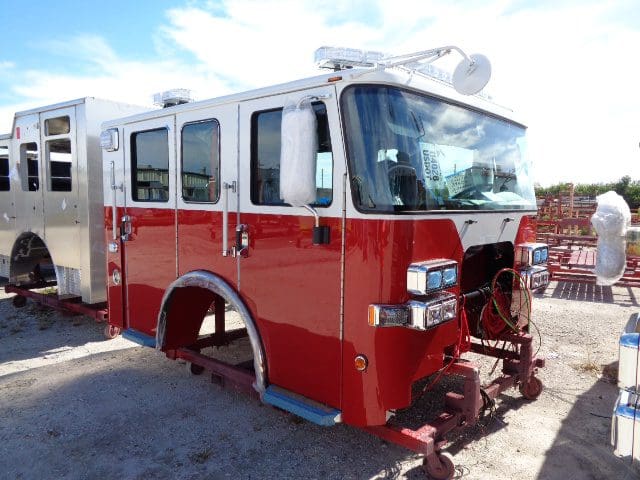

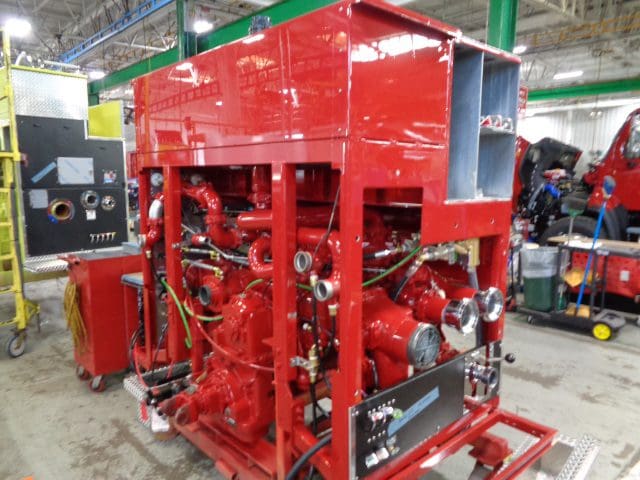

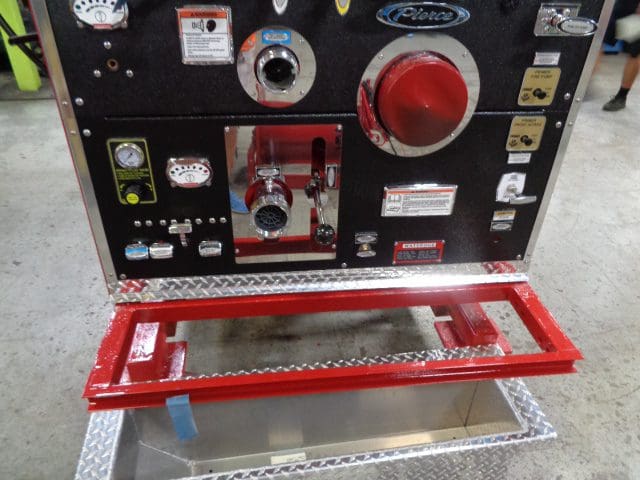

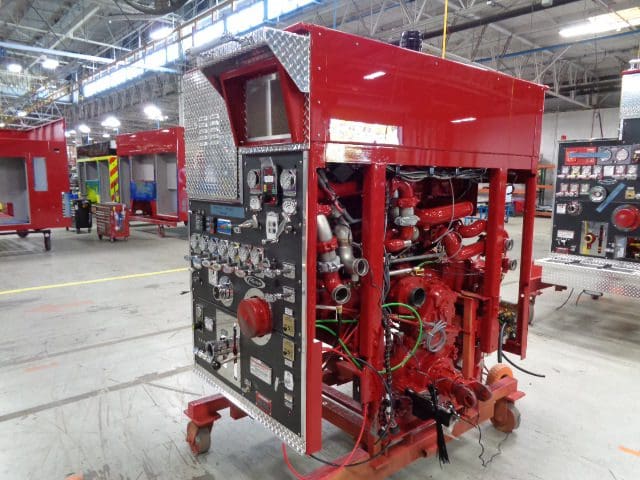

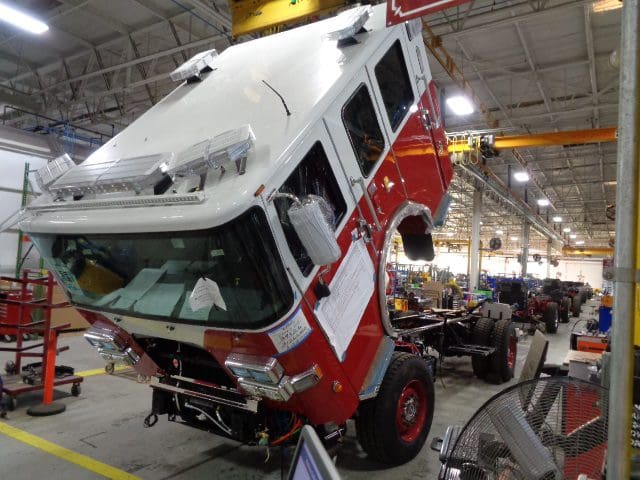

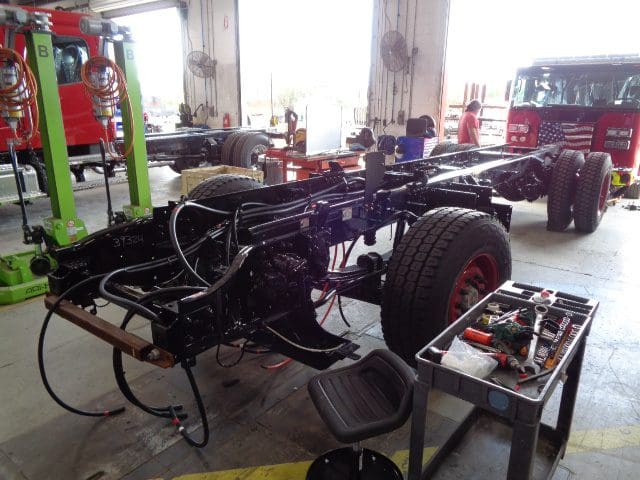

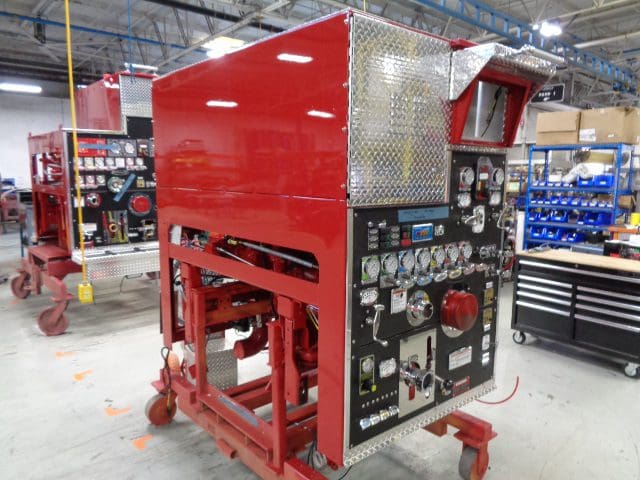

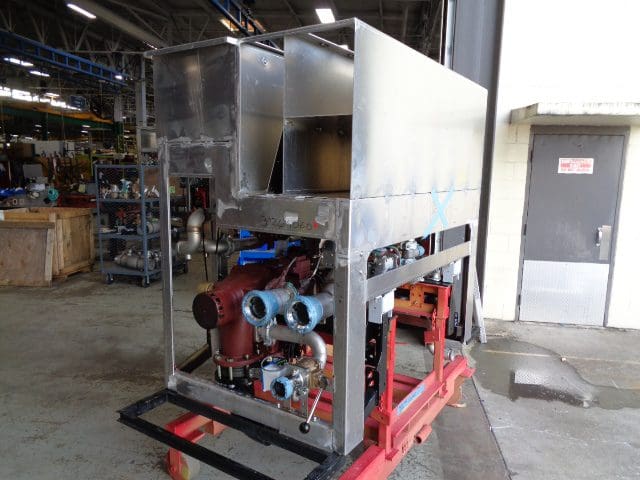

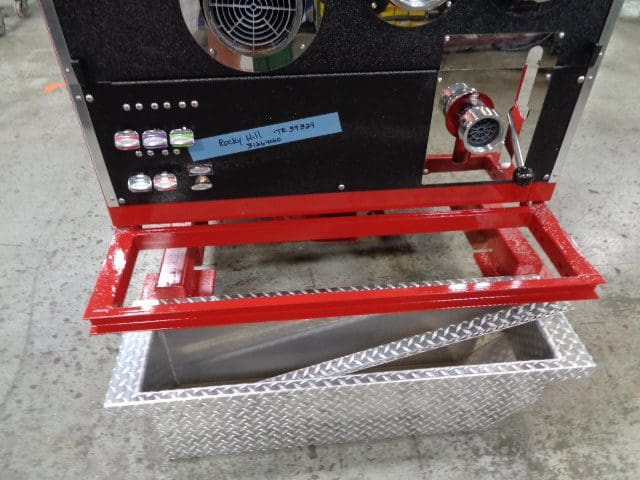

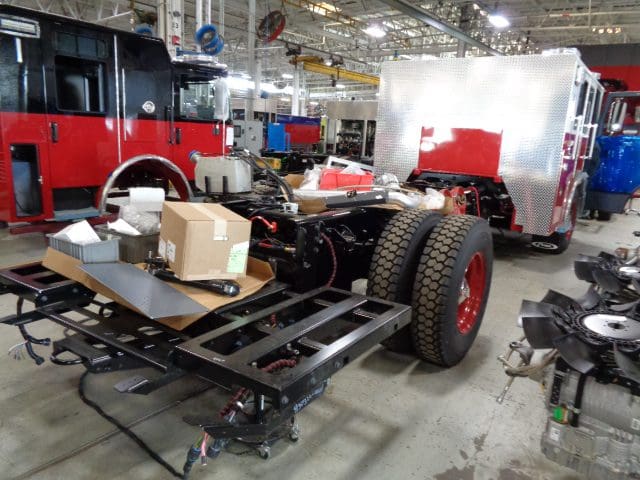

In this report, the cab was in staging and the chassis frame began initial assembly. The pump house began final pump assembly, and the body was in staging.
02-02-24
In this report, the cab was in staging and the pump house was in staging for paint (no photos). The body was in staging (no photos).
01-26-24

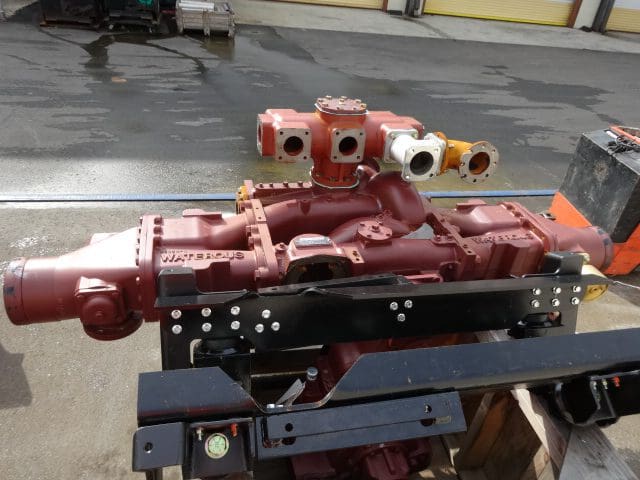

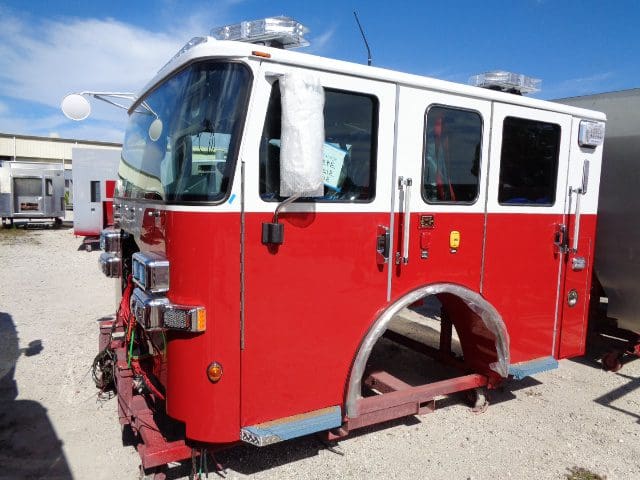

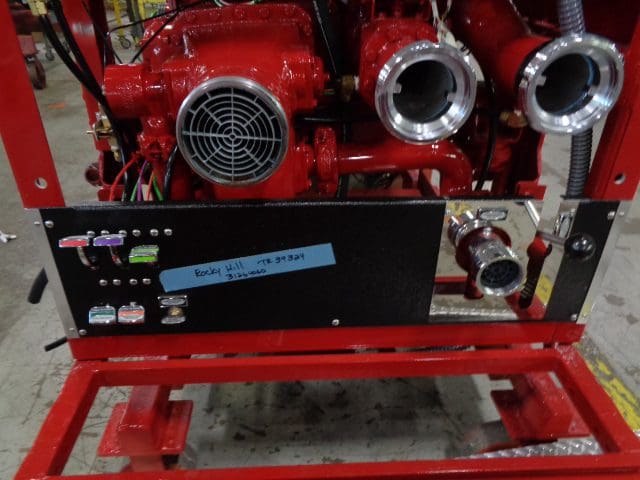

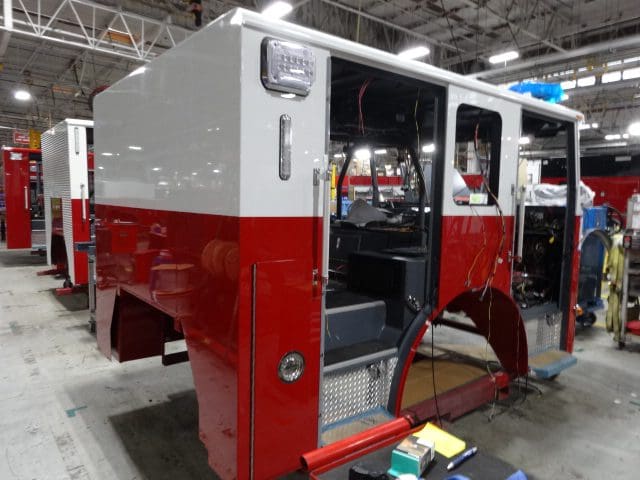

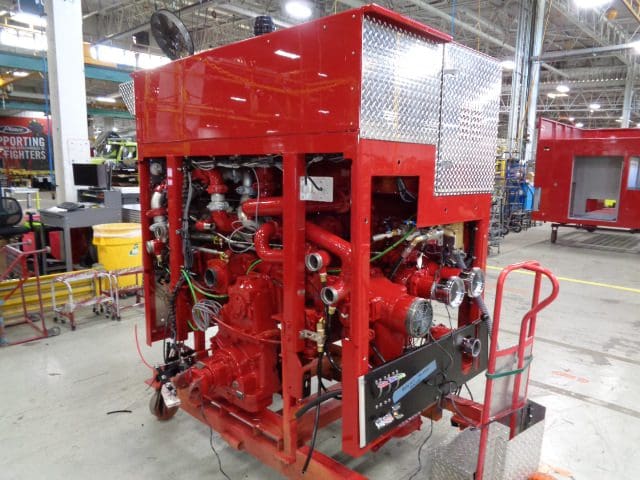

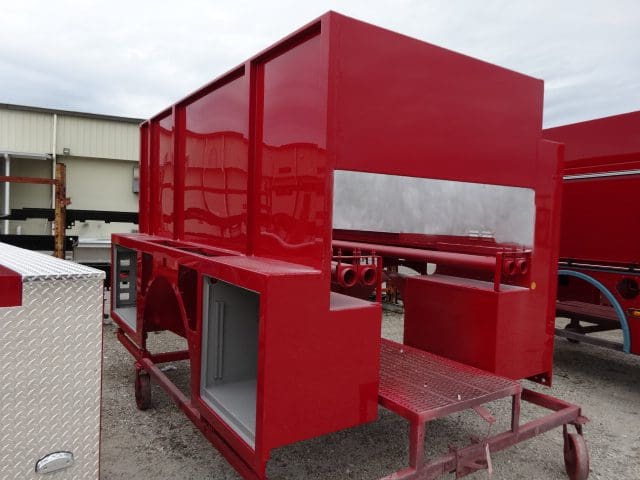

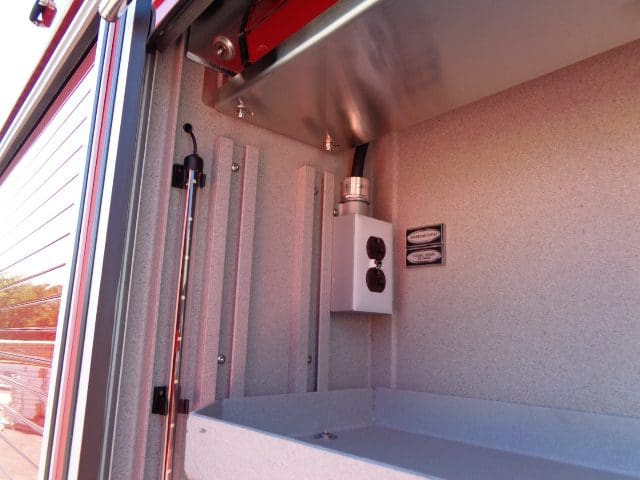

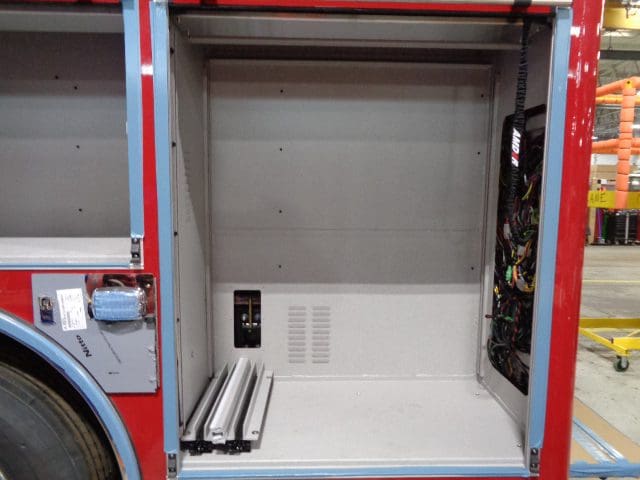

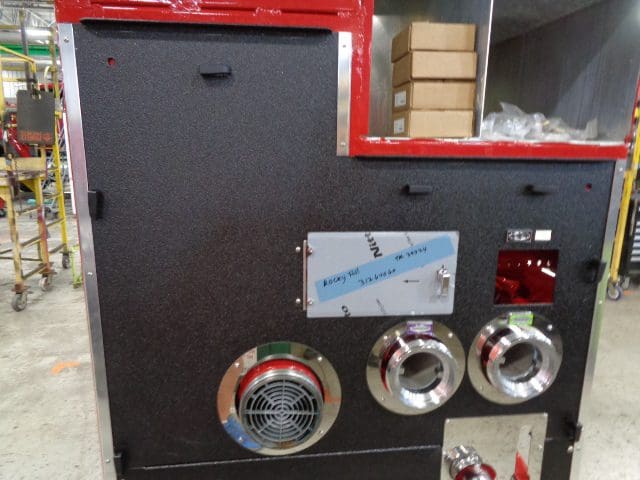

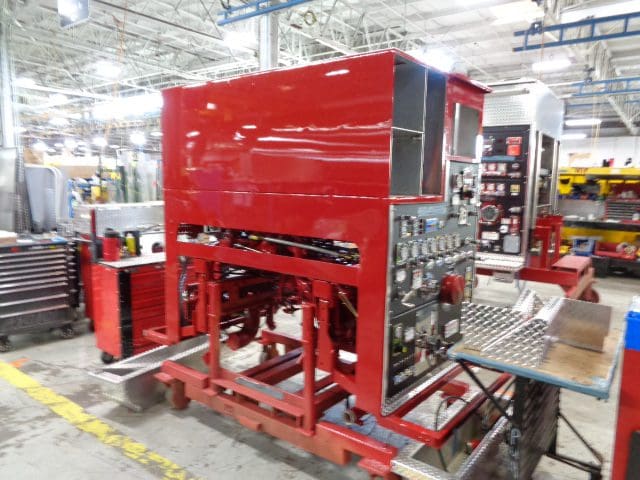

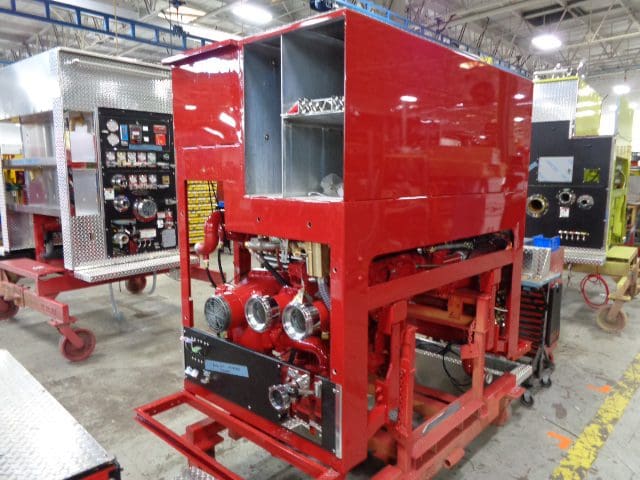

In this report, the cab continued to receive trim and wiring harnesses and the fire pump was joined with the pump house structure. The body was in staging.
01-19-24

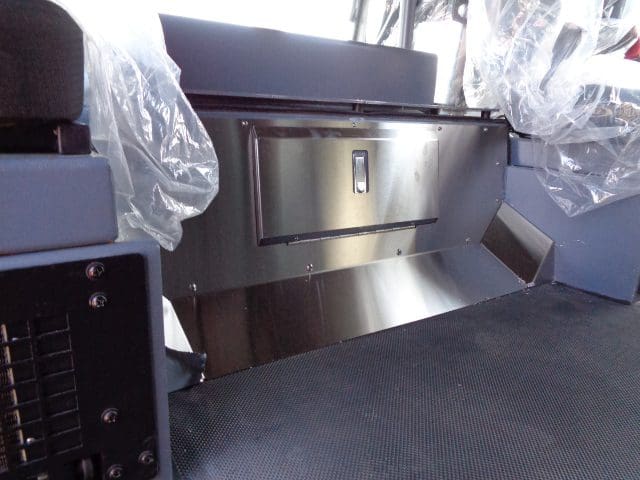

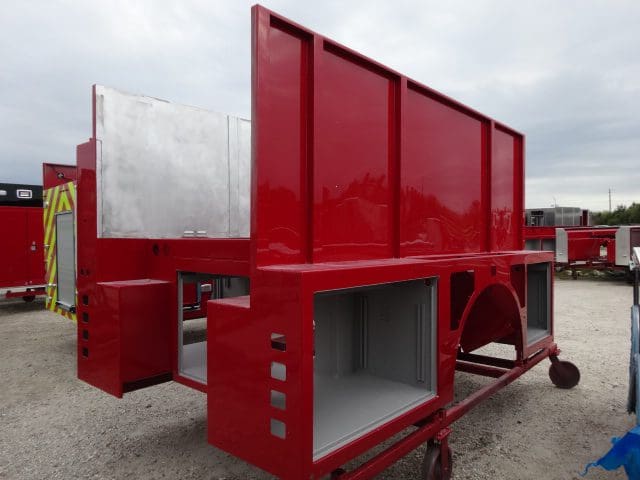

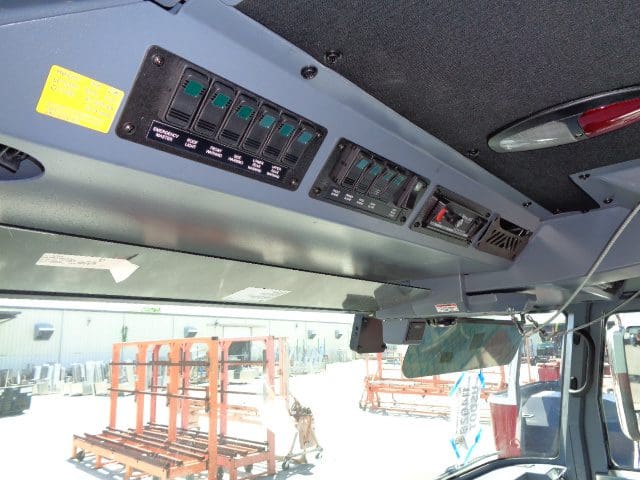

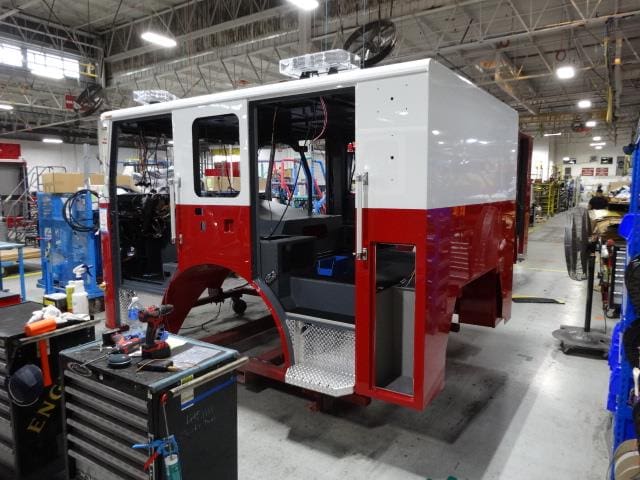

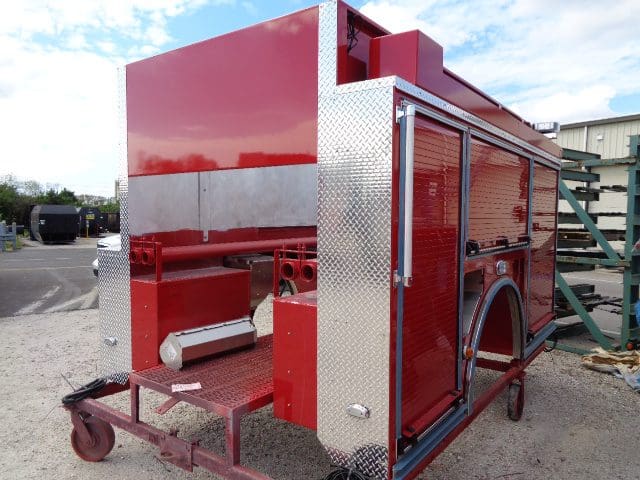

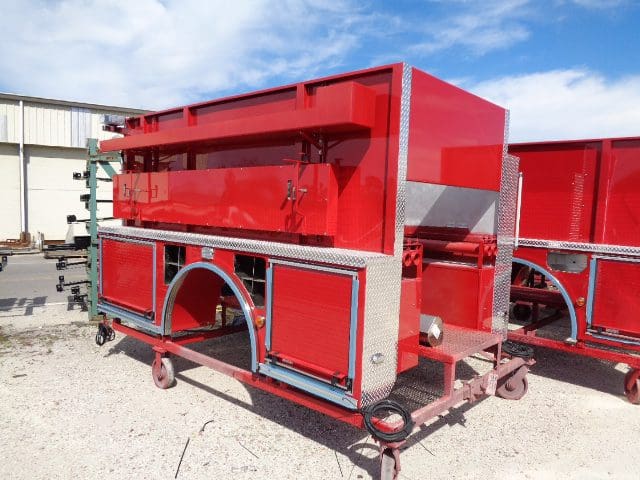

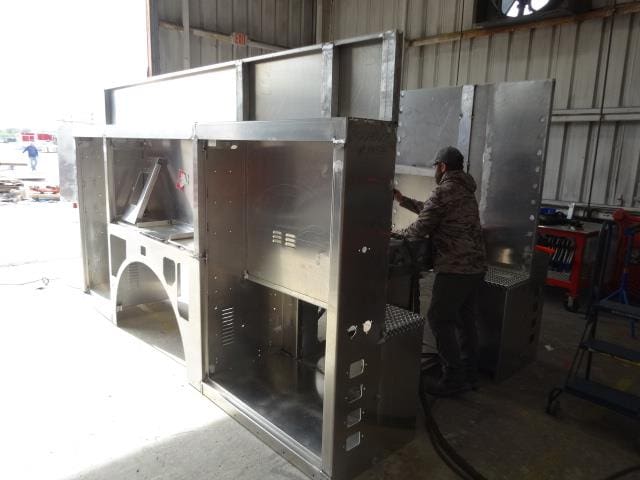

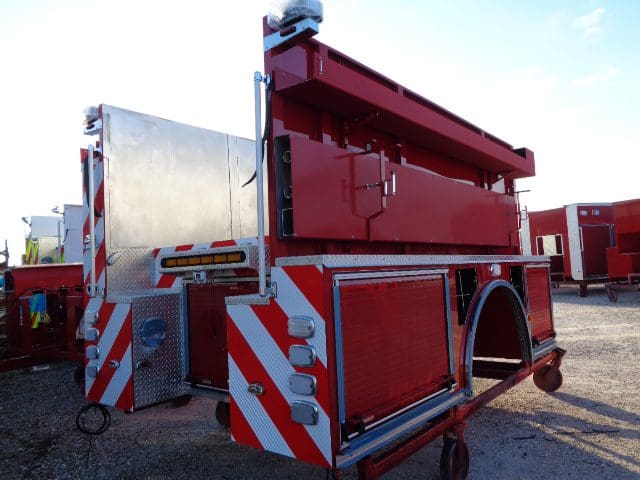

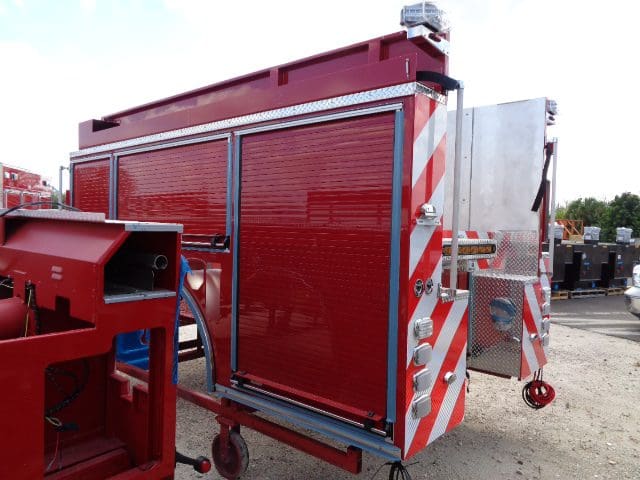

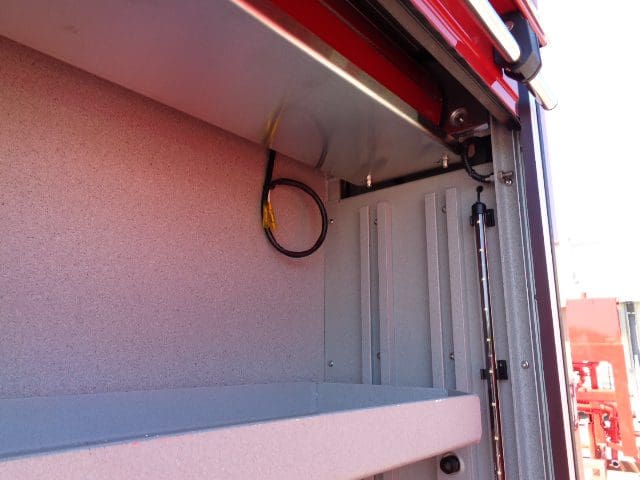

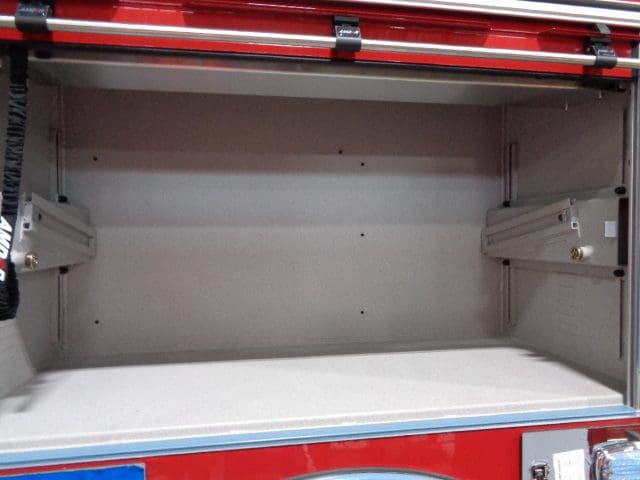

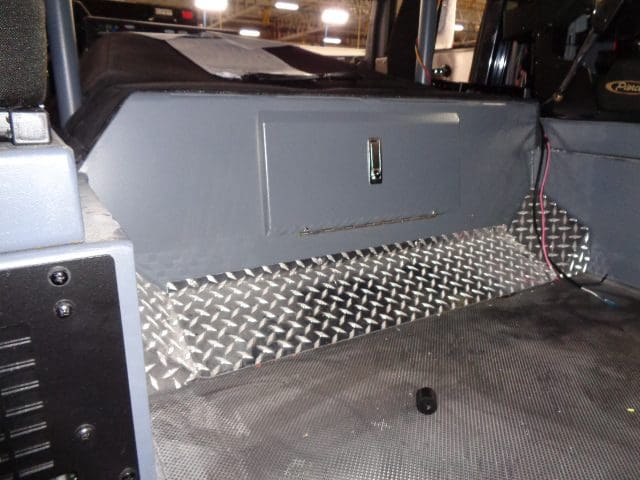

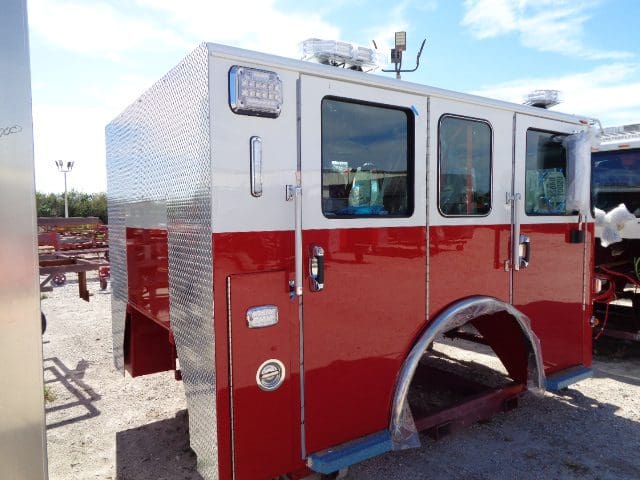

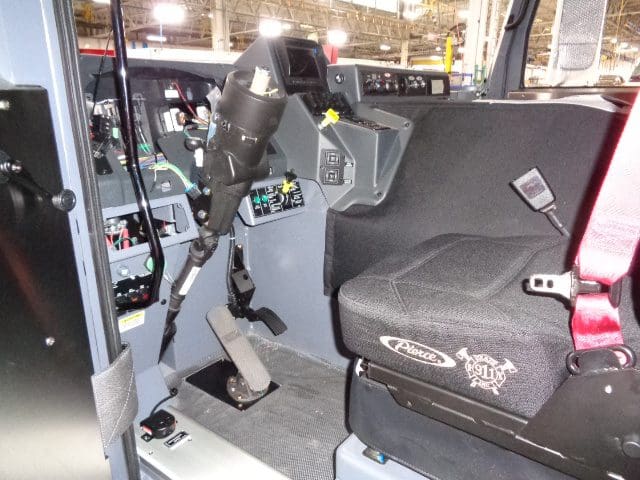

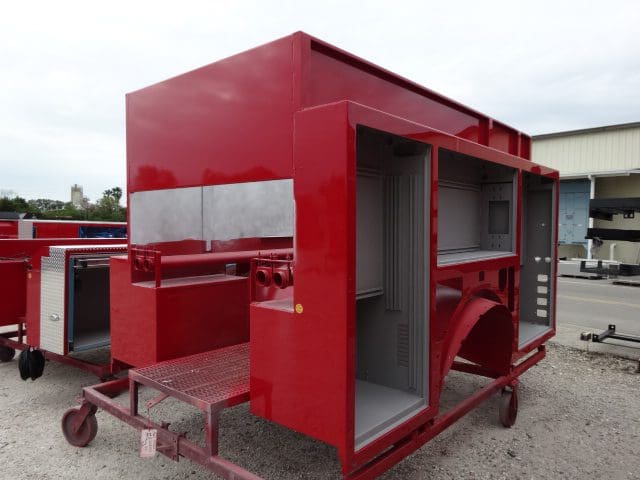

In this report, the cab and fire pump were unavailable for photos. The body began to receive trim and wiring harnesses.
01-12-24

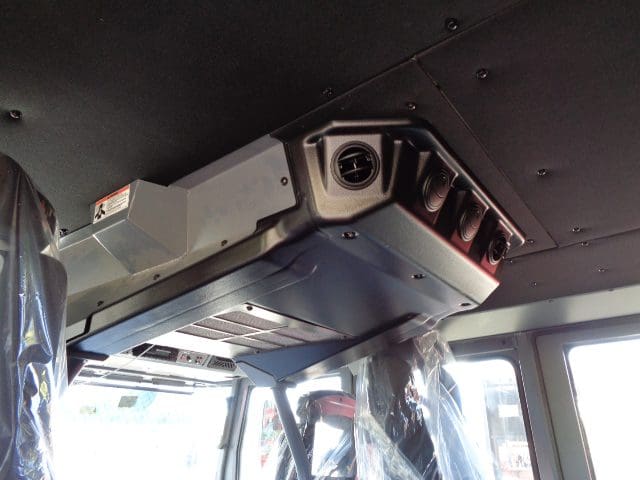

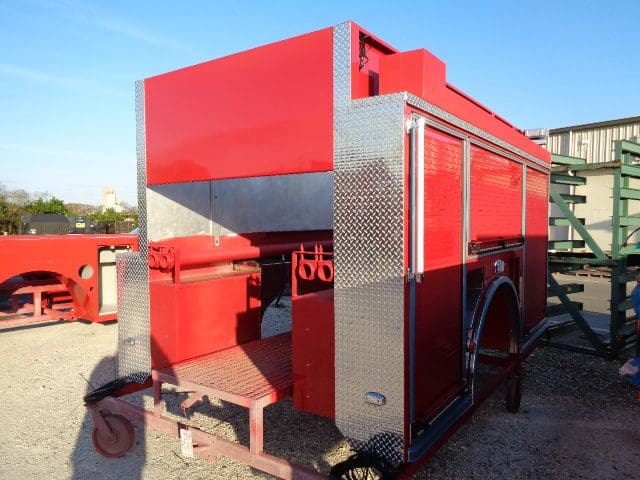

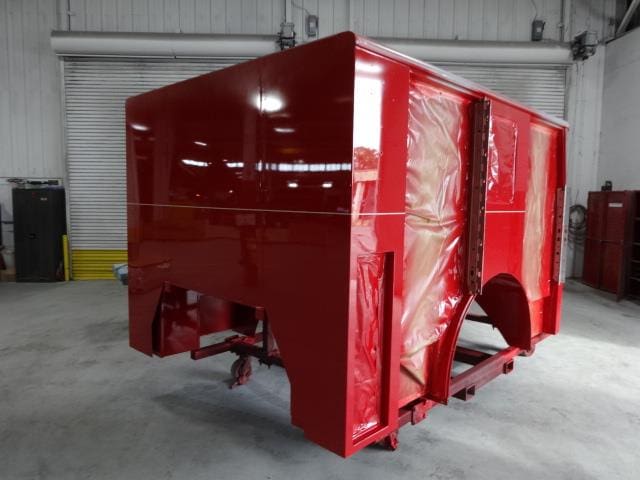

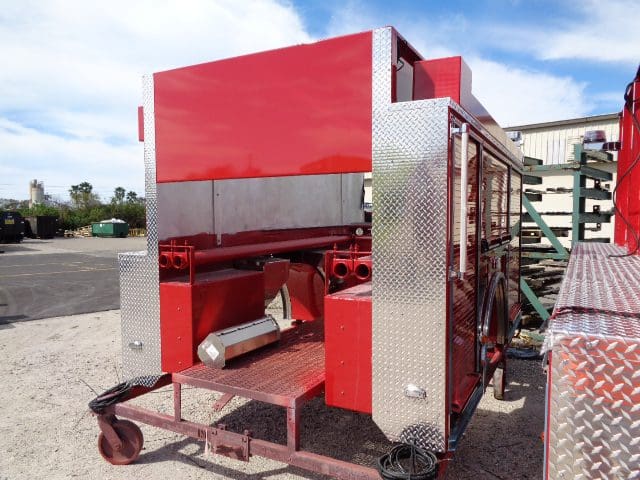

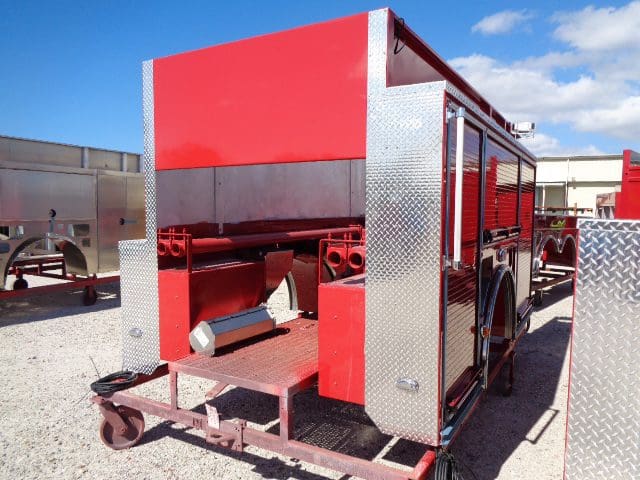

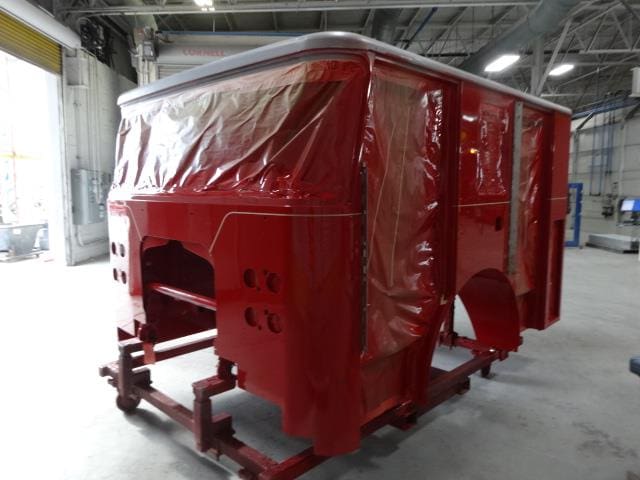

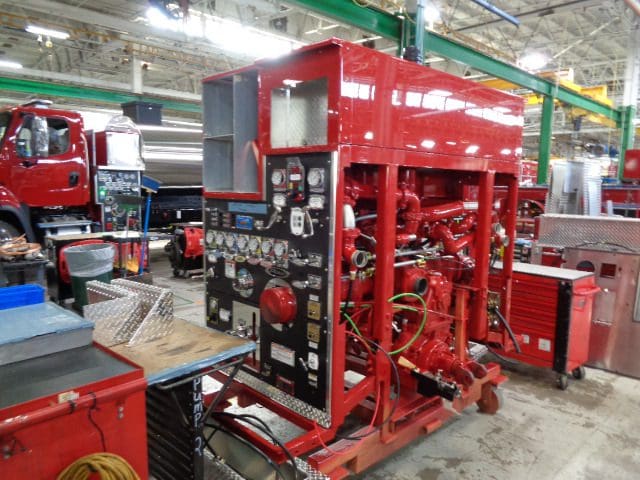

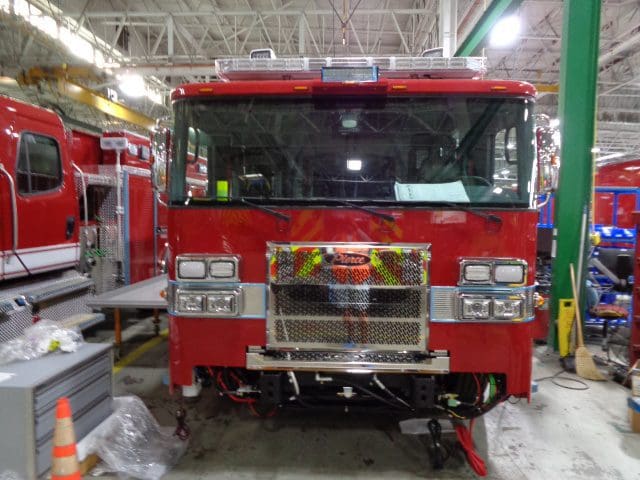

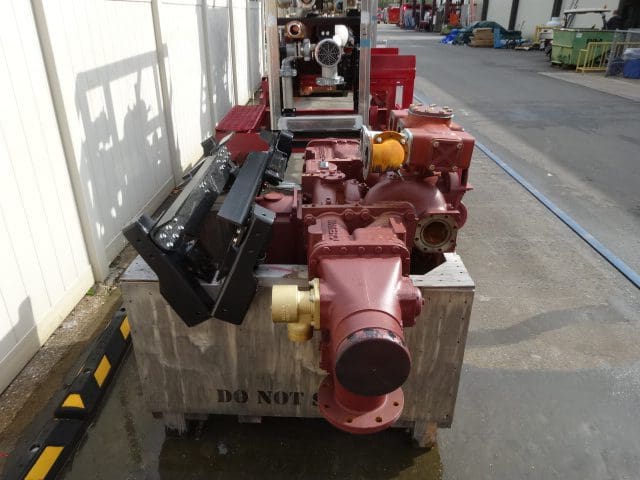

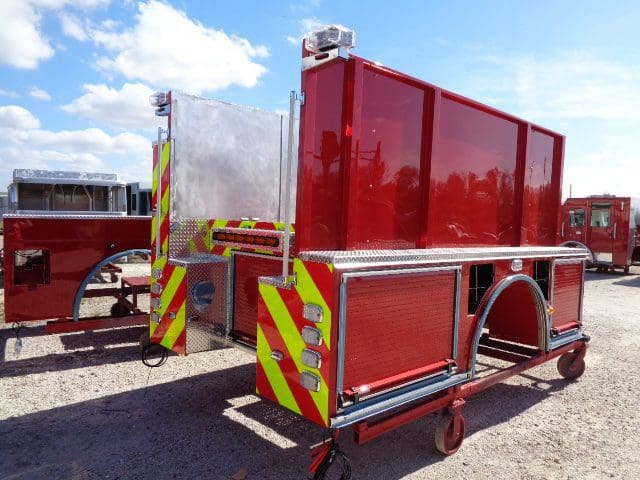

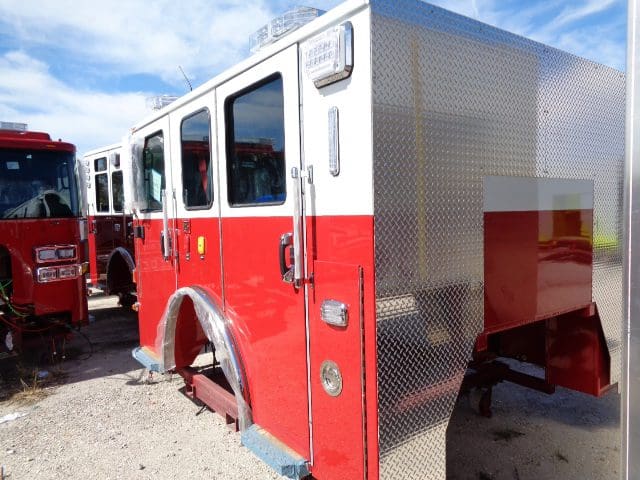

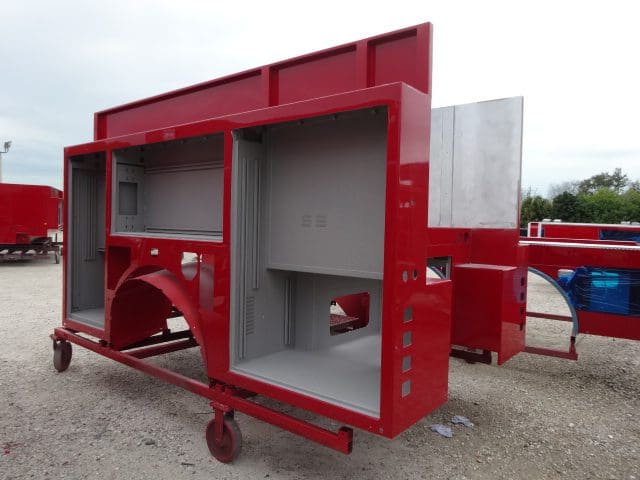

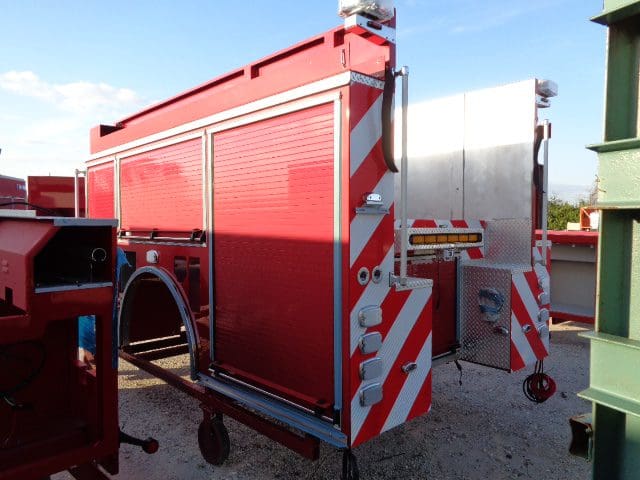

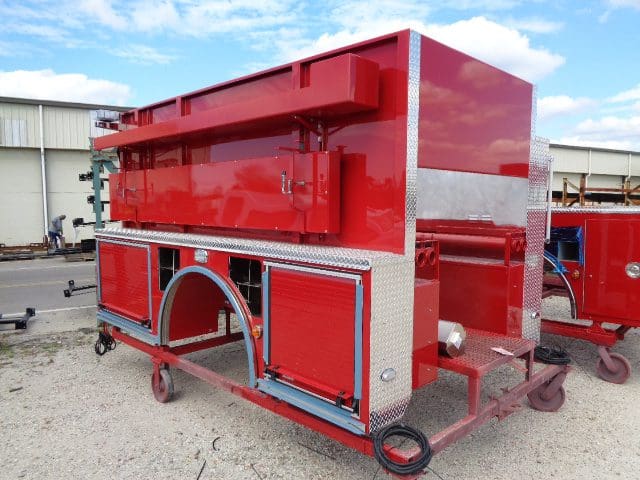

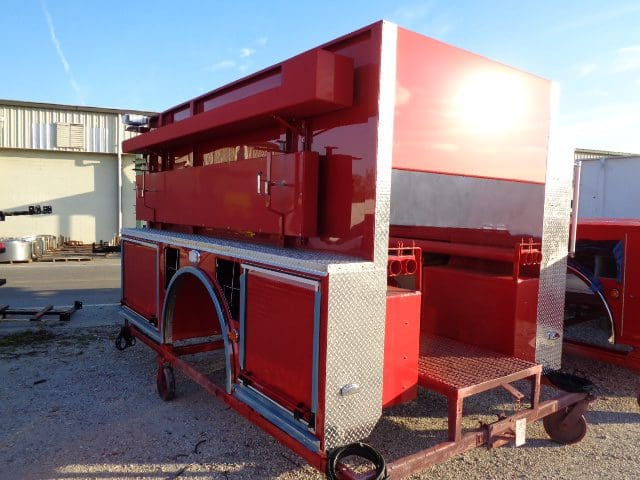

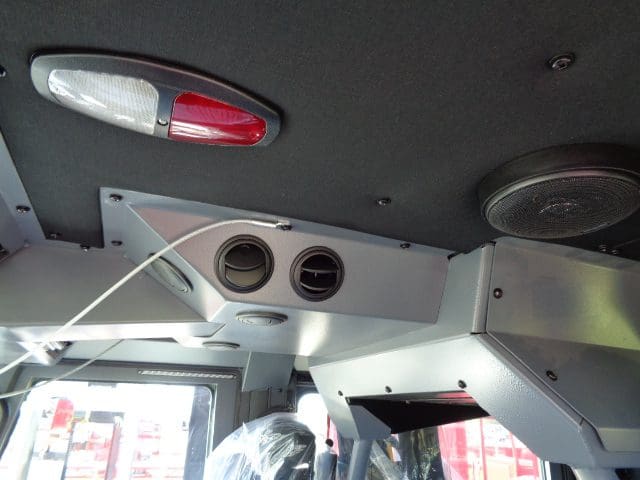

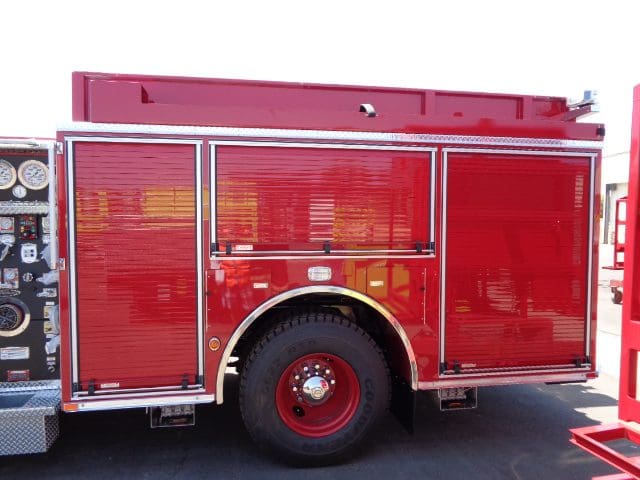

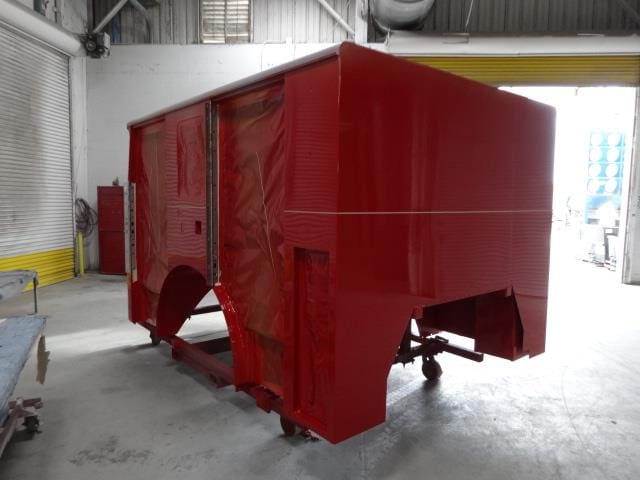

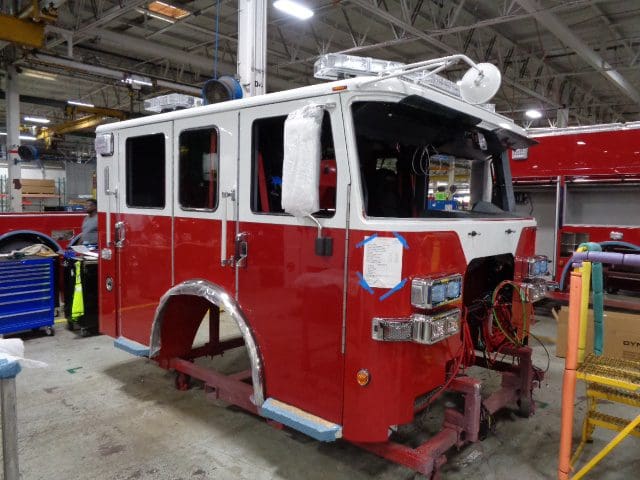

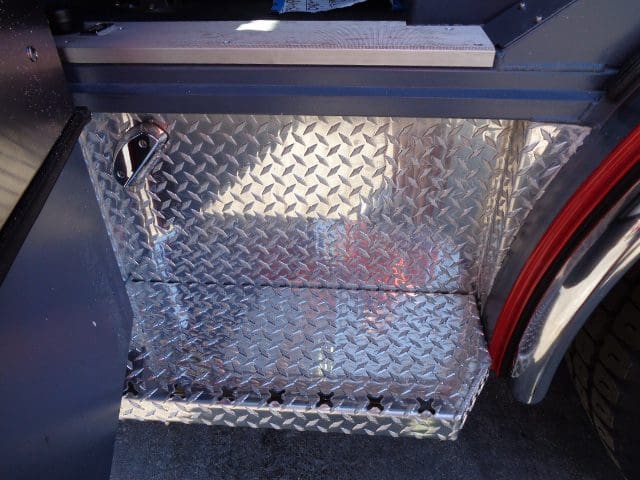

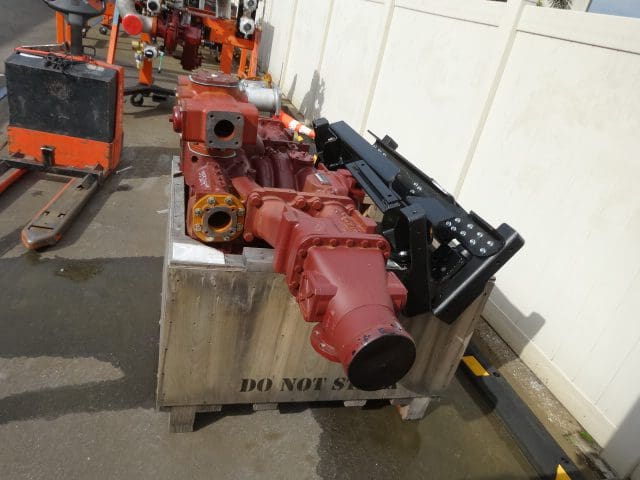

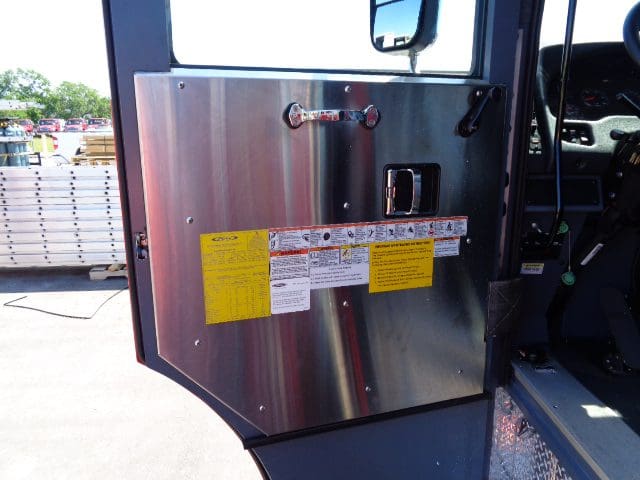

In this report, the cab continued to receive trim and wiring harnesses and the fire pump arrived. The body finished with paint.
01-06-24

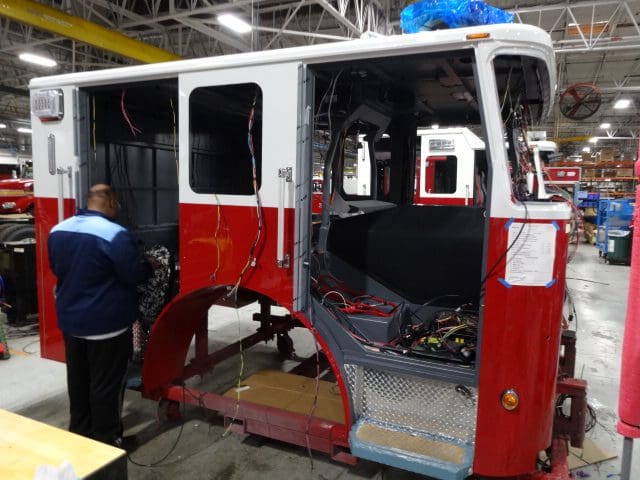

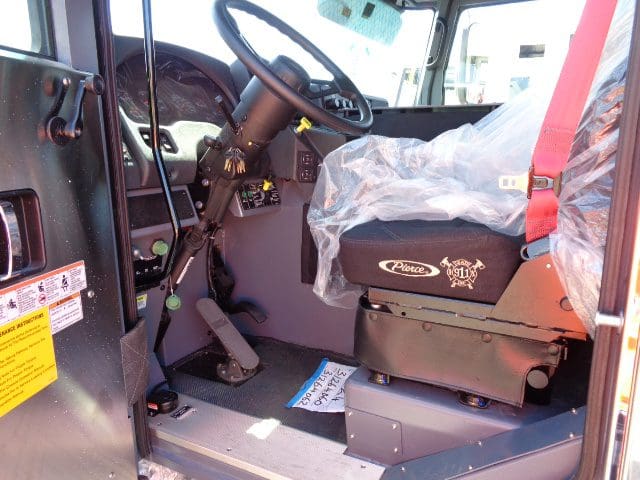

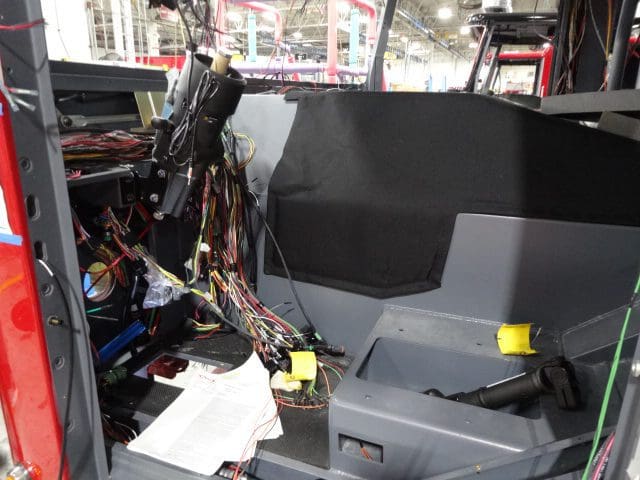

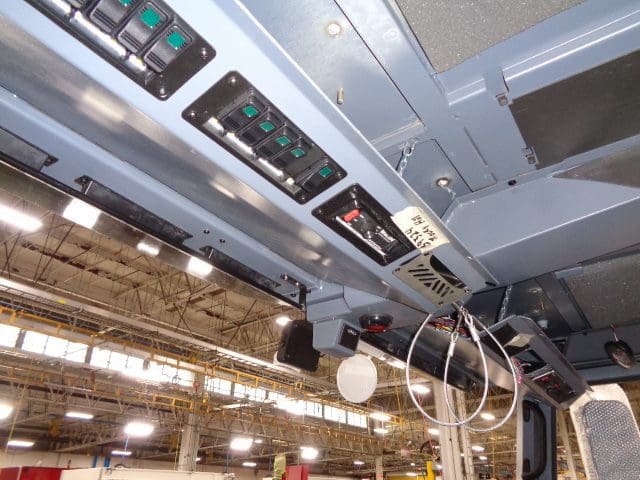

In this report, the cab began to receive trim and wiring harnesses and the body was unavailable for photos.
11-18-23

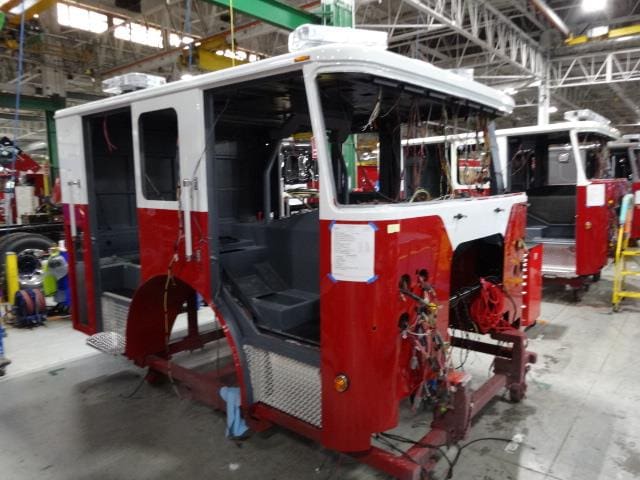

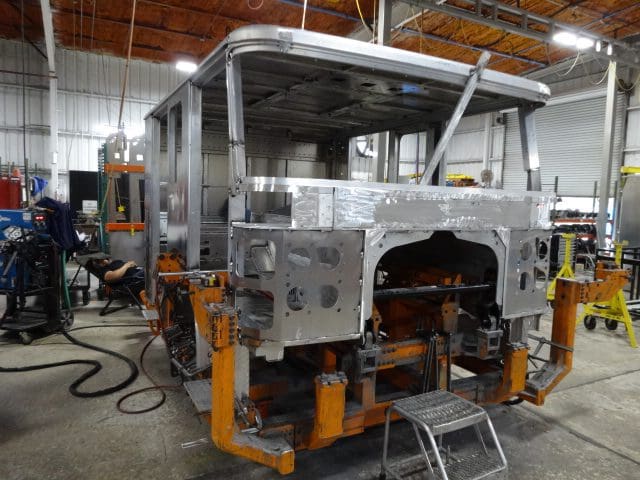

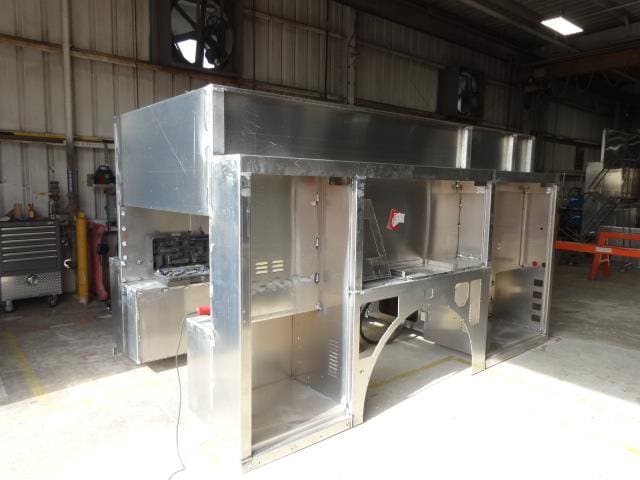

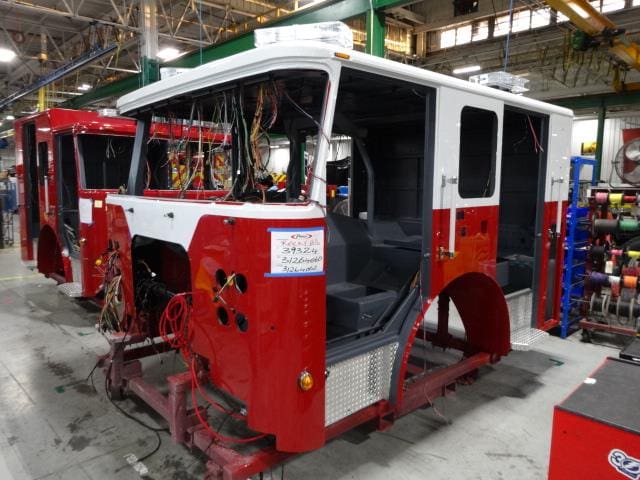

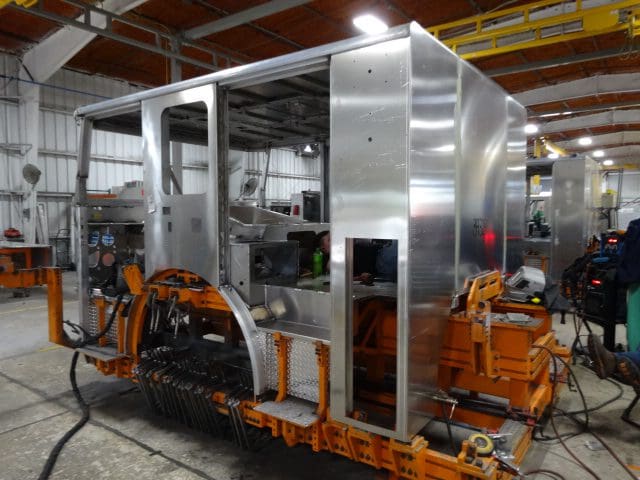

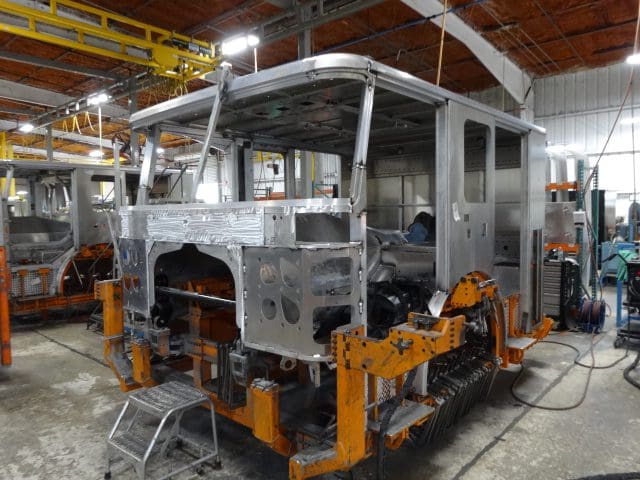

This new Pierce apparatus is now in production at the Bradenton Florida facility. In this report, the cab began fabrication.
